You are currently on the new version of our website. Access the old version .
Applied SciencesApplied Sciences
  • Article
  • Open Access

21 January 2026

Scheduling of the Automated Sub-Assembly Welding Line Based on Improved Two-Layer Fruit Fly Optimization Algorithm

and
1
School of Mechanical Engineering, Shanghai Jiao Tong University, Shanghai 200240, China
2
Shanghai Changxing Ocean Laboratory, School of Mechanical Engineering, Shanghai Jiao Tong University, Shanghai 200240, China
3
Jiangnan Shipyard (Group) Co., Ltd., Shanghai 201913, China
*
Author to whom correspondence should be addressed.
This article belongs to the Special Issue Advances in AI and Optimization for Scheduling Problems in Industry

Abstract

Faced with the contradiction between the increasingly growing demand and labor-intensive manufacturing modes, in the current era of rapid development of informatization and artificial intelligence, improving manufacturing efficiency by means of automated manufacturing equipment has become a recognized development direction for most shipyards. This trend is particularly evident in the manufacturing of sub-assemblies, which are the smallest composite units of the hull. Taking an automated sub-assembly welding line in a shipyard as the research object, this paper constructs a mathematical model aimed at optimizing production efficiency based on the analysis of its operational processes and characteristics and proposes an improved two-layer fruit fly optimization algorithm (ITLFOA) for solving the automated sub-assembly welding line scheduling problem (ASWLSP). The proposed ITLFOA features a two-layer nested algorithm structure, with several key improvements proposed for both optimization layers, such as heuristic rules for spatial layout, improved neighborhood operators, an added disturbance mechanism, and an added population diversity restoration mechanism. Finally, the performance of ITLFOA is validated through a comparative analysis against the initial two-layer fruit fly optimization algorithm (initial TLFOA), the well-established Variable Neighborhood Search (VNS) algorithm and the actual manual operation results on a specific case of a shipyard.

1. Introduction

In recent years, the demand for China’s shipbuilding industry has gradually increased. According to the latest data released by the China Association of the National Shipbuilding Industry, the number of new orders accounted for 64.2% of the global total, an increase of 15.1% compared with the last five years. China’s shipbuilding industry has maintained the world’s largest market share for 16 consecutive years [1].
However, most shipbuilding enterprises in China still rely on manual operations, which are time-consuming, labor-intensive, and inefficient. Moreover, the production and operational environment is harsh, facing hazards such as high temperatures, noise, and dust. The entire Chinese shipbuilding industry is confronted with the growing social problem of “labor shortage”.
To address the above issues, the state has actively advocated the implementation of an innovation-driven development strategy, promoting industrial upgrading through technological innovation, replacing old technologies with new ones, and substituting labor-intensive technologies with intelligent ones. Driven by Industry 4.0 and intelligent manufacturing, automated production lines have become the core carrier for transforming and upgrading the manufacturing industry for high-quality growth. In recent years, major domestic shipbuilding enterprises have responded to the national call and vigorously promoted the advancement and construction of “digital shipbuilding”.
Modern shipbuilding enterprises adopt a segmented production model based on group technology and are oriented towards intermediate products, which are gradually manufactured and integrated into ship products. As shown in Figure 1, the operation process of shipbuilding mainly includes component processing, component assembly and welding, block integration, and hull joining. All components formed in the process beginning with parts and ending at the complete hull are referred to as intermediate products, which are sequentially classified as sub-assembly, intermediate assembly, main assembly, and block. Sub-assemblies represent the smallest assembly units of a ship’s hull, and a typical ship is generally composed of tens of thousands of such sub-assemblies. Meanwhile, to adapt to the modern shipbuilding system, shipbuilding enterprises adopt a pull-type production planning and management system. Therefore, as the foundational and most granular assembly process in shipbuilding, sub-assembly manufacturing directly determines the dimensional accuracy, welding quality, and overall construction efficiency of subsequent intermediate and main assemblies. Smooth sub-assembly task performance underpins the steady advancement of subsequent works and on-schedule ship delivery.

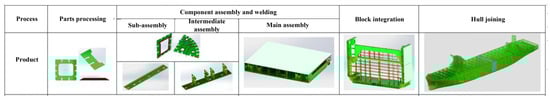

Figure 1. Shipbuilding process.
Furthermore, on the one hand, the number of sub-assemblies is enormous; an average ship consists of tens of thousands of sub-assemblies. On the other hand, most sub-assemblies weigh less than 1 ton. Although heavier than general products, they belong to the component level in the shipbuilding field and can be operated mechanically. Therefore, sub-assemblies have become the pilot target for shipyards to pursue automated transformation. At present, some shipyards have launched the construction of automated sub-assembly production lines, and studies on the manufacturing scheduling of automated sub-assembly production lines have become a top priority for current shipyard research. Therefore, this paper focuses on welding, the final production link of sub-assemblies, and investigates the scheduling problem of the automated sub-assembly welding line.
Some studies have already considered the scheduling problem of automated sub-assembly welding line [2]. But they focus on task sequencing optimization, typically assuming a known spatial layout and neglecting the impact of workpiece batching and layout on task allocation.
Compared with these existing works, the differentiated innovations of this study lie in two aspects. First, it expands the problem definition by establishing the first coupled model integrating sub-assembly batching, spatial layout planning, and multi-robot task allocation and sequencing. This approach breaks the limitations of single-dimensional optimization and enables the solution of complex scheduling problems with intertwined multi-constraints. Second, it achieves innovation in the algorithm framework: hierarchical heuristic rules and neighborhood operators are designed for the two-layer optimization structure, where outer-layer operators handle global adjustments of batching and layout and inner-layer operators adapt to local optimization of robot task allocation. This layered design circumvents the limitations of generic heuristic algorithms that adopt uniform optimization strategies for both global and local decision-making, effectively balancing the algorithm’s global exploration capability and local exploitation efficiency. It also ensures that the optimization process aligns with the inherent logic of the scheduling problem, laying a solid foundation for deriving high-quality and practical scheduling schemes.
The principal contributions of this work are outlined as follows.
1.
Makespan-minimized mathematical model tailored to the automated sub-assembly welding line scheduling problem (ASWLSP) in shipbuilding.
2.
Improved two-layer fruit fly optimization algorithm (ITLFOA) integrated with heuristic layout rules, optimized neighborhood operators, disturbance and diversity restoration mechanisms for hierarchical coordinated scheduling.
3.
Rigorous multi-benchmark comparative validation demonstrating ITLFOA superiority and extending resource-constrained scheduling algorithms’ applicability in ship robotic welding scenarios.
The remainder of this paper is organized as follows. Section 2 reviews related research on automated production line scheduling and ship sub-assembly scheduling. Section 3 introduces the automated sub-assembly welding line installed in the component workshop of a shipyard, analyzing its operational processes and characteristics. Based on this analysis, a mathematical model is established to minimize the total completion time. Section 4 describes the improved two-layer fruit fly optimization algorithm. Section 5 conducts performance verification using a specific case from the shipyard. Section 6 presents the conclusions.

3. Problem Description and Modeling

3.1. Problem Description and Analysis

Figure 2 shows an automated sub-assembly welding line built in the component workshop of a shipyard, which consists of four areas: a manual loading and assembly area, a to-be-welded workpiece buffer area, an automated welding area, and a repair and unloading area. At first, components are manually transported to assembly stations for assembly work. After assembly, the components are sequentially conveyed to buffer stations and welding stations via the roller table system, where robots automatically identify and weld them to form sub-assemblies. And then, the sub-assemblies are transported to repair and grinding stations through the roller table system. Eventually, the sub-assemblies after repair and grinding are moved out of the line by workers.
Figure 2. An automated sub-assembly welding line.
The robot system in the welding area consists of a cantilever device with X / Y -directional movement functions and a rotation function about the θ -axis, as well as a robotic welding system. The robotic welding system is fixed within the cantilever device. Each cantilever device drives two robotic systems to move, and the two robots form a group and share all external axes, as shown in Figure 3. There are four sets of cantilever devices on both sides of the same track, meaning the entire production line is equipped with a total of eight robots.
Figure 3. Schematic diagram of welding robot.
Based on their arrangement on both sides of the roller table, the four sets of cantilever systems can be divided into same-side cantilever systems and opposite-side cantilever systems. The same-side cantilever systems share a common track and can perform collaborative welding on workpieces within the welding reachable area along the track. Due to the limitations of arm span and track, the opposite-side cantilever systems can only handle welding tasks for workpieces within 3.5 m in the Y-direction. It can be inferred that when welding workpieces with a width greater than 3.5 m, the two sets of opposite-side cantilevers can collaborate on welding the workpiece. When welding workpieces with a width within 3.5 m, the four sets of cantilever systems can be split into four independent cantilever welding systems for separate welding, and the entire production line can be divided into two independent upper and lower production lines for operation. The line is suitable for workpieces with a maximum height of 1 m and a maximum vertical welding height of 550 mm.
The x-axis of the sub-assembly workpiece coordinate system is arranged parallel to the length direction of the roller table. When the width of a workpiece perpendicular to the length direction of the roller table exceeds 3.5 m, the welding tasks within 3.5 m are performed by robots on the same side, while those beyond 3.5 m are handled by robots on the opposite side. Therefore, when workpieces with a width exceeding 3.5 m are placed in the welding area, the x-axis of their workpiece coordinate system must also be parallel to the length direction of the roller table. For workpieces with a width less than 3.5 m, the x-axis of their workpiece coordinate system is usually placed parallel to the length direction of the roller table but can also be placed arbitrarily. In addition, the robot has a 200 mm margin in the width direction of the roller table (Y-direction), meaning that if the distance between the x-axis of the workpiece and the edge of the track is within 200 mm, the robot can compensate for it; otherwise, due to the arm span limitation, the robot cannot compensate for this distance deviation, resulting in a failure to perform the intended welding tasks.
In terms of collision prevention, the two sets of opposite-side cantilever systems cannot simultaneously weld tasks near the 3.5 m centerline of the roller table. Usually, a safe distance must be maintained, or robot 1 performs welding while robot 2 pauses and waits until robot 1 completes welding and moves away from the centerline before robot 2 performs welding tasks near the centerline. For the two sets of same-side cantilever system welding workpieces on the roller table, the safe distance is defined as a spherical area with the center of the base of each cantilever system as the center and a radius of 3.5 m. If the distance between the two systems is greater than this safe distance, no collision will occur. Therefore, for the two sets of same-side cantilever systems, there are two independent welding areas on both sides of the welding zone, in which welding tasks can only be welded by one cantilever welding system. In addition to the two independent welding areas on the same side, there is also an independent welding area, and the welds in it need to be assigned to two sets of cantilever welding systems.

3.2. Problem Formulation

Improving robot welding efficiency is the current main demand of enterprises, so this study takes minimizing the total completion time as the objective function. The analysis of the automated sub-assembly welding line reveals that sub-assemblies are placed in batches in the work area for welding. Therefore, it is initially essential to take into account the batching and spatial layout of sub-assemblies with various shapes. Subsequently, for batches of sub-assemblies, their welding tasks need to be assigned to four sets of cantilever welding robots, and their welding sequence must be determined in the limited work area, as shown in Figure 4. These four sets of cantilever welding robots could be deemed analogous to parallel processing machines, so this scheduling problem can be classified as the parallel machine scheduling problem. However, unlike traditional parallel machine scheduling problems, equipment interference between robots must be considered during the operation of the four parallel welding robots.

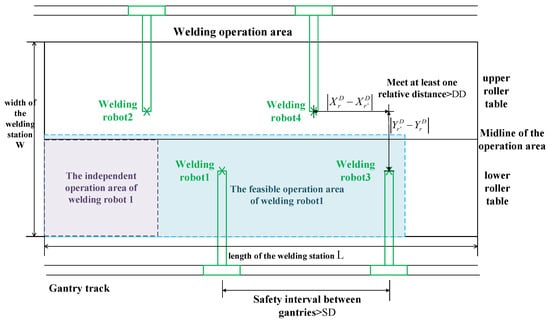

Figure 4. Schematic diagram of the work area.
The main decision variables of this scheduling problem include sub-assembly batching, sub-assembly spatial layout, welding task assignment within batches, and welding task sequencing within batches. Among these, welding task assignment and sequencing can only be further optimized after determining the sub-assembly sequencing, batching, and spatial layout, resulting in the nested optimization characteristic of this problem. In summary, the scheduling problem of the automated sub-assembly welding line studied in this paper can be defined as a two-layer cyclic optimization problem: first, the outer layer optimizes the sub-assembly sequencing, batching, and spatial layout. Then, the inner layer further optimizes the welding task assignment and sequencing. Finally, the solution of the outer layer optimization is further adjusted based on the results of the inner layer optimization.
To elucidate the modeling logic, a simplified illustrative example is considered. Suppose a batch contains several sub-assemblies of different shapes and sizes. The outer-layer optimization first determines (1) the sequence in which these sub-assemblies enter the welding area, (2) how they are grouped into batches for simultaneous processing, and (3) their precise spatial positions on the roller table to avoid physical overlap and respect robot reachability constraints. Once a feasible batch layout is fixed, the inner-layer optimization addresses the detailed scheduling within that batch: it assigns each individual welding seam task to one of the four robot systems and sequences the execution of these tasks on each robot, while strictly adhering to collision-avoidance constraints between the all robots. The overall makespan depends critically on both the outer layer and inner layer. The outer layer calculates an efficient spatial layout which maximizes parallel robot utilization. At the same time, the inner-layer carry out an optimal task assignment and sequence which minimize idle time and delays due to interference. This two-layer, cyclic approach reflects the practical nesting of these decisions in the operational control of the line.

3.2.1. Assumptions

(1) Once the spatial positions of sub-assemblies at the welding stations are determined, they will not be moved until the welding of the entire batch of sub-assemblies is completed. Most sub-assemblies require crane handling due to their weight, and adjusting their positions mid-welding would involve time-consuming crane operations and calibration, leading to prolonged downtime—this aligns with shipyard operational reality.
(2) The transfer time of sub-assembly batches into and out of the automated welding area is neglected in the model. Based on on-site data, the average transfer time is 30 s, accounting for only 0.67–1% of a batch’s completion time (3000–4500 s). This negligible proportion has minimal impact on scheduling accuracy, while simplifying the model to focus on core layout and task allocation.
(3) The idle movement time of welding robots between consecutive welding tasks is neglected in the model. Field measurements show the robot’s idle movement speed (0.13 m/s) is 20 times its welding speed, and each weld has a 90 s preparation time, resulting in idle movement time accounting for only 2% of total welding time. This simplification streamlines computation without affecting task sequencing or load balancing, as the time gap offers no practical decision-making value.
(4) When a welding task crosses the boundary between the upper and lower roller tables, take the lower roller table as an example. If the y-axis coordinate of the upper endpoint of the welding task is less than W / 2 + M D but greater than W / 2 , the welding task can be completed by the robot in the next operation; If the y-axis coordinate of the upper endpoint of the welding task is greater than W / 2 + M D , the welding task is split into two tasks at the W / 2 position, which are completed by the upper and lower robots, respectively. The same logic applies to the upper roller table. The splitting ensures full coverage of wide workpieces, avoids collision risks, and maintains welding efficiency, making the assumption highly applicable to industrial practice.
(5) A single welding task can only be completed by one welding robot, and once a welding task starts, it cannot be interrupted.

3.2.2. Mathematical Modeling

In the production process of sub-assemblies, the welding station, as a bottleneck link, requires that the four welding robots can participate in the sub-assembly welding process to the maximum extent. Therefore, the objective function of this paper is to minimize the total completion time, as presented in Equation (1).
minimize o b j = max ( E i ) ,
where the symbols of parameters and decision variables in the proposed algorithmic model are listed as in Table 1 and Table 2. The constraints considered are as follows:
Table 1. The symbols of parameters in the proposed algorithmic model.
Table 2. The symbols of decision variables in this paper.
(1) The same-side interference constraint. To prevent collision between adjacent robots (e.g., left-side robots or right-side robots), the distance between any two robots r and r on the same side along the x-axis must exceed the safety distance S D .
X r D X r D S D , r , r { r = r + 2 n r , n r Z + } ,
where r and r denote the indices of robots positioned on the same-side.
(2) The opposite-side interference constraint. To avoid operational interference between upper and lower welding robots on opposite-sides, if their distance along the x-axis is less than the safety distance D D , they must maintain the safety distance D D along the y-axis:
| X r D X r D | D D | Y r D Y r D | D D , r , r { r = r + 2 n r + 1 , n r Z + } ,
where r and r denote the indices of robots positioned on the opposite sides.
(3) The feasible working area constraint. A welding task i can be assigned to robot r only if both endpoints of the weld seam fall within the robot’s feasible working area, at this instant P i , r = 1 . This is formulated as Equation (4).
r = 1 R P i , r = 1 X r C S X j P + X j , i , f < X r C E Y r C S Y j P + Y j , i , f < Y r C E , i , f { 1 , 2 }
(4) The independent working area constraint. To ensure operational independence and reduce coordination complexity, a welding task i is valid only if at least one of its endpoints f lies within the robot’s independent working area, at this instant P i , r = 1 .
P i , r = 1 f { 1 , 2 } s . t . X r O S X j P + X j , i , f < X r O E Y r O S Y j P + Y j , i , f < Y r O E , i , r
(5) The designated area constraints. All of the sub-assemblies must not be placed beyond the designated area.
0 X j P X j P + max X j , h L 0 Y j P Y j P + max Y j , h W
(6) The space placement constraints. All sub-assemblies must not be overlapped. When the welding station coordinates ( x , y ) are occupied by sub-assembly j at time t, it is designated as such Q j , x , y , t = 1 ; otherwise, Q j , x , y , t = 0 .
Q j , x , y , t + Q j , x , y , t 1 j , j , x , y , t
The mathematical model constructed in this paper provides clear solution guidance and constraint boundaries for the subsequent optimization algorithm. The minimizing makespan defined by the objective function is directly transformed into the calculation criterion of individual fitness values in the algorithm. The outer layer takes the total makespan of all batches as fitness, and the inner layer takes the makespan of a single batch as fitness. The spatial layout constraints, robot collision avoidance constraints, and other constraints in the model correspond to the spatial layout heuristic rules in the algorithm-decoding process and the collision detection logic in welding task assignment, respectively, ensuring that the algorithm search always proceeds within the feasible solution space and avoids invalid iterations.

4. Optimization Algorithm

Fruit fly optimization algorithm (FOA) is selected as the baseline metaheuristic primarily due to its structural simplicity, rapid convergence, and strong global search capability. Compared to other algorithms such as PSO and GA, FOA requires fewer parameters, is easier to implement, and maintains high computational efficiency in continuous optimization problems, especially in high-dimensional spaces. These advantages make it particularly suitable as a foundational framework. To further enhance its optimization performance and avoid premature convergence, we extend the standard FOA into a two-layer cooperative structure, thereby balancing exploration and exploitation more effectively.
The improved two-layer fruit fly optimization algorithm is proposed in this paper, as shown in Figure 5. After inputting the sub-assemblies to be welded, the algorithm first enters the outer-layer optimization process to encode the sub-assembly workpieces and generate an initial population. Subsequently, the population is decoded to obtain the batching and spatial layout results of the sub-assemblies. On this basis, the inner-layer optimization process of welding task assignment and sequencing is further performed. The welding tasks in each batch are encoded, and the welding task population is randomly initialized. Then, the welding task population is decoded to obtain the start time and completion time of each welding task. In the inner-layer vision phase, the fitness value of each individual is evaluated based on the total idle time of each robot within the batch, and the roulette wheel selection method is adopted to preserve the population elite individuals. If the termination criterion for the inner-layer iteration is not satisfied, the algorithm employs four neighborhood operators designed for welding tasks to search for the optimal solution.

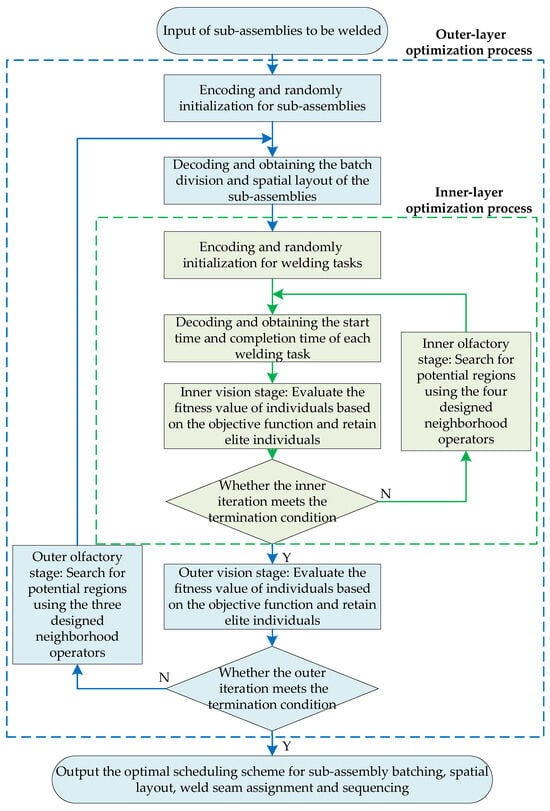

Figure 5. Flowchart of the improved two-layer fruit fly optimization algorithm.
After the completion of the inner-layer iteration, when the inner-layer optimization meets its convergence condition. The inner-layer outputs the finish time of the corresponding batch. This convergent feedback is then transmitted to the outer layer as the core evaluation basis for the current outer-layer solution. Next, the outer-layer vision phase evaluates the fitness of each individual in the sub-assembly-encoded population. The fitness value is comprehensively computed with reference to the finish time of all batches, which is aggregated from the convergent feedback of each batch’s inner-layer optimization. Based on this fitness evaluation, the roulette wheel selection method is also used to retain elite individuals with superior performance, ensuring the quality of the population for subsequent iterations. Similarly, in the olfaction phase of the outer-layer optimization process, three designed neighborhood operators are applied to search for more potential individuals in the solution space of sub-assembly encoding until the outer-layer iteration termination condition is satisfied. Finally, the optimal scheduling scheme, including sub-assembly batching, spatial layout, welding task assignment, and sequencing, are outputs.

4.1. Spatial Layout Method Under FOA (Outer-Layer Optimization Process)

4.1.1. Encoding and Initialization

A real-number encoding method is adopted for sub-assemblies, where each individual is represented by a chromosome. The length of the chromosome is equal to the number of sub-assemblies to be scheduled, denoted as J. Each gene in the chromosome is a real number between 0 and 1. The smallest gene value corresponds to the sub-assembly 1 with the smallest index. The second smallest gene value corresponds to the sub-assembly 2, and so on. Based on this encoding rule, an initial population containing P 1 chromosomes is randomly generated to form the initial population.

4.1.2. Decoding

The decoding process converts each chromosome in the population into a sub-assembly batching plan and a spatial layout plan.
Step 1. Convert the real-number-encoded chromosome into the corresponding sub-assembly sequence based on the encoding rule.
Step 2. Initialize an empty batch k and the corresponding available welding area.
Step 3. Attempt to place the first sub-assembly j in the sequence into the current batch k.
Step 4. If sub-assembly j can be placed in the current batch k, go to Step 5; otherwise, return to Step 2.
Step 5. Place sub-assembly j into batch k based on the heuristic rules for spatial layout (SLHR), update the usage status of the batch’s area, and remove sub-assembly j from the sub-assembly sequence.
Step 6. If all sub-assemblies have been scheduled, go to Step 7; otherwise, return to Step 3.
Step 7. End and output the sub-assembly batching scheme and the spatial layout scheme.
The heuristic rules for spatial layout (SLHR) are as follows:
Rule 1: Maximum load balancing rule
Due to the varying shapes and sizes of sub-assemblies in each batch, different welding task durations, and the limited working area of each robot, some robots may remain idle for extended periods. Therefore, the maximum load balancing rule is proposed: if sub-assembly j can be placed in batch k, select the placement posture ( X j P , Y j P , θ j P ) such that the variance of the total welding tasks in the feasible working area ( X r C S , X r C E ) , ( Y r C S , Y r C E ) of each robot after placement is minimized. This rule directly addresses the load imbalance issue among robots, reducing unnecessary idle time and improving overall production efficiency of the welding line.
Rule 2: Large-area sub-assembly first rule
Due to the different shapes and sizes of sub-assemblies in each batch, large-area sub-assemblies may fail to be placed if scheduled later, leading to low space utilization. Therefore, the large-area sub-assembly first rule is proposed: after creating a new empty batch k, first determine the spatial positions ( X j P , Y j P ) of large-area sub-assemblies (with base plate area above the overall third quartile) from the set of sub-assemblies to be scheduled. If these large-area sub-assemblies cannot be placed in batch k, then supplement with other sub-assemblies. This design ensures that key components with higher spatial requirements are reasonably arranged first, reducing the risk of batch splitting and improving scheduling continuity.
Rule 3: Long strip sub-assembly prioritizes the longitudinal placement rule
Since the interference between longitudinally placed sub-assemblies is relatively smaller than that between transversely placed ones, the longitudinal placement rule for long strip sub-assemblies is proposed. If the length L j of the sub-assembly is greater than 1.5 times its width W j and the length L j of the sub-assembly is less than the site width W, priority should be given to angle θ j P = 90 or 270 . Longitudinal placement reduces the overlapping probability of welding ranges between adjacent sub-assemblies, effectively mitigating robot collision risks during operation.
Rule 4: The upper and lower robots sub-assembly with the most welding tasks, prioritize using the upper and lower robots
During sub-assembly placement, some sub-assemblies have multiple welding tasks and require a long operation time. The following rule is proposed to avoid mutual interference between robots on different sides during operation. If sub-assembly j can be placed in batch k, select the placement posture ( X j P , Y j P , θ j P ) such that the difference in the number of welding tasks of sub-assembly j between the upper half and the lower half is minimized. Balancing the number of welding tasks between the upper and lower halves enables the parallel operation of upper and lower robots, shortening the processing cycle of high-load sub-assemblies and reducing cross-side robot interference for complex tasks.
Rule 5: Minimum interference welding task first rule
Considering the limited spatial area, sub-assemblies with fewer interferences between their welding tasks should be placed together as much as possible. Therefore, the minimum interference welding task first rule is proposed. If sub-assembly j can be placed in batch k, select the placement posture ( X j P , Y j P , θ j P ) such that the total interference length between the welding tasks of sub-assembly j and those of other sub-assemblies already placed in batch k is minimized. Minimizing welding task interference to the greatest extent possible, reducing the need for robot waiting and path adjustment, and minimizing the probability of interference during the welding process.

4.1.3. Neighborhood Operator Design

In this study, three types of neighborhood operators are designed for sub-assembly encoding to search for better population individuals.
Operator 1: Randomly select one gene from the current chromosome and randomly insert it into another position in the chromosome.
Operator 2: Randomly select two genes from the current chromosome and swap their positions in the chromosome.
Operator 3: Randomly select two genes from the current chromosome and insert these two genes into other positions in the chromosome.
These operators complement each other to form a flexible local search framework. The single-gene insertion and two-gene swapping operators enhance the algorithm’s exploitation capability by fine-tuning local solution structures, while the two-gene insertion operator strengthens exploration by adjusting the relative sequence of key sub-assemblies without disrupting their internal correlation. Based on the above three neighborhood operators, in the outer olfactory phase, N 1 neighborhood solutions are generated for each individual in the population to facilitate the search for better sub-assembly batching and spatial layout schemes within the solution space.
In addition, to expand the exploration space of solutions, two population optimization mechanisms are designed.
(1) Disturbance mechanism: Based on the current solution, randomly apply a certain neighborhood structure to generate a new solution, providing a new starting point for subsequent local searches. It enhances the global exploration capability of the algorithm, enabling it to search a wider solution space for potential optimal schemes.
(2) Population diversity restoration mechanism: When it is detected that the normalized standard deviation of the population’s fitness values, denoted as σ , is less than the threshold, a certain proportion of the solutions in the population, denoted as r r , are randomly replaced with newly generated random solutions. Here, the replacement rate is 20%. The optimal values of σ and r r are determined through experiments, as detailed in Section 5.1. This design ensures that the algorithm maintains strong search vitality throughout the iteration process, improving the probability of finding the global optimal solution.

4.2. Sequence Optimization Method Under FOA (Inner-Layer Optimization Process)

4.2.1. Encoding and Initialization

Welding tasks are encoded using an integer encoding method. Each individual is represented by R segments of chromosomes, where each segment corresponds to a set of cantilever welding robots r, and the integers in each chromosome correspond to the indices i of the welding tasks in the batch.
During the individual initialization process, since welding tasks in the independent operation area ( X r O S , X r O E ) , ( Y r O S , Y r O E ) can only be completed by the corresponding welding robot r, if part of a welding task is in this area, the entire welding task can only be welded by robot r, so the index i of this welding task can only be assigned to the chromosome corresponding to robot r. Subsequently, for welding tasks in the public area, they are randomly assigned to the chromosomes corresponding to the welding robots capable of performing those tasks. By repeating the above process, an initial population containing P 2 chromosomes is generated.

4.2.2. Decoding

The decoding process of the welding task sequence adopts a serial schedule generation mechanism.
Step 1: Set the scheduling time t = 0 and initialize the index list of scheduled welding tasks as empty.
Step 2: Identify the welding robots that are idle at the current time.
Step 3: Find the next welding task to be welded from the chromosome of each idle welding robot to form a set of candidate welding tasks.
Step 4: If there is spatial interference between the welding tasks in the candidate set and those currently being performed, go to Step 5; otherwise, go to Step 6.
Step 5: Remove those welding tasks from the candidate set.
Step 6: If there is spatial interference between the allocatable regions of the tasks in the candidate set, go to Step 7; otherwise, go to Step 8.
Step 7: Compare the lengths of the pending welding tasks of the robots corresponding to the interfering welding tasks. The welding task of the robot with the longer pending welding task length is further removed from the candidate set.
Step 8: Place all remaining welding tasks in the candidate set, calculate their welding end times based on the welding time calculation rules, and remove the indices of these tasks from the corresponding robot chromosomes.
Step 9: Once all welding tasks are scheduled, move to Step 11; otherwise, go to Step 10.
Step 10: Choose the minimum completion time of the scheduled welding tasks exceeding the current scheduling time to serve as the next scheduling time, and return to Step 2.
Step 11: End and output the welding task assignment and welding schedule.
Through the above decoding method, a specific welding task encoding individual can be converted into the corresponding welding task assignment and welding schedule, and then the total idle duration of the batch is computed to evaluate the fitness value of the individual.

4.2.3. Neighborhood Operator Design

In this study, four types of neighborhood operators are designed for welding task encoding to search for better population individuals.
Operator 1: Randomly select one chromosome segment from the individual, then randomly select one gene from this chromosome and insert it into a random position within the same chromosome.
Operator 2: Randomly select one chromosome segment from the individual, then randomly select two genes from this chromosome and swap their positions.
Operator 3: Randomly select one chromosome segment from the individual, then randomly select one gene from this chromosome. If there are robots capable of performing the corresponding welding task, insert this gene into a random position in the chromosome corresponding to that robot.
Operator 4: Randomly select two genes from the individual. If the corresponding welding robots can both perform at least two welding tasks, randomly select two tasks from the public welding task set and insert them into random positions in the two chromosomes.
These operators create a targeted search framework for inner-layer optimization by combining local fine-tuning via gene insertions and swaps with cross-robot adjustments, using robot-based gene insertion and task exchanges. This balance of exploiting local solutions and exploring new task combinations prevents premature stagnation, ensuring effective welding task assignment and full use of robot capabilities. Based on the above four neighborhood operators, in the inner olfactory phase, N 2 neighborhood solutions are generated for each individual in the population to facilitate the search for better scheduling schemes for welding task assignment and sequencing in the solution space. The disturbance mechanism and population diversity restoration mechanism are also used in the iteration process to expand the exploration space of solutions.

4.3. Analysis of Algorithm Calculation Complexity

The computational cost of the improved two-layer fruit fly optimization algorithm (ITLFOA) stems primarily from the decoding and neighborhood search operations embedded in its two-layer nested structure. In outer-layer optimization, decoding each individual involves generating the spatial layout of sub-assemblies, with a time complexity of approximately O ( J ) , which is dominated by interference checking in heuristic layout rules. For inner-layer optimization, the decoding of welding task sequences adopts a serial schedule generation scheme, yielding a complexity of around O ( n ) , where n represents the total number of welding tasks per batch. The associated cost arises mainly from spatial interference checks for weld seam execution at each scheduling step. Thus, the total time complexity of the algorithm can be approximated as O ( G 1 · P 1 ( J + G 2 P 2 B n ) ) , where G 1 , G 2 and P 1 , P 2 refer to the iteration counts and population sizes for the outer and inner layers, respectively, and B denotes the number of batches.
Although this complexity exhibits polynomial growth, the number of sub-assemblies processed daily in practical automated sub-assembly welding line scheduling problems (ASWLSPs) rarely exceeds 100, and the task count n per batch is constrained by the physical dimensions of the welding area, ensuring that key problem parameters do not increase indefinitely. The parameter tuning presented in Section 5.1 of this paper is specifically designed to obtain high-quality solutions for problems of a given scale within an acceptable computational time frame ranging from several minutes to tens of minutes. In summary, the computational complexity of ITLFOA is manageable and practical for solving real-world scheduling problems in shipyards, demonstrating favorable engineering scalability. Finally, the pseudocode of ITLFOA is shown in Algorithm 1.
Algorithm 1 ITLFOA Algorithm
Require:
An automated sub-assembly welding line scheduling problem (ASWLSP), outer-layer maximum iteration count G 1 , max , inner-layer maximum iteration count  G 2 , max
Ensure:
Optimal scheduling scheme
 1:
Generate outer-layer initial population P outer , set G 1 = 0
 2:
while  G 1 < G 1 , max  do
 3:
    for all individual p i , outer P outer  do
 4:
        Decode p i , outer : sub-assembly batching and spatial layout
 5:
        Obtain batch set B = { B 1 , B 2 , , B k }
 6:
        for all batch B k B  do
 7:
           Generate inner-layer initial population P inner , set G 2 = 0
 8:
           while  G 2 < G 2 , max  do
 9:
               for all individual p j , inner P inner  do
10:
                   Decode p j , inner : seam assignment and sequencing
11:
                   Evaluate fitness (batch completion time M k )
12:
               end for
13:
               Select elite individuals via roulette wheel selection
14:
               Update P inner using 4 neighborhood operators with disturbance mechanism
15:
                G 2 = G 2 + 1
16:
           end while
17:
           Get optimal batch completion time M k *
18:
        end for
19:
        Compute total makespan: Total M = k = 1 K M k *
20:
        Select elite individuals in P outer via roulette wheel selection
21:
        Update P outer using 3 neighborhood operators with disturbance mechanism
22:
        Update P outer with diversity restoration mechanism
23:
         G 1 = G 1 + 1
24:
    end for
25:
end while
26:
Output the optimal scheduling scheme

5. Results and Discussions

This paper uses partial data from a shipyard to form a solution case. The baseline case includes 30 sub-assemblies ( J = 30 ) , the space size is ( 11 , 7 ) ( ( L , W ) = ( 11 , 7 ) ) . The safety distance between welding robots on the same side is 3.5 ( S D = 3.5 m ) , the safety distance between welding robots on opposite sides is 3 ( D D = 3 m ) , and the additional working distance in the Y-direction for welding robots at the junction of the upper and lower rollers is 0.2 ( M D = 0.2 m ) .
The effective working areas and independent working areas of each welding robot are detailed in Table 3. All units related to spatial dimensions are meters.
Table 3. Feasible and independent working areas of welding robots (unit: meters).

5.1. Parameter Settings

The key parameters to be determined for the proposed ITLFOA include outer-layer population size P 1 , inner-layer population size P 2 , the number of neighborhood solutions generated in the outer layer N 1 , and the number of neighborhood solutions generated in the inner-layer N 2 . Taguchi design approach is adopted to identify the optimal settings of these parameters. The value ranges of these parameters are P 1 { 20 , 30 , 40 } , P 2 { 20 , 30 , 40 } , N 1 { 1 , 2 , 3 } , N 2 { 1 , 2 , 3 } , as shown in Table 4; L 2 ( 3 4 ) orthogonal experimental combinations are selected. The algorithm is executed ten times per experimental combination, and the obtained objective function values are used as response values.
Table 4. Reference Values for Parameter Testing.

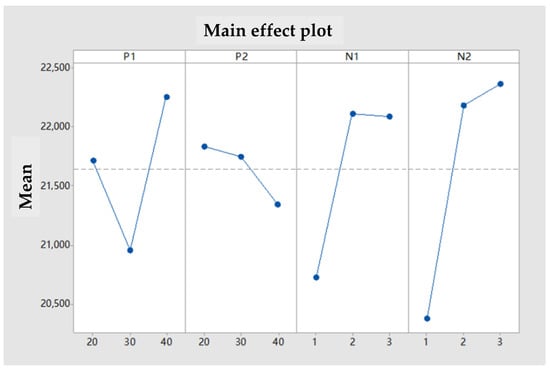

Eventually, the main effect plots of the mean value and signal-to-noise ratio are shown in Figure 6 and Figure 7. Analysis of these figures reveals that the minimum mean response and maximum signal-to-noise ratio are achieved when parameters P 1 , P 2 , N 1 , and N 2 are set to levels 2, 3, 1, and 1, respectively. Consequently, the optimal parameter combination was selected as P 1 = 30 , P 2 = 40 , N 1 = 1 , N 2 = 1 . Furthermore, the relative importance of these parameters, in descending order, was determined from Table 5 as N 2 , N 1 , P 1 , P 2 .

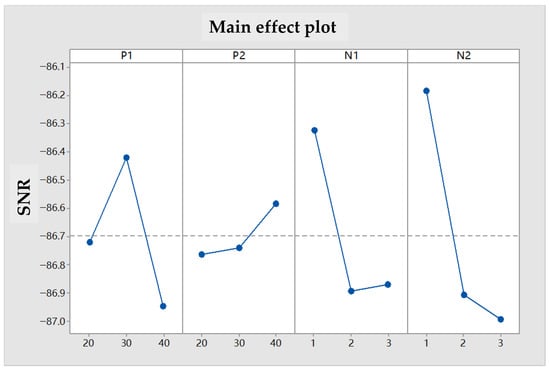

Figure 6. Main effect plot of means.
Figure 7. Main effect plot of Signal-to-Noise Ratio (SNR).
Table 5. Mean Response Table.
To further justify the chosen values for the population diversity restoration mechanism’s normalized standard deviation threshold ( σ ) and the solution replacement rate ( r r ), an additional experimental study was conducted. With the optimal settings of P 1 = 30 , P 2 = 40 , N 1 = 1 , N 2 = 1 fixed, we systematically evaluated various combinations of σ { 0.2 , 0.3 , 0.4 } and r r { 10 % , 20 % , 30 % } . Each combination was executed three times independently, and the average makespan was recorded. The results, presented in Table 6, demonstrate that the combination of σ = 0.3 and r r = 20 % yields the most favorable performance, achieving the lowest average makespan. This experimental validation supports our selection of these critical parameters for the population diversity restoration mechanism.
Table 6. Experimental Evaluation of Population Diversity Restoration Mechanism Parameters.

5.2. Performance Verification of the Proposed Algorithm

The performance of the proposed ITLFOA is comprehensively evaluated from three aspects to verify its efficiency and superiority. First, the solutions obtained by ITLFOA are compared with the current manual scheduling scheme. Second, the initial version of TLFOA (without the proposed improvements) is applied to the same problem for a direct performance comparison. Third, the Variable Neighborhood Search (VNS) algorithm, is introduced as an additional benchmark to contextualize the performance within broader optimization methodologies. These algorithms all use the same termination criteria, specifically the outer-layer maximum iteration count G 1 , max is 60, and the inner-layer maximum iteration count G 2 , max is 80.

5.2.1. Comparative Analysis with Manual Scheduling Results

In actual production, the approach adopted by engineers to obtain the spatial layout of sub-assemblies is as follows. At first, the large-area sub-assemblies are placed at the bottom-left or bottom-right corner; then, the small-area sub-assemblies in accordance with the principle of enhancing space utilization are placed in the vacant areas of the work space based on the principle of improving space utilization, but the choice of specific placement positions is relatively arbitrary.
Next, to allocate the weld seams, the welds within the feasible welding area are evenly partitioned between the two sets of welding systems based on the quantity of welds in their respective independent working areas.
In determining the welding sequence, the same-side welding robot adopts the sequence of vertical welding first, then flat welding, followed by welding along the main welding direction X. If there are welding tasks in the secondary welding direction Y within a certain X interval, the system switches to the welding tasks in the Y-direction. After completing the welding tasks in the secondary welding direction Y, it continues welding along the main welding direction, as shown in Figure 8.

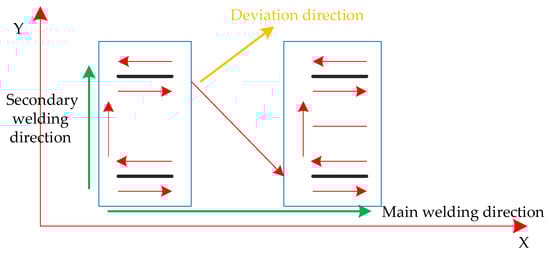

Figure 8. Schematic diagram of welding direction.

In the independent welding area, the two welding robots adopt collision avoidance strategies to prevent collisions, i.e., following collision avoidance strategy and opposing collision avoidance strategy, as shown in Figure 9 and Figure 10.
Figure 9. Following collision avoidance principle.
Figure 10. Opposing collision avoidance principle.
(1) Following collision avoidance strategy: When welding in the same direction, if the distance between the two robots is greater than 3.5 m, they can perform following welding; otherwise, the robots will pause for safety reasons and wait for manual handling.
(2) Opposing collision avoidance strategy: When welding in opposite directions, if the distance between the two robots is greater than 3.5 m, they can perform opposing welding; otherwise, the robots will pause for safety reasons and wait for manual handling.
Eventually, the manual scheduling results are shown in Figure 11, Figure 12, Figure 13, Figure 14, Figure 15, Figure 16, Figure 17, Figure 18, Figure 19 and Figure 20. To aid in the interpretation of the scheduling results (Figure 11, Figure 12, Figure 13, Figure 14, Figure 15, Figure 16, Figure 17, Figure 18, Figure 19 and Figure 20), the graphical elements are explained as follows: Each block represents a welding task. The black number inside a block denotes the unique identifier of the welding seam within its current batch. The blue annotation associated with each block provides detailed information about the corresponding sub-assembly, formatted as [ I n d e x ] : [ T y p e ] , ( X , Y , θ ) . For example, the annotation 0: 108B, (0, 5.3, 0) indicates that this task belongs to sub-assembly #0, of type 108B, positioned at coordinates (0, 5.3) with a rotation angle ( θ ) of 0 degrees.

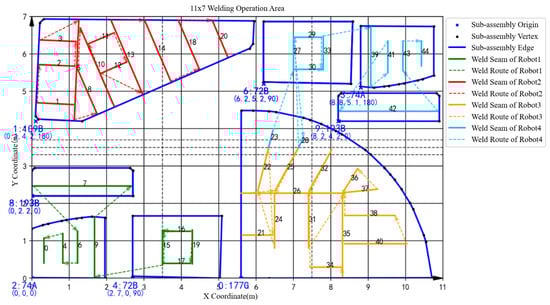

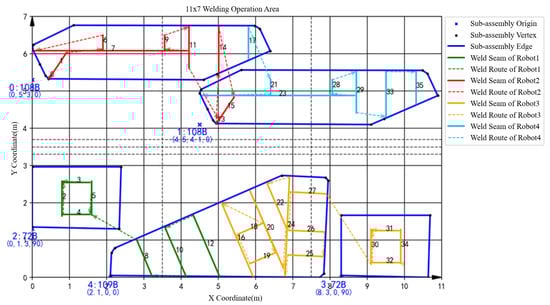

Figure 11. Spatial layout of batch 1 in the manual scheduling results.

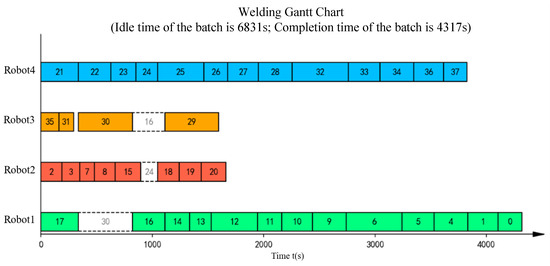

Figure 12. Gantt chart for sequence optimization of batch 1 in the manual scheduling results.
Figure 13. Spatial layout of batch 2 in the manual scheduling results.
Figure 14. Gantt chart for sequence optimization of batch 2 in the manual scheduling results.
Figure 15. Spatial layout of batch 3 in the manual scheduling results.
Figure 16. Gantt chart for sequence optimization of batch 3 in the manual scheduling results.

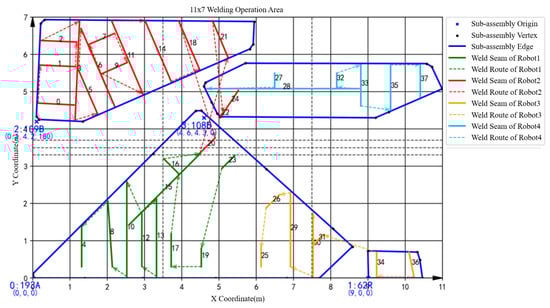

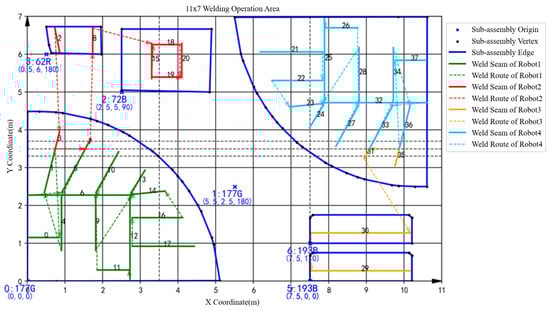

Figure 17. Spatial layout of batch 4 in the manual scheduling results.
Figure 18. Gantt chart for sequence optimization of batch 4 in the manual scheduling results.
Figure 19. Spatial layout of batch 5 in the manual scheduling results.
Figure 20. Gantt chart for sequence optimization of batch 5 in the manual scheduling results.
The scheduling results obtained by a single run of the proposed ITLFOA for the same case are shown in Figure 21, Figure 22, Figure 23, Figure 24, Figure 25, Figure 26, Figure 27, Figure 28, Figure 29 and Figure 30. The comparison of the results obtained by ITLFOA and manual operation is shown in Table 7.

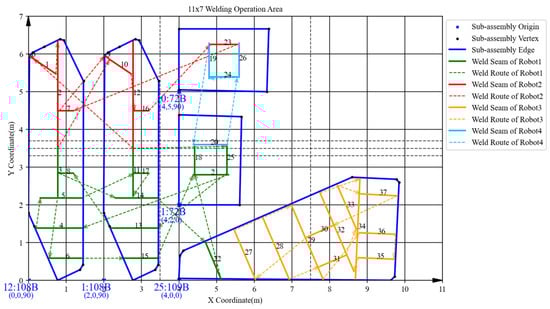

Figure 21. Spatial layout of batch 1 in the manual scheduling results.

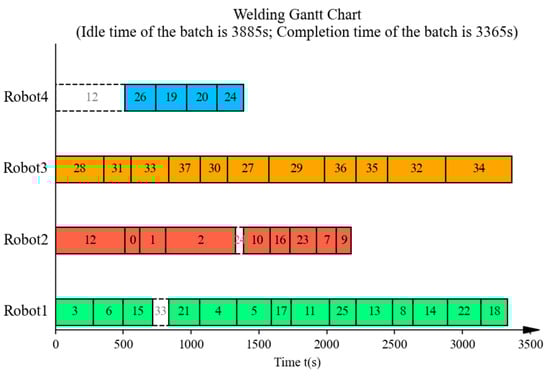

Figure 22. Gantt chart for sequence optimization of batch 1 in the manual scheduling results.

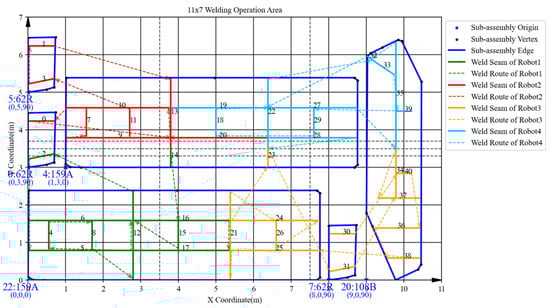

Figure 23. Spatial layout of batch 2 in the manual scheduling results.

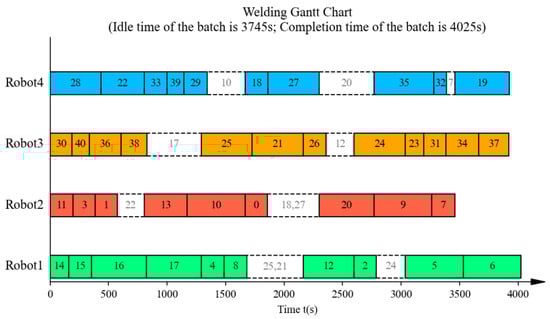

Figure 24. Gantt chart for sequence optimization of batch 2 in the manual scheduling results.

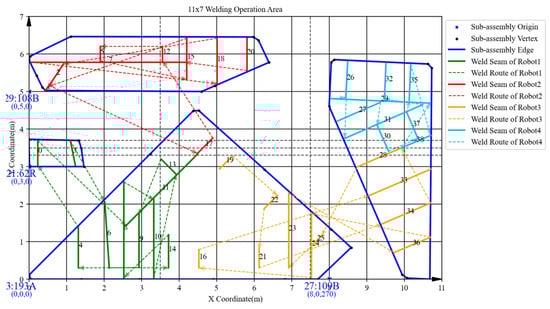

Figure 25. Spatial layout of batch 3 in the manual scheduling results.

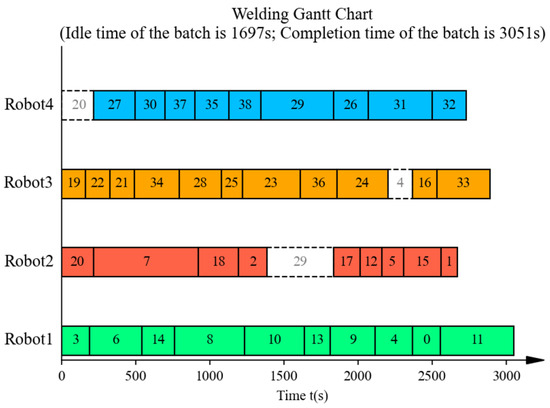

Figure 26. Gantt chart for sequence optimization of batch 3 in the manual scheduling results.
Figure 27. Spatial layout of batch 4 in the manual scheduling results.

Figure 28. Gantt chart for sequence optimization of batch 4 in the manual scheduling results.

Figure 29. Spatial layout of batch 5 in the manual scheduling results.

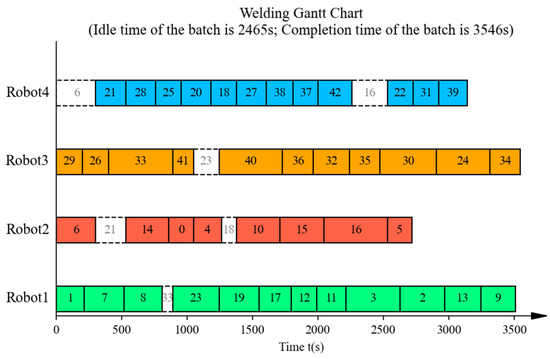

Figure 30. Gantt chart for sequence optimization of batch 5 in the manual scheduling results.
Table 7. The comparison of the results obtained by ITLFOA and manual operation.
As shown in Figure 11, Figure 12, Figure 13, Figure 14, Figure 15, Figure 16, Figure 17, Figure 18, Figure 19, Figure 20, Figure 21, Figure 22, Figure 23, Figure 24, Figure 25, Figure 26, Figure 27, Figure 28, Figure 29 and Figure 30 and Table 7, the proposed ITLFOA has distinct advantages in solving ASWLSP compared with manual scheduling. Regarding the total idle time, the result derived from ITLFOA is 14,120 s, while the result in manual operation is 32,266 s, compared with manual operation, the proposed ITLFOA reduces by 18,146 s, which means an improvement of 56.24%. Meanwhile, in terms of the total completion time, the result obtained by ITLFOA is 17,414 s, while the result in manual operation is 21,789 s, compared with manual operation, the proposed ITLFOA reduces by 4375 s, which means an improvement of 20.08%.
Further analysis of the scheduling results of each batch reveals obvious load imbalance in batches 3, 4, and 5 in the manual operation. Because during the process of determining the spatial layout of sub-assemblies, manual scheduling mainly focus on space utilization without considering load balancing. In addition, there is frequent equipment interference waiting in batch 2. This is due to the fact that robots on the same side are more prone to welding interference in the complex welding task distribution areas under the strategy “same side identical, opposite sides reversed”. In detail, a comparison of the sub-assembly spatial layouts reveals that the key difference stems from sub-assembly 108B. In the spatial layout of batch 2 obtained by ITLFOA (Figure 23), sub-assembly 108B is placed longitudinally, enabling the uniform distribution of its welding load between the upper and lower halves of the welding area. Consequently, the workloads of the upper and lower robots are more balanced, leading to nearly identical processing times among the four robots during subsequent weld scheduling. In contrast, in spatial layout of batch 2 of the manual scheduling results (Figure 13), sub-assembly 108B is placed transversely, resulting in most welding tasks being assigned to the lower half. This causes robots 1 and 3 to bear longer welding tasks, leading to unbalanced robot loads during weld scheduling. Meanwhile, the transverse placement of the longest welding task (task 21) results in processing interference with multiple other welding tasks. As illustrated in Figure 14, welding task 21 forces both robots 3 and 1 to experience prolonged waiting times, further extending the completion time of robot 1. Collectively, these two factors result in the longer completion time of batch 2 in the manual scheduling results. It fully demonstrates the effectiveness of the heuristic rules for spatial layout proposed in the ITLFOA.

5.2.2. Performance Comparison of ITLFOA, Initial TLFOA, and VNS

To the best of our knowledge, few published studies have specifically addressed the scheduling problem of automated sub-assembly welding lines, especially those integrating spatial layout and robot interference constraints. To provide a comprehensive evaluation of ITLFOA’s performance, we compare it against both its foundational version (initial TLFOA) and a well-established metaheuristic algorithm, Variable Neighborhood Search (VNS). It mainly aims to verify the effectiveness of several key improved designs proposed in the algorithm of this paper: the heuristic rules for spatial layout; the improved neighborhood operators; the added disturbance mechanism and population diversity restoration mechanism. The difference between of the ITLFOA and initial TLFOA is shown in Table 8. The comparison of the results obtained by ITLFOA, initial TLFOA and VNS is shown in Table 9. For VNS, standard parameter settings were employed.
Table 8. The difference between the ITLFOA and initial TLFOA.
Table 9. The comparison of the results obtained by ITLFOA, initial TLFOA, and VNS.
It can be seen from Table 9 that compared with the initial TLFOA and VNS, the ITLFOA proposed in this paper still exhibits favorable performance in both the total idle time and the total completion time. This demonstrates the effectiveness of the improved designs in ITLFOA, such as the heuristic rules for spatial layout, the improved neighborhood operators, the added disturbance mechanism, and the added population diversity restoration mechanism. In addition, compared with the initial manual operation results, the scheduling results obtained by the initial TLFOA have also a notable enhancement, which indirectly confirms the effectiveness of the two-layer algorithm structure of TLFOA.
To sum up, the comparison results of the above two aspects can prove that for ASWLSP, the proposed ITLFOA achieves better performance in terms of the design of the two-layer algorithm structure and the improvement of the improved designs.

5.2.3. Robustness and Statistical Analysis Across Problem Scales

To assess the robustness and statistical reliability of the proposed algorithm, experiments were extended to problem instances of different scales, specifically with 20, 30, 40, 50, 60, 70, and 80 sub-assemblies ( J 20 , J 30 , J 40 , J 50 , J 60 , J 70 , J 80 ) . For each case and each algorithm (Initial TLFOA, VNS, ITLFOA), three independent runs were executed. The mean and standard deviation of the total completion time are reported in Table 10. This approach allows for an evaluation of performance consistency and sensitivity to problem size.
Table 10. Statistical comparison of makespan (mean ± standard deviation) across different problem scales and algorithm.
As evidenced by Table 10, the proposed ITLFOA consistently outperforms both the initial TLFOA and VNS across all tested problem scales.

6. Conclusions

Amid the global wave of intelligent manufacturing and Industry 4.0, China’s shipbuilding industry boasting a 16-year consecutive global market share leadership faces acute contradictions between surging market demand and labor-intensive, inefficient production modes. Harsh working environments and a worsening “labor shortage” have further highlighted the urgency of automated transformation. As the smallest and most numerous composite units of ship hulls, sub-assemblies have become the primary breakthrough for shipyards to realize automation. The scheduling of automated sub-assembly welding lines, as a core link connecting component processing and block integration, not only determines the efficiency of shipbuilding production but also aligns with the national strategy of “digital shipbuilding” and the broader industrial trend of integrating batch processing, spatial layout, and multi-robot collaboration.
This study focuses on the automated sub-assembly welding line scheduling problem (ASWLSP) in shipyards, a complex constrained optimization problem involving multiple intertwined decision dimensions: sub-assembly batching, spatial lay-out planning, multi-robot task allocation, and welding sequence optimization. Unlike conventional scheduling problems, ASWLSP must address unique industry-specific constraints, including collision avoidance between same-side and opposite-side robots (with safety distances of 3.5 m and 3 m, respectively), limited robot working areas, and load balancing among eight robots grouped into four cantilever systems. The core challenge lies in resolving the nested dependency between global decisions (sub-assembly sequencing, batching, and spatial layout) and local decisions (welding task assignment and sequencing) to minimize the total completion time (makespan) while ensuring no spatial overlap of sub-assemblies, full coverage of welding tasks, and compliance with robot operational constraints.
To solve this problem, a mathematical model taking minimizing the makespan as its objective function is constructed, and an improved two-layer fruit fly optimization algorithm (ITLFOA) is proposed. In the outer-layer optimization process, the design of heuristic decoding algorithms, three neighborhood operators, a disturbance mechanism, and a population diversity restoration mechanism are proposed to optimize sub-assembly sequencing, sub-assembly batching, and sub-assembly spatial layout. In the inner-layer optimization process, heuristic decoding algorithms, four neighborhood operators, a disturbance mechanism, and a population diversity restoration mechanism are designed to obtain welding task assignment and welding task sequencing. Afterwards, the solutions of the outer-layer optimization will be further adjusted according to the results of the inner-layer optimization. Through such interaction between the inner and outer layers, the scheduling scheme for the automated sub-assembly welding line is obtained. Finally, the performance verification is carried out on a specific case of a shipyard. By comparing with the initial two-layer fruit fly optimization algorithm and the results obtained by the shipyard based on actual manual experience, the validity of ITLFOA is illustrated.
The scheduling problem of automated sub-assembly welding lines is a practically important engineering challenge for shipyards, and it enriches the existing research on resource-constrained scheduling by incorporating unique industry characteristics. It demonstrates cross-scenario adaptability, particularly in industrial settings that utilize gantry and cantilever robots for batch processing. These scenarios demand the coordinated integration of workpiece arrangement, task allocation, and multi-robot operation under specific operational constraints. Although the proposed ITLFOA has achieved relatively optimal solutions, the two-layer nested structure increases the algorithm’s computational complexity, which may affect its real-time performance in large-scale scheduling scenarios. In further research, a hybrid algorithm combining ITLFOA with deep learning mechanisms can be taken into consideration to improve the adaptability and solving speed of the algorithm through automatically extracting spatial layout features and welding task correlation patterns from historical data. In addition, only a single shipyard case has been considered. More diverse cases of different production line configurations, even in other manufacturing industries, can be used to test the performance of the proposed algorithm.
Generally, this study fills a research gap in ASWLSP by establishing the first coupled optimization model and a tailored ITLFOA, systematically addressing the nested decision-making challenges of automated sub-assembly welding line scheduling. It not only provides a practical solution for shipyards to achieve efficient, intelligent scheduling but also enriches the theoretical framework of resource-constrained scheduling by integrating industry-specific constraints (e.g., robot collision avoidance, spatial layout heuristics). The findings and methodologies presented offer valuable insights for promoting the transformation of labor-intensive manufacturing industries toward automation and intelligence, contributing to the advancement of global smart manufacturing practices.

Author Contributions

Conceptualization, W.X.; Methodology, W.X.; Software, W.X.; Validation, W.X.; Formal analysis, W.X.; Investigation, W.X.; Data curation, W.X.; Writing—original draft, W.X.; Writing—review & editing, W.X.; Supervision, Z.L. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Institutional Review Board Statement

Not applicable.

Data Availability Statement

The original contributions presented in this study are included in the article. Further inquiries can be directed to the corresponding author.

Conflicts of Interest

Author Wenlin Xiao was employed by the company Jiangnan Shipyard (Group) Co., Ltd. The remaining author declares that the research was conducted in the absence of any commercial or financial relationships that could be construed as a potential conflict of interest.

References

  1. CANSI. China’s Shipbuilding Industry Maintains Global Lead in Three Major Indicators for the First Three Quarters of 2025. Available online: https://www.cansi.org.cn/cms/document/19761.html (accessed on 17 October 2025).
  2. Liu, W.; Kuang, Z.; Zhang, Y.; Zhou, B.; He, P.; Li, S. An effective hybrid genetic algorithm for the multi-robot task allocation problem with limited span. Expert Syst. Appl. 2025, 280, 127299. [Google Scholar] [CrossRef]
  3. Shi, D.; Fan, W.; Xiao, Y.; Lin, T.; Xing, C. Intelligent scheduling of discrete automated production line via deep reinforcement learning. Int. J. Prod. Res. 2020, 58, 3362–3380. [Google Scholar] [CrossRef]
  4. Bai, L.; Wu, N.; Li, Z.; Zhou, M. Optimal one-wafer cyclic scheduling and buffer space configuration for single-arm multicluster tools with linear topology. IEEE Trans. Syst. Man Cybern. Syst. 2016, 46, 1456–1467. [Google Scholar] [CrossRef]
  5. Yang, F.; Wu, N.; Qiao, Y.; Su, R. Polynomial approach to optimal one-wafer cyclic scheduling of treelike hybrid multi-cluster tools via Petri nets. IEEE/CAA J. Autom. Sin. 2017, 5, 270–280. [Google Scholar] [CrossRef]
  6. Manzini, M.; Demeulemeester, E.; Urgo, M. A predictive–reactive approach for the sequencing of assembly operations in an automated assembly line. Robot. Comput.-Integr. Manuf. 2022, 73, 102201. [Google Scholar] [CrossRef]
  7. Sriskandarajah, C.; Drobouchevitch, I.; Sethi, S.P.; Chandrasekaran, R. Scheduling multiple parts in a robotic cell served by a dual-gripper robot. Oper. Res. 2004, 52, 65–82. [Google Scholar] [CrossRef]
  8. Kim, H.J.; Lee, J.H. Scheduling of dual-gripper robotic cells with reinforcement learning. IEEE Trans. Autom. Sci. Eng. 2021, 19, 1120–1136. [Google Scholar] [CrossRef]
  9. Kim, H.J.; Lee, J.H. Look-ahead based reinforcement learning for robotic flow shop scheduling. J. Manuf. Syst. 2023, 68, 160–175. [Google Scholar] [CrossRef]
  10. Lee, J.H.; Kim, H.J. Optimal Scheduling of Timed Petri Nets With Resource Marking and Ready Times: Application to Robotic Flow Shops. IEEE Robot. Autom. Lett. 2025, 10, 3684–3691. [Google Scholar] [CrossRef]
  11. Wang, J.; Zhou, H.; Guo, J.; Si, H.; Chen, X.; Zhang, M.; Zhang, Y.; Zhou, G. A Q-Learning-based Deep Deterministic Policy Gradient Algorithm for the Re-entrant Hybrid Flow Shop Joint Scheduling Problem with Dual-gripper. Eng. Lett. 2025, 33, 1632–1647. [Google Scholar]
  12. Mao, Z.; Wang, W.; Sun, Y.; Fang, K. Job shop scheduling problem with a dual-gripper robot. IISE Trans. 2025, 1–16. [Google Scholar] [CrossRef]
  13. Ghadiri Nejad, M.; Kovács, G.; Vizvári, B.; Barenji, R.V. An optimization model for cyclic scheduling problem in flexible robotic cells. Int. J. Adv. Manuf. Technol. 2018, 95, 3863–3873. [Google Scholar] [CrossRef]
  14. Liu, S.Q.; Kozan, E. A hybrid metaheuristic algorithm to optimise a real-world robotic cell. Comput. Oper. Res. 2017, 84, 188–194. [Google Scholar] [CrossRef]
  15. Gultekin, H.; Dalgıç, Ö.O.; Akturk, M.S. Pure cycles in two-machine dual-gripper robotic cells. Robot. Comput.-Integr. Manuf. 2017, 48, 121–131. [Google Scholar] [CrossRef][Green Version]
  16. Wang, D.; Liu, S.; Zou, J.; Qiao, W.; Jin, S. Flexible robotic cell scheduling with graph neural network based deep reinforcement learning. J. Manuf. Syst. 2025, 78, 81–93. [Google Scholar] [CrossRef]
  17. Hofmann, T.; Wenzel, D. How to minimize cycle times of robot manufacturing systems. Optim. Eng. 2021, 22, 895–912. [Google Scholar] [CrossRef]
  18. Helmberg, C.; Hofmann, T.; Wenzel, D. Periodic event scheduling for automated production systems. INFORMS J. Comput. 2022, 34, 1291–1304. [Google Scholar] [CrossRef]
  19. Wang, T.; Zhang, Y.; Hu, X. A Q-learning based hyper-heuristic scheduling algorithm with multi-rule selection for sub-assembly in shipbuilding. Comput. Ind. Eng. 2024, 197, 110567. [Google Scholar] [CrossRef]
  20. Lee, K.J.; Lee, J.K.; Choi, S.Y. A spatial scheduling system and its application to shipbuilding: DAS-CURVE. Expert Syst. Appl. 1996, 10, 311–324. [Google Scholar] [CrossRef]
  21. Lozano-Perez, T. Spatial planning: A configuration space approach. IEEE Trans. Comput. 1983, 32, 108–120. [Google Scholar] [CrossRef]
  22. Koh, S.; Eom, C.; Jang, J.; Choi, Y. An improved spatial scheduling algorithm for block assembly shop in shipbuilding company. In Proceedings of the 2008 3rd International Conference on Innovative Computing Information and Control; IEEE: Washington, DC, USA, 2008; p. 253. [Google Scholar]
  23. Shin, J.G.; Kwon, O.H.; Ryu, C. Heuristic and metaheuristic spatial planning of assembly blocks with process schedules in an assembly shop using differential evolution. Prod. Plan. Control 2008, 19, 605–615. [Google Scholar] [CrossRef]
  24. Shang, Z.; Gu, J.; Ding, W.; Duodu, E.A. Spatial scheduling optimization algorithm for block assembly in shipbuilding. Math. Probl. Eng. 2017, 2017, 1923646. [Google Scholar] [CrossRef]
  25. Ge, Y.; Wang, A. Spatial scheduling for irregularly shaped blocks in shipbuilding. Comput. Ind. Eng. 2021, 152, 106985. [Google Scholar] [CrossRef]
  26. Kwon, B.; Lee, G.M. Spatial scheduling for large assembly blocks in shipbuilding. Comput. Ind. Eng. 2015, 89, 203–212. [Google Scholar] [CrossRef]
  27. Dixit, V.; Verma, P.; Raj, P.; Sharma, M. Resource and time criticality based block spatial scheduling in a shipyard under uncertainty. Int. J. Prod. Res. 2018, 56, 6993–7007. [Google Scholar] [CrossRef]
  28. Ge, Y.; Wang, A. Spatial scheduling strategy for irregular curved blocks based on the modified genetic ant colony algorithm (MGACA) in shipbuilding. Int. J. Prod. Res. 2018, 56, 3099–3115. [Google Scholar] [CrossRef]
  29. Hu, S.; Liu, T.; Wang, S.; Kao, Y.; Sun, X. A hybrid heuristic algorithm for ship block construction space scheduling problem. Discret. Dyn. Nat. Soc. 2015, 2015, 841637. [Google Scholar] [CrossRef]
  30. Shen, Y.; Gao, Y.; Yuan, M.; Sun, H.; Guo, Z. Multi-objective immune optimization of path planning for ship welding robot. Electronics 2023, 12, 2040. [Google Scholar] [CrossRef]
  31. Meng, C.; Feng, Z.; Zhao, D.; Li, X.; Yu, J.; Yang, L. A Fuzzy Scheduling Method for Pipeline Processing in Shipyards Incorporating the Black Widow Optimization Algorithm. Appl. Sci. 2024, 14, 5639. [Google Scholar] [CrossRef]
  32. Han, Y.; Gong, D.; Li, J.; Zhang, Y. Solving the blocking flow shop scheduling problem with makespan using a modified fruit fly optimisation algorithm. Int. J. Prod. Res. 2016, 54, 6782–6797. [Google Scholar] [CrossRef]
  33. Wang, C.; Li, S. Hybrid fruit fly optimization algorithm for solving multi-compartment vehicle routing problem in intelligent logistics. Adv. Prod. Eng. Manag. 2018, 13, 466–478. [Google Scholar] [CrossRef]
  34. Shang, Z.; Chen, Y.; Mumtaz, J. An Improved Fruit Fly Optimization Algorithm for Multi-Objective Scheduling in Hybrid Flow Shops. Eng. Proc. 2025, 111, 37. [Google Scholar]
  35. Wang, L.; Zheng, X.l. A knowledge-guided multi-objective fruit fly optimization algorithm for the multi-skill resource constrained project scheduling problem. Swarm Evol. Comput. 2018, 38, 54–63. [Google Scholar] [CrossRef]
  36. Ma, Q.; He, Y.; Zhou, F. Multi-objective fruit fly optimization algorithm for test point selection. In 2016 IEEE Advanced Information Management, Communicates, Electronic and Automation Control Conference (IMCEC); IEEE: New York, NY, USA, 2016; pp. 272–276. [Google Scholar]
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Article Metrics

Citations

Article Access Statistics

Multiple requests from the same IP address are counted as one view.
