Critical Risk Factors Affecting Time and Cost in Highway Construction: A Global Systematic Literature Review
Abstract
1. Introduction
Research Objectives
- To identify and recommend a comprehensive classification system for risk factors associated with highway construction projects.
- To identify the key risk factors associated with highway construction projects.
- To determine the most critical risks affecting road/highway construction project cost and time performance.

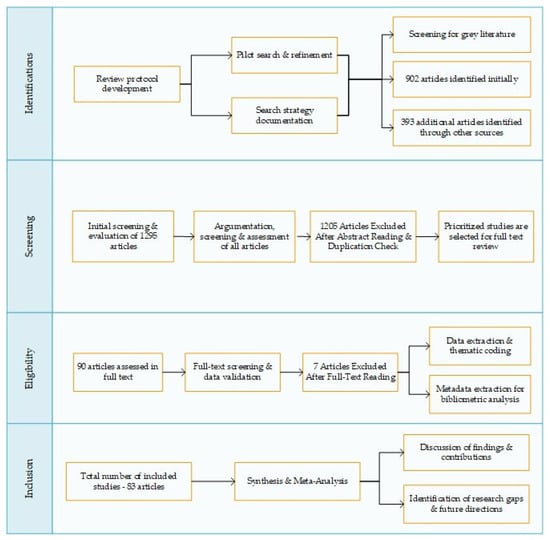

2. Fundamentals of the Systematic Literature Review
2.1. Description of the Systematic Literature Review
2.2. Methodology
2.2.1. Methodology of SLR
- (1)
- Title/Abstract Screening: Initial screening of studies to identify relevance based on predefined criteria.
- (2)
- Full-Text Screening: Detailed review and synthesis of studies that met the inclusion criteria during the title/abstract screening phase.
- (1)
- Research Questions: Clearly defined questions guiding the review process.
- (2)
- Eligibility Criteria: Development of inclusion and exclusion criteria to ensure the relevance and quality of selected studies.
- (3)
- Search Terms and Sources: Identification of relevant keywords, synonyms, and databases to comprehensively capture the literature.
- (4)
- Scope of the Review: Conceptual definitions and boundaries to ensure focus and coherence.
Search Question
- What is the evidence supporting the use of risks management/optimisation (framework) in highway construction?
- What is the evidence supporting the use of risk optimization methods for highway construction?
2.2.2. Methodology of Identifying the Most Common Risk Factors in Highway Projects
2.2.3. Methodology for Producing the Recommended Classification Standard
3. Results and Analysis of Key Risk Factors
3.1. Classification of Highway Construction Risks
3.1.1. Challenges in Risk Classification Across Literature
3.1.2. Recommended Classification
3.1.3. Identification of Critical Risks Associated with Time and Cost for Highway Construction
3.2. Key Risk Factors (Frequency Analysis)
4. Implications and Relevance of Findings
5. Limitations
6. Conclusions
Supplementary Materials
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Acknowledgments
Conflicts of Interest
References
- Datta, S. The impact of improved highways on Indian firms. J. Dev. Econ. 2012, 99, 46–57. [Google Scholar] [CrossRef]
- Ghani, E.; Grover, A.; Kerr, W. Highway to Success: The Impact of the Golden Quadrilateral Project for the Location and Performance of Indian Manufacturing. Econ. J. 2016, 126, 317–357. [Google Scholar] [CrossRef]
- Pérez-Valbuena, G.J. La Infraestructura del Transporte vial y la Movilización de Carga en Colombia; Banco de la República: Bogotá, Colombia, 2005. [Google Scholar]
- Anderson, S.; Molenaar, K.; Schexnayder, C.; Transportation Research Board; National Cooperative Highway Research Program; Transportation Research Board. Guidebook on Risk Analysis Tools and Management Practices to Control Transportation Project Costs; NCHRP Report-658; National Academies Press: Washington, DC, USA, 2010; ISBN 978-0-309-28059-4. [Google Scholar]
- FHWA; Titus-Glover, L.; Darter, M.I.; Quintus, H.V. Impact of Environmental Factors on Pavement Performance in the Absence of Heavy Loads; Final Report FHWA-HRT-16-084; Infrastructure Research and Development Federal Highway Administration: McLean, VI, USA, 2019.
- Paterson, W.D.O. Road Deterioration and Maintenance Effects: Models for Planning and Management. Available online: https://documents1.worldbank.org/curated/en/222951468765265396/pdf/multi-page.pdf (accessed on 19 August 2025).
- Llopis-Castelló, D.; García-Segura, T.; Montalbán-Domingo, L.; Sanz-Benlloch, A.; Pellicer, E. Influence of Pavement Structure, Traffic, and Weather on Urban Flexible Pavement Deterioration. Sustainability 2020, 12, 9717. [Google Scholar] [CrossRef]
- Highway Public-Private Partnerships. More Rigorous Up-Front Analysis Could Better Secure Potential Benefits and Protect the Public Interest, GAO-08-44; GAO: Washington, DC, USA, 2008.
- Mallett, W.J. Public-private partnerships in highway and transit infrastructure provision. Highw. Constr. Manag. Maint. 2013, 149–177. Available online: https://www.everycrsreport.com/reports/RL34567.html (accessed on 24 August 2025).
- Yang, D.Y.; Frangopol, D.M. Life-cycle management of deteriorating civil infrastructure considering resilience to lifetime hazards: A general approach based on renewal-reward processes. Reliab. Eng. Syst. Saf. 2019, 183, 197–212. [Google Scholar] [CrossRef]
- Edwina Policies to Extend the Life of Road Assets. Available online: https://www.itf-oecd.org/policies-extend-life-road-assets (accessed on 19 August 2025).
- Vishwakarma, A.; Thakur, A.; Singh, S.; Salunkhe, A. Patil Institute of Engineering and Technology, Pimpri, Pune-411018 Risk Assessment in Construction of Highway Project. Int. J. Eng. Res. Technol. (IJERT) 2016, V5, IJERTV5IS020515. Available online: https://www.ijert.org/research/risk-assessment-in-construction-of-highway-project-IJERTV5IS020515.pdf (accessed on 24 August 2025).
- Birnie, J.; Yates, A. Cost prediction using decision/risk analysis methodologies. Constr. Manag. Econ. 1991, 9, 171–186. [Google Scholar] [CrossRef]
- Zwikael, O.; Ahn, M. The Effectiveness of Risk Management: An Analysis of Project Risk Planning Across Industries and Countries. Risk Anal. 2011, 31, 25–37. [Google Scholar] [CrossRef]
- Ball, D.J. The Evolution of Risk Assessment and Risk Management: A Background to The Development of Risk Philosophy. Arboric. J. 2007, 30, 105–112. [Google Scholar] [CrossRef]
- ISO 31000:2018; Risk Management—Guidelines. ISO: Geneva, Switzerland, 2018. Available online: https://www.iso.org/standard/65694.html (accessed on 20 August 2025).
- Gough, D.; Oliver, S.; Thomas, J. An introduction to systematic reviews (2nd Edition). Psychol. Teach. Rev. 2017, 23, 95–96. [Google Scholar] [CrossRef]
- Moher, D.; Liberati, A.; Tetzlaff, J.; Altman, D.G. The PRISMA Group Preferred Reporting Items for Systematic Reviews and Meta-Analyses: The PRISMA Statement. PLoS Med. 2009, 6, e1000097. [Google Scholar] [CrossRef]
- Thomas, J.; Graziosi, S.; Brunton, J.; Ghouze, Z.; O’Driscoll, P.; Bond, M.; Koryakina, A. EPPI-Reviewer: Advanced software for systematic reviews. Maps Evid. Synth. 2023. [Google Scholar]
- El-Sayegh, S.M. Risk assessment and allocation in the UAE construction industry. Int. J. Proj. Manag. 2008, 26, 431–438. [Google Scholar] [CrossRef]
- Hasina, P.T.; Fazil, P. Risk Management in Commercial Building Construction using PESTEL and SWOT Analysis. Int. J. Eng. Res. Technol. (IJERT) 2021, 10, 812–816. [Google Scholar]
- Infrastructure Risk Group. Managing Cost Risk and Uncertainty in Infrastructure Projects. Available online: https://www.ice.org.uk/download-centre/managing-cost-risk-and-uncertainty-in-infrastructure-projects (accessed on 23 August 2025).
- Nguyen, A.; Mollik, A.; Chih, Y.-Y. Managing Critical Risks Affecting the Financial Viability of Public–Private Partnership Projects: Case Study of Toll Road Projects in Vietnam. J. Constr. Eng. Manag. 2018, 144, 05018014. [Google Scholar] [CrossRef]
- Valunjkar, S. Identification of risks in Highway Projects and their Mitigation Strategies. In Proceedings of the ICACSE-2020, GCE KARAD and REC, Azamgarh, India, 24–25 April 2020. [Google Scholar]
- Heravi, G.; Hajihosseini, Z. Risk Allocation in Public–Private Partnership Infrastructure Projects in Developing Countries: Case Study of the Tehran–Chalus Toll Road. J. Infrastruct. Syst. 2012, 18, 210–217. [Google Scholar] [CrossRef]
- Msomba, Z.; Samson, M.; Ramadhan, S. Mlinga Identification of Crucial Risks Categories in Construction Projects in Tanzania. Int. J. Eng. Res. Technol. (IJERT) 2018, V7, IJERTV7IS020062. [Google Scholar] [CrossRef]
- Azhagarsamy, S.; Dantuluri, V.; Anudeep, S.; Anuj, V.; Suriyakumaran, P.; Santhosheswar, M. Risk assessment in construction of highway project. Int. J. Innov. Res. Technol. 2021, 8, 30–37. [Google Scholar]
- Sharaf, M.; Abdelwahab, H. Analysis of Risk Factors for Highway Construction Projects in Egypt. J. Civ. Eng. Archit. 2015, 9, 526–533. [Google Scholar] [CrossRef]
- Ogbu, C.P.; Adindu, C.C. Direct risk factors and cost performance of road projects in developing countries: Contractors’ perspective. J. Eng. Des. Technol. 2019, 18, 326–342. [Google Scholar] [CrossRef]
- Zhi, H. Risk management for overseas construction projects. Int. J. Proj. Manag. 1995, 13, 231–237. [Google Scholar] [CrossRef]
- Tah, J.H.M.; Carr, V. A proposal for construction project risk assessment using fuzzy logic. Constr. Manag. Econ. 2000, 18, 491–500. [Google Scholar] [CrossRef]
- Aleshin, A. Risk management of international projects in Russia. Int. J. Proj. Manag. 2001, 19, 207–222. [Google Scholar] [CrossRef]
- El-Sayegh Sameh, M.; Mansour Mahmoud, H. Risk Assessment and Allocation in Highway Construction Projects in the UAE. J. Manag. Eng. 2015, 31, 04015004. [Google Scholar] [CrossRef]
- Schramek, A.; McCormack, T.; Est, P. Review Force Majeure Clauses Before Storms Hit. 2021. Available online: https://www.nortonrosefulbright.com/en-419/knowledge/publications/ce1962e4/review-force-majeure-clauses-before-storms-hit (accessed on 24 August 2025).
- Moore, J.P.V. Jackson Weathering the Storm—Part 3: Force Majeure in Construction Contracts. Available online: https://www.texasconstructionlawblog.com/2025/05/weathering-the-storm-part-3-force-majeure-in-construction-contracts/ (accessed on 24 August 2025).
- De Leon, G.P.; Darrell, D. Force Majeure Weather Modeling. In Proceedings of the PMICOS 2010 Conference, Calgary, AB, Canada, 2–5 May 2010. [Google Scholar]
- Lovells, H. Managing Extreme Weather-Related Delay and Disruption Claims on Projects. Available online: https://www.hoganlovells.com/en/publications/managing-extreme-weatherrelated-delay-and-disruption-claims-on-projects?utm_source=chatgpt.com (accessed on 24 August 2025).
- Mastt. Everything to Know About Force Majeure Risk. Available online: https://www.mastt.com/risks/force-majeure (accessed on 24 August 2025).
- Rivera, L.; Baguec, H.; Yeom, C. A Study on Causes of Delay in Road Construction Projects across 25 Developing Countries. Infrastructures 2020, 5, 84. [Google Scholar] [CrossRef]
- Mashal, Q. Delay Analysis of Road Construction Projects in Afghanistan. IJRAR 2013, 10, 59–68. [Google Scholar]
- Creedy, G.D.; Skitmore, M.; Wong, J.K.W. Evaluation of Risk Factors Leading to Cost Overrun in Delivery of Highway Construction Projects. J. Constr. Eng. Manag. 2010, 136, 528–537. [Google Scholar] [CrossRef]
- Hasan, R.; Suliman, S.M.A.; Malki, Y.A. An Investigation into the Delays in Road Projects in Bahrain. Int. J. Res. Eng. Sci. (IJRES) 2014, 2, 28–41. [Google Scholar]
- Zayed, T.; Amer, M.; Pan, J. Assessing risk and uncertainty inherent in Chinese highway projects using AHP. Int. J. Proj. Manag. 2008, 26, 408–419. [Google Scholar] [CrossRef]
- Tian, J.; Li, Z.; Xi, J. Safety risk Assessment for Construction of Highway on Plateau Mountainous. IOP Conf. Ser. Earth Environ. Sci. 2021, 643, 012188. [Google Scholar] [CrossRef]
- Ramirez, D.; Rivera, L.; Orobio, A.; Cuadros, J. Evaluation of the impact of schedule risks in a road infrastructure project. Rev. Espac. 2018, 39, 14–32. [Google Scholar]
- Aziz, R.F.; Abdel-Hakam, A.A. Exploring delay causes of road construction projects in Egypt. Alex. Eng. J. 2016, 55, 1515–1539. [Google Scholar] [CrossRef]
- Abu El-Maaty, A.E.; El-Kholy, A.M.; Akal, A.Y. Modeling schedule overrun and cost escalation percentages of highway projects using fuzzy approach. Eng. Constr. Archit. Manag. 2017, 24, 809–827. [Google Scholar] [CrossRef]
- Khodeir, L.M.; Nabawy, M. Identifying key risks in infrastructure projects—Case study of Cairo Festival City project in Egypt. Ain Shams Eng. J. 2019, 10, 613–621. [Google Scholar] [CrossRef]
- El-Kholy, A.M. Exploring the best ANN model based on four paradigms to predict delay and cost overrun percentages of highway projects. Int. J. Constr. Manag. 2021, 21, 694–712. [Google Scholar] [CrossRef]
- Issa, U.H.; Marouf, K.G.; Faheem, H. Analysis of risk factors affecting the main execution activities of roadways construction projects. J. King Saud Univ. Eng. Sci. 2023, 35, 372–383. [Google Scholar] [CrossRef]
- Wubet, W.A.; Burrow, M.; Ghataora, G. Risks affecting the performance of Ethiopian domestic road construction contractors. Int. J. Constr. Manag. 2023, 23, 639–647. [Google Scholar] [CrossRef]
- Carbonara, N.; Costantino, N.; Gunnigan, L.; Pellegrino, R. Risk Management in Motorway PPP Projects: Empirical-based Guidelines. Transp. Rev. 2015, 35, 162–182. [Google Scholar] [CrossRef]
- Antoniou, F. Delay Risk Assessment Models for Road Projects. Systems 2021, 9, 70. [Google Scholar] [CrossRef]
- Patil, D.-S. Causes of Delay in Indian Transportation Infrastructure Projects. Int. J. Res. Eng. Technol. 2013, 2, 71–80. [Google Scholar] [CrossRef]
- Pathan, E.R. Risk Assessment of BOT Road Projects. J. Mech. Civ. Eng. 2013, 5, 40–59. [Google Scholar] [CrossRef]
- Katkar, M.B.; Khandekar, S.D. Study of risk management for National Highway Project. Int. J. Eng. Res. Technol. 2015, 2, 2146–2152. [Google Scholar]
- Honrao, Y.; Desai, D.B. Study of Delay in Execution of Infrastructure Projects—Highway Construction. Int. J. Sci. Res. Publ. 2015, 5, 1–8. [Google Scholar]
- Makam, K.; Chappidi, H. Time and Cost Overrun Analysis of Highway Projects; Lambert Academic Publishing: Saarbrücken, Germany, 2015; ISBN 978-3-659-75192-9. [Google Scholar]
- Vasishta, N.; Chandra, D.S.; Asadi, S. Analysis of Risk Assessment in Construction of Highway Projects Using Relative Importance Index Method. Int. J. Mech. Eng. Technol. 2018, 9, 1–6. [Google Scholar]
- Thombare, M.K.; Ambre, H. Risk Management in BOT PNG Toll Plaza. IRJET 2019, 6, 6324–6329. Available online: https://www.irjet.net/archives/V6/i5/IRJET-V6I5877.pdf (accessed on 24 August 2025).
- Rajput, B.L. Risk Factors Causing Cost Overrun in Highway Construction Projects; Social Science Research Network: Rochester, NY, USA, 2020. [Google Scholar]
- Danisworo, B.; Latief, Y. Estimation model of Jakarta MRT phase 1 project cost overrun for the risk based next phase project funding purpose. IOP Conf. Ser. Earth Environ. Sci. 2019, 258, 012049. [Google Scholar] [CrossRef]
- Thapanont, P.; Santi, C.; Pruethipong, X. Causes of delay on highway construction projects in Thailand. MATEC Web Conf. 2018, 192, 02014. [Google Scholar] [CrossRef]
- Mousavi, S.M.; Tavakkoli-Moghaddam, R.; Azaron, A.; Mojtahedi, S.M.H.; Hashemi, H. Risk assessment for highway projects using jackknife technique. Expert Syst. Appl. 2011, 38, 5514–5524. [Google Scholar] [CrossRef]
- Ghorbani, A.; Ravanshadnia, M.; Nobakht, M.B. A Survey of Risks in Public Private Partnership Highway Projects in Iran. In Proceedings of the ICCREM 2014, Kunming, China, 18 November 2014; American Society of Civil Engineers: Reston, VI, USA; pp. 482–492. [Google Scholar] [CrossRef]
- Jahanger, Q.K. Important Causes of Delay in Construction Projects in Baghdad City. Aust. J. Basic Appl. Sci. 2013, 7, 14–23. [Google Scholar]
- Al-Hazim, N.; Abusalem, Z. Delay and cost overrun in road construction projects in Jordan. Int. J. Eng. Technol. 2015, 4, 288. [Google Scholar] [CrossRef]
- Atibu Seboru, M. An Investigation into Factors Causing Delays in Road Construction Projects in Kenya. Am. J. Civ. Eng. 2015, 3, 51. [Google Scholar] [CrossRef]
- Isah, M.A.; Kim, B.-S. Assessment of Risk Impact on Road Project Using Deep Neural Network. KSCE J. Civ. Eng. 2022, 26, 1014–1023. [Google Scholar] [CrossRef]
- Alfakhri, A.Y.Y.; Ismail, A.; Khoiry, M.A.; Arhad, I.; Irtema, H.I.M. A Conceptual Model of Delay Factors Affecting Road Construction Projects in Libya. J. Eng. Sci. Technol. 2017, 12, 3286–3298. [Google Scholar]
- Kamanga, M.J.; v d M Steyn, W.J. Causes of delay in road construction projects in Malawi. J. S. Afr. Inst. Civ. Eng. 2013, 55, 79–85. [Google Scholar]
- Mohamed Ghazali, F.E. Operational Risks for Highway Projects in Malaysia. Proc. World Acad. Sci. Eng. Technol. 2009, 41, 364–367. [Google Scholar]
- Wafa, S.M.F.; Singh, B. Delays in Road Construction Projects in the State of Perak. Constr. Manag. Transp. 2016, 2, 53–66. [Google Scholar]
- Karunakaran, S.; Ramli, M.Z.; Malek, M.A.; Musir, A.A.; Imran, N.F.; Fuad, N.F.S.M.; Zawawi, M.H.; Zainal, M.Z. Causes of Delay on Highway Construction Project in Klang Valley; AIP Publishing LLC.: Ho Chi Minh, Vietnam, 2018; p. 020242. [Google Scholar] [CrossRef]
- Razi, P.Z.; Ali, M.I.; Ramli, N.I. Ahp-Based Analysis of the Risk Assessment Delay Case Study of Public Road Construction Project: An Empirical Study. J. Eng. Sci. Technol. 2019, 14, 875–891. [Google Scholar]
- Manavazhi, M.R.; Adhikari, D.K. Material and equipment procurement delays in highway projects in Nepal. Int. J. Proj. Manag. 2002, 20, 627–632. [Google Scholar] [CrossRef]
- GaiN, H. Impact of Risk Management Practice on Success of Road Construction Project. Smart J. 2021, 7, 3467–3475. [Google Scholar] [CrossRef]
- Chileshe, N.; Awotunde, G. An Evaluation of Risk Impacting Highway and Road Construction Projects in Nigeria. In Proceedings of the 8th International Conference on Construction and Real Estates Management (ICCREM 2010) ‘Leading Sustainable Development through Construction and Real Estates Management’, Brisbane, Australia, 1–3 December 2010. [Google Scholar] [CrossRef]
- Ekung, S.; Adeniran, L.; Adu, E. Theoretical Risk Identification Within the Nigeria East- West Coastal Highway Project. Civ. Eng. Urban Plan. 2015, 2, 1–11. [Google Scholar]
- Fabi, J.K.; Awolesi, J.A.B. A Study of Risk Management Practice of Highway Projects in Nigeria. J. Econ. Sustain. Dev. 2015, 6, 171. [Google Scholar]
- Pantelidis, L. A critical review of highway slope instability risk assessment systems. Bull. Eng. Geol. Environ. 2011, 70, 395–400. [Google Scholar] [CrossRef]
- Mahamid, I. Common risks affecting time overrun in road construction projects in Palestine: Contractors’ perspective. Australas. J. Constr. Econ. Build. 2013, 13, 45–53. [Google Scholar] [CrossRef]
- Cruz, C.O.; Marques, R.C. Risk-Sharing in Highway Concessions: Contractual Diversity in Portugal. J. Prof. Issues Eng. Educ. Pract. 2013, 139, 99–108. [Google Scholar] [CrossRef]
- Emam, H.; Farrell, P.; Abdelaal, M. Causes of Delay on Large Infrastructure Projects in Qatar. In Proceedings of the 31st Annual ARCOM Conference, Lincoln, UK, 7–9 September 2015. [Google Scholar] [CrossRef]
- Elawi, G.S.A.; Algahtany, M.; Kashiwagi, D. Owners’ Perspective of Factors Contributing to Project Delay: Case Studies of Road and Bridge Projects in Saudi Arabia. Procedia Eng. 2016, 145, 1402–1409. [Google Scholar] [CrossRef]
- Andrić, J.M.; Wang, J.; Zou, P.X.W.; Zhang, J.; Zhong, R. Fuzzy Logic–Based Method for Risk Assessment of Belt and Road Infrastructure Projects. J. Constr. Eng. Manag. 2019, 145, 04019082. [Google Scholar] [CrossRef]
- Perera, B.A.K.S. Risk Management in Road Construction: The Case of Sri Lanka. Int. J. Strateg. Prop. Manag. 2009, 13, 87–102. [Google Scholar] [CrossRef]
- Karaman, A.E.; Köseoğlu, E. Risk Analysis Application in Highway Projects. Düzce Üniversitesi Bilim Ve Teknol. Derg. 2021, 9, 520–533. [Google Scholar] [CrossRef]
- Ayeni, R.; Udeaja, C.; Fong, D.; Chen, Y. A Risk Analysis of Construction Projects Delay Factors in the United Kingdom. In Proceedings of the International Conference on the Leadership and Management of Projects in the Digital Age (IC:LAMP), Eker, Bahrain, 27–28 November 2022. [Google Scholar]
- Chapman, P. Project delivery performance: Insights from English roads major schemes. Proj. Leadersh. Soc. 2024, 5, 100128. [Google Scholar] [CrossRef]
- Grunow, R.N. PERT and Its Application to Highway Management. In Highway Research Record; National Academies: Washington, DC, USA, 1963. [Google Scholar]
- Vidalis, S.M.; Najafi, F.T. Cost and time overruns in highway construction. In Proceedings of the Canadian Society for Civil Engineering—30th Annual Conference: 2002 Chellenges Ahead, CSCE 30th Annual Conference Proceedings, Montreal, QC, Canada, 5–8 June 2002; pp. 2799–2808. [Google Scholar]
- Molenaar, K.R. Programmatic Cost Risk Analysis for Highway Megaprojects. J. Constr. Eng. Manag. 2005, 131, 343–353. [Google Scholar] [CrossRef]
- Shiraki, N.; Shinozuka, M.; Moore, J.E.; Chang, S.E.; Kameda, H.; Tanaka, S. System Risk Curves: Probabilistic Performance Scenarios for Highway Networks Subject to Earthquake Damage. J. Infrastruct. Syst. 2007, 13, 43–54. [Google Scholar] [CrossRef]
- Gransberg, D.D.; Riemer, C. Impact of Inaccurate Engineer’s Estimated Quantities on Unit Price Contracts. J. Constr. Eng. Manag. 2009, 135, 1138–1145. [Google Scholar] [CrossRef]
- Li, Z.; Madanu, S. Highway Project Level Life-Cycle Benefit/Cost Analysis under Certainty, Risk, and Uncertainty: Methodology with Case Study. J. Transp. Eng. 2009, 135, 516–526. [Google Scholar] [CrossRef]
- Gharaibeh, N.G.; Shirazi, H. Risk-Based Model for Pricing Highway Infrastructure Warranties. J. Infrastruct. Syst. 2009, 15, 378–382. [Google Scholar] [CrossRef]
- Le, T.; Caldas, C.H.; Gibson, G.E.; Thole, M. Assessing Scope and Managing Risk in the Highway Project Development Process. J. Constr. Eng. Manag. 2009, 135, 900–910. [Google Scholar] [CrossRef]
- Bhargava, A.; Labi, S.; Sinha, K. Development of a Framework for Ex Post Facto Evaluation of Highway Project Costs in Indiana; FHWA/IN/JTRP-2009/33; Purdue University: West Lafayette, IN, USA, 2011; p. 3012. [Google Scholar]
- Strong, K.C.; Shane, J.S. Risk Mitigation Strategies for Operations and Maintenance Activities; Institute for Transportation Iowa State University: Ames, IA, USA, 2012; p. 152. [Google Scholar]
- Anastasopoulos, P.C.; Labi, S.; Bhargava, A.; Mannering, F.L. Empirical Assessment of the Likelihood and Duration of Highway Project Time Delays. J. Constr. Eng. Manag. 2012, 138, 390–398. [Google Scholar] [CrossRef]
- Tran, D.Q.; Molenaar, K.R. Impact of Risk on Design-Build Selection for Highway Design and Construction Projects. J. Manag. Eng. 2014, 30, 153–162. [Google Scholar] [CrossRef]
- Hanna, A.S.; Blasier, K.; Aoun, D.G. Risk Misallocation on Highway Construction Projects. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2015, 7, 04515002. [Google Scholar] [CrossRef]
- Tran, D.; Bypaneni, S. Impact of Correlation on Cost-Risk Analysis for Construction Highway Projects. In Proceedings of the Construction Research Congress 2016; San Juan, PR, USA, 24 May 2016; American Society of Civil Engineers: Reston, VI, USA; pp. 668–678. [Google Scholar] [CrossRef]
- Diab, M.F.; Varma, A.; Panthi, K. Modeling the Construction Risk Ratings to Estimate the Contingency in Highway Projects. J. Constr. Eng. Manag. 2017, 143, 04017041. [Google Scholar] [CrossRef]
- Bypaneni, S.P.K.; Tran, D.Q. Empirical Identification and Evaluation of Risk in Highway Project Delivery Methods. J. Manag. Eng. 2018, 34, 04018007. [Google Scholar] [CrossRef]
- Castro-Nova, I.; Gad, G.M.; Touran, A.; Cetin, B.; Gransberg, D.D. Evaluating the Influence of Differing Geotechnical Risk Perceptions on Design-Build Highway Projects. ASCE-ASME J. Risk Uncertain. Eng. Syst. Part A Civ. Eng. 2018, 4, 04018038. [Google Scholar] [CrossRef]
- Gaikwad, S.V.; Calahorra-Jimenez, M.; Molenaar, K.R.; Torres-Machi, C. Challenges in Engineering Estimates for Best Value Design–Build Highway Projects. J. Constr. Eng. Manag. 2021, 147, 04021065. [Google Scholar] [CrossRef]
- Tummalapudi, M.; Harper, C.M.; Taylor, T.R.B.; Waddle, S.; Catchings, R. Causes, Implications, and Strategies for Project Closeout Delays in Highway Construction. Transp. Res. Rec. J. Transp. Res. Board 2022, 2676, 479–490. [Google Scholar] [CrossRef]
- T I Lam, P. A sectoral review of risks associated with major infrastructure projects. Int. J. Proj. Manag. 1999, 17, 77–87. [Google Scholar] [CrossRef]
- Kaliba, C.; Muya, M.; Mumba, K. Cost escalation and schedule delays in road construction projects in Zambia. Int. J. Proj. Manag. 2009, 27, 522–531. [Google Scholar] [CrossRef]
- Ariyanto, I.N.; Purba, A. A Systematic Review and Analysis of Risk Assessment in Highway Construction Projects. Oper. Res. Eng. Sci. Theor. Appl. 2020, 3, 29–47. [Google Scholar] [CrossRef]
- Zhasmukhambetova, A.; Evdorides, H.; Davies, R.J. Integrating Risk Assessment and Scheduling in Highway Construction: A Systematic Review of Techniques, Challenges, and Hybrid Methodologies. Future Transp. 2025, 5, 85. [Google Scholar] [CrossRef]
- Page, M.J.; McKenzie, J.E.; Bossuyt, P.M.; Boutron, I.; Hoffmann, T.C.; Mulrow, C.D.; Shamseer, L.; Tetzlaff, J.M.; Akl, E.A.; Brennan, S.E.; et al. The PRISMA 2020 statement: An updated guideline for reporting systematic reviews. BMJ 2021, 372, n71. [Google Scholar] [CrossRef]

| Repeated Risk Factor | Reported Category | References | Proposed as the Standardised Category for This Risk Factor | Justification (for the “Standardised Category” Recommendation (or Not)) |
|---|---|---|---|---|
| 1. Weather (and Extreme Weather) | Construction-related | Construction Risk (Implementation Phase)—External Events—Infrastructure Risk Group [22], Nguyen et al. [23], Deshpande and Valunjkar [24] | Secondary (impact): Weather is an external cause, the construction impacts (delays, lost productivity, cost overruns, rework) happen afterward as consequences, not because of the construction process itself. | |
| Environmental | El-Sayegh and Mansour [33], Azhagarsamy et al. [27] | Yes (for Weather) | Ordinary/adverse weather is a climatic/environmental condition expected to impact site conditions/productivity. | |
| Force majeure | Heravi and Hajihosseini [25], Msomba et al. [26] Schramek and McCormack [34], Vogel and Moore [35], Ponce de Leon et al. [36] | Yes (for Extreme Weather) | In contractual and risk-management practice, extreme weather (e.g., record temperatures, rainfall and wind speeds are leading to wildfires, severe storms and floods) is treated as an event beyond the parties’ reasonable control, often a force-majeure trigger, because it exceeds the normal adverse weather conditions that baseline construction planning is expected to accommodate. (Hogan Lovells [37], Mastt [38]) | |
| 2. Force Majeure | Construction-related | Deshpande and Valunjkar [24] | Secondary (impact): Force majeure affects construction, but it is not caused by construction activities. | |
| Environmental | Hasina and Fazil [21] [24] | Some force majeure events (storms, floods) are environmental in nature, but not all e.g., war and terrorism | ||
| Force majeure—As a Category itself | Msomba et al. [26], Sharaf & Abdelwahab [28], Heravi and Hajihosseini [25] [28] | Yes | Multiple Academic Risk Management Studies, International standards classify force majeure as its own category of risk as it refers to extraordinary events (earthquakes, floods, wars, pandemics) beyond the control of any party. | |
| Safety/Incidents | Infrastructure Risk Group [22] | Secondary (impact) | ||
| Site | El-Sayegh and Mansour [33], Ogbu and Adindu [29] | Secondary (impact): Force majeure events may impact a site, but they are not site-specific risks, they are higher-level uncontrollable risks. | ||
| 3. Change in law/Change in laws and regulations | Political | El-Sayegh and Mansour [33] [2], Hasina & Fazil [21], Msomba et al. [26] Infrastructure Risk Group [22], Heravi and Hajihosseini [25] | Yes | The primary cause is government policy. Change in law is fundamentally a government or legislative action, it arises from policy decisions, legal reforms, or regulatory updates Multiple Academic Risk Management Studies, standard contract frameworks (FIDIC). |
| Construction-related | Azhagarsamy et al. [27] | Secondary (impact): delays, cost overruns | ||
| 4. Design changes/Design error/Defective design | Construction-related | Deshpande and Valunjkar [24], Nguyen at al. [23] | Secondary (impact): rework or delays | |
| Design | Hasina and Fazil [21], Msomba et al. [26], Sharaf and Abdelwahab [28], Ogbu and Adindu [29] | Yes | The terms design changes, design error, defective design all originate from design processes, e.g., incomplete surveys, inaccurate assumptions, or poor drafting. Multiple Academic Risk Management Studies. | |
| Technological | Hasina and Fazil [21] | Secondary (impact) | ||
| 5. Land acquisition | Political | Azhagarsamy et al. [27] | Yes | The acquisition process depends on government approvals, expropriation decisions, and administrative clearances. |
| Construction-related | Deshpande and Valunjkar [24] | Secondary (impact) | ||
| Legal | Heravi and Hajihosseini [25] | Secondary (impact) | ||
| Social | Hasina and Fazil [21] | Secondary (impact) | ||
| Schedule/Planning | Msomba et al. [26] | Secondary (impact) | ||
| Site | Sharaf & Abdelwahab [28] | Secondary (impact) | ||
| 6. Delays in expropriations | Political | Hasina and Fazil [21] | Yes | Expropriation is a government-led legal process where private land is taken for public use |
| Technical | El-Sayegh and Mansour [33] | Delays in expropriations stem from government/legal processes, not technical challenges e.g., engineering failures. | ||
| 7. Fire | Force majeure | Msomba et al. [26], Sharaf & Abdelwahab [28] | Yes | Major, uncontrollable fires |
| Safety/Incidents | Azhagarsamy et al. [27], Infrastructure Risk Group [22] | Yes | Fires caused by negligence or unsafe work practices belong in “Safety/Incidents” | |
| 8. Delay in payments | Economic | Deshpande & Valunjkar [24], Hasina & Fazil [21] | Economics relate to macro factors like inflation or currency rates | |
| Commercial/ Contractual | El-Sayegh and Mansour [33] | Describe related effects (e.g., disputes, poorly managed contracts) | ||
| Financial | Sharaf & Abdelwahab [28], Ogbu and Adindu [29], Azhagarsamy et al. [27] | Yes | Multiple Academic Risk Management Studies. This is fundamentally about money availability, cash flow problems, funding shortages, client/owner financial constraints/financial management. | |
| Management | Msomba et al. [26] | Describe related effects project oversight problems (e.g., admin inefficiency, scheduling delays) | ||
| 9. Inadequate site investigation | Construction-related | Deshpande and Valunjkar [24], Msomba et al. [26] | Deals with execution issues and on-site activities (delays, rework, congestion, labour problems) rather than the pre-construction survey stage. | |
| Environmental | El-Sayegh and Mansour [33] | Referring to pollution, ecological damage, regulatory compliance, climate effects, etc. e.g., Protected wetlands, site contamination may influence the investigation | ||
| Technical | Azhagarsamy et al. [27] | Covers design and engineering complexity or technological aspects, not about surveying or ground studies. | ||
| Contractor/Subcontractors | Hasina and Fazil [21] | Secondary consequences: performance issues or failures by parties might cause inadequate investigation | ||
| Site | El-Sayegh and Mansour [33], Ogbu and Adindu [29], Infrastructure Risk Group [22] | Yes | “Inadequate site investigation” is about missing or incomplete geotechnical/soil studies, that’s a site-level risk (directly tied to subsurface conditions) Multiple Academic Risk Management Studies. | |
| 10. Inflation | Economic | Infrastructure Risk Group [22], Sharaf and Abdelwahab [28], Hasina and Fazil [21] | Yes | Economic in nature, reflect a general rise in prices across the economy (macro-level). |
| Financial | Msomba et al. [26], Heravi and Hajihosseini [25], Azhagarsamy et al. [27] | Focuses more on project-specific cash flow, funding, and liquidity issues (e.g., delayed payments, insufficient project financing) | ||
| Operation & maintenance | Nguyen et al. [23] | Deals with long-term upkeep and lifecycle costs, not the root cause of inflation or market-wide price changes | ||
| 11. Delay in approvals | Political | Hasina and Fazil [21] | Yes | Approvals (permits, clearances, licenses) almost always depend on government agencies or regulatory bodies. Delays usually stem from bureaucracy, policy changes, or slow government processes. |
| Technical | El-Sayegh and Mansour [33] | Approval is not a technical issue (like design complexity or engineering). | ||
| Construction-related | Sharaf & Abdelwahab [28], Nguyen et al. [23] | covers execution issues on-site; approvals happen before or parallel to construction. | ||
| Schedule/ Planning | Deshpande and Valunjkar [24] | Secondary (impact): Delays affect the schedule, but the root cause is the political approval process. | ||
| Environmental | Infrastructure Risk Group [22], Hasina and Fazil [21] | Some approvals are environmental permits, but the delay itself is caused by government process. | ||
| 12. Poor performance of contractor | Construction-related | Deshpande and Valunjkar [24], Msomba et al. [26] | Covers execution risks like site delays etc. | |
| Schedule/Planning | Msomba et al. [26] | Secondary (impact): Poor performance impacts the schedule | ||
| Contractor/Subcontractors | Sharaf and Abdelwahab [28], Hasina & Fazil [21], Ogbu & Adindu [29] | Yes | Specifically addresses the competence, resources, and management of contractors. | |
| Organizational | Azhagarsamy et al. [27] | Refers to the project owner or overall management structure. | ||
| 13. Change of tax; Taxation risk; Changes in tax regulation | Political | Infrastructure Risk Group [22] | Yes | Tax changes are driven by government policy and regulation. |
| Economic | Sharaf and Abdelwahab [28], Hasina and Fazil [21] | Macro/strategic risk. Macro conditions such as recession, demand slump, inflation, policy or structural supply shock, war-driven shortages across many inputs. | ||
| 14. Commodity/material price escalation risk | Economic | Deshpande and Valunjkar [24], Hasina and Fazil [21] | Economic is macro/strategic risk such as recession, demand slump, inflation, policy or structural supply shock, war-driven shortages. | |
| Financial | Azhagarsamy et al. [27] | Yes | Commodity price (market) risk that might be driven by supply/demand shocks, logistics, foreign exchange, sanctions, etc. | |
| 15. Exchange rate fluctuations | Economic | Infrastructure Risk Group [22], Sharaf and Abdelwahab [28], Hasina and Fazil [21] | Exchange—rate swings are market-price movements, so financial market risk. | |
| Financial | Nguyen et al. [23] | Yes | Financial because it directly affects the movement and settlement of funds (financial/market risks that hit cash flows, valuations, and balance sheets, price moves in currency pairs) | |
| 16. Claims and disputes | Construction related | Sharaf and Abdelwahab [28] | It’s a contractual entitlement issue | |
| Commercial/Contractual | Msomba et al. [26], El-Sayegh and Mansour [33] | Yes | Claims and disputes are fundamentally about exercising or contesting contract rights/obligations (time, money, scope, variations, EOT, LDs, payment). | |
| Management | Deshpande and Valunjkar [24] | Management is usually a driver/mitigation issue (poor contract admin, weak change control), not the claim itself. |
| No. | Category | Risk Factors (Significant Examples—Not Exhaustive, Primary Category Recommended to Remove Historic Ambiguity) |
|---|---|---|
| 1 | Political | Political pressure/interference; War, terrorism or hostilities; Change of tax/taxation risk/changes in tax regulation; Protestor influence; Public inquiry; Government relations; Threat of war; Changes in Rules and Regulations; Changes in laws and policies affecting the project; Political instability of the government (unfavorable political environment); Delay in approvals: Delay or refusal of project approval and permit by government departments (excessive approval procedures); Outbreak of hostilities (wars, revolution, riots, and terrorism); Corrupt local government officials demand bribes or unjust rewards; High level of bureaucracy of the authority; Expropriation and nationalization of assets/facilities without reasonable compensation; Government’s improper intervention during construction; Poor relations with related government departments, Government restrictions on foreign companies (e.g., import/export restrictions, mandatory technology transfer, differential taxation of foreign firms, etc.); Termination of concession by government; Influential economic events; Sanction; Local citizens issue; Interference of local politicians; Delayed statutory clearances/Delays in obtaining NOCs (No Objection Certificates); Delay in environmental and forest clearance; Delay in land acquisition; Insufficient right of way. |
| 2 | Technical | Technical feasibility, Engineering capability, Quality and integrity of design; Insufficient technology/skills/techniques; Technical (Design): Inadequate design; Inadequate specification; Complexity of project; Misinterpretation of traffic data. |
| 3 | Construction related | Replacement of consultant; On site congestion; Defective design; Incompetent subcontractor; Unavailability of land; Improper construction methods; Unsafe working conditions; Unexpected Surface conditions; Access conditions; Differing site condition; Security problems; Unidentified utilities; Unrealistic time estimates by the contractor; Low productivity of personnel; Equipment and machines; Defective construction materials; Lack of project close supervision by the client; Conflicts; Defective work; Failure of work; Changing need; Rework; Project delay; Disputes between labours; Changing sequences in construction activity; Non availability of resources; Revision of design; Availability of camp for labours; Change in quantities of work; In Time work permissions for executing work; Safety of workers; Stoppage of work due to Medical outbreak; Unforeseen geological conditions; Approval delay in construction period; Unavailability of material and labour; Environmental compliance; Change in construction procedure; Delay in material procurement; Poor quality of material; Excessive labour and material movement; Lower work quality, Dewatering due to change in water table, Insufficient resource availability |
| 4 | Legal | Statutory non-compliance (statutory breaches); Litigation/arbitration; Enforceability, IP infringement, Data protection/privacy breaches where applicable including when a contract dispute escalates to litigation/arbitration. Note: it could be argued that all legal items are escalations within all the other Categories. However, within the highways construction industry these are classified as being “of risk to be escalated to the legal teams”, due to ease of categorisation by Risk Managers. In reality it can be argued that there should be no “legal” risk category as issues should be attributed to the other categories. |
| 5 | Environmental | Adverse weather, Incomplete environmental analysis; Historic/brownfield sites; Disposal of construction waste; Contaminated soils; Effect on wetlands; Climate effects; Permitting and approvals; Environmental and geotechnical: Environmental factors; Subsurface conditions; Geotechnical survey; Dewatering; In-accurate survey; Site Contamination; Perceived Environmental Impacts of Project; Adverse environmental impacts of the project; Pollution associated with construction activities (dust, harmful gases, noise, solid and liquid wastes, etc.); Strict environmental regulations and requirements; Poor environmental regulations and controls; Changes in environmental standards and permitting; Poor preliminary assessment and evaluation of environmental impacts of the project; Failure to obtain environmental approval; Natural disasters; Management of large construction waste; Pollution and safety rules; Forest clearance; Any natural obstructions. |
| 6 | Social | Criminal Acts; Cultural Differences; Bribes; Public opposition to the project (public objections, social grievances); Differences in social, cultural, and religious backgrounds; Insecurity and crime (theft, vandalism, and fraudulent practices); Strikes and labour disputes; Poor public relations with local contacts; Unfavourable social environment; Societal conflict and/or public unrest; Poor public decision-making process; Disturbances to public activities. |
| 7 | Economic | Inadequate cost planning; Cost overrun; Unavailability of funds; Inflation; Political changes; Economic crisis; Project-funding problems; Unpredicted changes in interest rates; Unfavourable economic situations in the country (instability of economic conditions); Market demand changes; Recession; Demand slump; Policy or structural supply shock; War-driven shortages across many inputs. |
| 8 | Financial | Inadequate project funding; Labour and material cost; Interest rate changes; Bankruptcy of major participants/Sponsor bankrupt; Time of payments; Advance payment; Project time extension; Delay from clients; Increment for staff benefits; Raw material prices/Unprecedented price in raw materials; Fluctuations in Estimated finance than expected; Delay in payments; Cash flow problems; Unavailability of critical resources in the local market; Change of input resource prices; Limited capital; Need for land appraisal; Financial problems due to environmental protection,; Change in value of granted lands due to inflation; Change in value of granted lands due to development; Financing cost–related risks: Insufficient equity contribution; Preferential debt unavailability; Exchange rate risk: Exchange rate fluctuations/Variation rate of exchange; Fluctuations in currency exchange and/or difficulty of convertibility; Inability to service debt; High compensation demands; Unsettled and lack of project funding; Change in material prices/material price escalation; Poor financial market or unavailability of financial instrument resulting in difficulty of financing (Financing availability & market liquidity risk). |
| 9 | Commercial/ Contractual | Ambiguities in contract formation; Project labour agreements; Claims and disputes/Inadequate claim administration; Contract Strategy: Unrealistic timelines; Ignored risks; Poorly tailored contract forms; Third-party liability; Conflict in contract documents. |
| 10 | Logistical | Logistical Disruption: Late procurement; Late manufacture; Disrupted transport/delivery; Security holdups, Insufficient/inadequate storage; Congestion; Inability to dispose of waste. |
| 11 | Management | Poor allocation of resources; Poor motivation; Lack of or insufficient managerial skills; Lack of risk management; Unsatisfactory conduct of status review meetings; Poor labour planning; Lack of decision making; Inadequate project planning resource; Project management risks: Lack of coordination/communication; Delays in preparation of submittals; Delays in the approvals of submittals; Inefficient dispute resolution; Untimely inspection and testing; Inadequate inspection and testing; Poor relationship between parties; Documents and process directed as per agreement for mitigation of risk; Project team discussions on risk; Use of WBS and project milestones to help identify project risks; Documented process for identifying project risks, Inefficient planning. |
| 12 | Schedule/Planning | Financial delays; Construction delays; Delay in material transportation; Delay in site possession; Delay of mobilization; Inefficient delivery method; Inappropriate contract awards; Poor contractor and supplier selection; Inadequate project planning; Inappropriate pricing; Length project development period; Inadequate contingency planning; Indecision; Poor estimation process/Improper estimation of time and cost. |
| 13 | Resources (Plants, Equipment, Materials) | Breakdown of plant; Unavailability of raw material required for plant; Poor equipment management & planning; Equipment quality; Equipment breakdown, Condition; Availability of Equipment; Storage; Maintenance; Mobilization; Material damage; Material storage. |
| 14 | Human resources | Labour accidents; Lack of specialized staff; Inexperienced staff; Lack of coordination; Unskilled labours and poor labour productivity; Low labour productivity; Labour availability; Inadequate (under and over) Recruitment. |
| 15 | Force majeure | Severe weather condition (according to contract law definition); Fire; Earthquake; Flood; Tornado; Hurricanes; War; Revolution; Natural disasters; Terrorism; Riots; Government actions or prohibitions; Strikes; Explosions. |
| 16 | Safety/Incidents | Safety and security; Poor safety procedures; Non availability/no use of safety equipment and tools at site; Death/injuries at site due to accidents; Non availability of proper medical facilities at site; Accidental: Damage to equipment’s; Labour injuries; Equipment and material fire and theft; Removal of structures; Shifting of utilities; HSE incident; Asset failure; Fire; Industrial action. |
| 17 | Design (Design and Scope Changes/Errors) | Design quality; Changes in scope of work/client; Inadequate survey data; Lack of experience of design team; Inaccurate quantity estimates by the design team; Unclear scope of work; Inaccurate assumption on technical data; Inadequate technical staffs; Design error and omission; Road alignment; Traffic flow; Alignment availability; Change in design; Scope vagueness; Shortage of information; Improper feasibility study; Complexity of project design; Design changes by owner or his agent during construction; Insufficient data collection and survey before design; Mistakes and delays in producing design documents; Misunderstanding of owner’s requirements by design engineer; Poor use of advanced engineering design software; Unclear and inadequate details in drawings; Incomplete project design; Defective or Incomplete design; Discrepancy between actual quantities and contract quantities; Incompetent supervision/poor project management; Corruption/unethical practices. |
| 18 | Technological | Emerging disruptive technologies; Obsolescence; Poor constructability; Complexity of design; Technology changes; Delay in design; Inadequate study and insufficient data before design; Unclear and inadequate details in design drawings and specifications; Unanticipated engineering and design changes. |
| 19 | Contractor/ Subcontractors | Subcontractor bankrupt; Subcontractor quality; Subcontractor delay; Frequent change of subcontractors; Poor performance of contractor/Inadequate contractor experience; Inappropriate construction methods; Incompetent project team; Ineffective project planning and scheduling; Poor communication and coordination between owner and consultant; Poor site management and supervision; Unreliable subcontractors; Inappropriate contractor’s policies; Poor financial control on site; Poor project planning and control; Lack of experience; Defective work/Reworks, Poor estimating. |
| 20 | Site/Site Environment and Location/Site Access & Conditions | Site facilities; Site security; Site mobilization; Existing traffic; Unexpected underground utilities; Archaeological finds; Unforeseen soil conditions; Inadequate safety measures; Feasibility of construction methods; Inadequate construction quality; Restrictive site conditions; Geo-technical risks/ground conditions; Frustrated site access; unexpected site costs; Slow mobilization, poor ground/water table; Building foundations, sewers, contamination, archaeology/unexploded ordnance; Wildlife and other environmental; Demolition problems; Inadequate site investigation; Diversion of existing traffic. |
| 21 | Organizational | Suboptimal decision processes; Invalid assumptions; Organization risk; Coordination risk/Poor coordination; Intense competition at tender stage; Efficiency of managers or supervisors; Lack of specified arbitrators; Change of supervisors; Improper distribution of roles and responsibility; Conflict between executives; Stakeholders disputes over changes; Contractor problem and inadequate experience. |
| 22 | Operation and maintenance | Operation cost overrun; Operator default; High maintenance costs; Underestimated maintenance frequency (premature deterioration); Government-requested change in output specifications; Tort liability. |
| 23 | Performance-related risks | Performance reliability; Not achieving required quality; Not meeting stakeholders’ expectations; Poor quality; Poor supervision; Excessive settlement; Damage, Site nuisance (noise, light, vibration); Systems integration problems. |
| 24 | Consultant-related risks | Lack of consultant experience in construction projects; Conflicts between consultant and design engineer; Delay in approving major changes in scope of work by consultant; Delay in performing inspection and testing; Inadequate project management assistance; Late in reviewing and approving design document; Poor communication and coordination between owner and contractor. |
| № | Author(s) | Year | Location | Method of Identifying Risks | Key Risk Factors |
|---|---|---|---|---|---|
| 1 | Rivera et al. [39] | 2020 | Across 25 developing countries | Data gathered from previous studies by qualitative perceptions collected from surveys. | The lack of experience of the construction manager, inadequate planning/scheduling, expropriation for the construction of the project, changes in the design, poor communication between construction parties, shortage of equipment, force majeure, contract modification, delays in execution of progress billing, shortage of construction materials, delayed payment to contractors, poor labour productivity. |
| 2 | Mashal and Mathur [40] | 2023 | Afghanistan | Literature review, Questionnaire survey | Delay in progress payment by owner, variations in quantities, lack of modern equipment, delay in approval of completed work by client, security (external related), poor communication and coordination with other parties, lack of material in market, change orders by owner during construction, corruption and bribery. |
| 3 | Creedy et al. [41] | 2010 | Australia (Queensland) | NGT, Multivariate linear regression analysis, Delphi techniques, | Design and scope change, Insufficient investigations and latent conditions, Deficient documentation, specification and design, Owner project management costs, Services relocation, Constructability, Price escalation, Right-of-way costs, Contractor risks, Environment. |
| 4 | Hasan et al. [42] | 2014 | Bahrain | Field survey, Questionnaire | Lack of planning, shortage of manpower and materials, suspension of work, budget availability and delay in decision making, lack of experience, Services and utilities. |
| 5 | Zayed et al. [43] | 2008 | China | Questionnaire survey | Political, financial, emerging technology and resource risks (shortage of skilled workers, availability of specialty equipment, and delays of materials supply). |
| 6 | Tian et al. [44] | 2021 | China | Field investigation, expert scoring/expert survey within a risk-matrix | Collapse (disaster risk), Risk of bridge lifting (project risk), Instability at tunnel portal excavation (project risk), Pressure of construction (social risk), Large-scale equipment management (management risk). Also, several High risks, including landslide, water damage, debris flow, falling from height in bridge works, bridge high-slope excavation, tunnel water-inrush, management system/personnel issues, and material transport constraints. |
| 7 | Ramírez et al. [45] | 2018 | Colombia | Risk Criticality Index, RFMEA), Expert surveys (Cronbach’s alpha and Spearman correlation), MCS, CSRAM, Case study model of actual road project | Delays in the delivery of material and equipment, Effect of social and cultural factors, Acquisition of land, Geological problems on site, Defective/incomplete design, Effect of rain on construction activities, Mismanagement and poor site supervision by the contractor, Subcontractor scheduling conflicts, Contractual problems, Inefficient planning and programming by the contractor. |
| 8 | Sharaf and Abdelwahab [28] | 2015 | Egypt | Questionnaire survey | Delay in making decisions, land acquisition and interference from the project owner, design change. |
| 9 | Aziz et al. [46] | 2016 | Egypt | Questionnaire survey | Owner’s financial problems, Shortages of equipment, Inadequate contractor experience (work), Shortage of construction materials, Equipment failure (breakdown), Design errors due to unfamiliarity with local conditions and environment, Soil investigation is the first step in decision of the design of road with traffic capacity, loads on road, number of layers of pavement, Poor subcontractor performance delays, Rework due to change of design or deviation order; Poor site management and supervision by the contractor. |
| 10 | El-Maaty et al. [47] | 2017 | Egypt | Questionnaire survey, Fuzzy logic approach, Regression Analysis | Schedule Overrun: Contractor’s technical staff is insufficient and ineligible to accomplish the project, difficulties in financing the project by the contractor, lack of equipment efficiency, shortage of equipment, shortage of construction materials. Cost Escalation: inadequate preparation of the project concerning planning and execution, inadequate planning for project costs and lack of cost follow-up, lack of communication between project parties, increase in construction material prices, Contractor’s failure to conduct a technical study before bidding. |
| 11 | Khodeir et al. [48] | 2019 | Egypt | Questionnaire survey | Incorrect Sewer location during construction, Delay in Material Approval, Late Delivery of Material to Site, Inefficient Quality control, Poorly Installed Sewers, Wrongly Installed Sewer size, Delivery Problems in Sewer pipe length, Technology changes, Unsuitable Soil Filled Around Sewers, Inadequate supervision system, Low subcontractor performance, Poor Water Insulation Application on Site, Shortage of construction equipment, Poor subcontractor’s performance, Shortage of construction materials. |
| 12 | El-Kholy [49] | 2019 | Egypt | Modular Neural Network Paradigm, MAPE | Core construction project risks: schedule risks, cost risk (cost overruns). |
| 13 | Issa et al. [50] | 2021 | Egypt | Field survey | Lack of pre-studies & shortage of project data/documents/details during design stage, Delay in applying the next layer of the road leads to erosion of the existing layer, Poor grading of the granular soil, Discontinuity or delay in crushed stones supply. |
| 14 | Wubet et al. [51] | 2021 | Ethiopia | Questionnaire survey, Relative Importance Index (RII), Statistical Analysis: ANOVA, Kendall’s W | Shortage of finance/cash flow problems, Inadequate planning, Lack of access to foreign currency, Delay in possession of the construction site (Right of Way), Frequent breakdown of equipment, Delay in delivery of material and equipment; Financial failure, Inflation, Delay in payments, Poor commitment and coordination within contractor teams. |
| 15 | Carbonara et al. [52] | 2015 | Europe-based (multi-country) | Delphi Survey, Multiple-Case Study (8 real motorway PPP projects in UK, Greece, Netherlands, and Belgium) | Demand/Usage Risk (the uncertainty in future traffic volume and usage levels, which heavily affects the revenue stream of PPP motorway projects), Cost overrun; Financial closure risk, Interest rate increase, Inflation, Debt servicing risk, Force majeure risks, Regulatory risks (e.g., changes in legislation). |
| 16 | Fani Antoniou [53] | 2021 | Greece | Two hypothetical projects | Weather conditions, late land acquisition, utility networks and traffic control. |
| 17 | Patil et al. [54] | 2013 | India | Questionnaires survey | Land Acquisition, Environmental Impact of the project, financial closure, Change orders by the client, Poor site management and supervision by contractor. |
| 18 | Pathan & Pimplikar [55] | 2013 | India | Case-study analysis, Quantification via cash-flow modelling | Interest-rate (PLR) fluctuation, Revenue inadequacy/traffic risk, Force-majeure shocks, Technical/scope change risks, Regulatory/third-party delays, Legal/arbitration risk, Policy/contract risks. |
| 19 | Katkar et al. [56] | 2015 | India | Expert opinion | Environmental Permission, Emotional Issue, Land Acquisition, Political, Quality, Time, Money, Machinery, Rebound development around road analysis, Labor, Natural Obstruction, Knowledge level of lead group. |
| 20 | Honrao et al. [57] | 2015 | India | Questionnaire survey, Statistical indices | Difficulties in obtaining work permits and land acquisition, utilities are unidentified or incorrectly located, external environment related delay causes (traffic diversion, hot weather effect on execution activities, scarcity of materials in the market), owner interference during execution, ineffective construction methods by contractor, delay in solving design problems (major change of design during construction by consultant, bad project cost estimation). |
| 21 | Makam and Rao [58] | 2015 | India | Questionnaire survey, Regression analysis using SPSS (version not reported in the original study), Data analysis based on 230 NHDP highway project reports | Land acquisition delays, shifting of utilities (water mains, electrical, and telephone lines), inadequate Detailed Project Reports (DPRs), contractual disputes and poor contract management, law and order issues in certain states, geological surprises and adverse weather, capacity constraints (labour, equipment, and materials). |
| 22 | Vishwakarma [12] | 2016 | India | Likert scale, RII | Funds/Money, Time/delay in project, Local disturbances (law & order), Uncertain land acquisition cost, Issues related to obtaining Railway permits, Issues related to obtaining Government permits, Construction in hilly region, Unanticipated damage during construction, Utilities not relocated on time, Heritage issues. |
| 23 | Vasishta [59] | 2018 | India (Andhra Pradesh region) | Questionnaire survey, RII Analysis | Lack of coordination, Selection of inappropriate equipment, Insufficient technology/skills/techniques, Lack of communication, Inadequate construction quality. |
| 24 | Thombare and Ambre [60] | 2019 | India | Questionnaire survey, Case study, Risk-analysis tools | Delay in approvals, change in law/policy, cost overrun, dispatch/traffic constraints (revenue shortfall), land acquisition & compensation issues, enforceability of contracts, construction schedule risk, financial closing risk. |
| 25 | Rajput et al. [61] | 2020 | India | Questionnaire survey | Improper planning, delay in land acquisition, delay in project approval and permits, delay in making progressive payments, inaccurate cost estimate, delay in inspections, corruption at different levels, price increase of materials, shortage of equipment, machinery and tools, shortage of skilled manpower, frequent breakdown of equipment, and difficulties in financing. |
| 26 | Deshpande and Valunjkar [24] | 2020 | India | Questionnaire survey, Fuzzy Logic Toolbox | Delay in land acquisition, needs requested by stakeholders, unavailability of land and funds, disputes and claims, construction delays, force majeure, cost overruns, delay in owners’ payment, delay in site possession. |
| 27 | Azhagarsamy et al. [27] | 2021 | India | Questionnaire survey, RII, SPSS, real case study. | Rework due to error in execution; Inadequate specification; Inadequate design; Diversion of existing traffic; Land acquisition; Inadequate site investigation; High compensation demands; Lack of risk management; Unskilled labour/poor labour productivity; Lower work quality. |
| 28 | Danisworo et al. [62] | 2018 | Indonesia (Jakarta) | Questionnaires survey, Interviews | The Contract Specifications explaining the Employer’s Requirement are not clear and detail, the duration of the Contract is not appropriate, Delay in utility relocation, Delay in land acquisition, Issue of interface design, Request changes to work methods/designs from clients/external parties, Delay payment, Changes to Central Government Regulations, Changes to Regional Regulations, Lack of preparation in estimated costs. |
| 29 | Thapanont et al. [63] | 2018 | Internationally, Thailand | Questionnaire survey, Interviews | Incomplete drawings, lack of equipment efficiency or financial status of contractors, delay in relocating existing infrastructure structures, less of project engineer experiences, and delay in relieving environmental impact. |
| 30 | Mousavi et al. [64] | 2011 | Iran (Tehran) | Highway project risk identification information (key project documents) | Changes in design, Delay of material supply, Lack of experience in inspection and forwarding, Defective design, errors and rework, Lack of attention to contract requirements, Unsuitable weather conditions, Inadequate specifications, Failure in transmitting data from preliminary design to final Design, International relations, Health, Safety and Environment (HSE) matters, Change in scope of work, Lack of experienced workers, Technical problems, Economical inflation, Delay in paying and receiving project’s invoices, Political factors change. |
| 31 | Heravi and Hajihosseini [25] | 2012 | Iran | Case study: Tehran-Chalus Toll Road project | Inaccurate prediction of rate of inflation can increase project costs, Political risk, problems with land acquisition and compensation were important in the construction stage, leading to a significant delay in site delivery as well as projects’ schedule. |
| 32 | Ghorbani et al. [65] | 2014 | Iran | Questionnaire survey | Inflation risk, limited capital, improper design, ‘inadequate study and insufficient data, change in the value of granted lands due to development, termination of concession by the Government and financial problems due to environmental protection. Financial risk as the most important risk for the construction of the highway PPP project in Iran. |
| 33 | Jahanger [66] [ | 2013 | Iraq (Baghdad) | Questionnaire survey | Mistakes, discrepancies in design documents, ineffective planning, and poor scheduling of the project by the contractor. |
| 34 | Al-Hazim and Salem [67] | 2015 | Jordan | Case-based analysis approach, Expert input, Percentage ranking | Terrain conditions (including difficult access, land acquisition issues, utility relocation delays, and lack of civil services), Weather conditions (extreme heat, rain, and seasonal disruptions), Variation orders (changes made after the project starts), Availability of labour (labour shortages or inefficiencies), Mistakes in design (leading to rework and scope changes). |
| 35 | Seboru [68] | 2015 | Kenya | Questionnaires survey | Payment by client, slow decision making and bureaucracy in client organization, inadequate planning and scheduling, and rain. |
| 36 | Isah and Kim [69] | 2022 | Korea | Assessment of Risk Impact on Road Project Using Deep Neural Network | Design (Changes in scope, Incomplete and omission in design, Inadequate specification, Financial and economic Inflation, Exchange rate fluctuation, Delay in payment by the client, Construction Technical and execution issues, Material delay, Shortage of technical and skilled labor on site, Politics and environment, Change of government laws and regulations, Delay in permission and approval Contract management, Delay in settling claims, Contract risk management by sub-contractor, Weather, Extreme weather condition. |
| 37 | Aboubaker et al. [70] | 2017 | Libya | Questionnaire survey, descriptive statistics (SPSS), EFA, Cronbach’s Alpha | Delays in the conversion and transfer of utility services by the competent authorities (such as power lines, water, etc.), difficulty in budget availability for the project, original contract duration is too short, delay in progress payments by the owner, effects of subsurface (underground) conditions. |
| 38 | Kamanga et al. [71] | 2013 | Malawi, South Africa, Botswana and Swaziland | Questionnaire survey | Shortage of fuel, Insufficient contractor cash-flow/difficulties in financing projects, Shortage of foreign currency for importation of materials and equipment, Slow payment procedures adopted by the client in making progress payments, Insufficient equipment, Delay in relocating utilities, Shortage of construction materials such as bitumen, cement and steel, Delay in paying compensations to land owners, Shortage of technical personnel, Delay in site mobilization. |
| 39 | Ghazali [72] | 2009 | Malaysia | Literature review, extensive interviews with key personnel | High: Initial toll-tariff decided by the government. Medium: Over-loaded freight transportation, Leakage of dangerous material/cargo on road surface, Traffic congestion, Change of road network. Low: Environmental pollution to water-supply quality, Flood/fog, Sudden increase in toll-tariff, Change of government policy, Poor road signs and delineator, Road side hazard, Inefficient road-safety device, Poor road surface. |
| 40 | Wafa and Singh [73] | 2010 | Malaysia (State of Perak) | Questionnaire survey, Collection of road project’s data | Lack of materials, lack of workers, change of design, financial problems and lack of machinery. |
| 41 | Karunakaran et al. [74] | 2019 | Malaysia (Klang Valley) | Pilot survey and Questionnaire survey | Improper planning, weather, poor site management, poor site investigation, underground utilities, land acquisition, accessibility problems at site, improper construction method, late payment for completed work progress, lack of experienced contractor, site accident (safety issues), machinery failure, late delivery of material to site, late salary to labour, lack of equipment. |
| 42 | Razi et al. [75] | 2019 | Malaysia (East Coast region of Malaysia) | Expert Interviews, Questionnaire survey, AHP, Sensitivity analysis | Technical: Unforeseen ground conditions, Existing utilities issue, Insufficient drawings and specification, Frequent design change. Natural hazards: Flood, Heavy rain, Heat wave. Economic and financial: Fund risk inflation risk. Contractual: Lack of contract clarity, Inappropriate contract, Improper estimation. Socio-politics: Land acquisition issue, Changes in government law and regulations, Changes in politics and environment. Organizational: Lack coordination between parties, Inadequate planning and scheduling in project team, Unclear job roles and responsibility. Resources: Shortage of material on site, Late delivery of material and equipment, Shortage of technical skill personnel, Shortage of workers. |
| 43 | Manavazhi et al. [76] | 2002 | Nepal | Survey method | Organizational weaknesses, suppliers’ defaults, governmental regulations, and transportation delays. |
| 44 | Hemant GAİN [77] | 2021 | Nepal | Questionnaire survey | Project Schedule Risk, Safety, Health, and Environmental Risks, Cost Overrun/Budget Risk, Financial and Economic Risk, Force Majeure Risk, Political, Legal, and Social Risks, Organizational Management Risk, Contractual Risks, Quality Standard Risks, Technical Design Risks. |
| 45 | Chileshe and Awotunde [78] | 2010 | Nigeria | Questionnaire survey, Likert scale, RII, TII | Top by likelihood of occurrence: Contaminated soil & unstable soil condition, Design changes & inaccurate design details, Defective material & material shortages. Top by degree of impact: Defective material & material shortage, Poor quality control & poor performance control, Design changes & inaccurate design details. |
| 46 | Ekung et al. [79] | 2015 | Nigeria (East-West Coastal Highway project) | Expert Validation, Survey, 3-point Likert scale, Risk Matrix | Government lack of political will, Change in government, Corruption and financial fraud, Insufficient design details, Incompetent design team, Ground Condition, Unstable market conditions, Flood/coastal surge risks, Exceptional Inclement Weather, Militant insurgency. |
| 47 | Fabi and Awolesi [80] | 2015 | Nigeria (Lagos State) | Questionnaire survey, Descriptive statistics (mean rankings), ANOVA, SPSS | Risks in the management process. Lack of accepted industry model for risk analysis, Human/organizational resistance (reluctance or inability to adopt modern risk management practices), Lack of dedicated resources (insufficient tools, training, and systems for managing risk), Prevalence of rule-of-thumb approaches (reliance on informal methods rather than structured techniques). |
| 48 | Ogbu and Adindu [29] | 2019 | Nigeria | Questionnaire survey | Safety and security, force majeure, geotechnical risks/ground conditions, payments delay/cash flow problems, change of input resource prices and interest rate changes/cost of funds, lack of experience, poor estimating, defective/incomplete design, incompetent supervision and corruption/unethical practices. |
| 49 | Pantelidis [81] | 2011 | Not specified | Literature Review, Critical Analysis | Insufficient consideration of geology and geomorphology, Neglect of climatic conditions, Limited focus on consequence categories, Questionable suitability of consequence factors. |
| 50 | Mahamid [82] | 2013 | Palestine | Questionnaire survey | Financial status of the contractors, payment delays by the owner, the political situation, segmentation of the West Bank, poor communication between construction parties, lack of equipment efficiency and high competition in bids. |
| 51 | Cruz and Marques [83] | 2013 | Portugal (Portuguese road concessions) | Case Study | Political interference, optimism bias in demand forecasts, and the absence of active regulators—factors lead to frequent renegotiations of contracts and substantial public compensations to concessionaires. The inability to manage increasing uncertainties in forecasts has prompted the government to adopt availability payment schemes to mitigate public losses. |
| 52 | Emam et al. [84] | 2015 | Qatar | Questionnaire survey | Long response times from utility agencies; major changes in design during construction; ineffective planning and scheduling; ineffective control of progress; and changes in the scope of projects. |
| 53 | Elawi et al. [85] | 2016 | Saudi Arabia | Real time quantitative performance analysis, Quantitative comparison | Land acquisition, contractor’ lack of expertise, re-designing, line services (haphazard underground utilities), Clashes with other Ministries, Design conflicts between owners, Variation in estimated quantities between designer and GC (General Contractor), Differences in opinions from the Ministry of Traffic, Deliberate delay in construction by the GC, Change of consultant during project execution. |
| 54 | Andrić et al. [86] | 2019 | Silk Road (China with Central Asia, India, Middle East, Western Asia and Europe) | Expert judgment, Fuzzy sets, Fuzzy logic, Fuzzy matrices | Delay in supplying materials, increases in material prices, poor quality of materials, delays in equipment delivery, increases in the costs of equipment use, and economic risk. |
| 55 | Perera et al. [87] | 2009 | Sri Lanka | Multiple case-study, semi-structured interviews, documentary and archival evidence, cross-case comparison | Defective design; Late approvals; Late handing over of the site; Tentative drawings; Unforeseen site ground conditions; Relations with neighbourhood (community issues); Public security and safety; Inflation; Scope change |
| 56 | Msomba et al. [26] | 2018 | Tanzania | Questionnaire survey | Inadequate project preparation (project planning), delayed payment by the client (inadequate funding), delayed compensation of land and properties, delayed reallocation of utilities (telecommunication and power lines), delayed approvals for various substantial claims and poor performance of contractor. |
| 57 | Karaman and Köseoğlu [88] | 2021 | Turkey | Questionnaire survey, Decision Matrix | Economic crisis, Embargo and war, Acceleration demand of project by employer or government, Labour force issues (inefficiency, poor workmanship), Slope flows (site risk), Falling from height and material fall. |
| 58 | El-Sayegh and Mansour [33] | 2015 | UAE | Questionnaire survey | Inefficient planning, unexpected underground utilities, quality and integrity of design, delays in the approvals of submittals, delays in expropriations, delays in obtaining no object certificates (NOCs) from authorities, poor coordination, inadequate safety measures, delay in payments, material, labour, and equipment resourcing. |
| 59 | Ayeni et al. [89] | 2023 | UK | Expert interviews, questionnaire survey—Likert scales, analysis in Excel/SPSS, RII | Client-related: delay in decision-making/order issuance; variation/changes in design; delay in revising/approving design documents. Consultant-related: delay in approval of drawings; delay in design preparation/late design revisions; frequent design changes or errors. Contractor-related: delay in providing utilities; construction mistakes/defects and rework; delay in subcontractor works. External: adverse weather; delays/issues with permissions & statutory approvals; changes in material types/specifications. |
| 60 | Chapman [90] | 2024 | UK | Secondary analysis of public evaluations (National Highways POPE and related sources) for 138 schemes; descriptive statistics | Inflation, poor oversight of the delivery of major road schemes, lack of data on performance and failure to aggregate data to identify the main trends or reasons for cost overruns and the lack of project management expertise and inhouse capability to be an intelligent customer, issues with risk management practices, methods of procurement and delivery capability. |
| 61 | Grunow [91] | 1963 | USA | PERT, CPA | Management-level uncertainties and scheduling risks: delays due to lack of manpower, right-of-way acquisition issues, bureaucratic approval delays, disruptions from changes in political leadership, inaccurate or uncertain time estimates for project activities. |
| 62 | Vidalis and Najafi [92] | 2002 | USA (Florida) | Review of completed FDOT highway projects, Expert interviews | Design issues (including incomplete or inaccurate designs), changed conditions (referring to unforeseen site or project scope changes during construction). |
| 63 | Molenaar [93] | 2005 | USA (Washington State) | CEVP (Cost Estimating Validation Process), Probability & Impact estimates, Monte Carlo Simulation, Sensitivity Analysis | Market conditions, ROW acquisition problems, Change in seismic criteria, Inadequate design/design uncertainty for interchanges, Geotechnical conditions, Local arterial improvements and access, Rail lines, Off- and on-site wetlands, ROW value and impact, Bridge foundations, Storm water treatment and/or quantities, Changes in permitting, Natural hazards, Traffic demand, Staging areas, NEPA/404 merger process, Environmental impact statement, Utility issues, Work window, Auxiliary lanes, WSDOT program management, Labor disruptions. |
| 64 | Shiraki et al. [94] | 2007 | USA (Los Angeles Highway network) | System Risk Curves, Probabilistic Seismic Hazard Analysis, MCS | Seismic risk (earthquakes can cause systemic disruption across highway network). |
| 65 | Gransberg and Riemer [95] | 2009 | USA (Oklahoma) | Historical project data of 462 completed ODOT highway projects, FHWA, Absolute error metrics | Inaccurate quantity estimates in engineer’s pre-bid documentation, which can lead to unbalanced bids by contractors, inefficiencies in pricing, increased cost exposure for both contractors and owners, manipulation of quantities to create hidden contingencies, distorting actual project costs. |
| 66 | Li and Madanu [96] | 2009 | USA (Indiana) | Indiana real data Case study, MCS, Beta probability distributions, Shackle’s model, Latin Hypercube stratified sampling | Uncertainty in construction, rehabilitation, and maintenance costs, variability in traffic growth rates, fluctuating discount rates. |
| 67 | Gharaibeh and Shirazi [97] | 2009 | USA | Risk-based modelling approach founded on Kaplan and Garrick’s theory | Risk of premature infrastructure failures in highway projects, which can lead to significant financial liabilities for contractors offering warranties. |
| 68 | Le et al. [98] | 2009 | USA | Quantitative Evaluation Mechanism (level of definition) | Poorly defined scope can lead to: increased project costs, schedule delays, quality issues. |
| 69 | Bhargava et al. [99] | 2011 | USA (Indiana) | Ex post facto analysis using historical data from INDOT projects, Statistical modelling, MCS, Multinomial logit models | Cost overruns. Factors contribute to the probability and magnitude of cost escalation: Project size, Work category (e.g., expansion, bridge, pavement), Area type (urban vs. rural), Highway classification (NHS vs. non-NHS), Time delays between project proposal, design, and letting, Contract type and geographic location. |
| 70 | Strong & Shane [100] | 2012 | USA (Iowa) | Survey Validation, Descriptive statistics, Likert scale | Top risks leading to crashes during mobile highway operations and maintenance: Improper traffic control systems near work zones, High speed limits on highways near mobile work zones. |
| 71 | Anastasopoulos et al. [101] | 2012 | USA (Indiana) | Analysed 1722 Indiana highway projects | Project cost (contract bid amount), project type, planned project duration, and the likelihood of adverse weather. |
| 72 | Tran & Molenaar [102] | 2014 | USA | Questionnaire survey | Scope risk, third-party and complexity risk, construction risk, utility and ROW, level of design and contract risk, management risk, regulation and railroad risk. |
| 73 | Hanna et al. [103] | 2015 | USA | Literature Review, Survey, Review of court cases and legal precedent related to each risk | Design adequacy (including incomplete or erroneous designs and constructability issues), specification interpretation, third-party delay, changed conditions (unforeseen site conditions, unsuitable subgrade material), claims process (inefficiencies and disputes due to unclear change order procedures). |
| 74 | Tran and Bypaneni [104] | 2016 | USA | Correlation coefficients, Simulation techniques | Cost Uncertainty. |
| 75 | Diab et al. [105] | 2017 | USA | Opinion survey, Questionnaire survey. | Late and erroneous surveys, inadequate constructability reviews, inexperienced project manager. |
| 76 | Bypaneni and Tran [106] | 2018 | USA | Expert feedback, analysed 274 real-world highway projects, Risk scoring, Cronbach’s alpha test, Correlation analysis | Delays in completing in railroad agreements, project complexity, uncertainty in geotechnical investigation, delays in a right-of-way (ROW) process, unexpected utility encounter, work-zone traffic control, challenges to obtaining environmental documentation, delays in delivery schedules. |
| 77 | Castro-Nova et al. [107] | 2018 | USA | Expert Survey Questionnaire | Landslides, Subsidence (subsurface voids), Contaminated material, Prediction of subsurface conditions due to inaccessible drilling locations, Sensitiveness of public considerations (parks, historic building, etc.), Karst formations, Slope instability. |
| 78 | Gaikwad et al. [108] | 2021 | USA | Review & analysis of bid dispersion and estimate accuracy from 305 D-B/BV highway projects, Interviews | Inaccuracy in engineering cost estimates, High bid dispersion among contractors (Innovation and differing scopes in design proposals, Varying risk appetites of design-build teams); Misalignment of best-value procurement with actual practice (risk of ineffective implementation of best-value principles). Three main root causes of bid dispersion and estimate inaccuracy: Ineffective communication of project goals to design-builders, Innovative and value engineering techniques not accounted for in estimates, Lack of a robust risk-based cost estimation program. |
| 79 | Tummalapudi et al. [109] | 2022 | USA | Questionnaire survey, Case studies | Difficulties in attaining the required documentation, claims and litigations, managing multiple funding sources, a lack of urgency from local utilities/entities, and the lack of sufficient DOT project staff. |
| 80 | Nguyen et al. [23] | 2018 | Vietnam | Quantitative survey, Qualitative semi structured interviews | Land Unavailability, Design Changes Required by Public Authority, Insufficient Traffic Volume, Toll Rates Are Too Low to Generate the Expected Return, Major Maintenance Required More Often Than Estimated, Inflation, Insufficient Equity Contribution, Interest Rate Risk. |
| 81 | Lam [110] | 1999 | Worldwide | Case studies | Changes by owner’s request, which includes unexpected external stakeholders’ involvement, extra road/bridge capacity request, adding wetland mitigation, forcing contractors to work at night, and any other extra work; Error in Right-of-Way, Land acquisition delay. |
| 82 | Kaliba et al. [111] | 2009 | Zambia | Literature review, Interviews, Questionnaire survey, Analysis of real project case data | Environmental, Equipment, Financial, Human Resource, Management, Material, Planning/Design, Regulatory/Administrative. |
| 83 | Ariyanto et al. [112] | 2020 | Study is based in Indonesia. Study is presented as a systematic review applicable internationally. | Literature review | Finance, Contractor Experience, Client Service, Material, Duration, Finance, Construction Method, Structure Construction, Project Management Contract, K3, Government. |
| Risk Factors | Frequency | Percentage |
|---|---|---|
| 1. Financial/Economic Issues | 42 | 50.6% |
| 2. Design and Scope Changes | 39 | 47.0% |
| 3. Material Issues | 31 | 37.3% |
| 4. Contractor-Related Issues | 28 | 33.7% |
| 5. Political/Regulatory | 27 | 32.5% |
| 6. Land Acquisition Delays | 25 | 30.1% |
| 7. Equipment Issues | 22 | 26.5% |
| 8. Utilities Relocation/Conflicts | 21 | 25.3% |
| 9. Planning and Scheduling | 20 | 24.1% |
| 10 (a) Labour/Personnel Issues | 18 | 21.7% |
| 10 (b) Weather Conditions | 18 | 21.7% |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2025 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Zhasmukhambetova, A.; Evdorides, H.; Davies, R.J. Critical Risk Factors Affecting Time and Cost in Highway Construction: A Global Systematic Literature Review. Future Transp. 2025, 5, 192. https://doi.org/10.3390/futuretransp5040192
Zhasmukhambetova A, Evdorides H, Davies RJ. Critical Risk Factors Affecting Time and Cost in Highway Construction: A Global Systematic Literature Review. Future Transportation. 2025; 5(4):192. https://doi.org/10.3390/futuretransp5040192
Chicago/Turabian StyleZhasmukhambetova, Aigul, Harry Evdorides, and Richard J. Davies. 2025. "Critical Risk Factors Affecting Time and Cost in Highway Construction: A Global Systematic Literature Review" Future Transportation 5, no. 4: 192. https://doi.org/10.3390/futuretransp5040192
APA StyleZhasmukhambetova, A., Evdorides, H., & Davies, R. J. (2025). Critical Risk Factors Affecting Time and Cost in Highway Construction: A Global Systematic Literature Review. Future Transportation, 5(4), 192. https://doi.org/10.3390/futuretransp5040192
