Enabling BIM Innovation Through Knowledge-Driven Legal–Contractual Risk Management: A Novel Strategic Risk Breakdown Structure
Abstract
1. Introduction
- It conceptualises a structured legal–contractual knowledge spectrum—an original contribution that systematises legal and contractual BIM risks into a coherent framework not previously developed in research.
- It integrates mixed-method evidence into a validated risk knowledge system (BIM-RBS and BIM-RBS–MS), providing a novel methodological contribution that enhances the scientific robustness of existing BIM risk studies.
- It generates actionable, empirically grounded strategies that address persistent gaps in contractual instruments (NEC, JCT, CIC, AIA), offering new insights for industry, policymakers, and researchers.
1.1. Literature Review
1.2. BIM Adoption and Collaborative Practices
1.3. Legal–Contractual Risks in BIM Projects
1.4. Existing Contractual Frameworks and Their Limitations
1.5. Gaps in Current Research and Limitations of Existing Models
- Weak links between risk factors and mitigation strategies: Few studies provide direct, validated connections between identified risks and practical contractual strategies or governance mechanisms.

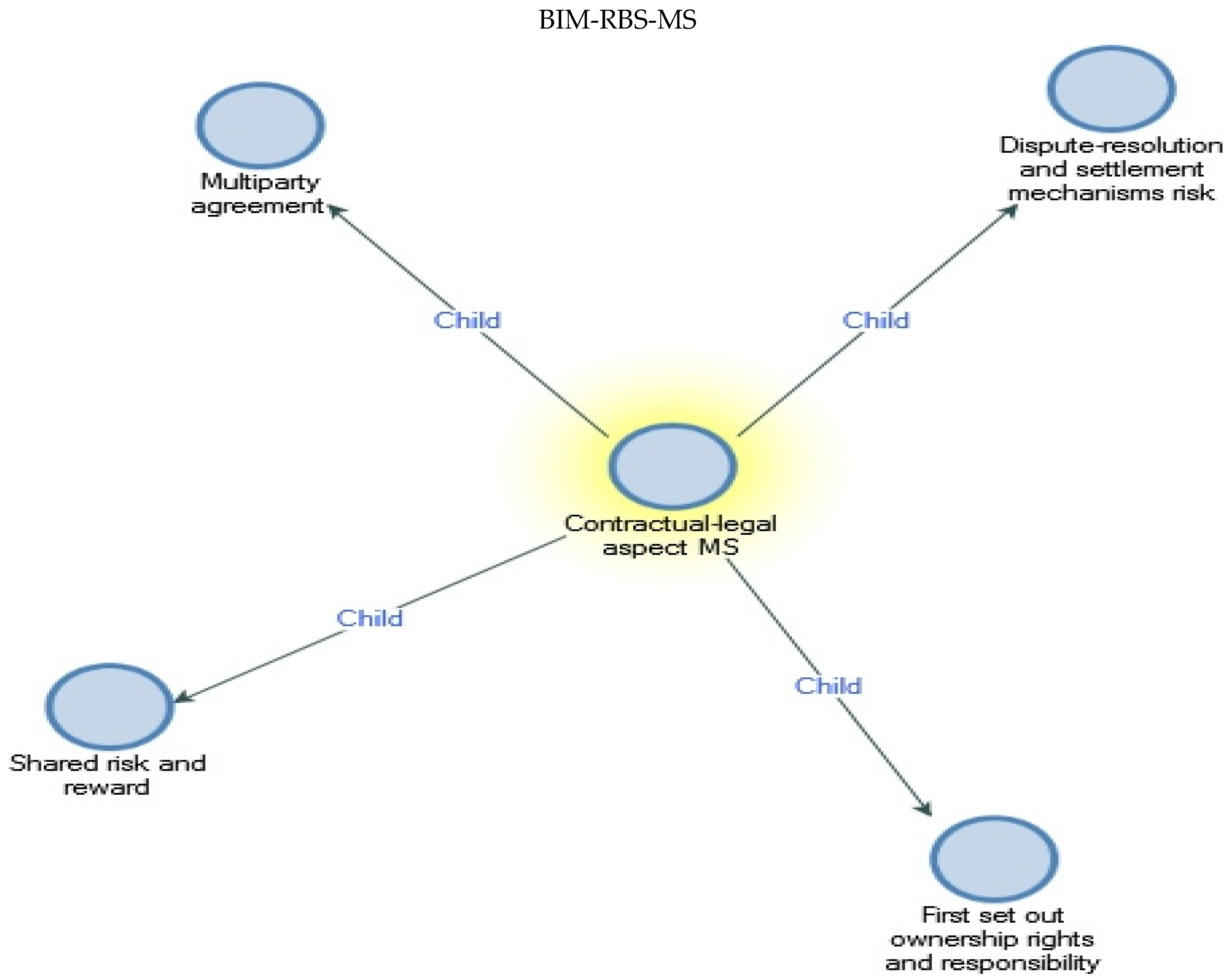

1.6. Theoretical Framework
- BIM-RBS (Risk Breakdown Structure)
- BIM-RBS–MS (Risk Management Strategies)
- BIM-RBS Triangle, which conceptualises the interaction of risks, strategies, and BIM dimensions within BIM-based construction networks (BbCNs)
- Bridges legal theories and socio-technical systems thinking
- Explains how legal–contractual risks emerge within BIM-enabled collaboration
- Justifies the systematic classification of BIM-related risks
- Supports the development of an evidence-based knowledge framework for BIM innovation.
1.7. Research Objectives
- To critically identify and classify legal–contractual risk factors associated with BIM implementation using a structured Risk Breakdown Structure (BIM-RBS).
- To examine how legal–contractual risks influence the equilibrium of BIM-enabled socio-technical systems using the Leavitt Socio-Technical Model (LSTM).
- To develop and validate a set of empirically grounded risk management strategies (BIM-RBS–MS) that correspond to the identified risk factors.
- To construct an integrated BIM-RBS–MS Nexus that links risk categories with appropriate strategies, providing an actionable framework for practitioners.
- To contribute an innovation-oriented legal–contractual knowledge spectrum that supports improved governance, collaboration, and risk allocation in BIM-enabled projects.

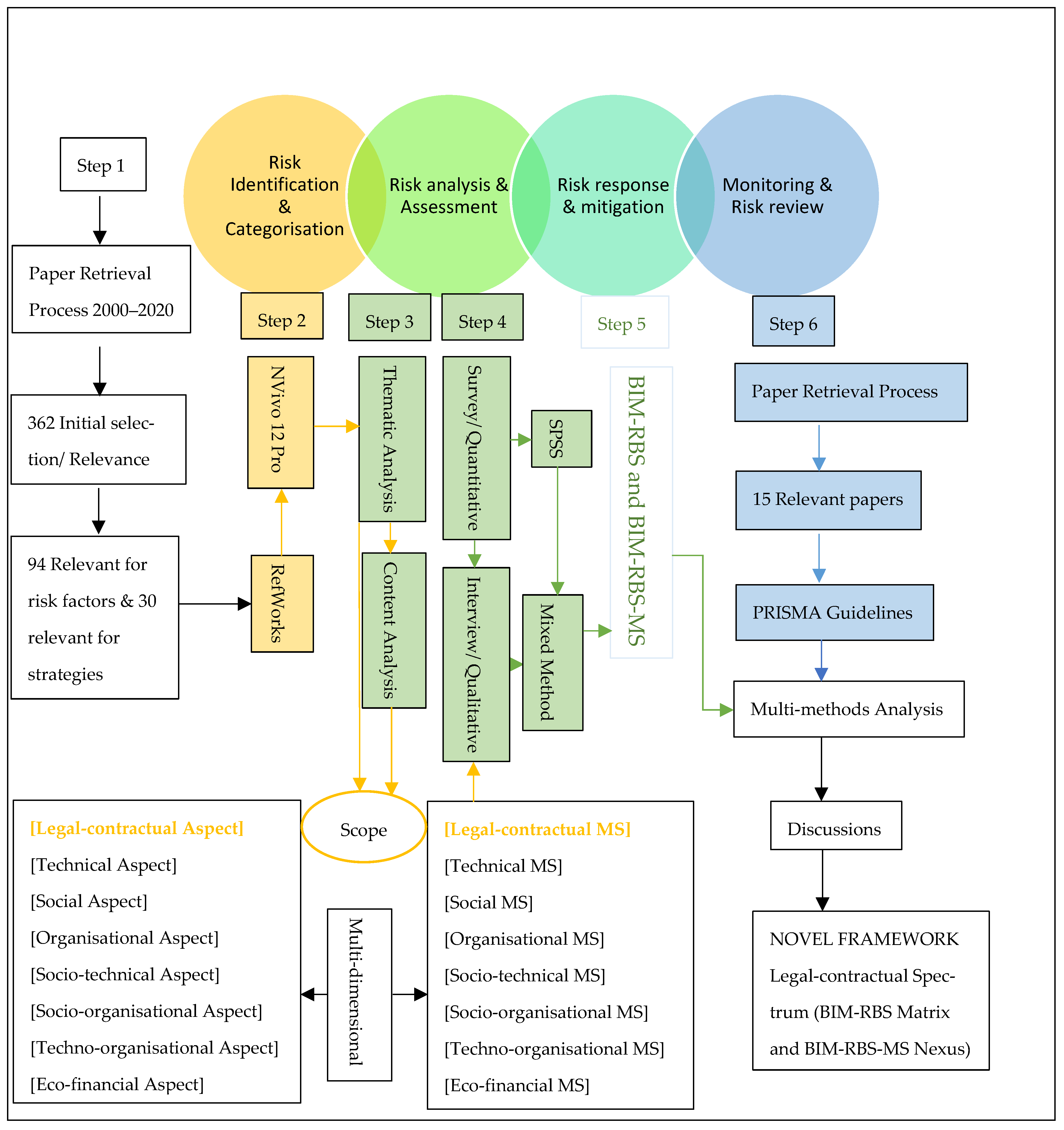

2. Methodology
2.1. Research Design and Paper Retrieval Process
2.2. Survey and Interviews
- Sector (consultants, contractors, clients)
- Geographic region
- Years of BIM experience
- Professional role
- Cronbach’s Alpha to test internal reliability of BIM-RBS items
- Simple Linear Regression (SLR) to explore relationships between BIM experience and perceived risk magnitude.
- Reliability: Cronbach’s Alpha = 0.947 (Very High Reliability) confirms strong internal consistency.
- Construct validity: Achieved through alignment of survey items with the BIM-RBS derived from the literature.
- Triangulation: Combining secondary data, survey data, and interview data ensures methodological robustness.
- Data saturation: Achieved after the eighth interview, with no new themes emerging.
2.3. Mixed Methods
- Cross-checking risk factors across the literature, survey, and interviews
- Comparing perceived risk magnitude with LSTM-equilibrium interpretations
- Aligning management strategies (MS) with specific risk categories
- Constructing the BIM-RBS–MS Nexus, linking each risk to a validated mitigation strategy
3. Results and Analysis

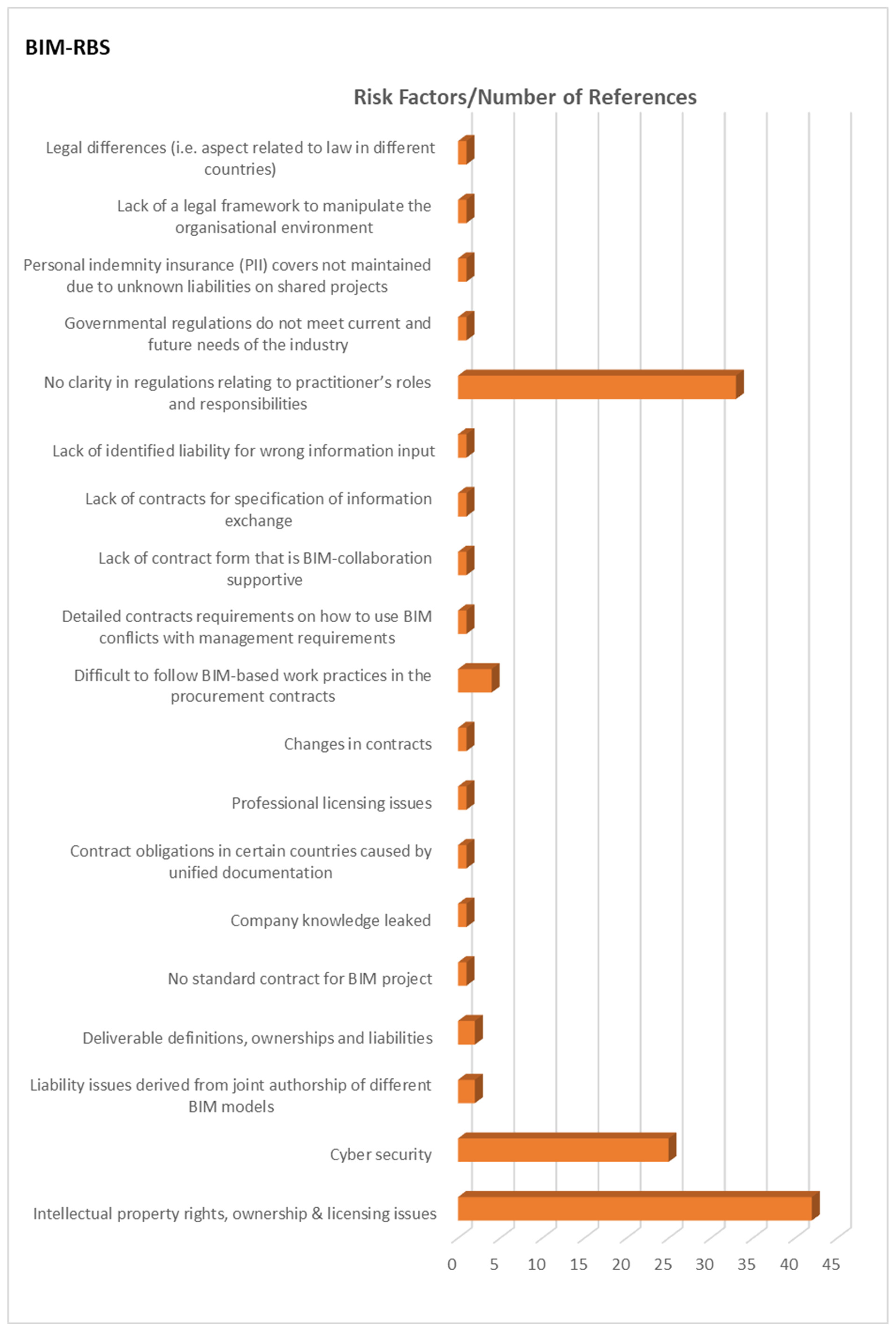

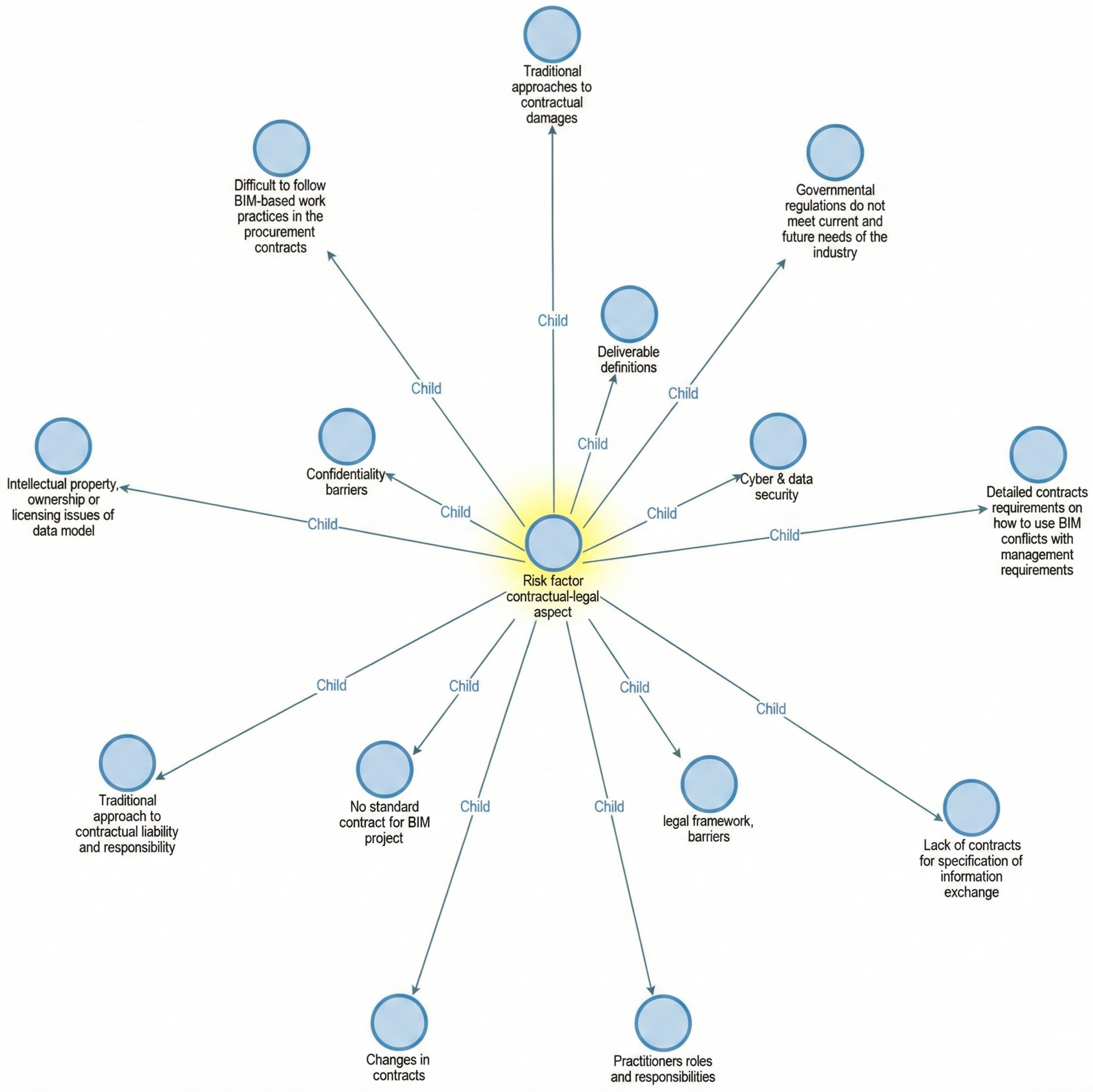

3.1. Secondary Data Analysis (Literature Review)
- unclear ownership and authorship of federated models;
- undefined roles and responsibilities across project actors;
- inconsistent or outdated government regulations;
- misalignment between BIM-enabled collaboration and traditional procurement systems; and
- Implementing version control and approval workflows to ensure traceability and minimise legal disputes over model revisions [21].
3.2. Primary Data Analysis (Interviews)
- Participant A noted that “traditional procurement methods cannot handle BIM,” emphasising that collaborative procurement systems remain underutilised despite being more suitable for BIM-enabled projects.
- Participant G described the “garbage in, garbage out” dynamic, illustrating how errors in early model inputs propagate contractual risks downstream.
- Participant E stressed that existing regulations “do not move with the pace of technology.”
- Participant G highlighted the challenge of working across regions with differing BIM regulations (e.g., Canadian provinces), describing it as a significant legal and operational barrier.
- Participant A emphasised the absence of “intermediaries who understand both BIM and the contract,” highlighting a gap in BIM-legal expertise.
- Participant G noted that organisations are increasingly looking for “technologies downstream to mitigate risks before they escalate,” indicating a growing recognition that the legal landscape is not keeping pace with technological advancement.
- Participant D emphasised that “liability should not be shared” unless responsibilities are contractually defined with clarity.
- Participant E highlighted significant variability in insurance coverage between firms.
- Participants F and G recommended proactive approaches such as subtrade bonding, early clarification of coverage, and alignment of contractual definitions with insurer requirements.
- the adoption of BIM protocols (e.g., CIC BIM Protocol, ISO 19650 suite);
- rigorous definition of roles, workflows, and model responsibilities;
- enhanced cybersecurity and access control procedures;
- version control mechanisms and model approval workflows;
- clear legal definitions of BIM processes and data-sharing rules.
- Offering empirical evidence explaining how and why legal risks emerge during BIM-enabled collaboration;
- Validating and enriching the risk categories identified through the literature review;
- Demonstrating the real-world interplay between contractual frameworks, human actors, digital technologies, and organisational structures;
- Providing practitioner-informed insight into the socio-technical pathways through which risks propagate, thereby strengthening the theoretical integration of LSTM within BIM legal studies.
3.3. Primary Data Analysis (Survey)

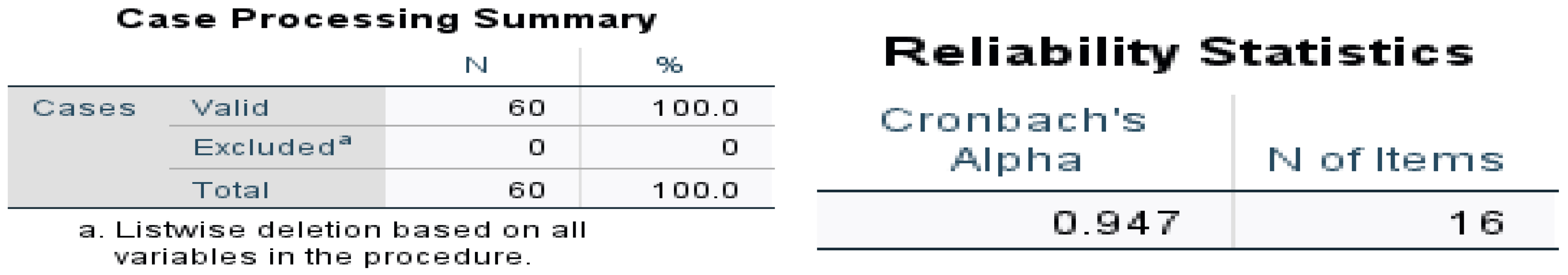

3.3.1. Reliability of Legal–Contractual Risk Constructs

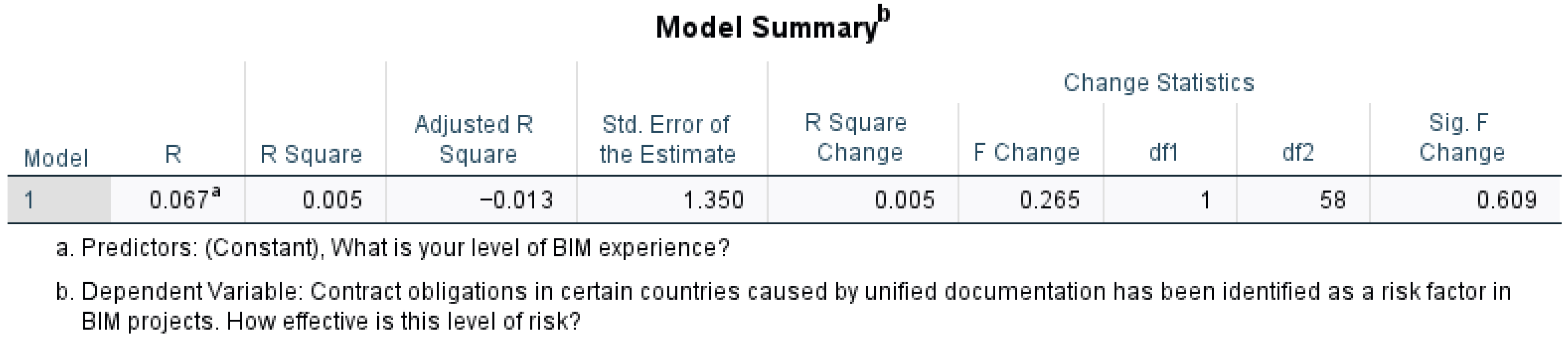

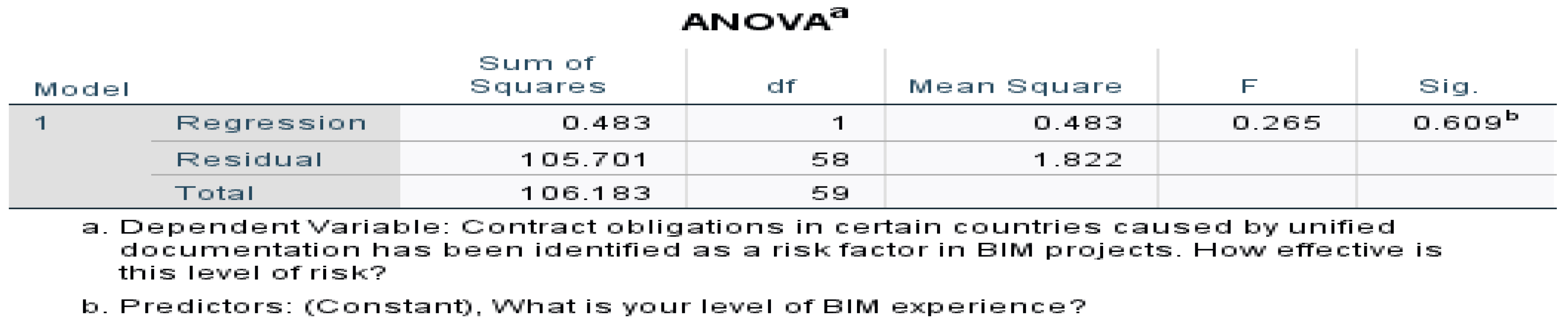

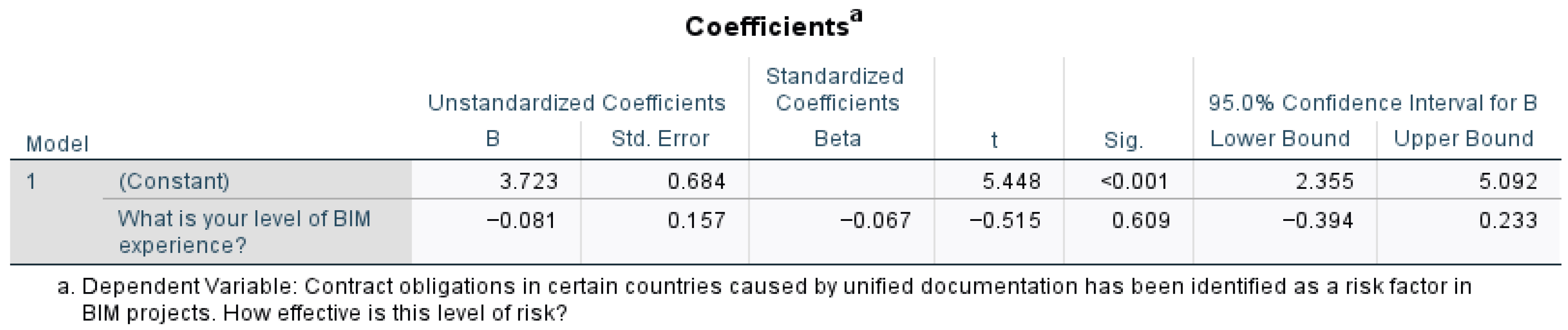

3.3.2. Regression Analysis: The Influence of BIM Experience on Risk Perception
- legal–contractual risks are perceived consistently across experience levels;
- BIM experience alone does not meaningfully alter risk perception;
- The risks identified in the BIM-RBS are systemic, not dependent on individual expertise.

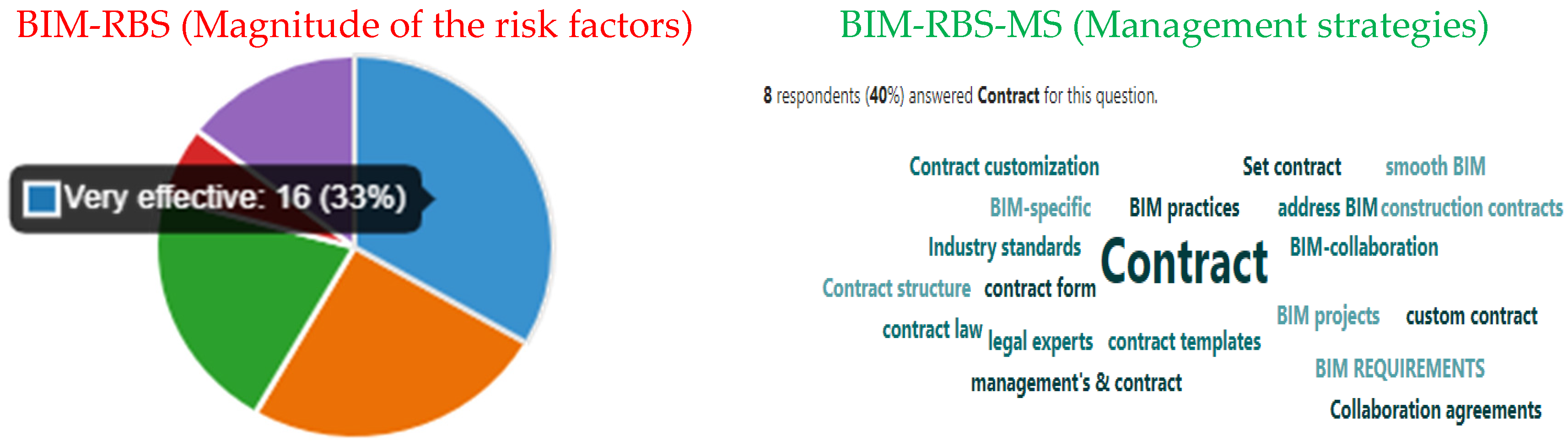

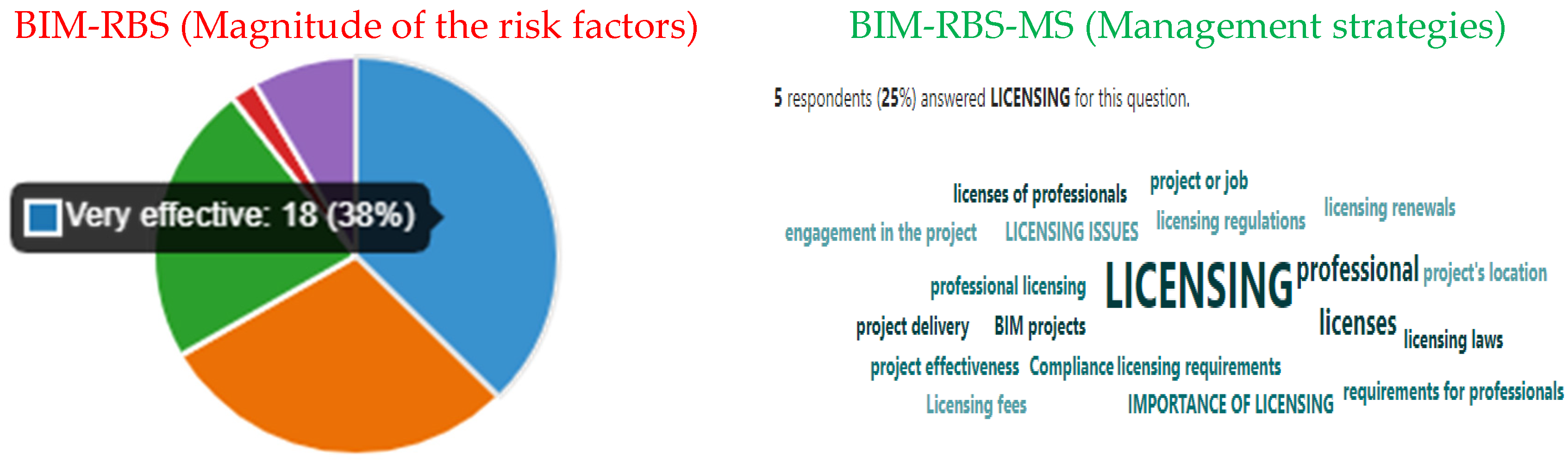

3.3.3. Magnitude of Legal–Contractual Risks
Contract Obligations Misalignment
Professional Licensing Issues
- unclear definitions of professional responsibility in federated models;
- cross-disciplinary overlaps in design authorship;
- liability attribution across multi-author workflows.
Lack of Supportive BIM-Collaboration Contract Forms
- shared digital authorship;
- model management responsibilities;
- multi-disciplinary collaboration obligations.
Cross-Jurisdictional Legal Differences
3.3.4. Interpretation and Scientific Significance
- Confirm the internal validity of the BIM-RBS risk categories through high reliability scores.
- Demonstrate that legal risks are systemic, not user-driven, reinforcing socio-technical interpretations of BIM risk.
- Identify the most severe risks, including cross-jurisdictional legal differences and contract misalignment.
- Provide quantitative grounding for the BIM-RBS–MS Nexus, linking risk magnitude to targeted strategic responses.

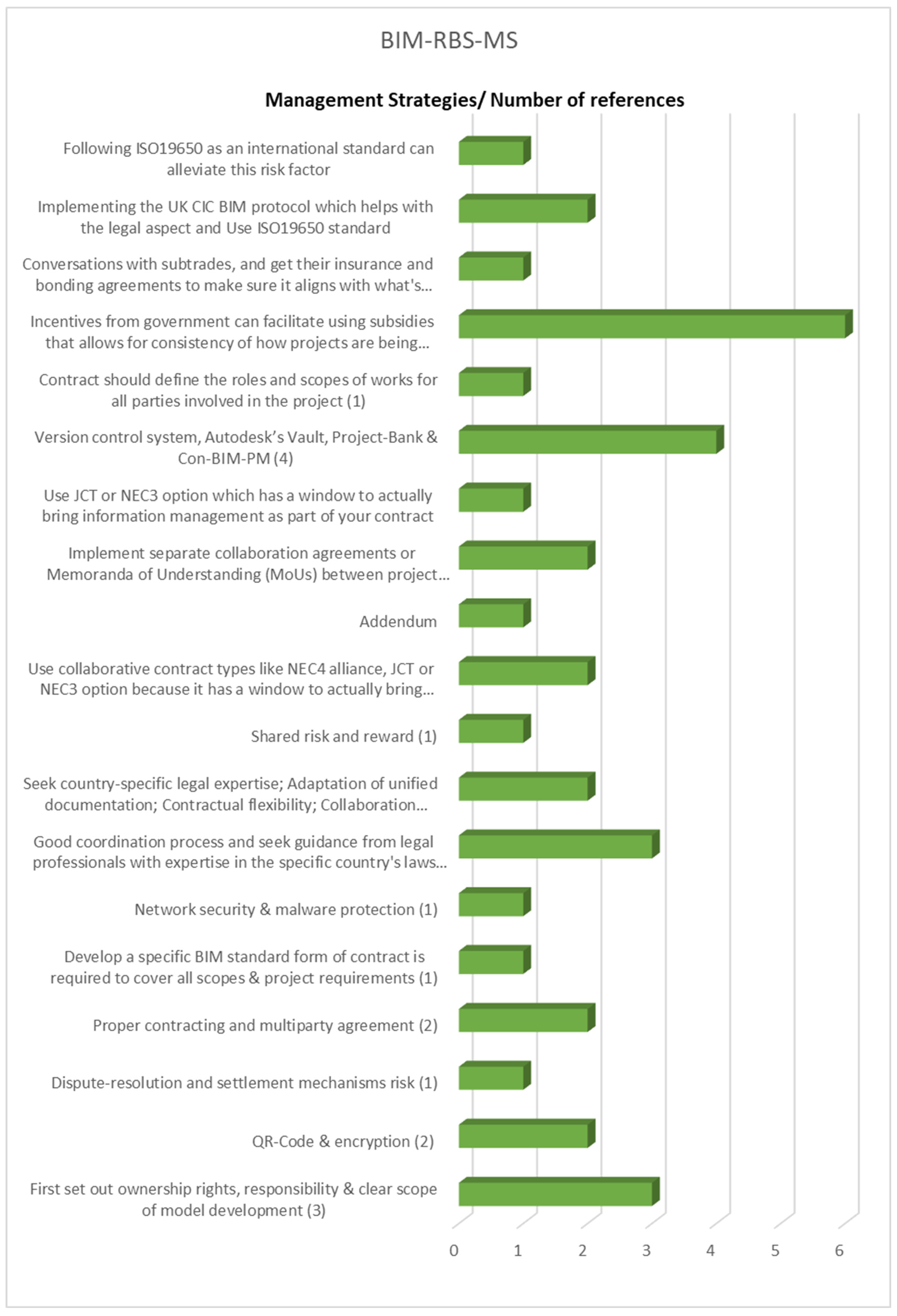

3.4. Findings
3.5. Discussion
4. Conclusions and Knowledge Contributions
Future Research Direction, and Recommendations for Innovation and Knowledge Impact
- Adopt the BIM-RBS Matrix as a proactive tool during contract preparation and project planning phases to clarify risk allocation, reduce disputes, and improve collaboration.
- Use the BIM-RBS–MS Nexus to guide the selection of tailored management strategies, ensuring that digital, legal, and organisational risks are jointly addressed rather than managed in isolation.
- Invest in training and capacity building to equip project managers, legal advisors, and BIM coordinators with the skills required to operationalise these frameworks.
- Integrate the BIM-RBS framework into national and international BIM guidelines (e.g., ISO 19650, NEC, JCT, CIC) to provide standardised guidance on risk allocation and contractual provisions.
- Encourage the development of dispute resolution protocols specific to BIM by recognising the unique challenges of shared digital environments.
- Promote incentives for collaborative risk-sharing models, such as shared risk–reward mechanisms, to align stakeholder interests and reduce adversarial practices.
- Extend investigations into socio-organisational, eco-financial, and techno-organisational perspectives to build a richer understanding of BIM legal–contractual governance.
- Empirically test the BIM-RBS Matrix across jurisdictions, contract types, and project scales to validate knowledge transferability and ensure global applicability.
- Advance theoretical development on the legal–contractual dimension within BIM adoption models, strengthening innovation governance theory in construction and allied industries.
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Acknowledgments
Conflicts of Interest
Abbreviations
| ACA | Association of Consultant Architects |
| AEC | Architecture, engineering, construction |
| AIA | American Institute of Architects |
| BbCNs | BIM-based construction networks |
| BEP | BIM execution plan |
| BIM | Building Information Modelling |
| CA | Cronbach’s Alpha (α) test |
| CDBB | Centre for Digital Built Britain |
| CDE | Common data environment |
| CIOB | Chartered Institute of Building |
| CIC | Construction Industry Council |
| DBB | Design-bid-build |
| FIDIC | Fédération Internationale des Ingénieurs-Conseils (International Federation of Consulting Engineers) |
| GC | General Contractor |
| IFC | Industry foundation classes |
| IPD | Integrated project delivery |
| IPR | Intellectual property rights |
| ISO | International Organisation for Standardisation |
| JCT | Joint Contracts Tribunal |
| LCA | Legal–contract aspect |
| LOD | Level of development |
| LSTM | Leavitt Socio-technical Model |
| MF | Microsoft Form |
| MoU | Memorandum of Understanding |
| MS | Management strategies |
| NBS | National Building Specification |
| NEC | New engineering contracts |
| PAS | Publicly available specification |
| PII | Personal indemnity insurance |
| PPC | Project partnering contract |
| PRISMA | Preferred Reporting Items for Systematic Reviews and Meta-Analyses |
| RBS | Risk Breakdown Structure |
| SBCC | Scottish Building Contracts Committee |
| SLR | Simple linear regression |
| SPSS | Statistical Package for Social Sciences |
| UK | United Kingdom |
| VC | Version control |
Appendix A

Appendix B
| Contract obligations in certain countries caused by unified documentation have been identified as a risk factor in BIM projects. Agree or Disagree | ||||||
|---|---|---|---|---|---|---|
| Question 20A: How does it affect the implementation process and what is the level of that risk? | Question 20B: What management strategy was used to resolve or navigate through this issue? | |||||
| Answer: | Answer: | |||||
| Level of risk | Very Low | Low | Medium | High | Very High | |
| Professional licensing issues has been identified as a risk factor in BIM projects relating to this category. Agree or Disagree | ||||||
| Question 21A: How does it affect the project? Please indicate the level of risk. | Question 21B: What strategy was used to resolve this issue? | |||||
| Answer: | Answer: | |||||
| Level of risk | Very Low | Low | Medium | High | Very High | |
| The lack of contract form that is BIM-collaboration supportive is identified as a risk factor in this category. Agree or Disagree | ||||||
| Question 22A: How does it affect the implementation process and what is the level of that risk? | Question 22B: What management strategy was used in support of collaboration without the form of contract? | |||||
| Answer: | Answer: | |||||
| Level of risk | Very Low | Low | Medium | High | Very High | |
| The issue with legal differences (i.e., aspect related to law in different countries) when different organisations come together to work on a BIM project, has been identified as a risk factor in this category. Agree or Disagree | ||||||
| Question 23A: How does it affect the project? Please indicate the level of risk. | Question 23B: How did they navigate through these differences? | |||||
| Answer: | Answer: | |||||
| Level of risk | Very Low | Low | Medium | High | Very High | |
| Various studies have recognised that it is difficult to follow BIM-based work practices in the procurement contracts. Agree or Disagree | |
|---|---|
| Question 15A: What part of the work practice made it difficult to follow the contract? Indicate the level of risk? | Question 15B: What strategy did you follow to minimise the risk of deviating from the procurement contract? |
| Answer: | Answer: |
| The lack of contracts for specification of information exchange has been identified as a risk factor in BIM projects. Agree or Disagree | |
| Question 16A: How does it affect the implementation process with regards to information exchange and what are the legal implications? Indicate the level of risk? | Question 16B: What management strategy was used without the contract for specification of information exchange? |
| Answer: | Answer: |
| Governmental regulations do not meet with current and future needs of the industry relating to BIM implementation and is identified as a risk factor in this category. Agree or Disagree | |
| Question 17A: What are the requirements of the industry that governmental regulations are lacking and what are the legal implications? Please indicate the level of risk. | Question 17B: What type of strategy did your organisation adopt to manage these irregularities? |
| Answer: | Answer: |
| Issues with Personal Indemnity Insurance (PII) covers not maintained due to unknown liabilities on shared projects like organisations working together on a BIM project, has been identified as a risk factor within the contractual/legal aspect. Agree or Disagree | |
| Question 18A: What liability issue did you encounter during the project that PII doesn’t cover? Indicate the level of risk? | Question 18B: What strategy was implemented to guide members working together to avoid legal implications? |
| Answer: | Answer: |
| The issue with the lack of a legal framework to manipulate the organisational environment when different organisations are working together on a BIM project, has been identified as a risk factor in this category. Agree or Disagree | |
| Question 19A: What sort of problem evolved relating to this issue? Please indicate the level of risk. | Question 19B: How did you manage to control the risk without legal implications? |
| Answer: | Answer: |
Appendix C
| Participants | Profession | BIM Experience | Classification | Time |
|---|---|---|---|---|
| A | Programme leader | More than 5 years | XXX stars | 15.00 |
| B | Senior project manager | More than 5 years | XXX stars | 20.57 |
| C | BIM Engineer | Less than 5 years | XX stars | 13.00 |
| D | Structural Engineer | Less than 5 years | XX stars | 12:00 |
| E | Site Engineer | More than 5 years | XXX stars | 14.30 |
| F | Site Engineer | More than 5 years | XXX stars | 15.00 |
| G | BIM and VDC manager | 18 years | XXX stars | 18.00 |
| H | Director General | 9 years | XXX stars | 13.00 |
| I | Construction manager | Less than 1 year | X star | 13.00 |
| J | Site Engineer | Less than 1 year | X star | 14.30 |
| K | Structural Engineer | Less than 1 year | X star | 14.00 |
| L | Manager | Less than 1 year | X star | 13.00 |
| M | Marketing Engineer | Less than 1 year | X star | 15.30 |
| N | Construction | Less than 1 year | X star | 12.00 |
| O | Site Engineer | Less than 1 year | X star | 13.30 |
| P | Site Architect | Less than 1 year | X star | 15.30 |
| Q | Site Engineer | Less than 1 year | X star | 16.00 |
References
- Ahmadian, E.; Bingham, C.; Elnokaly, A.; Sodagar, B.; Verhaert, I. Impact of Climate Change and Technological Innovation on the Energy Performance and Built form of Future Cities. Energies 2022, 15, 8592. [Google Scholar] [CrossRef]
- Alotaibi, B.S.; Waqar, A.; Radu, D.; Khan, A.M.; Dodo, Y.; Althoey, F.; Almujibah, H. Building information modelling (BIM) adoption for enhanced legal and contractual management in construction projects. Ain Shams Eng. J. 2024, 15, 102822. [Google Scholar] [CrossRef]
- Dao, T.N.; Chen, P.H.; Nguyen, T.Q. Critical success factors and a contractual framework for construction projects adopting building information modelling in Vietnam. Int. J. Civ. Eng. 2021, 19, 85–102. [Google Scholar]
- El Hajj, C.; Montes, G.M.; Sleiman, S. Investigation of BIM Contractual Perspective in the MENA Construction Industry. In Proceedings of the 2023 Fifth International Conference on Advances in Computational Tools for Engineering Applications (ACTEA), Zouk Mosbeh, Lebanon, 5–7 July 2023; IEEE: New York, NY, USA, 2023; pp. 104–108. [Google Scholar]
- Mahdian, A.; Jalal, M.P.; Roushan, T.Y. Contractual risks of BIM implementation and the proposed contract form for DBB and DB projects. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2023, 15, 06522003. [Google Scholar] [CrossRef]
- Mohammadi, S.; Aibinu, A.A.; Oraee, M. Risk Allocation and Mitigation Practices for Building Information Modeling: Addressing Legal and Contractual Risks Associated with Contract Documentation. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2024, 16, 04524005. [Google Scholar] [CrossRef]
- Dogonyaro, I.; Elnokaly, A. Strategies to Mitigate Risks in Building Information Modelling Implementation: A Techno-Organizational Perspective. Intell. Infrastruct. Constr. 2025, 1, 5. [Google Scholar] [CrossRef]
- Baharom, M.H.; Habib, S.N.H.A.; Ismail, S. Building information modelling (BIM): Contractual issues of intellectual property rights (IPR) in construction projects. Int. J. Sustain. Constr. Eng. Technol. 2021, 12, 170–178. [Google Scholar] [CrossRef]
- Berema, R.K.R.; Ismail, Z.; Brahim, J. Comparative analysis of existing contracts for building information modelling (BIM) projects in Malaysia and selected common law countries. Int. J. Sustain. Constr. Eng. Technol. 2021, 12, 9–18. [Google Scholar] [CrossRef]
- Erpay, M.Y.; Sertyesilisik, B. Preliminary checklist proposal for enhancing BIM-based construction project contracts. J. Inf. Technol. Constr. 2021, 26, 341–365. [Google Scholar] [CrossRef]
- Muhammad, R.; Nasir, A.R. Integrating BIM in construction dispute resolution: Development of a contractual framework. Buildings 2022, 12, 1828. [Google Scholar] [CrossRef]
- Duran, O.; Elnokaly, A. Collaborative approach to design: Case-study of future-proofing a Paragraph 80 house. Build. Simul. 2023 2023, 18, 1491–1498. [Google Scholar]
- Nilchian, S.; Sardrood, J.M.; DarabPour, M.; Tafreshi, S.T. The Study of the Contracts of Building Information Model (BIM) and the Approach to its Contractual Framework Codification. Amirkabir J. Civ. Eng. 2021, 53, 3239–3260. [Google Scholar]
- Taghizadeh, K.; Roushan, T.Y.; Alizadeh, M. Liability in BIM projects—Preliminary review results. Int. J. Archit. Comput. 2022, 20, 476–490. [Google Scholar] [CrossRef]
- Bensalah, M.; Elouadi, A.; Mharzi, H. Overview: The opportunity of BIM in railway. Smart Sustain. Built Environ. 2019, 8, 103–116. [Google Scholar] [CrossRef]
- Ganbat, T.; Chong, H.Y.; Liao, P.C.; Lee, C.Y. A cross-systematic review of addressing risks in building information modelling-enabled international construction projects. Arch. Comput. Methods Eng. 2019, 26, 899–931. [Google Scholar] [CrossRef]
- Georgiadou, M. An overview of benefits and challenges of building information modelling (BIM) adoption in UK residential projects. Constr. Innov. 2019, 19, 298–320. [Google Scholar] [CrossRef]
- Lindblad, H. Black boxing BIM: The public client’s strategy in BIM implementation. Constr. Manag. Econ. 2019, 37, 1–12. [Google Scholar] [CrossRef]
- Chong, H.Y.; Fan, S.L.; Sutrisna, M.; Hsieh, S.H.; Tsai, C.M. Preliminary contractual framework for BIM-enabled projects. J. Constr. Eng. Manag. 2017, 143, 04017025. [Google Scholar] [CrossRef]
- Weber, B.; Achenbach, M. Legal governance for BIM–Rights management and lawful data Use. In Life-Cycle of Structures and Infrastructure Systems; CRC Press: Boca Raton, FI, USA, 2023; pp. 3292–3299. [Google Scholar]
- Feist, S.; Ferreira, B.; Leitão, A. Collaborative algorithmic-based building information modelling. In Protocols, Flows and Glitches: 22nd International Conference of the Association for Computer-Aided Architectural Design Research in Asia (CAADRIA); The Association for Computer-Aided Architectural Design Research in Asia (CAADRIA): Hong Kong, China, 2017; pp. 613–623. [Google Scholar]
- Lin, Y.C.; Chen, Y.P.; Huang, W.T.; Hong, C.C. Development of BIM execution plan for BIM model management during the pre-operation phase: A case study. Buildings 2016, 6, 8. [Google Scholar] [CrossRef]
- Lu, W.; Peng, Y.; Shen, Q.; Li, H. Generic model for measuring benefits of BIM as a learning tool in construction tasks. J. Constr. Eng. Manag. 2013, 139, 195–203. [Google Scholar] [CrossRef]
- Hartmann, T.; Fischer, M. Applications of BIM and Hurdles for Widespread Adoption of BIM 2007 AISC-ACCL e-Construction Roundtable Event Report; Center for Integrated Facility Engineering: Stanford, CA, USA, 2008; pp. 1–18. [Google Scholar]
- Schwartz, A.; Scott, R.E. Contract Theory and the Limits of Contract Law. Yale Law J. 2003, 113, 541–619. [Google Scholar] [CrossRef]
- Elnokaly, A.; Dogonyaro, I. Framework to assess connection of risk factors and management strategies in Building Information Modelling. Acad. Eng. 2024, 1, 1–20. [Google Scholar] [CrossRef]
- Leavitt, H.J. Applied organization change in industry: Structural, technical and human approaches. In New Perspectives in Organizational Research; Cooper, W.W., Leavitt, H.J., Shelly, M.W., Eds.; John Wiley: New York, NY, USA, 1964; pp. 55–71. [Google Scholar]
- Merschbrock, C.; Hosseini, M.; Martek, I.; Arashpour, M.; Mignone, G. Collaborative Role of Sociotechnical Components in BIM-Based Construction Networks in Two Hospitals. Am. Soc. Civ. Eng. 2018, 34, 05018006. [Google Scholar] [CrossRef]
- Oraee, M.; Hosseini, M.R.; Papadonikolaki, E.; Palliyaguru, R.; Arashpour, M. Collaboration in BIM-based construction networks: A bibliometric-qualitative literature review. Int. J. Proj. Manag. 2017, 35, 1288–1301. [Google Scholar] [CrossRef]
- Creswell, J.W.; Creswell, J.D. Research Design: Qualitative, Quantitative, and Mixed Methods Approach, 5th ed.; Sage Publishing: Thousand Oaks, CA, USA, 2020. [Google Scholar]
- Górecki, J. Big Data as a Project Risk Management Tool. Risk Manag. Treatise Eng. Pract. 2018, 787, 788. [Google Scholar]
- Ya’acob, I.A.M.M.; Rahim, F.A.M.; Zainon, N. Risk in implementing building information modelling (BIM) in Malaysia construction industry: A review. In E3S Web of Conferences; EDP Sciences: Les Ulis, France, 2018; Volume 65, p. 03002. [Google Scholar]
- Azhar, S. Building information modelling (BIM): Trends, benefits, risks, and challenges for the AEC industry. Leadersh. Manag. Eng. 2011, 11, 241–252. [Google Scholar] [CrossRef]
- Chang, C.Y. Risk-bearing capacity as a new dimension to the analysis of project governance. Int. J. Proj. Manag. 2015, 33, 1195–1205. [Google Scholar] [CrossRef]
- Kivits, R.A.; Furneaux, C. BIM: Enabling sustainability and asset management through knowledge management. Sci. World J. 2013, 2013, 983721. [Google Scholar] [CrossRef]
- Jamil, A.H.; Fathi, M.S. Contractual challenges for BIM-based construction projects: A systematic review. Built Environ. Proj. Asset Manag. 2018, 8, 372–385. [Google Scholar] [CrossRef]
- Beach, T.; Petri, I.; Rezgui, Y.; Rana, O. Management of collaborative BIM data by federating distributed BIM models. J. Comput. Civ. Eng. 2017, 31, 04017009. [Google Scholar] [CrossRef]
- Building Information Modelling (BIM) PROTOCOL. In Standard Protocol for Use in Projects Using Building Information Models, 2nd ed.; Construction Industry Council: London, UK, 2018.
- Chien, K.F.; Wu, Z.H.; Huang, S.C. Identifying and assessing critical risk factors for BIM projects: Empirical study. Autom. Constr. 2014, 45, 1–15. [Google Scholar] [CrossRef]
- Circo, C.J. Contract theory and contract practice: Allocating design responsibility in the construction industry. Fla. Law Rev. 2006, 58, 561–638. [Google Scholar]
- Butler, H.N. The contractual theory of the corporation. Geo. Mason UL Rev. 1989, 11, 99–123. [Google Scholar]
- Sackey, E.; Tuuli, M.; Dainty, A. Sociotechnical Systems Approach to BIM Implementation in a Multidisciplinary Construction Context. Am. Soc. Civ. Eng. 2014, 31, 1–11. [Google Scholar] [CrossRef]
- Akhtar, D.M.I. Research Design. Research in Social Science: Interdisciplinary Perspectives. 2016, pp. 68–84. Available online: https://scholar.google.com/scholar?hl=en&as_sdt=0%2C5&q=Research+Design+Md.+Inaam+Akhtar+Deptt.+of+Political+Science%2C+Faculty+of+Social+Sciences%2C+Jamia+Millia+Islamia%2C+New+Delhi&btnG= (accessed on 28 August 2022).
- Zhao, X.; Feng, Y.; Pienaar, J.; O’Brien, D. Modelling paths of risks associated with BIM implementation in architectural, engineering and construction projects. Archit. Sci. Rev. 2017, 60, 472–482. [Google Scholar] [CrossRef]
- Aksenova, G.; Kiviniemi, A.; Kocaturk, T.; Lejeune, A. From Finnish AEC knowledge ecosystem to business ecosystem: Lessons learned from the national deployment of BIM. Constr. Manag. Econ. 2019, 37, 317–335. [Google Scholar] [CrossRef]
- Dhakal, K. NVivo. J. Med. Libr. Assoc. 2022, 110, 270–272. [Google Scholar] [CrossRef]
- Zou, Y.; Kiviniemi, A.; Jones, S.W. A review of risk management through BIM and BIM-related technologies. Saf. Sci. 2017, 97, 88–98. [Google Scholar] [CrossRef]
- Ding, L.Y.; Zhong, B.T.; Wu, S.; Luo, H.B. Construction risk knowledge management in BIM using ontology and semantic web technology. Saf. Sci. 2016, 87, 202–213. [Google Scholar] [CrossRef]
- Enegbuma, W.I.; Aliagha, U.G.; Ali, K.N. Preliminary building information modelling adoption model in Malaysia: A strategic information technology perspective. Constr. Innov. 2014, 14, 408–432. [Google Scholar] [CrossRef]
- Oyedele, L.O.; Regan, M.; von Meding, J.; Ahmed, A.; Ebohon, O.J.; Elnokaly, A. Reducing waste to landfill in the UK: Identifying impediments and critical solutions. World J. Sci. Technol. Sustain. Dev. 2013, 10, 131–142. [Google Scholar] [CrossRef]
- Sabo, W.; Zahn, J.K. Building information modelling and legal issues. Constr. Specif. 2005, 58, 18–19. [Google Scholar]
- Winfield, M. UK Standard form Contracts: Are They ‘BIM-Enabled’. 2015. Available online: https://constructionmanagement.co.uk/uk-standard-form-contracts-are-they-bim-enabled/#:~:text=In%20recognition%20of%20BIM’s%20need,supporters%20of%20the%20CIC%20Protocol (accessed on 29 May 2020).
- Darabseh, M.; Joo, M. Protecting BIM design intellectual property with blockchain: Review and framework. In Proceedings of the Conference CIB W78, Luxembourg, 11–15 October 2021; Volume 2021, pp. 11–15. [Google Scholar]
- ISO 19650-1; Organization and Digitization of Information About Buildings and Civil Engineering Works, Including Building Information Modelling (BIM). Information Management Using Building Information Modelling. International Organization for Standardization: Geneva, Switzerland, 2018.
- Almarri, K.; Aljarman, M.; Boussabaine, H. Emerging contractual and legal risks from the application of building information modelling. Eng. Constr. Archit. Manag. 2019, 26, 2307–2325. [Google Scholar] [CrossRef]
- Nilchian, S.; Sardroud, J.M.; Darabpour, M.; Tafreshi, S.T. Features and conditions of building information modelling contracts. Buildings 2022, 12, 1839. [Google Scholar] [CrossRef]
- Cohen, L.; Manion, L.; Morrison, K. Research Methods in Education; Routledge: Oxfordshire, UK, 2018. [Google Scholar]
- BS 1192:2007+A2:2016; Collaborative Production of Architectural, Engineering and Construction Information. British Standards Institution: London, UK, 2016.
- PAS 1192-2:2013; Specification for Information Management for the Capital/Delivery Phase of Construction Projects Using Building Information Modelling. British Standards Institution (BSI): London, UK, 2013.

| Categories | Magnitude of Risk Factors | ||||
|---|---|---|---|---|---|
| Legal–Contract Aspect | Very Low Risk | Low Risk | Medium Risk | High Risk | Very High Risk |
| Contract obligations caused by unified documentation | 11 | 0 | 29 | 27 | 33 |
| Professional licensing issues | 8 | 2 | 23 | 29 | 38 |
| Lack of supportive BIM-collaboration contract form | 15 | 6 | 21 | 25 | 33 |
| Issues with legal differences in various countries laws | 11 | 2 | 20 | 40 | 27 |
| Average (%) | 11.25 | 2.5 | 23.25 | 30.25 | 32.75 |
| LSTM | Equilibrium state | <<<<<<<< | Disequilibrium state | ||
| >>>>>>>> | |||||
| BIM-RBS (Risk Factors) | BIM-RBS-MS (Management Strategies) | References |
|---|---|---|
| Conditions of the Agreement | Incorporate BIM standards and protocols into the contract guidelines, such as:
| [3,4,5,6,10,11,20,56] |
| Data security | Establish data security policies and inspection procedures and assign responsibilities for data backup and recovery. (model creation/signing the contracts with their subsets) | |
| ICT protocols and liability | Employ common data environment (CDE) and BIM execution plan (BEP) to promote data sharing and cooperation | |
| Intellectual property and copyright ownership Model ownership | In the contractual agreement, establish intellectual property rights, copyright ownership, and licenses for the usage of the model. (updating LOD table and modelling requirements) (IFC) (BIM protocol) | |
| Data infringement and confidentiality. | BIM data governance; protect confidential data from corruption, theft, or manipulation by project players | |
| Hosting and archiving of BIM Files/Missing files/Authenticity of the files/File misuse/Adequacy and method of transferred files | Define BIM, integrated model and modelling requirements | |
| Access rights to specify model users and the authority to share information with other parties | Define model element, production and delivery table with naming convention | |
| BIM model issues: quality control, errors, inaccuracy, inconsistency; integrity and responsibility of model. | Define LOD, availability of information and technology, and licensing of model. | |
| Method of resolving clashes | Define model user and author | |
| Contradiction between BIM and construction method | Define project information requirements | |
| Unclear rights, legal obligations and responsibilities | Define the role of BIM coordinator, relationships between BIM stakeholders in the contracts and appendix. Establish standards and guidelines for BIM adoption. | |
| Uncertainty of the current status of legal system in country where BIM is adopted | Government schemes with clear standard/duty of care for each project stakeholder | |
| Modification rights | Seek permission from copyright owner | |
| Legal status of the BIM Model as the ‘single source of truth’ | (Using metadata, e.g., Map viewer BIM without disclosures) (BEP) (Addendum) Industry-wide cultural change | |
| Unclear BIM standards and protocols used in contract | (ISO; PAS; BSI Standards) CIC/BIM Protocol |
| Stakeholder | Recommendation | Knowledge and Innovation Impact |
|---|---|---|
| Construction Industry | Adopt the BIM-RBS Matrix during contract preparation and project planning. | Converts tacit legal/contractual risks into explicit knowledge, reducing disputes and enabling collaborative innovation. |
| Use the BIM-RBS–MS Nexus to guide tailored management strategies. | Integrates digital, legal, and organisational knowledge streams to enable effective innovation diffusion. | |
| Invest in training and capacity building for BIM managers, legal advisors, and project leaders. | Builds absorptive capacity to operationalise frameworks and embed innovation into daily practice. | |
| Policymakers and Standard-Setting Bodies | Integrate the BIM-RBS framework into BIM standards (e.g., ISO 19650, NEC, JCT, CIC). | Standardises risk knowledge, ensuring scalability and comparability across projects and countries. |
| Develop dispute resolution protocols tailored to BIM environments. | Provides knowledge-based mechanisms for fair and timely resolution, enhancing trust in BIM adoption. | |
| Promote incentives for collaborative risk-sharing (e.g., shared risk–reward). | Aligns stakeholder knowledge and interests, fostering organisational innovation and reducing adversarial practices. | |
| Research and Academia | Extend investigations into socio-organisational, eco-financial, and techno-organisational perspectives. | Expands the knowledge base by embedding multidisciplinary perspectives into innovation adoption. |
| Empirically test the BIM-RBS Matrix across jurisdictions and project scales. | Validates knowledge transferability, ensuring global relevance and adaptability. | |
| Advance theoretical development on the legal–contractual dimension in BIM adoption models. | Strengthens the knowledge foundations for innovation governance in construction and allied industries. |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2025 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Dogonyaro, I.; Elnokaly, A. Enabling BIM Innovation Through Knowledge-Driven Legal–Contractual Risk Management: A Novel Strategic Risk Breakdown Structure. Appl. Sci. 2025, 15, 13038. https://doi.org/10.3390/app152413038
Dogonyaro I, Elnokaly A. Enabling BIM Innovation Through Knowledge-Driven Legal–Contractual Risk Management: A Novel Strategic Risk Breakdown Structure. Applied Sciences. 2025; 15(24):13038. https://doi.org/10.3390/app152413038
Chicago/Turabian StyleDogonyaro, Ibrahim, and Amira Elnokaly. 2025. "Enabling BIM Innovation Through Knowledge-Driven Legal–Contractual Risk Management: A Novel Strategic Risk Breakdown Structure" Applied Sciences 15, no. 24: 13038. https://doi.org/10.3390/app152413038
APA StyleDogonyaro, I., & Elnokaly, A. (2025). Enabling BIM Innovation Through Knowledge-Driven Legal–Contractual Risk Management: A Novel Strategic Risk Breakdown Structure. Applied Sciences, 15(24), 13038. https://doi.org/10.3390/app152413038
