You are currently viewing a new version of our website. To view the old version click .
Engineering Proceedings
  • Proceeding Paper
  • Open Access

7 November 2025

Development of Integrated Framework for Automated Construction Progress Sensing, Monitoring and Evaluation †

and
Department of Industrial and Systems Engineering, University of Pretoria, Pretoria 0028, South Africa
*
Author to whom correspondence should be addressed.
Presented at the 12th International Electronic Conference on Sensors and Applications, 12–14 November 2025; Available online: https://sciforum.net/event/ECSA-12.
This article belongs to the Proceedings The 12th International Electronic Conference on Sensors and Applications

Abstract

The construction industry is increasingly adopting digital technologies to enhance productivity and efficiency, in alignment with the principles of Construction 4.0 (C4). The progress and advances recorded thus far are largely due to advancements in cyber-physical systems (CPS), computational processing power, deep learning solutions, robotics, and other related technologies. However, a major challenge in this research space is the lack of an integrated solution for both the interior and exterior construction environments, which has led to fragmented data, hindering efficiency. Several researchers have proposed frameworks in recent years that focused on either indoor or outdoor construction environments; this approach has resulted in the creation of siloed information, to the detriment of the C4 ideals and principles. In this study, a comprehensive system architecture for raw data captured using sensors and other inputs to provide useful insight for the construction team and stakeholders was mapped out. This study presents an integrated framework of various technologies for both indoor and outdoor construction environments. The solution provided for localisation algorithms and technologies such as Simultaneous Localisation and Mapping (SLAM), odometry, and inertial measurement unit (IMU) devices. The unified 5-level Cyber-Physical Systems (CPS) architecture was used as the primary architecture, and it was compared with the IoT Architecture layers in terms of data analytics and management perspectives. The Digital Twin (DT), which sits at the cyber level of the architecture, warehouses and tracks in real-time the dynamic complexities of the construction site throughout the project life cycle, serving as the single source of truth for the project. This system architecture and framework presented in this research contributed towards advancing the field of construction automation by offering a scalable solution for efficient construction in project management.

1. Introduction

The planning and implementation of large and complex construction and installation projects are often rife with cost overruns due to schedule delays and rework [1]. This is often a result of improper constructability considerations at the design phase of the project and inaccurate schedule and cost estimates at the planning phase. This can also be a result of the inability to properly capture, access, and respond correctly to the variabilities that arise from the dynamic nature of the construction and installation site [2]. This study focuses on creating an integrated framework for capturing construction activity data and variations from project baselines during the construction and installation phase of the project lifecycle, utilising emerging technologies.
Traditionally, construction activities are captured in logbooks and photographic images, which are later transferred into project report templates and fed into the construction management software manually. This workflow leaves a lot of room for error due to mistakes as a result of human fatigue and other factors. The data and information collected are also often siloed within each discipline, department, and subcontractor’s repository/databases [3]. This creates friction in the flow of information, impacting the ability of the project management team to make data-driven decisions based on the current state of the construction and installation project. The data/information captured is also sometimes subjective [2], and often lacks positional context, as similar geometry and aesthetics can be found at different locations within the construction site.
To bridge the gap highlighted, information technology systems are used to bridge the physical and digital aspects of the construction industry. While the use of technology is not new to construction, the level of connectedness, speed of execution, and cost of execution are rapidly making it ideal for the construction engineering and execution phase, as well as for the entire project lifecycle. Embedded cyber-physical systems are enabling this integration towards the goal of C4 [4].
The technology adoption rate in the construction industry lags behind that of other sectors, such as manufacturing [5]. This has resulted in low productivity, cost overruns, and safety issues, among others [6]. However, there has been an increase in the adoption rate of technology in the fourth industrial revolution (4IR) era.
There are several emerging technologies—Cyber-Physical Systems (CPS), Internet of Things (IoT), Big Data, Cloud Computing, Wireless Sensor Networks (WSN), and Radio Frequency Identification—that are now being adopted to reduce mistakes and provide objects (data and visual images) with the metadata that provides the context that previously lacked. These IT systems come as standalone or integrated embedded systems, which include physical environment, embedded computing devices, and smart objects that indicate real-time data that are processed into the workflow and then provide insights that are used by the construction project management team for making project decisions.
Construction 4.0 (C4), inspired by Industry 4.0, has emerged as a paradigm shift emphasising the integration of cyber-physical systems (CPS), automation, and data-driven decision-making to enhance efficiency and sustainability to eventually achieve autonomous intelligent systems in the construction industry. The key enablers include Internet of Things (IoT) sensors, robotics, building information modelling (BIM), and artificial intelligence (AI), which facilitate real-time monitoring and predictive analytics [5]. It is important to note that the goal of C4 is not to digitalise our current construction approaches and workflow, but to re-imagine an autonomous, self-adapting intelligent system that dynamically responds to variation and trends outside the established project baseline [7].
The outdoor construction industry exhibits far more complexity, variability and uncertainty compared to manufacturing, which is mostly characterised by repeated operations to produce a specific product in a controlled environment. This means directly adopting the Industry 4.0 principle (the foundation for C4) is not recommended [4].
There are several data collection points in a project’s construction activities. The data is typically siloed in separate repositories and databases across different disciplines. There is therefore a need to create a framework that synchronises and coordinates data from various cyber-physical data sources into an operable and optimisable data storage that can be turned into insight for all technical teams and other stakeholders [4].

1.1. Problem Statement

Despite these advancements in the adoption of IT in construction, a significant gap persists: the existing frameworks for construction progress monitoring focus either on indoor or outdoor environments. The two environments employ different systems due to the distinct nature of lightning, occlusions, and satellite access, among other variables that vary between the two environments. For instance, outdoor monitoring often relies on drones and GPS-based systems, while indoor solutions utilise fixed cameras and RFID tags. This fragmentation results in inefficient data management, delayed decision-making, and increased project risks. It is therefore imperative to develop an integrated framework that highlights the differences, limitations, and mitigating/bridging approaches. A major challenge faced in this research space is the lack of an integrated solution for both the interior and exterior construction environments has led to fragmented data, hindering efficiency.
The outdoor–indoor paradigm is basically that of a difference in the efficiency of the sensors used. It is important to ensure that the dichotomy is grounded in an integrated workflow for implementation. Therefore, a systems architecture that showcases the overall flow of data and information, highlighting the systems and technologies involved from data collection to insight and from perception to cognition, is included.
Recent studies have explored partial solutions that focus on the combination of different technologies. For example, automated progress monitoring models using lidar scan capture, as well as a photogrammetry approach, a computer vision (CV) technique that utilises convolutional neural networks (CNNs), reconstruct site images to form a 3D model of the site. Several combinations have been proposed for the indoor and outdoor site environment, based on cost, internet access, satellite access, and lightning conditions, among other limiting factors. Other researchers embedded IoTs into the workflow to achieve a digital twin (DT). Digital Twins (DTs) have gained traction for lifecycle management, offering virtual replicas that synchronise with physical assets via IoT and BIM integration. However, only a few frameworks address the integration of indoor and outdoor monitoring within a unified DT ecosystem.

1.2. Research Objectives

The objectives of this research are to develop an integrated framework for automated construction progress sensing, monitoring, and evaluation. This was carried out at two levels. These include:
  • Highlight the system architecture that highlights the connectivity of different data collection, process and executing layers of the construction management operation in the Construction 4.0 context. Many segmentation perspectives will be considered within the framework.
  • The study also highlights an integrated framework that highlights the complementary use of sensors in an indoor and outdoor construction environment.

1.3. Research Contributions

There is an increasing need for civil and construction workers to not only understand the art of construction, but also IT skills, especially sensing technologies and data analytics knowledge, to function in the current data-driven construction practices. While many researchers have discussed the different aspects of technological use in construction, it is important to present a big-picture, top-down, systems approach in order to see how they are all connected.
This study addresses the gap highlighted by first presenting a system architecture of a construction site management using the unified 5-level Cyber-Physical Systems (CPS) architecture [8], and the broad architecture was delineated to focus on the integrated framework for construction progress sensing, monitoring, and evaluation. The integrated framework combines sensors, the fundamental building block for perception. It combines them to achieve localisation technologies (e.g., Simultaneous Localisation and Mapping (SLAM), odometry, Inertial Measurement Units (IMUs), cameras, CPS, and IoT sensors); deep learning (computer vision (CV)); and BIM within a DT platform. The objective is to enable automated, real-time progress sensing, monitoring, and evaluation for both indoor and outdoor environments, promoting scalable C4 adoption. This research contributed towards advancing the field of construction automation by offering a scalable solution for efficient construction in project management through the use of an integrated framework.

3. System Architecture and Integrated Framework

To fully deploy C4, it is important that business executives, engineers and decision-makers in the Architectural, Engineering and Construction (AEC) space understand what the system architecture of an integrated construction operations system that caters for the entire project lifecycle is like. It is therefore important to present the system perspective for clarity of execution. The presented system architecture will advance the field of construction automation by offering a scalable solution for efficient construction project management operations.

3.1. Review of the Previous Framework

Construction sites are highly dynamic environments characterised by continuous changes in workers, machinery, and equipment, making prediction challenging [11]. Preventing construction site accidents requires systematic management and continuous monitoring across various dimensions.
Ref. [25] posit that IoT and communication technologies, such as Cellular Communications (LTE, 5G), Bluetooth Low-Energy (BLE), Wi-Fi, and UWB, enhance safety by enabling real-time data collection and alert notifications. Individual sensing technologies are suitable tools for monitoring construction sites. However, most existing research focuses on specific technologies and limited scopes, with insufficient studies addressing comprehensive monitoring for areas such as worker safety management and quality control [11]. Ref. [6] conducted an extensive literature review of C4 and developed a four-layer implementation plan for adoption throughout the project’s lifecycle, using a case study approach. Their work presented an integration framework for nine C4 technologies. These are BIM, augmented reality (AR), and virtual reality (VR). Ref. [8] proposed an architecture that leverages CPS to bridge physical and digital realms. With sensors as the core for real-time data collection, the unified 5-level architecture can guide the deployment of CPS. The proposed architecture expanded the traditional two functional components of CPS, which they described as “the advanced connectivity that ensures real-time data acquisition from the physical world and information feedback from the cyber space; and intelligent data management, analytics and computational capability that constructs the cyber space.”

3.2. Framework Overview

The proposed integrated framework is structured as a multi-layer system inspired by C4 implementation models, comprising data acquisition, processing, integration, and visualisation layers. The unified 5-level CPS implementation architecture, as proposed by [8], is adopted as the base architecture. The architecture is analysed from the perspective of data extraction and acquisition, data analysis, data engineering, and data management.

3.3. Unified 5-Level CPS Implementation Architecture (5C Architecture)

The unified 5-level Cyber-Physical Systems (CPS) architecture, commonly known as the 5C architecture, serves as a guideline for implementing CPS in Industry 4.0 (I4) manufacturing environments. 5C structures the progression from raw data acquisition to advanced system adaptation. Levels of data analysis (or analytics maturity) align closely with these 5C levels, evolving from basic descriptive processing to sophisticated adaptive decision-making. Figure 1 below shows the breakdown of the 5C architecture.

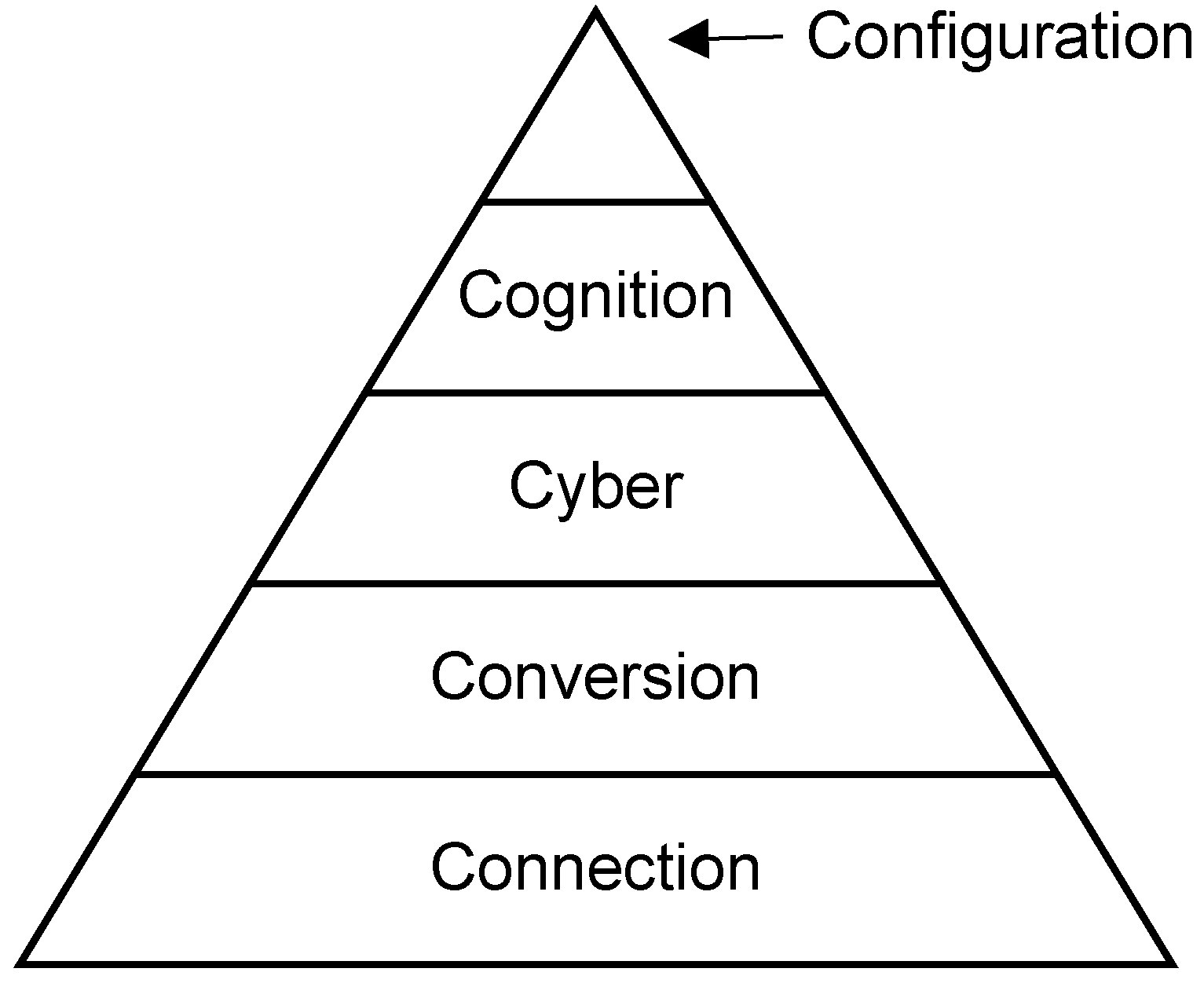

Figure 1. Unified 5-level CPS implementation architecture.
Though the architecture was originally proposed for manufacturing systems, this study has adapted it for the construction project monitoring and management systems. The implications of the [8] are discussed below:
  • Smart Connection Level (Connection): Here, devices or sensors and other Internet of Things (IoT) technology are used to collect construction-related data. The data includes environmental data (temperature, humidity, lightness, atmospheric pressure), state of work, surveillance information, images and videos [8]. The focus is on the collection and extraction of accurate, reliable raw data from physical assets via sensors and networks.
  • Conversion Level (Conversion): At this level, the data collected at the connection layer is converted to insight/information through statistical tools and machine learning for prediction, forecasting, and decision-making in construction operations and responding to the variations from the initially set baselines [8].
  • Cyber Level: At this level, the information collected is warehoused. In the C4 context, the information is collected in the same structured database to prevent information silos. This is the central data hub for the construction company/enterprise. The data collected across all is used to update the BIM, digital twin of the physical asset, Enterprise Resource Planning (ERP), project and construction management software. The data collected is used for predictive and prescriptive purposes [8].
  • Cognition Level: At this level, the data gathered is converted to information that guides the engineering, project, and construction team, as well as the necessary project stakeholders. The CMT uses the information to make decisions [8].
  • Configuration Level: At this level, feedback from the cyber level is used to adjust, improve, and correct the physical assets and the construct team activities dynamically and autonomously. In the context of construction project management, machine learning and deep learning algorithms are used to suggest preventive and corrective actions to the CPMT [8].
The goal and the core of the proposed integrated framework is the collection and management of construction data. If the collected data is not integrated, then the goal of C4 cannot be achieved. While the 5C architecture and others like it govern the systems’ connection to the people and project outcome, the implementation is governed by data management. It is therefore important to consider the data analysis and data management perspective.

3.4. Data Analysis Levels

Insights from collected and warehoused data are mined at different levels, ranging from basic data processing to advanced, autonomous decision-making. The levels are briefly described below.
  • Descriptive analytics answers the what question; it focuses on describing, summarising, and providing real-time insights into what is happening in the raw data collected. This level is used for monitoring the performance or status of a construction site.
  • Diagnostic analytics answers the why question; it provides deeper insight that helps to determine why something is happening. Here, the root causes of issues or anomalies are identified through data correlation and analysis.
  • Predictive analytics forecasts what will happen by using historical and current data to predict future events, like construction delay, cost overrun, or any other construction trends.
  • Prescriptive analytics recommends what should be performed to cause-correct any anomalies and variations. This level of analysis supports decision-makers with actionable insights needed to optimise construction processes or mitigate risks.
  • Adaptive/Autonomous analytics uses autonomous, self-optimising actions where systems dynamically adjust based on real-time insights, ensuring resilience and efficiency. AI/ML/DL technologies are used to imitate human decision-making. The systems continuously learn from new data to improve their ability to analyse and make decisions over time.
Each of the levels above corresponds to the levels in 5C Architecture.

3.5. Data Management

Data management is the structured process, policy, and tools used for organising, storing, and governing data to ensure its quality, accessibility, and security throughout its lifecycle. Data management ensures that the data being collected and the metadata are well integrated and interoperable across all applicable systems and devices in the workflow. This is achieved by stating the acceptable data formats, connectivity protocols, and initial quality checks. In the 5C architecture context, data management ensures that, from the raw data acquisition to autonomous system optimisation, data management defines the foundational infrastructure and governance to support this progression.

Stages of Data Management

Data management from raw construction data collected onsite to advanced, automated systems in the 5C architecture can be explained in five stages, described below:
  • Data Collection and Ingestion: Focuses on gathering raw data from various sources, such as sensors, IoTs, CPS, databases, or manual inputs, ensuring accurate and secure capture. Here, data sources are configured, establishing connectivity protocols, defining metadata, and performing basic validation. This is equivalent to the ‘Extract’ level of the data engineering ETL (Extract, Transform, and Load) process.
  • Data Processing and Quality Management: The goal here is to clean, transform, and normalise raw construction data extracted into data that is consistent, accurate, and usable for analysis. Data quality for reliable insights is the focus here. This level is equivalent to the ‘Transform’ level of the data engineering process.
  • Data Storage and Integration: Focuses on organising and storing data in scalable repositories, such as databases or data lakes, while integrating data from multiple sources for comprehensive analysis. This level ensures data is structured and accessible. This level is equivalent to the ‘Load’ level of the data engineering process.
  • Data Access and Governance: Ensures data is discoverable, secure, and compliant with regulations, enabling effective use in analytics and decision-making. This level focuses on governance policies and tools to manage data access and usage.
  • Data Automation and Optimisation: Enables real-time, automated data management to support dynamic, self-optimising applications. This level focuses on streaming data pipelines and automated governance to facilitate advanced, autonomous systems.
Each of the levels above corresponds to the levels in 5C Architecture.

3.6. Architecture Interpretation Methodology/Approach

The proposed system architecture adopts the 5C IoT architecture paradigm, a 5-layer architecture proposed by [8] as its base architecture. The 5C architecture (connection, conversion, cyber level, cognition, and configuration level) is then compared with similar IoT architectures with varying numbers of architecture levels/layers and nomenclature. IoT layers are also compared with data analysis and management perspectives. Figure 2 below provides an overview of the architecture.

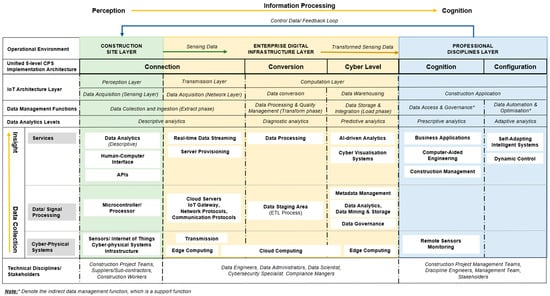

Figure 2. Architecture Methodology/Approach Schema.

From a broad data flow perspective, data flows vertically from the bottom up in each layer of the architecture; data is collected at the bottom using CPS to capture data, it then goes through the data/signal processing stage, and then to the services stage at the top, where services are rendered. The level of insight achieved at each level of the IoT architecture corresponds to its respective stage in data analytics.
In the horizontal direction, tagged ‘information processing’, data/information flows from left to right across the IoT architecture layers. The horizontal direction is a spectrum from perception to cognition; the left is the perception region, and the right is the cognition region. The level of information increases to the right to achieve a higher level of useful decision-making data/information. This corresponds to the level of data analytics, until it reaches the cognition stage/level on the right side of the architecture.
In the vertical, there are four main groups for the rows, these are as follows: the operational environment, IoT architecture/data perspectives, data flow, and the technical disciplines/stakeholders. This is shown in Figure 2 below.
On the horizontal, there are three (3) operation environments these are the construction site layer, the enterprise digital infrastructure layer, and the professional discipline layer. These layers are colour-coded for easy delineation, as shown in Figure 3 below. The technical disciplines responsible for each of the layers are discussed below, and are listed in Figure 5.

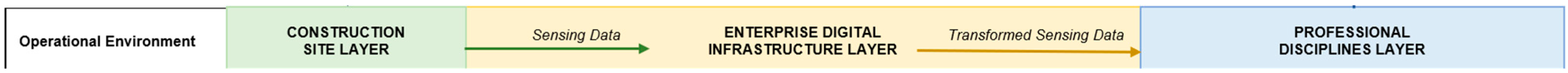

Figure 3. Operational Environment Layers.
Some of these main rows have sub-groups, which are indicated and explained below:
  • Operational environment: This group indicates the environment where the operation is being carried out. There are three operational environments in this framework, they are as follows: the construction site layer, the enterprise digital infrastructure layer, and the professional disciplines layer. These layers are explained below.
    Construction site layer: This is the outdoor brownfield or greenfield construction site where the construction activities are taking place. The sensors, actuators, and CPS are deployed in this environment. As indicated in the schema, sensing data collected in the Perception layer of the Connection level of the 5C architecture is the output of this layer and is then transmitted through the Transmission layer, still at the Connection layer of the 5C architecture, through to the enterprise digital infrastructure layer. The disciplines that interact directly or indirectly with this operational environment include the construction project teams, suppliers/subcontractors, construction workers, etc.
    Enterprise digital infrastructure layer: This layer is the digital infrastructure layer of the construction company (enterprise). The infrastructure here helps with the transmission and processing of the sensing data and the creation of a single source of truth for all enterprise systems. The layer is not created and maintained by civil/construction project teams but by the data engineering team. The data engineering team ensures the appropriate data is extracted, transformed and loaded, guided by the enterprise data governance policies, and is made available to each team/discipline for decision-making. The IoT layers (transmission layer and computation layers), as well as the data management and analytics layers, were previously discussed in Section 3.3, Section 3.4 and Section 3.5.
    Professional disciplines layer: This layer is where business, engineering, construction, and other management teams carry out analysis, simulation, visualisations and decision-making. There is a feedback mechanism tagged ‘control data/feedback loop’ to pass signal/information to the sensors and actuators on site, as well as the construction project team on the construction site. The disciplines that interact directly or indirectly with this operational environment include the construction project management teams, discipline engineers, management team, and other stakeholders.
  • IoT architecture/data perspectives: This group deals with the IoT architecture, data analytics, and data management aspects of the processing of perceived data obtained from sensors to a higher level of cognition across the architecture levels. The 5C architecture serves as the baseline, and the various IoT architectures with varying numbers of architecture levels/layers and nomenclature, as well as the data analytics and data management levels equivalence, are indicated in Figure 4 below.

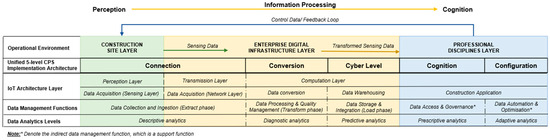

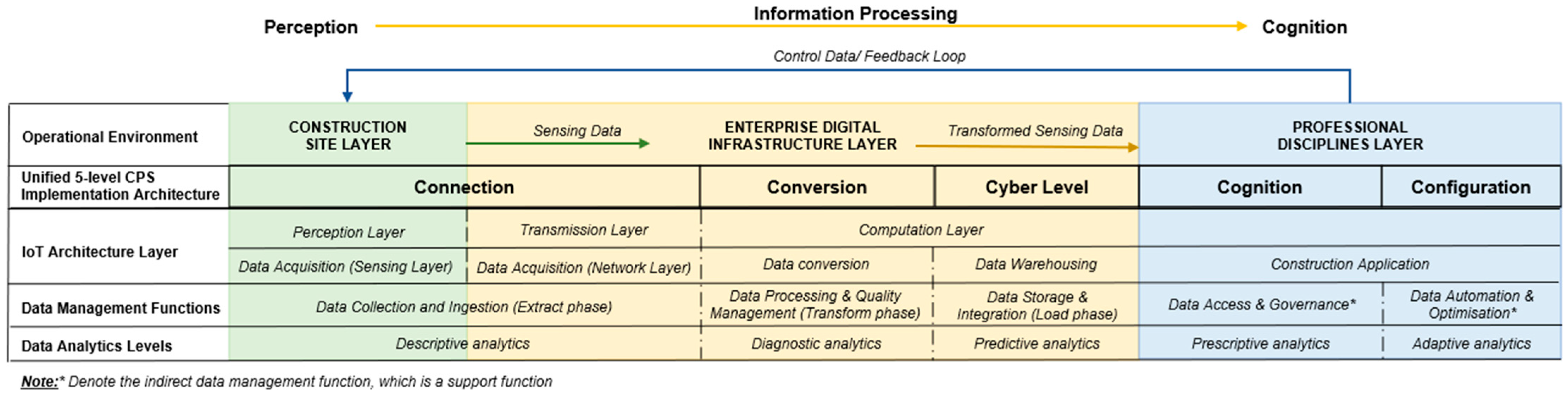

    Figure 4. IoT architectures and data perspectives.
  • Data Flow: Data flows vertically from the bottom up in each layer of the architecture; data is collected at the bottom using CPS to capture data and then processed in the data/signal processing stage, and then used at the services stage at the top, where services are rendered.
  • Technical disciplines/stakeholders: The disciplines that interact directly or indirectly with each of the operational environments were listed in the operational environment section above and listed in Figure 5.

3.7. Systems Architecture for Integrated IoT/CPS for Digital Construction Site Management

The system architecture is further expanded in two steps: Integrated Framework IoT/CPS in Construction Progress Sensing, Monitoring, and Evaluation—block view (Figure 5), and Integrated Framework IoT/CPS in Construction Progress Sensing, Monitoring, and Evaluation—expanded view (Figure 6). Figure 5, the block view, provides the group names of each of the sections in the architecture, while Figure 6, the expanded view, the expanded view provides more details about each of the groupings. Each detail in the expanded view includes activities, technologies, and broad business operations as may apply to the section in concern.

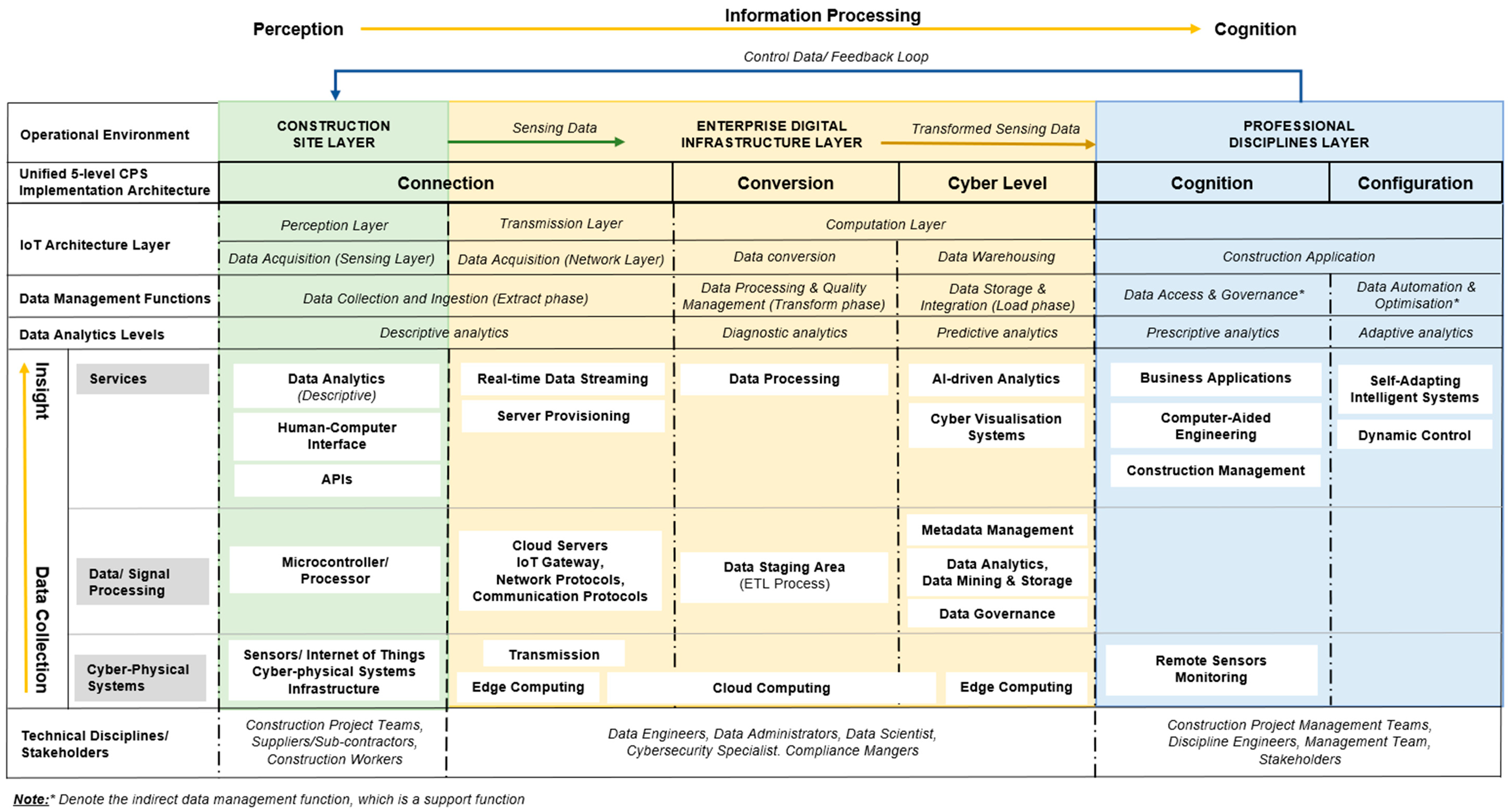

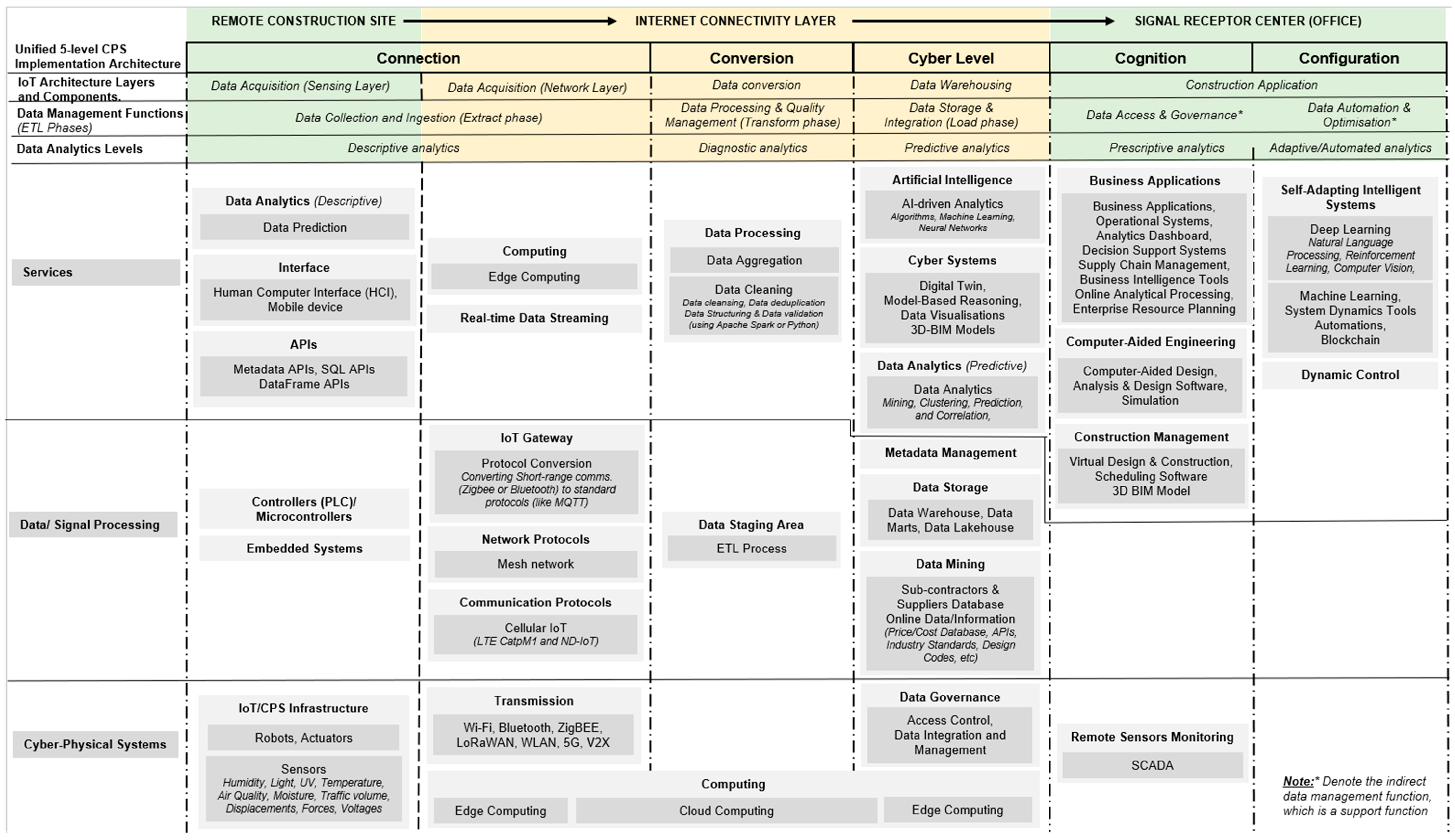

Figure 5. Integrated Framework IoT/CPS in Construction Progress Sensing, Monitoring, and Evaluation—Block View.

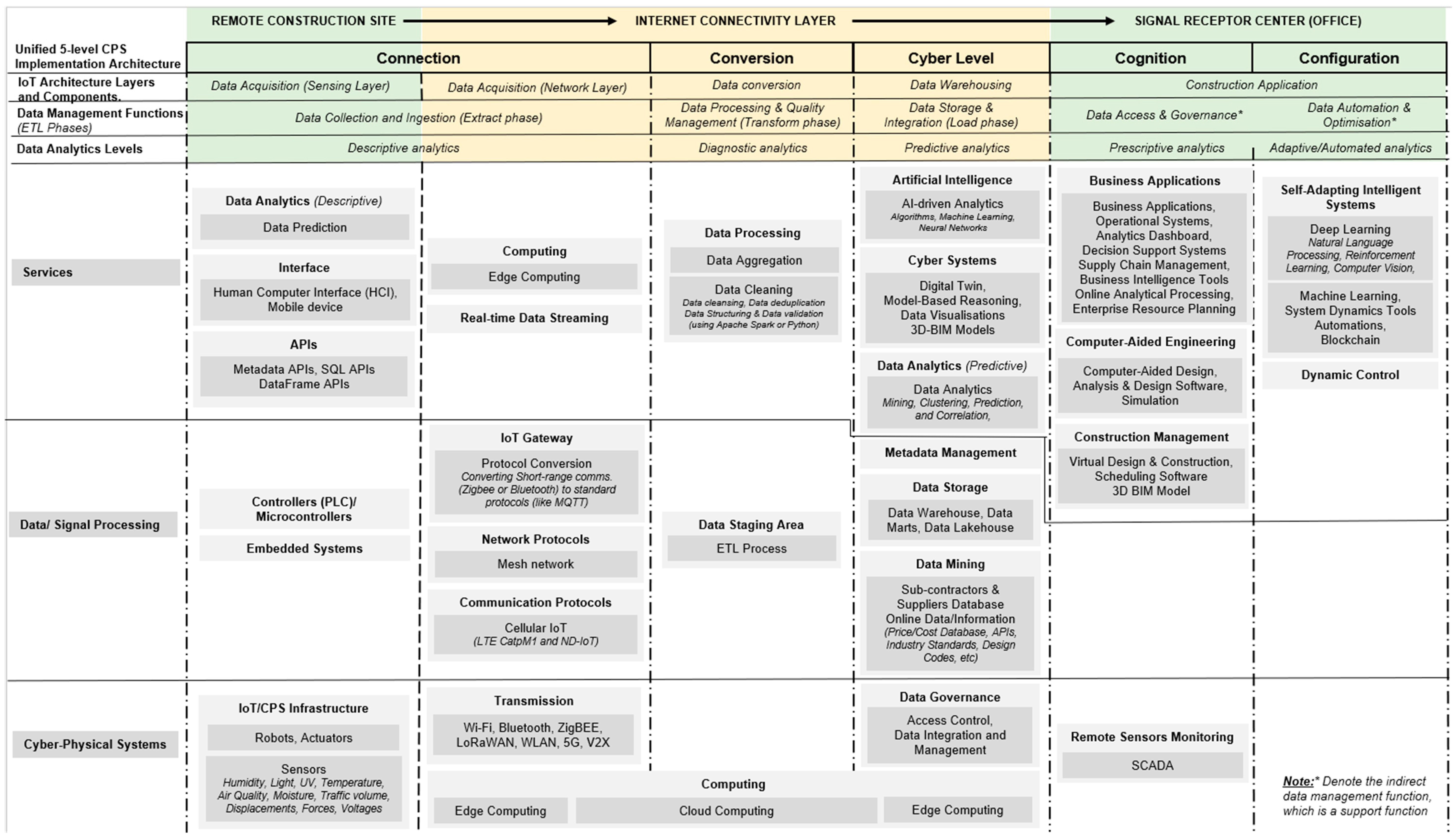

Figure 6. Integrated Framework IoT/CPS in Construction Progress Sensing, Monitoring, and Evaluation—expanded view.

3.8. Integrated Framework for IoT/CPS in Construction Progress Sensing, Monitoring and Evaluation

As shown in Figure 7 below, the integrated framework for IoT/CPS being developed is divided into four segments: The vehicles, the sensors, the transmitters, and the processors. The vehicles, which serve as a medium of carriage for other sensors, include robots, unmanned aerial vehicles (UAVs)/drones. The sensors, which are used to detect, measure and capture information about human activities, material movement, and the utilisation of equipment/machine operations, as well as construction progress. This includes IoT devices, laser scanners, cameras, and GPS. Also, the transmitters used to send information include the internet, cables, protocols, etc. And lastly, the processors, which extract, transform and load the CPS data into the data infrastructure (data lake, data warehouse). The data is then filtered and made available to the relevant enterprise system from the data mart of the particular system. Tools and technologies used include algorithms, machine learning, and deep learning technologies (computer vision, natural language processing). The segments can then be grouped into (1) The Information Propagation, which includes the vehicles, sensors, and transmitters, and (2) The Information Processing, which includes the processor [12,26].

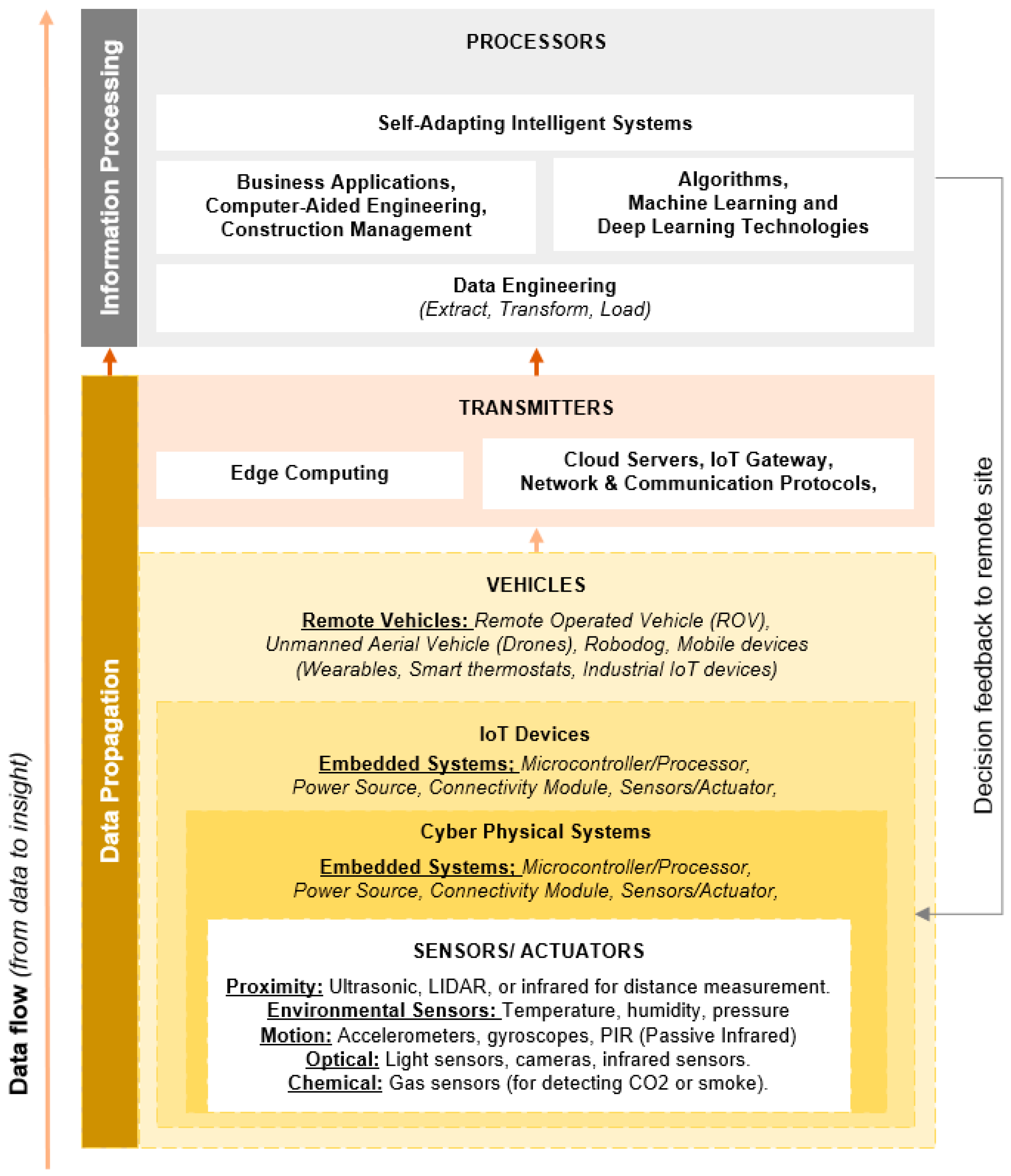

Figure 7. Integrated Framework IoT/CPS in Construction Progress Sensing, Monitoring, and Evaluation.
In the integrated framework presented above, data flows from the sensors in the embedded system and is empowered for local signal processing by the CPS, which accesses the other systems through IoT. It can be observed that data flows from the base, at the sensor level, to the processor level. Feedback can then be sent back to the construction site in the form of a project parameter update, project schedule updates, and remote access of sensors and actuators, etc. It should be noted that the integrated framework is a high-level expanded sensor segment of the previously discussed system architecture for digital construction site management. The usage of the sensors to be used in indoor and outdoor environments was discussed in Section 2.6—Implementation Approaches, Algorithm, and Technology deployed in Positioning, Localisation and Navigation in Indoor and Outdoor Environments. (Note: This framework can be better interpreted when viewed through the overall system architecture.) This can be adopted in the construction operations management, such as project management.

4. Discussion

The integrated framework will be used to visualise the physical and digital infrastructure architecture, as well as the data management practice required to prevent data silo and achieve a single source of truth for the construction project throughout its lifecycle. The presented framework also fosters communication and collaboration among the multiple disciplines in a construction project. It also enhances stakeholder engagement [27].
The integrated framework overcomes siloed monitoring by unifying indoor and outdoor data streams, aligning with C4 four-layer models. Compared to CV-only approaches, it enhances scalability through DT integration. The challenges in the presented framework include high initial sensor costs and data privacy concerns.
The integrated framework provides a system overview—from the base data capture component to the configuration level, which is more of a futuristic level. The prevailing C4 use cases are currently at the cognition level, where, at best, the AI and other related systems might suggest preventive and corrective actions, which are still subject to human subjective decision for implementation. Therefore, while the 5C Architecture adopted in this research work has five levels, the implementation or setting up of the systems in the framework is not in the civil engineering and construction project management disciplines/domain, as shown in the discipline layer of the integrated framework. That said, it is important for civil engineers, construction project management professionals, policy makers, and researchers to have a high-level overview of how to achieve higher productivity through the deployment of C4 systems.

4.1. Research Limitations

The presented framework has not been tested in simulations; real-world deployments may face environmental interferences. Future work could incorporate edge computing for faster processing. While an effort was made to include the relevant elements, there are some that may not have been included in the framework. Also, while a hypothetical use case was analysed, the presented integrated framework was not validated in a real-life project/use case.

4.2. Future Recommendation

It is important to implement the presented integrated framework in order to gain relevant insights and the necessary updates required from feedback. Future studies will thus focus on extending and bridging the gaps highlighted. It is also imperative to dive deeper into the Configuration layer to achieve the autonomous, self-adapting, and intelligent goal by investigating the feasibility of adopting agentic AI technologies.

4.3. Conclusions

This study presents a sensor-driven framework for automated construction progress monitoring, integrating SLAM, IoT, CV, BIM, and DT for indoor–outdoor unity. It advances C4 by enabling efficient, scalable project management, with potential for widespread industry adoption. This research has contributed towards advancing the field of construction automation by offering a scalable solution for efficient construction in project management through the use of an integrated DT framework.
