Abstract
From a managerial perspective, project success hinges on estimates at completion as they allow tailoring response actions to cost and schedule overruns. While the literature is moving towards sophisticated approaches, standard methodologies, such as Earned-Value Management (EVM) and Earned Schedule (ES), are barely implemented in certain contexts. Therefore, it is necessary to improve performance forecasting without increasing its difficulty. The objective of this study was twofold. First, to guide modeling and implementing project progress within cost and to schedule Performance Factors (PFs). Second, to test several PFs utilized within EVM and ES formulae to forecast project cost and duration at completion. Progress indicators dynamically adjust the evaluation approach, shifting from neutral to conservative as the project progresses, either physically or temporally. This study compared the performance of the progress-based PFs against EVM and ES standard, combined, and average-based PFs on a dataset of 65 real construction projects, in both cost and duration forecasting. The results show that progress-based PFs provide more accurate, precise, and timely forecasts than other PFs. This study allows practitioners to select one or more of the proposed PFs, or even to develop one, following the guidelines provided, to reflect best their assumptions about the future course of project performance.
1. Introduction
Project monitoring and control processes are crucial to project success. The larger and more complex a project, the higher the likelihood of risks emerging and compromising its performance []. Therefore, it is essential to monitor project activities and implement control actions as needed [].
Control actions are developed based on Estimates at Completion (EACs) obtained from evaluating project performance. The extent of control actions depends on the deviation between the EACs and their corresponding planned values []. However, EACs are subject to variability, as various factors influence them, including the interrelationships among project variables [].
Earned Value Management (EVM) [] and its extension, Earned Schedule (ES) [], stand among the most widely adopted project-monitoring methodologies. EVM compares the project Work Performed () and the Actual Cost () with the Performance Measurement Baseline (PMB), which consists of the Work Scheduled () values from the project start and its Planned Duration (PD). In contrast, ES focuses on the homonym metric (), representing the time when the current was scheduled to be attained, as per the PMB.
Previous research has proven EVM and ES effective in multiple projects []. However, both methodologies overlook cost and schedule performance relationships and trends []. Furthermore, neither EVM nor ES incorporate project progress into the evaluation of EACs. In contrast, the forecasting approach should be contingent on whether the project performance has stabilized [].
The limitations of EVM and ES have sparked studies exploring alternative methods for project performance forecasting. These studies can be divided into two categories: those that build on and aim to improve EVM and ES and those adopting a different approach, including nonlinear regression, Bayesian inference, and Artificial Intelligence (AI).
Despite the advancements in project-monitoring methodologies, the adoption of EVM and ES remains restricted in specific scenarios []. Additionally, the complexity of sophisticated methods poses challenges for practical implementation by practitioners []. Consequently, there is a pressing need to enhance project performance forecasting by refining EVM and ES without compromising their simplicity in application.
This study had a twofold objective. First, to guide modeling project progress and implementing it within project Performance Factors (PFs), and to propose a series of progress-based PFs to implement within EVM and ES formulae for evaluating the project cost and duration estimates at completion. Second, to benchmark the proposed progress-based PFs against EVM and ES standard, combined, and average-based PFs under the accuracy, precision, and timeliness criteria at the overall, project, and progress levels.
This paper is structured as follows. Section 1 introduces the background of the study and its objective. Section 2 describes standard and alternative methods to project performance forecasting, highlighting the research gap. Section 3 illustrates the proposed progress modeling, implementation, and benchmarking procedures. Section 4 presents the benchmarking results. Section 5 discusses the results obtained, providing theoretical and practical implications and describing the limitations of the method adopted. Lastly, Section 6 concludes by stating the study limitations and future research avenues.
2. Literature Review
2.1. EVM and ES
EVM assesses project performance, using three metrics: Actual Cost (), Planned Value (), and Earned Value (). Let t indicate time. Following Fleming and Koppelman [], the consists of the actual expenditures incurred by the , the corresponds to the budgeted cost associated with the , as per
and the corresponds to the budgeted cost associated with the , as per
EVM evaluates the project Cost Estimate at Completion () and Time Estimate at Completion (), using two different approaches. The is determined by the sum of the and the cost Estimate-to-Complete () [], which is evaluated through the ratio of the cost associated with the remaining work () to the cost Performance Factor (), as per
Instead, the is determined by the ratio of the to the schedule Performance Factor () [], as per
In standard EVM, the and the are set to the Cost Performance Index () and the Schedule Performance Index (), respectively. The former is the ratio of the to the [], as per
while the latter is the ratio of the to the [], as per
An index higher, equal, or inferior to 1 indicates performance superior to, on a par with, or below the PMB, respectively.
Previous studies have demonstrated EVM to be effective in cost forecasting [,] but not in duration forecasting. Specifically, studies have criticized because it relies on cost metrics (i.e., and ), which equal the of the project’s Actual Duration (), as per Equations (1) and (2), making the index converge to 1 as the project progresses [,]. This limitation has led to exploring alternative methodologies for schedule performance analysis.
ES was developed to overcome the limitations of . In ES, schedule performance is based on the metric, calculated as per
assuming linear progress between consecutive values []. Similar to Equation (3), the ES Time Estimate at Completion () is determined by the sum of t and the Time Estimate to Complete (), which consists of the ratio of the “remaining duration” () to the [], as per
In a standard ES, the corresponds to the ES Performance Index (), which is the ratio of to t [], as per
Unlike , the does not converge to 1 as the project approaches completion, remaining meaningful throughout the project duration.
Earlier studies have proven ES more effective than EVM in duration forecasting [,]. Nonetheless, both methodologies present further limitations, from assessing cost and schedule performances separately to neglecting trends []. These flaws have led researchers to explore alternative methods for project performance forecasting.
Studies on project forecasting methods fall into two categories. The first category entails those studies that rely on standard EVM and ES formulae but implement different PFs. This method prioritizes simplicity as it neither introduces further assumptions nor needs external data. Instead, the second category encompasses those studies that use formulae different from those used by EVM and ES, introducing additional assumptions or relying on external data to improve forecasting performance.
2.2. Performance-Factor-Based Forecasting Methods
PFs can be either time-invariant or time-based. Let x indicate the forecast target. Time-invariant PFs assume the form . The specific case in which
reflects the assumption by which the current Cost Variance (i.e., ) [] or the ES Schedule Variance (i.e., ) [] will remain the same until project completion (i.e., and ), whereas setting in Equation (4) reflects the assumption by which the project will end exactly on time (i.e., ). In contrast, time-based PFs assume the form , determining the rate of future accrual () or recovery () of cost overruns (if ) or schedule delay (if ).
Regarding time-based PFs, standard EVM uses the as the and the as the . These PFs reflect two assumptions: first, cost and time performances are unrelated, and second, future performance solely depends on the current one, ignoring any trends. To relax these assumptions, studies have proposed combined PFs and average-based PFs.
Combined PFs, combining cost and schedule performances, encompass products and weighted averages of the and the . Products include the EVM Critical Ratio (), as per
and the ES Critical Ratio (), as per
Weighted averages include the EVM Weighted Average (), as per
and the ES Weighted Average (), as per
where w denotes the weight.
Average-based PFs, accounting for past trends in cost and schedule performances, include the cumulative, moving, and exponential moving averages of standard and combined PFs. Let denote the x PF, where indicates cost and indicates schedule. Then, the Cumulative Average (CA) is determined, as per
the Moving Average (MA) is determined, as per
where k indicates the sample window, and the Exponential Moving Average (EMA) is determined, as per
where indicates the smoothing factor, and .
Combined PFs have been tested in cost forecasting [,,,,,] and duration forecasting [,,]. The same applies to the Cumulative Average and the Moving Average [,,], as well as to the Exponential Moving Average [,,]. In all the studies above, while the best PF depended on the specific project characteristics, the and the were proven the most robust.
2.3. Other Forecasting Methods
Alternative forecasting methods to improve performance forecasting offer more sophisticated modeling capabilities, but they come at the expense of increased difficulty in implementation. The methods include nonlinear regression, Bayesian inference, and AI.
Nonlinear regression studies are based on the properties of project S-curves. Specifically, the studies calculate duration and cost estimates at completion by fitting theoretical models to the and data, respectively, and projecting the resulting models forward. The method was tested in both cost forecasting [,] and duration forecasting [,]. The difficulties related to nonlinear regression lie in choosing the theoretical model and performing the curve-fitting procedure.
Bayesian inference methods rely on external data to evaluate the parameters of ex-ante distributions [] and use internal project-monitoring data to refine such distributions during project execution. These methods are applied to project S-curves [], to cost- and schedule-overruns probability [], and to risks-occurrences probability []. In adopting the Bayesian approach, the difficulties lie in defining the ex-ante distributions, collecting data to evaluate their parameters, and updating the parameters with the project in place.
AI algorithms use external data to build project-cost and duration forecasting models. Several reviews of AI applications in project monitoring are available, including [,,]. Algorithms include linear regression [], support vector machine [,,], tree-based methods [,], k-nearest neighbors [], ensemble methods [,], and artificial neural networks [,,,,,,]. The difficulty in using AI models lies in collecting the data and in the procedures required to prevent underfitting and overfitting.
2.4. Research Gap
Despite the potential improvements in forecasting performance, alternative methods to EVM and ES are rarely utilized in practice. This is due to several factors, chief among them being difficulty in implementation or, one step earlier, lack of data on which to base the necessary assumptions. For this reason, where the preconditions for adopting more sophisticated methods are lacking, practitioners need simple methods that do not deviate excessively from standard EVM and ES. In light of this, this study provides progress-based PFs to predict the project-cost and duration estimates at completion while maximizing the trade-off between prediction performance and implementation difficulty. All PFs consider the current state of progress, which is used to move from a conservative projection to a bottom-up projection as the project approaches completion.
3. Research Methodology
This section is divided into two parts. The first part introduces the PFs that will be tested and describes how to model and implement progress within them. The second part describes the benchmarking, including the procedures to preprocess the data and the criteria to evaluate the forecasting performance of the models implementing the PFs.
3.1. Progress-Based Performance Factors
This study tested four categories of PFs: standard, combined, average-based, and progress-based. Standard PFs include EVM and ES indexes. Combined PFs include combinations of standard PFs. Average-based PFs are evaluated by calculating different types of averages of standard and combined PFs. Lastly, progress-based PFs are evaluated by modeling and implementing progress within standard PFs.
Let denote the generic Progress Indicator. Then, should be expressed in terms of physical or time progress, and should range between 0% and 100% (i.e., ). In light of this, physical progress can be expressed as per while time progress can be expressed as per , where the subscript “s” distinguishes the scaled from the unscaled variable.
This study sought to integrate into the calculation, to shift from a neutral approach () to a more conservative one () as project performance stabilized. Since , could be implemented as a weight () or an exponent (). When implemented as a weight, was determined, as per
While determined , determined . When implemented as an exponent, was determined, as per
The effect of on was determined by both the sign and the value of , as per Table 1.
Table 1.
Combinations of and and their effect on .
The combinations of and determined the pace at which shifted from neutral to conservative.
To summarize, the standard PFs included 1, , , and . The combined PFs included , , , and . The average-based PFs were evaluated using all the standard PFs but 1 and the combined PFs; the parameters k and were set only once. The progress-based PFs were evaluated using all the standard PFs but 1, and all the possible combinations of , , , and as and . The total number of PFs amounted to 71; the complete list will be provided when presenting the benchmarking results.
3.2. Benchmarking
Benchmarking PFs involves testing them in cost and duration forecasting on a real project dataset. This phase entails five steps: Data Collection, Scaling, Interpolation, Forecasts Evaluation, and Performance Assessment.
3.2.1. Data Collection
Data Collection involves retrieving monitoring data from real projects to develop the testing dataset. This study used 65 projects selected from the Operations Research and Scheduling Research group of the Faculty of Economics and Business Administration at Ghent University (Belgium) database []. Selection criteria ensured projects experienced both cost and schedule variances throughout their execution. Table 2 provides the projects’ building type, the number of activities in the network, , , , and .
Table 2.
Projects properties.
3.2.2. Data Scaling
Data scaling involves expressing project data on a unitless scale. This step prevented projects with metrics expressed in different orders of magnitude from biasing the performance scores. Scaling was achieved by dividing the cost metrics (i.e., , , and ) by the and time metrics (i.e., t, ) by the . All the scaled metrics but and were denoted using the subscript “s”. All the scaled metrics but t, , and ranged between 0 and 1.
3.2.3. Data Interpolation
Data interpolation involves evaluating the project metrics at specific points in time. This step allowed inferring the project’s evolution through all its stages. Interpolation was performed linearly to obtain the project metrics values at 5% progress intervals (i.e., . Records corresponding to and were omitted as no forecasts were calculated at the project start (i.e., ) and end (i.e., ).
3.2.4. Forecast Evaluation
Forecast Evaluation involves using the PFs to calculate the project estimates at completion. All 71 PFs were used for both cost and duration forecasting. Cost forecasts were determined by implementing the PFs as the within Equation (3), while duration forecasts were determined by implementing the PFs as the within Equation (8).
3.2.5. Performance Assessment
This study compared the PFs’ forecasting performance under three criteria: accuracy, precision, and timeliness. Accuracy referred to the ability to provide forecasts close to the real value of the target variable. Precision referred to the ability to minimize the dispersion of forecast errors. Timeliness referred to how fast forecasts achieved accuracy and precision.
For each observation i in the dataset, we let and indicate the real value and the forecast for that observation, respectively. Then, the forecast error () was determined by the difference between and , as per
All performance criteria could be assessed by analyzing the functional boxplots of the forecast errors. In the functional-boxplot variant, all measures were expressed as a function of the . The variables , , and represented the first, second, and third quartiles, respectively, while indicated the lower bound and the upper bound. Unlike in standard boxplots, this study defined the and the as the 10th and 90th percentiles of , respectively.
Figure 1 illustrates a functional boxplot with the on the x-axis. The filled area between and represents the functional InterQuartile Range (). Following this notation, accuracy was assessed based on how close , , and fall to the axis (i.e., ), precision was assessed by the extent of the areas between the and the and the , and timeliness was determined by how fast these measures converged.
Figure 1.

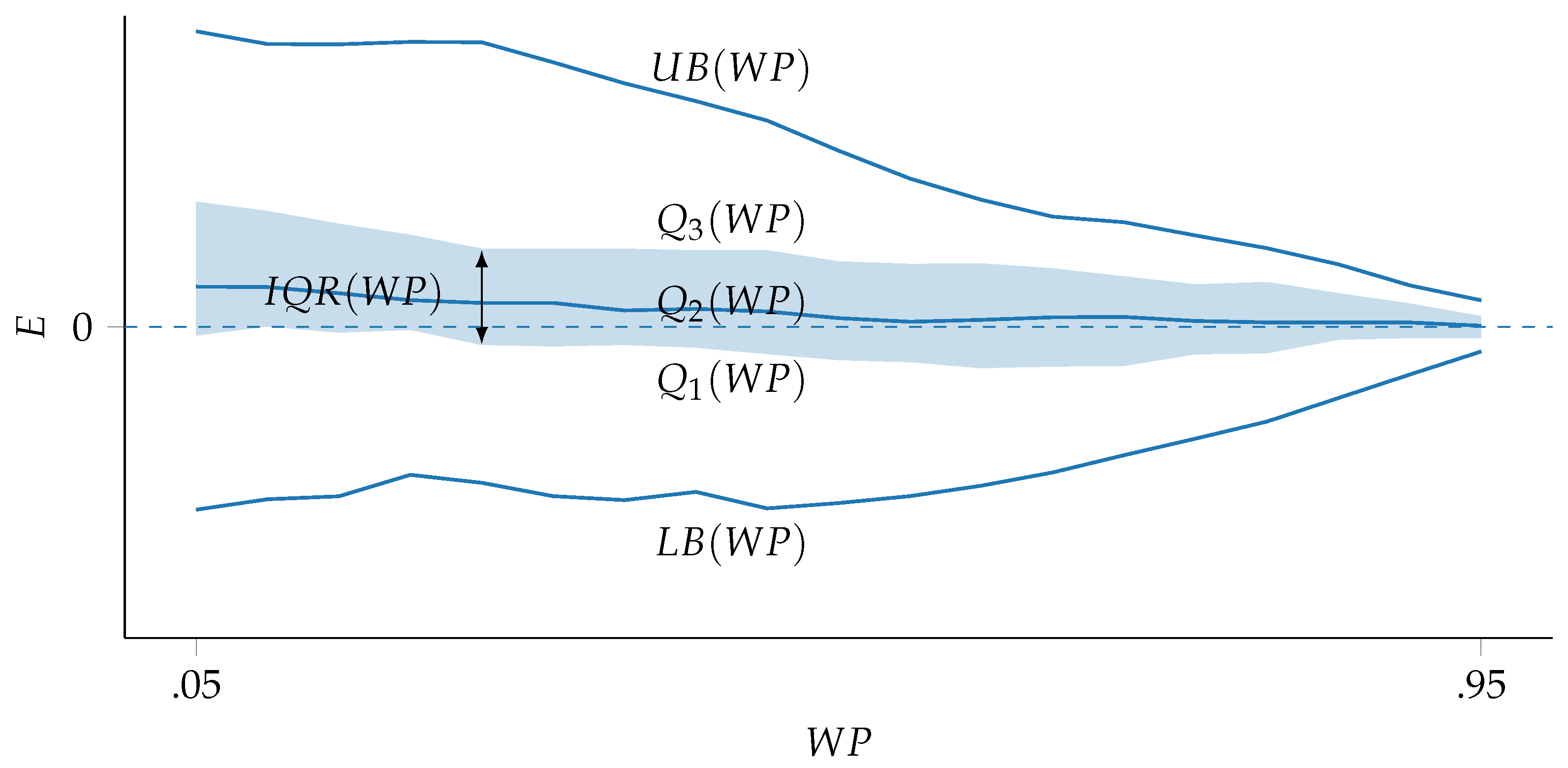

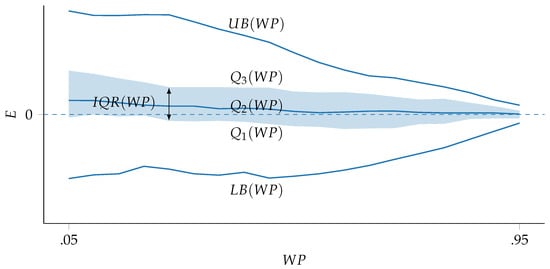

Example of forecast Error (E) functional boxplot with the Work Performed () as the x-axis.
All performance criteria but timeliness could be summarized at a higher level without analyzing each PF functional boxplot. To achieve this, the benchmark utilized three regression scores: Mean Absolute Error (), measuring average accuracy, Root Mean Squared Error (), measuring robustness, and a custom score based on the area determined by and throughout the project progress (A), measuring precision.
We let n indicate the total number of observations in the project dataset. Then, the was evaluated, as per
the was evaluated, as per
and A was calculated by evaluating the integral between the first and third quartiles lines and the -axis (), as per
Figure 2 provides an example of how A was calculated. The light blue area corresponds to , while the dark blue one corresponds to .
Figure 2.

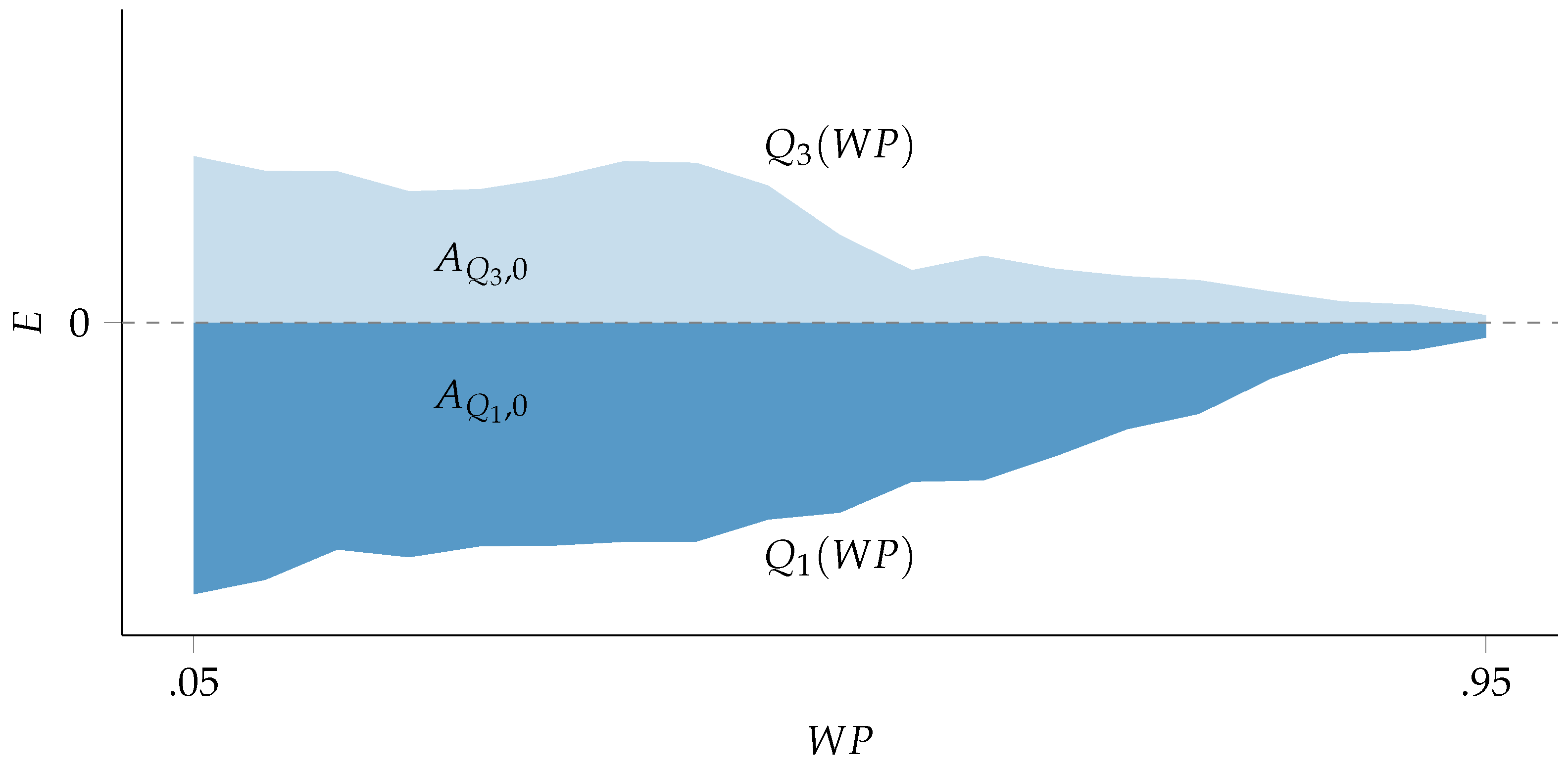

Example of functional boxplot Area score (A) evaluation.
4. Results
The PF parameters were assigned arbitrary values: weight parameter , sample window parameter , and smoothing parameter .
Table 3 presents the A, rank, , and scores of the s, calculated on the entire dataset. The rank was determined based on the ascending order of A. The best-performing PF was , ranking first with and . Among non-progress-based PFs, 1 ranked highest, placing 12th with and . The best-performing standard PF was , ranking 37th with and .
Table 3.
Cost PFs forecasts: overall accuracy scores.
Table 4 presents the A, rank, , and scores of the s, calculated on the entire dataset. The rank was determined based on the ascending order of A. The best-performing PF was , ranking first with and . Among the non-progress-based PFs, 1 ranked highest, placing 6th with and . The best-performing standard PF was , ranking 49th with and .
Table 4.
Schedule PFs forecasts: overall accuracy scores.
Table 5 presents, for each project, the s that minimized the and scores, calculated across all the values. Concerning , the progress-based PFs best performed in 32 projects, the average-based PFs in 21, the standard PFs in 8, and the combined PFs in 4 projects. Regarding , the progress-based PFs best performed in 34, the average-based PFs in 20, the standard PFs in 8, and the combined PFs in 3 projects. In 48 projects, the best was consistent across both and , while it differed in the remaining 17 projects.
Table 5.
Cost forecasts: best PFs by project.
Table 6 presents, for each project, the s that minimized the and scores, calculated across all the values. Concerning , the progress-based PFs best performed in 40 projects, the average-based PFs in 17, the standard PFs in 4, and the combined PFs in 4 projects. Regarding the , the progress-based PFs best performed in 38 projects, the average-based PFs in 16, the combined PFs in 7 projects, and the standard PFs in 4. In 41 projects, the best was consistent across both and , while it differed in the remaining 24 projects.
Table 6.
Duration forecasts: best PFs by project.
Table 7 presents, for each , the s that minimized the and scores, calculated across all projects. Concerning the , the progress-based PFs best performed in the interval, the combined PFs best performed in the interval, and the best performed at . Regarding the , the progress-based PFs best performed in all but interval, where the average-based PFs performed best. In both the and scores, the -based scores best performed in the , while the -based PFs best performed in the remaining.
Table 7.
Cost forecasts: best PFs by .
Table 8 presents, for each , the s that minimized the and scores, calculated across all projects. Concerning the , the progress-based PFs best performed across all phases. Regarding the , the progress-based PFs performed best in all but stages, where the standard PF performed best. In both the and scores, the early phases (i.e., ) and the very last phases () were dominated by -based scores, while starting from the mid phases (), the -based PFs dominated.
Table 8.
Duration forecasts: best PFs by .

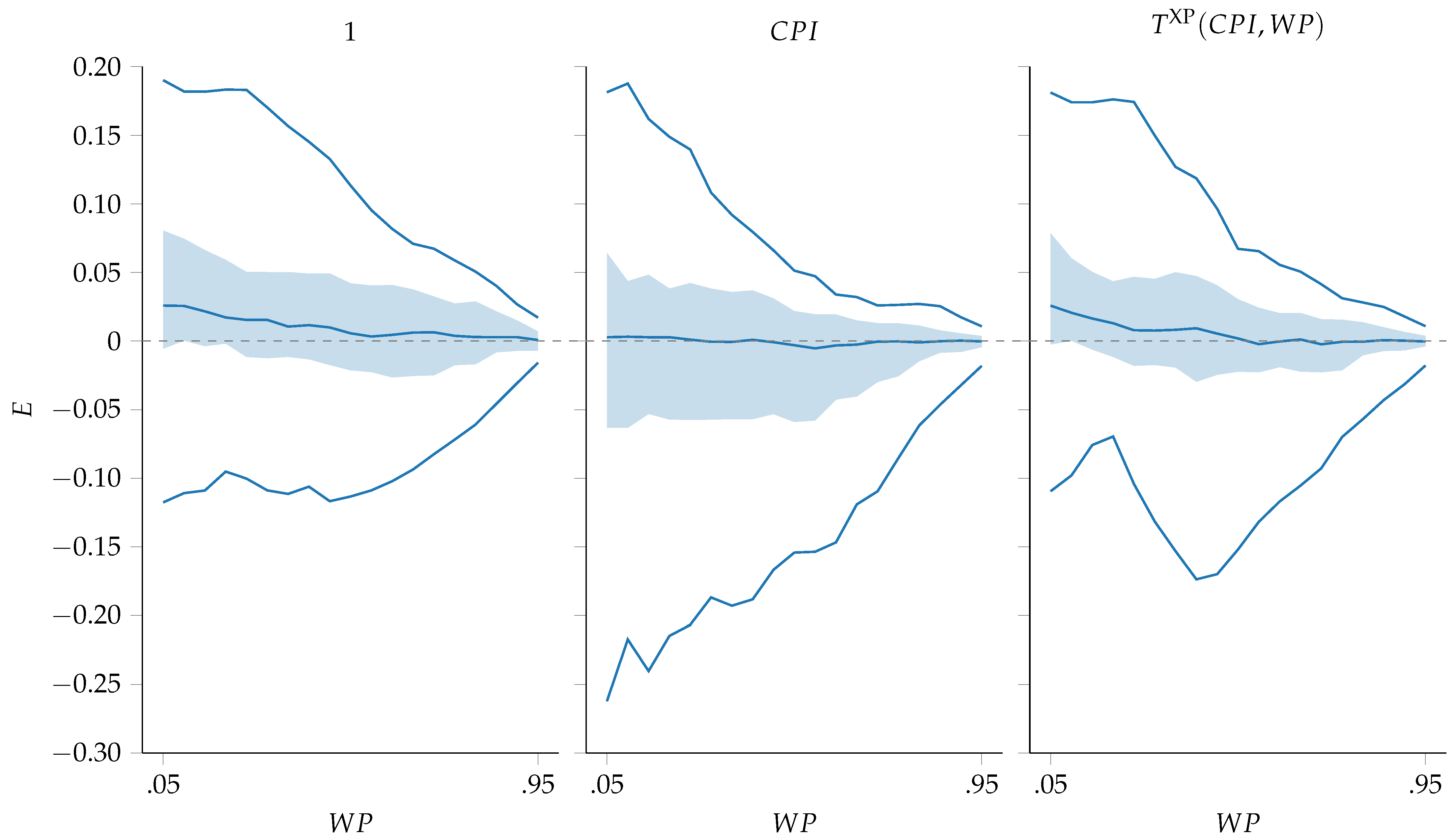

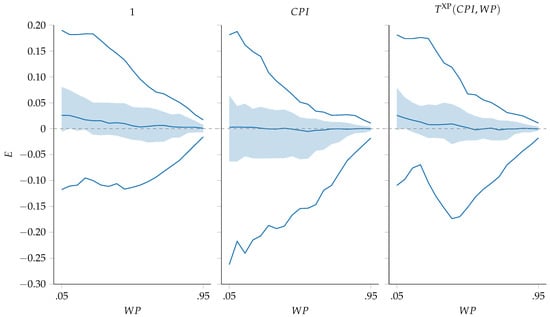

Figure 3 displays the functional boxplots of the forecasting errors of the models implementing 1, , and the best progress-based from Table 3, i.e., . Regarding the standard PFs, 1 exhibited a larger range between and but a smaller IQR than the in the early stages; the opposite occurred in the mid–late stages. On the other hand, performed the best among the three s, showing narrower bounds throughout all but the mid-stages, as shifting from the to 1 made it still subject to outliers. Furthermore, ’s IQR was narrower than the 1 and ones throughout all the phases.
Figure 3.

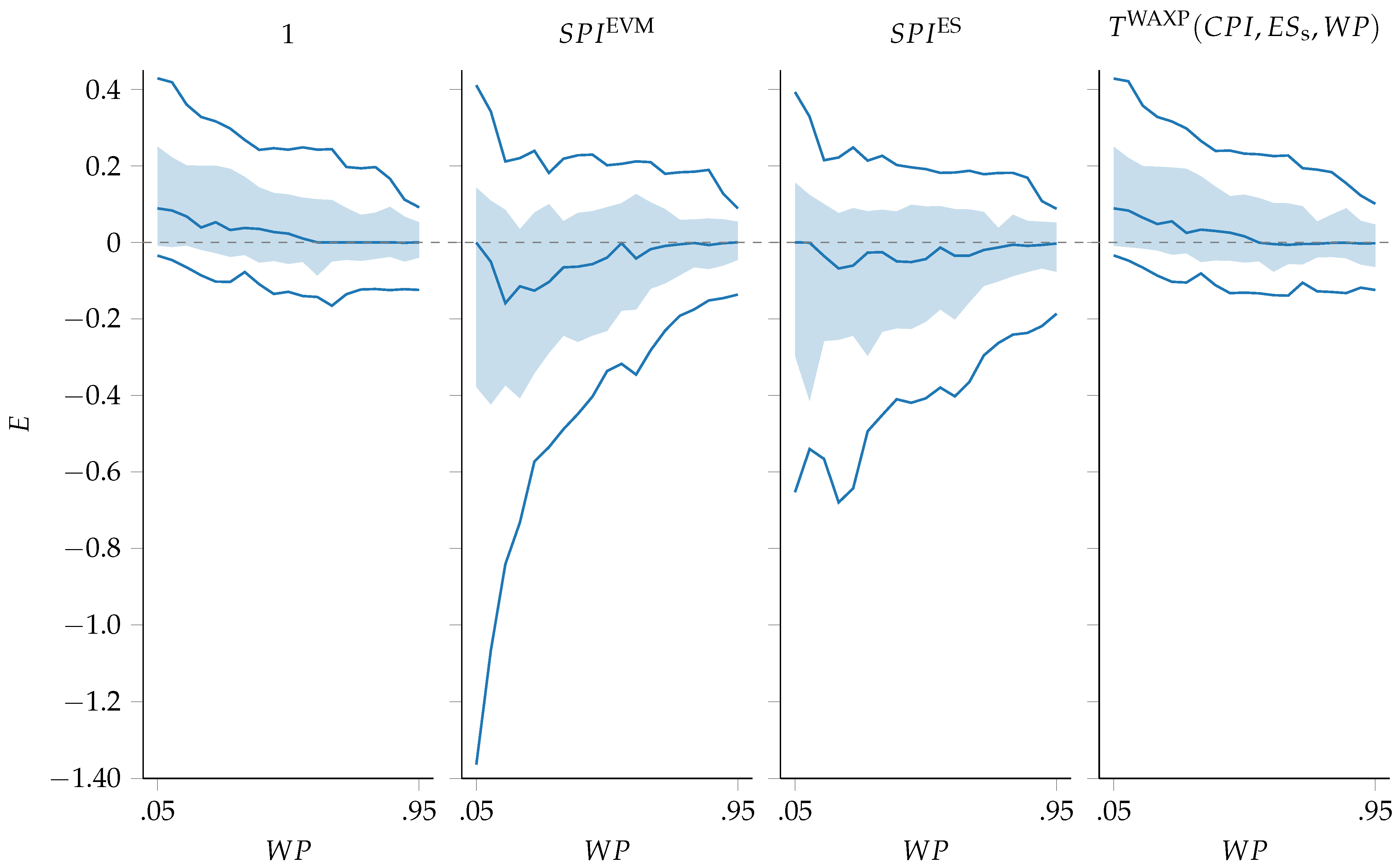

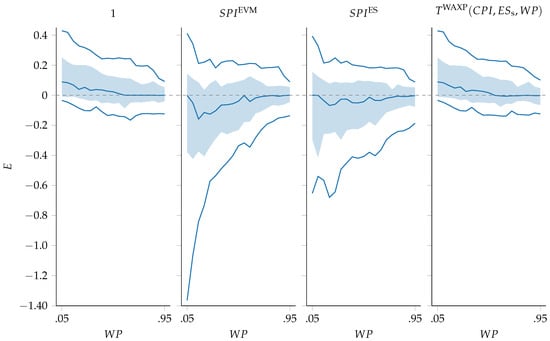

Functional boxplots of cost forecasting models implementing standard PFs and the best-performing progress-based PF.
Figure 4 displays the functional boxplots of the forecasting errors of the models implementing 1, , , and the best progress-based from Table 4, i.e., . Regarding the standard PFs, 1 performed best across all stages. Using as the in Equation (8) instead of Equation (4) provided more accurate and precise results, yet fell behind other s in performance. On the other hand, performed the best, showing slightly narrower bounds and IQR throughout all the project phases.
Figure 4.
Functional boxplots of duration forecasting models implementing standard PFs and the best-performing progress-based PF.
5. Discussion
From a theoretical perspective, this study revealed multiple aspects. First, the progress-based PFs provided more accurate, precise, robust, and timely forecasts than the standard, combined, and average-based PFs for the dataset under analysis. The differences in the individual criteria were limited, especially when evaluated using scores calculated at the dataset level. However, when analyzed in aggregate and at the individual-project or physical-progress level, the differences in performance between progress-based and other PFs were more appreciable. Furthermore, even the slightest improvements could be crucial to project success in projects with hard budget or time constraints. This study also revealed that, in certain cases, the most effective cost-performance forecasting model () incorporated either or , while the most effective schedule-performance forecasting model () incorporated . This could be due to two reasons. On the one hand, it is possible that cost performance was heavily influenced by schedule performance or vice versa. Alternatively, it may be that one of the indices exhibited greater stability, mitigating outliers in forecasting. This study also confirmed that the progress-based PFs consistently outperformed the other approaches. However, no progress-based PF or (either physical or temporal) emerged as the clear winner. Therefore, it is recommended to consider forecasts from multiple PFs rather than relying solely on one.
From a practical perspective, this study provides guidance in developing progress-based PFs to change how estimates are evaluated during project execution without switching methods. Then, the study proposes a set of PFs developed following these principles, relying only on EVM and ES variables. While a particular PF may exhibit superior performance compared to others or even appear to be entirely disconnected from the project dynamics, its estimates should still be considered, complementing those derived from more suitable PFs or expert judgment.
The method adopted by the study has several limitations, all of which refer to Equation (20). First, the proposed progress-based PFs were developed using only , , and . Second, the evaluation of was limited to . Third, the weights and that multiply 1 and , respectively, could be reversed, just as 1 could be substituted. Lastly, no project critical phase was identified, as all progress stages (both in terms of physical progress and time progress) were accounted for in the same way. All these limitations were deliberately adopted to avoid further complicating the construction of the progress-based PFs. Future research may address all directions unexplored by the current study.
6. Conclusions
In project management, accurate and precise estimates are essential for making informed decisions regarding control actions and their scope. However, due to the inherent uncertainty in project activities, implementing the sophisticated estimation methods proposed in the literature is often impractical for practitioners. This study aimed to address this challenge by proposing a method that aligns with standard project-management practices while enhancing the reliability of estimates. Practitioners should readily adopt the proposed method and seamlessly integrate it with existing processes, ensuring its practical applicability and real-world impact.
The proposed method leverages the standard EVM and ES formulae to estimate project completion cost and duration. However, it introduces projection factors that account for physical project progress, temporal progress, or both. Progress is represented as an indicator that, through weighting or exponentiation, allows the PF to be adjusted from a conservative to a neutral value, effectively modifying the assumption underlying the remaining cost or duration calculation.
The study tested 71 PFs on 65 real projects for cost and duration-to-completion forecasting for 1235 total observations, each corresponding to a discrete advancement of physical progress. The results, analyzed across the board, at the individual-project level and the individual-percentage-of-physical-progress level, show that progress-based PFs can provide more accurate, precise, and timely forecasts. The most significant improvement was perceived in precision, followed by timeliness, and then by accuracy. In contrast to the sophisticated methods predicted in the literature, although the performance improvement over standard methodologies was limited, the proposed PFs were absolutely straightforward as they were based entirely on the same metrics predicted by the standard methodologies.
This study faced the limitation of using only EVM and ES metrics in the construction of the progress-based PFs. While these metrics provide valuable insights into project performance, they may not capture the full spectrum of factors that influence project progress and potential deviations from the original plan. Future research could explore the inclusion of additional variables, such as the project’s complexity, the experience of the project team, and external market conditions, to enhance the predictive power of the proposed method. Another limitation lies in the dependence on the project dataset used. Future studies could broaden the sample of projects analyzed.
