Abstract
The modern civil engineering and construction sector requires collaborative work environments, learning and trust among all parties involved, qualities that are absent in the Peruvian reality. This study, which is based on an extensive literature review, investigates this challenge. The study reflects upon (i) the current situation of public works procurement in Peru and (ii) the New Engineering Contract (NEC), which has recently been implemented in Peruvian Special Public Infrastructure Projects. Comparisons are presented between the characteristics, documentation and roles of these two systems, with the purpose of understanding and representing the advantages, disadvantages and possibilities of integrating the good contractual management practices of the NEC4 Engineering and Construction Contract into the traditional Peruvian State Contracting Law (Ley de Contrataciones del Estado: LCE). The research is validated through the case study of a high-impact road infrastructure project in the city of Arequipa, Peru, which revealed five main deficiencies from Peruvian procurement processes which hinder good contractual management and, also, facilitated an initial assessment of the challenges and improvement opportunities in public infrastructure procurement. Thus, a contribution is made to closing the knowledge gap regarding the implementation of the NEC4 ECC in public sector works.
1. Introduction
All stages of the development of an infrastructure project should receive the same levels of effort and thought without detracting from any of them, as is conventionally the case with the procurement process. Giving it such consideration reduces the chances of disputes during the contractual period of the project []. Such a well-known level of concern and subsequent innovation regarding this matter in the United Kingdom led to various options for standardised procurement models for engineering and construction projects being created and disseminated. This is also the case in developed countries, i.e., Hong Kong [], New Zealand [], United Arab Emirates [], South Africa [] and many more countries where due importance is given to the procurement process.
In developing countries, the situation is quite the opposite []. Regarding this issue, McDermot et al. [] concluded that the primary factor contributing to the failure of infrastructure projects lies in the planning stage; this is further broken down into poor contractual management and a lack of early involvement from contractors and stakeholders during this stage. Furthermore, defective planning in contractual management can result in heavier problems such as cost overruns, which also implies the misuse of public infrastructure resources [].
Peru, which has recently been promoting this sense of concern and special care that should be given to the contracting processes for infrastructure projects, represents one of these problematic cases. However, the focus of this concern is directed towards the development and execution of Special Public Infrastructure Projects, which enjoy the power to be regulated under legislations that allow the use of standardised international contracts []. The creation of these projects leaves aside the rest of the public works, which are still governed by the regulations of the Peruvian State Contracting Law; in Spanish, Ley de Contrataciones del Estado (LCE).
Therefore, the objective of the current study is to address this situation by proposing recommendations for the contractual management of public infrastructure projects in Peru; this will be achieved through the implementation of processes and tools considered in the standardised contract, the New Engineering Contract 4: Engineering and Construction Contract (NEC4 ECC), ideal for the development of a collaborative work environment, which is currently missing due to the lack of collaborative philosophy in general.
The research is based on literature reviews throughout Section 3, with the main objective of understanding and finding similarities or differences between the Peruvian State Contracting Law and NEC4 ECC. In addition, a case study of a high-impact road infrastructure project in the city of Arequipa, Peru, is developed in Section 4, which presented all the circumstances and inconveniences required by the study during its contractual execution stage. Hence, a new contribution is made regarding the benefit of improving the traditional contracting models and processes used in Peru, thus seeking to contribute to the closing of the knowledge gap of the NEC4 ECC standardised procurement model in a developing country.
2. Methodology
The methodology of this study comprises two (02) stages, consisting of (i) an extensive literature review on the two main topics of the study and (ii) the analysis of a single case study.
To commence with, a literature review on the current state of public works procurement in Peru was carried out. The search for legal documents and reports issued by Peruvian government organisms included entities such as the General Comptroller of the Republic (Contraloria General de la Republica, CGR, in Spanish), Ministry of Economy and Finance (Ministerio de Economia y Finanzas, MEF, in Spanish), Supervisory Body of State Contracting (Organismo Supervisor de las Contrataciones del Estado, OSCE, in Spanish) and Presidency of the Council of Ministers (Presidencia del Consejo de Ministros, PCM, in Spanish). Overall, numerical and factual data were analysed to comprehend the Peruvian situation and its most recent attempts for better infrastructure project management.
Simultaneous systematic scientific research focused on the NEC was undertaken. Google Scholar was the starting search engine, where the research was directly limited to review articles. Keyword combinations such as NEC, Collaborative Procurement, Early Contractor Involvement, Compensation Events, Early Warnings and Dispute Avoidance Boards were used. Not every keyword combination included NEC in its composition. Then, papers in Scopus and Web of Science were analysed, considering that such databases contain the largest number of peer-reviewed journals and have a broader coverage of information not limited to English language. The findings were limited to articles containing the mentioned keywords, as well as articles directly related to infrastructure projects, procurement management and global usage of the NEC. The Institution of Civil Engineers’ own literature on the NEC4 was also studied as a fundamental topic in the literature review; this included the NEC4: Engineering and Construction Contract Bundle and the Managing Reality, Third edition: Complete Set, both acquired via NEC Contracts’ official website.
Finally, the analysis of the collected data was developed, with the main focus being comparing the roles, documentation and procurement strategies proposed by both the traditional Peruvian and international standardised contracting models.
As a result of the literature review, a lack of Peruvian peer-reviewed scientific research on the subject was identified. Thus, it was proposed to carry out a case study to contribute to the closure of such a knowledge gap.
To establish the scope of the case study, four hundred and eighty-four (484) public infrastructure works from the Provincial Municipality of Arequipa and seven (07) representative District Municipalities of the city, with a start date between 2018 and 2022, were reviewed. As a result of the data collection and analysis, twenty-one (21) projects were filtered by the number of contractual modifications, comptroller’s reports, contracted cost and general inconveniences during their execution.
Based on the literature review, it was deemed convenient to reduce the sample to one (01), in order to carry out a single and embedded case study of an emblematic infrastructure project for the city; inasmuch as it represents a clear opportunity to review and analyse a phenomenon considered by very few [].
Data collection for the case study involved searching for documentation related to the selected infrastructure project; this was achieved through access to the public transparency electronic system provided by the Peruvian government. These websites included the Contract Searcher of the State Procurement Electronic System (Sistema Electronico de Contrataciones del Estado, SEACE, in Spanish), Infobras (which is a tool for searching public projects information), CGR’s Control Report Searcher and OSCE’s Public Searcher.
The process of data analysis of the case study’s documentation began with a technical characterisation. It was mainly focused on the categorisation of failures, which led to contract addenda, and the classification of control reports issued by the CGR in every phase of the project. This analysis stage allowed for the identification of the technical deficiencies and their origin in the analysed documentation. Then, a comparison between the case study contract and the NEC4 ECC’s main objectives was portrayed in order to comprehend what was lacking from the traditional Peruvian contract model compared to an international standardised contract model. The mentioned methods helped objectively diagnose the current state of the case study and its main procurement process deficiencies.
Finally, both the analysis of the literature review and the case study diagnosis permitted the elaboration of proposals for the improvement or implementation of clauses in response to the deficiencies identified in the public infrastructure projects procurement in Peru. In brief, Figure 1 graphically summarises the methodology.

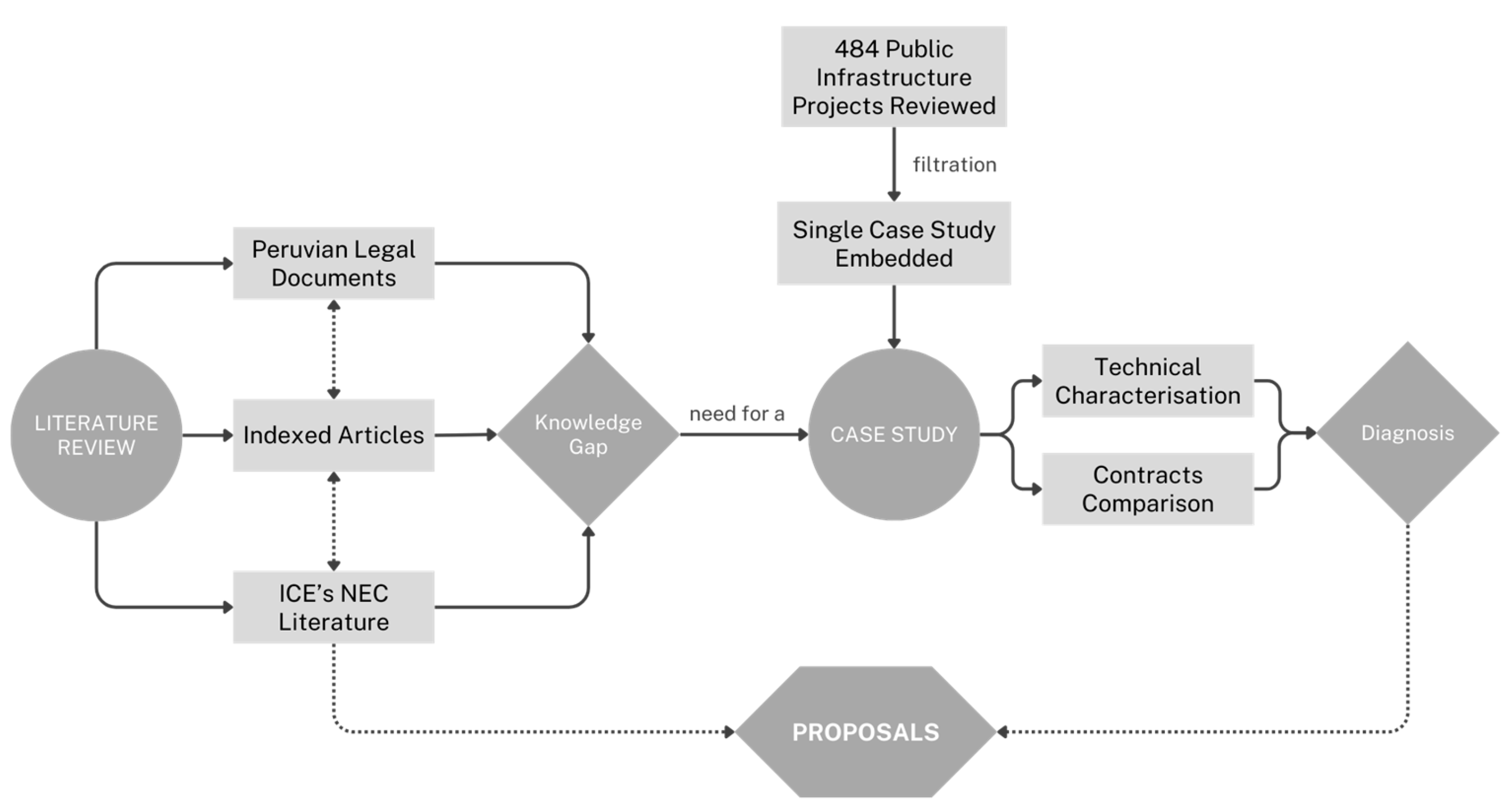

Figure 1.
Methodology flow chart.
3. Literature Review
Over the years, the level of distrust and confrontation between parties in construction projects has increased due to traditional and adversarial schemes originated from a deficient procurement normative [,,]. Globally, in 2022, the International Chamber of Commerce [] showed that the construction and energy industries represented 45% of the arbitrages registered.
Many have argued about the existence of a necessity to migrate to collaborative environments, which can provide more innovative solutions and better overall constructability, particularly through the better development of a construction contract [,]. Rahmani [] addresses such existence of a tendency for a change in adversarial traditional culture in the construction industry.
Therefore, new procurement strategies are clearly required, specifically those that can facilitate the achievement of intended outcomes for the best interests of infrastructure projects through a better contractual management with integrated and collaborative teamwork between parties, as it should be stipulated in the actual contract form [,].
Mutual trust is also a determining factor in the contractual management of successful infrastructure projects; this is the basic quality of the collaborative philosophy under which the standardised contracting models were designed, which seek to propose collaborative environments between all levels of the project []. Although mutual trust and collaboration may appear easily achievable in theory, they both rely on a major overall change in the philosophy of the conservative and bureaucratic mindsets [].
Such a philosophy opens up the possibility of balanced risk management between the parties involved in a construction contract, a quality identified as the most effective technique for avoiding conflict []. Furthermore, Eriksson et al. [] and Taylor [] assert that this philosophy would allow access to modern management mechanisms such as Early Contractor Involvement (ECI), since contract risks are commonly assumed by the contractor, who often does not have the capacity for the aforementioned responsibility. [].
Table 1 summarises the bibliography consulted in prominent journals, from which the global use of the NEC is highlighted in order to develop the subsequent subsections and therefore allow for the identification of the most important tools and practices from the NEC, as well as determining the recurrent use of the methodologies for research on this topic. It is pertinent to mention that the table does not present the Peruvian literature regarding this topic due to its absence in notable journals. Therefore, the literature review enables the identification of an existing scientific knowledge gap on the matter.
Table 1.
Relevant bibliography consulted.
3.1. The Current State of Public Procurement in Peru
Public works procurement in Peru is governed by the standards of Law No. 30225, State Contracting Law [], commonly known as the LCE, and is in turn regulated by the Supervisory Body for State Contracting; in Spanish, Organismo Supervisor de Contrataciones del Estado (OSCE).
Firstly, it should be understood that there are two execution modalities: (1) by direct administration, where the one who plays the role of the client is in charge of the entire development of the infrastructure project; and (2) by contract as processes involving a contractor are sought. The second of these is of primary interest to this study. In turn, it is relevant to understand that in Peru, there is a Civil Code, which, unlike the Common Law in the United Kingdom, regulates civil relations, so that contracts of small to medium length and with references to both the LCE and the Civil Code will be found, as stipulated in the pro-forma contract of the Standard Bases for Public Tender for the Contracting of the Execution of Works [].
However, regardless of the regulations, many procurements, in particular for works, are not actually executed or completed. As a result, Peru has a basic infrastructure access gap estimated at US$110 billion over the long-term []. In addition, the country ranked 85th out of 140 in infrastructure development, being significantly below neighbouring countries such as Chile, which ranked 41st. []. These alarming figures can be explained by the fact that the District, Provincial and Regional Municipalities did not allocate the resources corresponding to 35%, 39% and 42% of the Public Investment Projects, respectively, leaving their final destination unknown [].
In addition, the General Contralory of the Republic [], hereafter referred to as the CGR by its name in Spanish, Contraloría General de la Republica, indicated that, by September 2022, a national total of two thousand three hundred and two (2302) public works were paralysed, of which 12.5% were due to breaches of contract and 6.1% to discrepancies, arbitration and disputes. By March 2023, the CGR [] identified a total of one thousand seven hundred and forty-six (1746) stalled public works, so that the magnitudes of the previously mentioned causes now represent 17.6% and 5.4%, respectively.
In this regard, it is not surprising that there is little coordination between levels of government, which leads to interference with public infrastructure works []. In addition, the National Policy for the Modernisation of Public Management to 2030 [] pointed out that one of the causes of the problem of public management is the inappropriate organisational design of the entities to fulfil their missions and the inadequate information and transparency offered by the state to the people.
It is therefore valid to assume that public entities in Peru are currently working with procedures and contractual frameworks that do not respond effectively to the current standards demanded by the construction sector, so much so that the National Infrastructure Plan for Competitiveness, henceforth PNIC [], highlighted the weakness of public management in the area of procurement as set out in the LCE, which regulates the Peruvian state’s contracting system. This is reinforced by the fact that the CGR [] has been emphasising the urgent need to use procurement methods other than conventional ones.
3.2. New Engineering Contracts
To lessen the need to seek a change in philosophy, which is not exclusive to Peru and much less to contemporary times, a main exponent for the procurement of infrastructure projects under the provisions of the Institution of Civil Engineers (ICE) emerged in the 20th century, the NEC Contracts, which managed to demonstrate their effectiveness with international success cases, in particular, thanks to its third version, NEC3.
It was in 1993 that the ICE published the first version of the New Engineering Contracts, followed by the second version, commonly referred to as NEC2, in 1995. By 2005, this version had already demonstrated its effectiveness on several infrastructure projects in the UK, which led to the creation of NEC3 in that year. In search of improved collaboration, NEC4 was born in 2017, which is the most recent and complete version of these standardised contracts [].
Such a suite of contracts, popularly misnamed collaborative contracts, are rather stimuli and procurement tools for construction, which propose clauses that allow for collaborative environments between the parties involved [,].
In New Zealand, according to Wright and Fergusson [], NEC ECC contracts demonstrated benefits in terms of project management, clarity and contractual relationships. Yeung et al. [] also note that NEC3 ECC construction projects were shown to excel in the following Key Performance Indicators (KPIs): completion time, safety, quality, cost reduction, team satisfaction and most importantly, the equitable sharing of risk management and the development of mutual trust and cooperation.
In this sense, NEC4, in its most recent version, proposes innovation in traditional contracts through (1) flexibility, (2) clarity and simplicity and (3) stimulus to good management, thanks to an extensive family of standardised contracts for engineering and construction []. From this range of contracts, consisting of twenty (20) standardised models, particular focus will be given to the ECC for the purposes of this study.
The NEC4 ECC is appropriate for use in the procurement of engineering and construction works, operating under any required risk and liability sharing regime, and does not require the use of NEC4 for the inherent subcontracting of large-scale works requiring this type of contract management. In this way, it is established that it is not intended to make use of the options for subcontracting works, goods or services offered by NEC4.
3.3. NEC in Peru
In Peru, there are three crucial precedents that applied the tools proposed by the NEC, and for this, it is necessary to understand the different scenarios generated by the inconsistent execution of these infrastructure projects.
On the one hand, there is the successful execution of the Pan American Games 2019 Special Project (PEJP), which was recognised for its efficient optimisation of time, costs and achievement of objectives, thanks to the use of NEC3 tools []. On the other hand, there is the questionable and delayed execution of the portfolio of projects of the Reconstruction with Changes Programme [], projects whose consultancy was carried out under the terms of NEC3, and finally, the relatively new execution of the Special Public Investment Project ‘Bicentennial Schools’, whose seventy-five (75) projects were adjudicated under NEC4 standards, of which optimistic results are still expected.
It is therefore pertinent to bear in mind that implementing an internationally successful system in a different political, regulatory and cultural context is a process that must be progressive, careful and objective [,]. Complementary to the idea, Shafik et al. [] concluded that in order to implement standardised procurement modalities such as FIDIC to the Egyptian Civil Code, it was necessary to take into account the legal framework of origin, as it requires a meticulous adaptation that does not ignore the regulatory regime of where it will be applied.
Such is the case of Peru, where public procurement, as mentioned above, is regulated under the traditional standards of the LCE, which makes it difficult for procurement models such as the NEC to be applied to the legal context of the country, as there is no regulation regarding this, apart from numeral 212.2 of this Law. This is reinforced by the fact that the three aforementioned previous applications were contracted and executed, partially or totally, under special procurement regimes, which allowed the entities to be exempt from the standard regulations of the LCE.
On the other side, the recent publication of the National Sustainable Infrastructure Plan for Competitiveness [] highlighted that there is still no standard contract model for projects developed under the Public–Private Partnership modality in Peru, despite this being a key objective of the PNIC [], which, in turn, identified the importance of the Project Management Office and the contract execution unit NEC3 for the success of the PEJP in 2019. Indeed, these models should have been precedents for the improvement in the pro-forma of the public works tendering and execution contract in Peru.
Thus, the challenge of implementing the use of standardised procurement models for public construction in Peru is evident, even more so considering that the results of the recent incorporation of the NEC4 procurement model are still awaited; however, this implementation, as such, is not impossible to achieve.
3.4. NEC4 ECC’s Contractual Management
This section’s development is based on the references in Table 2.
Table 2.
NEC4 ECC bibliography.
In order to gain an understanding of how the procurement process of these infrastructure projects with the NEC ECC is carried out, it is necessary to make a complete review of some relevant aspects, such as roles, documentation and tools of the standard model, which generate incentives for good project management.
Firstly, it is appropriate to point out that the roles of the ECC have no point of comparison with any traditional model contract; therefore, it is necessary to know the roles and responsibilities of those involved in an NEC4 ECC contract. Despite what has been previously said, Table 3 attempts to detail these aspects with a particular focus on the roles that will be part of the object of study and presents their respective counterparts in the LCE.
Table 3.
NEC4 ECC contract roles and counterparties.
Similarly, it is necessary to recognise the documentation involved in the procurement and tendering process of an infrastructure project, as these are approved by various levels of management or representatives prior to the signing of the contract, indicating that a professional standard required for quality control must be met. The main documents to be submitted by both parties to a works contract are detailed in Table 4, which compares NEC4 ECC and LCE.
Table 4.
Comparison of documentation submitted for both procurement and tendering processes.
It is of utmost importance to mention that a properly prepared Contract Data minimises any ambiguity and uncertainty regarding important data such as the response periods between the parties, the names of the parties involved, start and end dates of the works, methods of payment and all types of Secondary Option Clauses chosen for a given project. Similarly, an appropriate scope provides the contractor with information that specifies and describes the works required by the client.
On the other hand, the parties involved in the tendering, procurement and execution of a work under NEC4 apply the same responsibilities as indicated in Table 3, regardless of the degree of customisation of the contract. This is because the standardised NEC4 ECC model is based on nine (09) Core Clauses, which are not modifiable and, on their own, provide greater sophistication and detail than the pro-forma presented by the LCE.
Additionally, there are six (06) Main Option Clauses to define the type of payment to the contractor for the work performed, of which one (01) must be chosen depending on the balance in the desired risk allocation. The Main Option Clauses eligible in an NEC4 ECC contract are:
- Option A, priced contract with activity schedule;
- Option B, priced contract with bill of quantities;
- Option C, target contract with activity schedule;
- Option D, target contract with bill of quantities;
- Option E, cost reimbursable contract;
- Option F, management contract.

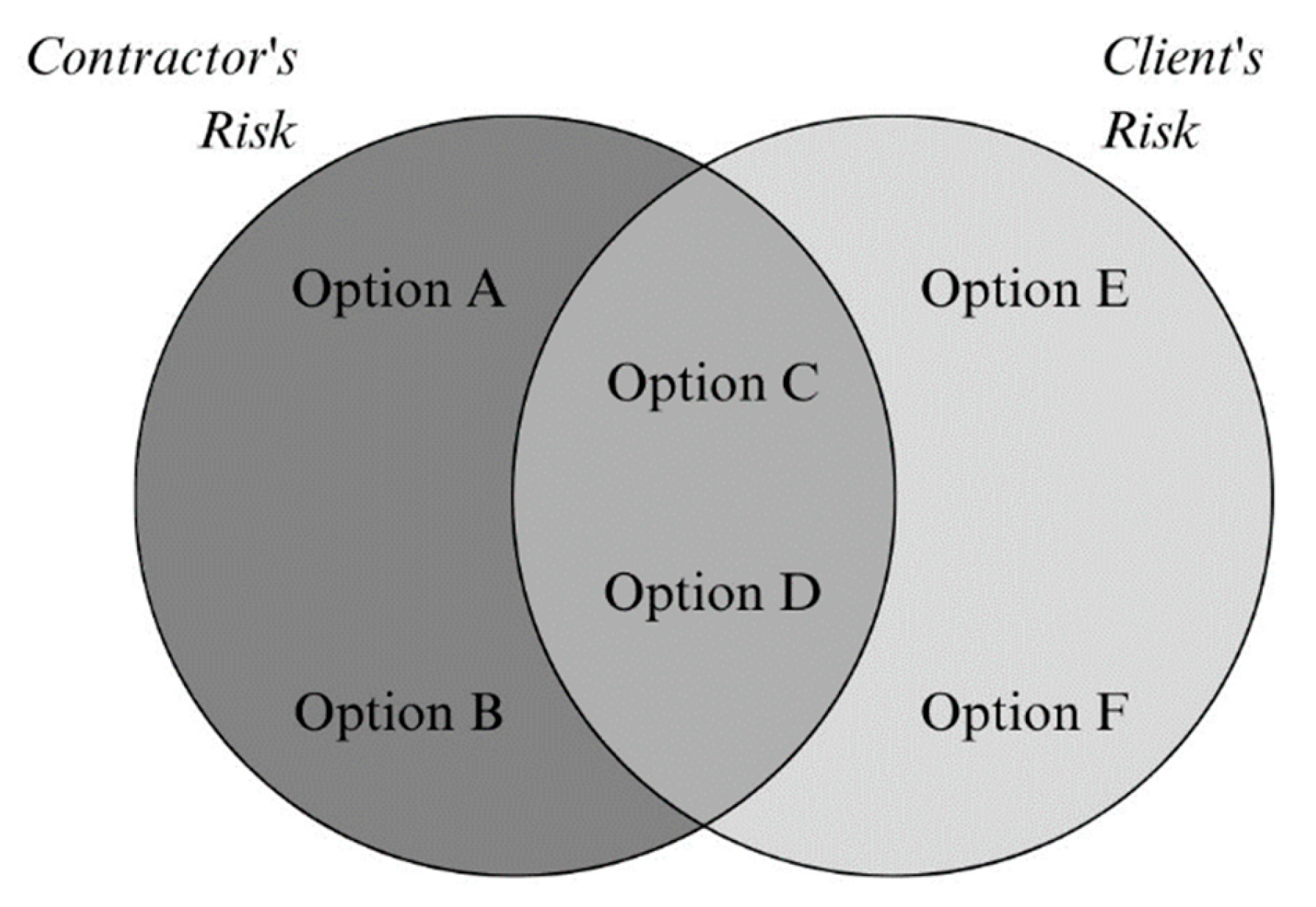

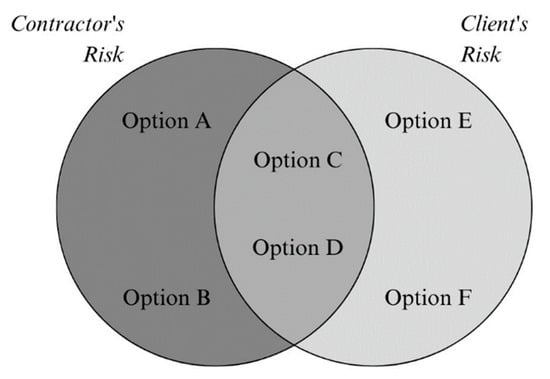

Figure 2 shows the distribution of risks according to the type of Main Option chosen, which is shared between the client and the contractor.
Figure 2.
Risk distribution according to the Main Option Clauses of NEC4.
The basis of the standardised model is sufficient to be able to contract with NEC4; however, the complexity of the infrastructure works, the involvement of the multiple actors in the contract and the variable circumstances that occur in a medium to large project make it necessary to apply incentives for good project management.
NEC4 proposes stimuli and tools for good project management in its Core and Secondary Option Clauses, starting with the procurement and tendering processes, where these stimuli and tools are specified in documents such as the Contract Data, the scope, the programme, etc. Within the wide range of clauses, they stand out as the main drivers of the philosophy of collaborative work.
3.4.1. Communications (Clause 13)
Communications within the framework of an NEC4 ECC contract are the most important basis and tool for establishing collaborative environments.
All parties to the contract are obliged to notify each other by means of a written communication system that is properly established in the contract. There are, therefore, established response times for all types of notifications, be they early warning, compensation events, ambiguities, inconsistencies, etc.
In order to maintain a proper identification and level of response to communications, it is established that each party has its own record and schedule of communications, which will allow immediate access to the record of events that may facilitate the prevention or resolution of potential problems.
3.4.2. Early Warning (Clause 15)
An early warning, on the other hand, is a notification that can be made by either the project manager or the contractor, in order to alert the other party of any event that may increase the price total, delay completion dates and key deliverables or impair the performance of the works.
The generation of an early warning should be performed as soon as the event becomes known, so that meetings are held to establish and manage the appropriate resolution changes more efficiently.
If the contractor does not generate an early warning that could have foreseen a damaging event for the project, the contractor will be penalised; however, if the project manager does not generate an early warning, the project manager will not be penalised. In this way, the contractor and the client are encouraged to fulfil their responsibilities diligently.
3.4.3. Compensation Events (Core Clause 6)
Compensation events refer to a situation that may occur during the execution of the project and that, if not attributable to the contractor, the latter is entitled to be compensated for the effects that may have been generated.
Failure to be notified by the contractor within eight (08) weeks from the first instance when such an event could have been alerted shall result in the contractor being penalised by recognising the value of the work performed as if such a compensation event had been alerted and foreseen in time by a competent contractor. A project manager has no time limit for notifying compensation events.
Considering that, under a philosophy of mutual and cooperative work, such as the one proposed by the NEC, it is expected that a contractor is neither benefited nor harmed by a compensation event, he must present the solution and quotation of the compensation event to the project manager, who will evaluate it and, if necessary, instruct him to reformulate better alternatives that are more practical at the moment of facing the situation.
3.4.4. Incentives
While collaborative actions and tools have been mentioned positively, they could not be carried out in a context where incentives for good working practices are not encouraged. Thus, NEC4 provides some specific clauses to reward the parties for their good performance in achieving objectives.
One example is clause X12, which apart from encouraging a particularised multiparty collaboration, provides incentives to those parties that meet or improve the established KPIs. Similarly, and being mutually excluded with clause X12, clause X20 encourages incentives to the contractor through the obligation to report on KPIs set and programmed by the counterpart, which will be evaluated, approved and remunerated by the project manager.
There are also incentives for the early completion of the works (clause X6) or incentives from the Main Options C and D that work with the target contract, where the final price for the works performed is compared with a target price set in the contract, so that, if there is a positive balance of this comparison, this is divided between the parties as contracted.
3.4.5. Dispute Avoidance Board (Clause W3)
NEC4, within its new tools, provides three (03) dispute mitigation and resolution options. Of particular interest is option W3, where a Dispute Avoidance Board is used as the first method of resolution. Board members visit the project site, inspect the works, provide recommendations and resolve potential disputes before they are formally referred to a court.
Most of these tools do not have a similarity in the LCE except for the latter, which has been slowly adopted since 2014 under the name of Dispute Resolution Board [], or JRD by its name in Spanish, Junta de Resolución de Disputas, and proved to be a special feature of the PEJP, thus contributing to its consolidation []. In turn, the communication mechanisms in NEC4 ECC present a possible similarity in the LCE, being the Electronic Works Notebook [], where on-site occurrences and consultations of different kinds are registered; however, in practice, the latter does not proceed under a strict formalism as NEC does. Likewise, in terms of incentives within the LCE, only the concept of penalties is found as a potential incentive.
4. Case Study
In order to see the true impact of the meagre tools and incentives proposed by the LCE, compared to those consulted in the previous section, it is proposed to study the real case of a Peruvian infrastructure project, which was selected taking into account the number of contractual modifications, control reports and general problems that it presented during its execution; in addition, the contracted amount and its level of social impact were considered. Table 5 presents, in an organised manner, the general data, to date, of the work.
Table 5.
General data of the case study.
4.1. Technical Characterisation of the Work
Knowing the current state of the work, the need arises to know the defects and problematic events that could have led the case study to its current situation, which will be described hereinafter. It is then proposed to characterise the addenda identified using the CGR’s Control Report Finder [].
As of the date of the study, the work has a total of eleven (11) addenda, including Additional Works Provisions, in Spanish, Prestación Adicional de Obra (PAO), binding deductions, greater metrics, reductions and extensions of the deadline, which represent an accumulated incidence of 44.01% of the contracted amount.
Table 6 characterises the addenda in order to establish the causes of failure that led to the work defects identified. It should be noted that the CGR categorised all the addenda under the concept of ‘Deficiency in the Technical Works File’; however, knowing the documentation that makes up a technical works file, the authors went deeper into the concept indicated by the CGR, with the purpose of specifying the causes of failure.
Table 6.
Classification of failures which led to contract addenda.
Understanding that all the addenda were originated by different types of deficiencies in the technical works file, where five (05) of them were in the descriptive memory (scope of work and site information), seven (07) in drawings and technical specifications, another seven (07) in costs and budgets and two (02) in special studies, it can be intuited that these deficiencies are present in all the stages of the procurement process.
Ideally, this process should meet a professional level of approval by both parties of the contract, especially considering that the entity hires a specialised external agent for the preparation of this technical works file, and on the other hand, it is the contractor who accepts it and commits to it at the time of applying for the contract.
However, the suitability of an infrastructure project of the magnitude of the case study is not easily guaranteed and this can be aggravated by an incorrect procurement process, which leads to poor contract execution. Proof of this in the case study is that the CGR has made seven (07) control reports on the work concerning the three stages of the development of a public works contract. Table 7 characterises the control reports at all stages of the procurement process in order to understand the causes and potential damage to the work.
Table 7.
Characterisation of control reports.
The analysis of the comptroller’s reports shows that the three (03) stages of the project were not exempt from situations in which the CGR had to intervene, the most recurrent being the contractual execution stage, which contains five (05) out of a total of seven (07) comptroller’s reports.
4.2. Comparison
Therefore, in order to identify the causal processes of the deficient procurement, a comparison and contrast was made between the works contract, adjusted to the OSCE pro-forma, and the international standardised model for the procurement of works, the NEC4 ECC.
With respect to the works contract, it is understood that, together with the technical works file, they are the main documents presented by the entity in the integrated bidding documents for the opening of a call for tenders for a contract work.
Consequently, and for the purposes of the scope of the investigation, only the comparison with the works contract will be carried out; this is because the technical works file is subject to a works consultancy service contract for the preparation of the same, a form of procurement that does not apply to the ECC, but to other standardised models of the NEC4 family.
Table 8 compares the elements contained in a traditional LCE contract, considering as indicators the incentives and tools recommended by the NEC4 ECC in two of its main objectives: (1) clarity and simplicity and (2) stimulus to good management. In this way, the comparison exposes the shortcomings, failures and possible successes that make up the contract in the case study.
Table 8.
Comparison between the contract for the execution of works and the NEC4 ECC incentives and tools.
4.3. Diagnosis
In order to establish an objective diagnosis of the state of the procurement of the case study, the sixth clause of the contract for the execution of the work must be taken into account. This establishes the documentation that makes up the contract, such as the integrated bases, the winning bid, plans, technical works file and execution schedules, materials and supplies.
Based on this premise, it is understood that the technical works file is part not only of the contracting process, but also of the contract itself. This reaffirms the fact that there is a set of documents that circulated through the different levels of management and sub-management concerned within the entity, from which it is assumed that these documents were adequately assessed and approved. Therefore, at the macro level, it is possible to appreciate a deficiency in the contracting process on the part of the entity.
Thus, it is not surprising that all the addenda are attributable to errors and deficiencies in the documentation that forms part of the contract. This is justified by facts such as the accumulated incidence of a 44.01% increase in the contracted amount, far exceeding the value of 15% established by the LCE as the maximum limit for the CGR to intervene, which is then responsible for approving subsequent addenda. Likewise, if it reaches 50.00%, this percentage gives the entity the power to decide whether or not to terminate the contract [].
The approval of the 367 calendar days of extension of the execution period of the work, which represents an increase of 94.10% of the contracted execution period, shows a worrying deficiency in the management, prevention and allocation of risks, starting with the scant consideration of potential risks in the contract per se. Thanks to the review of the time extension resolutions, it is possible to establish that three of these are based on the approval of the respective PAO, which require such time to be executed; however, these PAO again show causality in the deficient execution of the technical works file.
Nevertheless, it is important to highlight the appropriate action of the JRD in resolving the two disputes associated with the resolution of their respective extensions, given that it had an appropriate response time and level of quality in its decisions; in short, the JRD considered the award of the extension periods for the execution of the work to the contractor to be justified, as they were correctly requested, although they had been previously indicated as unfounded by the supervisor and the entity.
It is also noted that a large part of the reasons why the CGR had to intervene in the project are attributable to the contractor, who showed shortcomings during his participation in the execution of the contract and was not diligent in allowing the absence of some of his professionals during the execution of the contract. This shows a certain level of disinterest or lack of motivation to carry out the contracted work on the part of the contractor, who, under oath, signed the contract.
Under this last consideration, it should be noted that the supervision team also had repeated absences that could have affected the quality of the work and caused damage to the work. This could also be due to a lack of interest on the part of the works supervision team, who should have been the first to ensure compliance with the scope of the work stipulated in the contract.
For its part, the entity is responsible for the inadequate approval of the technical works file by the project designer, since the latter prepared it with multiple deficiencies previously identified. Furthermore, the entity did not contribute to the transparency of public information regarding the contractual execution processes, and in turn, the poor communication between entities led to potential cost risks, which reinforces the problem exposed by the National Policy for the Modernisation of Public Management to 2030 [] regarding the difficulty of the entities to fulfil their missions, due to their counterproductive organisational design and the poor promotion of transparency.
In summary, it is possible to identify the following as the five main deficiencies from Peruvian procurement processes which hinder good contractual management:
- P1: weaknesses in tendering processes;
- P2: poor risk management;
- P3: lack of professional ethics;
- P4: lack of clarity in the contract and its parties;
- P5: lack of incentives for good practice.
It is noteworthy that the points identified as deficient in traditional LCE contract management are, coincidentally, those that the NEC considers as pillars for the development of an appropriate construction procurement. This leaves plenty of room for improvement through the adaptation of tools and incentives for good practice, such as those discussed below.
5. Results and Discussion
In an attempt to provide a solution to the five (05) deficiencies identified in the diagnosis, proposals are set out in Table 9 with the aim of improving certain clauses in the OSCE pro-forma, identified as determining factors for the final result of a public works project, as well as proposals for the implementation of new clauses based on NEC4 ECC tools. The justification for these clauses is also presented in narrative form.
Table 9.
Proposal for improvement and implementation.
Within the large number of modifications to the contract, regardless of whether the responsibilities are attributable to a greater extent to one or the other party to the contract, both parties demonstrated deficiencies during the procurement processes. This can be attributed, from the outset, to the questionable conduct of the preparatory and selection phase, where the parties did not demonstrate the proper care and attention to detail in carrying out their responsibilities. There are thus evident levels of disinterest or lack of motivation for the development of the procurement stages. It is therefore required that measures be adopted to implement a system of incentives for good practices for the actors in a public works contract, as McDermot et al. [] identified it as one of the top success factors for infrastructure projects.
Proper use of KPIs from project managers, as well as its benefits for the measurement and upgrade of infrastructure projects, was discussed by Yeung et al. [] and Cheung et al. []. The implementation of NEC4 tools such as Secondary Option X20, which proposes the use of KPIs to remunerate performance in meeting targets, or Secondary Option X6, which bonuses the early delivery of work, would incentivise both parties to ensure that work is completed even before the contract is signed. Moreover, they even go beyond a penalty system, which does not function as an incentive as such, but rather as a mechanism for reprimanding bad practices.
From the bibliographic review and the diagnosis obtained, it can be inferred that the change to a collaborative philosophy presents considerable constraints in the Peruvian civil context, enough so that it cannot ideally be achieved in the short- or medium-term; this is largely due to the search for the parties’ own benefit. So then, a change is also needed in the procurement systems proposed by the LCE.
Patterson [] discussed the implications of using target price Main Options C and D in depth, emphasising that these may change, for the better, the way that the client and contractor work together. Main Option D could be used to innovate the system of procurement works at unit prices, since it works with a target price where the contractor and the entity can agree on a bonus system for the optimisation of resources, time and quality. Likewise, if a methodology such as the ECI, Secondary Option X22, was chosen, it would even be possible to work with a Main Option C, which, apart from working with a target price, establishes greater clarity regarding the development of the works, as it is the contractor himself who will be a fundamental part of the design of the project. The ECI impact was studied by Rahmani [], as well as Farrel and Sunindijo [], with both studies concluding that a better project performance is the main benefit from both parties working as one with shared interests.
Implementing an early warning system may enhance and innovate problem-solving techniques in infrastructure projects, since it implies both parties to work together in preventing or mitigating cost, time and quality risks, as concluded by Meng []. Such a system becomes essential when accompanied by compensation events, which can improve the risk allocation and help avoid possible future disputes between the parties.
Remembering also that the contract is made up of supporting documentation, it is important to ensure that it contains all the information necessary for the contractor to be able to carry out the proposed works. To achieve this, a procurement structure such as NEC4 could be adapted, which contains particular documents such as the site information, which is provided by the entity and avoids the contractor being confronted with unforeseen existing buildings or services; in the same way, the scope specifies the extent of the works required by the entity, thus having two documents strictly referring to project information, which would facilitate the delivery of the works to the contractor.
Finally, to complement the proposal in view of the inherent need to improve the documentation pertaining to procurement processes, implementing a document such as Contract Data would ensure knowledge of the contract in its entirety, as well as the responsibilities of each party and would demand a higher level of collaborative work during its elaboration; in addition, it would allow for raising the performance levels of both parties during the execution of the contract.
In any case, in agreement with Wilkinson and Farhi [], as long as the search for a change in philosophy and mentality is not prioritised, in order to achieve higher standards of mutual work among public servants, none of these innovation tools will have a major positive impact on public procurement processes; ergo, the clauses and documentation implemented will remain as merely legal formalities.
Moreover, it is important to address the research limitations, which resulted in the analysis of a single infrastructure project in the case study. One of the primary constraints is the outdated and limited availability of information in the public transparency electronic system provided by local Peruvian entities; additionally, inherent difficulties arose when attempting to obtain information directly from the parties involved in the contract, largely due to issues related to confidentiality and internal bureaucratic processes.
6. Conclusions
The neglected public works sector has lately been forgotten and overshadowed by Special Infrastructure Projects, which have received preferential attention in the implementation of new contract management methodologies; for example, the particular use of the NEC in every single one of such projects, which is also the main reason why this study focuses on the implementation of this standardised contract.
Due to this cause, it is concluded that there is a need for change in the procurement processes, as well as in the way the contract and its parts are used, which, as the NEC postulates, should be everyday working documents. The consolidation of the implementation of the JRD in the LCE is nothing but a demonstration of the wide range of possibilities for adapting new and better tools, such as some clauses of the NEC4 ECC, whose effectiveness has been researched and demonstrated internationally.
In addition to the adaptation of these tools to the Peruvian context, the correct use and maximum benefit of these tools requires a collaborative philosophy; a quality that is absent in the Peruvian public works construction sector.
Finally, the identification of existing problems allows for an understanding of the needs of this sector, as well as the possibilities for improvement proposed by the NEC4 ECC, thus contributing to the closing of the knowledge gap between these two sectors.
Author Contributions
Conceptualisation, C.S.-C. and O.Y.-A.; methodology, C.S.-C. and O.Y.-A.; validation, C.S.-C. and O.Y.-A.; formal analysis, C.S.-C. and O.Y.-A.; investigation, C.S.-C. and O.Y.-A.; resources, C.S.-C. and O.Y.-A.; data curation, C.S.-C. and O.Y.-A.; writing—original draft preparation, C.S.-C. and O.Y.-A.; writing—review and editing, C.S.-C. and O.Y.-A.; visualisation, C.S.-C. and O.Y.-A.; supervision, C.S.-C., O.Y.-A., A.J.E.V., M.S.G.M. and A.A.M.Z.; project administration, C.S.-C., O.Y.-A., A.J.E.V., M.S.G.M. and A.A.M.Z.; funding acquisition, C.S.-C., O.Y.-A., A.J.E.V., M.S.G.M. and A.A.M.Z. All authors have read and agreed to the published version of the manuscript.
Funding
This research was funded by Universidad Católica de Santa María, through the project “Evaluación de Proyectos del Concurso Fondo para la Investigación 2022-II (Tipo 1 y Tipo 2)”, approved under resolution 29002-R-2022.
Data Availability Statement
The data presented in this study are available on request from the corresponding author, O.Y.-A. The data are not publicly available due to ethical restrictions.
Acknowledgments
The authors thank Filiberto Montoya, Martin Zeballos, Neil Carhart and Atilio Bustos for providing useful insights and assistance with the research reported.
Conflicts of Interest
The authors declare no conflict of interest.
References
- Mitchell, B.; Trebes, B. Managing Reality. Book Two: Procuring an Engineering and Construction Contract, 3rd ed.; Institution of Civil Engineers: London, UK, 2017. [Google Scholar]
- Lau, C.H.; Mesthrige, J.W.; Lam, P.T.I.; Javed, A.A. The challenges of adopting new engineering contract: A Hong Kong study. Eng. Constr. Archit. Manag. 2019, 26, 2389–2409. [Google Scholar] [CrossRef]
- Wilkinson, S.; Farhi, C. Could the NEC be widely used in New Zealand? Manag. Procure. Law 2008, 161, 107–113. [Google Scholar] [CrossRef]
- Alhyari, O.H.; Ani, A.R.A. Is the Engineering and Construction Contract Legally Less Competitive than the Red Book in Civil Law Countries? J. Leg. Aff. Disput. Resolut. Eng. Constr. 2022, 14, 06522001. [Google Scholar] [CrossRef]
- Laryea, S. Procurement strategy and outcomes of a new universities project in South Africa. Eng. Constr. Archit. Manag. 2019, 26, 2060–2083. [Google Scholar] [CrossRef]
- Rullan, S.; Saucedo, E.; Bacaria, J. Public Procurement for Innovation: Challenges and prospects for Latin America. In Proceedings of the International Symposium on Management of Technology (ISMOT), Hangzhou, China, 8–9 November 2012; pp. 599–601. [Google Scholar] [CrossRef]
- McDermot, E.; Agdas, D.; Díaz, C.R.R.; Rose, T.; Forcael, E. Improving performance of infrastructure projects in developing countries: An Ecuadorian case study. Int. J. Constr. Manag. 2020, 22, 2469–2483. [Google Scholar] [CrossRef]
- Rajan, T.A.; Gopinath, G.; Behera, M. PPPs and Project Overruns: Evidence from Road Projects in India. J. Constr. Eng. Manag. 2014, 140, 04013070. [Google Scholar] [CrossRef]
- Medina, F.J.C. Los proyectos especiales de inversión pública y el modelo de ejecución de inversiones públicas: Revisión de las herramientas que pueden emplearse para mejorar las contrataciones del Estado. IUS ET VERITAS 2021, 62, 131–151. [Google Scholar] [CrossRef]
- Yin, R.K. Case Study Research: Design and Methods; SAGE Publications; International Educational and Professional Publisher: Thousand Oaks, CA, USA; London, UK; New Delhi, India, 2003; Volume 5. [Google Scholar]
- Campos, M.A.; Bedoya, A.N. Hacia la administración contractual colaborativa en la obra pública en el Perú: Propuestas de aplicación. Derecho Soc. 2020, 55, 163–174. [Google Scholar]
- Murphy, S.E.; Spillane, J.P.; Hendron, C.; Bruen, J. NEC Contracting: Evaluation of the Inclusion of Dispute Review Boards in lieu of Adjudication in the Construction Industry in the United Kingdom. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2014, 6, 04514002. [Google Scholar] [CrossRef]
- Farrel, A.; Sunindijo, R.Y. Overcoming challenges of early contractor involvement in local government projects. Int. J. Constr. Manag. 2020, 22, 1902–1909. [Google Scholar] [CrossRef]
- ICC. ICC Reaches Arbitration Milestone with Case 28,000. Available online: https://iccwbo.org/news-publications/news/icc-reaches-arbitration-milestone-with-case-28000/ (accessed on 13 October 2023).
- Lama, B.J.A.; Becerra, N.I.D. Mecanismos multi-tier y el Dispute Avoidance en el entorno colaborativo de los contratos New Engeneering Contract 4 (NEC4)*. Derecho Soc. 2020, 55, 125–144. [Google Scholar]
- Cheung, S.O.; Cao, N.; Ma, W.S.A. Using KPI for Incentivization. In Proceedings of International Structural Engineering and Construction; ISEC Press: Fargo, ND, USA, 2020; Volume 7. [Google Scholar] [CrossRef]
- Rahmani, F. Challenges and opportunities in adopting early contractor involvement (ECI): Client’s perception. Archit. Eng. Des. Manag. 2020, 17, 67–76. [Google Scholar] [CrossRef]
- Franco, R.E. La incorporación de procesos colaborativos en el contrato para lograr proyectos de construcción de alto desempeño. Rev. Derecho Soc. 2020, 55, 175–195. [Google Scholar]
- Mitchell, B.; Trebes, B. Managing Reality. Book One: Introduction to the Engineering and Construction Contract, 3rd ed.; Institution of Civil Engineers: London, UK, 2017. [Google Scholar]
- ARCADIS. Global Construction Disputes Report: Collaborating to Achieve Project Excellence; ARCADIS: Amsterdam, The Netherlands, 2020. [Google Scholar]
- Eriksson, P.E.; Volker, L.; Kadefors, A.; Lingegård, S.; Larsson, J.; Rosander, L. Collaborative procurement strategies for infrastructure projects: A multiple-case study. Manag. Procure. Law 2019, 172, 197–205. [Google Scholar] [CrossRef]
- Taylor, F. NEC 4 Contract: Early Contractor Involvement (ECI). 2022. Available online: https://www.hka.com/nec4-contract-early-contractor-involvement-eci/ (accessed on 10 April 2023).
- Figueroa, V.J.E. La distribución de los riesgos en los contratos colaborativos de construcción. Derecho Soc. 2020, 55, 197–221. [Google Scholar]
- Nkunda, R.M.; Kazungu, I.; Changalima, I.A. Collaborative Procurement Practices in Public Organizations: A Review of Forms, Benefits and Challenges. Ghana J. Dev. Stud. 2023, 20, 40–57. [Google Scholar] [CrossRef]
- Yeung, J.F.Y.; Chan, D.W.M.; Chan, J.H.L.; Lok, K.L. Development of a Composite Project Performance Index for the New Engineering Contract (NECPPI) of construction projects in Hong Kong: A Delphi study. Int. J. Constr. Manag. 2022, 23, 2804–2817. [Google Scholar] [CrossRef]
- Laryea, S. Compensation events in NEC3 contracts: Case studies from South Africa. Proc. Inst. Civ. Eng. 2016, 169, 49–64. [Google Scholar] [CrossRef]
- Shafik, N.; Qodsi, S.; Serag, E.; Helmi, M. Application of FIDIC Contracts under the Egyptian Civil Code. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2016, 8, 04516004. [Google Scholar] [CrossRef]
- Meng, X. Is Early Warning Effective for the Improvement of Problem Solving and Project Performance? J. Manag. Eng. 2014, 30, 146–152. [Google Scholar] [CrossRef]
- Patterson, R. Using NEC contracts to manage risk and avoid disputes. Manag. Procure. Law 2009, 162, 157–167. [Google Scholar] [CrossRef]
- Wright, J.N.; Fergusson, W. Benefits of the NEC ECC form of contract: A New Zealand case study. Int. J. Proj. Manag. 2008, 27, 243–249. [Google Scholar] [CrossRef]
- Rankin, J.; Jameson, P.; Yarwood, N. NEC X12 at the heart of Worcestershire Highways. Proc. Inst. Civ. Eng. 2007, 160, 31–36. [Google Scholar] [CrossRef]
- MEF. Reglamento de la Ley N° 30225, Ley de Contrataciones del Estado; MEF: Lima, Peru, 2018. [Google Scholar]
- OSCE. Bases Estándar de Licitación Pública para la Contratación de la Ejecución de Obras; OSCE: Lima, Peru, 2019. [Google Scholar]
- Bonifaz, J.L.; Urrunaga, R.; Aguirre, J.; Quequezana, P. Brecha de Infraestructura en el Perú. Estimación de la brecha de Infraestructura de Largo Plazo 2019–2038; Bonifaz, J.L., Urrunaga, R., Aguirre, R., Quequezana, P., Eds.; IADB: Washington, DC, USA, 2020. [Google Scholar]
- WEF. The Global Competitiveness Report 2019; World Economic Forum: Cologny, Switzerland, 2019. [Google Scholar]
- CGR. Efectividad de la Inversión Pública a Nivel Regional y Local Durante el Período 2009 al 2014; CGR: Lima, Peru, 2016. [Google Scholar]
- CGR. Reporte de Obras Paralizadas en el Territorio Nacional a Setiembre 2022; CGR: Lima, Peru, 2022. [Google Scholar]
- CGR. Reporte de Obras Paralizadas en el Territorio Nacional a Marzo 2023; CGR: Lima, Peru, 2023. [Google Scholar]
- PCM. Política Nacional de Modernización de la Gestión Pública al 2030; PCM: Lima, Peru, 2022. [Google Scholar]
- MEF. Plan Nacional de Infraestructura para la Competitividad; MEF: Lima, Peru, 2019. [Google Scholar]
- ICE. NEC4 Engineering and Construction Contract; Institution of Civil Engineers: London, UK, 2017. [Google Scholar]
- CGR. Control Gubernamental a la Reconstrucción con Cambios (2017–2023); CGR: Lima, Peru, 2023. [Google Scholar]
- Medina, F.J.C. El Acuerdo de Gobierno a Gobierno y los Contratos NEC: ¿Soluciones a las deficiencias de la normativa de contrataciones del Estado que puedan ser replicadas por todas las entidades? IUS ET VERITAS 2019, 58, 110–127. [Google Scholar] [CrossRef]
- MEF. Plan Nacional de Infraestructura Sostenible para la Competitividad 2022–2025; MEF: Lima, Peru, 2022. [Google Scholar]
- ICE. NEC4 Establishing a Procurement and Contract Strategy; Institution of Civil Engineers: London, UK, 2017. [Google Scholar]
- ICE. NEC4 Preparing an Engineering and Construction Contract; Institution of Civil Engineers: London, UK, 2017; Volume 2. [Google Scholar]
- ICE. NEC4 Managing an Engineering and Construction Contract; Institution of Civil Engineers: London, UK, 2017; Volume 4. [Google Scholar]
- Mitchell, B.; Trebes, B. Managing Reality. Book Three: Managing the Contract, 3rd ed.; Institution of Civil Engineers: London, UK, 2017. [Google Scholar]
- Medina, F.J.C. Contratación pública y la experiencia de los Juegos Panamericanos. El modelo de gestión que promueve el gobierno. Rev. Derecho Adm. 2019, 18, 113–142. [Google Scholar]
- OSCE. Lineamientos Para el Uso del Cuaderno de Obra Digital; OSCE: Lima, Peru, 2020. [Google Scholar]
- CGR. Buscador de Informes de Servicios de Control. Available online: https://buscadorinformes.contraloria.gob.pe/BuscadorCGR/Informes/inicio.html?utm_source=gobpee&utm_medium=otsbuscador&utm_campaign=buscador (accessed on 23 April 2023).
- Congreso de la República. Ley de Transparencia y Acceso a la Información Pública; Congreso de la República: Lima, Peru, 2002. [Google Scholar]
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2023 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
