Next Article in Journal
MNEs Subsidiary Training and Development and Firm Innovative Performance: The Moderating Effects of Tacit and Explicit Knowledge Received from Headquarters
Next Article in Special Issue
Analysis of Selected Building Constructions Used in Industrial Construction in Terms of Sustainability Benefits
Previous Article in Journal
Different Ways to Access Knowledge for Sustainability-Oriented Innovation. The Effect of Foreign Direct Investment
Previous Article in Special Issue
A Predictive Environmental Assessment Method for Construction Operations: Application to a Northeast China Case Study
Article Menu
Issue 11 (November) cover image

Export Article

Open AccessArticle
Sustainability 2018, 10(11), 4207; https://doi.org/10.3390/su10114207

An Integrated Environment–Cost–Time Optimisation Method for Construction Contractors Considering Global Warming

1
Department of Construction Management, Harbin Institute of Technology, Harbin 150001, China
2
Department of Civil, Environmental, and Natural Resources Engineering, Luleå University of Technology, 97187 Luleå, Sweden
3
Department of Construction Management, Key Lab of Structures Dynamic Behavior and Control of the Ministry of Education, Key Lab of Smart Prevention and Mitigation of Civil Engineering Disasters of the Ministry of Industry and Information Technology, Harbin Institute of Technology, Harbin 150090, China
*
Author to whom correspondence should be addressed.
Received: 22 October 2018 / Revised: 8 November 2018 / Accepted: 10 November 2018 / Published: 14 November 2018
(This article belongs to the Special Issue Sustainable Construction and Building Materials)
Full-Text   |   PDF [5788 KB, uploaded 17 November 2018]   |

Abstract

Construction contractors play a vital role in reducing the environmental impacts during the construction phase. To mitigate these impacts, contractors need to develop environmentally friendly plans that have optimal equipment, materials and labour configurations. However, construction plans with optimal environment may negatively affect the project cost and duration, resulting in dilemma for contractors on adopting low impacts plans. Moreover, the enumeration method that is usually used needs to assess and compare the performances of a great deal of scenarios, which seems to be time consuming for complicated projects with numerous scenarios. This study therefore developed an integrated method to efficiently provide contractors with plans having optimal environment–cost–time performances. Discrete-event simulation (DES) and particle swarm optimisation algorithms (PSO) are integrated through an iterative loop, which remarkably reduces the efforts on optimal scenarios searching. In the integrated method, the simulation module can model the construction equipment and materials consumption; the assessment module can evaluate multi-objective performances; and the optimisation module fast converges on optimal solutions. A prototype is developed and implemented in a hotel building construction. Results show that the proposed method greatly reduced the times of simulation compared with enumeration method. It provides the contractor with a trade-off solution that can average reduce 26.9% of environmental impact, 19.7% of construction cost, and 10.2% of project duration. The method provides contractors with an efficient and practical decision support tool for environmentally friendly planning. View Full-Text
Keywords: construction contractor; environment-cost-time optimisation; particle swarm optimisation; discrete-event simulation; construction planning construction contractor; environment-cost-time optimisation; particle swarm optimisation; discrete-event simulation; construction planning
Figures

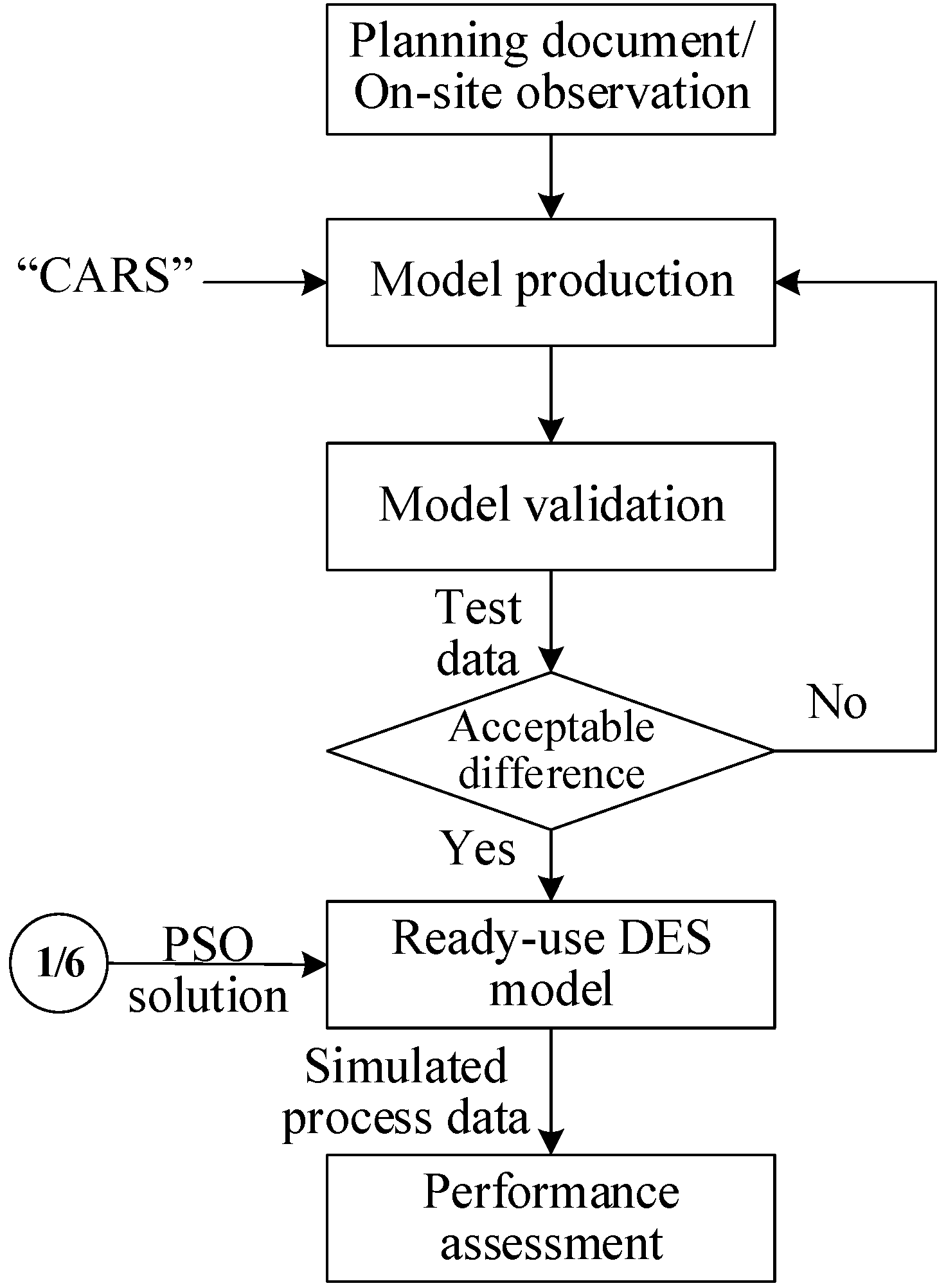

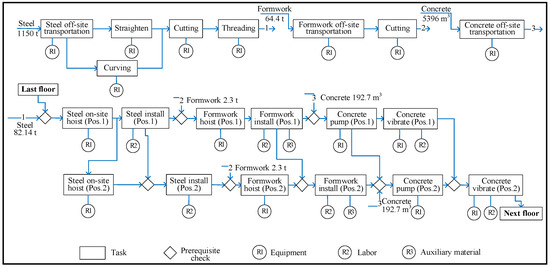

Figure 1

This is an open access article distributed under the Creative Commons Attribution License which permits unrestricted use, distribution, and reproduction in any medium, provided the original work is properly cited (CC BY 4.0).

Supplementary material

SciFeed

Share & Cite This Article

MDPI and ACS Style

Feng, K.; Lu, W.; Chen, S.; Wang, Y. An Integrated Environment–Cost–Time Optimisation Method for Construction Contractors Considering Global Warming. Sustainability 2018, 10, 4207.

Show more citation formats Show less citations formats

Note that from the first issue of 2016, MDPI journals use article numbers instead of page numbers. See further details here.

Related Articles

Article Metrics

Article Access Statistics

1

Comments

[Return to top]
Sustainability EISSN 2071-1050 Published by MDPI AG, Basel, Switzerland RSS E-Mail Table of Contents Alert
Back to Top
