From Construction Deadlock to Industrial Precision: A Dialectical Lifecycle Perspective of Modular Construction—The Case of Turkey
Abstract
1. Introduction
2. Literature Review
2.1. The Global Productivity Paradox in Construction
2.2. A Paradigm Shift: Modular Construction—Characteristics and Multi-Dimensional Advantages
| Main Themes | Identified Advantages | References |
|---|---|---|
| Time Efficiency and Speed | Rapid process and predictability | [14,39] |
| Concurrent engineering | [10] | |
| Weather-independent production | [18] | |
| Digital integration | [38] | |
| Cost Effectiveness | Industrial economies of scale | [16,17] |
| Resource efficiency | [10] | |
| Labor cost reduction | [40] | |
| Quality and Performance | Factory-controlled quality assurance | [19,22] |
| Value engineering | [15,41] | |
| Sustainability | Environmental: Emission reduction | [42,43] |
| Circularity and waste optimization | [27,31,34] | |
| Social: Occupational safety and workforce retention | [36] | |
| Urban benefit: Mitigation of on-site nuisances | [10,35] | |
| Economic: Operational and logistical efficiency | [17,32,44] | |
| Mitigation of labor shortages | [37] |
2.3. The Contextual Gap: Spatial, Economic, and Socio-Technical Dynamics
- Spatial Incompatibility and Parcel-Geometry Impasse: Istanbul’s historically fragmented, amorphous parcel structure is in sharp geometric conflict with the standard volumetric modules that form the basis of industrial production. The integration of standardised box geometry into irregular parcels leads to significant space losses; meanwhile, the transition to planar (panelised) systems to adapt to parcel form creates a paradoxical loss of efficiency and increased costs [10,15,40]. Although panel systems provide flexibility to the plot geometry, they weaken the system’s fully industrial product quality by increasing on-site assembly, insulation, and joining labour [10]. Furthermore, narrow and sloping streets in urban regeneration areas can create an operational barrier known as the last 100 metres logistics, making the physical access of large-scale units to the site a challenge [46,47].
- Economic Fragility and Sectoral Resilience: Turkey’s fragmented sector structure, dominated by numerous small-scale contractors, is structurally incompatible with the economies of scale required by MC and the early design freeze requirement [16,45,48]. This model, which eliminates flexibility in an inflationary environment and requires high upfront costs, carries a potentially difficult financial risk for actors accustomed to traditional construction culture [2].
- Socio-Technical Resistance: The success of the technology is limited by social acceptance. The fact that housing is the primary investment vehicle and status symbol in the Turkish market leads to industrial housing systems being equated with the image of prefabricated housing, stemming from past experiences with disaster relief housing. This creates a perceptual barrier, where modular structures are labelled as temporary and low-quality. This cultural resistance, independent of the technical excellence of the system, reduces the second-hand value of the housing and undermines investor confidence, hindering market penetration [26,27,49,50].
2.4. Integrated Theoretical Framework: Systemic Analysis of Life Cycle Performance
- Design: This is the deterministic stage where performance is determined, and where the primary trade-offs between economic limits and ecological targets are negotiated. 80% of the carbon footprint and total cost of ownership (TCO) are determined by decisions made at this stage. Design is not merely an aesthetic concept but a technical strategy that determines the future deconstruction potential of the building [58,59,60].
- Production: This is the stage where the embedded carbon load, which is the focus of LCA analysis, is generated. Material waste and inefficient logistics in conventional processes create irreversible environmental costs at this stage; industrial production has the potential to minimise this load at source, albeit potentially at the expense of local employment (social conflict) [54,61,62].
- Operation & Maintenance: This stage, lasting 50 to 100 years, is the most critical component of LCC analysis. Energy consumption and maintenance costs (OPEX) define the economic life of the building. The continuity of structural performance and user comfort is measured by the ability to preserve value over this long period [53,56,63].
- End-of-Life (Value Recovery): This is where the circular approach breaks the linear flow. In this phase, the structure ceases to be a waste pile and gains the status of an economic resource. The cost of demolition is replaced by the residual value obtained by reintegrating the components into the system [64,65].
3. Materials and Methods

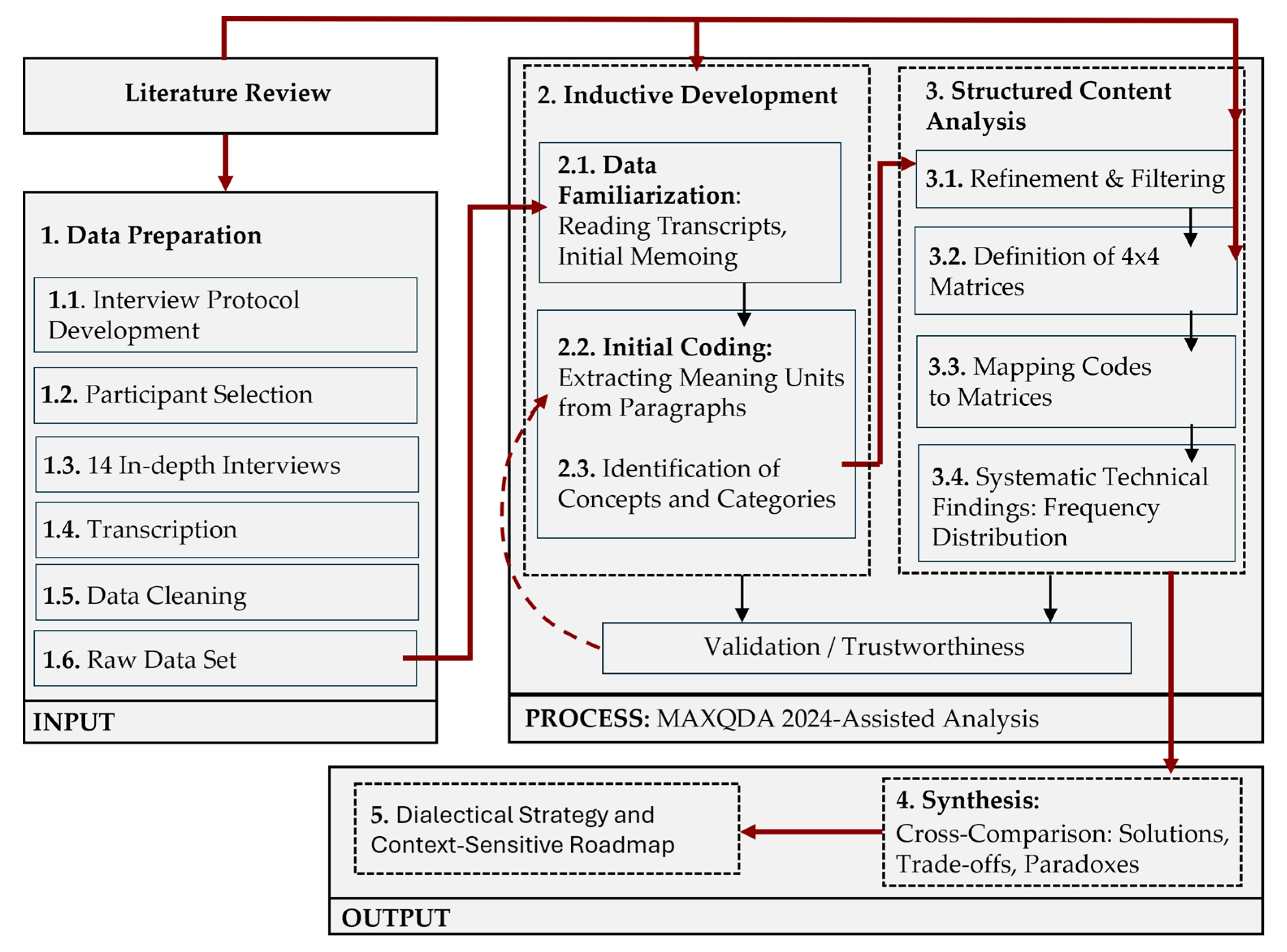

3.1. Research Design: From Qualitative Insight to Structured Visualization
3.2. Research Area: Turkey as an Extreme Case
- Seismic Risk: Building safety is a vital necessity due to the impending Istanbul earthquake.
- Economic Volatility: The hyperinflationary environment constantly puts pressure on construction costs and the supply chain.
- Urban Density: Spatial and logistical constraints created by irregular parcel structures and contiguous building patterns.
3.3. Participants and Data Collection
3.3.1. Sampling Strategy and Participant Profile
- Manufacturers (4 individuals—Technological Executives): These are technology providers with an average of 20 years or more of experience in the sector, managing high-volume industrial production facilities. This group has the technical equipment to measure not only the technical limitations of the factory site, but also the operational efficiency of automation lines and production speed compared to conventional construction sites.
- Designers and Architects (4 people—Process Designers): Senior architects who are proficient in BIM and Digital Twin technologies and who take on the role of system integrator in complex projects. This group consists of primary decision-makers who translate user requirements into technical language and personally manage the methodological conflict between the flexibility of conventional design and the standardised principles of modular discipline.
- Supply Chain Strategists (3 individuals): Visionary managers who manage volatility in the global steel and concrete markets while also mastering innovative material technologies and their structural performance. These specialists are in a position to optimise the supply chain and logistics costs of both conventional and new-generation inputs on a macro scale.
- Investors and Contractors (3 people—Financial Decision Makers): Top executives who guide large-scale residential and mixed-use portfolios and manage the economic feasibility (ROI) of the project. This group, which determines the choice of reinforced concrete or steel systems based on market dynamics, represents market makers focused on capital profitability and risk management rather than technical data.
- Strategic Insider Perspective (n = 2): Only two of the participants (E1 and E3) hold decision-making positions with direct ownership and commercial interests in the modular construction sector. The inclusion of these two individuals was deemed essential to obtain first-hand data on the system’s financial risks and market barriers.
- Professional and Critical Majority (n = 12): Approximately 86% of the participants consist of experts with no financial stake in the sale or success of modular construction. This group comprises professional engineers and managers (E2, E4) offering technical expertise and strategic management perspectives, service-oriented designers (E5–E8), market-neutral suppliers (E9–E11), and traditional housing investors (E12–E14) who view the modular system as a potential risk or alternative.
- Data Cross-Validation: The fact that the investor group is particularly focused on the traditional system has ensured that potential criticisms directed at the modular system are brought to light in a transparent manner. The fact that the findings were shaped through an expert consensus reached between a minority with a commercial interest (n = 2) and a system-independent majority (n = 12) methodologically safeguards the research’s objectivity and claim to validity. A detailed breakdown of the participants’ demographic and professional profiles is presented in Appendix A, Table A1.
3.3.2. Data Collection and Ethics Approval
- Phase 1: Inductive Questions: At the start of the interview, broad-spectrum questions were posed to participants without imposing any parameters, such as “What does conventional construction practice bring to mind?” or “What is the first obstacle that comes to mind when you hear modular system?” The aim was to capture cultural resistance, mindset and preconceptions within the sector in their purest form.
- Phase 2: Parametric Depth Questions (Deductive Phase): In the second phase, the questions took on a more structured form, focusing on the matrix’s theoretical framework. In this section, the matrix cells were populated with target-oriented (depth) technical questions.

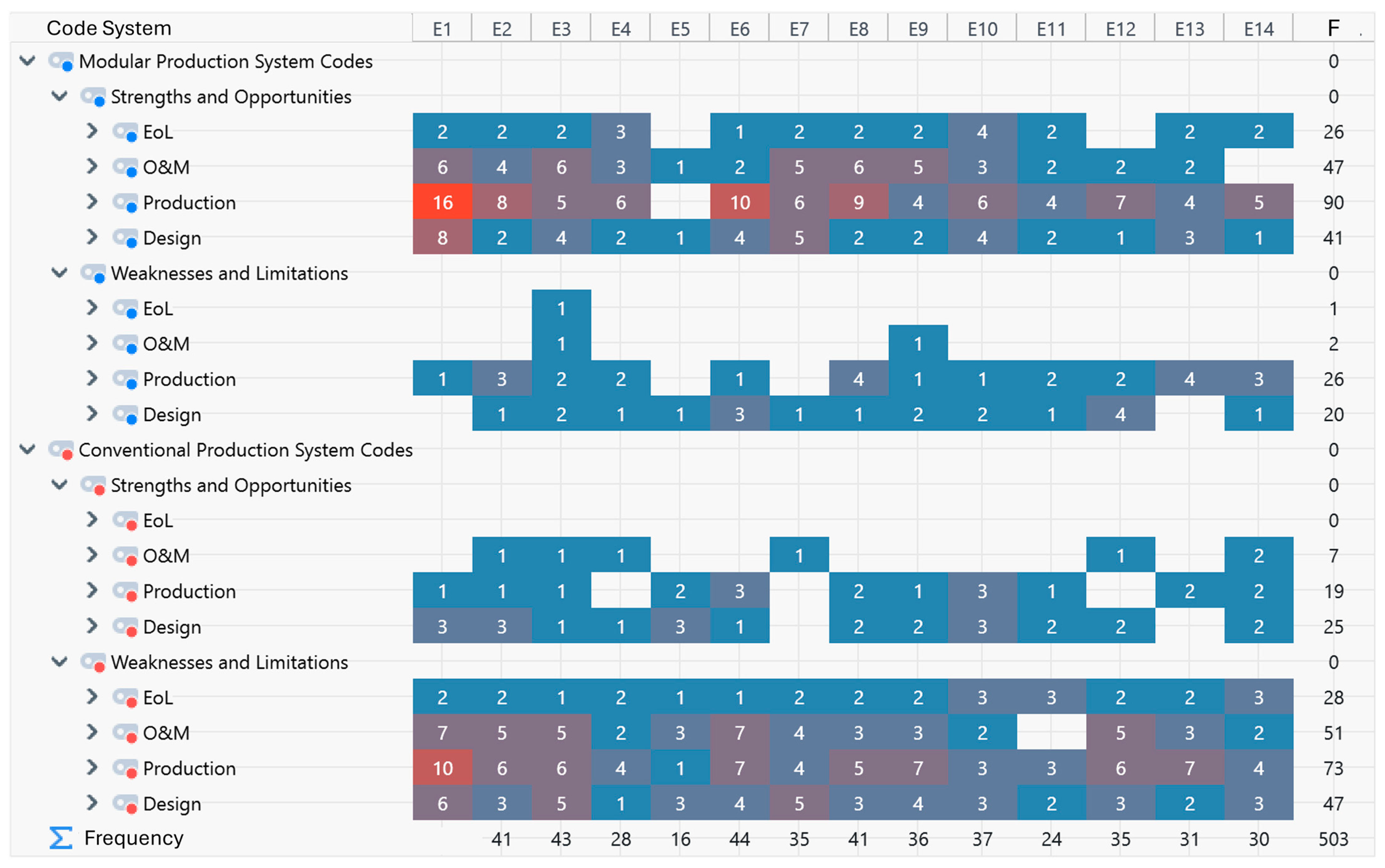

3.4. Data Analysis: Multi-Stage Qualitative Analysis
- Phase 1: Inductive Category Development: In this exploratory first stage of the analysis, the focus was on the data itself, independent of the literature and preconceptions. The process, which began with the reading of transcripts and the taking of preliminary notes (Figure 1; Step 2.1), continued with initial coding (Figure 1; Step 2.2), in which units of meaning linked to paragraphs were extracted; the framework of the raw data set was established through the identification of concepts and categories (Figure 1; Step 2.3). At this stage, without any theoretical constraints, each piece of raw data was fitted into the codes and conceptual framework, allowing the experts’ perceptions of the subject to be examined from a broad perspective.
- Phase 2: Structured Content Analysis: In the second phase, the codes derived in the first phase were refined to fit a pre-defined theoretical framework (Figure 1; Step 3.1). Through the consolidation of synonymous concepts, the merging of contextual similarities, and the removal of outliers present in only a single interview, the data was reduced to 199 final units of meaning. In light of the parameters obtained from the literature review, the four main life cycle phases (Design, Production, O&M, EoL) and 4 performance criteria (Cost, Time, Quality, Sustainability) were defined (Figure 1; Step 3.2), and the code set was assigned to these matrices and subjected to a structural analysis. In placing the codes into the cells, the primary domain of influence attributed by the participant to the relevant problem/solution was taken as the basis. At this stage, the qualitative data were structured within a framework based on frequency-based consensus indicators in order to transparently demonstrate the trends in expert consensus. These mature qualitative data, rich in contextual depth, and their frequency distributions form the findings section of the study. At this stage, the following analytical steps were followed to map the level of consensus among experts regarding the derived qualitative codes and their frequency distribution:
- Code: The smallest semantic label found in interview transcripts that defines a specific structural problem or industrial solution. During the analysis process, codes were polarised within a dialectical framework: elements that enhance structural safety, industrial speed, quality standardisation and ecological circularity were assigned positive (+) values; whereas elements that create structural crises—such as resource wastage, control deficiencies, seismic risk or slow scaling—were assigned negative (-) values. In uncertain situations involving multi-dimensional interactions (for example, where time loss leads to an indirect increase in costs), the systematic assignment of the code to the relevant performance cell was carried out based on the root cause criterion attributed by participants to the relevant problem or solution.
- Frequency: This is an analytical indicator representing the number of times a refined analytical code, or the semantic units consolidated under that code, is validated by different experts. A high frequency indicates a strong structural consensus across the sector. As a rule, even if a participant refers to the same code five times during an interview, the frequency value for that participant is recorded as ‘1’. As there are a total of 14 participants, the maximum frequency value for a code can be 14. This method prevents the data from being dominated by a particular participant, ensuring that the finding represents its prevalence across the sector and the consensus among experts.
- Raw Quote: “The concrete leaves the batching plant as C35; the quality is good. But when it is poured on site, if the vibrator is not used and it is not watered, the quality of that concrete drops to C20. The problem is not with the material, but with the lack of discipline in its application.” (E11)
- Initial Coding (Phase 1): Using the qualitative content analysis methodology, the text was tagged and raw codes were created—‘Neglect of Concrete Watering’ and ‘Lack of Application Discipline’—which preserve the terminology used by the participant.
- Analytical Refinement (Phase 2): During the filtering process, these raw statements were consolidated with similar semantic units such as ‘Human Initiative’, ‘Culture of Lack of Oversight’ and ‘Unskilled Labour’, transforming them into the analytical unit ‘Human Initiative and Oversight Gap’.
- Matrix–Cell Assignment: As the code originates from labour deficiencies and a lack of supervision in the production phase, it has been assigned to the ‘Production/Quality’ cell—its primary domain—with a negative (-) polarity.
3.5. Validity and Reliability of the Research
3.6. Research Limitations
- Data Interpretation and Thematic Prevalence: In this study, code frequencies are not treated as quantitative measures, physical impact metrics or objective risk weights. Due to the qualitative nature of thematic analysis, codes representing different phenomena are, by their very nature, incomparable and cannot be assessed on an equally weighted numerical scale. Consequently, the frequencies reported in this study represent only thematic prevalence and intra-sample consistency. These values indicate the shared mental models among the interviewed experts and the intensity of emphasis placed on specific topics. For example, the fact that a particular code has a high frequency does not mean that the issue in question is more physically or economically damaging (or serious) than a code with a lower frequency; rather, it indicates that this issue is experienced much more widely and discussed intensively within the sector’s professional discourse.
- Coding Reliability and Single-Coder Bias: Although consistency over time has been internally validated through iterative coding reviews, reliance on a single coder carries the potential for systematic individual bias. Whilst this approach ensures consistency throughout the analysis, the absence of a double-blind procedure involving an independent coder unaware of the research hypothesis remains a methodological limitation. To mitigate this risk, data triangulation and peer validation among co-authors were employed to enhance the conceptual rigour and reliability of the findings.
- Pilot Validation: Whilst the research instrument was validated through academic peer review, the absence of a formal pilot test with a market-active professional is acknowledged as a methodological limitation that may have restricted the early identification of certain site-level pragmatic nuances.
- Scope of LCA and LCC: The study has used life cycle stages as a conceptual analytical framework. The empirical basis relies not on real-time carbon footprint (LCA) or life cycle cost (LCC) calculations, but on experts’ perceptions of performance within these stages.
- Sample Size and Generalisability: The research is limited to a heterogeneous group of n = 14 individuals possessing deep expertise within Turkey’s construction ecosystem. By the nature of qualitative research, the findings do not claim statistical generalisation for the entire construction sector; however, they provide a strong trend map for emerging markets with similar economic and seismic dynamics.
- Geographical and Conjunctural Context: The findings have been shaped by Turkey’s current inflationary economic climate and seismic risk sensitivities. This situation may have led experts to evaluate parameters such as ‘cost’ and ‘quality’ at more extreme (negative or positive) ends of the spectrum.
- Narrative Quantification and Attribution: Numerical values or percentages used by participants to emphasise systemic effects are treated as narrative illustrations reflecting the perceived magnitude of issues, rather than objective parametric measurements. In the Results section, these specific expressions are presented transparently with direct attribution to the respective expert (e.g., E4), ensuring that all quantitative references are traceable to their qualitative source.
4. Results

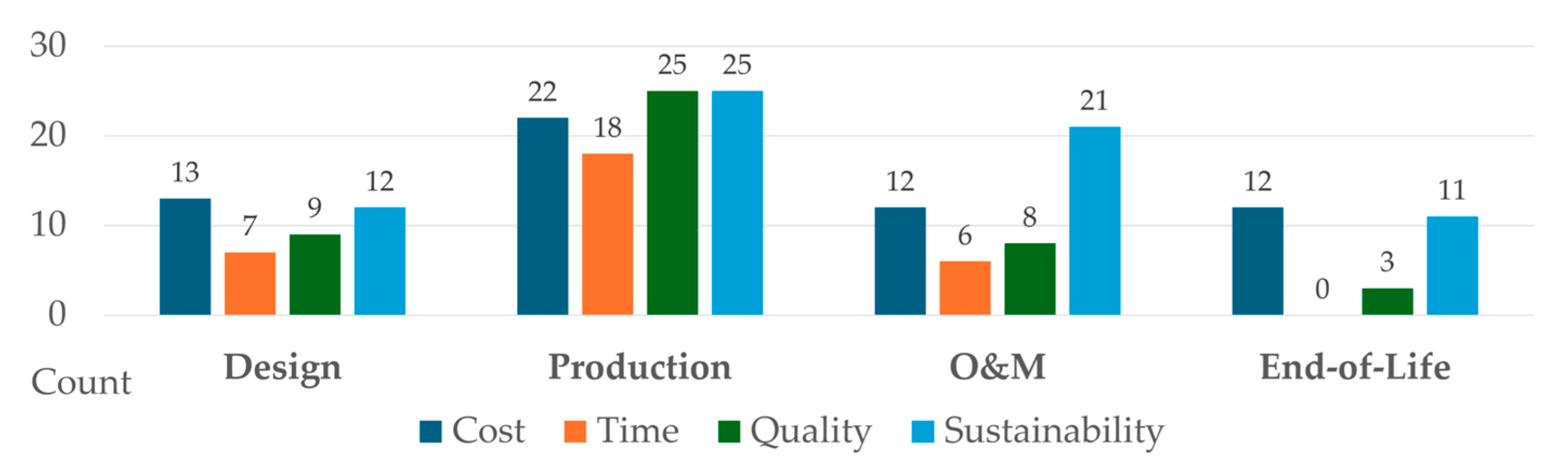

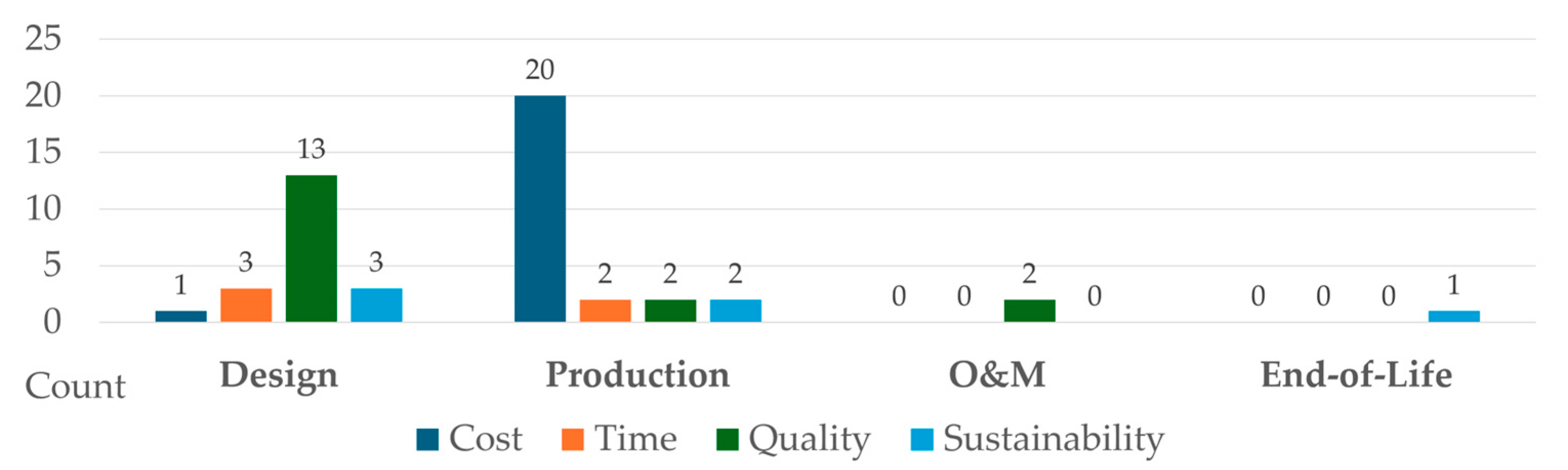

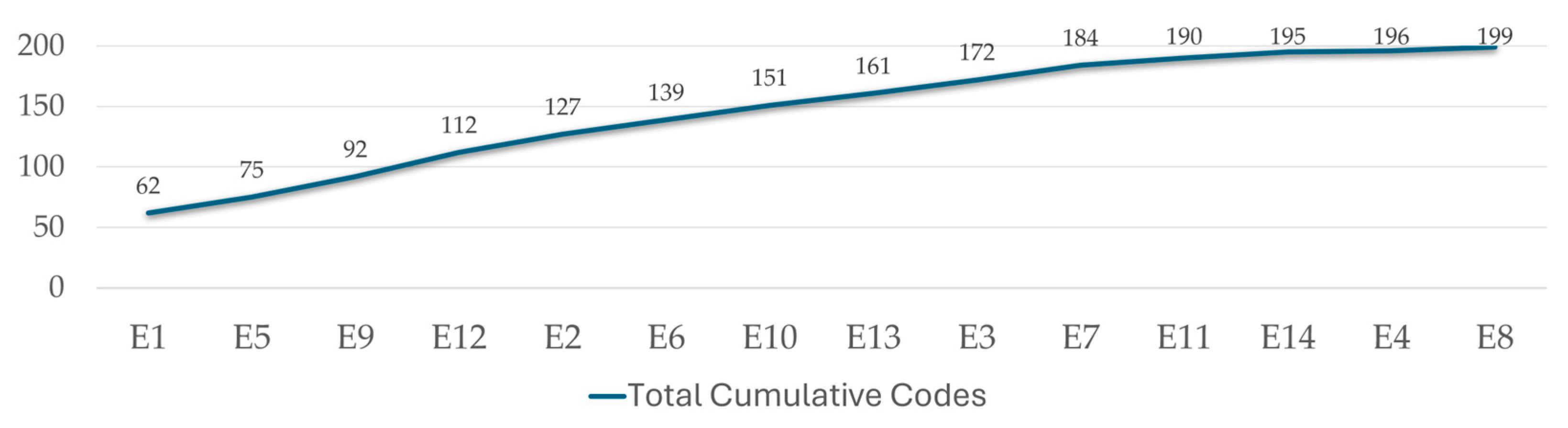

4.1. Life Cycle Consensus Matrices: A Frequency-Based Analysis

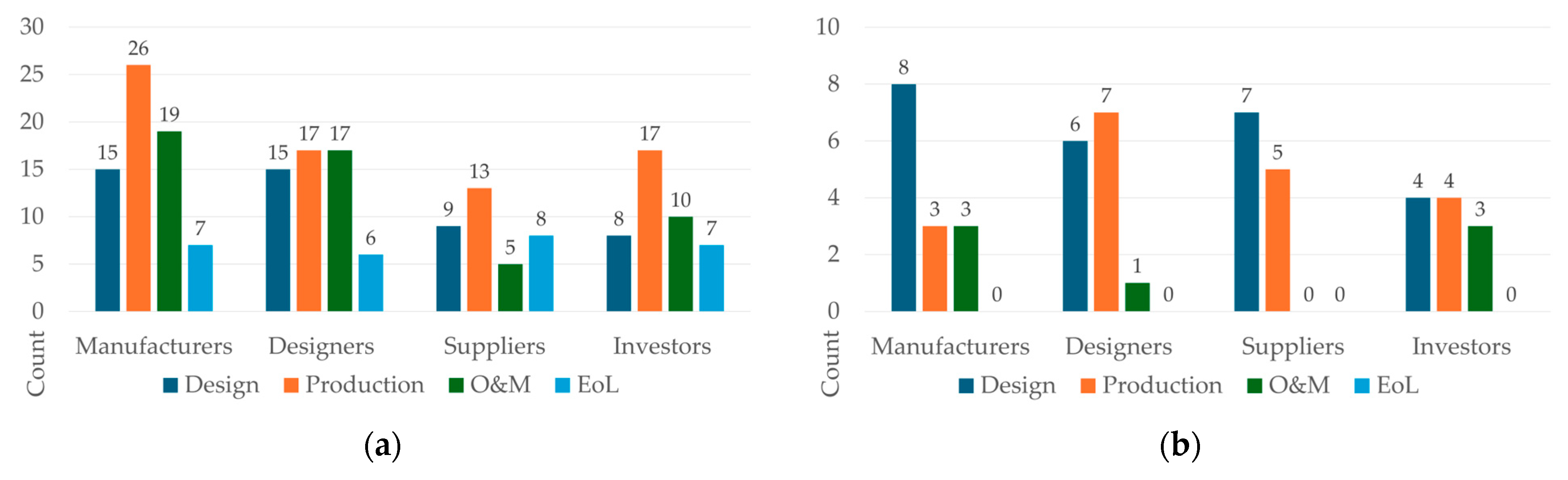

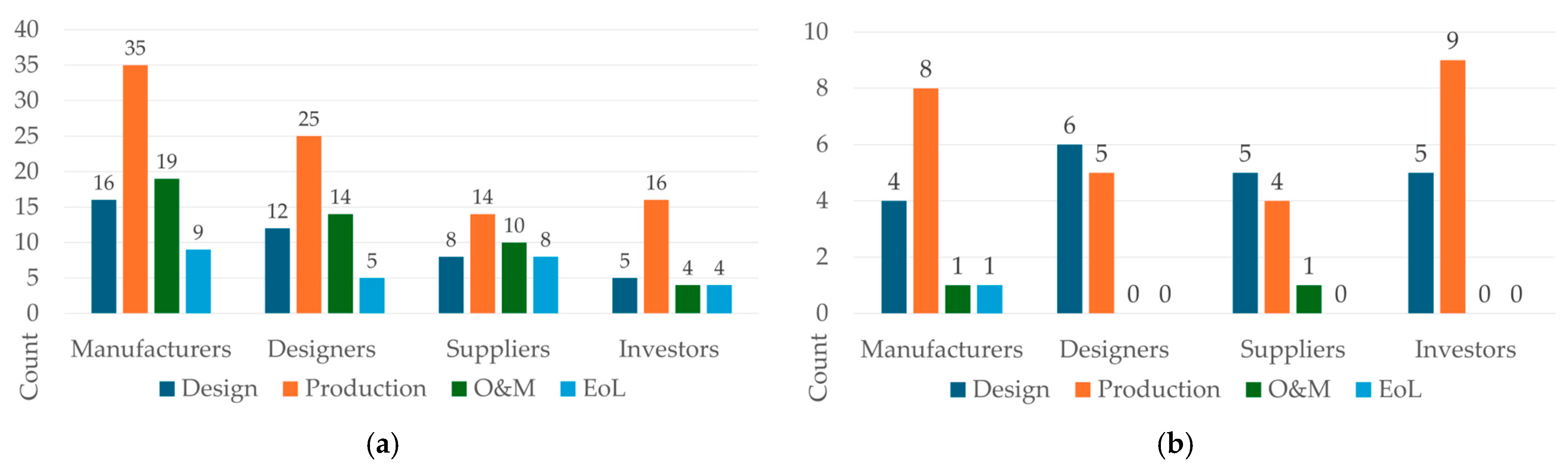

4.2. Distribution of Perceptions of Performance by Participant Group

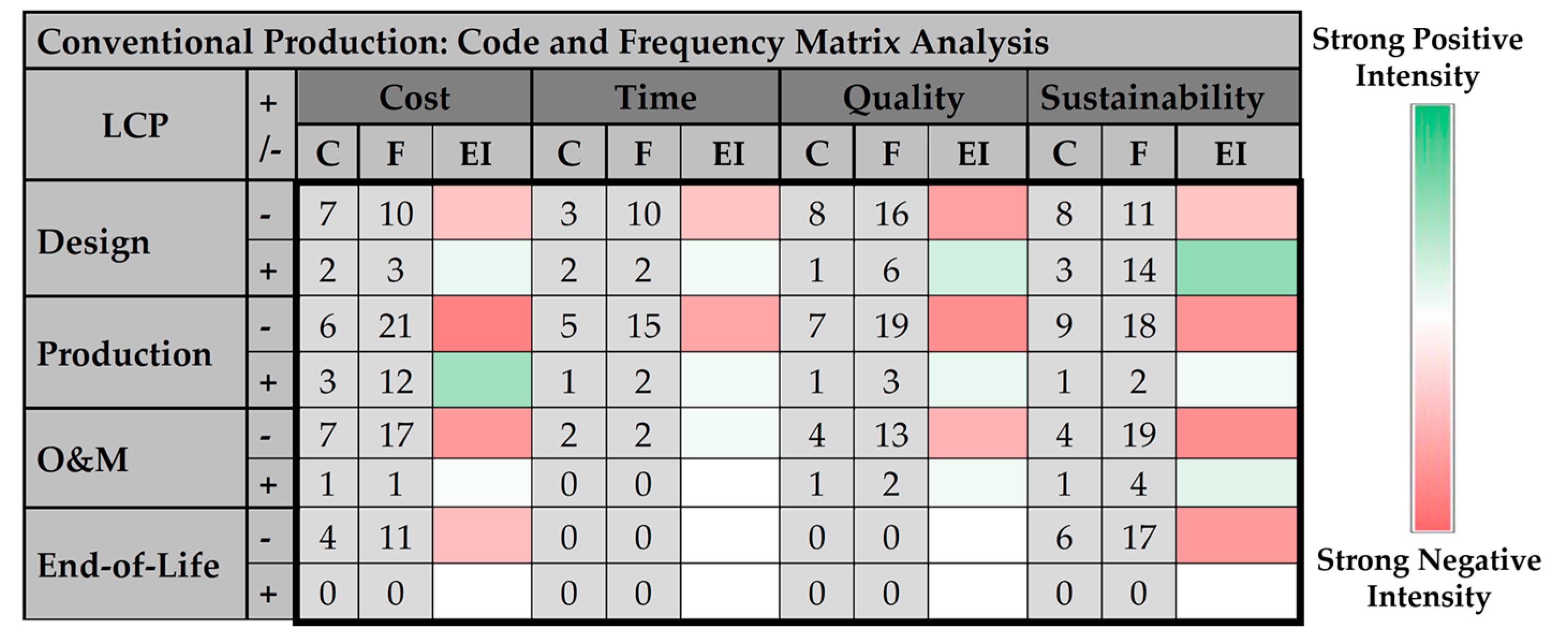

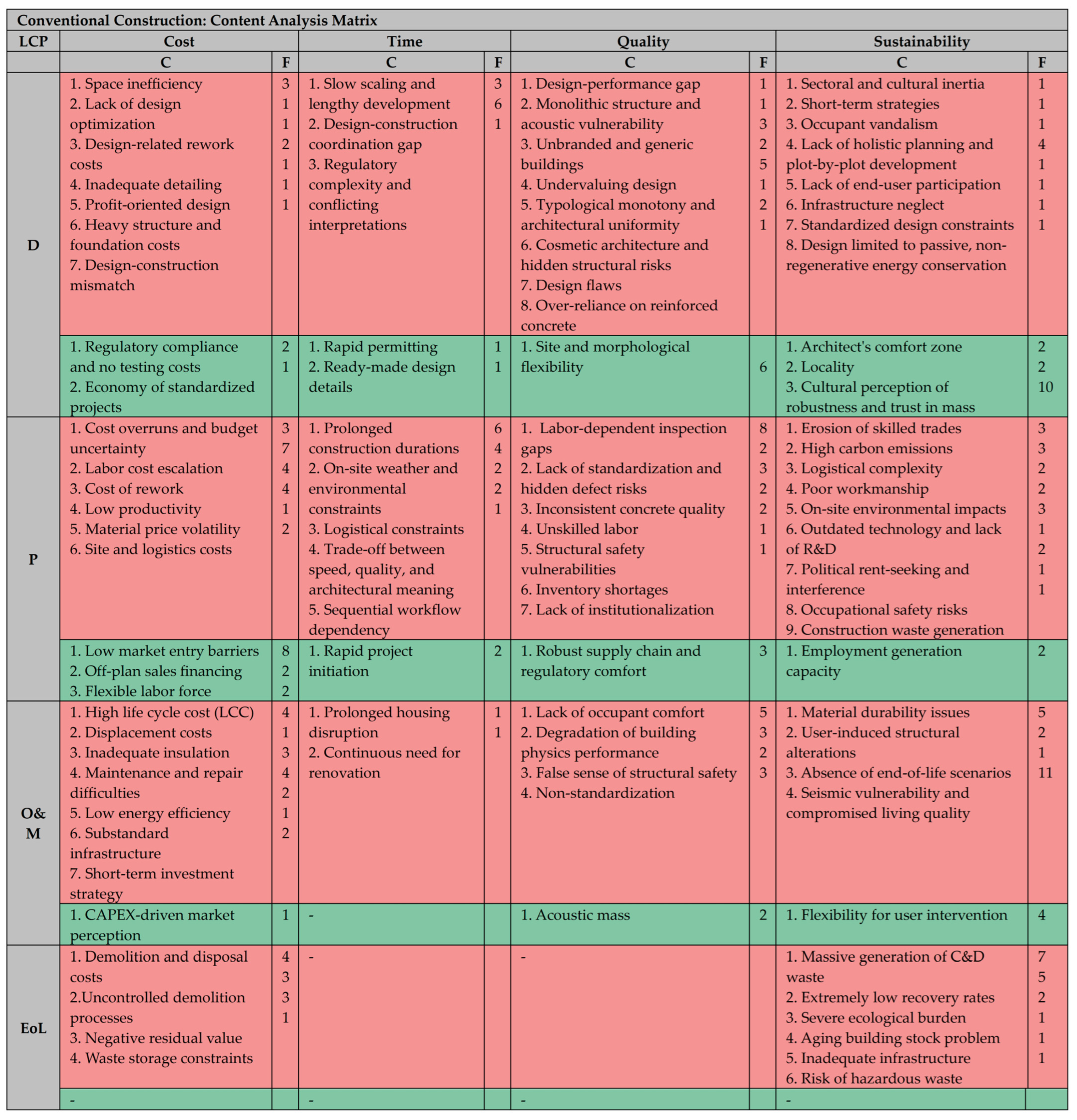

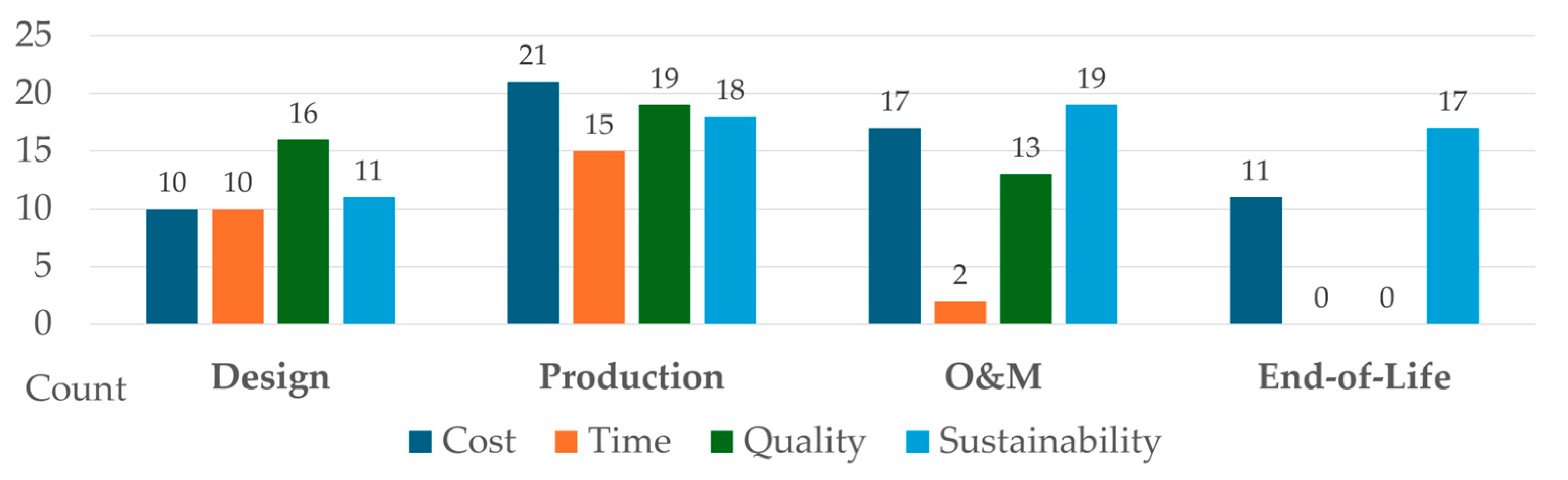

4.3. Conventional Construction Paradigm: Systematic Weaknesses and Structural Limitations
4.3.1. Design: Methodological Weaknesses
- Cost Burden Passed on to Production: Design decisions translate directly into financial burdens for the production phase. Inefficiencies in the cost structure begin primarily with a 5–9% volumetric loss caused by reinforced concrete sections that are made cumbersome by seismic requirements (E1). Cost erosion in the process is fuelled by a chain of methodological weaknesses that begins with the lack of standard library logic, deepens with inadequate detailed design, and is locked in by economic rent pressure that prioritises maximum square metres over quality. Treating each project as a prototype from scratch makes design optimisation impossible.
- Temporal Stagnation and Ontological Disconnection: Temporal inefficiency begins with slow scaling and a long development process triggered by a lack of standardization. The coordination gap created by the ontological disconnect between design and site extends the construction schedule. Regulatory complexity and differences in interpretation lock administrative processes, dragging the design phase into unpredictable sluggishness.
- Identity Erosion: Within the sector, design has been reduced to a bureaucratic procedure rather than a process of producing unique value, transforming into a systemic dysfunction. Formulaic structures designed with construction clichés produce homogenized structures disconnected from user needs. Anonymous user profiles and regulatory constraints limit architectural diversity, resulting in an aesthetic-deprived typological stagnation. This approach, in which structural weaknesses are masked by luxurious facades and described by participants as a cosmetic concealment of structural vulnerabilities, masks a lack of technical depth with surface-level aesthetic treatments.
- Unsustainable Approach: The design concept treats the structure not as a cyclical entity, but as a temporary consumer object with an economic lifespan limited to 30–35 years (E2). This design approach, which strips the concept of sustainability of its regenerative solutions and reduces it to mere passive insulation details, turns the system into a massive construction burden that will be passed on to future generations. The parcel-based design concept, which rejects holistic urban planning, strains the urban infrastructure and produces chronic negative externalities.
4.3.2. Production: Productivity Decline and the Labour Paradox
- Cost Inversion and Financial Erosion: Findings regarding the cost structure of production indicate that it is characterised by an asymmetric cost inversion, where the historical material-labour cost balance (70/30) has reversed, with labour becoming dominant (40/60; E1). This structural change, combined with a low productivity barrier of 40 man-hours per square metre (E3), restricts the system to an expensive labour platform; the 18–24 month sluggish process (E6), defined by participants as financial erosion, is seen to trigger budget deviations and general expenses in an inflationary environment. It has been determined that leaving production entirely to the initiative of skilled workers, rather than technology, has chronicled non-standard manufacturing and rework cycles in the field, making the cost of correcting faulty work the largest hidden expense item that consumes the project’s profitability.
- Temporal Inertia and Environmental Determinism: In the temporal dimension, the conventional system is defined by participants as an open-air factory; it is emphasised that the production speed is dependent on physical limits that cannot be accelerated, such as climatic conditions, daylight, and the chemical setting time of concrete, as well as the requirement for sequential workflows that prevent parallel manufacturing. Meeting mass housing demand at this craft speed is seen as mathematically impossible; the 1.5–2 year processes that delay the return on investment (ROI) create an economic bottleneck (E13). Logistical constraints, particularly the 80 km limit on ready-mixed concrete and the lock-in of construction sites in regional densities, completely eliminate the system’s scalability (E2).
- Non-Standard Production and Structural Fragility: From a quality and safety perspective, the fact that production is far from standardised and is entirely left to the momentary performance and initiative of the worker stands out as a systemic weakness. The reduction of control mechanisms to a bureaucratic formality and the dominance of informal relationship networks in the field pave the way for hidden flaws that lead to fatal consequences, such as interference with concrete quality. The collapse of even new buildings that complied with regulations after earthquakes confirms this control crisis and has created a lasting structural safety anxiety in society.
- Technological Stagnation and Ecological Burden: In terms of sustainability, the sector is described as a technologically stagnated environment where the skilled workforce is eroding and the younger generation does not choose construction due to primitive working conditions. Marginal levels of R&D investment and the persistent use of outdated production techniques from half a century ago have transformed the sector into a significant environmental contributor responsible for 38% of global carbon emissions (E1). This labour-intensive regime, which excludes innovation and feeds on rent mechanisms, proves to be a linear process of depletion that inevitably produces the future demolition waste and results in severe environmental burdens, rather than meeting the housing needs of the future.
4.3.3. Operation & Maintenance: Performance Degradation
- High Life Cycle Cost and Operational Lock-in: The service life of conventional structures, characterised by early structural ageing starting at 20–22 years and the necessity for demolition recurring at 40-year intervals, demonstrates unsustainable inefficiency in terms of LCC (E3). Contractors’ commercial perspective, which prioritises only the initial investment cost (CAPEX), excludes qualified infrastructure investments that would minimise operating expenses (OPEX), condemning the user to a lifelong economic burden. This cost spiral is further exacerbated by the operational lock-in created by the embedded infrastructure and installation architecture; even the simplest revision can turn into a costly, destructive repair, making operating expenses an uncontrollable burden.
- Housing Disruption and Chronic Incompleteness: The temporal dimension is defined by a radical housing disruption and loss of spatial belonging, displacing users for 18–24 months during urban transformation processes (E1). In the post-delivery phase, the never-ending construction site syndrome, arising from the structure’s inability to meet user needs, traps the building in a state of chronic incompleteness, with renovations and additions continuing throughout its lifetime.
- Structural Pathology and Perceptual Illusion: Leaving the quality parameters during the usage process to the ethical initiative of contractors rather than supervision transforms the structure into an area of chronic discomfort and pathology. The violation of acoustic privacy evolves into a source of psycho-social tension that damages neighbourly relations, while the failure to provide thermal comfort forces users into inefficient retrofitting solutions. In this scenario, where waterproofing errors trigger reinforcement corrosion, dragging the building into a phase of structural fatigue within 30 years (E9), the public’s perceptual illusion of coding the solid sound coming from heavy structural elements as robustness is a dangerous cultural barrier that masks the risk of earthquakes.
- Seismic Insecurity: From a sustainability perspective, the conventional stock, with its limited 50-year lifespan (E6), deviates from the definition of permanent housing and exhibits the character of a temporary shelter that rapidly deteriorates under external influences. The absence of a dismantling scenario transforms the structure into a pile of rubble that cannot be recovered at the end of its life, while the unconscious interventions made by users in their search for comfort further disrupt the structural balance of the building. However, the heaviest toll of the system is that structures rotting from within due to reinforcement corrosion confine millions of users within structurally substandard residential stock, increasing the seismic risk pool, offering a humanly unsustainable quality of life that trades the right to shelter for anxiety about life safety.
4.3.4. End-of-Life: Ecological Terminalism and the Negative Value Table
- Structural Deadlock as a Negative Value and Expense Item: Economic analyses reveal that conventional stock ceases to be an asset at the end of its life cycle and becomes a financial burden characterized by negative residual value due to the constraints of recovering reinforced concrete rubble and high disposal costs. Uncontrolled demolition processes carried out using the ‘hit-and-break’ method, which leads to storage crises, document that the process results in the destruction of urban wealth, along with the damage it causes to the environment and infrastructure.
- Institutional Void in Time and Quality Parameters: The absence of data in the time and quality cells of the methodological matrix does not represent a data deficiency; rather, it represents a systemic void created by established practices that reduce recycling to demolition-focused excavation rather than technical deconstruction. The absence of deconstruction quality and efficiency metrics proves the conventional system’s ontological incompatibility with the circular economy and its primitive character, which indexes the process solely to the speed of rubble removal.
- Linear Depletion and Unmanageable Debris: Findings on sustainability document that the conventional system is a linear depletion model that produces billions of cubic metres of demolition and construction waste. The heavy ecological burden created by reinforced concrete structures, which have a disproportionate mass density compared to steel equivalents, breaks the value chain by combining with the material’s down-cycling only as road fill and low recovery rates. Furthermore, the risk of hazardous waste arising from petroleum-derived insulation materials mixing with rubble increases environmental toxicity, while the existing stock of old buildings leaves cities with an unmanageable legacy of debris and ecological terminalism.
4.4. Conventional Construction Paradigm: Systematic Strengths and Opportunities
4.4.1. Design: Corporate Integration and Morphological Flexibility
4.4.2. Production: Financial Comfort and Legal Protection
4.4.3. Operation & Maintenance: Perceptual Economy and Property Autonomy
4.4.4. End-of-Life: Systematic Silence

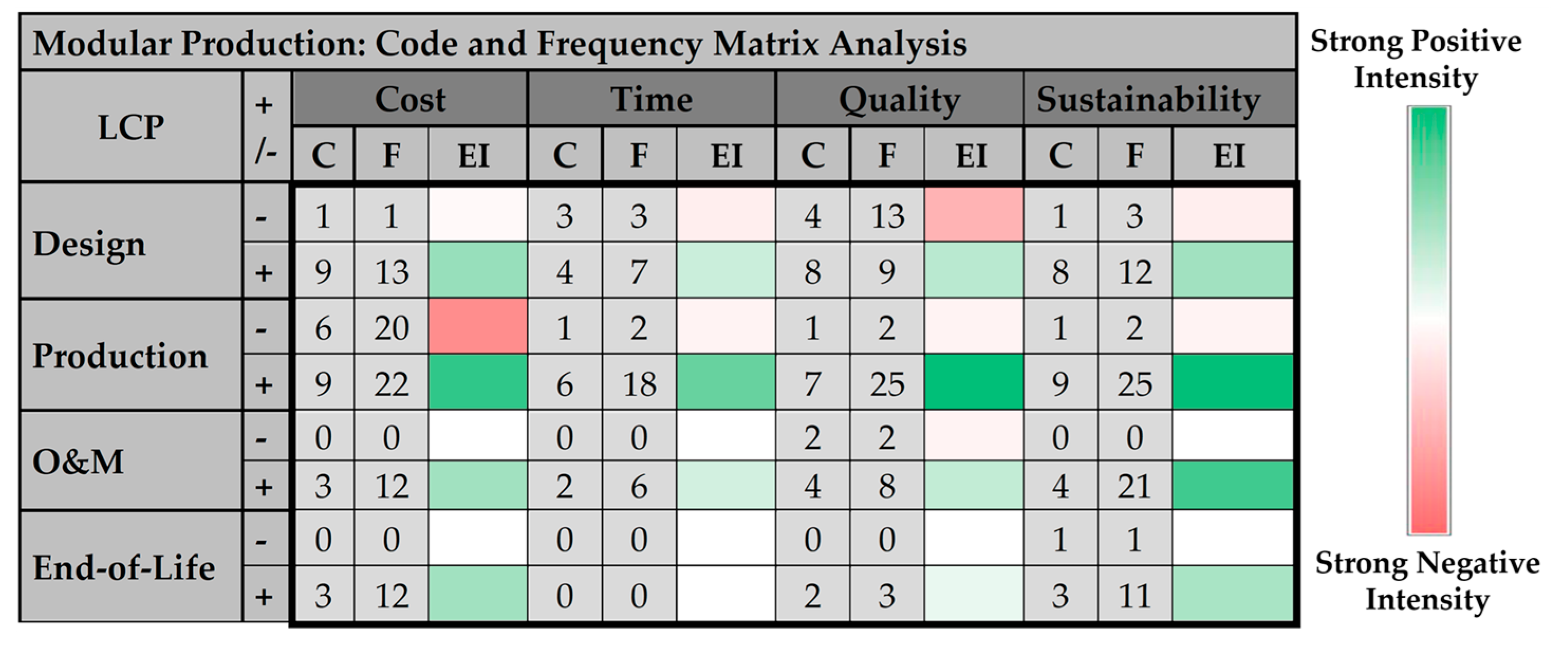

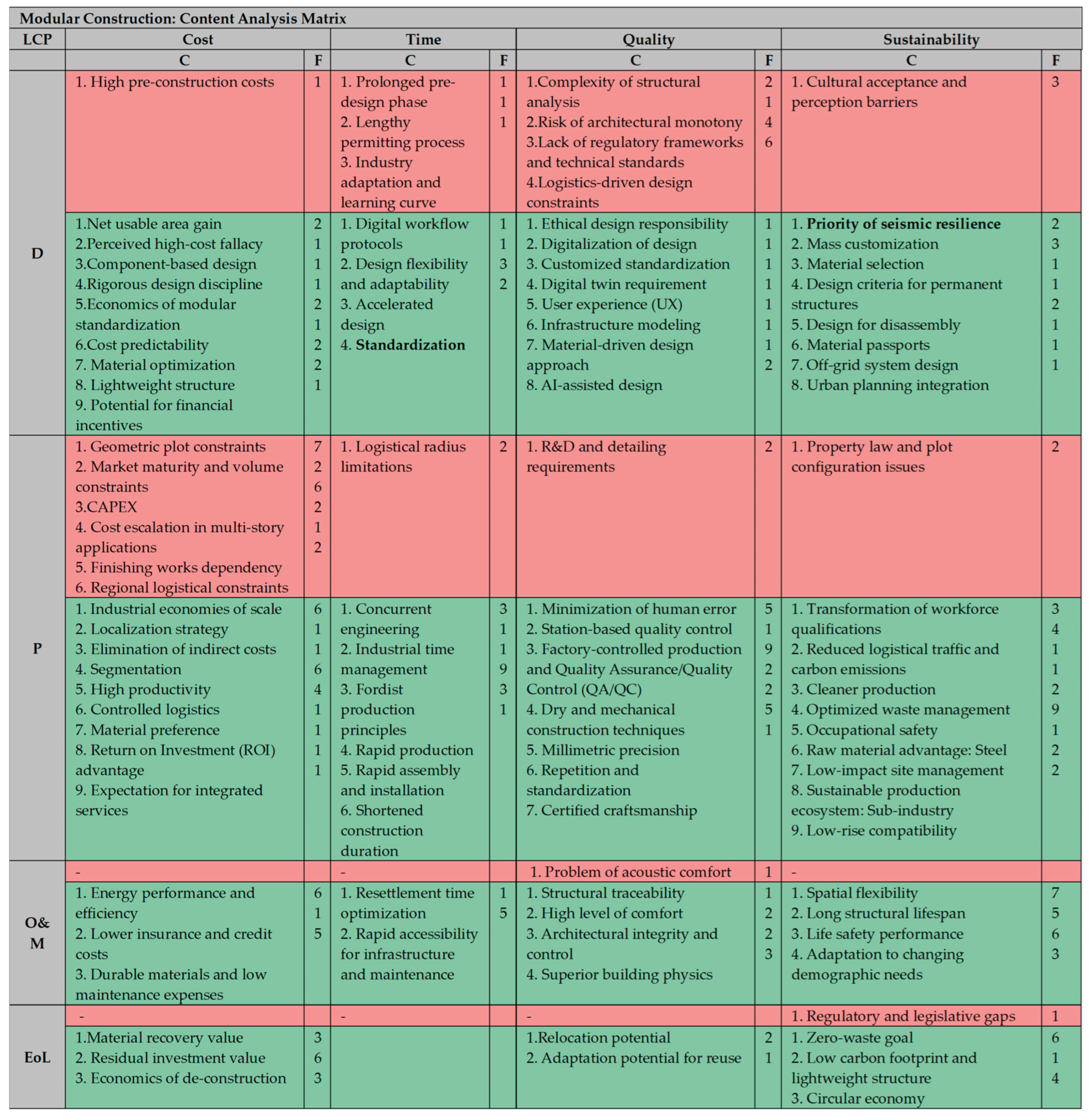

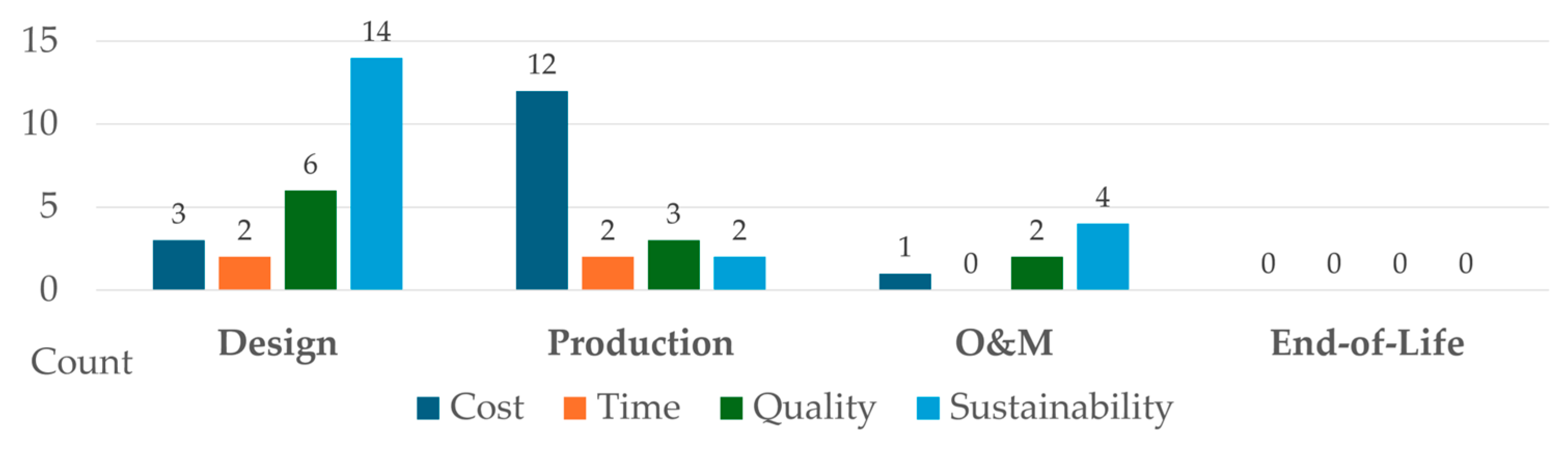

4.5. Modular Construction Paradigm: Systematic Strengths and Opportunities
4.5.1. Design
- Design-Driven Cost Management and Volumetric Efficiency: Analyses at the intersection of design and cost indicate that the modular system has the potential to balance the high cost perception in the sector with the marginal share of the supporting skeleton in the total budget and the net space gain it provides. Compared to reinforced concrete, steel design with delicate sections is predicted to create a feasibility advantage of up to 30% and to enable optimisation of basic costs through the principle of lightness (E10). Process findings indicate that a disciplined design, structured with component-based libraries and modular standardisation economics, can transform the uncertainty risks and budget deviations of tailor-made production into a calculable financial model.
- Digital Synchronisation and Accelerated Design Cycles: Findings show that the use of digital workflow protocols (BIM and Digital Twin) transforms the design process from mere visualisation into an industrial recipe that dictates speed and accuracy in production. Supported by artificial intelligence and component libraries, this assembly concept reduces project times to the level of rapid design, while standardisation in wet areas and Lego logic gives the system a dynamic adaptation capability that does not require drawing repetition.
- Cognitive Transformation and Digital Excellence: The concept of quality in the system is based on a cognitive revolution shaped by the ethical design responsibility of architects and engineers and material-specific design awareness, rather than physical control. In this process, where digital tools are positioned as error-free controllers rather than options, a holistic approach ranging from terrain simulation to component-based 3D precision is essential. Ultimately, customised standards that break the cube perception and VR/AR integration elevate design quality to an experiential dimension (UX) by involving the user in the process.
- Seismic Assurance and Circular Life: Findings on the sustainability axis indicate that design motivation is shaped by seismic resilience (social sustainability), a local necessity, rather than global ecological trends. In this context, where the system is approached with permanent structure criteria rather than temporary shelter perceptions, it is observed that demountable design (DfD), which aims for disassembly rather than demolition, and material passport applications that enable resource tracking, tend to transform the structure from a linear waste model to a circular resource. Furthermore, it is noted that the industrial standard in the carrier, supported by mass customisation and off-grid autonomy pursuits in the user interface, strives to establish a balance between environmental adaptation and architectural diversity.
4.5.2. Production: Fabrication Determinism
- Industrial Scale Economy and Package-Based Cost Structure: Data shows that the competitive strength of the modular system emerges when industrial scale economy comes into play rather than individual production, and that costs can be radically reduced through mass production. In this process, the elimination of indirect costs such as site overheads and financing burdens, along with high productivity advantages, emerges as a key factor strengthening the system’s economic viability. In terms of cost manageability, the segmentation and hardware package approach, where the carrier frame (chassis) remains fixed and the user interface can be customised according to budget, offers a flexible financial model similar to that of the automotive sector. While the localisation strategy (regional production) and the necessity for controlled logistics close to raw materials are emphasised to overcome logistical bottlenecks, it is determined that the commercial success of the system depends on the advantage of a rapid return on investment (ROI) and the capacity to offer integrated services (turnkey), including infrastructure.
- Parallel Process Management and Fordist Speed Protocols: Findings document that the simultaneous engineering model, in which site preparation and factory production are carried out synchronously, radically shortens construction times. This structure, which provides 24/7 operational continuity by freeing production from climate and daylight constraints, demonstrates the potential to increase unit production speed to one module per minute, thanks to Fordist production principles transferred from the automotive sector and robotic lines. The process’s speed, which is up to four times faster than conventional methods, translates into strategic value for investors by reducing financing costs, while the rapid on-site assembly capability (12 min per module) minimises construction time and environmental impact (E4).
- Deterministic Control and Industrial Excellence: Findings in production and quality document that the process has evolved into a deterministic industrial standard, free from the uncertainty of human initiative in the construction site environment. The station-based quality assurance/quality control (QA/QC) mechanism, transferred from the automotive sector, physically prevents defective production from passing to the next stage, thereby eliminating the risk of rework. Meanwhile, the millimetric precision achieved through dry and mechanical construction techniques frees the structure from centimetric construction site tolerances. In this context, standardisation is not a monotonous repetition, but a cumulative improvement process where the same detail is produced thousands of times to achieve perfection. This cycle, which eliminates the need to reinvent each time, transforms the construction practice into an experienced industrial product, optimised with certified workmanship and free from prototype risks.
- Strategic Raw Material Power and Industrial Ecosystem: Working from a sustainability perspective points to the emergence of a new employment paradigm in the construction sector. This transformation from construction labour to assembly operator strengthens social belonging and job security thanks to a fixed workplace (factory) and controlled working conditions; it offers a sustainable career path that is compatible with technology and counteracts the erosion of the master-apprentice relationship. Utilising Turkey’s 65 million tonne steel production capacity as a strategic raw material resource, this model establishes a regenerative ecosystem where waste management is controlled within the factory and structures can be dismantled and re-evaluated (E1, E9, E10).
4.5.3. Operation & Maintenance: Institutionalisation of Performance and Product-Focused Life Cycle
- Industrial–Financial Assurance: From a cost perspective, participants emphasise that bundle insulation and layered wall structures, made possible by manufacturing precision, eliminate thermal bridges, leading to a radical reduction in operating costs. The energy-producing building concepts mentioned by experts point to the potential for the structure to transform from a financial burden for the user into an asset that offers energy independence. Furthermore, the system’s compliance with industrial standards creates the opportunity for it to be classified as a low-risk product in terms of insurance and credit mechanisms.
- Disciplined management: Experts who draw attention to the issue of maintenance and repair in terms of time highlight the concept of spare parts logic. Unlike traditional demolition-focused interventions, the planned access to installation shafts in modular systems and the ability to replace faulty components using the plug-and-play method transform maintenance processes into a millimetre-precise assembly discipline. It has been found that the resettlement time in urban transformation is radically shortened thanks to parallel production, which is a critical finding that minimises the burden of rent and relocation on users.
- Industrial Performance: In terms of quality, the structural traceability provided by the modular system’s steel skeleton allows the structure to remain controllable and transparent throughout its lifetime, unlike concrete. Experts note that the air-tightness resolved in the factory environment and the application of vibration-damping blocks overcome the acoustic and thermal weaknesses of traditional systems. On the user side, this situation is described as unlimited spatial adaptation freedom, achieved by removing and installing partition walls in the interior, while preserving the main structure of the building like a work of art.
- Permanent Safety: Sustainability analysis presents the structural lifespan of galvanised steel, predicted by experts to be up to 250 years (E9, E10), as an argument for permanent construction. The building’s lightness minimises seismic loads, and its absolute commitment to life safety, with the goal of creating buildings where people will not die, is the strongest source of motivation in interviews. Consequently, the modular system stands out as a regenerative housing paradigm that can respond to the minimalist and functional demands (mass customisation) of changing demographic needs, such as those of Generation Z, and can be tracked throughout its lifetime with a material passport.
4.5.4. End of Life: Circular Economy and Deposit Model
- Valuable Investment: From a cost perspective, interview data conceptualises the economic value of steel structures using the metaphor of the ‘Deposit Model’. Participants describe building a modular structure not as spending money, but as leaving a deposit to be recovered in the future. While demolition is an expense in the conventional system, the 100% recyclability of the steel chassis and its scrap value based on foreign exchange rates in the modular system transform the building into an insurance policy or investment vehicle that can be converted into cash even at the end of its life. Findings under the heading of the de-assembly economy demonstrate that dismantling a structure rather than demolishing it allows not only steel but also components such as doors, windows, and boilers to be reused in other structures as donor parts, thereby turning demolition costs into profit.
- Spatial Dynamism: Participants highlight the concept of relocation potential (portability). The ability to dismantle a modular structure after 20 years and relocate it to another site, or to replace its internal modules according to functional needs, breaks the structure’s dependence on its physical location and initial design (E2). This allows the building to evolve from a frozen mass in time and space into a dynamic entity that adapts to technological developments and changing demographic demands.
- Circular Waste Management: In the sustainability analysis, the ‘Zero Waste Goal’ emerges as the strongest theme. Experts state that optimisation in the factory environment minimises production waste, while in the construction phase, clean assembly processes replace the generation of rubble. The structure being 22 times lighter than reinforced concrete reduces the amount of raw materials extracted from nature and the ecological burden by the same proportion (E3). As a result, the modular system offers a circular economy paradigm that leaves behind a legacy of resources rather than waste for the environment, where materials can be separated magnetically and reused at a 100% rate, dismantling takes precedence over demolition, and the cycle is tracked with a material passport.
4.6. Modular Construction Paradigm: Systematic Weaknesses and Structural Limitations
4.6.1. Design: The Systemic Rigidity Paradox and Logistical–Cultural Boundaries
4.6.2. Production: Industrial Rigidity, Scale Paradox and Spatial Incompatibility
4.6.3. Operation & Maintenance: Acoustic Barrier
4.6.4. End-of-Life Phase: Regulatory Inertia and Legal Uncertainties
5. Discussion
5.1. Complementary Solutions
5.1.1. Design: Ontological Integration and Digital Precision
5.1.2. Production: Industrial Rationalisation and Process Determinism
5.1.3. Operation & Maintenance: Integrated Life Assurance and Socio-Economic Transformation
5.1.4. End-of-Life: Transformation from Recycling Obligation to Asset and Transition from Linear to Circular
5.2. Structural Trade-Offs
5.3. Internal Paradoxes and Recommendations
5.4. Methodological Reflections and Limitations
5.5. Global Implications for Seismically Active Regions
6. Conclusions
6.1. Summary of Key Findings
6.2. Phased Transition Model and Future Vision
- Stage I: Institutional Prerequisites, Regulatory and Labour Force Reform: The transformation must begin with open-source guidelines drawn up by civil initiatives based on professional rationality rather than bureaucracy. These guidelines, which are an absolute prerequisite, must be put into operation through the implementation by state authorities of product type approval and digital licensing legislation that shifts oversight from the construction site to the factory. In parallel with the legal framework, a comprehensive training and workforce reform must be launched to ensure that the administrative transformation is fully reflected on the ground.
- Stage II: Financial Innovation and Hybrid Adaptation: Once legal legitimacy is established, the financial system should classify modules as transferable securities rather than land-dependent real estate. Concurrently, conventional practices for managing the amorphous urban fabric should not be abruptly excluded; phased hybrid solutions, where volumetric modules are the primary focus and are integrated with panel and traditional systems, should be implemented on-site. At this stage, the contractor evolves from a mere builder into a systems integrator coordinating assembly logistics.
- Stage III: Industrial Maturity and Continuous Updating: Full-scale implementation cannot be achieved without the investor confidence provided by the financial adaptation and hybrid solutions of Stage II. Island-based transformations gain momentum alongside proven demand pools. In this final stage, modular lightness is rebranded not as a weakness but as seismic advanced technology. Housing ceases to be a static asset and transforms into a living product that is continuously updated and improved through user feedback, much like in the automotive sector.
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Acknowledgments
Conflicts of Interest
Abbreviations
| (+) | Positives/Strengths |
| (−) | Negatives/Weaknesses |
| BIM | Building Information Modeling |
| C | Code Count |
| C&D | Construction and Demolition |
| CAPEX | Capital Expenditure |
| DfD | Design for Disassembly |
| DfMA | Design for Manufacture and Assembly |
| EI | Emphasis Intensity |
| EoL | End-of-Life |
| F | Frequency |
| LCA | Life Cycle Assessment |
| LCC | Life Cycle Costing |
| LCP | Life Cycle Phase |
| MC | Modular Construction |
| O&M | Operation & Maintenance |
| OPEX | Operational Expenditure |
| QA/QC | Quality Assurance/Quality Control |
| R&D | Research and Development |
| ROI | Return on Investment |
| VR/AR | Virtual Reality/Augmented Reality |
Appendix A
| Expert Code | Sectoral Role | Institution Type | Position | Years of Experience | Education |
|---|---|---|---|---|---|
| E1 | Manufacturer | Modular/Steel Structure Manufacturer | Founder | >20 Years | Bachelor’s Degree |
| E2 | Manufacturer | Modular/Steel Structure Manufacturer | Managing Director | >20 Years | Master’s Degree |
| E3 | Manufacturer | Modular/Steel Structure Manufacturer | Founder | >20 Years | Bachelor’s Degree |
| E4 | Manufacturer | Modular/Steel Structure Manufacturer | Engineer | >20 Years | Master’s Degree |
| E5 | Designer | Architectural Design Office | Principal Architect | 5–10 Years | Bachelor’s Degree |
| E6 | Designer | Architectural Design Office | Co-founder/Architect | >20 Years | Bachelor’s Degree |
| E7 | Designer | Architectural Design Office | Architect/Academic | 5–10 Years | Master’s Degree |
| E8 | Designer | Architectural Design Office | Architect | 5–10 Years | Bachelor’s Degree |
| E9 | Supplier | Construction Materials Manufacturer | Founder | >20 Years | Master’s Degree |
| E10 | Supplier | International Supply Chain Firm | Director | >20 Years | Ph.D. |
| E11 | Supplier | Construction Materials Manufacturer | Director | >20 Years | Master’s Degree |
| E12 | Investor | Private Sector Housing Developer | Co-founder | >20 Years | Bachelor’s Degree |
| E13 | Investor | Private Sector Housing Developer | Co-founder | >20 Years | Bachelor’s Degree |
| E14 | Investor | Private Sector Housing Developer | Co-founder | 5–10 Years | Master’s Degree |
Appendix B
| Question Guide of the Interviews |
|---|
| 1- What does conventional construction practice bring to mind? |
| 2- What is the first obstacle that comes to mind when you hear the term ‘modular system’? |
| 3- How is the Turkish construction sector currently performing in terms of cost, quality, time and sustainability; what are the main problems and structural barriers shaping this picture? |
| 4- Specifically regarding Turkey’s existing housing stock and the production of new housing, what are the strengths and weaknesses within the life cycle context, taking into account the design, production, operation & maintenance, and end-of-life stages? |
| 5- Within this framework, what are the most common issues encountered in today’s conventional housing production system in terms of product (design/components) and process (procurement–production–logistics–construction site)? |
| 6- How do you view the feasibility of applying an industrial-based modular system in urban regeneration and housing production in Turkey? What might the key challenges and opportunities be? |
| 7- What opportunities and challenges might modular housing bring during the design phase? (Aesthetics, functionality, materials, speed, quality, etc.) |
| 8- What are the key elements in product design and the design process? What strategies can be developed? |
| 9- In areas characterised by dense urban fabric and plot typologies featuring diverse forms and dimensions, how can modular designs be developed? |
| 10- What are the possibilities for using high-quality, sustainable and cost-effective materials? Which materials can be used to design building components? |
| 11- How can standardisation and flexible design (customisation) be achieved in building components, and at what scales? |
| 12- In what ways can the modular housing production process add value? Furthermore, how would you assess its impacts in terms of time, cost, quality and sustainability? |
| 13- What are the potential challenges and opportunities arising at the product and process levels during the production phase? |
| 14- How can a production organisation (such as a factory, production scale, supply chain, logistics) be developed in areas with dense urban fabric, such as Istanbul? |
| 15- Within this organisation, how can coordination and task allocation among stakeholders (such as investors, contractors, architects and engineers, suppliers, the state, and customers) be ensured? |
| 16- Can modular housing create added value compared to conventional housing in terms of operation and maintenance costs and comfort conditions? What strategies can be developed? |
| 17- By what methods can a space be functionally and aesthetically transformed or customised to adapt to users’ changing needs? |
| 18- In terms of energy efficiency, ease of repair and longevity, what contributions can a modular system make? What strategies can be developed? |
| 19- What challenges are encountered with the existing housing stock in Turkey as it reaches the end of its life cycle? |
| 20- Can prefabricated modular housing create added value in the recycling process? Within this framework, how should the conversion process of a housing unit that has reached the end of its technical life be managed? |
| 21- What are the key characteristics a residential property should possess in terms of ease of recycling, quality and process costs at the end-of-life stage? |
| 22- Finally, is there any other opinion, experience or point you would like to share regarding this topic? |
Appendix C



References
- Barbosa, F.; Mischke, J.; Parsons, M. Improving Construction Productivity; McKinsey & Company: Hong Kong, China, 2017; Available online: https://www.mckinsey.com/capabilities/operations/our-insights/improving-construction-productivity (accessed on 12 January 2026).
- Woetzel, J.; Mischke, J.; Barbosa, F.; Ribeirinho, M.J.; Sridhar, M.; Parsons, M.; Bertram, N.; Brown, S. Reinventing Construction: A Route to Higher Productivity; McKinsey Global Institute: Beijing, China, 2017; pp. 1–168. Available online: https://www.mckinsey.com/~/media/mckinsey/business%20functions/operations/our%20insights/reinventing%20construction%20through%20a%20productivity%20revolution/mgi-reinventing-construction-a-route-to-higher-productivity-full-report.pdf (accessed on 12 January 2026).
- Sveikauskas, L.; Rowe, S.; Mildenberger, J.D.; Price, J.; Young, A. Productivity Growth in Construction. J. Constr. Eng. Manag. 2016, 142, 04016045. [Google Scholar] [CrossRef]
- Mischke, J.; Stokvis, K.; Vermeltfoort, K.; Biemans, B. Delivering on Construction Productivity Is No Longer Optional; McKinsey & Company: Hong Kong, China, 2024; Available online: https://www.mckinsey.com/capabilities/operations/our-insights/delivering-on-construction-productivity-is-no-longer-optional (accessed on 12 January 2026).
- Rathnayake, A.; Middleton, C. Systematic Review of the Literature on Construction Productivity. J. Constr. Eng. Manag. 2023, 149, 03123005. [Google Scholar] [CrossRef]
- Shiha, A.; El-adaway, I.H. Identifying Early Warning Signs of Construction Labor Shortages. Constr. Manag. Econ. 2025, 43, 765–793. [Google Scholar] [CrossRef]
- Türkiye İstatistik Kurumu (TÜİK). İstatistik Göstergeler/Statistical Indicators 1923–2011; Yayın No: 3890; Türkiye İstatistik Kurumu: Ankara, Türkiye, 2012; Available online: https://cdn.teyit.org/wp-content/uploads/2019/11/istatistikgostergeler.pdf (accessed on 28 January 2026).
- Türkiye İstatistik Kurumu (TÜİK). Adrese Dayalı Nüfus Kayıt Sistemi Sonuçları, 2022; Türkiye İstatistik Kurumu: Ankara, Türkiye, 2023. Available online: https://data.tuik.gov.tr/Bulten/Index?p=Adrese-Dayali-Nufus-Kayit-Sistemi-Sonuclari-2023-49685 (accessed on 28 January 2026).
- İstanbul Büyükşehir Belediyesi (İBB). İstanbul Deprem Çalıştayı (2–3 Aralık 2019) Raporu; İstanbul Büyükşehir Belediyesi: İstanbul, Türkiye, 2019. Available online: https://depremzemin.ibb.istanbul/uploads/prefix-idc-2019-668637456e49a.pdf (accessed on 15 January 2026).
- Bertram, N.; Fuchs, S.; Mischke, J.; Palter, R.; Strube, G.; Woetzel, J. Modular Construction: From Projects to Products; McKinsey & Company: Hong Kong, China, 2019; pp. 1–34. Available online: https://www.mckinsey.com/~/media/mckinsey/business%20functions/operations/our%20insights/modular%20construction%20from%20projects%20to%20products%20new/modular-construction-from-projects-to-products-full-report-new.pdf (accessed on 12 January 2026).
- Yang, Z.; Lu, W. Facility Layout Design for Modular Construction Manufacturing: A Comparison Based on Simulation and Optimization. Autom. Constr. 2023, 147, 104713. [Google Scholar] [CrossRef]
- Wuni, I.Y.; Shen, G.Q. Holistic Review and Conceptual Framework for the Drivers of Offsite Construction: A Total Interpretive Structural Modelling Approach. Buildings 2019, 9, 117. [Google Scholar] [CrossRef]
- Zhang, Y.; Pan, M.; Pan, W.; Yang, Y.; Wu, J. Enhancing Modular Construction Supply Chain: Drivers, Opportunities, Constraints, Concerns, Strategies, and Measures. Develop. Built Environ. 2024, 18, 100408. [Google Scholar] [CrossRef]
- Jaillon, L.; Poon, C.S. The Evolution of Prefabricated Residential Building Systems in Hong Kong: A Review of the Public and the Private Sector. Autom. Constr. 2009, 18, 239–248. [Google Scholar] [CrossRef]
- Bayliss, S.; Bergin, R. The Modular Housing Handbook; RIBA Publishing: London, UK, 2020. [Google Scholar] [CrossRef]
- Woetzel, J.R. A Blueprint for Addressing the Global Affordable Housing Challenge; McKinsey Global Institute: Beijing, China, 2014; Available online: https://www.mckinsey.com/~/media/mckinsey/featured%20insights/urbanization/tackling%20the%20worlds%20affordable%20housing%20challenge/mgi_affordable_housing_executive%20summary_october%202014.ashx (accessed on 12 January 2026).
- Ismail, S.; Hon, C.K.H.; Crowther, P.; Skitmore, M.; Lamari, F. The Drivers and Challenges of Adopting the Malaysia Industrialised Building System for Sustainable Infrastructure Development. Constr. Innov. 2023, 23, 1054–1074. [Google Scholar] [CrossRef]
- Shin, J.; Choi, B. Design and Implementation of Quality Information Management System for Modular Construction Factory. Buildings 2022, 12, 654. [Google Scholar] [CrossRef]
- Li, H.X.; Al-Hussein, M.; Lei, Z.; Ajweh, Z. Risk Identification and Assessment of Modular Construction Utilizing Fuzzy Analytic Hierarchy Process (AHP) and Simulation. Can. J. Civ. Eng. 2013, 42, 1184–1195. [Google Scholar] [CrossRef]
- Lawson, M.; Ogden, R.; Goodier, C.I. Design in Modular Construction; CRC Press: London, UK, 2014; pp. 1–280. [Google Scholar] [CrossRef]
- Atkinson, R. Project Management: Cost, Time and Quality, Two Best Guesses and a Phenomenon, It’s Time to Accept Other Success Criteria. Int. J. Proj. Manag. 1999, 17, 337–342. [Google Scholar] [CrossRef]
- Kamali, M.; Hewage, K. Life Cycle Performance of Modular Buildings: A Critical Review. Renew. Sustain. Energy Rev. 2016, 62, 1171–1183. [Google Scholar] [CrossRef]
- Schoenborn, J. A Case Study Approach to Identifying the Constraints and Barriers to Design Innovation for Modular Construction. Master’s Thesis, Virginia Tech, Blacksburg, VA, USA, 2012. Available online: http://hdl.handle.net/10919/32397 (accessed on 25 February 2026).
- Wuni, I.Y.; Shen, G.Q. Barriers to the Adoption of Modular Integrated Construction: Systematic Review and Meta-Analysis, Integrated Conceptual Framework, and Strategies. J. Clean. Prod. 2020, 249, 119347. [Google Scholar] [CrossRef]
- Zakaria, A.S.; Gajendran, T.; Rose, T.; Brewer, G. Contextual, Structural and Behavioral Factors Influencing the Adoption of Industrialized Building Systems: A Review. Archit. Eng. Des. Manag. 2017, 14, 3–26. [Google Scholar] [CrossRef]
- Pan, W.; Dainty, A.R.J.; Gibb, A.G. Establishing and Weighting Decision Criteria for Building System Selection in Housing Construction. J. Constr. Eng. Manag. 2012, 138, 1239–1250. [Google Scholar] [CrossRef]
- Wuni, I.Y.; Shen, G.Q.; Osei-Kyei, R. Sustainability of Off-Site Construction: A Bibliometric Review and Visualized Analysis of Trending Topics and Themes. J. Green Build. 2020, 15, 131–154. [Google Scholar] [CrossRef]
- United Nations Environment Programme (UNEP). 2023 Global Status Report for Buildings and Construction: Beyond Foundations: Mainstreaming Sustainable Solutions to Cut Emissions from the Buildings Sector; UNEP: Nairobi, Kenya, 2024; Available online: https://wedocs.unep.org/rest/api/core/bitstreams/75c570dd-e011-4bfd-a8a0-2bdef38c0599/content (accessed on 17 January 2026).
- Ginga, C.P.; Ongpeng, J.M.C.; Daly, M.K.M. Circular Economy on Construction and Demolition Waste: A Literature Review on Material Recovery and Production. Materials 2020, 13, 2970. [Google Scholar] [CrossRef]
- Aye, L.; Ngo, T.; Crawford, R.H.; Gammampila, R.; Mendis, P. Life Cycle Greenhouse Gas Emissions and Energy Analysis of Prefabricated Reusable Building Modules. Energy Build. 2012, 47, 159–168. [Google Scholar] [CrossRef]
- Broad Group. Building a 30-Story Hotel in 15 Days. Available online: http://en.broad.com/NewsDetail-86.aspx (accessed on 23 March 2025).
- Zhang, Y.; Pan, W.; Teng, Y.; Chen, S. Construction Waste Reduction in Buildings through Modular and Offsite Construction. J. Manag. Eng. 2024, 40, 04024026. [Google Scholar] [CrossRef]
- Fraser, M.; Haigh, L.; Soria, A.C. The Circularity Gap Report 2023; Circle Economy: Amsterdam, The Netherlands, 2023; Available online: https://www.circularity-gap.world/2023 (accessed on 16 January 2026).
- Bernstein, H.M.; Gudgel, J.E.; Laquidara-Carr, D. Prefabrication and Modularization: Increasing Productivity in the Construction Industry; McGraw-Hill Construction: Bedford, MA, USA, 2011. Available online: https://www.nist.gov/system/files/documents/el/economics/Prefabrication-Modularization-in-the-Construction-Industry-SMR-2011R.pdf (accessed on 25 February 2026).
- Sharafi, P.; Rashidi, M.; Samali, B.; Ronagh, H.; Mortazavi, M. Identification of Factors and Decision Analysis of the Level of Modularization in Building Construction. J. Archit. Eng. 2018, 24, 04018010. [Google Scholar] [CrossRef]
- Horínkova, D. Advantages and Disadvantages of Modular Construction, Including Environmental Impacts. IOP Conf. Ser. Mater. Sci. Eng. 2021, 1203, 032002. [Google Scholar] [CrossRef]
- Elnaas, E. The Decision to Use Off-Site Manufacturing (OSM) Systems for House Building Projects in the UK. Ph.D. Thesis, University of Brighton, Brighton, UK, 2014. [Google Scholar]
- Zanni, M.A.; Soetanto, R.; Ruikar, K.D. Exploring the Potential of BIM-Integrated Sustainability Assessment in AEC. In Proceedings of the Sustainable Building and Construction Conference (SB13), Coventry University, Coventry, UK, 3–5 July 2013; Available online: https://radar.gsa.ac.uk/5613/1/016ZanniSoetantoRuikar%20-%20final%20author%20version.pdf (accessed on 25 February 2026).
- Barcelona Housing Systems. Technology. Available online: https://www.barcelonahousingsystems.com/technology/ (accessed on 23 March 2025).
- Wallance, D. The Future of Modular Architecture; Routledge: London, UK, 2021. [Google Scholar]
- Koskela, L. Application of the New Production Philosophy to Construction; Stanford University: Stanford, CA, USA, 1992. [Google Scholar]
- Lawson, R.M.; Ogden, R.G.; Bergin, R. Application of Modular Construction in High-Rise Buildings. J. Archit. Eng. 2011, 18, 148–154. [Google Scholar] [CrossRef]
- Tam, V.W.Y.; Tam, C.M.; Zeng, S.X.; Ng, W.C.Y. Towards Adoption of Prefabricatation in Construction. Build. Environ. 2007, 42, 3642–3654. [Google Scholar] [CrossRef]
- Liu, Y.; Dong, J.; Shen, L. A Conceptual Development Framework for Prefabricated Construction Supply Chain Management: An Integrated Overview. Sustainability 2020, 12, 1878. [Google Scholar] [CrossRef]
- Gumusburun Ayalp, G.; Ay, I. Model Validation of Factors Limiting the Use of Prefabricated Construction Systems in Turkey. Eng. Constr. Archit. Manag. 2021, 28, 2610–2636. [Google Scholar] [CrossRef]
- Choi, J.O.; O’Connor, J.T. Modularization Critical Success Factors Accomplishment: Learning from Case Studies. In Proceedings of the Construction Research Congress, Atlanta, GA, USA, 19–21 May 2014; pp. 1636–1645. [Google Scholar] [CrossRef]
- Choi, J.O.; Chen, X.B.; Kim, T.W. Opportunities and Challenges of Modular Methods in Dense Urban Environment. Int. J. Constr. Manag. 2019, 19, 93–105. [Google Scholar] [CrossRef]
- Wuni, I.Y.; Shen, G.Q. Critical Success Factors for Modular Integrated Construction Projects: A Review. Build. Res. Inf. 2020, 48, 763–784. [Google Scholar] [CrossRef]
- Ramaji, I.J.; Memari, A.M. Product Architecture Model for Multistory Modular Buildings. J. Constr. Eng. Manag. 2016, 142, 04016047. [Google Scholar] [CrossRef]
- Linner, T.; Bock, T. Evolution of Large-Scale Industrialisation and Service Innovation in Japanese Prefabrication Industry. Constr. Innov. 2012, 12, 156–178. [Google Scholar] [CrossRef]
- Irwin, E.G.; Jayaprakash, C.; Munroe, D.K. Towards a Comprehensive Framework for Modeling Urban Spatial Dynamics. Landsc. Ecol. 2009, 24, 1223–1236. [Google Scholar] [CrossRef]
- Lu, K.; Jiang, X.; Yu, J.; Tam, V.W.; Skitmore, M. Integration of Life Cycle Assessment and Life Cycle Cost Using Building Information Modeling: A Critical Review. J. Clean. Prod. 2021, 285, 125438. [Google Scholar] [CrossRef]
- Islam, H.; Jollands, M.; Setunge, S. Life Cycle Assessment and Life Cycle Cost Implication of Residential Buildings—A Review. Renew. Sustain. Energy Rev. 2015, 42, 129–140. [Google Scholar] [CrossRef]
- Korpi, E.; Ala-Risku, T. Life Cycle Costing: A Review of Published Case Studies. Manag. Audit. J. 2008, 23, 240–261. [Google Scholar] [CrossRef]
- ISO 14040; Environmental Management—Life Cycle Assessment—Principles and Framework. International Organization for Standardization: Geneva, Switzerland, 2006.
- Kirk, S.J.; Dell’Isola, A. Life Cycle Costing for Design Professionals, 2nd ed.; McGraw-Hill: New York, NY, USA, 1995. [Google Scholar]
- Asiedu, Y.; Gu, P. Product Life Cycle Cost Analysis: State of the Art Review. Int. J. Prod. Res. 1998, 36, 883–908. [Google Scholar] [CrossRef]
- Barringer, H.P.; Weber, D.P. Life Cycle Cost Tutorial. In Proceedings of the Fifth International Conference on Process Plant Reliability, Houston, TX, USA, 1996; Gulf Publishing Company: Houston, TX, USA, 1996. [Google Scholar]
- Bogenstätter, U. Prediction and Optimization of Life-Cycle Costs in Early Design. Build. Res. Inf. 2000, 28, 376–386. [Google Scholar] [CrossRef]
- Kovacic, I.; Zoller, V. Building Life Cycle Optimization Tools for Early Design Phases. Energy 2015, 92, 409–419. [Google Scholar] [CrossRef]
- Jang, H.; Ahn, Y.; Roh, S. Comparison of the Embodied Carbon Emissions and Direct Construction Costs for Modular and Conventional Residential Buildings in South Korea. Buildings 2022, 12, 51. [Google Scholar] [CrossRef]
- Wang, Y.; Lam, S.K.; Wu, Z.; Gong, L.; Li, H.; Jiang, M. Does the Modular Construction Project Outperform the Traditional One? A Comparative Life Cycle Analysis Study in Hong Kong. Buildings 2025, 15, 2811. [Google Scholar] [CrossRef]
- Fabrycky, W.J.; Blanchard, B.S. Life-Cycle Cost and Economic Analysis; Prentice Hall: Englewood Cliffs, NJ, USA, 1991. [Google Scholar]
- MacArthur, E. Towards the Circular Economy. J. Ind. Ecol. 2013, 2, 23–44. [Google Scholar]
- Jiang, L.; Bhochhibhoya, S.; Slot, N.; de Graaf, R. Measuring Product-Level Circularity Performance: An Economic Value-Based Metric with the Indicator of Residual Value. Resour. Conserv. Recycl. 2022, 186, 106541. [Google Scholar] [CrossRef]
- Stahel, W.R. The Circular Economy: A User’s Guide; Routledge: London, UK, 2019. [Google Scholar] [CrossRef]
- Schulze, G. Growth Within: A Circular Economy Vision for a Competitive Europe; Ellen MacArthur Foundation and McKinsey Center for Business and Environment: Cowes, UK, 2016; pp. 1–22. [Google Scholar]
- Mayring, P. Qualitative Content Analysis: Theoretical Foundation, Basic Procedures and Software Solution; Social Science Open Access Repository: Klagenfurt, Austria, 2014; Available online: https://nbn-resolving.org/urn:nbn:de:0168-ssoar-395173 (accessed on 16 April 2026).
- Schreier, M. Qualitative Content Analysis in Practice; SAGE Publications: London, UK, 2012. [Google Scholar]
- Sandelowski, M. Real qualitative researchers do not count: The use of numbers in qualitative research. Res. Nurs. Health 2001, 24, 230–240. [Google Scholar] [CrossRef]
- Kuckartz, U. Qualitative content analysis: From Kracauer’s beginnings to today’s challenges. Forum Qual. Sozialforsch. 2019, 20, 20. [Google Scholar] [CrossRef]
- Becker, H.S. Problems of inference and proof in participant observation. In Research Design; Routledge: London, UK, 2017; pp. 312–324. [Google Scholar]
- Maxwell, J.A. Using numbers in qualitative research. Qual. Inq. 2010, 16, 475–482. [Google Scholar] [CrossRef]
- Lincoln, Y.S.; Guba, E.G. Naturalistic Inquiry; Sage: Beverly Hills, CA, USA, 1985. [Google Scholar]
- Lincoln, Y.S.; Guba, E.G. But Is It Rigorous? Trustworthiness and Authenticity in Naturalistic Evaluation. New Dir. Program Eval. 1986, 1986, 73–84. [Google Scholar] [CrossRef]
- Miles, M.B.; Huberman, A.M. Qualitative Data Analysis: An Expanded Sourcebook; Sage Publications: Thousand Oaks, CA, USA, 1994. [Google Scholar]
- Oorschot, L.; Asselbergs, T. New Housing Concepts: Modular, Circular, Biobased, Reproducible, and Affordable. Sustainability 2021, 13, 13772. [Google Scholar] [CrossRef]
- Bakhshi, S.; Chenaghlou, M.R.; Rahimian, F.P.; Edwards, D.J.; Dawood, N. Integrated BIM and DfMA Parametric and Algorithmic Design Based Collaboration for Supporting Client Engagement within Offsite Construction. Autom. Constr. 2022, 133, 104015. [Google Scholar] [CrossRef]
- Marchesi, M.; Matt, D.T. Design for Mass Customization: Rethinking Prefabricated Housing Using Axiomatic Design. J. Archit. Eng. 2017, 23, 05017004. [Google Scholar] [CrossRef]
- Formoso, C.T.; Tillmann, P.A.; Hentschke, C.D.S. Guidelines for the Implementation of Mass Customization in Affordable House-Building Projects. Sustainability 2022, 14, 4141. [Google Scholar] [CrossRef]










Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2026 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license.
Share and Cite
Bütün, B.; Başdoğan, S. From Construction Deadlock to Industrial Precision: A Dialectical Lifecycle Perspective of Modular Construction—The Case of Turkey. Buildings 2026, 16, 1946. https://doi.org/10.3390/buildings16101946
Bütün B, Başdoğan S. From Construction Deadlock to Industrial Precision: A Dialectical Lifecycle Perspective of Modular Construction—The Case of Turkey. Buildings. 2026; 16(10):1946. https://doi.org/10.3390/buildings16101946
Chicago/Turabian StyleBütün, Buğra, and Serhat Başdoğan. 2026. "From Construction Deadlock to Industrial Precision: A Dialectical Lifecycle Perspective of Modular Construction—The Case of Turkey" Buildings 16, no. 10: 1946. https://doi.org/10.3390/buildings16101946
APA StyleBütün, B., & Başdoğan, S. (2026). From Construction Deadlock to Industrial Precision: A Dialectical Lifecycle Perspective of Modular Construction—The Case of Turkey. Buildings, 16(10), 1946. https://doi.org/10.3390/buildings16101946
