Article

An Efficient Metaheuristic Algorithm for Job Shop Scheduling in a Dynamic Environment

1
School of E-Business and Logistics, Beijing Technology and Business University, Beijing 100048, China
2
Faculty of Mechanical Engineering, University of Maribor, 2000 Maribor, Slovenia
3
School of Management, Beijing Union University, Beijing 100101, China
*
Author to whom correspondence should be addressed.
Mathematics 2023, 11(10), 2336; https://doi.org/10.3390/math11102336
Submission received: 18 April 2023 / Revised: 12 May 2023 / Accepted: 15 May 2023 / Published: 17 May 2023

Abstract

:
This paper proposes an Improved Multi-phase Particle Swarm Optimization (IMPPSO) to solve a Dynamic Job Shop Scheduling Problem (DJSSP) known as an non-deterministic polynomial-time hard (NP-hard) problem. A cellular neighbor network, a velocity reinitialization strategy, a randomly select sub-dimension strategy, and a constraint handling function are introduced in the IMPPSO. The IMPPSO is used to solve the Kundakcı and Kulak problem set and is compared with the original Multi-phase Particle Swarm Optimization (MPPSO) and Heuristic Kalman Algorithm (HKA). The results show that the IMPPSO has better global exploration capability and convergence. The IMPPSO has improved fitness for most of the benchmark instances of the Kundakcı and Kulak problem set, with an average improvement rate of 5.16% compared to the Genetic Algorithm-Mixed (GAM) and of 0.74% compared to HKA. The performance of the IMPPSO for solving real-world problems is verified by a case study. The high level of operational efficiency is also evaluated and demonstrated by proposing a simulation model capable of using the decision-making algorithm in a real-world environment.

1. Introduction

In a world where dynamic events are becoming more frequent and their impact on the production system is becoming more complex, effective production planning and scheduling are the key to achieving a company’s global competitiveness. The proper timing of dynamic events in real time can be a major challenge on a day-to-day basis. The importance of proper scheduling has been recognized in research for many decades [1].
The research trend is increasingly directed toward the proper dynamic optimization of production systems [2]. Comparative studies by researchers [3] have shown why artificial intelligence methods [4] are among the most appropriate for solving dynamic events (machine breakdown, changes in processing times, arrival of new orders, etc.) [5]. The researchers’ results [6] state that using only one artificial intelligence method does not address the complexity of the multi-objective optimization of the Dynamic Job Shop Scheduling Problem (DJSSP) optimization problem [7]. Therefore, the researchers’ results show that the development of different hybrid methods is reasonable. In hybridization, researchers combine the advantages of each method and remove their limitations, improving their performance and robustness [8,9]. In reality, the complexity of the DJSSP problem is reflected in the flexibility of the production system where the correct mathematical formulation allows the algorithm to respond quickly and efficiently [10]. The fast adaptation of the proposed algorithms [11] enables effective solutions with the reliable automatic processing of dynamic events and changes in the system [12,13]. Despite the shortcomings of certain methods, such as priority rules, their proliferation in commercial use proves useful in today’s world [14]. In the age of Industry 4.0 and the ability to create digital twins that are justified in terms of time and costs [15], the use of an effective supporting simulation model is critical in any case. The potential of a data-driven simulation model [16] that captures large amounts of data in real time [17] provides a link between an effective decision algorithm and a real-world production or service process. The era of Industry 4.0 highlights the importance of optimized dynamic production systems [18] where commercial tools are no longer the only way to achieve satisfactory operation; the need for self-developed solutions is the key to achieving global competitiveness [19]. The optimization of key production parameters [20,21] goes far beyond the scope of simple simulation interfaces [22] and expresses the need for highly connectable and powerful supporting simulation environments [23].
The limitations of the presented work refer to the lack of an efficient methodology for solving dynamic events and, in most cases, to the lack of transfer of the decision-making methods to real-world applications [24]. The main motivation of the presented research work is to demonstrate the importance of developing an effective decision-making algorithm to solve the DJSSP optimization problem. The objective is to demonstrate the effectiveness of the proposed algorithm using test data sets (to allow efficient comparison of the decision-making results of the proposed algorithm with the existing solutions) and to test it using data sets from a real-world production system supported by a simulation modelling method. The main contribution of the research work is related to the evaluation of the effectiveness of the newly proposed algorithm and shows the importance of using simulation environments in which the decision-making logic and solution scheme of the proposed algorithm can be integrated. Through the compatibility and adaptability of the system, we aim to enable a comprehensive optimization system that facilitates the user’s daily production planning in dynamic events with the main objective of achieving the company’s competitiveness in terms of cost and time in the global market.

2. Problem Description

A DJSSP is a combinatorial optimization problem where we have n jobs specified in the introduction and n jobs arrive after the scheduled start of n jobs. All job orders ( n and n ) must be executed on m available machines. When considering DJSSP further, the constraints are as follows [25]:
  • All machines from a set of m are available at time 0;
  • A single operation can only be executed on one machine at a time;
  • A single machine i can only execute one operation at a time;
  • The operation executed on machine i can only be interrupted if a dynamic event occurs (machine breakdown, new job arrival or process time change);
  • The next operation cannot be executed until the previous operation is completed;
  • The processing times of the operation and the assigned machine i are known in advance. During a single operation, the processing time may change due to a dynamic event that changes the original processing time of the operation;
  • The original operation processing time is know;
  • The setup times do not depend on the sequence of operation execution and the machine on which the operation is executed but are included in the operation processing time;
  • The transfer time between machines is 0.
The problem formulation is performed using the following notations for decision variables, data sets, and parameters:
j Initial jobs ( j = 1 ,   ,   n ) ;
j New jobs ( j = 1 ,   ,   n ) ;
i Machines ( i = 1 ,   ,   m ) ;
A Set of routing constraints ( i , j ) ( h , j ) ;
A Set of new jobs’ routing constraints ( i , j ) ( h , j ) ;
p i j Process time of operation ( i ,   j ) ;
p i j Process time of new job operation ( i ,   j ) ;
c i j Completion time of job j on machine i ;
c i j Completion time of new job j on machine i ;
y i j Starting time of the operation ( i ,   j ) ;
y i j Starting time of a new operation ( i , j ) ;
r p The start time of the rescheduled job order;
t m i The start time that the machine i will be idled at the start of rescheduling a job order.
In the mathematical description of the single-objective optimization problem, the DJSSP focuses on minimizing the job’s makespan (completion time of all orders) C m a x , where c i , j is the completion time of job j on machine i , described by Equation (1).
C m a x = ( c i j ,   i = 1 ,   ,   n )
Two constraints ensure that C m a x is greater than or equal to the completion time of job j and new job j on machine i , represented by Equations (2) and (3).
C m a x c i j , where   i = 1 ,   ,   m   and   j = 1 ,   ,   n
C m a x c i j , where   i = 1 ,   ,   m   and   j = 1 ,   ,   n
Equations (4) and (5) present the makespan of the individual operation of orders n and the dynamic event of new orders’ arrival n .
c i j = y i j + p i j   where   i = 1 ,   ,   m   and   j = 1 ,   ,   n
c i j = y i j + p i j ,   where   i = 1 ,   ,   m   and   j = 1 ,   ,   n
The constraint of the optimization problem that the next operation cannot be performed until the previous one is completed is defined by Equations (6) and (7). In addition, some constraints shown in Equations (8)–(11) must be implemented according to the requirement that only one job can be processed on one machine at a time.
y h j y i j p i j   for   all   ( i , j ) ( h , j ) A
y h j y i j p i j   for   all   ( i , j ) ( h , j ) A
M z i j k + ( y i j y i k ) p i k ,   where   ( i = 1 ,   ,   m ,   1 j k n )
M z i j k + ( y i j y i k ) p i k ,   where   ( i = 1 ,   ,   m ,   1 j k n )
M ( 1 z i j k ) + ( y i k y i j ) p i j ,   where   ( i = 1 ,   ,   m ,   1 j k n )
M ( 1 z i j k ) + ( y i k y i j ) p i j ,   where   ( i = 1 ,   ,   m ,   1 j k n )
under the following conditions: z i j k = 1 , if J j precedes J k on machine M i ( z i j k = 0 , otherwise), z i j k = 1 , if J j precedes J k on machine M i ( z i j k = 0 , otherwise), t i j = 1 , if J j will be processed on machine M i after rescheduling ( t i j = 0 , otherwise), and t i j = 1 if J j will be processed in machine M i after rescheduling ( t i j = 0 , otherwise).
When the dynamic event appears, the new start time of the rescheduled job orders and the start time of machine i at the start of the rescheduled job orders is defined by Equations (12) and (13).
y i j ( t m i + r p ) t i j ,   where   ( i = 1 ,   ,   m   and   j = 1 ,   ,   n )
y i j ( t m i + r p ) t i j ,   w h e r e   ( i = 1 ,   ,   m   a n d   j = 1 ,   ,   n )
In this work, we are focused on optimizing the orders’ schedule in real-time, taking into account the types of dynamics events. The mathematical structure is integrated into the proposed IMPPSO metaheuristic algorithm. For a more practical method, the continuous rescheduling approach is added, where rescheduling is performed every time a dynamic event, i.e., a new order n , arrives.

3. Metaheuristic Method

To solve the job shop scheduling problem in dynamic environments, a metaheuristic algorithm is adopted and improved to improve its performance.

3.1. Multi-Phase Particle Swarm Optimization

Inspired by the related work of Heppner and Grenander [26] and the social behavior of a flock of birds and a school of fish, Particle Swarm Optimization (PSO) was proposed in 1995, which is very popular in many fields [27]. Because PSO uses a combination of local and global search strategies, Multi-phase Particle Swarm Optimization (MPPSO) is proposed to increase the diversity of the population and the exploration capabilities of the problem space [28]. In MPPSO, the particles are divided into two groups, one towards the global best position found so far and the other towards the opposite direction, and a hill-climbing mechanism is introduced that has been found helpful in other evolutionary algorithms. MPPSO can obtain the optimum fitness with fewer fitness evaluations and less computation time and can be used to train neural networks to reduce the error value. The flow chart of the MPPSO is shown in Figure 1 [28].

3.2. Improved Multi-Phase Particle Swarm Optimization

Based on the Improved Multi-objective Multi-phase Particle Swarm Optimization [29], an Improved Multi-phase Particle Swarm Optimization (IMPPSO) is proposed by introducing a cellular neighbor network. A cellular neighbor network is constructed and initialized in the IMPPSO after initializing the velocities and positions of particles randomly. This is followed by the calculation of the velocity change frequency corresponding to the current iteration, and the velocity is reinitialized if the reinitialization condition is met. Then, the current phase is determined. The velocity and position of each particle are updated after determining the current phase. The group with the best position in the cellular neighbor network and the updated sub-dimension size of the current particle are determined first in the process of updating each particle. Then, sub-dimensions from the dimensions of the current particle that have not been updated are selected randomly. After the coefficient has been determined, the velocity of the current particle’s sub-dimension is updated and its temporary position calculated. The constraints of the temporary location are handled immediately. Following the measurement of the temporary position, the current particle position is updated with the temporary position if it has better fitness. After all particles have been updated, the global best position and the cellular neighbor network are updated. The general pseudo-code of the IMPPSO is shown in Algorithm 1.
Algorithm 1 The general pseudo-code of the IMPPSO
Step 0: Setting the parameters. The number of rows r and columns c of the cellular neighbor network, the neighbor type of the cellular neighbor network n t , the rewiring probability of the cellular neighbor network p , the minimum/maximum depth of the cellular neighbor network d , the k nearest neighbors of the cellular neighbor network k , the size of the swarm N s (Note that N s = r c ), the dimension of the problem N d , the lower and upper boundary values for the problem l u (corresponding to the first row and the second row, respectively), the number of phases N p , the frequency change of the phase p c f , the number of groups within each phase N g , the maximum sub-dimension length s l _ m a x = m i n ( 10 , r o u n d ( N d / 2 ) ) , the initial velocity change variable value V C I , the final velocity change variable value V C F , and the maximum number of iterations m a x _ i t e .
Step 1 Initialize the variables. The phase change count p c c = 0 , the last velocity change V C l a s t = 0 , and the count of consecutive generations with no change in global best fitness C G C o u n t .
Step 2: Initialize the population. The velocity v , position x and their fitness f , the global best position G b x and its fitness G b .
Step 3: Initialize the cellular neighbor network using the algorithm [30].
Step 4: Iterative population.
for i t e = 1 : m a x _ i t e
        Step 4.1: Calculate the current velocity change variable.
        Step 4.2: Determine whether the reinitiate velocity condition is met and reinitiate the velocity when it is met.
        Step 4.3: Determine the current phase p h .
        Step 4.4: Update the particle.
        for i = 1 : N s
                Step 4.4.1: Determine the group for the current particle.
                Step 4.4.2: Obtain the k nearest neighbor’s best position for the current particle.
                Step 4.4.3: Initialize the dimension set of the problem.
                Step 4.4.4: Determine the size of the select index of the sub-dimension for updating.
                Step 4.4.5: Update the sub-dimension.
                while ~ i s e m p t y ( d i m _ s e t )
                        Step 4.4.5.1: Select the sub-dimension for updating.
                        Step 4.4.5.2: Cache the position of the current particle.
                        Step 4.4.5.3: Set the coefficient’s value in each group within each phase.
                        Step 4.4.5.4: Update the velocity of the current particle.
                        Step 4.4.5.5: Update the temporary position.
                        Step 4.4.5.6: Handle the constraints.
                        Step 4.4.5.7: Evaluate the fitness of the temporary position.
                        Step 4.4.5.8: Update the position of the current particle.
                        Step 4.4.5.9: Delete the updated sub-dimensions.
                end
        end
        Step 4.5: Determine whether the global best position has changed.
        Step 4.6: Update the K nearest neighbor’s best position.
end

3.2.1. Cellular Neighbor Network Introduction

In human society or a network, cellular neighbor structures can achieve good performance [31]. Therefore, the cellular neighbor network proposed in the literature [31] is introduced into the IMPPSO. In the cellular neighbor network, each cell is composed of each particle in the IMPPSO, as the current position of the particles is the historical best position they have searched. There are many cellular neighbor structures; the Von Neumann neighborhood [32] and the Moore neighborhood [33] are the most famous in two-dimensional space. Figure 2a,b shows their respective examples. In (a) and (b) of Figure 2, the red square represents the observed object, and the green square represents its neighbors. The examples of their cellular neighbor networks are shown in (c) and (d), respectively, of Figure 2.

3.2.2. Velocity Reinitialization

During the iteration of the IMPPSO, the velocity of the particles is reinitialized when the condition is met. The inertial weight can improve the global exploration and local exploitation of the algorithm [34]. A linear dynamic velocity change variable is introduced in the IMPPSO [29].

3.2.3. Sub-Dimension Selection

In the original MPPSO, the length of the update sub-dimension is selected randomly, and the sub-dimensions are updated from the first dimension to the last dimension based on the selected sub-dimension length [28]. In the IMPPSO, the maximum length of sub-dimensions is set to half of the number of dimensions, and the sub-dimension selection strategy is set to select the sub-dimension for improved global exploration and local exploitation of particles randomly [29]. In the randomly selected sub-dimension strategy, the sub-dimensions of the selected length are selected randomly from the sub-dimensions that have not been updated.

3.2.4. Constraint Handling

During the particle update process, the particle position may violate the constraints, which need to be handled. Therefore, the constraint handling function is introduced. If a dimension violates the boundary constraints, there is a 50% probability of being set to a random value and a 25% probability of being set to the global best value, otherwise it is set to the boundary value. When set to the boundary value, it is set to the upper bound if the upper bound constraint is violated, otherwise it is set to the lower bound. The boundary handling equation is shown in Equation (14).
x ( i , j ) = { l u ( 1 , j ) + ( l u ( 2 , j ) l u ( 1 , j ) ) r a n d , r d < 0.5 G b x ( 1 , j ) 0.5 r d < 0.75 l u ( 1 , j ) + i a z r d 0.75     x ( i , j ) < l u ( 1 , j ) l u ( 2 , j ) i a z r d 0.75     x ( i , j ) > l u ( 2 , j )
where x ( i ,   j ) represents dimension j of particle i that violates the boundary constraints, r d is a random value in the interval ( 0 , 1 ) , and i a z is a constant that tends infinitely to 0 if the boundary value is available, otherwise it equals 0.

3.3. Encoding Example

The relative position indexing [35]-based encoding solution is introduced to extend IMPPSO to solve combinatorial optimization problems. Table 1 and Figure 3 show a DJSSP example for the solution encoding and an example of the encoding solution, respectively. In the proposed encoding solution, the number of dimensions of the particle is set to the number of all operations, including the operations of newly arrived jobs, and each dimension of the particle represents the priority of the corresponding operation. The smaller the value of the dimension, the higher the priority of the corresponding operation. In Figure 3  S 0 , the value range of each dimension of the particle is the interval (0,1). Based on the relative position indexing, see Figure 3  S 1 , the position of the particle is transferred into the discrete domain. Based on Table 1, the processing sequence of the jobs can be obtained (See Figure 3  S 2 ). That is, for each dimension value of the sequence S 1 , the number of jobs corresponding to the row index is looked up in Table 1. Since the order of each operation of a job is immutable in the DJSSP, the k -th occurrence of a job number in S 2 represents the k -th operation of that job. Finally, the processing order of all operations can be obtained (See Figure 3  S 3 ). Each dimension value in the sequence S 3 represents the operation corresponding to the row index in Table 1. The operations’ processing sequence is as follows: ( 2 ,   2 ) , ( 1 ,   3 ) , ( 4 ,   1 ) , ( 3 ,   1 ) , ( 5 ,   3 ) , ( 3 ,   3 ) , ( 2 ,   3 ) , ( 5 ,   1 ) , ( 1 ,   1 ) , ( 1 ,   2 ) , ( 2 ,   1 ) , ( 5 ,   2 ) , ( 3 ,   2 ) , ( 4 ,   3 ) , ( 4 ,   2 ) , where ( . ,   . ) represent the job number and the machine number. For example, ( 3 ,   1 ) means job 3 is processed on machine 1 .

4. Numerical Experiment

A numerical experiment is designed to evaluate the performance of the IMPPSO. Benchmark instances are introduced, together with an encoding solution, to determine the parameters of the algorithm.

4.1. Benchmark Instances

For a known NP-hard combinatorial optimization, an efficient algorithm is required to minimize the makespan of the DJSSP [25]. Therefore, the proposed benchmark instances of the DJSSP, denoted as Kundakcı and Kulak, are introduced to measure the performance of the IMPPSO for solving the DJSSP. In the Kundakcı and Kulak problem set, some dynamic events are considered, such as machine breakdowns, new job arrivals, and changes in the processing time, etc. Based on the number of operations that do not consider the arrival of new jobs, the 15 benchmark instances in the Kundakcı and Kulak problem set are categorized as small, medium, and large problems. The details of the Kundakcı and Kulak problem set are shown in Table 2. “GAM Best” and “HKA Best” represent the optimal fitness of each benchmark instance obtained by the Genetic Algorithm-Mixed (GAM) [25] and the Heuristic Kalman Algorithm (HKA) [30], respectively. The “Improvement Rate” indicates the improvement rate of the optimal fitness of each benchmark instance obtained by the HKA over the GAM, that is, ( b a ) / a   100 % , where a and b represent “GAM Best” and “HKA Best”, respectively. The HKA obtains the optimal fitness achieved by the GAM and improves the optimal fitness of most benchmark instances, with a minimum improvement rate of 0.9%, a maximum improvement rate of 13.13%, and an average improvement rate of 4.47%. Therefore, the HKA makes a relatively large improvement to the optimal fitness of the benchmark instances obtained by the GAM.

4.2. Experimental Design

The IMPPSO proposed in the literature [29], the original MPPSO [28], and HKA [28] are selected for comparison. In the literature [29], when reinitializing the velocity, the velocity of the particle is reinitialized randomly to a random normally distributed value in a range that decreases exponentially with the number of iterations. This old version of the IMPPSO is denoted as OIMPPSO. In the OIMPPSO, a cellular neighbor network is introduced, denoted as IMPPSO. In order to have a greater velocity in the later iteration of the algorithm to escape the local optimum, the speed is initialized randomly when reinitializing the velocity; the second oldest version of the IMPPSO is denoted as OIMPPSO2. Similarly, a cellular neighbor network is introduced in OIMPPSO2, denoted as IMPPSO2. These algorithms solve the Kundakcı and Kulak problem set for comparison.
All selected algorithms are programmed in MATLAB. Each algorithm is applied to solve the Kundakcı and Kulak problem set and is run 30 times independently. The software environment for numerical experiments is the 2021b version of MATLAB. The hardware environment for numerical experiments is a laptop with a x64-processor Intel(R) Core(TM) i7-8550U CPU @ 1.80 GHz 1.99 GHz and 16 GB RAM.

4.3. Parameter Settings

The parameters of the algorithms are set based on the literature and experiments. The parameters r , c , and m a x _ i t e are set according to the experiments, while the remaining parameters are set according to the literature ([29,30]). The parameters of the algorithms are shown in Table 3.

4.4. Experimental Result

The average convergence of the algorithms for the optimal solution of the Kundakcı and Kulak problem set is shown in Figure 4. The x-axis and y-axis of all subplots in Figure 4 represent the generation and fitness (time units), respectively. It can be seen from the figure that most versions of the MPPSO can converge quickly to the optimal solution of the Kundakcı and Kulak problem set obtained by the HKA algorithm. All versions of the MPPSO perform best with small-size problems, well with medium-size problems, and not very well with large-size problems. Although some benchmark instances of the Kundakcı and Kulak problem set, such as KK10 × 8, kk20 × 5, kk15 × 10, do not reach their optimal solutions obtained by the HKA algorithm, the average convergence curves of all versions of the MPPSO maintain a downward trend, which means that increasing the number of iterations can improve their performance further. The various versions of the IMPPSO have better convergence than the original MPPSO. They can converge more quickly and continue their convergence. Compared with other versions of the improved MPPSO, the algorithms with the cellular neighbor network can reduce their convergence speed, which is considered beneficial to avoid the algorithm falling into the local optimum.

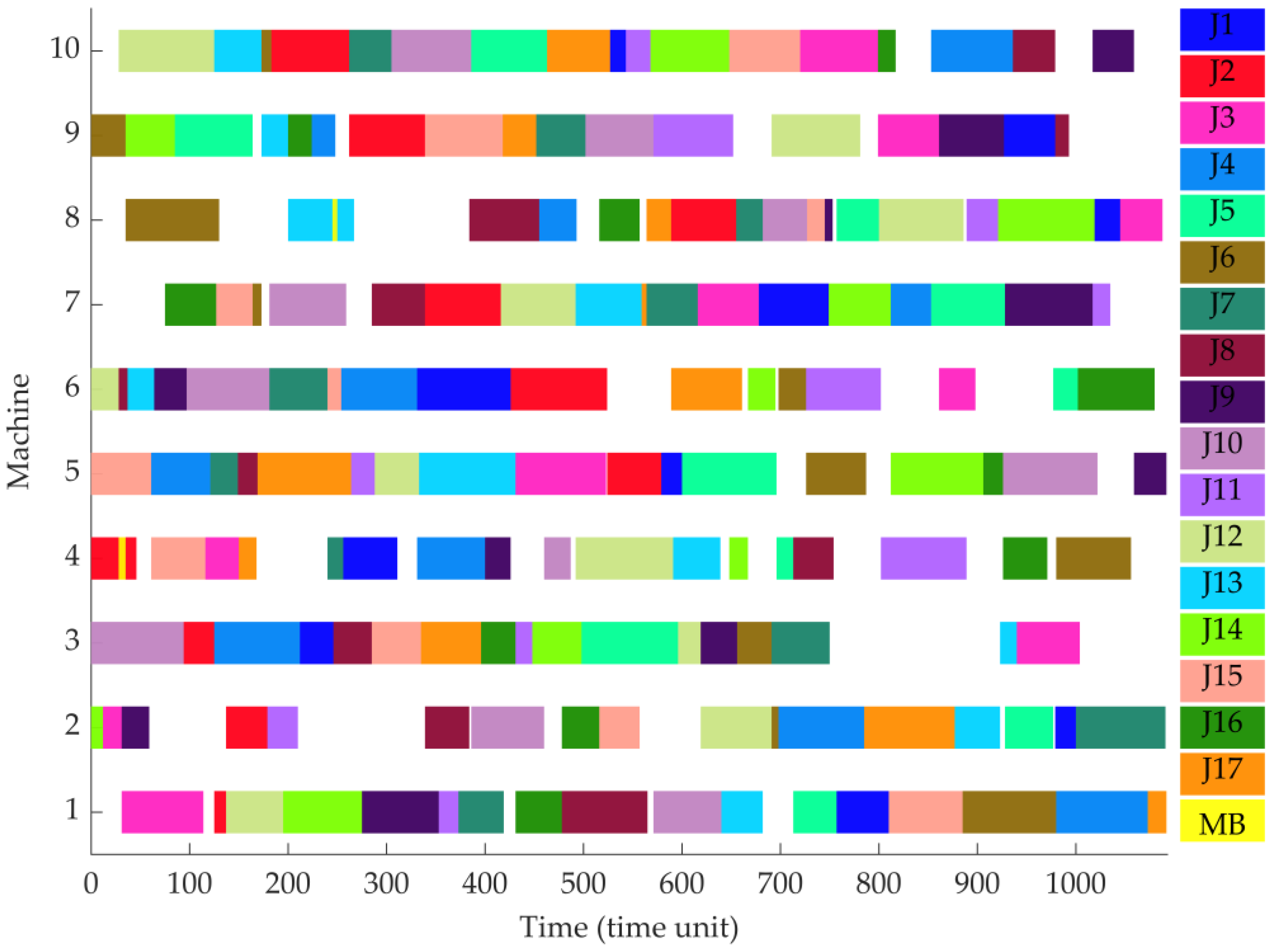

Figure 5 shows the statistical analysis of the algorithms for the fitness for the Kundakcı and Kulak problem set. The x-axis and y-axis of all subplots in Figure 5 represent the algorithm and fitness (time units), respectively, the red + represents outliners. It can be seen from the figure that all versions of the MPPSO show very good robustness in 7 of 12 of the benchmark instances of the problem set. In other benchmarks, all of the improved versions of the MPPSO show better performance than the original MPPSO. Table 4 shows the computational statistics of the algorithms for the fitness for some instances in the Kundakcı and Kulak problem set. The algorithms with a cellular neighbor network (IMPPSO2 VonNeumann, IMPPSO2 Moore, IMPPSO VonNeumann and IMPPSO Moore) perform better than the other versions of the improved algorithms. Furthermore, the algorithms with a cellular network perform better in large-size problems. Moreover, the Von Neumann neighborhood has better performance than the Moore neighborhood and can obtain solutions that are closer to the optimal solutions of the benchmark instances. The Von Neumann neighborhood can reduce the convergence speed of the algorithm, which is beneficial to avoid the algorithm falling into the local optimal solution and is more likely to find the global optimal solution. In large-size problems, the Von Neumann neighborhood is more likely to find better solutions for the benchmark instances. However, for a single algorithm, OIMPPSO performs the best. The IMPPSO2 shows better robustness than the IMPPSO. The IMPPSO2 can obtain the optimal solutions of the benchmark instances better than the IMPPSO.
The IMPPSO2 with the Von Neumann neighborhood obtains a better solution for the KK15 × 10 benchmark instance. The best solution of the KK15 × 10 with IMPPSO2 VonNeumann is shown in Table 5. Figure 6 shows the Gantt chart of the KK15 × 10 with IMPPSO2 VonNeumann. Job are represented by abbreviations from J1 to J17. The machine breakdown (MB, represented by the yellow background in the figure) of machine 4 and machine 8 occurs during the processing of job 2 and job 13, respectively.
Figure 7 shows the statistical analysis of the algorithms for the running time for the Kundakcı and Kulak problem set. The x-axis and y-axis of all subplots in Figure 7 represent the algorithm and running time (s), respectively, where red + represents outliners. All of the improved MPPSOs run longer than the original MPPSO, essentially doubling the time. However, the running time of all of the improved MPPSOs are almost the same. For small-size problems, the average time for 30 independent runs of all of the improved algorithms is within 30 s. The average time for 30 independent runs of almost all of the improved algorithms is within 2 min for medium-size problems. For large-size problems, the average time for 30 independent runs of all of the improved algorithms is within 4 min for most benchmark instances and within 6 min for only two of the benchmark instances. Therefore, as the problem size increases, the algorithm running time increases significantly. However, the running times of the algorithms are acceptable, which gives a suboptimal solution for the problem in a reasonable time.

5. Case Study

The operation of the proposed algorithm in a real-world environment is studied using a simulation model of a production system for the evaluation of dynamic events’ impacts. The simulation modelling is performed using Simio software. According to the previously proposed data transfer architecture between the decision algorithm and the simulation model (MatLab to Simio data transfer) [36], we conduct an experiment in which we observe the influence of dynamic events on the production system’s productivity and its efficiency. We focus on analyzing the correctness of the proposed decision-making algorithm’s (IMPPSO) operation using five representative parameters of the production system’s efficiency (machine utilization, machine time processing, machine breakdown time, machine operational costs, and machine breakdown costs). With the help of the simulation model and the given results, we are able to confirm the adequacy of the operation and the applicability of the proposed method.

5.1. Case Description

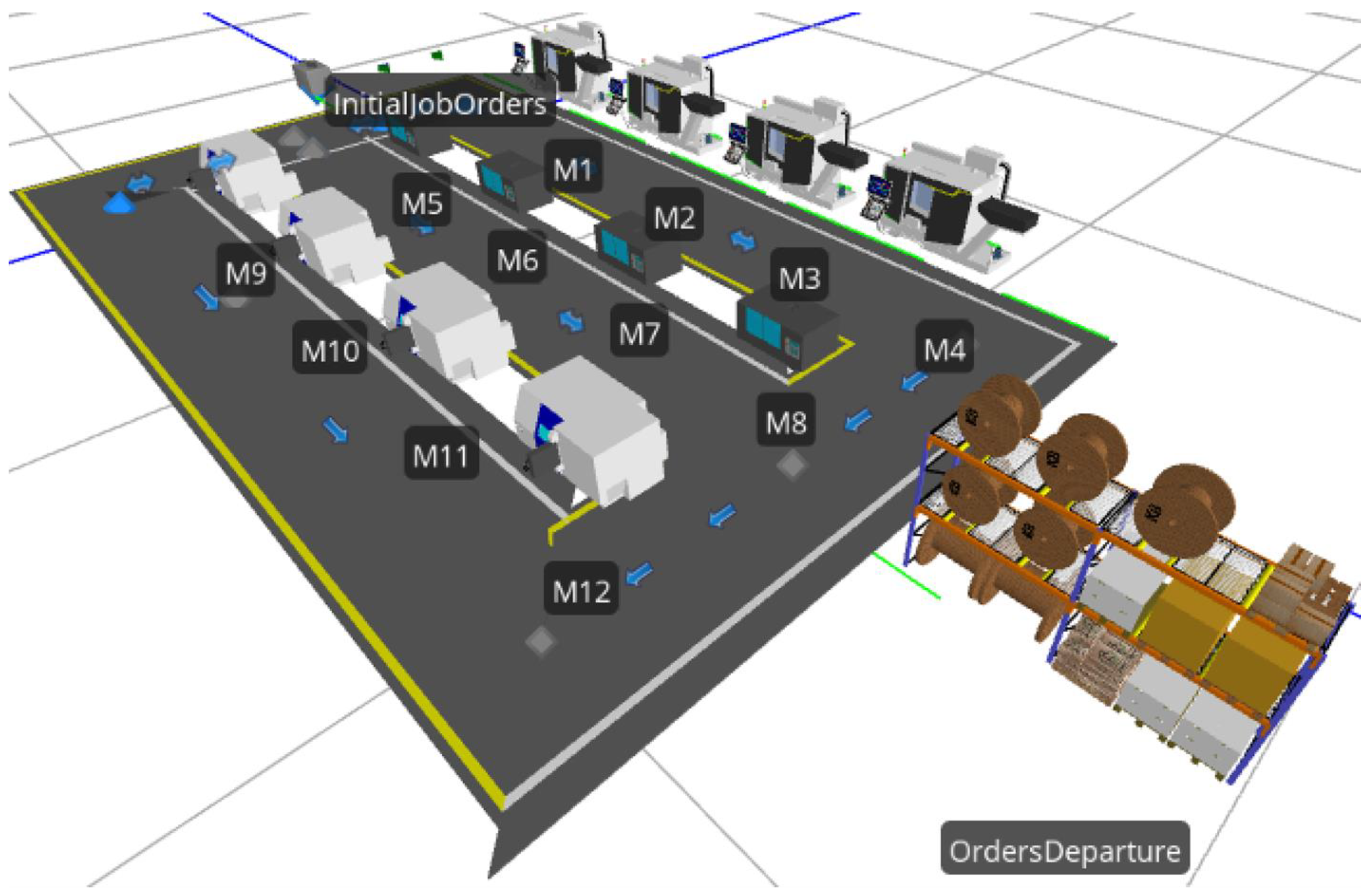

Figure 8 shows a simulation model of a manufacturing plant in the European Union where we have twelve workstations (machines from M1 to M12) and two additional stations: the arrival and dispatch of orders station. The simulation model and its entities summarize the characteristics of a real-world production system; the simulation model was built for the testing purposes of the proposed algorithm, and it can be used in everyday production scheduling tasks. The data of the real-world production system present the input data to the simulation model, where we have a known number of initial orders, a known order sequence, and the expected processing time of the individual operation on a specific needed machine. Dynamic events, which are not known in advance, and on the basis of which the decision IMPPSO algorithm must react in real-time, include a change in the estimated processing time of the operation, the arrival of a new order, and the breakdown of the machine. A fast response to dynamic events allows the production system to function in a timely and financially justified manner. The simulation time assumes the execution of job orders corresponding to the boundary conditions of the model: The production use a two-hour warm-up period, the paths between the machining centers are without lengths (the transport is carried out by a forklift), each workstation is operated by an operator, the entered series of orders is ready for machining at the start time, and the finished orders are dispatched immediately in the shipping process. The characteristics of the workstation operation are assumed according to the DJSSP literature, the details of which were presented in the second section.
The input data set and associated dynamic events are shown in Table 6. The displayed set of orders assumes three different types of dynamic events (a change in the process time of a specific job, a new job arrival, and an unknown machine breakdown) in as many as 35% of the orders. High-order dynamics and the tracking of the optimal utilization of the production system are only possible if the proposed IMPPSO algorithm is used and the decision making is done in real-time. The performance of the production system with the indicated dynamics of orders and events prevents the optimal operation and global competitiveness of the company or represents its high risk.

5.2. Algorithm Experiment

Because the number of jobs and the number of machines for the case are 15 and 12, respectively, and based on experiments, the maximum number of iterations for all versions of the MPPSO is set to 750, and the other parameters are the same as in Table 3. The average convergence of the algorithms for the optimal solution of the case is shown in Figure 9. It can also be seen that the various versions of the IMPSSO increase the convergence speed and improve the performance, and the various versions of the IMPSSO with the cellular neighbor structures can reduce its convergence speed appropriately and improve the performance further.
Figure 10 shows the statistical analysis of the algorithms for the fitness of the case, where red + represents outliners. It can also be seen that the various versions of the IMPPSO have better statistical performance, and the performance of the IMPPSO with the cellular neighbor structures is further improved.
The IMPPSO with the Moore neighborhood obtains a better solution for the case. Figure 11 shows the Gantt chart of jobs from J1 to J17, with the machine brake down (MB), of the case with IMPPSO Moore. The breakdown of machine 2 occurs during the processing of job 4, while a machine breakdown occurs when machine 9 happens to be idle.
Figure 12 shows the statistical analysis of the algorithms for the running time of the case, where red + represents outliner. It can also be seen that the running time of various versions of the IMPPSO is basically twice that of the original MPPSO, while the running times of various versions of the IMPPSO are basically the same.

5.3. Simulation Modelling Result

The simulation result in Table 7 shows three observed parameters (machine time processing, machine utilization, and machine operational cost) describing the operation of the production system and the effects of the dynamic events. The average machine processing time is a 166 time unit with a standard deviation of a 50.1 time unit. The value of the standard deviation proves the adequacy of the simulation model operation and the IMPPSO algorithm, as the machine processing times are correlated with the input data set, in which the production system processes real-world products, where the normative times of individual operations vary depending on the necessary execution of the technological process. Since the problem involves DJSSP and dynamic events, in which machine breakdown plays a crucial role, the parameter machine downtime is also plotted in Figure 13, where the results are consistent with the input data presented in Table 6. The high performance of the proposed IMPPSO algorithm is demonstrated by the simulation modelling results of the machine utilization rate, as this value is, on average, 84.3%, which, according to the literature [5] and the properties of the DJSSP problem, proves the high efficiency of the proposed algorithm. The standard deviation of the machine utilization parameter is 16.2%, where we note in a detailed analysis that the size of the deviation depends on the number of operations that need to be performed on a given machine, as well as the possible waiting time until the arrival of a new order appears. Based on the results, we note that a larger number of orders would improve the machine utilization rate parameter further.
Considering the global market dynamics, when the justification of production systems is conditioned primarily by the operation cost evaluation, Table 7 and Figure 14 show the operational and breakdown costs. The presented results show the importance of reducing the number of unscheduled machines’ breakdowns, but, when they occur, the IMPPSO algorithm must reschedule orders successfully and propose a new execution of individual operations on specific machines in real-time. In the present case, it is shown that the proposed algorithm can distribute individual operations optimally to the appropriate machines while reducing the machine breakdown time (and, hence, the cost), as shown in Figure 14. Downtime-related failures in the case study example account for only 0.2% of the total operation value in the production system.

6. Discussion

In all benchmark instances of the Kundakcı and Kulak problem set, all improved MPPSO versions converge faster than the original MPPSO while maintaining their performance. The randomly select sub-dimension strategy is the key factor. Moreover, this is the reason why their run times for all benchmark instances increase significantly. The introduction of the cellular neighbor network can reduce the convergence speed of the improved algorithms, which is most obvious in KK20 × 5. Decreasing the speed of convergence is considered to be beneficial to increase the global exploration capability of the algorithm. The global exploration capability of the IMPPSO2 is better than that of the IMPPSO, which is more likely to find the global optimal solution. When reinitializing the velocity of a particle, reinitializing the velocity randomly can enhance the diversity of the population.
The IMPPSO can obtain a solution that is closer to the real optimal solution of each benchmark instance of the Kundakcı and Kulak problem set. The improvement of algorithms for the optimal solution of the Kundakcı and Kulak problem set is shown in Table 8. Compared with the GAM, the IMPPSO has improved fitness for most benchmark instances of the Kundakcı and Kulak problem set, which has the most obvious effect in large-size problems. Compared with the GAM, the average improvement rate of the IMPPSO is 5.16%, the minimum improvement rate is 2.51%, and the maximum improvement rate is 14.69%. Similarly, the IMPPSO further improves the fitness for most of the benchmark instances of the Kundakcı and Kulak problem set obtained by the HKA, which also has the most obvious effect in large-size problems. Compared with the HKA, the average improvement rate of the IMPPSO is 0.74%, the minimum improvement rate is 0.88%, and the maximum improvement rate is 1.80%. Therefore, the IMPPSO has better global exploration capability than the GAM and HKA, which can find a suboptimal solution that is closer to the optimal solution of each benchmark instance of the Kundakcı and Kulak problem set. Compared with the GAM and HKA, the IMPPSO improves the fitness of the benchmark instances of the Kundakcı and Kulak problem set by 60% and 53.33%, respectively.
The various versions of MPSSO are used in the case study. The various versions of the IMPPSO, especially those with the cellular neighbor structures, achieve relatively good performance. However, their performance in obtaining the true optimal solution of the case still needs to be improved further, for the real-world problems are more complex. We can see from the case that a job does not need to be processed on all machines, resulting in further discretization of the solution space, and more local extrema may appear, which will increase the difficulty of solving the problem further. The advantages of the proposed decision-making algorithm can also be seen in the result of the simulation model, which proves that the presented algorithm enables the scheduling of orders and dynamic events’ decision-making, so that the production system operates in the optimal mode. The successful implementation of the proposed IMPPSO algorithm in the commercial software package Simio is possible, as stated in the literature [36,37], but, unlike in the literature, the presented simulation model allows the monitoring of the dynamic events of the DJSSP problem. The advantage of the case study evaluation is the real-world input data, which allow evaluation of both the decision-making algorithm and the simulation model. In the future, it is necessary to generate and obtain more extensive and complex data sets to improve and optimize the performance of both the decision-making algorithm and the simulation model further.

7. Conclusions

The IMPPSO is proposed by introducing the cellular neighbor network, the velocity reinitialization strategy, the randomly select sub-dimension strategy, and the constraint- handling function. The Von Neumann neighborhood and the Moore neighborhood are introduced in the cellular neighbor network. The velocity reinitialization strategy uses a linear dynamic velocity change variable. The strategy is adopted by selecting sub-dimensions randomly from the remaining dimensions that have not been updated. The constraint handling function, which assigns the violated dimension to a random value, a global optimal value or a boundary value with a certain probability, is introduced to handle constraints. The MPPSO and HKA are selected as a comparison of various versions of the IMPPSO. The various versions of the IMPPSO have faster convergence and better global exploration capability. While requiring twice as much running time as the original MPPSO, they can obtain suboptimal solutions for the problem in a reasonable time. The average improvement rate in the fitness of the IMPPSO for the benchmark instances of the Kundakcı and Kulak problem set is 5.16% compared to the GAM and 0.74% compared to the HKA.
The performance of the various versions of the IMPPSO applied to solve real-world problems is verified by a case study. The various versions of the IMPPSO perform better than the original MPPSO. Due to the complexity of real-world problems, the performance of the IMPPSO needs to be improved further. The importance of the presented work is reflected in the daily consideration of the DJSSP production system scheduling, where dynamic events pose increasing challenges to the industry. The integration of the presented decision-making algorithm and the simulation model, which can be applied in the daily scheduling practice, enables the rapid adaptation of the production system to dynamic events. The possibility of using the presented method enables rapid adaptation to other dynamic events, which are occurring increasingly in times of pandemics, tightened security problems, and unreliable supply chains.
The presented results indicate a diverse spectrum of further research that will focus on optimizing the proposed IMPPSO algorithm’s efficiency, where we will work to ensure a high level of efficiency and robustness of the algorithm’s operation for small, medium, and large datasets. Further research of the proposed simulation model with a comparative study of multiple algorithms would confirm the strong potential of the proposed algorithm, as proven in the decision-making algorithm comparison. As stated in the literature [16,19], it is not possible to trace the interconnectivity between an effective decision-making and simulation model solving DJSSP, which can be stated as one of the advantages of the presented work.

Author Contributions

Conceptualization, R.O. and H.Z.; methodology, H.Z. and X.L.; software, H.Z., R.O. and X.L.; validation, R.O., B.B. and H.Z.; data curation, H.Z. and R.O.; writing—original draft preparation, R.O. and H.Z.; writing—review and editing, R.O., H.Z. and B.B.; visualization, H.Z. and R.O.; supervision, B.B.; funding acquisition, H.Z. All authors have read and agreed to the published version of the manuscript.

Funding

This work was supported by the Beijing Social Science Foundation [Grant number 21GLC044].

Data Availability Statement

Not applicable.

Acknowledgments

We would like to express our deepest appreciation to the Beijing Technology and Business University and the University of Maribor for the possibility of carrying out our research work. We would also like to thank all of the anonymous reviewers and the Editor for their comments. With the corrections, suggestions, and comments made, the manuscript has gained in scientific value.

Conflicts of Interest

The authors declare no conflict of interest. The funders had no role in the design of the study; in the collection, analyses, or interpretation of data; in the writing of the manuscript; or in the decision to publish the results.

References

  1. Ramasesh, R. Dynamic Job Shop Scheduling: A Survey of Simulation Research. Omega 1990, 18, 43–57. [Google Scholar] [CrossRef]
  2. Hinderer, K.; Rieder, U.; Stieglitz, M. Introduction and Organization of the Book. In Dynamic Optimization; Universitext; Springer International Publishing: Cham, Switzerland, 2016; pp. 1–11. ISBN 978-3-319-48813-4. [Google Scholar]
  3. Park, J.; Mei, Y.; Nguyen, S.; Chen, G.; Zhang, M. An Investigation of Ensemble Combination Schemes for Genetic Programming Based Hyper-Heuristic Approaches to Dynamic Job Shop Scheduling. Appl. Soft Comput. 2018, 63, 72–86. [Google Scholar] [CrossRef]
  4. Wang, Z.; Zhang, J.; Yang, S. An Improved Particle Swarm Optimization Algorithm for Dynamic Job Shop Scheduling Problems with Random Job Arrivals. Swarm Evol. Comput. 2019, 51, 100594. [Google Scholar] [CrossRef]
  5. Chryssolouris, G.; Subramaniam, V. Dynamic Scheduling of Manufacturing Job Shops Using Genetic Algorithms. J. Intell. Manuf. 2001, 12, 281–293. [Google Scholar] [CrossRef]
  6. Zhang, L.; Gao, L.; Li, X. A Hybrid Genetic Algorithm and Tabu Search for a Multi-Objective Dynamic Job Shop Scheduling Problem. Int. J. Prod. Res. 2013, 51, 3516–3531. [Google Scholar] [CrossRef]
  7. Nguyen, S.; Zhang, M.; Johnston, M.; Tan, K.C. Automatic Design of Scheduling Policies for Dynamic Multi-Objective Job Shop Scheduling via Cooperative Coevolution Genetic Programming. IEEE Trans. Evol. Comput. 2014, 18, 193–208. [Google Scholar] [CrossRef]
  8. Aydin, M.E.; Öztemel, E. Dynamic Job-Shop Scheduling Using Reinforcement Learning Agents. Rob. Auton. Syst. 2000, 33, 169–178. [Google Scholar] [CrossRef]
  9. Shahrabi, J.; Adibi, M.A.; Mahootchi, M. A Reinforcement Learning Approach to Parameter Estimation in Dynamic Job Shop Scheduling. Comput. Ind. Eng. 2017, 110, 75–82. [Google Scholar] [CrossRef]
  10. Shen, X.-N.; Yao, X. Mathematical Modeling and Multi-Objective Evolutionary Algorithms Applied to Dynamic Flexible Job Shop Scheduling Problems. Inf. Sci. 2015, 298, 198–224. [Google Scholar] [CrossRef]
  11. Baykasoğlu, A.; Madenoğlu, F.S.; Hamzadayı, A. Greedy Randomized Adaptive Search for Dynamic Flexible Job-Shop Scheduling. J. Manuf. Syst. 2020, 56, 425–451. [Google Scholar] [CrossRef]
  12. Zhang, F.; Mei, Y.; Nguyen, S.; Zhang, M. Evolving Scheduling Heuristics via Genetic Programming With Feature Selection in Dynamic Flexible Job-Shop Scheduling. IEEE Trans. Cybern. 2021, 51, 1797–1811. [Google Scholar] [CrossRef]
  13. Zhou, Y.; Yang, J.-J.; Huang, Z. Automatic Design of Scheduling Policies for Dynamic Flexible Job Shop Scheduling via Surrogate-Assisted Cooperative Co-Evolution Genetic Programming. Int. J. Prod. Res. 2020, 58, 2561–2580. [Google Scholar] [CrossRef]
  14. Nie, L.; Gao, L.; Li, P.; Li, X. A GEP-Based Reactive Scheduling Policies Constructing Approach for Dynamic Flexible Job Shop Scheduling Problem with Job Release Dates. J. Intell. Manuf. 2013, 24, 763–774. [Google Scholar] [CrossRef]
  15. Zhang, M.; Tao, F.; Nee, A.Y.C. Digital Twin Enhanced Dynamic Job-Shop Scheduling. J. Manuf. Syst. 2021, 58, 146–156. [Google Scholar] [CrossRef]
  16. Kuck, M.; Ehm, J.; Hildebrandt, T.; Freitag, M.; Frazzon, E.M. Potential of Data-Driven Simulation-Based Optimization for Adaptive Scheduling and Control of Dynamic Manufacturing Systems. In Proceedings of the 2016 Winter Simulation Conference (WSC), Washington, DC, USA, 11–14 December 2016; pp. 2820–2831. [Google Scholar]
  17. Zhou, L.; Zhang, L.; Ren, L.; Wang, J. Real-Time Scheduling of Cloud Manufacturing Services Based on Dynamic Data-Driven Simulation. IEEE Trans. Ind. Inform. 2019, 15, 5042–5051. [Google Scholar] [CrossRef]
  18. Yang, W.; Takakuwa, S. Simulation-Based Dynamic Shop Floor Scheduling for a Flexible Manufacturing System in the Industry 4.0 Environment. In Proceedings of the 2017 Winter Simulation Conference (WSC), Las Vegas, NV, USA, 3–6 December 2017; pp. 3908–3916. [Google Scholar]
  19. Ojstersek, R.; Buchmeister, B. Simulation Based Resource Capacity Planning with Constraints. Int. J. Sim. Model. 2021, 20, 672–683. [Google Scholar] [CrossRef]
  20. Vinod, V.; Sridharan, R. Simulation-Based Metamodels for Scheduling a Dynamic Job Shop with Sequence-Dependent Setup Times. Int. J. Prod. Res. 2009, 47, 1425–1447. [Google Scholar] [CrossRef]
  21. Vinod, V.; Sridharan, R. Simulation Modeling and Analysis of Due-Date Assignment Methods and Scheduling Decision Rules in a Dynamic Job Shop Production System. Int. J. Prod. Econ. 2011, 129, 127–146. [Google Scholar] [CrossRef]
  22. Xiong, H.; Fan, H.; Jiang, G.; Li, G. A Simulation-Based Study of Dispatching Rules in a Dynamic Job Shop Scheduling Problem with Batch Release and Extended Technical Precedence Constraints. Eur. J. Oper. Res. 2017, 257, 13–24. [Google Scholar] [CrossRef]
  23. Zou, J.; Chang, Q.; Arinez, J.; Xiao, G.; Lei, Y. Dynamic Production System Diagnosis and Prognosis Using Model-Based Data-Driven Method. Expert Syst. Appl. 2017, 80, 200–209. [Google Scholar] [CrossRef]
  24. Jemmali, M.; Hidri, L.; Alourani, A. Two-stage Hybrid Flowshop Scheduling Problem With Independent Setup Times. Int. J. Sim. Model. 2022, 21, 5–16. [Google Scholar] [CrossRef]
  25. Kundakcı, N.; Kulak, O. Hybrid Genetic Algorithms for Minimizing Makespan in Dynamic Job Shop Scheduling Problem. Comput. Ind. Eng. 2016, 96, 31–51. [Google Scholar] [CrossRef]
  26. Heppner, F.; Grenander, U. A Stochastic Nonlinear Model for Coordinated Bird Flocks. In The Ubiquity of Chaos; Krasner, S., Ed.; AAAS Publications: Washington, DC, USA, 1990; pp. 233–238. [Google Scholar]
  27. Kennedy, J.; Eberhart, R. Particle Swarm Optimization. In Proceedings of the Proceedings of ICNN’95—International Conference on Neural Networks, Perth, Australia, 27 November–1 December 1995; Volume 4, pp. 1942–1948. [Google Scholar]
  28. Al-Kazemi, B.S.N. Multiphase Particle Swarm Optimization; Syracuse University: New York, NY, USA, 2002. [Google Scholar]
  29. Zhang, H. Research on Multi-Objective Swarm Intelligence Algorithms for Door-to-Door Railway Freight Transportation Routing Design; Beijing Jiaotong University: Beijing, China, 2019. [Google Scholar]
  30. Zhang, H.; Buchmeister, B.; Li, X.; Ojstersek, R. Advanced Metaheuristic Method for Decision-Making in a Dynamic Job Shop Scheduling Environment. Mathematics 2021, 9, 909. [Google Scholar] [CrossRef]
  31. Li, X.-Y.; Yang, L.; Li, J. Dynamic Route and Departure Time Choice Model Based on Self-Adaptive Reference Point and Reinforcement Learning. Phys. A Stat. Mech. Its Appl. 2018, 502, 77–92. [Google Scholar] [CrossRef]
  32. Wikipedia Von Neumann Neighborhood. Available online: https://en.wikipedia.org/wiki/Von_Neumann_neighborhood (accessed on 26 August 2020).
  33. Wikipedia Moore Neighborhood. Available online: https://en.wikipedia.org/wiki/Moore_neighborhood (accessed on 23 June 2022).
  34. Sha, D.Y.; Lin, H.-H. A Multi-Objective PSO for Job-Shop Scheduling Problems. Expert Syst. Appl. 2010, 37, 1065–1070. [Google Scholar] [CrossRef]
  35. Marinakis, Y.; Marinaki, M. A Hybrid Particle Swarm Optimization Algorithm for the Open Vehicle Routing Problem. In Swarm Intelligence, Proceedings of the 8th International Conference, ANTS 2012, Brussels, Belgium, 12–14 September 2012; Dorigo, M., Birattari, M., Blum, C., Christensen, A.L., Engelbrecht, A.P., Groß, R., Stützle, T., Eds.; Springer: Berlin/Heidelberg, Germany, 2012; pp. 180–187. ISBN 978-3-642-32650-9. [Google Scholar]
  36. Ojstersek, R.; Lalic, D.; Buchmeister, B. A New Method for Mathematical and Simulation Modelling Interactivity: A Case Study in Flexible Job Shop Scheduling. Adv. Prod. Eng. Manag. 2019, 14, 435–448. [Google Scholar] [CrossRef]
  37. Guzman, E.; Andres, B.; Poler, R. A Decision-Making Tool for Algorithm Selection Based on a Fuzzy TOPSIS Approach to Solve Replenishment, Production and Distribution Planning Problem. Mathematics 2022, 10, 1544. [Google Scholar] [CrossRef]
Figure 1. The flowchart of the MPPSO.
Figure 1. The flowchart of the MPPSO.
Mathematics 11 02336 g001
Figure 2. The examples of cellular neighborhoods and cellular neighbor networks.
Figure 2. The examples of cellular neighborhoods and cellular neighbor networks.
Mathematics 11 02336 g002
Figure 3. An example of the encoding solution.
Figure 3. An example of the encoding solution.
Mathematics 11 02336 g003
Figure 4. The average convergence of the algorithms for the optimal solution of the Kundakcı and Kulak problem set.
Figure 4. The average convergence of the algorithms for the optimal solution of the Kundakcı and Kulak problem set.
Mathematics 11 02336 g004
Figure 5. The statistical analysis of the algorithms for the fitness for the Kundakcı and Kulak problem set.
Figure 5. The statistical analysis of the algorithms for the fitness for the Kundakcı and Kulak problem set.
Mathematics 11 02336 g005
Figure 6. The Gantt chart of the KK15 × 10 with IMPPSO2 VonNeumann.
Figure 6. The Gantt chart of the KK15 × 10 with IMPPSO2 VonNeumann.
Mathematics 11 02336 g006
Figure 7. The statistical analysis of the algorithms for the running time of the Kundakcı and Kulak problem set.
Figure 7. The statistical analysis of the algorithms for the running time of the Kundakcı and Kulak problem set.
Mathematics 11 02336 g007
Figure 8. The simulation model in Simio Software.
Figure 8. The simulation model in Simio Software.
Mathematics 11 02336 g008
Figure 9. The average convergence of the algorithms for the optimal solution of the case.
Figure 9. The average convergence of the algorithms for the optimal solution of the case.
Mathematics 11 02336 g009
Figure 10. The statistical analysis of the algorithms for the fitness of the case.
Figure 10. The statistical analysis of the algorithms for the fitness of the case.
Mathematics 11 02336 g010
Figure 11. The Gantt chart of the case with IMPPSO Moore.
Figure 11. The Gantt chart of the case with IMPPSO Moore.
Mathematics 11 02336 g011
Figure 12. The statistical analysis of the algorithms for the running time of the case.
Figure 12. The statistical analysis of the algorithms for the running time of the case.
Mathematics 11 02336 g012
Figure 13. The graphical representation of the results of the simulation model.
Figure 13. The graphical representation of the results of the simulation model.
Mathematics 11 02336 g013
Figure 14. The operational and breakdown costs.
Figure 14. The operational and breakdown costs.
Mathematics 11 02336 g014
Table 1. A DJSSP example for the solution encoding.
Table 1. A DJSSP example for the solution encoding.
NoJobsOccurrence TimeMachine NoProcessing TimesOriginal Processing TimeRemarks
11032
21018
310246Change in the process time
42026
52035
62014
73017
83038
930245Change in the process time
104014
114035
124025
135537 New job arrival
145513 New job arrival
155526 New job arrival
1601223 Machine breakdown
Table 2. The details of the Kundakcı and Kulak problem set.
Table 2. The details of the Kundakcı and Kulak problem set.
Size TypeNo.NameSize n × mNumber of OperationsNumber of Dynamic OperationsTotalGAM BestHKA BestImprovement Rate (%)
small1KK5 × 55 × 525103551510
2KK6 × 56 × 53015455575520.90
3KK8 × 58 × 5405456996990
4KK10 × 510 × 5505556246240
medium5KK10 × 610 × 6606666826820
6KK15 × 515 × 575580100110010
7KK10 × 810 × 88088810279448.08
8KK10 × 910 × 99018108104910054.19
large9KK20 × 520 × 510051051361120211.68
10KK10 × 1010 × 1010010110138912877.34
11KK22 × 522 × 511015125145814580
12KK12 × 1012 × 101201013010029128.98
13KK13 × 1013 × 101301014010169476.79
14KK20 × 720 × 714014154132612466.03
15KK15 × 1015 × 10150201701280111213.13
Table 3. The parameters of the algorithms.
Table 3. The parameters of the algorithms.
NoNameValueNoNameValueNoNameValue
1 r 106 N s 10011 V C I 15
2 c 107 N p 212 V C F 5
3 p 0.58 p c f 513 α 10
4 d 59 N g 214 m a x _ i t e small300
5 k 610 V C 10medium450
large600
Table 4. The computational statistics of the algorithms for the fitness for some instances in the Kundakcı and Kulak problem set.
Table 4. The computational statistics of the algorithms for the fitness for some instances in the Kundakcı and Kulak problem set.
Name KK6 × 5KK10 × 8KK10 × 9KK20 × 5KK10 × 10KK12 × 10KK13 × 10KK15 × 10
IMPPSO2
VonNeumann
Min543935990120212689049331092
Max5449741005123412929169481132
Mean543.03955.10993.431210.601278.73909.30941.471118.73
Std.0.1810.175.587.336.314.274.048.71
SR10016.671006.6793.3376.6793.3323.33
IMPPSO2
Moore
Min543935990119112699049301099
Max5449791005123212949169471134
Mean543.07958993.301212.931279.57910.43939.431117.87
Std.0.2510.564.048.416.683.464.448.38
SR1006.67100109073.3310033.33
IMPPSO
VonNeumann
Min543949990119212699049321102
Max5449731008122512939169481130
Mean543.13961.37992.531210.901279.80911.77942.231117.53
Std.0.356.834.466.475.383.415.437.10
SR100093.333.3396.6756.6773.3323.33
IMPPSO
Moore
Min543936990120012689049301105
Max5439751010122712879169481132
Mean543958.47992.331214.101278.53911.70941.231118.87
Std.08.104.906.435.644.265.127.40
SR1003.3396.673.3310043.3383.3316.67
OIMPPSO2Min543940990120012699049301098
Max5449731005122012929169491135
Mean543.07957.73992.371208.971278.60911.90942.801121.43
Std.0.257.263.525.597.323.355.178.99
SR1003.3310016.6793.335076.6710
OIMPPSOMin543933990119212699049361101
Max5439691007121312869169481132
Mean543955.37991.771204.631278.23910.80941.971118.50
Std.08.944.275.865.203.464.347.47
SR1001096.6736.6710066.679016.67
MPPSOMin543948990121312709099391115
Max5499871014124812949249551153
Mean543.23966.67999.801233.331283.33916.90948.201136.20
Std.1.109.227.338.806.503.443.578.72
SR100070076.6710300
Table 5. The best solution of the KK15 × 10 with IMPPSO2 VonNeumann.
Table 5. The best solution of the KK15 × 10 with IMPPSO2 VonNeumann.
M1ON 12213113133831036515477981284671505940170
ST 2311251371952753533734314785716407137578108859801073
FT 311413719527535337341947856564068275781088598010731092
M2ON1312181141017595155147118563716912949970
ST012311371793393864785166196916987858779289791000
FT12315917921038446051655769169878587792397710001091
M3ON9112321731451631531041344311785556913029
ST094125212246285335396431448498596619656691923940
FT941252122462853353964314484985966196566917509401004
M4ON1114223161632358496116127136457810815960
ST061116150240256331400460492591648696713802926980
FT461161501682563114004264875916396677137548899711056
M5ON14131617216210211412524195445813915810090
ST0611211491692642883334315245796007268129069261059
FT6112114916926428833343152357960069678790692610221092
M6ON1117112182926214434318168137571072850160
ST0283764971812402543314265896676987268619771002
FT2837649718124025433142652466169572680289810021080
M7ON1511435393741711512616667256138384888110
ST751271641812853394164925595646166787498128539281017
FT12716417325933941649255956461667874981285392810171035
M8ON52124763615616720689914986471201091401030
ST3520038445551656458965568272774575780088992110191045
FT130267455493557589655682727745753800886921101910451088
M9ON5113241123152331614616466971061192787880
ST03585173200224262339418452502571691799861927979
FT3585164200224248339418452502571652781861927979993
M10ON1121225415649442165410513514826157397989
ST281251731832623053864635275435686487207998539361017
FT1251731832623053864635275435686487207998179369791059
1 Operation Number; 2 Start Time; 3 Finish Time.
Table 6. Real-world simulation model input parameters.
Table 6. Real-world simulation model input parameters.
JobsOccurrence TimeMachine SequenceProcessing Time [Time Unit]Dynamic Event
J10M1, M4, M8, M9, M10, M12139
J20M1, M5, M7, M9, M11, M12121
J30M9, M10, M1252Change in the process time to 50
J40M2, M4, M8, M9, M11, M12139
J50M2, M6, M8, M9, M10, M12137
J60M1, M5, M7, M9, M11, M12121
J70M2, M4, M8, M9, M11, M12139
J80M2, M6, M7, M9, M10, M12146Change in the process time to 149
J90M1, M3, M7, M9, M11, M12123
J100M1, M5, M7, M9, M11, M12121
J110M1, M5, M7, M9, M11, M12126
J120M2, M3, M8, M9, M11, M12139
J130M1, M5, M7, M9, M11, M12124
J140M1, M6, M7, M9, M10, M12139
J150M9, M10, M1250
J16125M1, M4, M8, M9, M10, M12139New job arrival
J17155M1, M5, M7, M9, M11, M12125New job arrival
050M27Machine breakdown
0175M95Machine breakdown
Table 7. The results of the simulation model.
Table 7. The results of the simulation model.
MachineMachine Time Processing [Time Unit]Machine Utilization [%]Operational Cost [EUR]
M12061001476
M2103100601
M38345.6540
M417291.91519
M522898.31976
M68692.1846
M719287.71152
M813882.61035
M917171.51083
M1017364.81298
M1122099.51907
M1222077.71320
Table 8. The improvement of the IMPPSO for the optimal solution of the Kundakcı and Kulak problem set.
Table 8. The improvement of the IMPPSO for the optimal solution of the Kundakcı and Kulak problem set.
Size TypeNoNameGAM BestHKA BestIMPPSO BestImprovement Rate for GAM (%)Improvement Rate for HKA (%)
small1KK5 × 551515100
2KK6 × 55575525432.511.63
3KK8 × 569969969900
4KK10 × 562462462400
medium5KK10 × 668268268200
6KK15 × 510011001100100
7KK10 × 810279449339.151.17
8KK10 × 9104910059905.621.49
large9KK20 × 513611202119112.490.92
10KK10 × 101389128712688.711.48
11KK22 × 514581458145800
12KK12 × 1010029129049.780.88
13KK13 × 1010169479308.461.80
14KK20 × 71326124612466.030
15KK15 × 1012801112109214.691.80
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Zhang, H.; Buchmeister, B.; Li, X.; Ojstersek, R. An Efficient Metaheuristic Algorithm for Job Shop Scheduling in a Dynamic Environment. Mathematics 2023, 11, 2336. https://doi.org/10.3390/math11102336

AMA Style

Zhang H, Buchmeister B, Li X, Ojstersek R. An Efficient Metaheuristic Algorithm for Job Shop Scheduling in a Dynamic Environment. Mathematics. 2023; 11(10):2336. https://doi.org/10.3390/math11102336

Chicago/Turabian Style

Zhang, Hankun, Borut Buchmeister, Xueyan Li, and Robert Ojstersek. 2023. "An Efficient Metaheuristic Algorithm for Job Shop Scheduling in a Dynamic Environment" Mathematics 11, no. 10: 2336. https://doi.org/10.3390/math11102336

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
