Next Article in Journal
Experimental Study on the Flexural Behavior of over Reinforced Concrete Beams Bolted with Compression Steel Plate: Part I
Next Article in Special Issue
Extending BIM Interoperability for Real-Time Concrete Formwork Process Monitoring
Previous Article in Journal
Evaluation of Selected Sub-Elements of Spatial Data Quality on 3D Flood Event Modeling: Case Study of Prešov City, Slovakia
Previous Article in Special Issue
Developing a Building Fire Information Management System Based on 3D Object Visualization


Review

The Last Planner® System and Building Information Modeling in Construction Execution: From an Integrative Review to a Conceptual Model for Integration

1
Free University of Bozen-Bolzano, Faculty of Science and Technology, Piazza Università 5, 39100 Bolzano, Italy
2
Fraunhofer Italia Research, Via A.-Volta 13A, 39100 Bolzano, Italy
*
Authors to whom correspondence should be addressed.
Appl. Sci. 2020, 10(3), 821; https://doi.org/10.3390/app10030821
Received: 31 December 2019 / Revised: 14 January 2020 / Accepted: 21 January 2020 / Published: 23 January 2020
(This article belongs to the Special Issue BIM in the Construction Industry)

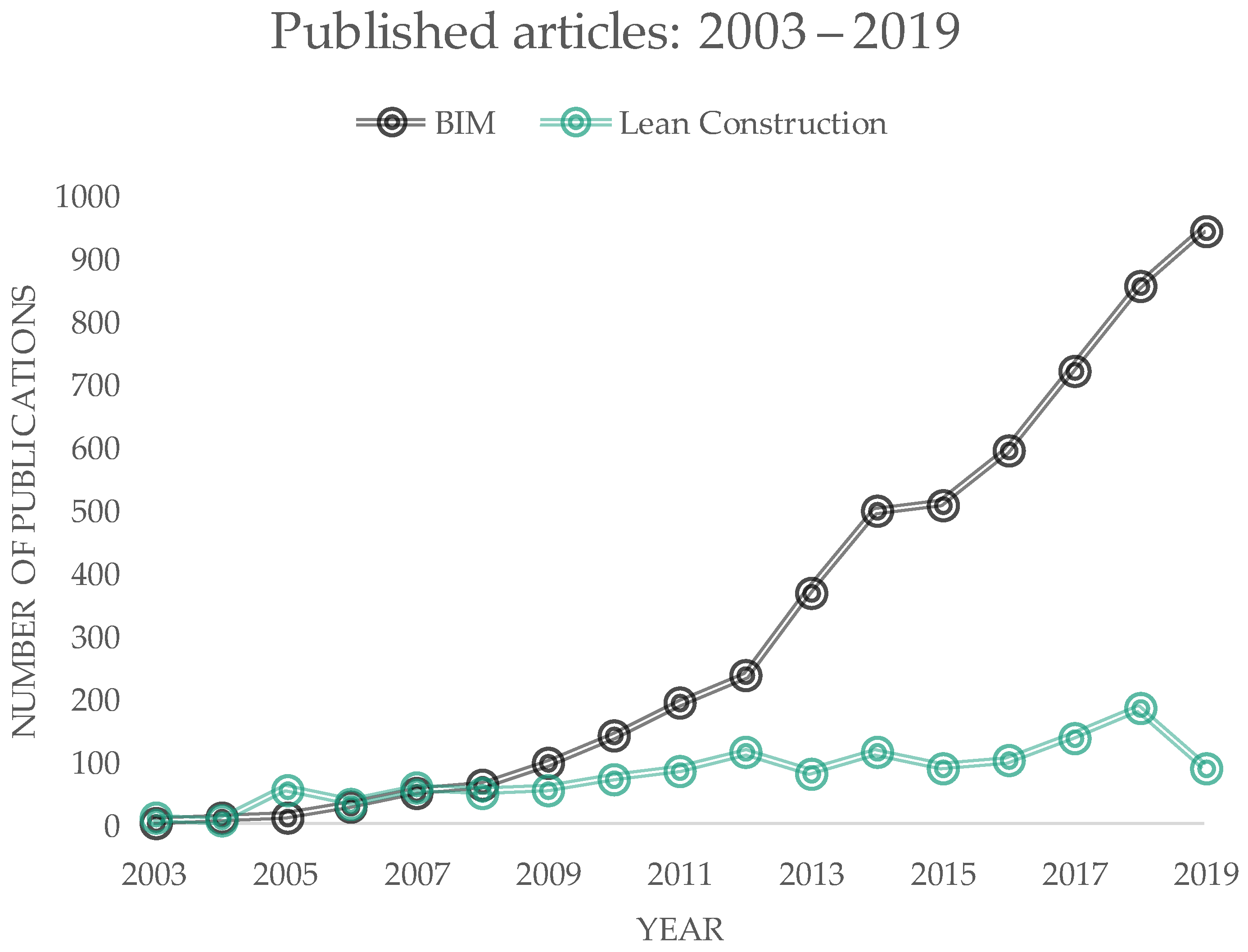

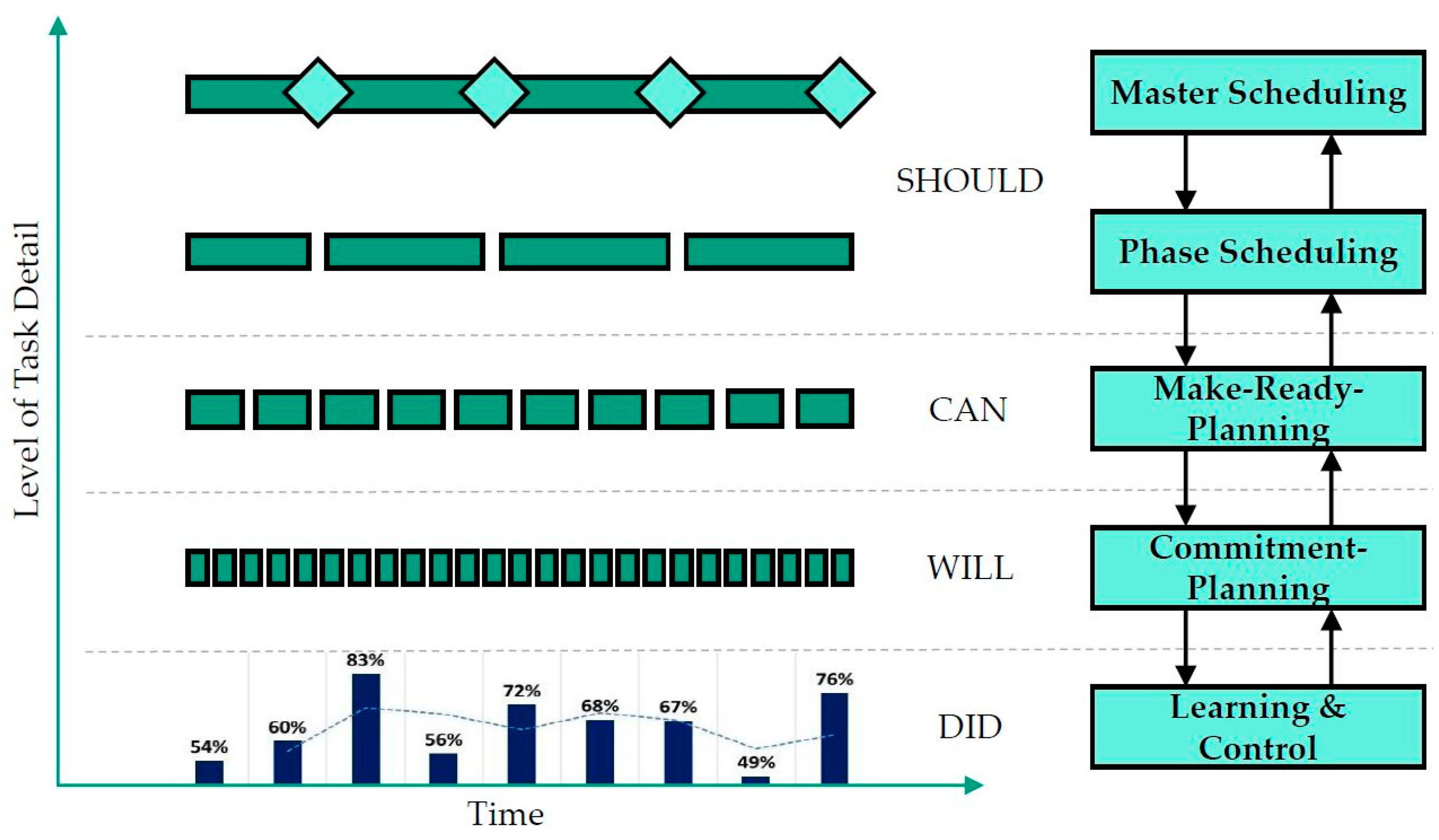

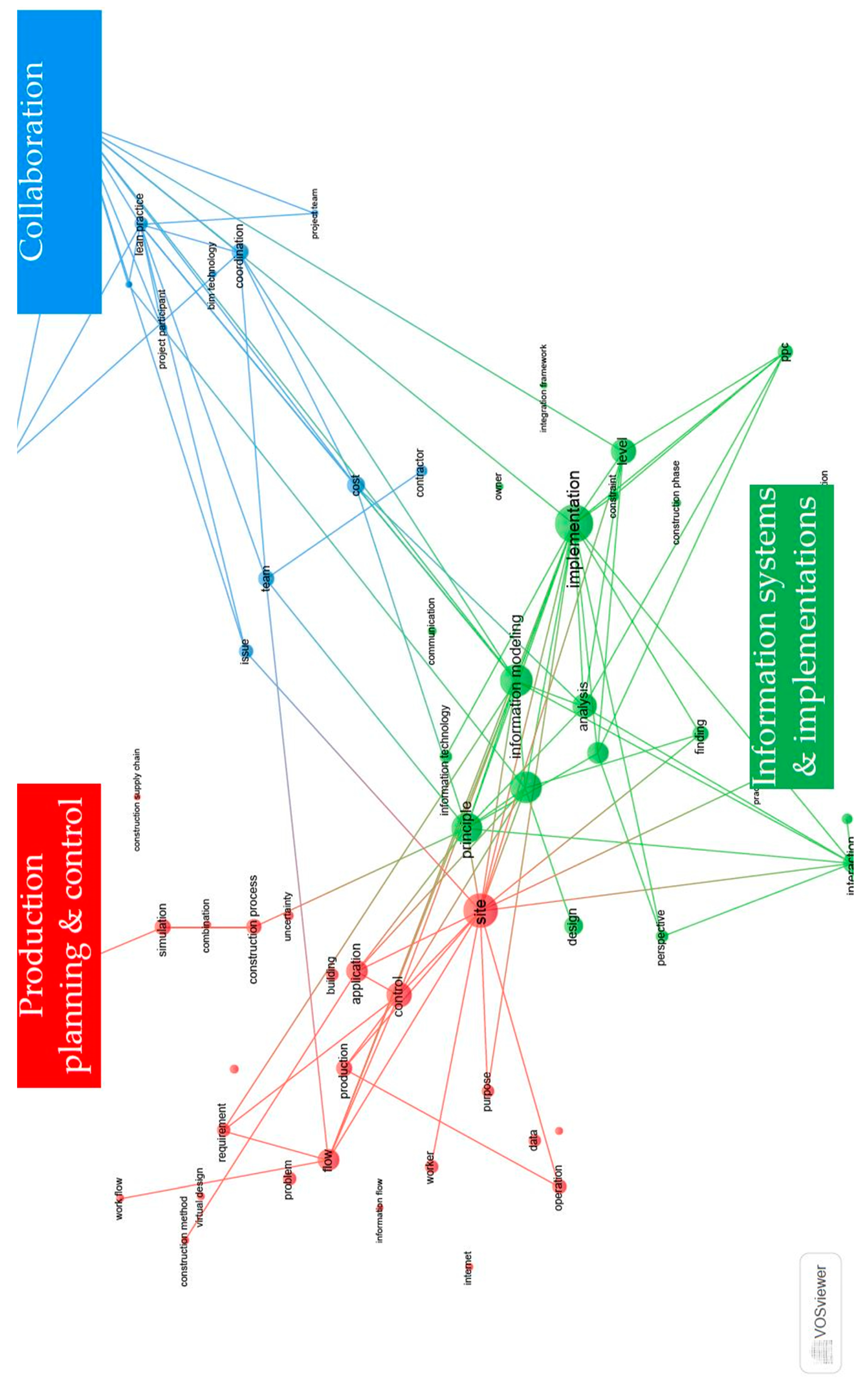

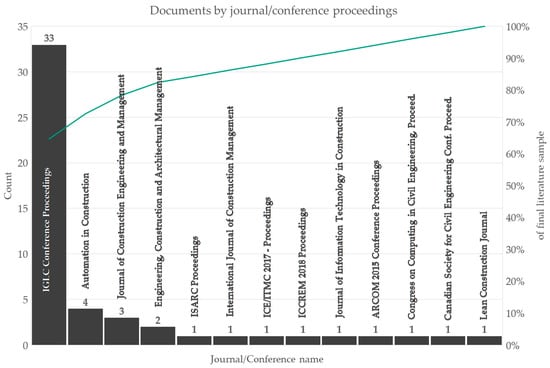

Many researchers have stated that lean and building information modeling (BIM) have positive synergies. This integrative literature review aims at exploring this body of knowledge within the scope of combinations of BIM and the Last Planner® System, as an important Lean construction method, in the phase of construction execution. The research motivation is to find out whether a comprehensive understanding of how to take advantage of these synergies exists. Eventually, the question arises of how to condense this understanding—if existing—into a robust conceptual model for integration. As a theoretical backbone, we will make use of the original BIM-Lean interaction matrix. The hypothesis is that new BIM functionalities have been evolved since the first formulation of this interaction matrix almost 10 years ago. These new BIM functionalities cause new interactions with existing lean principles. We will focus on interactions that refer directly or indirectly to production planning and control and use them to find the most relevant literature for this review. Within the content analysis, as a part of this review, we focus on existing conceptual models and frameworks for integration of BIM and the Last Planner® System and reveal their shortcomings. Eventually, we will propose a new conceptual model. View Full-Text
Keywords: BIM; lean construction; production planning and control; data-driven construction BIM; lean construction; production planning and control; data-driven construction
Show Figures

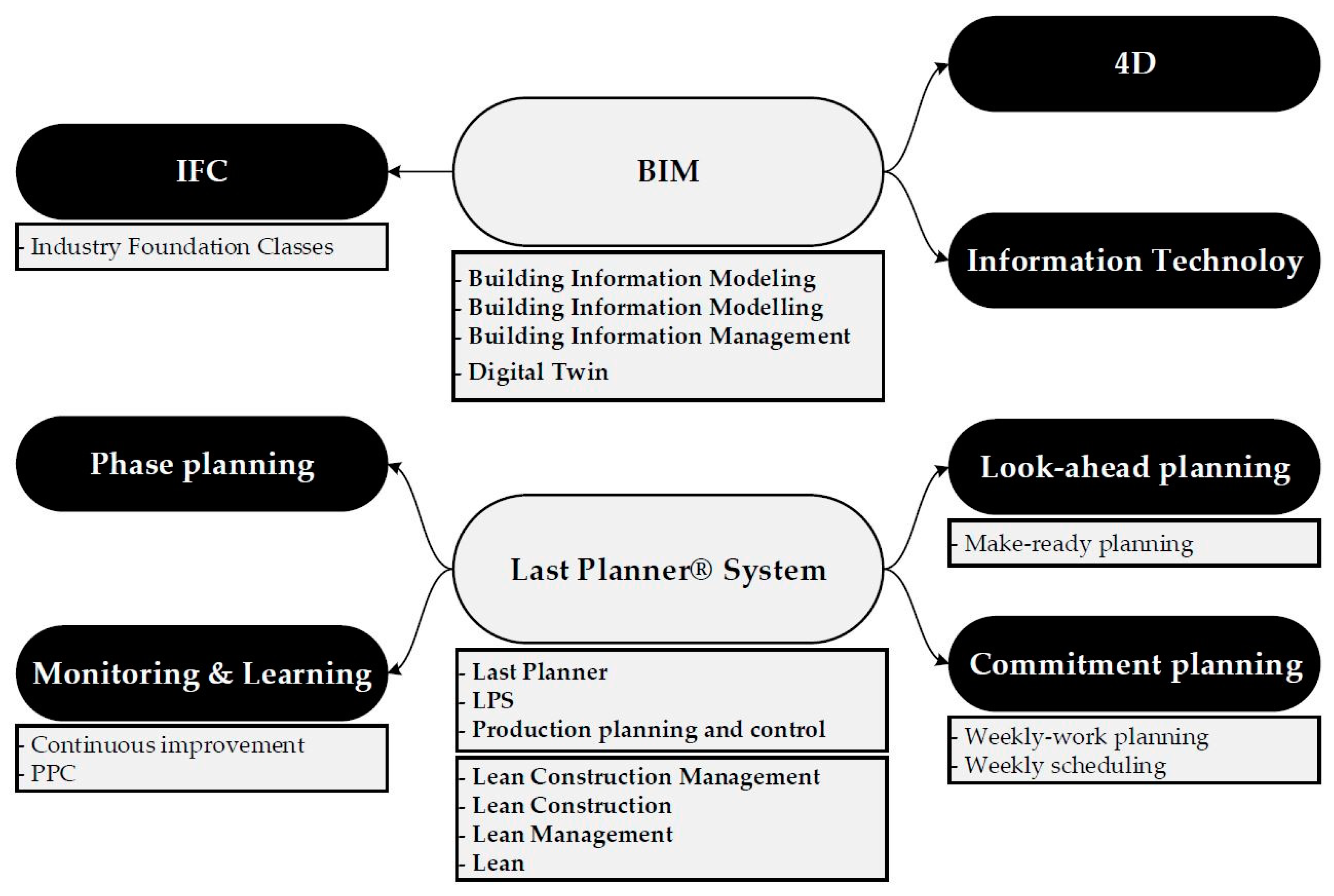

Figure 1
