Stakeholder Conflicts in the Construction Industry: A Systematic Review of Three Decades
Abstract
1. Introduction

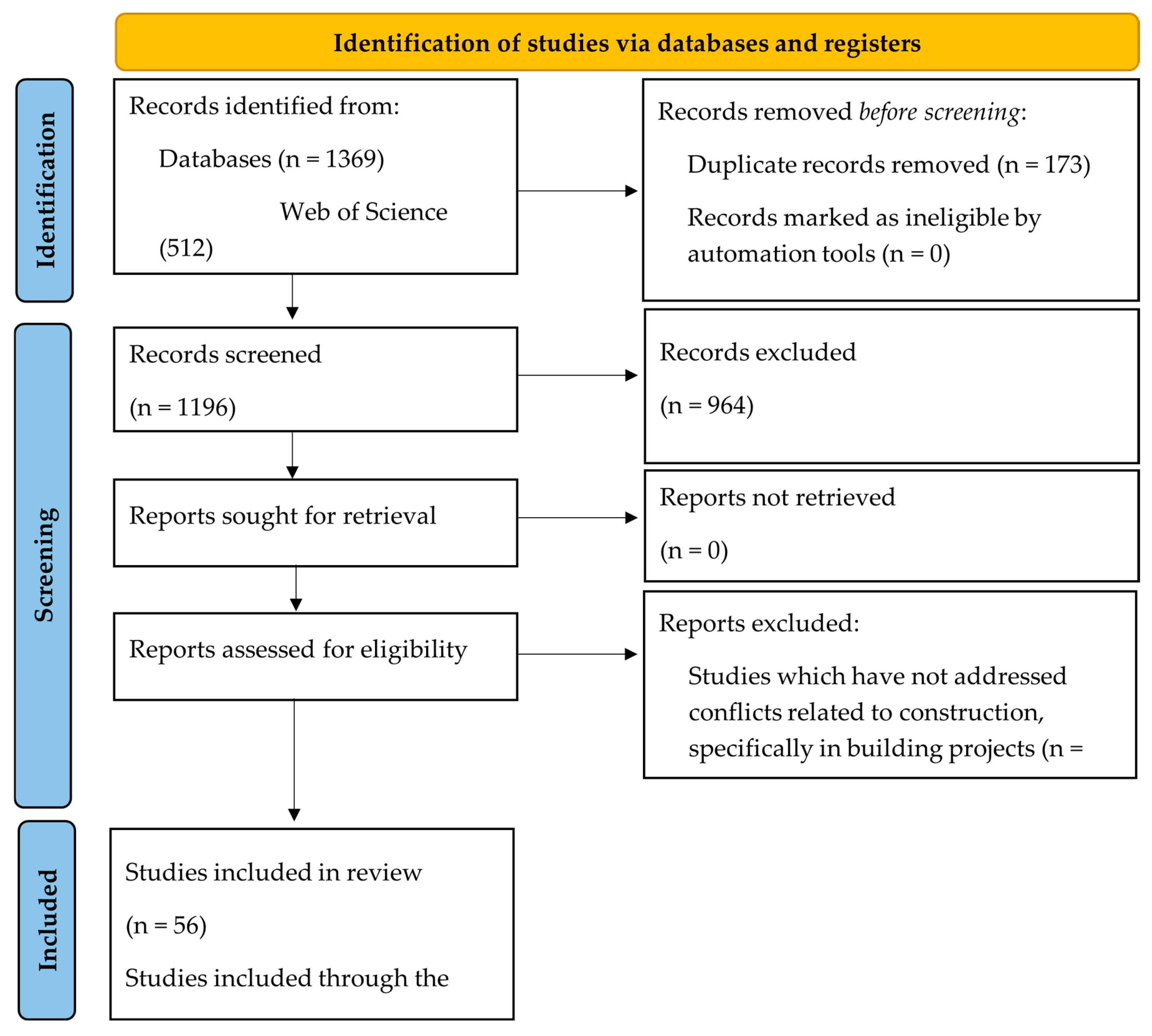

2. Materials and Methods
| Item No | Reference | Reference No |
|---|---|---|
| 1 | (Senaratne & Udawatta, 2013) | [5] |
| 2 | (Gunarathna et al., 2018) | [12] |
| 3 | (Gunasekara et al., 2023) | [27] |
| 4 | (Leung et al., 2005) | [28] |
| 5 | (Liu & Zhai, 2011) | [29] |
| 6 | (Li et al., 2015) | [30] |
| 7 | (Trinkūnas et al., 2021) | [31] |
| 8 | (Amoah & Nkosazana, 2022) | [32] |
| 9 | (Gardiner & Simmons, 1998) | [33] |
| 10 | (Yiu & Cheung, 2006) | [34] |
| 11 | (El-adaway et al., 2017) | [35] |
| 12 | (Chaturvedi et al., 2021) | [36] |
| 13 | (Padroth et al., 2017) | [37] |
| 14 | (Lee et al., 2023) | [38] |
| 15 | (Otasowie et al., 2023) | [39] |
| 16 | (Ussing & Wandahl, 2013) | [40] |
| 17 | (Yusuf & Pretorius, 2017) | [41] |
| 18 | (Tabish & Jha, 2023) | [42] |
| 19 | (Kayastha et al., 2024) | [43] |
| 20 | (Salem et al., 2024) | [44] |
| 21 | (Senaratne et al., 2013) | [45] |
| 22 | (Wu et al., 2017) | [46] |
| 23 | (Jaffar et al., 2011) | [47] |
| 24 | (Zhang & Huo, 2015) | [48] |
| 25 | (Rahimian et al., 2022) | [49] |
| 26 | (Leung et al., 2008) | [50] |
| 27 | (Ashif & Saud, 2024) | [51] |
| 28 | (Kamaruddeen et al., 2019) | [52] |
| 29 | (Aibinu et al., 2008) | [53] |
| 30 | (Nursin et al., 2018) | [54] |
| 31 | (Mahmudnia et al., 2022) | [55] |
| 32 | (Rahnamayiezekavat et al., 2022) | [56] |
| 33 | (Mahamid, 2024) | [57] |
| 34 | (Sagar et al., 2023) | [58] |
| 35 | (Chan et al., 2021) | [59] |
| 36 | (Vilkonis et al., 2023) | [60] |
| 37 | (Yan et al., 2024) | [61] |
| 38 | (Fassa & Wibowo, 2024) | [62] |
| 39 | (Al-Raqeb et al., 2024) | [63] |
| 40 | (Charehzehi et al., 2017) | [64] |
| 41 | (Peansupap & Cheang, 2015) | [65] |
| 42 | (Aibinu, 2009) | [66] |
| 43 | (Ayodeji, 2009) | [67] |
| 44 | (Aibinu, 2006) | [68] |
| 45 | (Strahorn et al., 2015) | [69] |
| 46 | (Ling & Khoo, 2016) | [70] |
| 47 | (Chauhan et al., 2024) | [71] |
| 48 | (A. Rehan et al., 2024) | [72] |
| 49 | (Ashok Rehan et al., 2024) | [73] |
| 50 | (Osei-Kyei et al., 2019) | [74] |
| 51 | (Fu et al., 2013) | [75] |
| 52 | (Rahman et al., 2020) | [76] |
| 53 | (Acharya et al., 2006) | [77] |
| 54 | (Chen et al., 2014) | [78] |
| 55 | (Oyedele et al., 2020) | [79] |
| 56 | (Bahadorestani et al., 2020) | [80] |
| 57 | (Ilter, 2012) | [81] |
| 58 | (Tabassi et al., 2017) | [82] |
| 59 | (Tabassi et al., 2019) | [83] |
| 60 | (Kukah et al., 2022) | [84] |
| 61 | (Abougamil et al., 2024) | [85] |
| 62 | (Hosseinian et al., 2022) | [86] |
| 63 | (Berg et al., 2023) | [87] |
3. Results

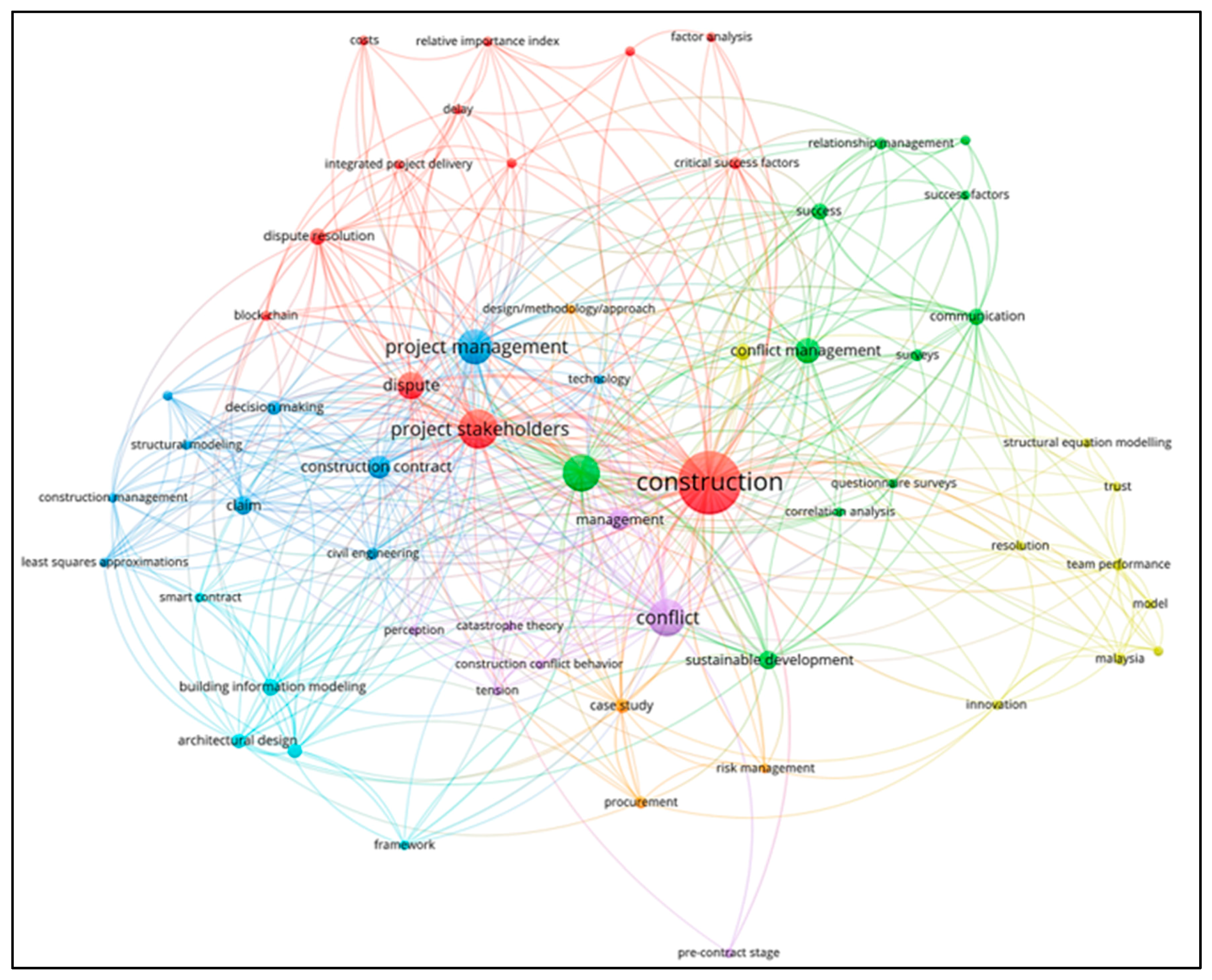

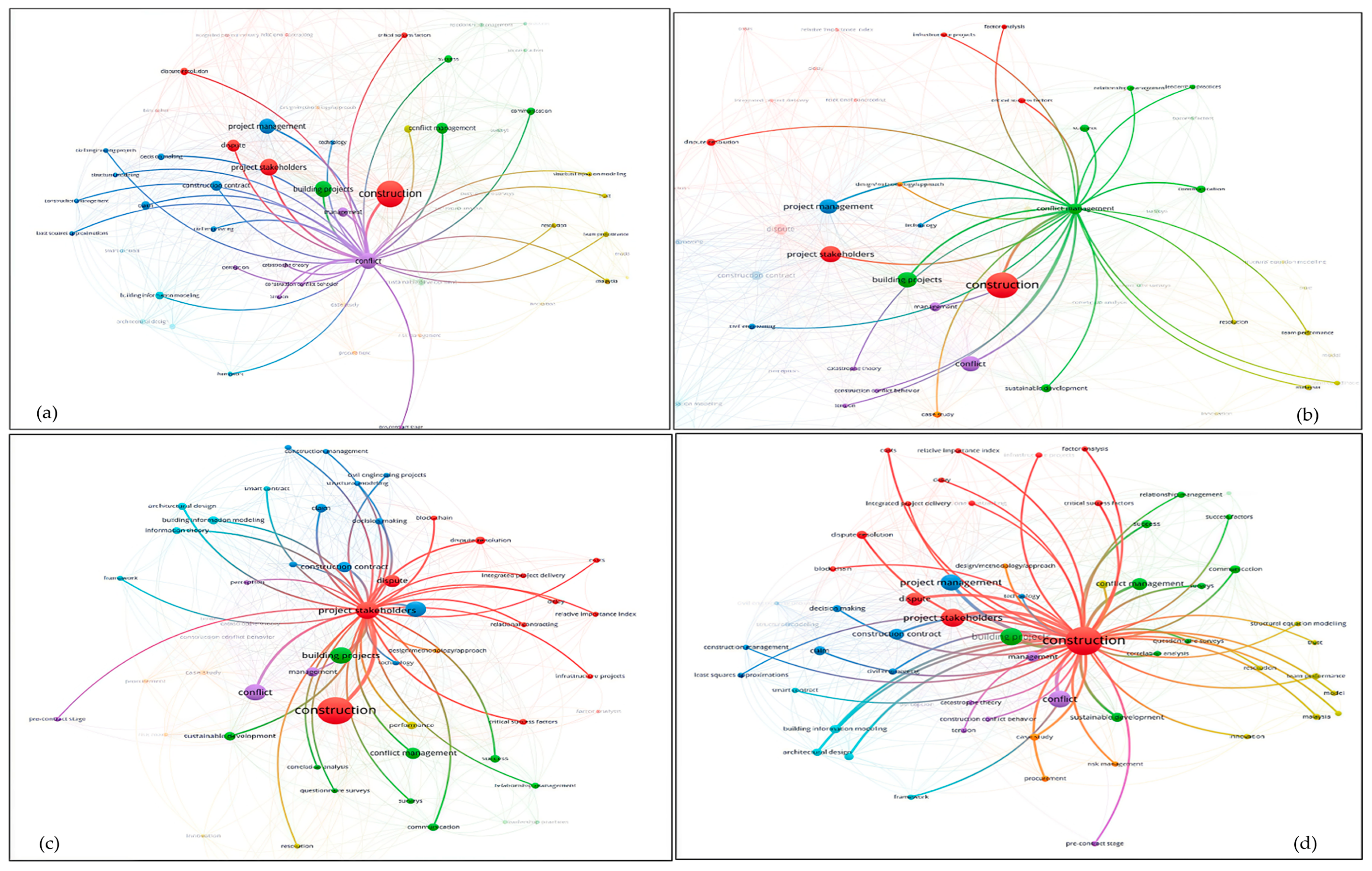

3.1. Bibliometric Analysis

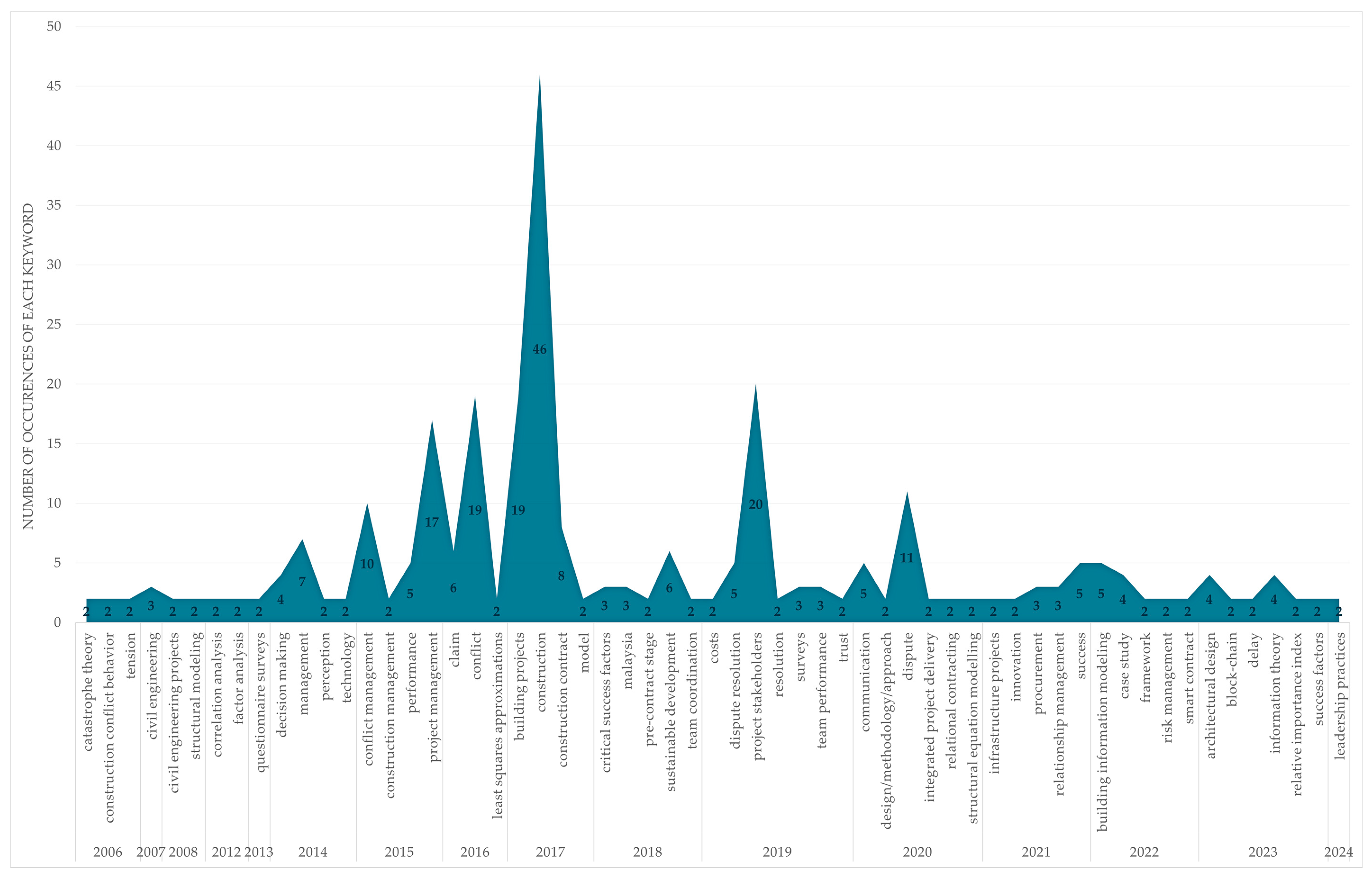

3.2. Trend Analysis
3.3. Causes of Conflicts Between the Stakeholders

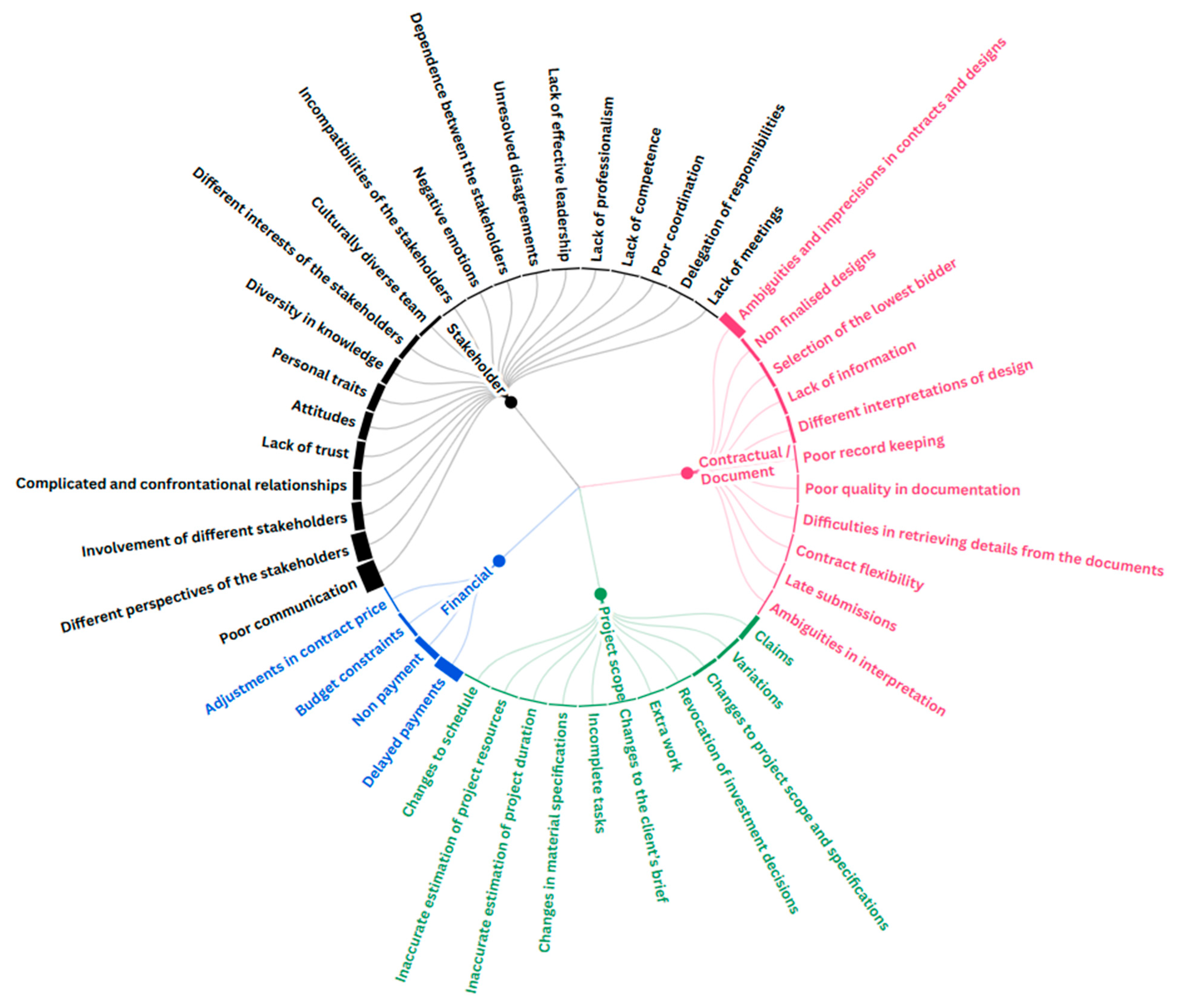

3.3.1. Taxonomies of the Causes of Conflicts Between the Project Stakeholders
- Stakeholder
- Project scope
- Contractual/Document
- Financial

3.3.2. Frequency Analysis of Causes of Conflicts

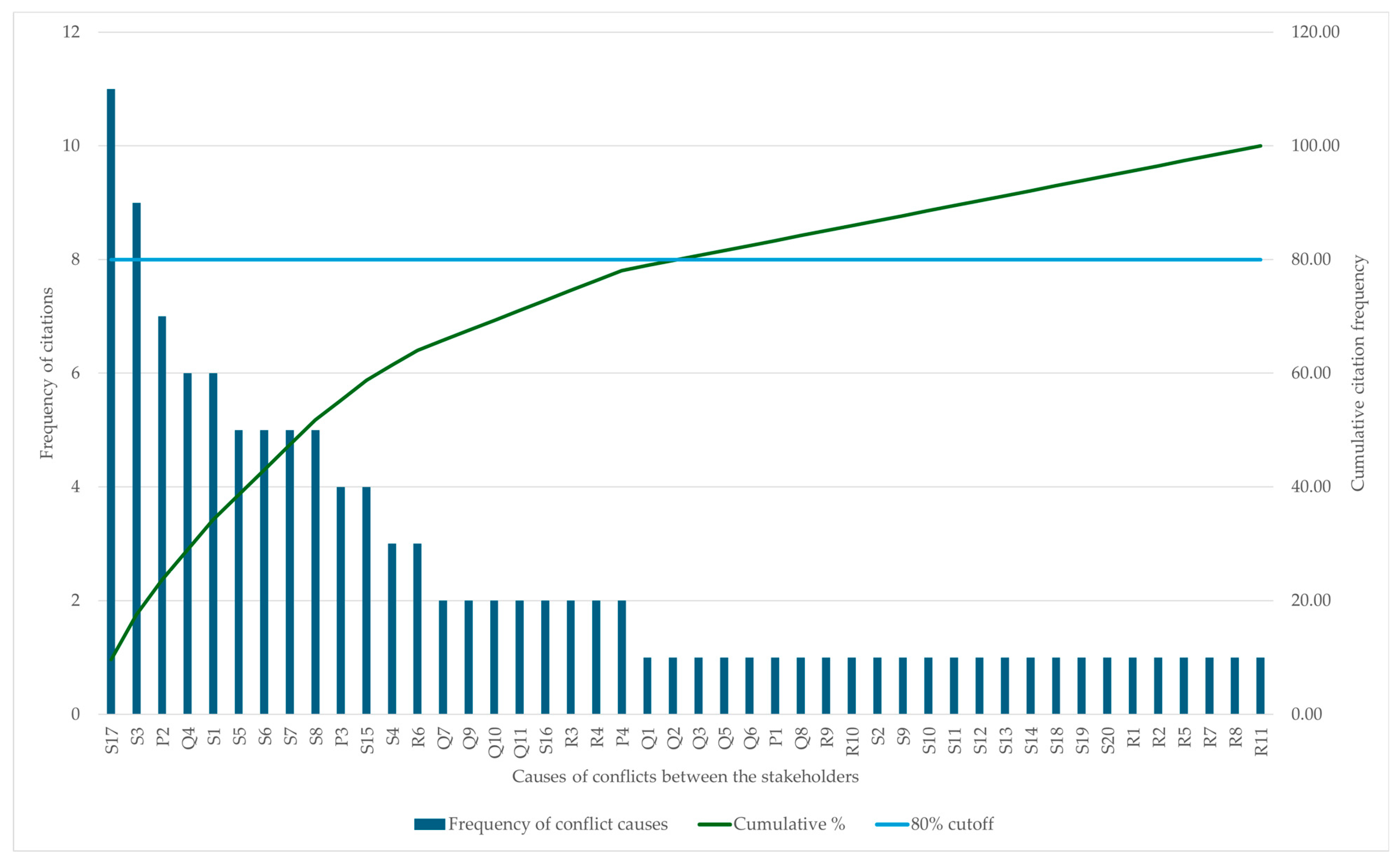

3.3.3. Pareto Analysis of the Causes of Conflicts

3.4. Conflict Management Strategies

3.4.1. Taxonomies of the Conflict Management Strategies Between the Project Stakeholders
- Stakeholder
- Contractual/Document
- Project scope
- Financial
- Technology
3.4.2. Frequency Analysis of Conflict Management Categories

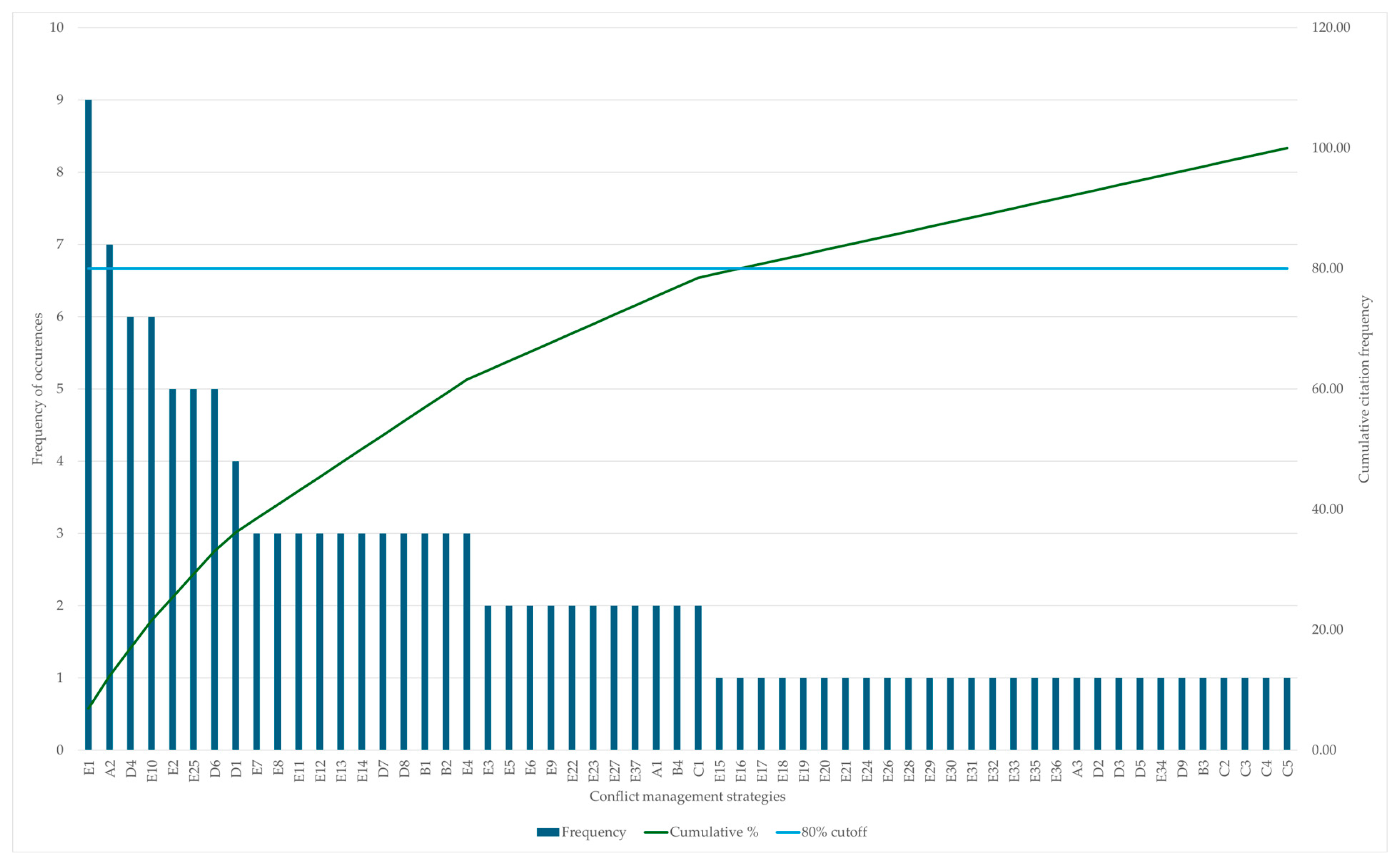

3.4.3. Pareto Analysis of Conflict Management Strategies
4. Discussion
5. Conclusions
Supplementary Materials
Author Contributions
Funding
Data Availability Statement
Conflicts of Interest
Abbreviations
| SLR | Systematic Literature Review |
| PRISMA | Preferred Reporting Items for Systematic Reviews and Meta-Analyses |
References
- Tahir, M.M.; Haron, N.A.; Alias, A.H.; Harun, A.N.; Muhammad, I.B.; Baba, D.L. Improving cost and time control in construction using building information model (Bim): A review. Pertanika J. Sci. Technol. 2018, 26, 21–36. [Google Scholar]
- Kwofie, T.E.; Alhassan, A.; Botchway, E.; Afranie, I. Factors contributing towards the effectiveness of construction project teams. Int. J. Constr. Manag. 2015, 15, 170–178. [Google Scholar] [CrossRef]
- De Dreu, C.K.; Weingart, L.R. Task versus relationship conflict, team performance, and team member satisfaction: A meta-analysis. J. Appl. Psychol. 2003, 88, 741–749. [Google Scholar] [CrossRef] [PubMed]
- Wu, G.; Zhu, Y.; Hu, Z. A bibliometric review of research on interorganizational conflicts in the construction industry: 1989–2021. Int. J. Confl. Manag. 2023, 34, 181–212. [Google Scholar] [CrossRef]
- Senaratne, S.; Udawatta, N. Managing intragroup conflicts in construction project teams: Case studies in Sri Lanka. Archit. Eng. Des. Manag. 2013, 9, 158–175. [Google Scholar] [CrossRef]
- Runde, C.E.; Flanagan, T.A. Building Conflict Competent Teams; Jossey-Bass, A Wiley Imprint: San Francisco, CA, USA, 2008. [Google Scholar]
- Runde, C.; Flanagan, T. Becoming a Conflict Competent Leader: How You and Your Organization Can Manage Conflict Effectively, 2nd ed.; Jossey-Bass, A Wiley Imprint: San Francisco, CA, USA, 2013. [Google Scholar]
- Adham, T.K.I. Conflict resolution in team: Analyzing the cause of conflicts and best skills for resolution. Sch. J. Eng. Technol. 2023, 11, 152–162. [Google Scholar] [CrossRef]
- Femi, O.T. Causes and effects of conflicts in the Nigerian construction industry. Int. J. Technol. En-Hancement Emerg. Eng. Res. 2014, 2, 7–16. [Google Scholar]
- Senarath, P.A.N.B.; Francis, M. Dispute avoidance from the perspective of procurement methods: A conceptual focus. In Proceedings of the 9th World Construction Symposium, Online, 9–10 July 2021. [Google Scholar]
- Senarath, N.B.; Francis, M. Dispute avoidance in the construction industry: A perspective of procurement methods. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2024, 16, 04524011. [Google Scholar] [CrossRef]
- Gunarathna, C.; Yang, R.J.; Fernando, N. Conflicts and management styles in the Sri Lankan commercial building sector. Eng. Constr. Archit. Manag. 2018, 25, 178–201. [Google Scholar] [CrossRef]
- Todorova, G.; Goh, K.T.; Weingart, L.R. The effects of conflict type and conflict expression intensity on conflict management. Int. J. Confl. Manag. 2022, 33, 245–272. [Google Scholar] [CrossRef]
- Madalina, O. Conflict management, a new challenge. Procedia Econ. Financ. 2016, 39, 807–814. [Google Scholar] [CrossRef]
- Wang, D.; Wang, T.; Jia, J.; Xiao, L. Inter-organizational conflict in the construction industry: A systematic review integrating multiple perspectives and future research directions. J. Asian Archit. Build. Eng. 2025, 1–15. [Google Scholar] [CrossRef]
- Liu, N.; Zhou, R.; Jin, R.; Xiao, Q.; Hu, Z. Scientometric review of construction conflict from 1991 to 2020. Eng. Constr. Archit. Manag. 2022, 30, 4210–4228. [Google Scholar] [CrossRef]
- Sabri, O.; Lædre, O.; Bruland, A. A structured literature review on construction conflict prevention and resolution: A modified approach for engineering. Organ. Technol. Manag. Constr. Int. J. 2022, 14, 2616–2630. [Google Scholar] [CrossRef]
- Page, M.J.; McKenzie, J.E.; Bossuyt, P.M.; Boutron, I.; Hoffmann, T.C.; Mulrow, C.D.; Shamseer, L.; Tetzlaff, J.M.; Akl, E.A.; Brennan, S.E.; et al. The PRISMA 2020 statement: An updated guideline for reporting systematic reviews. BMJ 2021, 372, n71. [Google Scholar] [CrossRef]
- Karunasena, G.; Gajanayake, A.; Wijeratne, W.M.P.U.; Milne, N.; Udawatta, N.; Perera, S.; Crimston, A.; Aliviano, P. Liquid waste management in the construction sector: A systematic literature review. Int. J. Constr. Manag. 2024, 24, 86–96. [Google Scholar] [CrossRef]
- Van Eck, N.J.; Waltman, L. Software survey: VOSviewer, a computer programfor bibliometric mapping. Scientometrics 2010, 84, 523–538. [Google Scholar] [CrossRef] [PubMed]
- Chen, C. CiteSpace II: Detecting and Visualizing Emerging Trends and Transient Patterns in Scientific Literature. J. Am. Soc. Inf. Sci. Technol. 2006, 57, 359–377. [Google Scholar] [CrossRef]
- Bastian, M.; Heymann, S.; Jacomy, M. Gephi: An open source software for exploring and manipulating networks visualization and exploration of large graphs. In Proceedings of the Third International ICWSM Conference, San Jose, CA, USA, 17–20 May 2009. [Google Scholar]
- Powell, T.; Sammut-Bonnici, T. Pareto analysis. In Wiley Encyclopedia of Management; Cooper, C.L., McGee, J., Sammut-Bonnici, T., Eds.; Wiley: Hoboken, NJ, USA, 2015. [Google Scholar] [CrossRef]
- Thirumal, S.; Udawatta, N.; Karunasena, G.; Al-Ameri, R. Barriers to Adopting Digital Technologies to Implement Circular Economy Practices in the Construction Industry: A Systematic Literature Review. Sustainability 2024, 16, 3185. [Google Scholar] [CrossRef]
- Talib, F.; Rahman, Z.; Qureshi, M.N. Pareto analysis of total quality management factors critical to success for service industries. Int. J. Qual. Res. 2010, 4, 155–168. [Google Scholar]
- Wuni, I.Y. Mapping the barriers to circular economy adoption in the construction industry: A systematic review, Pareto analysis, and mitigation strategy map. Build. Environ. 2022, 223, 109453. [Google Scholar] [CrossRef]
- Gunasekara, D.M.H.; Indikatiya, I.H.P.R.; Perera, B.A.K.S.; Senaratne, S. Managing intragroup conflicts within project design teams during pre-contract stage that effect the project deliverables in Sri Lanka. Constr. Innov. 2023, 23, 406–424. [Google Scholar] [CrossRef]
- Leung, M.Y.; Liu, A.M.M.; Ng, S.T. Is there a relationship between construction conflicts and participants’ satisfaction? Eng. Constr. Archit. Manag. 2005, 12, 149–167. [Google Scholar] [CrossRef]
- Liu, A.M.M.; Zhai, X.F. Influences of personality on the adoption of conflict-handling styles and conflict outcomes for facility managers. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2011, 3, 101–108. [Google Scholar] [CrossRef]
- Wang, Y.; Olofsson, T.; Shen, G.; Bai, Y. ICCREM 2015—Environment and the Sustainable Building, Proceedings of the 2015 International Conference on Construction and Real Estate Management, Luleå, Sweden, 11–12 August 2015; ASCE: Reston, VA, USA, 2015. [Google Scholar]
- Trinkūnas, V.; Quapp, U.; Banaitienė, N.; Holschemacher, K.; Trinkūnienė, E.; Banaitis, A. Comparison of Mediation Systems in the Construction Industry of Two European Countries. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2021, 13, 04521027. [Google Scholar] [CrossRef]
- Amoah, C.; Nkosazana, H. Effective management strategies for construction contract disputes. Int. J. Build. Pathol. Adapt. 2022, 41, 70–84. [Google Scholar] [CrossRef]
- Gardiner, P.D.; Simmons, J.E.L. Conflict in small- and medium-sized projects: Case of partnering to the rescue. J. Manag. Eng. 1998, 14, 35–40. [Google Scholar] [CrossRef]
- Yiu, K.T.W.; Cheung, S.O. A catastrophe model of construction conflict behavior. Build. Environ. 2006, 41, 438–447. [Google Scholar] [CrossRef]
- El-adaway, I.; Abotaleb, I.; Eteifa, S. Framework for Multiparty Relational Contracting. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2017, 9, 04517018. [Google Scholar] [CrossRef]
- Chaturvedi, S.; Bhatt, N.; Rajasekar, E.; Patel, H. Assessment of Critical Causes of Conflicts for Building Construction Projects in India Using Fuzzy Analytical Network Process. J. Inst. Eng. (India) Ser. A 2021, 102, 919–941. [Google Scholar] [CrossRef]
- Padroth, C.; Davis, P.R.; Morrissey, M. Contract Information Asymmetry: Legal Disconnect within the Project Team. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2017, 9, 04517015. [Google Scholar] [CrossRef]
- Lee, K.T.; Park, S.J.; Kim, J.H. Comparative analysis of managers’ perception in overseas construction project risks and cost overrun in actual cases: A perspective of the Republic of Korea. J. Asian Archit. Build. Eng. 2023, 22, 2291–2308. [Google Scholar] [CrossRef]
- Otasowie, K.; Aigbavboa, C.; Oke, A.; Adekunle, P. Contributing Factors to Relational Conflict in Construction Project Delivery in South Africa. In Proceedings of the 13th International Conference on Construction in the 21st Century, CITC 2023, Arnhem, The Netherlands, 8–11 May 2023. [Google Scholar]
- Ussing, L.F.; Wandahl, S. Unfavorable communications lead to conflicts in building projects. In ICCREM 2013: Construction and Operation in the Context of Sustainability, Proceedings of the 2013 International Conference on Construction and Real Estate Management, Karlsruhe, Germany, 10–11 October 2013; ASCE: Reston, VA, USA, 2013. [Google Scholar]
- Yusuf, A.S.; Pretorius, J.H.C. Conflict management in projects. In Proceedings of the 2017 IEEE AFRICON: Science, Technology and Innovation for Africa, AFRICON 2017 C7–8095588, Cape Town, South Africa, 18–20 September 2017. [Google Scholar]
- Tabish, S.Z.S.; Jha, K.N. Dispute Avoidance in Public Construction Projects. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2023, 15, 04522033. [Google Scholar] [CrossRef]
- Kayastha, R.; Kisi, K.; Chitrakar, Y. Analysis of Price Adjustment Claim during Project Time Extension. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2024, 16, 06523003. [Google Scholar] [CrossRef]
- Salem, E.; Elwakil, E.; Hegab, M. Emerging trends in construction dispute resolution: Integrating technology and collaboration for the future. In Civil Engineering, Material and Smart Buildings: New Technologies in Cities’ Infrastructures. ICATH 2023. Sustainable Civil Infrastructures; Mosallam, A.S., El Bhiri, B., Merzouk, S., Eds.; Springer: Cham, Switzerland, 2024. [Google Scholar]
- Senaratne, S.; Udawatta, N.; Gunasekara, D.M.H. Intragroup conflicts in the pre contract stage of construction projects. In Proceedings of the 38th Australasian Universities Building Education Association International Conference, Auckland, New Zealand, 20–22 November 2013. [Google Scholar]
- Wu, G.; Zhao, X.; Zuo, J. Effects of inter-organizational conflicts on construction project added value in China. Int. J. Confl. Manag. 2017, 28, 695–723. [Google Scholar] [CrossRef]
- Jaffar, N.; Tharim, A.H.A.; Shuib, M.N. Factors of conflict in construction industry: A literature review. Proceedia Eng. 2011, 20, 193–202. [Google Scholar] [CrossRef]
- Zhang, L.; Huo, X. The impact of interpersonal conflict on construction project performance: A moderated mediation study from China. Int. J. Confl. Manag. 2015, 26, 479–498. [Google Scholar] [CrossRef]
- Rahimian, A.; Hosseini, M.R.; Martek, I.; Taroun, A.; Alvanchi, A.; Odeh, I. Predicting communication quality in construction projects: A fully-connected deep neural network approach. Autom. Constr. 2022, 139, 104268. [Google Scholar] [CrossRef]
- Leung, M.Y.; Chan, Y.S.; Chong, A.; Sham, J.F.C. Developing structural integrated stressor-stress models for clients’ and contractors’ cost engineers. J. Constr. Eng. Manag. 2008, 134, 635–643. [Google Scholar] [CrossRef]
- Ashif, E.K.M.; Saud, S.J. A study on dispute resolution mechanisms with emphasis on high-rise buildings from perspectives of schedule, cost and quality in Ernakulam district, Kerala using relative importance index method. In Proceedings of SECON’24. SECON 2024. Lecture Notes in Civil Engineering; Nehdi, M., Rahman, R.A., Davis, R.P., Antony, J., Kavitha, P.E., Jawahar Saud, S., Eds.; Springer: Cham, Switzerland, 2024. [Google Scholar]
- Kamaruddeen, A.M.; Li, B.W.; John, O.N.; Wahi, W. Identification of the causes of conflict among construction players in Sarawak, Malaysia. Int. J. Recent Technol. Eng. 2019, 8, 2100–2107. [Google Scholar] [CrossRef]
- Aibinu, A.A.; Ofori, G.; Ling, F.Y.Y. Explaining cooperative behavior in building and civil engineering projects’ claims process: Interactive effects of outcome favorability and procedural fairness. J. Constr. Eng. Manag. 2008, 134, 681–691. [Google Scholar] [CrossRef]
- Nursin, A.; Latif, Y.; Mochtar, K.; Soeparto, H.G. Cross-Party Collaboration to Reduce Construction Waste to Design-Build Projects. Int. J. Technol. 2018, 9, 751–765. [Google Scholar] [CrossRef]
- Mahmudnia, D.; Arashpour, M.; Yang, R. Blockchain in construction management: Applications, advantages and limitations. Autom. Constr. 2022, 140, 104379. [Google Scholar] [CrossRef]
- Rahnamayiezekavat, P.; Sorooshnia, E.; Rashidi, M.; Faraji, A.; Mostafa, S.; Moon, S. Forensic Analysis of the Disputes Typology of the NSW Construction Industry Using PLS-SEM and Prospective Trend Analysis. Buildings 2022, 12, 1571. [Google Scholar] [CrossRef]
- Mahamid, I. Study of relationship between cost overrun and material waste in building construction projects. Int. Rev. Appl. Sci. Eng. 2024, 15, 20–28. [Google Scholar] [CrossRef]
- Sagar, S.K.; Oladinrin, O.T.; Arif, M.; Kaushik, A.; Islam, R. Impact of trust in virtual project teams: Structural equation modelling approach. Constr. Innov. 2023. [Google Scholar] [CrossRef]
- Chan, E.E.; Nik-Bakht, M.; Han, S.H. Sources of Ambiguity in Construction Contract Documents, Reflected by Litigation in Supreme Court Cases. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2021, 13, 04521031. [Google Scholar] [CrossRef]
- Vilkonis, A.; Antucheviciene, J.; Kutut, V. Construction contracts quality assessment from the point of view of contractor and customer. Buildings 2023, 13, 1154. [Google Scholar] [CrossRef]
- Yan, L.; Pan, Y.; Chen, Y. Understanding the Double-Edged Sword Effect of Contract Flexibility on Contractor’s Opportunistic Behavior in Construction Project: Moderating Role of BIM Application Degree. J. Constr. Eng. Manag. 2024, 150, 04024124. [Google Scholar] [CrossRef]
- Fassa, F.; Wibowo, A. Issues and challenges of employing the design-build contract system in government construction projects: Lessons learned from the gelora bung karno project. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2024, 16, 05024002. [Google Scholar] [CrossRef]
- Al-Raqeb, H.; Ghaffar, S.H.; Haitherali, H.; Gopakumar, A. Overcoming Barriers to Implementing Building Information Modelling in Kuwait’s Ministry of Public Works: A Framework for Sustainable Construction. Buildings 2024, 14, 130. [Google Scholar] [CrossRef]
- Charehzehi, A.; Chai, C.; Yusof, A.M.; Chong, H.Y.; Loo, S.C. Building information modeling in construction conflict management. Int. J. Eng. Bus. Manag. 2017, 9, 1–18. [Google Scholar] [CrossRef]
- Peansupap, V.; Cheang, L. Identifying Issues of Change Leading to Cost Conflicts: Case Study in Cambodia. Procedia Eng. 2015, 123, 379–387. [Google Scholar] [CrossRef][Green Version]
- Aibinu, A.A. Avoiding and Mitigating Delay and Disruption Claims Conflict: Role of Precontract Negotiation. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2009, 1, 47–58. [Google Scholar] [CrossRef]
- Ayodeji, A.A. Reducing Disputes in Construction Claims: The Role of the Decision-Making Process. AACE International Transactions. 2009. Available online: https://www.researchgate.net/publication/282905732_Reducing_disputes_in_construction_claims_The_role_of_the_decision-making_process (accessed on 20 February 2026).
- Aibinu, A.A. The relationship between distribution of control, fairness and potential for dispute in the claims handling process. Constr. Manag. Econ. 2006, 24, 45–54. [Google Scholar] [CrossRef]
- Strahorn, S.; Gajendran, T.; Brewer, G. The Influence of Trust in Traditional Contracting: Investigating the “Lived Experience” of Stakeholders. Constr. Econ. Build. 2015, 15, 81–101. [Google Scholar] [CrossRef]
- Ling, F.Y.Y.; Khoo, W.W. Improving relationships in project teams in Malaysia. Built Environ. Proj. Asset Manag. 2016, 6, 284–301. [Google Scholar] [CrossRef]
- Chauhan, U.S.; Saikia, S.; Johari, S. Mitigation measures for conflicting situations on Indian construction sites. In Proceedings of the 12th World Construction Symposium, Colombo, Sri Lanka, 9–10 August 2024. [Google Scholar]
- Rehan, A.; Thorpe, D.; Heravi, A. Leadership practices and communication framework for project success: The construction sector. Organ. Technol. Manag. Constr. Int. J. 2024, 16, 204–223. [Google Scholar] [CrossRef]
- Rehan, A.; Thorpe, D.; Heravi, A. Project success factors for leadership practices and communication: Challenges in the construction sector. Int. J. Manag. Proj. Bus. 2024, 17, 562–590. [Google Scholar] [CrossRef]
- Osei-Kyei, R.; Chan, A.P.C.; Yao, Y.; Mazher, K.M. Conflict prevention measures for public-private partnerships in developing countries. J. Financ. Manag. Prop. Constr. 2019, 24, 39–57. [Google Scholar] [CrossRef]
- Fu, Y.; Chen, Y.; Zhang, S. Empirical study on the relationship between owner-contractor conflict and schedule performance in design-bid-build projects. In ICCREM 2013: Construction and Operation in the Context of Sustainability, Proceedings of the 2013 International Conference on Construction and Real Estate Management, Karlsruhe, Germany, 10–11 October 2013; ASCE: Reston, VA, USA, 2013. [Google Scholar]
- Rahman, S.H.A.; Nusa, F.N.M.; Md Hanafiah, R.; Jusoh, M.Z.; Endut, I.R.; Faisol, N. Antecedents and Consequences of Trust and Satisfaction in Main Contractor and Subcontractor Relationship. In IOP Conference Series: Earth and Environmental Science; IOP Publishing: Bristol, UK, 2020. [Google Scholar]
- Acharya, N.K.; Lee, Y.D.; Kim, S.Y.; Kim, J.K. Teamwork and job satisfaction in construction projects. In Proceedings of the 2006 Technology Management for the Global Future-PICMET 2006 Conference, Istanbul, Turkey, 8–13 July 2006. [Google Scholar]
- Chen, Y.Q.; Zhang, Y.B.; Zhang, S.J. Impacts of different types of owner-contractor conflict on cost performance in construction projects. J. Constr. Eng. Manag. 2014, 140, 04014017. [Google Scholar] [CrossRef]
- Oyedele, A.; Owolabi, H.A.; Oyedele, L.O.; Olawale, O.A. Big data data innovation and diffusion in projects teams: Towards a conflict prevention culture. Dev. Built Environ. 2020, 3, 100016. [Google Scholar] [CrossRef]
- Bahadorestani, A.; Naderpajouh, N.; Sadiq, R. Planning for sustainable stakeholder engagement based on the assessment of conflicting interests in projects. J. Clean. Prod. 2020, 242, 118402. [Google Scholar] [CrossRef]
- Ilter, D. Identification of the relations between dispute factors and dispute categories in construction projects. Int. J. Law Built Environ. 2012, 4, 45–59. [Google Scholar] [CrossRef]
- Tabassi, A.A.; Bryde, D.J.; Abdullaha, A.; Argyropoulou, M. Conflict management style of team leaders in multi-cultural work environment in the construction industry. Procedia Comput. Sci. 2017, 121, 41–46. [Google Scholar] [CrossRef]
- Tabassi, A.A.; Abdullah, A.; Bryde, D.J. Conflict Management, Team Coordination, and Performance Within Multicultural Temporary Projects: Evidence from the Construction Industry. Proj. Manag. J. 2019, 50, 101–114. [Google Scholar] [CrossRef]
- Kukah, A.S.; Akomea-Frimpong, I.; Jin, X.; Osei-Kyei, R. Emotional intelligence (EI) research in the construction industry: A review and future directions. Eng. Constr. Archit. Manag. 2022, 29, 4267–4286. [Google Scholar] [CrossRef]
- Abougamil, R.A.; Thorpe, D.; Heravi, A. A BIM Package with a NEC4 Contract Option to Mitigate Construction Disputes in the Kingdom of Saudi Arabia. Buildings 2024, 14, 2009. [Google Scholar] [CrossRef]
- Hosseinian, S.M.; Andalib, M.; Carmichael, D.G. Appropriate Types of Payments in Construction Contracts Based on Agency Theory Parameters. J. Constr. Eng. Manag. 2022, 148, 04021187. [Google Scholar] [CrossRef]
- Berg, J.B.; Thuesen, C.; Jensen, P.A. Procurement innovation as a vehicle for sustainable change–a case study of the Danish model of strategic partnerships. Constr. Innov. 2023, 23, 665–682. [Google Scholar] [CrossRef]
- Oladinrin, O.T.; Arif, M.; Rana, M.Q.; Gyoh, L. Interrelations between construction ethics and innovation: A bibliometric analysis using VOSviewer. Constr. Innov. 2023, 23, 505–523. [Google Scholar] [CrossRef]
- Van Eck, N.J.; Waltman, L. Visualizing bibliometric networks. In Measuring Scholarly Impact: Methods and Practice; Ding, Y., Rousseau, R., Wolfram, D., Eds.; Springer: Cham, Switzerland, 2014; pp. 285–320. [Google Scholar] [CrossRef]
- Huang, Y.-J.; Cheng, S.; Yang, F.-Q.; Chen, C. Analysis and visualization of research on resilient cities and communities based on VOSviewer. Int. J. Environ. Res. Public Health 2022, 19, 7068. [Google Scholar] [CrossRef] [PubMed]

| Conflict Category | Code | Cause of Conflict | References | Frequency | |
|---|---|---|---|---|---|
| Financial | P1 | Adjustments in contract price | [43] | 1 | 14 |
| P2 | Delayed payments | [12,31,47,51,55,56,64] | 7 | ||
| P3 | Non-payment | [12,47,51,64] | 4 | ||
| P4 | Budget constraints | [5,52] | 2 | ||
| Contractual/document | Q1 | Poor record keeping | [55] | 1 | 20 |
| Q2 | Poor quality in documentation | [55] | 1 | ||
| Q3 | Difficulties in retrieving details from the documents | [55] | 1 | ||
| Q4 | Ambiguities and imprecisions of the contract documents and designs | [12,31,45,59,60,62] | 6 | ||
| Q5 | Contract flexibility | [61] | 1 | ||
| Q6 | Late submissions | [12] | 1 | ||
| Q7 | Non finalized designs | [12,65] | 2 | ||
| Q8 | Ambiguities in interpretation | [62] | 1 | ||
| Q9 | Selection of the lowest bidder | [57,63] | 2 | ||
| Q10 | Lack of information | [27,46] | 2 | ||
| Q11 | Different interpretations of design | [27,46] | 2 | ||
| Project scope | R1 | Revocation of investment decisions | [5] | 1 | 15 |
| R2 | Extra work | [5] | 1 | ||
| R3 | Variations | [5,12] | 2 | ||
| R4 | Changes to project scope and specifications | [32,65] | 2 | ||
| R5 | Changes to the client’s brief | [65] | 1 | ||
| R6 | Claims | [66,67,68] | 3 | ||
| R7 | Incomplete tasks | [27] | 1 | ||
| R8 | Changes in material specifications | [65] | 1 | ||
| R9 | Inaccurate estimation of project duration | [51] | 1 | ||
| R10 | Inaccurate estimation of project resources | [51] | 1 | ||
| R11 | Changes to schedule | [65] | 1 | ||
| Stakeholder | S1 | Involvement of different stakeholders | [5,28,29,30,31,32] | 6 | 65 |
| S2 | Incompatibilities of the stakeholders | [27] | 1 | ||
| S3 | Different perspectives of the stakeholders | [27,28,33,34,35,36,37,38,39] | 9 | ||
| S4 | Different interests of the stakeholders | [37,38,39] | 3 | ||
| S5 | Complicated and confrontational relationships | [40,41,42,43,44] | 5 | ||
| S6 | Lack of trust | [40,41,42,43,44] | 5 | ||
| S7 | Attitudes | [27,38,39,41,45] | 5 | ||
| S8 | Personal traits | [27,38,39,41,45] | 5 | ||
| S9 | Negative emotions | [48] | 1 | ||
| S10 | Dependence between the stakeholders | [46] | 1 | ||
| S11 | Unresolved disagreements | [41] | 1 | ||
| S12 | Lack of effective leadership | [51] | 1 | ||
| S13 | Lack of professionalism | [51] | 1 | ||
| S14 | Lack of competence | [51] | 1 | ||
| S15 | Diversity in knowledge | [5,27,46,47] | 4 | ||
| S16 | Culturally diverse team | [27,58] | 2 | ||
| S17 | Poor communication | [38,39,41,47,51,52,53,54,55,56,57] | 11 | ||
| S18 | Poor coordination | [51] | 1 | ||
| S19 | Delegation of responsibilities | [27] | 1 | ||
| S20 | Lack of meetings | [27] | 1 | ||
| Conflict Management Category | Code | Conflict Management Strategy | Reference | Frequency | |
|---|---|---|---|---|---|
| Technology | A1 | Incorporation of new technologies | [5,44] | 2 | 11 |
| A2 | Use of BIM | [27,44,51,61,63,64,85] | 7 | ||
| A3 | Blockchain technology | [55] | 1 | ||
| Finance | B1 | Adequate allocation of funds | [36,52,74] | 3 | 9 |
| B2 | Timely payments | [36,52,74] | 3 | ||
| B3 | Consider the operating and financing capabilities of the client | [46] | 1 | ||
| B4 | Implementation of payment systems | [51,71] | 2 | ||
| Project Scope | C1 | Develop a proper project scope | [36,74] | 2 | 6 |
| C2 | Realistic project schedule | [27] | 1 | ||
| C3 | Realistic goals | [27] | 1 | ||
| C4 | Monitor the timeline | [27] | 1 | ||
| C5 | Conduct feasibility studies | [27] | 1 | ||
| Contractual/Document | D1 | Include precise terms and conditions | [30,42,60,71] | 4 | 25 |
| D2 | Adopt suitable contracts | [86] | 1 | ||
| D3 | Prepare contingency plans | [32] | 1 | ||
| D4 | Establish clear regulations of resource allocation and task distribution | [27,30,36,46,71,74] | 6 | ||
| D5 | Adopt conventional designs | [46] | 1 | ||
| D6 | Adopt partnering | [33,35,36,46,87] | 5 | ||
| D7 | Mediation | [27,31,70] | 3 | ||
| D8 | Negotiation | [37,53,66] | 3 | ||
| D9 | Mutual agreements | [67] | 1 | ||
| Stakeholder | E1 | Effective and open communication | [27,46,49,50,69,70,71,72,73] | 9 | 80 |
| E2 | Trustworthy and quality communication | [30,36,40,73,74] | 5 | ||
| E3 | Implement proper communication protocols | [51,58] | 2 | ||
| E4 | Conduct training programs | [51,58,71] | 3 | ||
| E5 | Periodic meetings and reporting | [51,58] | 2 | ||
| E6 | Provide clear guidance on responsibilities | [51,58] | 2 | ||
| E7 | Foster a harmonious work environment | [46,71,75] | 3 | ||
| E8 | Foster a learning culture | [46,71,75] | 3 | ||
| E9 | Foster a conflict prevention culture | [78,79] | 2 | ||
| E10 | Build trust | [30,42,46,75,76,77] | 6 | ||
| E11 | Build equality | [30,42,76] | 3 | ||
| E12 | Build openness and communication | [46,75,77] | 3 | ||
| E13 | Build psychological safety | [46,75,77] | 3 | ||
| E14 | Build collaboration | [46,75,77] | 3 | ||
| E15 | Diverse background and experience of members | [58] | 1 | ||
| E16 | Understand and respect members | [58] | 1 | ||
| E17 | Familiarize with the attitude of members | [45] | 1 | ||
| E18 | Proper teamwork at personal level | [77] | 1 | ||
| E19 | Selecting same members | [27] | 1 | ||
| E20 | Make timely decisions and actions | [42] | 1 | ||
| E21 | Support from top management | [42] | 1 | ||
| E22 | Adoption of proper practices by project leaders | [73,80] | 2 | ||
| E23 | Proper stakeholder engagement and management | [54,80] | 2 | ||
| E24 | Awareness of project goals and share of responsibilities | [27] | 1 | ||
| E25 | Use of proper conflict management behaviors | [2,12,41,82,83] | 5 | ||
| E26 | Establish quality educational training for stakeholders | [51] | 1 | ||
| E27 | Engage qualified professionals | [46] | 2 | ||
| E28 | Adhere to strict quality control | [51] | 1 | ||
| E29 | Rewarding stakeholders for their skills | [51] | 1 | ||
| E30 | Effective dispute resolution methods | [51] | 1 | ||
| E31 | Consider the competency of contractor during tendering process | [46] | 1 | ||
| E32 | Improvements in conflict awareness | [27] | 1 | ||
| E33 | Enhance the skills of the design team | [27] | 1 | ||
| E34 | Appoint a project manager for design team | [27] | 1 | ||
| E35 | Provide training in political skills | [48] | 1 | ||
| E36 | Emotional intelligence of the project leaders | [84] | 1 | ||
| E37 | Develop team building skills | [40,54] | 2 | ||
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2026 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license.
Share and Cite
Senarath, N.B.; Udawatta, N.; Karunasena, G.; Shooshtarian, S. Stakeholder Conflicts in the Construction Industry: A Systematic Review of Three Decades. Buildings 2026, 16, 1229. https://doi.org/10.3390/buildings16061229
Senarath NB, Udawatta N, Karunasena G, Shooshtarian S. Stakeholder Conflicts in the Construction Industry: A Systematic Review of Three Decades. Buildings. 2026; 16(6):1229. https://doi.org/10.3390/buildings16061229
Chicago/Turabian StyleSenarath, Nilmi Bhagya, Nilupa Udawatta, Gayani Karunasena, and Salman Shooshtarian. 2026. "Stakeholder Conflicts in the Construction Industry: A Systematic Review of Three Decades" Buildings 16, no. 6: 1229. https://doi.org/10.3390/buildings16061229
APA StyleSenarath, N. B., Udawatta, N., Karunasena, G., & Shooshtarian, S. (2026). Stakeholder Conflicts in the Construction Industry: A Systematic Review of Three Decades. Buildings, 16(6), 1229. https://doi.org/10.3390/buildings16061229
