Dynamic Network Analysis of the Risks of Mega Infrastructure Projects from a Sustainable Development Perspective

1
School of Management Science and Real Estate, Chongqing University, Chongqing 400044, China
2
Faculty of Architecture and The Built Environment, Delft University of Technology, 2628BL Delft, The Netherlands
3
International Research Center Sustainable Built Environment, Chongqing University, Chongqing 400045, China
4
Construction Economics and Management Research Center, Chongqing University, Chongqing 400045, China
*
Author to whom correspondence should be addressed.
Buildings 2022, 12(4), 434; https://doi.org/10.3390/buildings12040434
Submission received: 18 February 2022 / Revised: 19 March 2022 / Accepted: 30 March 2022 / Published: 1 April 2022
(This article belongs to the Special Issue Construction Scheduling, Quality and Risk Management)

Abstract

:
Mega infrastructure projects (MIPs) are exposed to numerous interdependent risks of various natures which pose difficulties in risk management. Thus far, the research on the risk interactions of MIPs has been focused on developing static risk networks within a single category of risks, at certain stages of the project. It is essential to understand the risk interactions at various stages of MIPs to identify the key risks and key risk relationships that jeopardise their success. This is especially relevant nowadays, as MIPs are expected to be delivered sustainably. Therefore, to analyse the dynamic risk interaction of MIPs, initially, through literature analysis and expert interviews, combined with the four dimensions of sustainable development and the four stages of MIPs, 98 risk factors of MIPs were identified. Subsequently, semi-structured interviews were conducted to determine risk relationships and weights. Risk networks were developed for each stage of MIPs, and improved social network analysis was applied to these risk networks. Finally, the key risks and key risk relationships in each stage of MIPs were identified by analysing the changes of multi-level network indicators. This aided in determining risk control strategies. The results demonstrate that the key risks and key risk relationships are different for each stage of MIPs. Furthermore, the risks of different dimensions of sustainable development have different relationships at different stages. This research is the first to identify the risk relationships involved in MIPs by taking into consideration the whole project life cycle and its sustainable development. This research provides theoretical support for the risk management of MIPs, and strategic suggestions for controlling the risks at each stage of the project.

1. Introduction

Mega infrastructure projects (MIPs) refer to large-scale public engineering projects with funds exceeding USD 1 billion, usually commissioned by the government and delivered by capable private contractors and suppliers, which provide basic public services for social production and residents’ lives [1]. MIPs are usually in the transportation, water conservation, telecommunication, power generation, and other such sectors that significantly affect national politics, economy, national security, public health, environmental protection, and society [2]. In contrast with small or medium-sized infrastructure projects, MIPs have a larger investment scale, longer implementation period, complex uncertain factors, and numerous stakeholders [3]. MIPs involve many potential risks, which are multidimensional and interrelated [4]. Risk interaction may lead to abnormal risk propagation, due to which the occurrence probability and negative impacts of risks are amplified, significantly jeopardizing the project objectives [5]. Failure to adequately analyse these complex relationships results in poor risk assessments, ineffective risk mitigation initiatives and strategies [6]. Therefore, it is important to explore the interaction of risks to ensure the successful risk management of MIPs.
Many scholars agree that considering risk interactions is crucial when studying risk management for MIPs, and have carried out a series of relevant studies [4,7,8]. For example, Chang et al. determined the interrelationship between political risk factors for international high-speed rail projects, to enable international contractors to better understand the political risks of projects [9]. Lu and Zhang identified the key safety risk factors during the construction stage of subways and drew relationships between the subway construction safety risk factors, which are conducive to reasonable risk management by the government and managers [10]. Chen et al. examined the diversity and interdependence of construction schedule risks and generated more reliable risk identification and risk inferences [11]. Etemadinia and Tavakolan analysed the risks and risks relationships in the design stage of construction projects and identified the key risks that have a greater impact on project goals [12]. While research on risk interactions has received some attention, most studies have focused on the development of static risk networks that only consider certain phases of MIPs and a single category of risk factors.
However, few studies have examined the dynamics of risk interactions over the life cycle of MIP, and considered risk interactions among different categories. The risks of MIPs dynamically evolve throughout the project life cycle, with not only changes in the risk factors at each stage, but also in the means and intensity of interactions between risks [13]. When the risk interaction changes drastically, the accuracy of the static risk network analysis decreases, underestimating the importance of some nodes. This is because in a static network, important nodes at a certain time seem to be less important [14]. Furthermore, the effectiveness of risk control strategies proposed for key risks is greatly reduced. Therefore, it is necessary to transform the aggregated static risk network into a dynamic analysis of the risk network in different stages to determine the key risks.
Moreover, MIPs involve a variety of risks, including not only cost, schedule, and quality risks, but also social, economic and environmental risks associated with the project [1]. Hence, it is imperative that sustainable development is addressed as a core issue in MIPs risk management. To achieve sustainable project delivery, economic losses, environmental issues, and social disputes cannot be handled separately [15]. For example, large-scale hydropower infrastructure projects reduce energy consumption and bring huge economic benefits. However, some of these projects have caused serious environmental degradation and ecological disasters. This has intensified confrontations between the public, enterprises, and the government. Tao et al. argue that the interrelationship between different risk categories increases the complexity of the risk system [16]. Hence, it is necessary and challenging to integrate multiple dimensions of sustainable development to conduct MIPs risk interaction research.
This study aims to analyse the dynamic changes of risk interaction from different dimensions of sustainable development and different stages of the life cycle of MIPs. It expands the research perspective of MIPs risk interaction and makes up for the lack of consideration given to the dynamic characteristics and complexity of risks in the literature. This study uses the improved social network analysis (SNA) to calculate and analyse the dynamic changes in the multi-level network indicators for the established multi-stage risk network, and determine the key risks and risk relationships at each stage. This can help stakeholders develop risk response strategies to significantly reduce the complexity of risk networks to prevent or minimize adverse impacts and create more stable and sustainable projects.
Following this analysis in Section 1, the remainder of this paper is organised as follows: a brief overview of the relevant literature is presented in Section 2, and Section 3 describes the research process, lists the risks, and proposes an improved SNA approach. The results of the dynamic network analysis are presented in Section 4. The proposed risk management strategies and the risk network simulation are presented in Section 5, and the conclusion with future research suggestions in Section 6.

2. Literature Review

2.1. Risks of MIPs

The Project Management Institution defines risk as an uncertain event or condition, and the occurrence of risks will have a positive or negative effect on project goals [17]. Most of the existing studies on MIPs’ risks constrain the project objectives to cost, schedule, and quality [18]. Thamhain believes that it is necessary to manage MIPs to exceed a simple analysis of costs and schedules and try to understand the real cause of any uncertainty [19]. Sustainable development makes project risk management abandon the traditional goals (cost, schedule, and quality), and it is particularly crucial for construction projects [20]. Some scholars have studied the risks of MIPs from a sustainable development perspective, but most of the research only considered a single dimension of sustainable development. Yuan et al. used a questionnaire survey to determine the social risks of the transportation public–private partnership project, and proposed corresponding risk control measures to cope with negative social effects [21]. Malik et al. collected data from 156 different construction companies to study the link between environmental issues and project performance to reduce environmental risks [22]. There is no overall analysis of risks in all sustainable development dimensions.
In practice, balancing the three pillars of sustainable development is necessary [21]. Some studies assessing the sustainability performance of infrastructure have proposed other dimensions, such as transformational change and political system dimension [23], or integrated managerial infrastructure sustainability [24]. Some international organisations published regional infrastructure sustainability rating systems and considered additional dimensions, including the ‘IS Rating’ program initiated by the Infrastructure Sustainability Council of Australia [25], the Envision system organised by the Institute for Sustainable Infrastructure [26], and the institutional dimension proposed by the Inter-American Development Bank [27]. However, the importance of balancing the iron triangle of sustainable development has been underestimated in risk management research on MIPs [28]. Li et al. emphasised that coordinating the relationship between stakeholders and unifying their motives, goals, attitudes, and actions can avoid unnecessary disputes, thereby synergistically promoting the sustainability of the project in three aspects [29]. Therefore, when conducting risk management research on the sustainable development of MIPs, it is crucial to include the coordination dimension to examine the potential risks that may lead to an imbalance in the three pillars.
This article draws on Li et al. definition of MIPs’ risks from a sustainable development perspective [29]. That is, the risks of MIPs are factors that have a negative effect on the achievement of the goals of economic sustainability, social sustainability, environmental sustainability, and the coordination sustainability of projects.

2.2. Analysis of MIPs’ Risk Relationship

Over the past decade, different methods of analysing risk relationships for MIPs have been proposed and investigated, such as the Monte Carlo simulation [11], analytic network process [30], structural equation modelling [9], interpretative structural modelling [12], fuzzy analytic network process [31], fuzzy interpretive structural modelling [32], Bayesian belief network [33], and SNA [5]. Compared with the above methods, SNA is more suitable for representing the risk relationship network. It can check and determine risk interrelationships, visualise the structure of risk relationships, and use the network characteristics of nodes and links to quantify the risks and the risk relationship [34].
Although SNA has been widely used to study the risk relationship of MIPs [5,35,36], limitations still exist. An increasing number of SNA applications have calculated indicators based on link weight, but there are few studies that consider both the link weight and number. Most scholars have realised that the relationship between risks may be different in strength, so they assign different weights to links in the risk network [35]. However, for some network indicators such as degree and betweenness centrality, a calculation using only the weight or number of links cannot accurately reflect the true importance of the risk or the risk relationships [37]. Therefore, SNA indicators can be improved by determining the weighted value of the total weight of, and the number of, risk links.
In summary, through a literature review, it was found that the trend of papers within the subject area has shifted from traditional risk studies to risk studies integrating sustainable development goals, and finally, to risk relationship studies. Nevertheless, there are still some limitations that hinder risk prediction. According to the improved SNA, this study solves the complex dynamics of MIP risks and provides new opportunities for the risk management of MIPs.

3. Methods and Data

3.1. Research Process

The purpose of this study is to conduct a dynamic, quantitative, and visual understanding of the risk interrelationships at different stages of MIPs, and to formulate a reasonable and effective risk response strategy for the project. The research framework includes four steps: (1) risk identification of MIPs at each stage through a literature review and semi-structured interviews; (2) risk interaction relationship quantification and risk network establishment through a literature review and expert interviews; (3) risk network analysis in the life cycle of MIPs through improved SNA; and (4) formulation of risk mitigation strategies. The research framework is illustrated in Figure 1.

3.2. Step 1: Identify MIPs’ Risks

First, the literature relevant to the study was selected based on two principles, namely, (1) publications focused on the sustainable development of MIPs, and (2) publications must be accessible to a wide international audience. These two principles were used for avoiding articles that focussed only on specific areas. The keywords used to search for the literature included ‘mega infrastructure project’, ‘sustainable development’, and ‘mega infrastructure project risk’. The search yielded 34 key publications. The Nvivo software package (QSR International, Burlington, MA, USA) was used to analyse the content of the publications to identify the risks encountered throughout the lifecycles of MIPs. The content analysis involved three processes, namely, (1) the open code process that identified 103 risks and 127 initial sentences related to the sustainable development of MIPs, (2) classification of the above items under four identified dimensions and four stages, and (3) summarising and comparing the risks and sentences and combining those with similar meaning to reduce the number of risks in the list to 96.
Second, to refine the preliminary list of risks to ensure that all risks are reasonable and understandable, thirteen experts were invited to be interviewed through phone calls or via email. Of these, eight experts were consented to be interviewed. Despite the small sample size, the findings are important, as these experts hold senior positions in their respective organizations and have an average of 14,375 years of practical or research experience in the MIP field (Table 1). Therefore, these experts were able to provide insights that offered meaningful contributions.
Furthermore, the experts have rich work experience and knowledge covering the life cycles of MIPs: a government officer from Chongqing Commission of Housing and Urban-Rural Development participated in the decision-making, construction, and operation stages of multiple MIPs; a designer from China Southwest Architectural Design and Research Institute has served as the chief designer of an MIP; two construction contractors from China State Construction International Investments Limited, one of whom has worked with a consulting company, a design company, and a contractor company, participating in the design, construction, and operation stages of MIPs; an operator from Hong Kong-Zhuhai-Macao Bridge Authority participated in the construction, operation, and maintenance of the main part of the bridge; three university professors have research experience on the risk management process encompassing the complete life cycle of MIPs. Such expansive experience assures the reliability of the experts’ feedback for the study.
The experts were interviewed between 14 July 2021 and 23 August 2021 and their voices were recorded. The interviewees were asked three main questions: (1) Is the preliminary risks list complete? Is there anything more to add? (2) Are the risks correctly classified by the stages of MIPs and dimensions of risks? (3) Is the risk description ambiguous? The interviews resulted in the following revisions: (1) added one risk (‘delayed approval’) under the decision-making stage and two risks (‘difficult financing’ and ‘designing cost overrun’) under the design stage; (2) one risk (‘seawater corrosion’) was removed because seawater corrosion is not a common problem for all MIPs; and (3) according to engineering terminology, experts suggested that we change the nomenclature ‘labour, materials, and equipment cost overruns’ to ‘construction and installation cost overruns’. The final list of risks is presented in Table 2.

3.3. Step 2: Establish Risk Network

The essential purpose of determining the risk network at each stage was to obtain the data on risk relationships. For this, two steps were taken. The first was to determine if a relationship between a pair of risks existed. The dualism, in this case, is expressed as, if risk i leads to the occurrence of risk j, the risk link a i , j equals 1, otherwise 0. On 2 September 2021, eight experts attended a brainstorming meeting to determine the relationships among the risks in the list of risks. In the first round of brainstorming, the eight experts gave their evaluations anonymously. In the second round, all experts met to discuss the risk relationships wherein their opinions differed and conducted a second risk relationship data evaluation. For this evaluation, it was decided that for a risk relationship to be accepted, it must have the acceptance of no fewer than five out of the eight experts. In the third round, if the evaluation results reached by the experts closely resembled the results obtained in the previous round, the brainstorming session was closed as the final binary directed adjacency risk matrix (BDARM, Equation (1)) was established.
B D A R M = a i , j
Next, the weight ( w i , j ,) for the risk interaction relationship ( a i , j ) was determined to be 1. A Likert scale was used to quantify weights as follows: insignificant (1), mild (2), moderate (3), significant (4), and severe (5). On 7 September 2021, to determine the weight of risk interaction relationships, an independent validation focus group of the previous eight experts was formed. In the first round, the experts assessed the weight of risk interaction relationships anonymously. In the second round, the experts discussed the weights of risk interaction relationships and reached the preliminary evaluation results, and revisions were made. For example, in the design stage, three experts thought opaque project information (closed design information) had a weak effect (less than three) regarding bribery and corruption as a threat to the implementation of MIP. However, other experts described their experiences to assert that the risk link should be stronger. Therefore, the weightage of the link was unanimously raised to 4. At the end of the multi-round feedback, all experts agreed upon the effects of all risk links, and the final Weighted Risk Matrix (WRM; Equation (2)) was developed.
W R M = w i , j
The input node code and edge data were entered into Gephi network analysis software. The above 98 risks and quantitative risk interaction relationships were modelled into four visual risk networks that covered the entire project lifecycle.

3.4. Step 3: Network Analysis

To find the law of MIPs’ risk interaction evolution and formulate corresponding risk mitigation strategies, the following aspects of risk networks were analysed—the change of the network level, node/line level, group-level network metrics including network density (ND), node degree (NDE), the ratio of reachability to geo-distance (RRGD), node betweenness centrality (NBC), link betweenness centrality (LBC), direct inter-group interaction (DIGI), and global inter-group interaction (GIGI). Opsahl et al. indicated that the number and weights of risk links need to be considered together, and accomplished this focus using tuning parameter α [37]. To balance the number and weights of risk links, Wang et al. suggested that α be set to 0.5 [38]. Based on the above studies, Table 3 gives the improved formulae of these network metrics.
The seven metrics reflect the key risks and links in the risk network at each stage of a MIP. Network density indicates the overall network connectivity, calculated by the proportion of existing links to the maximum number of possible links. It lies between 0 and 1. NDE has two metrics—out-degree and in-degree. The out-degree indicates the direct effect of a node on its neighbouring nodes; the in-degree indicates the direct effect of a neighbouring node on a selected node. NBC or LBC represents the power of risk or a link’s control over the network as an intermediary. RRGD has two metrics: the RRGD-Out and RRGD-In. The RRGD-Out value represents the global impact of a risk on the network as a source, and is the sum of the reciprocal of reachability and geo-distance from risk i to another risk. The RRGD-In value represents the global impact of another risk on the source risk, and is the sum of reciprocal of reachability and geo-distance from another risk to risk i. Direct inter-group interaction (DIGI) reflects the direct effect of one risk group on another and is the number of links originating from group n to group m. Global inter-group interaction (GIGI) reflects the global effect of one risk group on another, and is the sum of links originating from the reciprocal of reachability and geo-distance from group n to group m.

4. Results

4.1. Network Level Results

The risk network in the decision-making stage is connected by 17 risk nodes through 191 links; the design stage includes 20 risk nodes and 266 risk links, the construction stage includes 37 risk nodes and 644 risk links; the operation stage includes 24 risk nodes and 292 risk links. The four risk networks are visualised in Figure 2, where the colour and shape of the nodes represent the risk dimensions and project stages, respectively. For example, EC1R4→SO1R2 indicates that EC1R4 has an effect on SO1R2. Risk nodes with more risk links are located more centrally in the network, whereas risk nodes with fewer risk links are placed closer to the boundary of the network. At the decision-making stage, a large area of blue nodes occupies the centre of the network map, indicating that a large number of risks in this stage are linked to social risks. In the design stage, a large area of orange risk nodes occupies the centre of the risk network, indicating that interactions with coordination risks account for most of the existing links. In the construction stage, a large number of red and orange nodes are in the centre of the risk network, indicating that economic risk and coordination risk play the most important roles in the risk network. In the operation stage, orange nodes occupy the centre of the network map, indicating that coordination risks play the most important role in the risk network.
The density of a risk network reflects its complexity. A higher network density means greater and stronger risk links in the network, which implies that managers face more challenges in risk management [36]. Figure 2 shows the network density in the four stages of the MIPs. The network densities of the decision-making, design, construction, and operation stages are 0.2964, 0.2852, 0.1816, and 0.1986, respectively. First, compared with the overall risk network density (0.0308) of MIPs calculated by Fang et al. [4], the density at each stage of this study was relatively high, indicating a stronger risk interaction relationship and more complex risk network at each stage.
Second, the network density changes with the progress of MIPs, with a maximum in the decision-making stage and a minimum in the construction stage. This may be because, in the early stage, MIPs have relatively high uncertainty and involve fewer stakeholders, and risks spread faster among these few and close stakeholders. Although the construction stage has the most risk nodes and relatively few direct risk interaction relationships, all risks can be linked by indirect risk interaction relationships, which means that risk management in the construction stage is very complicated.

4.2. Node Level Results

4.2.1. NDE

The node degree reflects the degree of the relationship of the risk node with its direct neighbours in the network. Risks with low in-degree and high out-degree values may be source risks and have a greater direct effect on other risks. Risks with high in-degree and low out-degree values are regarded as cumulative risks because they have various sources and are more sensitive to the occurrence of other risks [4]. In this study, the top 40% of risk nodes at each stage sorted by in-degree are selected as in-degree key risks because 40% of the risk nodes have a larger in-degree than the mean of all in-degrees (21.4391). Similarly, the top 50% of the risk nodes at each stage sorted by out-degree are selected as out-degree key risks. Table 4 presents the in-degree and out-degree key risks at each stage.
At the decision-making stage, EC1R5 (delay in project approval) has the highest in-degree (25.6125); CO1R2 (decision-making mechanisms not involving all stakeholders) has the highest out-degree (30.5778). There are seven in-degree key risks, four of which are social risks. There are nine out-degree key risks, including six social risks. This demonstrates that, at the decision-making stage, social risks are not only susceptible to other risks, but can also affect other risks, that is, key hub risks, which are consistent with the results of network visualisation.
In the design stage, EC2R2 (misestimate in time and cost) has the highest in-degree, arriving by 29.6648; SO2R5 (opaque project information) has the highest out-degree, arriving by 33.1663. There are eight in-degree key risks, where economic risks account for five. There are six coordination risks and four social risks among the ten out-degree key risks. In the design stage, economic risks are more sensitive to other risks, and coordination risks are likely to have a greater effect on other risks.
In the construction stage, the highest in-degree (EC3R1, construction and installation cost overruns) was 51.4975, and the highest out-degree (CO3R3, weak sustainability awareness) was 64.0859. Among fifteen in-degree key risks, there are nine social risks. There are ten environmental risks out of nineteen out-degree key risks. At the construction stage, a large number of social risks are more likely to be directly affected by predecessors. In contrast, some environmental risks have a direct effect on successors.
At the operation stage, SO4R8 (negative impact on residents’ life quality) and CO4R4 (weak monitor and maintenance platform of project sustainability) have the highest in-degree (35.7211) and the highest out-degree (36.5240), respectively. There are five social risks and four economic risks in ten in-degree key risks. Meanwhile, environmental risks and coordination risks account for six and four of the twelve out-degree key risks. At the operation stage, social and economic risks are more likely to be affected by other risks, and environmental and coordination risks are more likely to affect other risks.

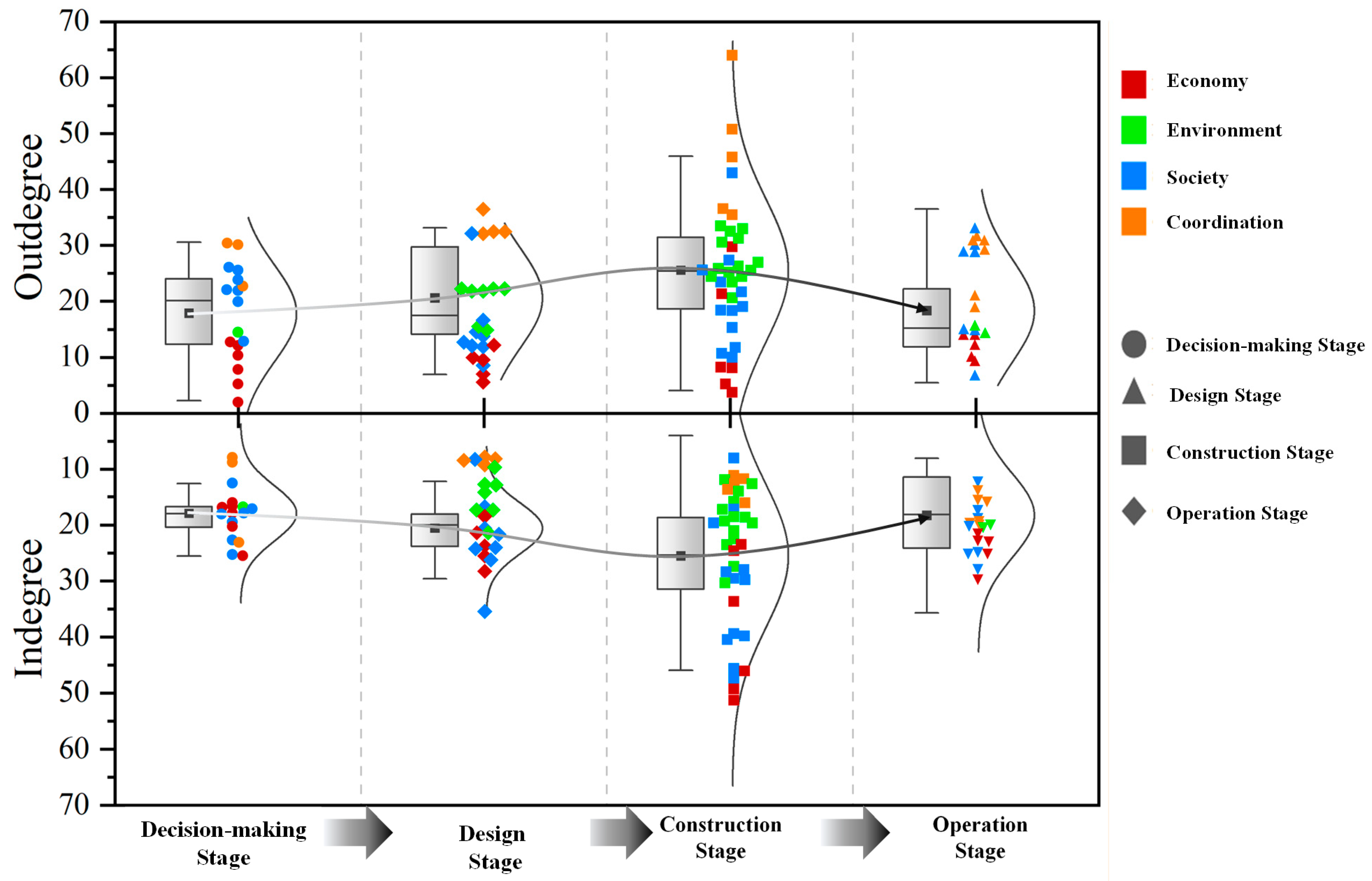

Figure 3 shows a scatter plot of the out-degree and in-degree of 98 risk nodes in the MIPs’ life cycle, and certain evolution trends are observed as the MIP progresses. First, in general, the average out-degree and in-degree of MIPs rise and then decline. The maximum out-degree (CO3R3; 64.0859) and in-degree (EC3R1; 51.4976) values of all risk nodes appear at the construction stage, indicating that the construction stage node degree is heterogeneously distributed in the network, and most risk nodes tend to be connected to a limited number of nodes.
Second, the distribution of out-degree and in-degree of risk nodes of each dimension shows opposite trends in terms of importance. For example, in the four stages, economic risk has the lowest out-degree and the highest in-degree. This is consistent with the fact that, to offset the losses caused by the risks of other dimensions of sustainable development, MIPs usually need to pay greater economic costs, such as environmental restoration costs [39], construction delay costs, and resettlement compensation costs. Therefore, equal and comprehensive attention to the risks of the four sustainable development dimensions of MIPs is of great significance for reducing MIP costs.

4.2.2. RRGD

Unlike the node degree, which reflects the degree of relationship of the risk node with its direct neighbours in the network, RRGD reflects the global interactive relationship amongst risks in the network [38]. In this study, the top 40% of risk nodes at each stage sorted by RRGD-In were selected as RRGD-In key risks because 40% of the risk nodes have a larger RRGD-In than the mean of all RRGD-In (26.8024). Similarly, the top 45% of risk nodes at each stage sorted by RRGD-Out are selected as RRGD-Out key risks. Table 5 represents the RRGD-In key risks and RRGD-Out key risks at each stage.
At the decision-making stage, SO1R5 (opportunism decision making) has the highest RRGD-In (23.5597); CO1R3 (weak and opaque decision-making process) has the highest out-degree, arriving by 30.5778. There are seven RRGD-In key risks, including three social risks and three economic risks. There are seven RRGD-Out key risks, four of which are social risks, and three of which are coordination risks. This indicates that, although direct interaction relationships play a leading role in the whole risk network, there is a certain degree of indirect influence—economic risk and coordination risks may indirectly affect social risk.
At the design stage, EC2R2 had the highest RRGD-In, arriving by 26.8024; SO2R5 had the highest RRGD-Out, arriving by 30.1489. Economic risks account for four of the eight RRGD-In key risks. There are five coordination risks and four social risks among nine RRGD-Out key risks. The above results indicate that the risk with a higher direct effect may have a higher global effect. For example, EC2R2 and SO2R5 have the largest node degrees and RRGD in the design stage.
In the construction stage, the highest RRGD-In (EC3R6: compensate for not meeting the Sustainable Development Goals) was 51.4976, and the highest RRGD-out (CO3R3) was 60.8803. Among the fifteen RRGD-In key risks, there are nine social risks. Environmental risks account for nine of the seventeen RRGD-Out key risks. At the construction stage, a large number of social risks are more likely to be directly and indirectly affected by predecessors. On the contrary, a large number of environmental risks have a direct and indirect effect on successors.
At the operation stage, SO4R8 and CO4R4 have the highest RRGD-In value (33.7081) and the highest RRGD-Out value (34.2699), respectively. Five and four of the ten RRGD-In key risks are social risks and economic risks. Meanwhile, environmental risks and coordination risks account for five and four of eleven RRGD-Out key risks.

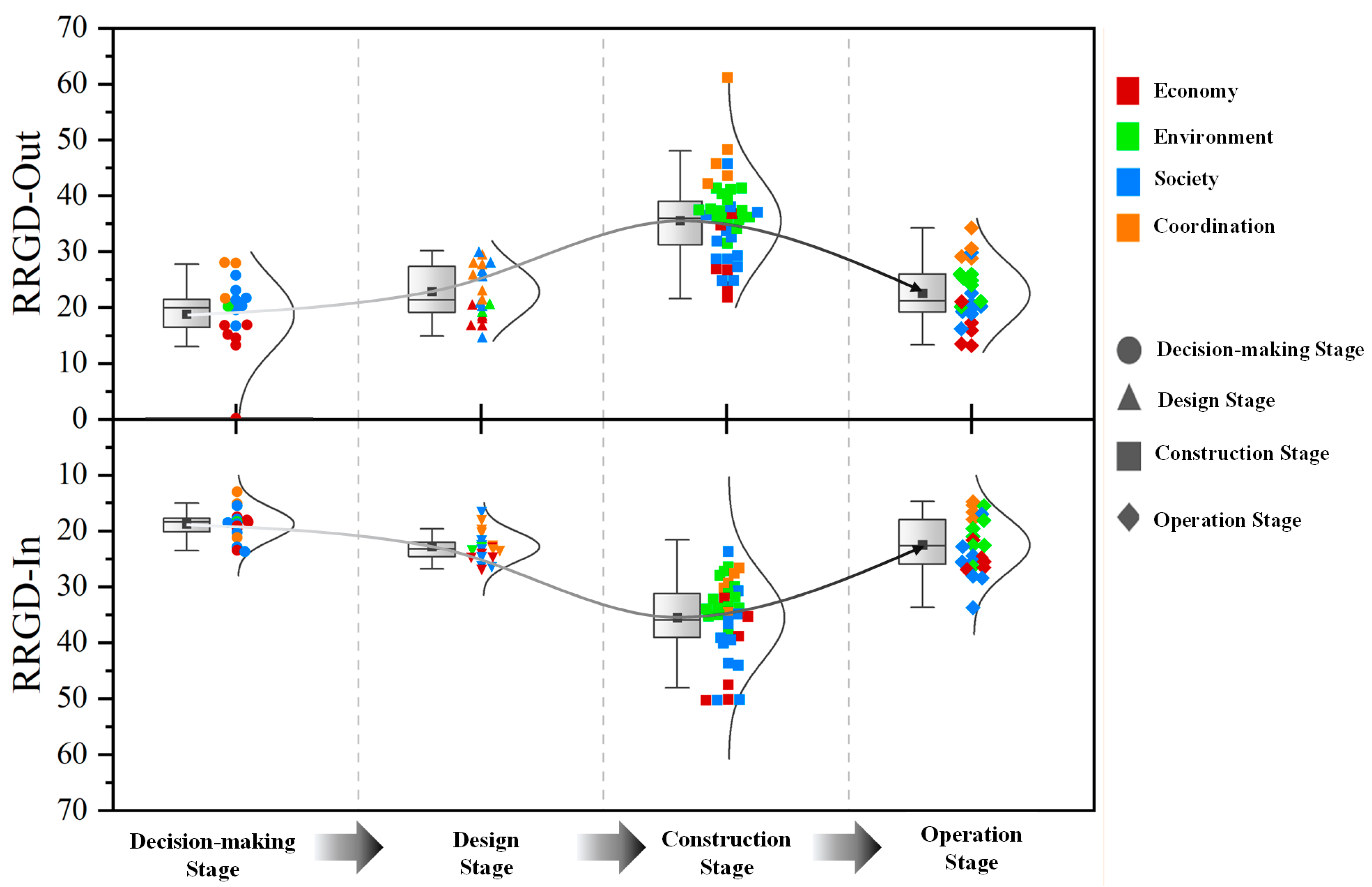

Figure 4 shows the evolution trend of RRGD-In and RRGD-Out with the life cycle of MIPs. In general, RRGD-Out and RRGD-In have similar change trends and increase after reaching a maximum in the construction stage. From the view of dimensions, RRGD-Out and RRGD-In of environmental and social risks both increase first and then decrease, reaching a peak in the construction stage, which is twice that of the other stages. This shows that environmental and social dimension risks play an important role in global source risk and global cumulative risk in the construction stage, because most of the nodes are linked to the risks of these two dimensions. The RRGD-Out of economic risk undergoes a small change in the whole life cycle, and the RRGD-In of economic risk is significantly higher at the construction stage. In contrast, the RRGD-In of coordination risk undergoes a small change in the whole life cycle, and the RRGD-Out of coordination risk is significantly higher at the construction stage.

4.2.3. NBC

Node betweenness centrality indicates the intermediary role that nodes play in bonding the various parts of the network. The higher the node betweenness centrality, the greater the control over the interaction relationships flowing through the network. In this study, the top 25% of the risks ranked by node betweenness centrality in each stage were selected as betweenness centrality key risks, because 25% of the risk nodes have higher betweenness centrality than the mean of all betweenness centrality (0.0226). Table 6 shows the betweenness centrality key risks for each stage.
In the decision-making stage, SO1R4 (bribery and corruption) had the highest betweenness centrality (0.0833) and played a powerful hub role in the MIP risk network. There are three social risks and one coordination risk among the four betweenness centrality key risks. In other words, in the decision-making stage, the risks with large hub roles are social risks.
In the design stage, SO2R7 (bribery and corruption) had the highest betweenness centrality (0.1287). There are two coordination risks, two economic risks, and one social risk among the five betweenness centrality key risks, which play a large hub role in the design stage.
In the construction stage, the highest betweenness centrality (SO3R2, bribery and corruption) was 0.1970. Coordination risks, environmental risks, and economic risk accounted for four, two, and one of the seven betweenness centrality key risks, respectively. This indicates that the risks with a large hub role are social risks.
In the operation stage, SO4R4 (damages on participation of local residents and community) has the highest betweenness centrality (0.3864). The ten betweenness centrality key risk nodes include three social risks and three economic risks. This indicates that the risks with a large hub role are social and economic risks.

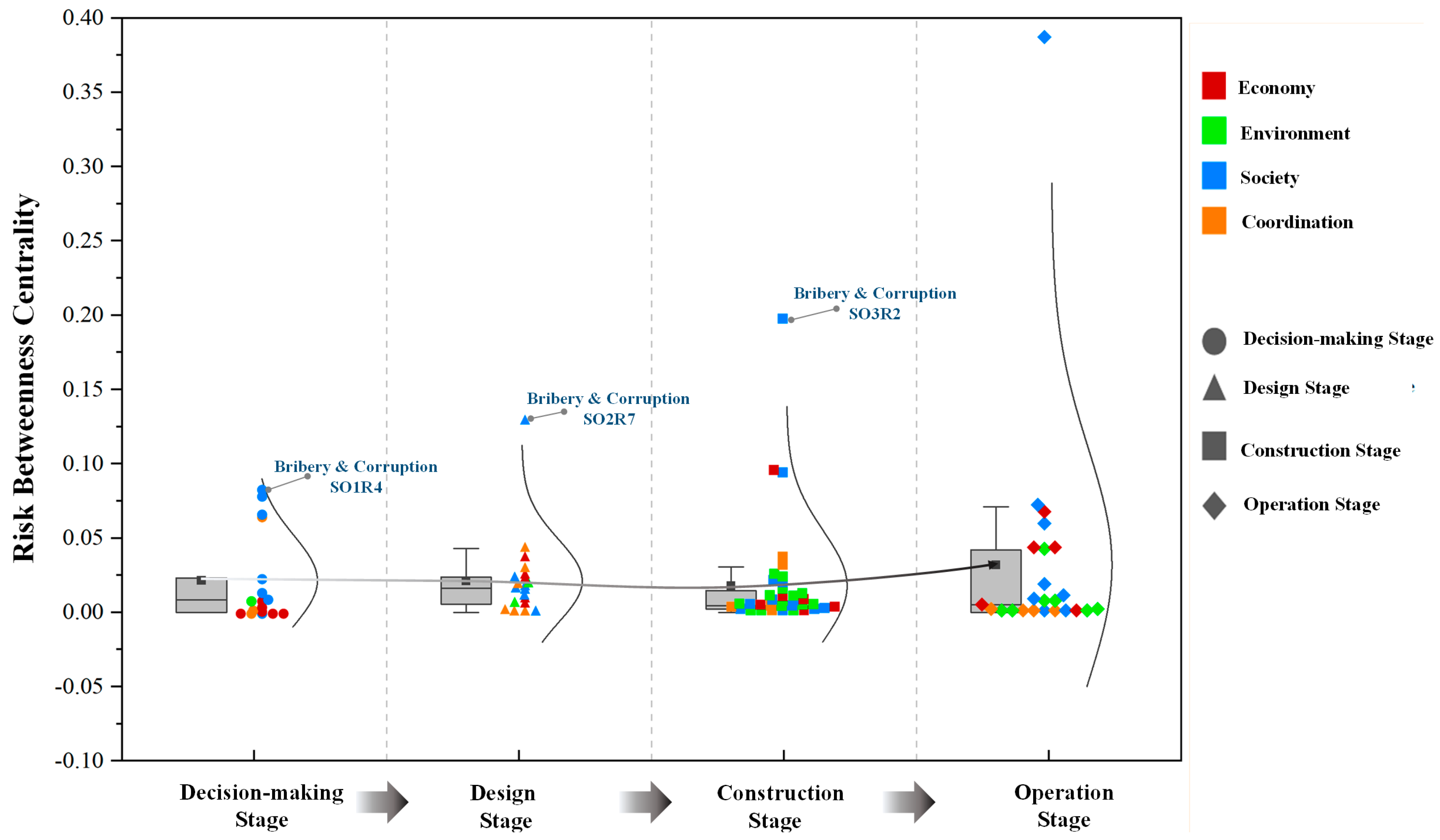

Figure 5 reflects the changing trend of node betweenness centrality with the MIPs’ life cycle. First, ‘bribery and corruption’ has the highest betweenness centrality value in the decision-making stage, design stage, and construction stage of MIPs, and it gradually increases. This shows that multiple nodes are directly linked by this risk node, which plays an important role in global risk propagation. If ‘bribery and corruption’ are not controlled at the beginning of MIPs, they will pose greater consequences as MIPs progresses. This result is in line with practice; many scandals can be found in MIPs. In the project approval, bidding, and construction stage, bribery and corruption often occur, which not only lead to serious quality problems and safety incidents, but also cause public complaints and severely harm government image and credibility [40].
Second, from the overall trend, the betweenness centrality of risks shows a slight downward trend, and when it reaches the operational stage, there is an obvious rebound. From the view of dimensions, social risks always occupy relatively important hub roles in the risk network of MIPs, and their betweenness centrality maintains an upward trend. The changing trend in betweenness centrality of economic risks is similar to that of social risks. The betweenness centrality of coordination risks shows an inverted U-shaped change trend, and its value in the design stage and construction stage is higher than that in the decision-making stage and operation stage. The betweenness centrality of environmental risks is relatively stable. The high betweenness centrality risk should be treated with caution, because by controlling these risks, the link can be cut off, thereby reducing the actual loss of MIPs caused by the risk interaction.

4.3. Link Level Results

Link betweenness centrality is a typical indicator for identifying key links [8]. It helps identify the hub links in the network that play the role of the key channels for risk transmission. Risk managers can prevent risk interaction by controlling these risk links. In this study, the top 25% of risk links at each stage are sorted by link betweenness centrality. These links are selected as key risk links because 25% of them have a larger link betweenness centrality than the mean of all link betweenness centrality values (0.0043). Table 7 ranks the top ten key risk links in each stage by link betweenness centrality.
There are 47 key risk links in the decision-making stage, the top three links ranked by link betweenness centrality value include EC1R4—SO1R2 (0.0625; costs caused by disputes with the community—damages on participation of local residents and community), EC1R1—SO1R5 (0.0349; wrong market demand forecasts [overrate]—opportunism decision making), and SO1R4—CO1R2 (0.0331; bribery and corruption—decision-making mechanisms not involving all stakeholders)
There are 66 key risk links in the design stage, the top three links ranked by link betweenness centrality value include EC2R4—SO2R7 (0.0390; land acquisition and resettling cost overruns—bribery and corruption), SO2R3—EC2R3 (0.0342; no access of the disabled—design deficiency), and EN2R2—CO2R3 (0.0303; non-matching with natural environment—lack of sustainable clauses in contract).
The construction stage consists of 161 key risk links, the top three links ranked by link betweenness centrality value include SO3R12—CO3R1 (0.0436; discoordination between contractor and public—inadequate communication and coordination among stakeholders), EC3R1—SO3R2 (0.0293; construction and installation cost overruns—bribery and corruption), and SO3R12—CO3R3 (0.0271; discoordination between contractor and public—weak sustainability awareness).
The operation stage consists of 73 key risk links, the top three links ranked by link betweenness centrality value include SO4R2—SO4R4 (0.0915; damages on residents’ health—damages on participation of local residents and community), EC4R2—SO4R4 (0.0734; devaluation of residents’ assets [decrease in residents’ income]—damages on participation of local residents and community), and EC4R4—EC4R2 (0.0589; weak solvency ability—devaluation of residents’ assets [decrease in residents’ income]).

The broken line in Figure 6 shows the changing trend of the average link betweenness centrality, and the heatmap reflects the average link betweenness centrality between dimensions. From a global perspective, the decision-making stage has the highest average link betweenness centrality, which indicates that the limited risk links in the decision-making stage become the common propagation path of many other risk nodes in the network. With the progress of MIPs, link betweenness centrality shows a U-shaped change trend and reaches a trough value (0.0025) in the construction stage. From the perspective of dimensions, the risk links from economic risks to social risks have the largest average betweenness centrality in the decision-making stage, and always remain in the top three positions in the entire life cycle of MIPs. In the design stage, the risk links from environmental risks to coordination risks have the largest average betweenness centrality. In the construction and operation stages, the risk links from social risks to coordination risks have the largest average betweenness centrality.

4.4. Risk Groups Results

4.4.1. DIGI

In this study, the risks of MIPs include four dimensions: economy, society, environment, and coordination. By calculating direct inter-group interactions, the direct interaction between dimensions can be identified, which can help risk managers communicate with each other to improve coordinated decision-making [4]. Figure 7 shows the direct inter-group interaction of the risk network in the four MIP stages.
In the decision-making stage, the largest direct inter-group interaction is from social risks to economic risks (52.3068), followed by coordination risks to social risks (36.6606), and then by coordination risks to economic risks (27.8209). The results show that social risks, economic risks, and coordination risks are closely related, whereas environmental risks seem to be relatively isolated. This may be because the environmental impact of a project is not exposed during the planning and start-up stages, and the project participants do not consider its environmental risks. However, the insufficient environmental impact assessment (EIA) in the initial stage leads to mistakes in decision-making, which leads to a large number of environmental risks in the construction and operation phases of the project. For example, if a highway is planned to be constructed in an international wetland reserve, until the project construction and operation stages begin, the wetland will be damaged and the surrounding residents will be affected by noise, air pollution, and other environmental impacts.
In the design stage, the largest direct inter-group interaction is from coordination risks to social risks (52.1950), followed by social risks to economic risks (47.8957) and coordination risks to economic risks (37.4166). The results show that economic risks are directly affected by social and coordination risks. Therefore, project managers should pay attention to social risks and coordination risks in the early stages of MIPs if they want to reduce project costs and control economic risk.
In the construction stage, the largest direct inter-group interaction is from environmental risks to social risks (143.1887), followed by environmental risks to economic risks (91.2140), and coordination risks to environmental risks (77.7689). The results show that the risks of the four dimensions are closely related, indicating that the risk relationship in this dimension is relatively complex. Environmental risks become important hub risks for economic and coordination dimension risks.
In the operation stage, the largest direct inter-group interaction is from environmental risks to social risks (48.5386), followed by coordination risks to environmental risks (43.3128) and environmental risks to economic risks (40.6571). The results show that environmental risks are closely related to risks of all dimensions, which is consistent with Dadpour et al., where environmental risk plays a key role in generating propagation effects and increasing the complexity of the risk network [41].
In summary, the above results indicate that, in the early stages of MIPs, economic, social, and environmental risks are closely related, and environmental risks are relatively isolated. After entering the construction stage, environmental risks become closely related to the risks associated with other dimensions. Environmental problems may lead to serious social problems, and may also aggravate economic risks. Meanwhile, coordination problems may cause environmental deterioration, forming a vicious circle [41]. Therefore, there is a complex interaction between the risks of the four dimensions.

4.4.2. GIGI

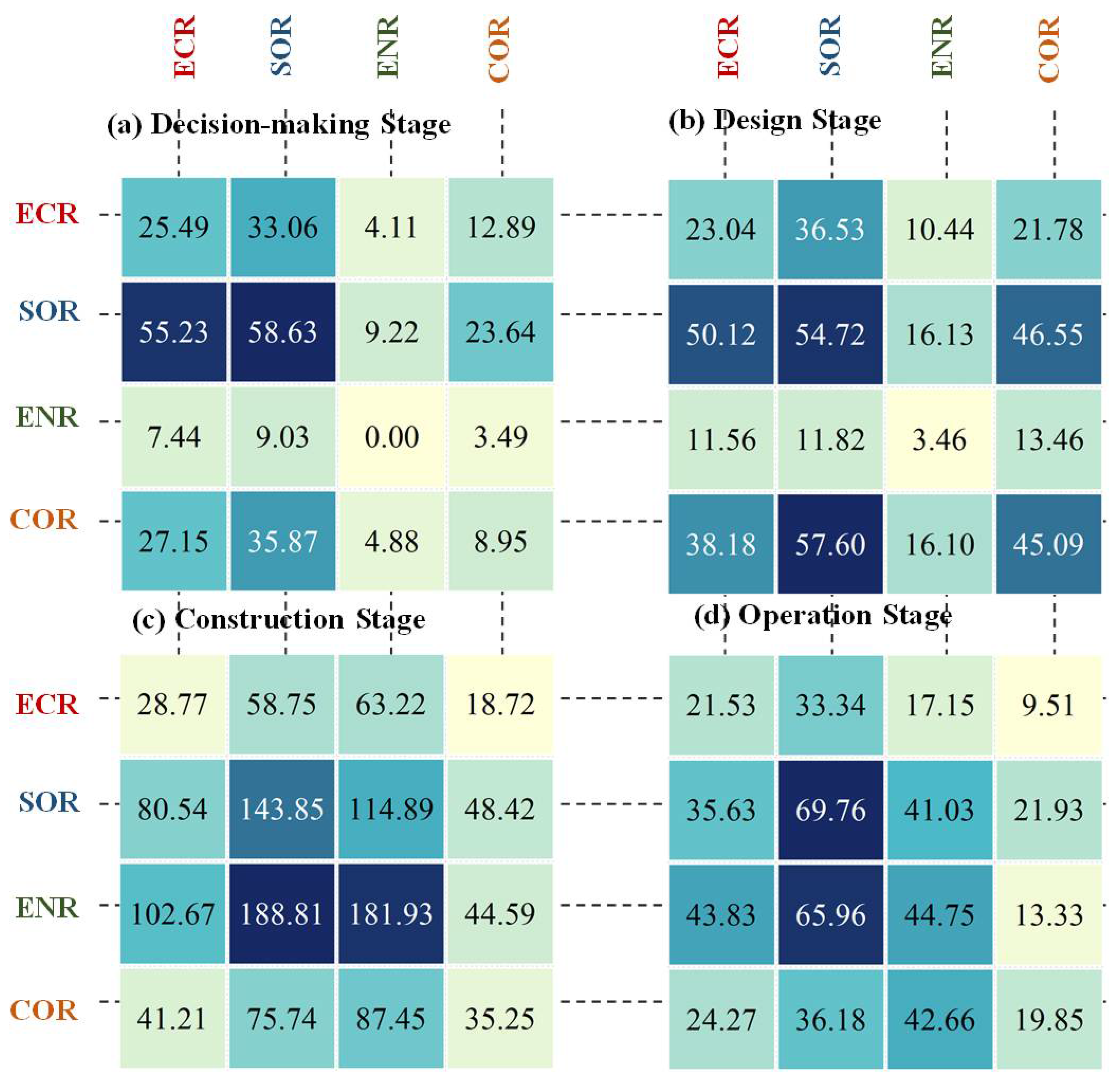

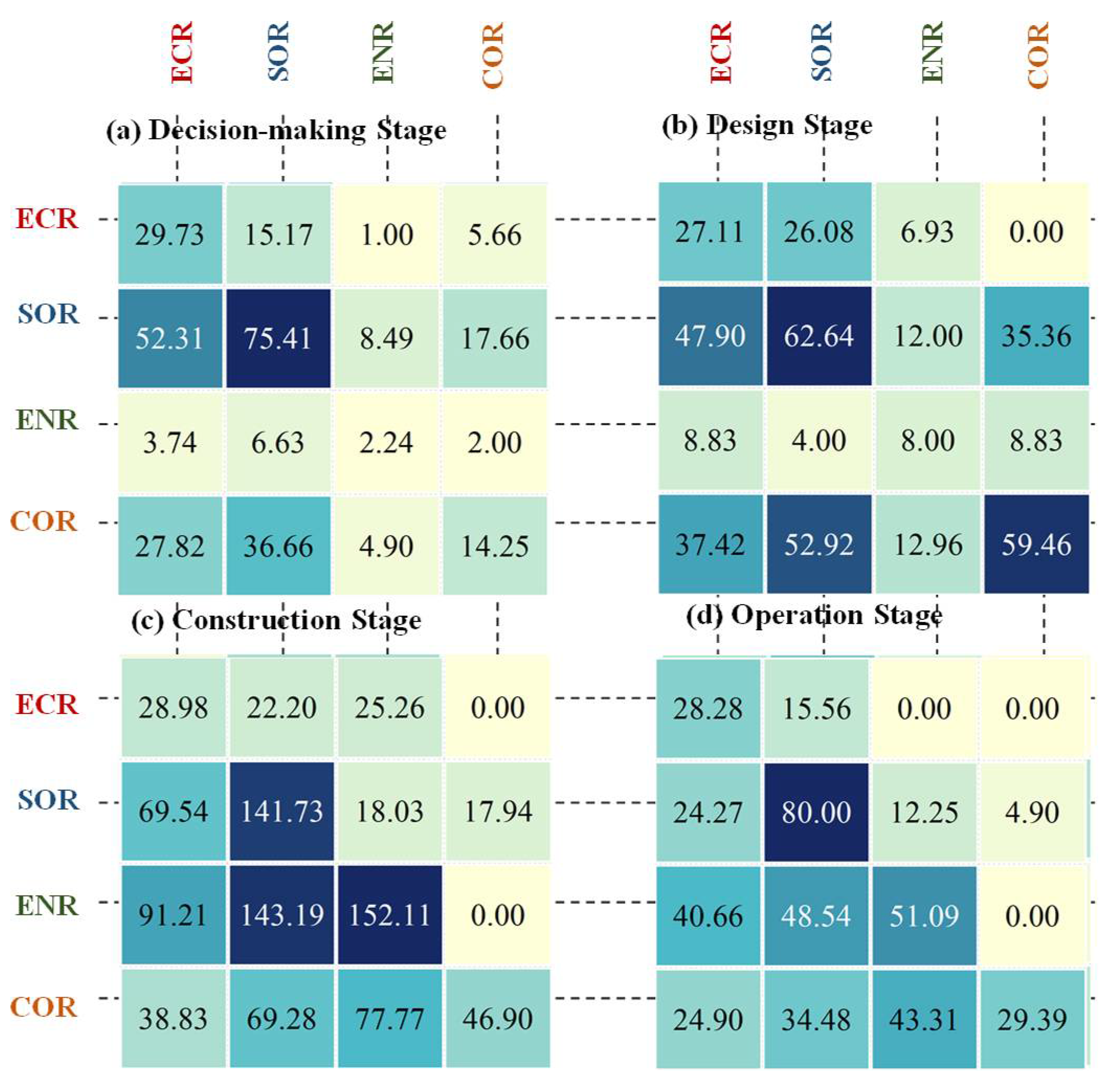

The global inter-group interaction integrates the indirect and direct effects of risk propagation between the two risk groups [38]. Figure 8 shows the global inter-group interaction of the risk network in the four MIP stages.
Compared with direct inter-group interactions, global inter-group interactions are stronger. For example, economic risk→coordination risk in the design stage, economic risk→coordination risk and environmental risk→coordination risk in the construction stage, and economic risk→environmental risk in the operation stage have little direct inter-group interaction, but have high global inter-group interactions. In addition, the close interaction relationship between the dimensions in direct inter-group interaction and global inter-group interaction is similar.

5. Discussion

5.1. Dynamic Risk-Response Strategies According to Key Risks

After determining each risk node metric ranking, all rankings are integrated to obtain the final key risks in each stage of the MIPs. Careful attention should be paid to the risks that appear in three or more metric ranking lists. They play multiple roles with different functions to support risk networks. Combining the results of high node degree, high RRGD, and high betweenness centrality, Table 8 lists the key risks.
Thirty-five key risks in Table 8 should be controlled first because they either have a significant direct or indirect effect on other risks or severely increase the complexity of risk interactions. There are 13 social risks, 9 economic risks, 8 coordination risks and 5 environmental risks among thirty-five key risks. Surprisingly, economic risks do not account for the largest proportion in the list, although many scholars regard economic risks as an important obstacle to MIPs. However, this discovery also explains why some previous scholars have focused on the social risks of MIPs, such as Li et al. [42] and Yuan et al. [21]. In addition, it confirmed the importance and necessity of introducing coordinated dimensions, and this finding is similar to the discovery of Li et al. [29]. They believe that balancing the risks of the three dimensions of economy, society, and environment has an important effect on the sustainable development of MIPs, and regard collaborative management as an important driving force and effective strategy to balance the three dimensions. In addition, project managers need to check potential risk control points at each stage of MIPs and adopt different risk response strategies associated with different risks [14].
The decision-making stage includes eight key risks which are mainly concentrated on social, coordination, and economic risks. CO1R2 (decision-making mechanisms not involving all stakeholders) and CO1R3 (weak and opaque decision-making process) are the risks with high out-degree and RRGD-Out at this stage. In other words, these two risks not only directly trigger other risks, but are also important source risks in the global network; therefore, MIP participants should actively control their occurrence, clarify the decision-making process in the decision-making stage, formulate a complete decision-making mechanism, and allow all stakeholders to participate in the decision-making stage [43]. EC1R5 (delay in project approval) is the highest in-degree risk at this stage; it is located at one end of the risk network; therefore, managers should focus on its root causes. In the decision-making stage, it was found that some risks have a negative effect on the local industry (EC1R2, EC1R3), damages on participation of local residents and community (SO1R2), cause difficulty in coordinating interest demand (SO1R7), have inadequate environmental effect assessment (EN1R1), and unsatisfying national or local legislation (CO1R1), causing the project manager to make many decisions again, prolonging the project approval time. Therefore, the project participants should reasonably extend the project decision-making time and make a full assessment during the project feasibility study. SO1R4 (bribery and corruption), CO1R1 (unsatisfying national or local legislation), SO1R5 (opportunism decision making), and SO1R2 (damages on participation of local residents and community) are the most important hub risks at this stage and have high in-degree and out-degree values. For this risk type, project participants should not only pay more attention to the effect of upstream risks, but also decouple control from downstream risks [8]. In practice, local government officials or developers are prone to bribing politicians, social elites, and leaders of major organisations (SO1R4) to approve projects that are beneficial to them (SO1R5) but unsatisfying (CO1R1), and citizens must pay public officials to obtain project decision-making information (SO1R2, SO1R1). These behaviours cause damage to connectivity among communities (SO1R6), difficulty in coordinating interest demand (SO1R7), wrong market demand forecasts (EC1R1), and other consequences. Therefore, project participants should formulate a strong punishment mechanism for corrupt behaviour, allow the public and local communities to participate in MIPs’ decision-making, fully use public supervision, and disclose project decision-making information to society through social media to reduce the occurrence of bribery and corruption [44].
The design stage includes seven key risks, concentrated on economic, social, and coordination risks. SO2R5 (opaque project design information) is the risk with a high RRGD-Out-degree at this stage. This indicates that designers need to take the initiative to share design information with other stakeholders, such as project owners, contractors, and governments. This would benefit all stakeholders in providing timely feedback on the project design and it can reduce design deficiencies (EC2R3), insufficient integration with local culture and environment (SO2R2, EN2R2), and misestimates in time and cost (EC2R2) caused by information closure [12]. EC2R2 (misestimate in time and cost) is a risk with a high RRGD-In value at the design stage. Project participants should actively find risk-mitigation strategies through a bottom-up method. For example, land acquisition and resettling cost overruns (EC2R4) can be reduced through reasonable project location planning and public opinion surveys, thereby reducing the cost of MIPs. CO2R3 (lack of sustainable clauses in contract) and CO2R4 (ambiguous sustainable management program) are risks with high out-degree, RRGD-Out values, and betweenness centrality. Owing to the lack of organizational culture on sustainability (CO2R5) in most Chinese MIPs, awareness regarding sustainable clauses is lacking when project contracts are drafted (CO2R3). Even if they are considered, the plans are not completed. Therefore, training project participants must improve their knowledge about sustainability practices and foster a culture of sustainable development within the organization. This can alleviate the lack of integrating project design with local culture and environment, and have project participants actively paying attention to the impact of MIPs on society and ecological environment. EC2R5 (designing cost overrun) and EC2R3 (design deficiency) are the risks with high in-degree, RRGD-in, and betweenness centrality. MIP stakeholders should focus on the upstream risks. For example, the project design should consider integration with the local culture and natural environment and utilisation of the disabled, and gather the opinions of other stakeholders to reduce project design deficiencies [12]. SO2R7 (bribery and corruption in the design stage) retains the same role as the decision-making stage and is the most important hub risk in the design stage. This means that, if there is no compulsory punishment and effective supervision for bribery and corruption in the design stage, the risks associated with bribery in the decision-making stage may also cause a chain reaction through this risk, resulting in more complex risk interactions and more serious risk consequences [44].
The construction stage includes 13 key risks, covering the four dimensions of sustainable development. EC3R1 (construction and installation cost overrun) is the risk with the highest in-degree and RRGD-in values at this stage. Construction delay (EC3R2), substandard quality (EC3R3), compensation for not meeting the sustainable development goals (EC3R6), and overuse of construction materials (EN3R7), all cause an increase in MIP construction and installation costs. Therefore, MIP managers should perform pre-work to reduce construction delays, regularly check the quality of the project to prevent quality failures, and strictly follow the sustainable clauses of contract to reduce compensation [45]. SO3R12 (discoordination between contractor and public), EC3R2 (construction delay), and EN3R12 (damages to the ecological balance) are the risks with high in-degree values, RRGD-IN, and betweenness centrality, and are hub risk nodes that are easily affected by other risks. Project participants should focus on controlling the upstream risks. For example, the public participation mechanism can be improved so that contractors and the public can communicate effectively [43], and non-construction land should not be occupied to protect ecological diversity. CO3R3 (weak sustainability awareness), CO3R1 (inadequate communication and coordination among stakeholders), EN3R1 (air pollution), EN3R2 (water pollution), EC3R3 (substandard quality), and EN3R11 (damages to natural heritage) are associated with a higher out-degree, RRGD-Out value, and betweenness centrality, and are hub nodes that easily affect other risks. Project participants should take the initiative to control this type of risk. These include improving sustainable practice knowledge and sustainability awareness of project participants, establishing efficient organizational communication channels to strengthen participants’ coordination, and implementing recovery and treatment measures on project waste water and waste gas to reduce the destruction of the landscape and strengthen the quality inspection of the project. SO3R2 (bribery and corruption), SO3R3 (excessive government intervention), and SO3R11 (damages on participation of local residents and community) are hub risks with high in-degree and out-degree at this stage. For these risks, project participants should actively take preventive measures and closely monitor their potential effect on the surrounding risks. For example, to reduce excessive administrative intervention, the government should reasonably restrict and regulate its own behaviour and effectively perform its supervisory powers, which benefit contractors to give full play to their own advantages and enthusiasm, and promote the success of the project [46]. It is worth noting that if bribery and corruption are not controlled in the previous stage, the construction stage will have more serious consequences. For example, bribery and corruption occurring during the bidding process of the design stage may cause the bidders to reduce costs of the construction stage to recoup their benefits, trigger project quality issues and safety incidents, and even cause public complaints and serious damage to government image and reputation [40].
The operation stage includes seven key risks, covering four dimensions. CO4R4 (weak monitor and maintenance platform of project sustainability) is the risk with a high out-degree and RRGD-Out at this stage, and is an important source risk at this stage. Therefore, project participants should monitor the operation situation of the project management process in real time, implementation effects of management strategies, and project risks through informatization methods and strengthen platform construction [41]. SO4R8 (Negative impact on residents’ life quality), EC4R5 (weak contribution toon local economy), EC4R2 (devaluation of residents’ assets [decrease in residents’ income]), and SO4R2 (damages to residents’ health) are the risks with high in-degree and RRGD-In at this stage, and are also important cumulative risks at this stage. Project participants should actively control their upstream risks, especially for environmental problems caused by project operations. Therefore, completing the setting of buffer areas between the project and residential areas and actively treating pollutants such as waste gas and wastewater generated by project operations can reduce public dissatisfaction with the project. SO4R4 (damages on participation of local residents and community) and EN4R7 (damages to the ecological balance) are the most important hub risks at this stage. Therefore, project participants should prevent and strengthen solvation for the above two risks during the construction stage.
It should be noted that there are key risks with the same meaning in different stages. For example, bribery and corruption (SO1R4, SO2R7, SO3R2) exist in the decision-making, design, and construction stages; damages on participation of local residents and community (SO1R2, SO3R11, SO4R4) exists in the design, construction, and operation stages, and damage to the ecological balance (EN3R12, EN4R7) exists in the construction and operation stages. These risk nodes should be controlled early in their occurrence, as they not only have an effect on their stage, but may also act as a hub risk between stages, leading to complex risk interactions in the life cycle of MIPs [13].

5.2. Dynamic Risk-Response Strategies According to Critical Risk Interactions

Key risk links were selected by betweenness centrality, as shown in Table 7. Ideally, by severing some links, the propagation effect of the risk interaction relationship will be reduced, thereby reducing the overall risk exposure [8]. Because there are too many key risk links at each stage, to understand their actual meaning and effect on the sustainable development of MIPs, this study classifies them and determines the main challenges faced by MIPs at each stage under the effect of risk interaction. The risk links in the same challenge have similar characteristics and can be solved similarly.
The decision-making stage includes 47 key risk links. The two risk relationships ‘SO1R2-EC1R2 (damages on participation of local residents and community—negative effect on the local industrial structure)’ and ‘SO1R1-EC1R1 (opaque project information—wrong market demand forecasts)’ both describe that stakeholders cannot obtain correct and effective project decision-making information, leading to project evaluation errors. Therefore, they are classified as the same challenge. Following the same principles, four main challenges that may be encountered at this stage are determined: (1) some stakeholders cannot obtain effective project decision-making information, resulting in project decision-making errors and economic, social, and environmental problems; (2) speculation behaviours of decision-makers lead to a management crisis within the project and cause social conflicts; (3) projects do not meet the national or local sustainable policies and affect the local economic development and social stability; and (4) insufficient project feasibility studies (market analysis, technical decision-making, environmental evaluation, etc.) lead to project delays and public protests. Therefore, in the decision-making stage, decision-making information should be disclosed [43], and punitive measures should be formulated to prevent speculation by decision-makers. Additionally, full feasibility studies should be conducted on the project with professional help.
The design stage includes 66 key risk links, and five major challenges are determined: (1) closed project design information and a lack of reference to the opinions of stakeholders leads to a design deficiency in terms of environmental protection; (2) design and resettlement cost overruns, improper estimates, financing difficulties, and other economic problems cause social problems; (3) the bribery and corruption in the bidding process cause social public opinion problems and project economic problems; (4) the government’s excessive administrative intervention leads to an imbalance in the coordination and management of projects; and (5) incomplete sustainability-related clauses and management plans in project contracts lead to management errors of project participants. Therefore, project design information should be shared with all stakeholders, all opinions should be integrated, strict supervision and punishment systems for bribery and corruption should be established [44], excessive government intervention reduced, and complete sustainability clauses and management plans ensured [43].
The construction stage includes 161 key risk links, summed into nine major challenges: (1) project construction may affect the health, safety, and quality of life of local residents, cause public dissatisfaction, and lead greater social risks; (2) construction has an effect on local employment and enterprise production and operation, leading to a local economic downturn and causing social problems; (3) safety accidents during construction stage threaten the safety and health of project participants, causing cost overruns, construction period delays, environmental, and social problems; (4) excessive administrative intervention causes internal project management imbalance; (5) bribery and corruption in order to hide the occurrence of environmental problems caused by the project lead to worse environmental pollution and arouse public resistance; (6) limited public participation as a stakeholder and various conflicts between the construction party and the public intensify public dissatisfaction with the projects, and lead to project economy loss; (7) construction does not meet the sustainable development goals, causing environmental pollution and ecological damage, which affect the normal life of residents, cause public resistance and claims, and cause economic losses; (8) project participants lack sustainability awareness and do not pay attention to environmental protection and public opinion, leading to environmental pollution problems and social conflicts; and (9) incoordination and contradictions within projects causes problems in project management. Therefore, it is necessary to train project participants in sustainable knowledge and safe construction, establish a diversified project management team, increase communication methods and channels between project internal personnel and external stakeholders, and accept public supervision [44].
The operation stage includes 73 key risk links, and four major challenges are identified: (1) negative effects on residents’ life quality and unemployment lead to a decrease in income and loss of rights and interests in public resources, which, in turn, lead to public protests and a decline in the local economy; (2) the operation process prevents public participation and lacks public supervision, and causes environmental pollution problems; (3) project operation causes ecological damage and environmental pollution around projects, which affects residents’ life quality and causes social problems; and (4) unreasonable project operation, overrun of operation and maintenance costs, weak project debt repayment ability, and insufficient contribution to the local economy, which will cause social and economic problems. Therefore, it is necessary to complete the mechanism of public participation in the operation stage [47], encourage and accept social supervision, actively seek professional help to assist in project operations, and deal with and control environmental pollution caused by project operations in a timely fashion.

5.3. Validation of the Effectiveness of the Strategies

First, deleting key risk nodes and cutting off key risk links at each stage network are used to simulate the realization of the mitigation above strategies [48]. The original risk networks were optimised into new risk networks. The new risk network in the decision-making stage is composed of nine risk nodes and 23 risk links; the design stage is composed of 13 risk nodes and 72 risk links; the construction stage is composed of 24 risk nodes and 192 risk links; and the operation stage is composed of 17 risk nodes and 104 risk links. Figure 9 illustrates the new network for each stage. By comparing the new risk networks in Figure 9 with the original risk network in Figure 2, the network interaction is significantly reduced.
Second, the effectiveness of risk mitigation strategies is evaluated by calculating the network density of new networks and it is established that the network density decreases significantly, as shown in Figure 9. The network density in the decision-making stage decreases from 0.2964 to 0.1361, a 54% decrease; in the design stage, it decreases from 0.2852 to 0.1885, a 34% decrease; in the construction stage, it decreases from 0.1816 to 0.1293, a 29% decrease; and in the operation stage, it decreases from 0.1986 to 0.1434, a 28% decrease. The above results demonstrate that the complexity of risk networks can be significantly reduced by implementing mitigation strategies for the identified key risks and key risk relationships at each stage of the project.

6. Conclusions

To achieve the sustainable development of MIPs and implement appropriate risk mitigation strategies, it is necessary to identify the risks related to the sustainable development of MIPs, to have a deep understanding of the risk interactions in various stages of MIPs, and to clarify which key risks and key risk relationships will lead to the failure of MIPs. To solve these problems, this study expanded the research perspective by taking into consideration the multiple dimensions of sustainable development and the multiple stages of a project life cycle to determine the risk of MIPs. Semi-structured interviews were conducted with 8 experts to determine risk relationships and weights. The improved SNA method was used to establish a risk network model of MIPs in four stages. The dynamic changes of network-level, node-level, link-level, and group-level network indicators were calculated and analysed, and the key risks and key links of each stage were determined. These findings were used to put forward a detailed and specific risk response control strategy, and to simulate and verify the feasibility, practicability, and superiority of this strategy. The findings of this project can be summarised in three main points.
First, this study revealed the changing trends of risk network indicators at all levels of MIPs, proving that the risk network of MIPs is dynamic and complex. The largest and smallest network densities appear in the decision-making stage (0.2964) and construction stage (0.1986), respectively. The node degree and RRGD show an inverted U-shaped trend, reaching a maximum during the construction stage. Node betweenness centrality shows a continuous and slight growth trend, reaching a maximum during the operation stage. Link betweenness centrality presents a U-shaped trend, reaching a minimum during the construction stage. Second, this study found that the risks of different dimensions of sustainable development have different close relationships at different stages. During the decision-making and design stages of MIPs, economic, social and coordination risks are closely related, and environmental risks are relatively isolated. After the construction stage, however, environmental risks are closely related to other risk dimensions. Finally, at different stages of MIPs, most of the key risks and key risk relationships are different, with a small number of key risks with the same meaning. The risks that encompass multiple stages, such as bribery and corruption (SO1R4, SO2R7, SO3R2) and damages on participation of local residents and community (SO1R2, SO3R11, SO4R4), should be controlled in the early stages of occurrence.
This study makes both theoretical and practical contributions. The results are of practical importance to participants of MIPs as it will assist in improving their understanding of MIPsrisks and risk interaction relationships from a sustainable development perspective. They can then formulate reasonable risk mitigation strategies, and promote the realisation of sustainable development of MIPs. In terms of academics, this study has provided new perspectives and methods for the field of MIP risk management. These include: expanding the definition of MIPs in light of sustainable development, and introducing the use of multi-stage SNA and innovative multi-level network metrics to consider the number and weight of risk links. It furthermore realistically simulated MIPs’ risk interaction relationships. Nevertheless, this study has had some limitations that need to be addressed. Firstly, only eight experts were invited to evaluate the risk relationships. They might not be able to fully represent the actual conditions. But the findings are helpful in the risk management of MIPs, and researchers can increase the interview sample for further investigations. Secondly, only the common risks of MIPs were researched to enhance the universality of the results. However, in practice, different types of MIPs pose very specific risks (for example, nuclear power plants have radiation risks). Future researchers may consider choosing a specific type of MIP as a research object to improve the pertinence of the results. Finally, this study selected discrete networks to develop risk networks at each stage of the MIPs. This ignores the risk interaction relationships between different stages of the project. Therefore, the risk interaction is another important area of research for future researchers.

Author Contributions

Conceptualization, Y.L. and P.X.; Formal analysis, Y.L. and P.X.; Investigation, Y.L. and J.G.; Methodology, Y.L., P.X. and K.Y.; Software, K.Y.; Validation, Y.L., K.Y. and J.G.; Visualization, Y.L. and P.X.; Writing—original draft, Y.L. and P.X.; Writing—review and editing, Y.L., P.X. and J.G. Y.L. and P.X. contributed equally to this paper. All authors have read and agreed to the published version of the manuscript.

Funding

This research was funded by the National Social Science Fund of China, grant number 21AGL033.

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Conflicts of Interest

The authors declare that they have no known competing financial interests or personal relationships that could have appeared to influence the work reported in this paper.

References

  1. Kardes, I.; Ozturk, A.; Cavusgil, S.T.; Cavusgil, E. Managing global megaprojects: Complexity and risk management. Int. Bus. Rev. 2013, 22, 905–917. [Google Scholar] [CrossRef]
  2. Flyvbjerg, B. What you should know about megaprojects and why: An overview. Proj. Manag. J. 2014, 45, 6–19. [Google Scholar] [CrossRef] [Green Version]
  3. Flyvbjerg, B. The Oxford Handbook of Megaproject Management; Oxford University Press: Oxford, UK, 2017. [Google Scholar]
  4. Fang, C.; Marle, F.; Zio, E.; Bocquet, J.-C. Network theory-based analysis of risk interactions in large engineering projects. Reliab. Eng. Syst. Saf. 2012, 106, 1–10. [Google Scholar] [CrossRef]
  5. Wang, L.; Sun, T.; Qian, C.; Goh, M.; Mishra, V.K. Applying social network analysis to genetic algorithm in optimizing project risk response decisions. Inf. Sci. 2020, 512, 1024–1042. [Google Scholar] [CrossRef]
  6. Wang, L.; Goh, M.; Ding, R.; Pretorius, L. Improved simulated annealing based risk interaction network model for project risk response decisions. Decis. Support Syst. 2019, 122, 113062. [Google Scholar] [CrossRef]
  7. Guan, L.; Abbasi, A.; Ryan, M.J. A simulation-based risk interdependency network model for project risk assessment. Decis. Support. Syst. 2021, 148, 113602. [Google Scholar] [CrossRef]
  8. Zhang, Y.; Tsai, C.-H.; Liao, P.-C. Rethinking risk propagation mechanism in public–private partnership projects: Network perspective. J. Infrastruct. Syst. 2020, 26, 04020011. [Google Scholar] [CrossRef]
  9. Chang, T.; Deng, X.; Hwang, B.-G. Investigating political risk paths in international high-speed railway projects: The case of Chinese international contractors. Sustainability 2019, 11, 4157. [Google Scholar] [CrossRef] [Green Version]
  10. Lu, Y.; Zhang, Y. Toward a Stakeholder Perspective on Safety Risk Factors of Metro Construction: A Social Network Analysis. Complexity 2020, 2020, 8884304. [Google Scholar] [CrossRef]
  11. Chen, L.; Lu, Q.; Li, S.; He, W.; Yang, J. Bayesian Monte Carlo Simulation–Driven Approach for Construction Schedule Risk Inference. J. Manag. Eng. 2021, 37, 04020115. [Google Scholar] [CrossRef]
  12. Etemadinia, H.; Tavakolan, M. Using a hybrid system dynamics and interpretive structural modeling for risk analysis of design phase of the construction projects. Int. J. Constr. Manag. 2021, 21, 93–112. [Google Scholar] [CrossRef]
  13. Shrestha, A.; Chan, T.-K.; Aibinu, A.A.; Chen, C.; Martek, I. Risks in PPP water projects in China: Perspective of local governments. J. Constr. Eng.Manag. 2017, 143, 05017006. [Google Scholar] [CrossRef]
  14. Tang, H.; Wang, G.; Miao, Y.; Zhang, P. Managing Cost-Based Risks in Construction Supply Chains: A Stakeholder-Based Dynamic Social Network Perspective. Complexity 2020, 2020, 8545839. [Google Scholar] [CrossRef]
  15. Shen, L.; Tam, V.W.Y.; Gan, L.; Ye, K.; Zhao, Z. Improving sustainability performance for public-private-partnership (PPP) projects. Sustainability 2016, 8, 289. [Google Scholar] [CrossRef] [Green Version]
  16. Tao, K.; Guo, D.; Wang, Y.; Wang, X. Study on risk conduction coupling mechanism and measure of building energy conservation Renovation Project. J. Eng. Manag. 2017, 31, 6. [Google Scholar] [CrossRef]
  17. Project Management Institute. The Project Management Body of Knowledge (PMBOK Guide), 5th ed.; Project Management Institute: Newtown Square, PA, USA, 2013. [Google Scholar]
  18. Ongkowijoyo, C.S.; Gurmu, A.; Andi, A. Investigating risk of bridge construction project: Exploring Suramadu strait-crossing cable-stayed bridge in Indonesia. Int. J. Disaster Resil. Built Environ. 2020, 12, 127–142. [Google Scholar] [CrossRef]
  19. Thamhain, H. Managing risks in complex projects. Proj. Manag. J. 2013, 44, 20–35. [Google Scholar] [CrossRef]
  20. Gijzel, D.; Bosch-Rekveldt, M.; Schraven, D.; Hertogh, M. Integrating Sustainability into Major Infrastructure Projects: Four Perspectives on Sustainable Tunnel Development. Sustainability 2020, 12, 6. [Google Scholar] [CrossRef] [Green Version]
  21. Yuan, J.; Li, W.; Guo, J.; Zhao, X.; Skibniewski, M.J. Social risk factors of transportation PPP projects in China: A sustainable development perspective. Int. J. Environ. Res. Public Health 2018, 15, 1323. [Google Scholar] [CrossRef] [Green Version]
  22. Malik, S.; Fatima, F.; Imran, A.; Chuah, L.F.; Klemeš, J.J.; Khaliq, I.H.; Asif, S.; Aslam, M.; Jamil, F.; Durrani, A.K. Improved project control for sustainable development of construction sector to reduce environment risks. J. Clean. Product. 2019, 240, 118214. [Google Scholar] [CrossRef]
  23. Hueskes, M.; Verhoest, K.; Block, T. Governing public–private partnerships for sustainability: An analysis of procurement and governance practices of PPP infrastructure projects. Int. J. Proj. Manag. 2017, 35, 1184–1195. [Google Scholar] [CrossRef]
  24. Liu, B.; Xue, B.; Chen, X. Development of a metric system measuring infrastructure sustainability: Empirical studies of Hong Kong. J. Clean. Product. 2021, 278, 123904. [Google Scholar] [CrossRef]
  25. The IS Rating Scheme, Version 2.0; Infrastructure Sustainability Council of Australia: Sydney, Australia, 2018.
  26. ISI Envision, Version 3; Institute for Sustainable Infrastructure: Washington, DC, USA, 2018.
  27. Inter-American Development Bank. What Is Sustainable Infrastructure: A Framework to Guide Sustainability across the Project Cycle; Inter-American Development Bank: New York, NY, USA, 2018. [Google Scholar]
  28. KKordi, N.E.; Belayutham, S.; Che Ibrahim, C.K.I. Mapping of social sustainability attributes to stakeholders’ involvement in construction project life cycle. Constr. Manag. Econ. 2021, 39, 513–532. [Google Scholar] [CrossRef]
  29. Li, Y.; Xiang, P.; You, K.; Guo, J.; Liu, Z.; Ren, H. Identifying the key risk factors of mega infrastructure projects from an extended sustainable development perspective. Int. J. Environ. Res. Public Health 2021, 18, 7515. [Google Scholar] [CrossRef]
  30. Yucelgazi, F.; Yitmen, İ. An ANP Model for Risk Assessment in Large-Scale Transport Infrastructure Projects. Arab. J. Sci. Eng. 2019, 44, 4257–4275. [Google Scholar] [CrossRef]
  31. Afzal, F.; Yunfei, S.; Junaid, D.; Hanif, M.S. Cost-risk contingency framework for managing cost overrun in metropolitan projects: Using fuzzy-AHP and simulation. Int. J. Manag. Proj. Bus. 2020, 13, 1121–1139. [Google Scholar] [CrossRef]
  32. Tavakolan, M.; Etemadinia, H. Fuzzy weighted interpretive structural modeling: Improved method for identification of risk interactions in construction projects. J. Constr. Eng. Manag. 2017, 143, 04017084. [Google Scholar] [CrossRef]
  33. Xu, H.; Zhang, Y.; Li, H.; Skitmore, M.; Yang, J.; Yu, F. Safety risks in rail stations: An interactive approach. J. Rail Transp. Plan. Manag. 2019, 11, 100148. [Google Scholar] [CrossRef]
  34. Cao, D.; Shao, S. Towards Complexity and Dynamics: A Bibliometric-Qualitative Review of Network Research in Construction. Complexity 2020, 2020, 8812466. [Google Scholar] [CrossRef]
  35. Ongkowijoyo, C.S.; Doloi, H.; Mills, A. Participatory-based risk impact propagation and interaction pattern analysis using social network analysis. Int. J. Disaster Resil. Built Environ. 2019, 10, 363–378. [Google Scholar] [CrossRef]
  36. Yu, L.; Liu, Q.; Hua, R.; Fu, Y. Risk Analysis of Cash on Delivery Payment Method by Social Network Analysis and Fuzzy Petri Net. IEEE Access 2020, 8, 174160–174168. [Google Scholar] [CrossRef]
  37. Opsahl, T.; Agneessens, F.; Skvoretz, J. Node centrality in weighted networks: Generalizing degree and shortest paths. Soc. Netw. 2010, 32, 245–251. [Google Scholar] [CrossRef]
  38. Wang, X.; Xia, N.; Zhang, Z.; Wu, C.; Liu, B. Human safety risks and their interactions in China’s subways: Stakeholder perspectives. J. Manag. Eng. 2017, 33, 05017004. [Google Scholar] [CrossRef]
  39. Babatunde, S.O.; Ekundayo, D.; Udeaja, C.; Abubakar, U.O. An investigation into the sustainability practices in PPP infrastructure projects: A case of Nigeria. Smart Sustain. Built Environ. 2020, 11, 110–125. [Google Scholar] [CrossRef]
  40. Reeves-Latour, M.; Morselli, C. Bid-rigging networks and state-corporate crime in the construction industry. Soc. Netw. 2017, 51, 158–170. [Google Scholar] [CrossRef]
  41. Dadpour, M.; Shakeri, E.; Nazari, A. Analysis of stakeholder concerns at different times of construction projects using Social network Analysis (SNA). Int. J. Civ. Eng. 2019, 17, 1715–1727. [Google Scholar] [CrossRef]
  42. Li, W.; Yuan, J.; Ji, C.; Wei, S.; Li, Q. Agent-Based Simulation Model for Investigating the Evolution of Social Risk in Infrastructure Projects in China: A Social Network Perspective. Sustain. Cities Soc. 2021, 73, 103112. [Google Scholar] [CrossRef]
  43. Kivilä, J.; Martinsuo, M.; Vuorinen, L. Sustainable project management through project control in infrastructure projects. Int. J. Proj. Manag. 2017, 35, 1167–1183. [Google Scholar] [CrossRef]
  44. Wan, X.; Wang, R.; Wang, M.; Deng, J.; Zhou, Z.; Yi, X.; Pan, J.; Du, Y. Online Public Opinion Mining for Large Cross-Regional Projects: Case Study of the South-to-North Water Diversion Project in China. J. Manag. Eng. 2022, 38, 05021011. [Google Scholar] [CrossRef]
  45. Banihashemi, S.; Hosseini, M.R.; Golizadeh, H.; Sankaran, S. Critical success factors (CSFs) for integration of sustainability into construction project management practices in developing countries. Int. J. Proj. Manag. 2017, 35, 1103–1119. [Google Scholar] [CrossRef]
  46. Sierra, L.A.; Yepes, V.; Pellicer, E. A review of multi-criteria assessment of the social sustainability of infrastructures. J. Clean. Product. 2018, 187, 496–513. [Google Scholar] [CrossRef]
  47. Yuan, H. Achieving sustainability in railway projects: Major stakeholder concerns. Proj. Manag. J. 2017, 48, 115–132. [Google Scholar] [CrossRef] [Green Version]
  48. Yu, T.; Shen, G.Q.; Shi, Q.; Lai, X.; Li, C.Z.; Xu, K. Managing social risks at the housing demolition stage of urban redevelopment projects: A stakeholder-oriented study using social network analysis. Int. J. Proj. Manag. 2017, 35, 925–941. [Google Scholar] [CrossRef]

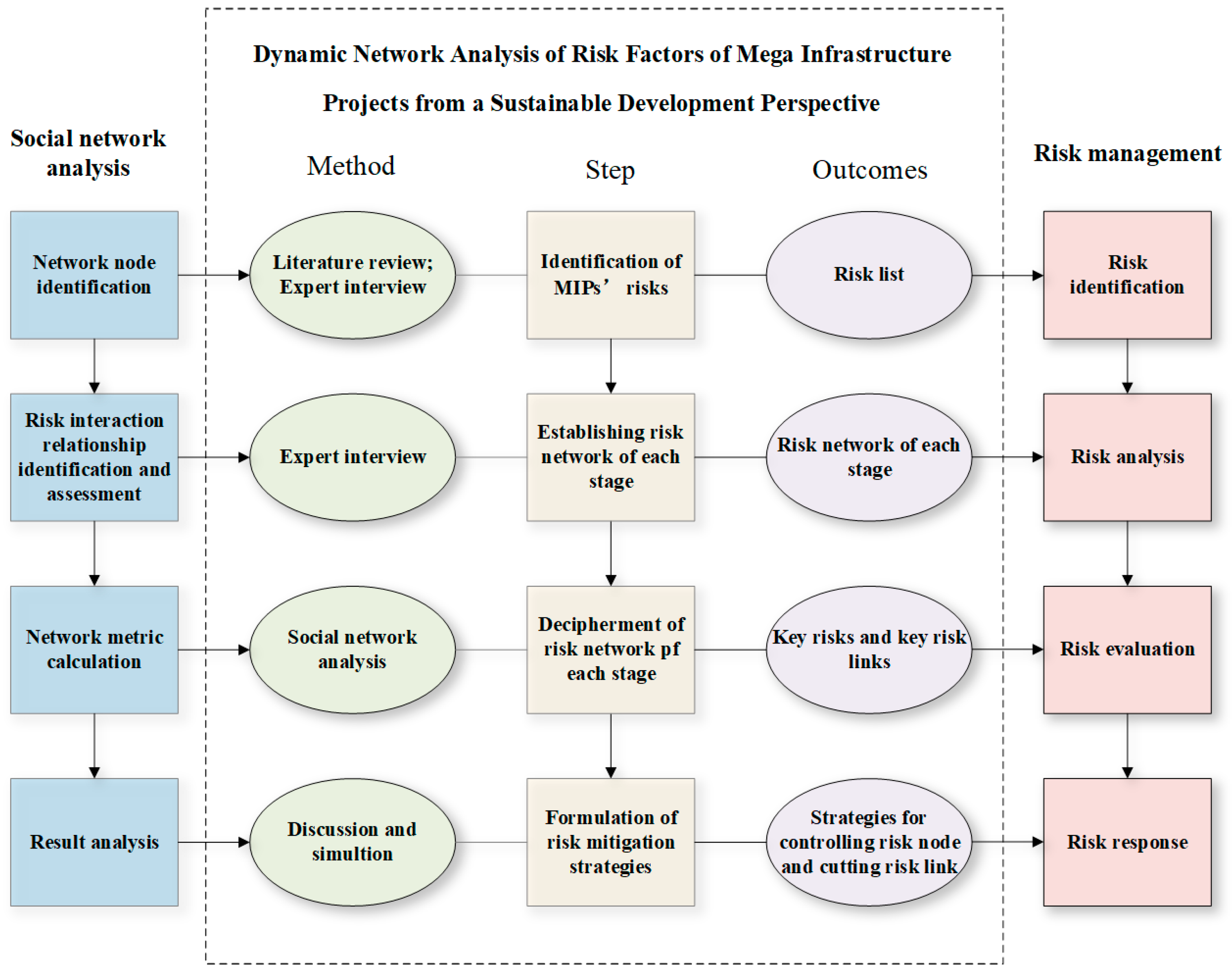

Figure 1. Main research framework.
Figure 1. Main research framework.
Buildings 12 00434 g001

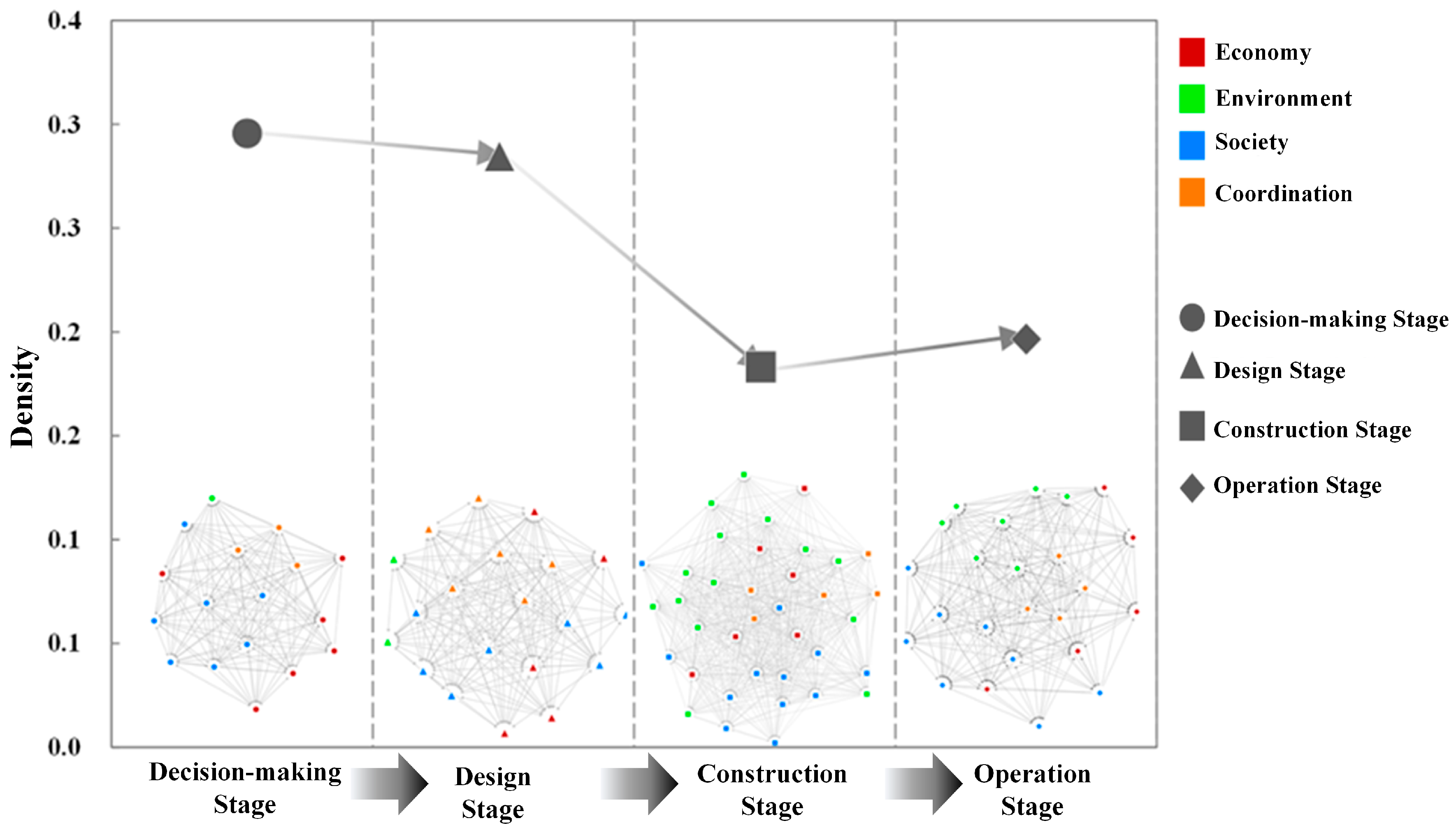

Figure 2. Four stage risk networks and the evolution of network density.
Figure 2. Four stage risk networks and the evolution of network density.
Buildings 12 00434 g002
Figure 3. The evolution of out-degree and in-degree.
Figure 3. The evolution of out-degree and in-degree.
Buildings 12 00434 g003
Figure 4. The evolution of RRGD-Out and RRGD-In.
Figure 4. The evolution of RRGD-Out and RRGD-In.
Buildings 12 00434 g004
Figure 5. The evolution of node betweenness centrality.
Figure 5. The evolution of node betweenness centrality.
Buildings 12 00434 g005
Figure 6. The evolution of link betweenness centrality. (Note: Because the value of link betweenness centrality is too small, to show the results clearly, all link betweenness centrality in the heat map is multiplied by 1000).
Figure 6. The evolution of link betweenness centrality. (Note: Because the value of link betweenness centrality is too small, to show the results clearly, all link betweenness centrality in the heat map is multiplied by 1000).
Buildings 12 00434 g006
Figure 7. Direct inter-group interaction.
Figure 7. Direct inter-group interaction.
Buildings 12 00434 g007
Figure 8. Global inter-group interaction.
Figure 8. Global inter-group interaction.
Buildings 12 00434 g008
Figure 9. Evolution of network density of optimized risk network.
Figure 9. Evolution of network density of optimized risk network.
Buildings 12 00434 g009
Table 1. Information about experts.
Table 1. Information about experts.
IDExperience (Year)RoleOrganisationParticipation Stages
Expert 112ScholarUniversityDecision-making, Design, Construction, Operation stages
Expert 219Project participantConstruction contractorConstruction, Operation stages
Expert 315Project participantOperatorConstruction, Operation stages
Expert 419Project participantDesignerDesign
Expert 520Project participantConstruction contractorDesign, Construction, Operation stages
Expert 610GovernmentGovernmentDecision-making, Construction, Operation stages
Expert 711ScholarUniversityDecision-making, Design, Construction, Operation stages
Expert 89ScholarUniversityDecision-making, Design, Construction, Operation stages
Table 2. Risk list of MIPs.
Table 2. Risk list of MIPs.
DimensionRiskMIP Life Cycle
Decision-Making
Stage
Design
Stage
Construction
Stage
Operation
Stage
EconomyWrong market demand forecasts (overrate)EC1R1
Negative effect on the local industrial structure (tourism, agriculture, etc.)EC1R2
Negative effect on the spatial layout of local industriesEC1R3
Costs caused by disputes with the communityEC1R4
Delay in project approvalEC1R5
Technical feasibility decision failureEC1R6
Difficult financing EC2R1
Misestimate in time and cost EC2R2
Design deficiency EC2R3
Land acquisition and resettling cost overruns EC2R4
Designing cost overrun EC2R5
Construction and installation cost overruns EC3R1
Construction delay EC3R2
Substandard quality EC3R3
Disposal of construction waste cost overruns EC3R4
Negative effect on local enterprises EC3R5
Compensate for not meeting the Sustainable Development Goals EC3R6
Ecological remediation cost overruns EC4R1
Devaluation of residents’ assets (decrease in residents’ income) EC4R2
Operation and maintain cost overruns EC4R3
Weak solvency ability EC4R4
Weak contribution on local economy EC4R5
SocietyOpaque project information (Closed design information)SO1R1SO2R5
Damages on participation of local residents and communitySO1R2SO2R6SO3R11SO4R4
Excessive government interventionSO1R3SO2R4SO3R3
Bribery and corruptionSO1R4SO2R7SO3R2
Opportunism decision makingSO1R5
Damages on connectivity among communitiesSO1R6
Difficulty of coordinating interest demandSO1R7
Unreasonable resettlement SO2R1
Non-matching with local culture SO2R2
No access of the disabled SO2R3
Damages of cultural heritage SO3R1
Construction safety and accidents SO3R4
Damages on employees’ health SO3R5
Damages on residents’ safety (personal or property) SO3R6SO4R1
Damages on residents’ health SO3R7SO4R2
Negative effect on employment(unemployment, underutilisation of local labour force) SO3R8SO4R6
Negative impact on residents’ life quality SO3R9SO4R8
Inadequate facilities surrounding the projects SO3R10SO4R7
Discoordination between contractor and public SO3R12
Widen the gap between rich and poor SO4R3
No access to public resources to local residents SO4R5
EnvironmentInadequate environmental effect assessmentEN1R1
Lack of environmental protection measures EN2R1
Non-matching with natural environment EN2R2
Air pollutant (greenhouse gases, toxic gases, dust) EN3R1EN4R1
Water pollution EN3R2EN4R2
Lights pollution EN3R3EN4R4
Noises pollution EN3R4EN4R3
Construction waste pollution (solid waste pollution) EN3R5
Usage of not environmental-friendly construction materials EN3R6
Overuse of construction materials EN3R7
Overuse of energy EN3R8EN4R5
Excessive consumption of non-renewable energy EN3R9EN4R6
Soil health degradation (salinization, swamping, etc.) EN3R10
Damages to natural heritage EN3R11
Damages to the ecological balance EN3R12EN4R7
Causing geological hazards (landslide, collapse, slope instability, soil erosion, etc.) EN3R13
Occupy a lot of non-construction land (green land, agricultural land, animal habitat) EN3R14
CoordinationUnsatisfying national or local legislationCO1R1
Decision-making mechanisms not involving all stakeholdersCO1R2
Weak and opaque decision-making processCO1R3
Ambiguous responsibility and right sharing clauses CO2R1
Inadequate investment and source sharing clauses CO2R2
Lack of sustainable clauses in contract CO2R3
Ambiguous sustainable management program CO2R4
Lack of organisation culture on sustainability CO2R5
Incomplete communication and coordination procedures CO2R6
Inadequate communication and coordination among stakeholders CO3R1
Non-complementary employee ability CO3R2
Weak sustainability awareness CO3R3
Inadequate experience CO3R4
Team conflict(non-cooperation) CO3R5
Unclear maintenance subjects of project sustainability CO4R1
Unclear monitor system of project sustainability CO4R2
Unclear monitor and maintenance organization of project sustainability CO4R3
Weak monitor and maintenance platform of project sustainability CO4R4
Table 3. Network metric.
Table 3. Network metric.
LevelMetricFormulaNotation
NetworkND D e n s i t y ( G ) = i , j N w i , j w m a x N ( N 1 ) (3) w m a x : the maximum weight of all links.
Node/LinkNDE O u t d e g r e e r ( i ) α = k i o u t × ( s i o u t k i o u t ) α     = ( j N a i , j ) 1 α   ( j N w i , j ) α (4) k i o u t :the number of links originating from risk i .
s i o u t : the total weight of the links originating from risk i .
k i i n : number of links directly toward risk i .
s i o u t : total weight of links directly toward risk i .
I n d e g r e e ( i ) α = k i i n × ( s i i n k i i n ) α
= ( j N w j , i ) 1 α ( j N a j , i ) α
(5)
NBC/LBC B e t w e e n ( i ) α = i , k , f N ,     i k f g k , f w α ( i ) g k , f w α (6) g k , f w α : the total number of shortest paths from risk k to risk f and g k , f w α ( i ) and g k , f w α ( i j ) : the number of shortest paths that pass through risk i and link i j .
B e t w e e n ( i j ) α = i , j , k , f N ,     i j k f g k , f w α ( i j ) g k , f w α (7)
RRGD R R G D i i n = j N 1 d w α ( j , i ) R R G D i o u t = j N 1 d w α ( i , j ) (8) d w α ( i , j ) : the shortest paths from risk k to risk j .
d w α ( i , j ) = m i n [ ( 1 w i h ) α + + ( 1 w h j ) α ] .
GroupDIGI D I G I n , m = ( i n , j m a i , j ) α × ( i n , j m w i , j ) 1 α (9)
GIGI G I G I n , m = i n , j m ( 1 d w α ( i , j ) ) (10)
Table 4. In-degree key risks and out-degree key risks.
Table 4. In-degree key risks and out-degree key risks.
StageDecision-Making StageDesign StageConstruction StageOperation Stage
In-degreeCodeValueCodeValueCodeValueCodeValue
EC1R525.6125EC2R229.6648EC3R151.4975SO4R835.7211
SO1R525.3969SO2R727.8209EC3R649.4874EC4R528.5307
CO1R123.2379EC2R525.0799SO3R1247.7494SO4R626.4953
SO1R722.8035SO2R225.0799EC3R246.2493EC4R225.7876
EC1R420.3961SO2R124.7992SO3R945.8258SO4R224.4949
SO1R419.5959EC2R122.9129SO3R640.6448SO4R524.2693
SO1R218.1659EC2R322.7596SO3R240.0000EC4R324.0000
EC2R421.4942SO3R739.5727SO4R121.9089
EC3R533.8231EC4R121.6333
EN3R1230.5123EN4R721.6333
SO3R829.9500
SO3R1129.6985
SO3R328.5307
SO3R528.1425
EN3R1127.5681
Out-degreeCodeValueCodeValueCodeValueCodeValue
CO1R230.5778SO2R533.1663CO3R364.0859CO4R436.5240
CO1R330.2985CO2R631.7333CO3R450.9117CO4R232.4962
SO1R126.2679CO2R330.9839CO3R245.9565CO4R332.4962
SO1R325.7488CO2R430.9839SO3R243.1277SO4R432.1714
SO1R424.0416SO2R430.1993CO3R536.7424CO4R132.1248
CO1R122.9129CO2R529.3258CO3R135.6651EN4R722.2486
SO1R522.2711SO2R628.9828EN3R133.6749EN4R122.2261
SO1R222.1359SO2R728.9137EN3R633.1663EN4R222.2261
SO1R720.1494CO2R121.1660EN3R232.7261EN4R521.8174
CO2R219.0788EN3R931.4643EN4R621.81742
EN3R530.7571SO4R716.6133
EC3R329.9500EN4R315.4919
SO3R327.5681
EN3R1327.1662
EN3R1126.4953
EN3R426.0768
SO3R1125.8070
EN3R1025.7488
EN3R1425.4165
Table 5. RRGD-In and RRGD-Out key risks.
Table 5. RRGD-In and RRGD-Out key risks.
StageDecision-Making StageDesign StageConstruction StageOperation Stage
RRGD-InCodeValueCodeValueCodeValueCodeValue
SO1R523.5597EC2R226.8024EC3R651.4976SO4R833.7081
EC1R523.3229SO2R726.3228SO3R1249.4874SO4R628.4022
SO1R722.7525SO2R126.1773SO3R947.7493SO4R228.0602
CO1R121.0475EC2R524.6650EC3R146.2493EC4R226.8667
SO1R420.1544EC2R324.6151EC3R245.8258EC4R526.5318
EC1R419.4155SO2R224.5475SO3R640.6448EN4R726.3771
EC1R118.9989EC2R123.9579SO3R740.0000SO4R125.5366
CO2R323.4609SO3R239.5727EC4R325.4781
SO3R1133.8231SO4R425.3722
SO3R530.5123EC4R124.7975
EC3R529.9500
EN3R1229.6985
SO3R828.5307
SO3R328.1425
EC3R335.0955
RRGD-OutCodeValueCodeValueCodeValueCodeValue
CO1R330.5778SO2R530.1489CO3R360.8803CO4R434.2699
CO1R230.2985CO2R629.7060CO3R448.0197CO4R230.6223
SO1R126.2679SO2R428.2880CO3R245.5057SO4R429.8868
SO1R325.7488CO2R428.2665SO3R245.4927CO4R329.1920
SO1R224.0416CO2R327.9740CO3R143.3313CO4R128.8742
CO1R122.9129SO2R726.8024CO3R541.9137EN4R126.0308
SO1R422.2711CO2R526.0956EN3R141.1415EN4R226.0308
SO2R625.8277EN3R640.9073EN4R525.3554
CO2R123.2812EN3R240.1097EN4R624.9171
EN3R939.0641EN4R724.1085
SO3R337.7851SO4R722.6697
EN3R1137.4009
EN3R1237.2099
EN3R537.1311
EN3R1337.0631
SO3R1136.7901
EC3R336.5868
Table 6. Betweenness centrality key risks.
Table 6. Betweenness centrality key risks.
StageDecision-Making StageDesign StageConstruction StageOperation Stage
NBCCodeValueCodeValueCodeValueCodeValue
SO1R40.0833SO2R70.1287SO3R20.1970SO4R40.3864
SO1R50.0788CO2R30.0429EC3R20.0947SO4R20.0711
SO1R20.0667EC2R30.0365SO3R120.0930EC4R20.0665
CO1R10.0649CO2R40.0292CO3R30.0360SO4R80.0586
EC2R50.0249CO3R10.0306EC4R40.0425
EN3R10.0246EC4R50.0425
EN3R20.0228
SO3R110.0204
SO3R30.0189
Table 7. Key risk link.
Table 7. Key risk link.
StageNo.
12345678910
Decision-making
Stage
StartEC1R4EC1R1SO1R4SO1R4SO1R2SO1R5SO1R6EC1R2SO1R6EC1R6
EndSO1R2SO1R5CO1R2CO1R3SO1R4CO1R3SO1R7SO1R5SO1R4SO1R4
Value0.06250.03490.03310.02760.02210.02210.02020.01960.01930.0184
Design
Stage
StartEC2R4SO2R3EN2R2SO2R2EC2R3EC2R1EN2R1EC2R5EC2R5EC2R2
EndSO2R7EC2R3CO2R3CO2R5SO2R2SO2R7CO2R3SO2R3SO2R7SO2R7
Value0.03900.03420.03030.02590.02500.02320.02150.02110.02110.0197
Construction StageStartSO3R12EC3R1SO3R12EC3R4EC3R2SO3R2EC3R2EC3R5SO3R2EN3R12
EndCO3R1SO3R2CO3R3SO3R2EN3R2EN3R9EN3R1SO3R2EN3R6SO3R2
Value0.04360.02930.02710.02630.02430.02360.02030.01970.01650.0161
Operation StageStartSO4R2EC4R2EC4R4EC4R5SO4R8SO4R4EC4R1SO4R4SO4R4SO4R4
EndSO4R4SO4R4EC4R2SO4R4SO4R4EN4R7EC4R4CO4R1CO4R2CO4R3
Value0.09150.07340.05890.05250.04800.03990.03890.03620.03620.0362
Table 8. The key risks of MIPs.
Table 8. The key risks of MIPs.
Decision-Making StageDesign StageConstruction StageOperation Stage
CodeRiskCodeRiskCodeRiskCodeRisk
SO1R4Bribery and corruptionSO2R7Bribery and corruptionSO3R2Bribery and corruptionSO4R4Damages on participation of local residents and community
CO1R1Unsatisfying national or local legislationCO2R3Lack of sustainable clauses in contractSO3R12Discoordination between contractor and publicEN4R7Damages on the ecological balance
SO1R5Opportunism decision makingCO2R4Ambiguous sustainable management programEC3R2Construction delaySO4R8Negative impact on residents’ life quality
SO1R2Damages on participation of local residents and communityEC2R5Designing cost overrunEN3R12Damages to the ecological balanceEC4R5Weak contribution on local economy
SO1R7Difficulty of coordinating interest demandEC2R3Design deficiencyEC3R1Construction and installation cost overrunsEC4R2Devaluation of residents’ assets (decrease in residents’ income)
CO1R2Decision-making mechanisms not involving all stakeholdersSO2R5Opaque project information (Closed design information)SO3R3Excessive government interventionSO4R2Damages on residents’ health
CO1R3Weak and opaque decision-making processEC2R2Misestimate in time and costSO3R11Damages on participation of local residents and communityCO4R4
EC1R5Delay in project approval CO3R3Weak sustainability awareness
CO3R1Inadequate communication and coordination among stakeholders
EN3R1Air pollutant (greenhouse gases, toxic gases, dust)
EN3R2Water pollution
EC3R3Substandard quality
EN3R11Damages to natural heritage
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Li, Y.; Xiang, P.; You, K.; Guo, J. Dynamic Network Analysis of the Risks of Mega Infrastructure Projects from a Sustainable Development Perspective. Buildings 2022, 12, 434. https://doi.org/10.3390/buildings12040434

AMA Style

Li Y, Xiang P, You K, Guo J. Dynamic Network Analysis of the Risks of Mega Infrastructure Projects from a Sustainable Development Perspective. Buildings. 2022; 12(4):434. https://doi.org/10.3390/buildings12040434

Chicago/Turabian Style

Li, Yuanli, Pengcheng Xiang, Kairui You, and Jin Guo. 2022. "Dynamic Network Analysis of the Risks of Mega Infrastructure Projects from a Sustainable Development Perspective" Buildings 12, no. 4: 434. https://doi.org/10.3390/buildings12040434

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
