Risk Factors That Lead to Time and Cost Overruns of Building Projects in Saudi Arabia

Department of Civil Engineering, King Saud University, P.O. Box 800, Riyadh 11421, Saudi Arabia
*
Author to whom correspondence should be addressed.
Buildings 2022, 12(7), 902; https://doi.org/10.3390/buildings12070902
Submission received: 21 May 2022 / Revised: 11 June 2022 / Accepted: 19 June 2022 / Published: 25 June 2022
(This article belongs to the Topic Advances in Construction and Project Management)

Abstract

:
Rapid transformation across all sectors through Saudi Arabia’s vision 2030 initiatives led to an increase in construction activities. However, the construction industry has been already facing huge cost and time overruns, affecting all stakeholders. The aim of this study is to identify and explore the influential risk factors that lead to completion delays and cost overruns of government-funded building construction projects in Saudi Arabia, all of which have been subjected to a traditional type of procurement method (Standard Public Works Contract). The literature examined in this study identified a total of 83 risk factors, which have been grouped into nine categories. A questionnaire-based survey was conducted to determine the participants’ perspectives on the degree of probability of occurrence (P) of each risk and its potential impact on a project in terms of time (IT) and cost (IC). The questionnaire survey was distributed to 200 experts and professionals associated with Saudi building construction projects, which were grouped into four categories: clients, designers, consultants, and contractors. Fifty-five acceptable questionnaires were returned and analysed. The relative importance index (RII), and Risk Importance (RI) were used to identify the most influential risk factors, and an agreement test was conducted. The results of the survey revealed that the most significant risks factors contributing to the delay of building construction projects’ completion are contractor’s financial difficulties, owner’s delay in making progress payments for completed works, contracts awarded to the lowest bidder, change orders during construction, ineffective project planning and scheduling by the contractor, shortage of manpower, and contractor’s poor site management and supervision. In addition, change orders during construction and contracts awarded to the lowest bidder are the most significant risks factors of exceeding budgets. Based on the results, it is concluded that for achieving sustainable development, client, contractor, and labour-related risks must be effectively managed.

1. Introduction

The main evaluation dimension of the successful execution of construction projects is to examine the achievement of project objectives (time, cost, and quality) [1,2,3]. Previous research has elicited that construction projects experience underachievement in both developed and developing countries as a result of completion delays and cost-overruns, with resultant negative impacts experienced by all involved parties, including financial loss [4,5,6].
Project delay has been defined as ‘the time overrun either beyond the completion date specified in the contract and the parties agreed upon for the delivery of the project, or a part of the project’ [7,8]. The liability of the contract parties for construction projects delays can be classified into excusable with compensation delays, excusable without compensation delays, non-excusable delays or contractor responsible, and concurrent delays [9,10]. Construction cost overruns is the actual/final costs minus those estimated, presented as a percentage of the estimated costs [11].
Completion delays and cost-overruns typically stem from a multitude of severe risks and uncertainties [12]. Whilst an entire host of studies and research has sought to identify risk factors in the global construction industry, they have concurred that the risk factors are different from one project to another and also depend on the country, procurement route (i.e., PPP, design-bid-build, and design and build), and the type of construction project. In addition, the top causes of cost-overruns are subject to change over time (in each decade); therefore, knowledge of them needs to be kept up to date in order to manage complexity effectively so as to avoid or minimise risks [12]. There are four different categories of construction project, namely building construction, heavy/civil construction, industrial construction, and residential construction, with the foremost accounting for the highest segment at 35–40% of construction projects [13]. Therefore, it is important to limit identifying the risk factors to a certain category of construction project that experiences almost the same issues, challenges, and risks. However, there is a lack of research on identifying the risks and categorising them according to different types of projects [14]. Recent studies focused on specific types of projects such as oil and gas [15,16], manufacturing and buildings [17], and road projects [18,19], there is a need to increase the research in identifying the risk factors in different projects types and to assess the changes in risk factors importance and probability [20]. It is important to address this research gap, because these can have potentially serious consequences, such as cost and time overruns, and can add additional pressure to construction projects [21,22]. In this context, this study addresses the following research question.
RQ: What are the risk factors adversely affecting time and cost of execution of building construction projects?
Thus, this study addresses this research gap by identifying the influential risk factors that lead to completion delay and cost overrun specific to government-funded building construction projects (i.e., government buildings, hospitals, schools, and universities) in Saudi Arabia, all of which have been subjected to a traditional type of procurement method (Standard Public Works Contract). Accordingly, the following research objectives are outlined to address the RQ:
  • To explore and identify the influential risk factors leading to duration and cost overrun during the construction stage, with special consideration for building projects in Saudi Arabia (i.e., risk factors list and classification) through the completion of a comprehensive literature review.
  • To study, rank, and analyse the identified risk factors (i.e., ‘risk impact × likelihood’) by conducting questionnaires.
Addressing the RQ and the above-listed objectives could achieve interesting findings which can contribute to the literature in providing the risk factors by project type, i.e., government-funded building construction projects. It can also help decision makers in better understanding the risks in construction industry during COVID-19 in order to better formulate policies and decision making with respect to Vision 2030 objectives. Furthermore, the findings can aid the managers of building construction projects in designing effective risk management strategies.

2. Literature Review

2.1. Overview of Construction Industry

Construction, in simple terms, is the process of constructing an infrastructure that requires collaboration of multiple disciplines, including architectural design management, financial and legal management, engineering and technology, logistics and procurement, sustainability, risk management, project management, etc. Types of construction can be broadly classified into industry-specific, building, and residential constructions [23]. The construction industry is considered to be one of the sustainable and continuous businesses that has been recording steady growth in recent decades. However, there are various risk factors that influence this industry, such as geopolitics, economy, resources, technology, etc. The global construction output growth in 2019 reduced to 2.7%, which was less than 2018, and such deterioration was observed in many developing countries, especially the Middle East, while developed countries, such as the USA and Australia, have struggled to maintain growth momentum [24].
Various findings have been identified in different studies [25,26,27,28], reflecting the complexity and different influencing factors in the construction industry. It has been estimated that there will be 85% growth (USD 15.5 trillion) in construction output by 2030 (3.9% growth per annuum), out of which 57% of growth was contributed by a developed country, the US, and developing countries including India and China [26]. Faster growth is predicted in the USA (5% per annuum) compared to China, followed by India and Japan. In a report by Robinson [27], the construction market is predicted to grow by USD 8 trillion by 2030. A KPMG [25] survey revealed that only 20% of the global constructive companies were innovative, 60% were followers, and 20% were behind the curve. In addition, disparities were observed in strategies, practices, and performance of the companies’, reflecting gaps in the process. Deloitte identified seven factors that can have an impact on growth in construction industry, including the following: innovation, competitive dynamics and margin improvement; internationalism, compliance, regulation, and transparency; and sustainability [28]. The findings from these studies indicate the complexity in construction industries, with there being various influencing factors, including geopolitics, environmental, technology, strategies, innovation, etc. Furthermore, the COVID-19 impact has significantly affected the construction industry, with many companies facing liquidity problems. Reduced spending and consumption capacity, operating restrictions and fear of contagion, supply chain disruptions, and lack of labour have all contributed to the impact, which have affected the sustainability of many SMEs across the globe [29]. A recent report on the construction industry predicted that smaller businesses and sub-contractors may fail rapidly; contract management can be a major issue as customers may seek to terminate or renegotiate contracts; internationalisation may become less viable as companies may reconsider the regions in which they want to operate in [30].

2.2. Saudi Arabian Construction Industry

Saudi Arabia’s construction industry was severely affected during 2015–2016 following the crash in oil prices, which reduced the capital flow; as a result, many projects were halted, postponed, or even cancelled. However, the construction industry in the country is expected to grow exponentially in the next few years, with it gearing up towards a post-oil era, when new major cities will be developed and constructed [31]. According to a report published by Mordor Intelligence [31], more than 5200 construction projects are currently ongoing in Saudi Arabia, valued at USD 819 billion, out of which 3727 are urban construction active projects, and these are valued at USD 386.4 billion. There 733 are utility sector projects valued at USD 95.6 billion and 500 relating to transportation, valued at USD 156.2 billion. The Saudi construction industry is highly competitive with major international players [32]. The market presents opportunities of growth, which is expected to increase the market competition further. However, with a few players holding a significant market share, the Saudi Arabian construction market has an observable level of consolidation [33]. Focusing on the type of construction, Saudi Arabia spent USD 575 billion on public construction projects between the years of 2008 and 2013 [34,35]. A recent report [36] has forecasted a growth of 2.9% in 2021 in the Saudi Arabian construction industry and CAGR of 4% during 2022–2025. Furthermore, a Public Investment Fund (PIF) of USD 800 billion was underlined by the Crown Prince for funding projects over the next decade. Moreover, year-on-year growth of construction contract awards in Saudi Arabia are forecasted to reach 96 percent in 2022, which is diversified over different types of projects [37]. For instance, the total value of planned building contract awards alone in the Saudi Arabia is predicted to be USD 10.95 billion in 2022 [38]. Given these forecasts, the construction industry will be growing rapidly in the next few years.
The Saudi Arabian construction market is expected to witness significant growth and offer lucrative potential, due to its Vision 2030, NTP (National Transformation Programme) 2020, and several ongoing reforms aimed at diversifying away from oil. The Vision 2030, NTP 2020, and private sector investment boost as well as the ongoing reforms are likely to be the growth drivers for the Saudi construction market in 2018 and beyond. Vision 2030, along with a significant investment in housing and infrastructure development promoted across the country by local authorities, is revitalizing the construction industry and generating interest in a growing number of international players. Due to these programmes, the construction industry might have access to various opportunities; however, there are challenges associated with these programmes. Changes in regulations, policies, and the granting of planning approval may create complexity in the commencement of new projects and the completion of those already in progress, as they will have to be modified according to these new regulations. In this context, it is worth noting that the Saudi contractors’ classification system functions within five grades according to the value they hold for a contract to be signed and 29 fields. The Example of the fields as following: buildings, roads, industrial works, marine works, dams, electrical works, and mechanical works [39]. In addition, according to the Government Tenders and Procurement Law in Saudi Arabia, all government bodies and agencies must use Saudi Arabia’s Public Works Contract (SPWC) for all government-funded public construction projects. In addition, an increase in the projects will require growth in the work force, as a result of which companies may well have to depend on expatriates, which might result in acquiring an unskilled workforce lacking experience and facing issues in regard to cultural integration. In addition, without proper estimations of costs and risks, the contractors may end up suffering from financial losses.

2.3. Risk Factors Leading to Cost and Time Overruns

Studies have identified various critical success factors for construction projects. These included time, cost, quality, safety, client’s satisfaction, employees’ satisfaction, cash-flow management, profitability, environment performance, learning and development, etc. [40]. However, the majority of the past research have extensively focused on the three major factors for success in construction industry, which included cost, time, and quality [41]. It has been elicited that over 70% of public construction projects in Saudi Arabia have experience delays [42]. Various risk factors and challenges explaining the time and cost overruns for these projects have been uncovered. Baghdadi and Kishk [43] identified 54 risk factors in the context of external, internal, and force majeure in aviation construction projects, which were causing duration delays as well as cost overruns. Mahamid [44], focusing on the factors affecting performance in construction projects, identified various risks, including poor communication among project participants, poor labour productivity, poor planning and scheduling, payment delays, escalation of material prices, poor labour productivity, and poor site management. Regarding the causes of disputes, Mahamid [44] identified 29 direct and 32 indirect dispute causes, of which major direct dispute causes included delay in progress payment by the owner, unrealistic contract duration times, change orders, poor quality of completed work, and labour inefficiencies. Major indirect dispute causes included inadequate contractor experience, lack of communication between the construction parties, ineffective planning and scheduling of the project by the contractor, cash problems during construction, and poor estimation practices.
Focusing on the design risks, Sha’ar et al. [45] identified unstable client requirements, lack of proper coordination between the various disciplines of the design team, awarding the contract to the lowest price regardless of the quality of services, lack of skilled and experienced human resources in the design firms, lack of skilled human resources at the construction site, delaying of due payments, lack of a specialised quality-control team, lack of professional construction management, delaying the approval of completed tasks, and deficient drawings and specifications. Various other challenges, such as those related to subcontractors, labour, machinery, availability of materials, and quality; and client-related risks such as financial issues, issues related to design documents, change in codes and regulations, scope of work, accidents on site, lack of expertise, re-designing, unqualified workforce, organisational culture, and poor contract management were identified from various studies conducted on Saudi Arabian construction industry [46,47,48].
Furthermore, the causes of the cost and time overruns factors differ between various projects/buildings. For instance, when comparing the delay factors between road infrastructure and building projects, a recent study [49] found that the major critical delay factors for road infrastructure projects included inadequate contractor experience and payment delays to the contractor, while the shortage of materials and financial difficulties of contractor were most salient for building projects. For tall building projects, the major causes of delay and cost overruns identified in [50] included “client’s cash flow problems/delays in contractor’s payment”, “contractor’s financial difficulties”, and “poor site organization and coordination between various parties”. Another study focusing on regular manufacturing and building construction [17] identified delays in progress payments, difficulties in financing the project by contractor/manufacturer, slowness in decision making, late procurement of materials, and delay in approving design documents as the major causes of cost and time overruns. In specialised construction projects, such as railways, the causes were found to be related to “Client’s decision-making process and changes in control procedures”, “Design errors (including ambiguities and discrepancies of details/specifications)”, “Labor skills level”, “Design changes by client or consultant”, and “Issues regarding permissions/approvals from other stakeholders” [51]. In addition, Allahaim [14] emphasised causes and classifications as differing by project type and stakeholder, with overall cost overrun depending on the type of project: power and health projects (60% cost overruns), transport and water projects (40% cost overruns), and education projects (30% cost overruns). Aljohani et al. [52] carried out a review of the literature and identified 173 causes of cost overrun in seventeen contexts, with the main ones being frequent design change, contractors’ financing, payment delay for completed work, lack of contractor experience, poor cost estimation, poor tendering documentation, and poor materials management. The authors concluded that the main causes differed from country to country, and that it would be an inaccurate method to use only the global literature to identify the causes for a specific country [14]. In contrast, Ahady et al. [53] found that most of causes of cost overruns in construction industries of development countries are similar, and the causes are different for every project. The most significant causes of cost overruns were fluctuations and increases in material price. Appendix A shows that various risk factors associated with construction projects from 17 studies [2,4,14,17,44,51,52,52,53,54,55,56,57,58,59,60,61,62,63,64,65].
Hence, the factors causing cost and time overruns may change by the types of construction projects. Therefore, there is a need to focus the research on specific building projects in the context of Saudi Arabia. Furthermore, most studies in the literature probed the causes of either cost or time overruns for the construction industry, but very few considered both. Given these gaps, it is essential that risk factors and risk management techniques in Saudi Arabia have to be studied from time to time in order to prevent any damage/losses and avoid cost and duration overruns in construction projects. Accordingly, the purpose of this study is to identify the influential risk factors that lead to completion delays and cost overruns of government-funded building construction projects in Saudi Arabia, all of which have been subjected to a traditional type of procurement method Standard Public Works Contract (SPWC).

3. Research Methodology

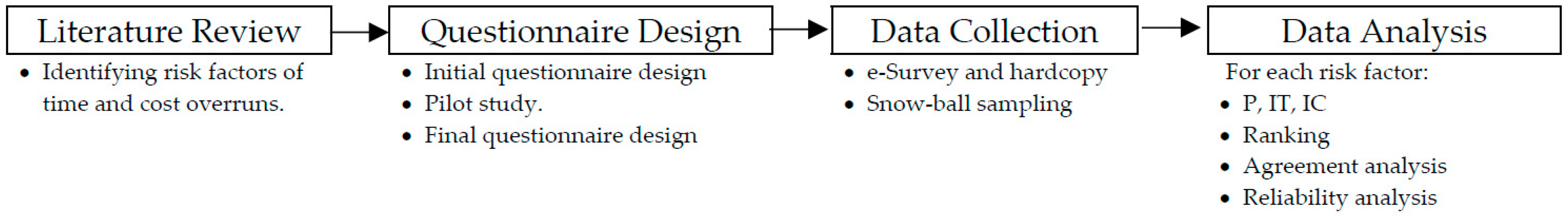

For this study, the researchers adopted a cross-sectional questionnaire-based survey to identify risk factors related to government-funded building construction projects in Saudi Arabia. Figure 1 illustrates the adapted research methodology phases used to achieve the study objectives. This methodology includes four phases: the identification of initial risk factors from the literature, questionnaire design, data collection, and then data analysis.
The first phase was the identification of initial risk factors from previous literature. A comprehensive literature review was carried out to uncover the various risk factors associated with construction projects. Then, the researchers identified the risk factors that were applicable in the context of Saudi Arabia. A final list of 83 risk factors, classified into nine different groups (client-related, designer-related, consultant-related, contractor-related, labour-related, material-related, equipment-related, external risks, and force majeure), was identified to be relevant for investigation in the context of this study, as shown in Appendix B.
The second phase was the questionnaire’s design. The initial questionnaire was developed based on the findings in the previous phase. All these applicable risk factors were included in the questionnaire, which was divided into three sections. The first section of the questionnaire included the participants’ demographic information, while the second focused on the level to which project delays and cost overruns affect construction projects. The third section pertained to identifying which risk factors caused project delays and cost overruns by asking three sub-questions for each risk. These included the probability of occurrence (P) in projects based on the respondents’ perspective and experience, the negative impact of the risk on project’s time (IT), and the negative impact of the risk on project’s cost (IC). The questionnaire used a Likert scale of five ratings (1: very low; 2: low; 3: moderate; 4: high; 5: very high) and was designed in both English and Arabic to improve the participants’ ease of accessibility and understandability. The researchers conducted a pilot study to validate the prepared questionnaire by distributing it to a set of experts in the construction field. The collected comments were reviewed to develop the final questionnaire.
The third phase of study was data collection. The questionnaire link was forwarded to the experts in construction industry who have been working in relevant building construction projects using various online networks. The researchers adopted snowball sampling [66], requesting the participants to forward the survey link to their colleagues and other relevant professionals. The survey was initially forwarded to 38 experts. Snowball sampling is a more conducive and practical technique for the research scope and to overcome the obstacle of the questionnaire’s length, finding the target audience, and providing high-quality information. However, because of snowball sampling, 63 responses were received. After removing eight incomplete responses, the responses from 55 participants were included in the data analysis.
The fourth phase of study was the data analysis of the survey results using MS Excel. The relative importance index (RII) calculated the probability of occurrence (P) of each risk, the impact of the risk on project’s time (IT), and the impact of the risk on project’s cost (IC). Risk Importance (RI) was used to determine the level of importance of each identified risk associated with building construction projects by multiplying the probability and impact for each in terms of project time and cost. In addition, the reliability of factor analysis was used to measure the strength of the internal consistency of the identified risk factors, and an agreement analysis test (Cronbach’s alpha) was conducted to measure the strength and direction of relationship between the parties involved in this study (client, contractor, and consultant).

3.1. Ranking of Risks

To carry out data analysis, the relative importance index (RII) for each risk was calculated by Equation (1) for the probability of occurrence (P) in projects based on the respondents’ perspective and experience, and for negative impact (I) of the risk on project’s time (IT) and for negative impact on project’s cost (IC), using five point Likert scales:
R I I = i = 0 n W i A × N = i = 0 n 5 n 5 + 4 n 4 + 3 n 3 + 2 n 2 + n 1 5 N
where
  • RII—is the Relative Importance Index;
  • Wi—is the weight given to each factor by the respondents from 1, 2, 3, 4, and 5 for very low, low, moderate, high, and very high, respectively;
  • A—is the highest weight (i.e., 5 in five-point Likert scale);
  • N—is the total number of respondents for every variable.
To prioritise risks, the formula of Risk Importance (RI) was calculated by multiplying the probability and impact for each in terms of project time and project cost (see Equation (2)). Based on the calculations, risks were classified as “high”, “moderate”, or “low” importance. Risks that have an (RI) value equal to or greater than (0.6) were classified as “high” and were significantly important, and those between 0.6 and 0.4 were classified as “moderate” importance and less than 0.4 as “low” importance:
Risk   Importance ; R I = P × I
where
  • RI—is the Risk Importance to determine the level of importance of each identified risk;
  • P—is the probability of risk occurrence;
  • I—is the impact of risk on time or cost.

3.2. Reliability of Factor Analysis

For this study, Cronbach’s alpha () testing was used to measure the reliability and strength of the internal consistency of the identified risk factors. The range is between 0 and 1, and the acceptable reliability number is typically 0.7 or higher as identified by [67]. The formula for Likert scale is shown in Equation (3) below:
C α = K K 1   [ 1 i = 0 k σ b 2 σ t 2 ]
where:
  • —is Cronbach’s alpha;
  • K—is many items;
  • σ b 2 —is the variance of test score;
  • σ t 2 —is the variance of item scores after weighing.

3.3. Agreement Analysis

Spearman’s rank correlation coefficient ( r s ) was used to measure the strength and direction of relationship between two ranked sets rather than the actual values. The coefficient was calculated by Equation (4) for ranked risk factors for pairs of the parties involved in this study (client, contractor, and consultant):
r s = 1 6 d 2 n ( n 2 1 )
where
  • r s —is Spearman’s rank correlation coefficient between two parties;
  • d —is the difference between ranks assigned to each risk;
  • n —is the number of pairs of rank.

4. Results and Discussion

4.1. Participants’ Demographics

Out of 55 acceptable questionnaires, 30 respondents (54.55%) belonged to the public sector, whereas (34.55%) were from the private sector, and 5.45% belonged to semi-government sector; the remaining 5.45% belonged to academic and research institutions. Twenty-seven respondents (49.09%) designated themselves as the client (owner/government agency), eighteen respondents (32.73%) were designers and consultants, and eight respondents (14.55%) reported to be contractors. The majority indicated that they had a masters degree (MSc) (41.82%), and 23.64% responded that they held a PhD.
Furthermore, the majority of the participants (63%) in this study had an experience of more than 15 years on construction projects, and they were distributed across various areas in the construction sector, reflecting the quality inputs gathered from the diverse experts. The quality of the responses was considered reliable for the analysis due to personal level interaction, relevant experiences, and clear understanding of the questionnaire among the participates. Table 1 summarises the first part of the questionnaire responses, including the respondents’ educational background and experience.

4.2. Delay and Cost Overrun in Construction Projects

Based on reported experience, more than 40% of projects had been subject to delays in the execution phase for thirty respondents (54.55%), and the percentage of project delays was more than 30%, as identified by 25 respondents. Fifty-four respondents had experienced project cost overruns in the execution phase and the average percentages of cost overruns were between 10% and 25% for 29 respondents, whereas 25 respondents (45.45%) have experienced projects cost overruns with less than 10% of average percentage of cost overruns. Table 2, below, summarises the results of second part of the questionnaire.
However, it has been documented that over 70% of the public projects in Saudi Arabia were delayed [68]. For instance, university construction projects were found to be experiencing delays from 50% to 150% [42]. The findings of this study indicate slightly fewer delays (45% of participants stating delays less than 40%) compared to previous studies [69,70], which have identified them as being from 70% to 75%.

4.3. Ranking of Risks

Risks that are associated with building construction projects in Saudi Arabia were assessed and ranked in terms of project delay and project cost overruns by calculating the Relative Importance Index (RII) of the probability of occurrence (P) for each risk, RII of impact of the risk on project time (IT), and (RII) of impact of the risk on project cost (IC). Then, Risk Importance (RI) was calculated for each risk in terms of project time (delay) and project cost (cost overruns), being subsequently ranked, as shown in Table A2 (Appendix B). The top ten risk factors that led to delay and cost overruns in building construction projects are shown in Table 3.
As a result of Risk Importance classification (high, moderate, and low), seven risk factors that were the most significant risks factors contributing to completion delay of building construction projects were (1) contractor’s financial difficulties (RI = 0.692), (2) owner’s delay in making progress payments for completed works (RI = 0.672), (3) contract awarded to lowest bidder (RI = 0.631), (4) change orders during construction (RI = 0.627), (5) ineffective planning and scheduling of project by contractor (RI = 0.627), (6) shortage of manpower (RI = 0.608), and (7) contractor’s poor site management and supervision (RI = 0.601). On the other hand, there were two significant risks factors contributing to cost overruns: (1) change orders during construction (RI = 0.622) and (2) contract awarded to lowest bidder (RI = 0.601). The top ten risk factors that led to delay and cost overruns in building construction projects are shown in Table 3.
The most significant risks factors identified in this study are related to contractors (financial difficulties, ineffective planning and scheduling of projects, and poor site management and supervision), clients (delay in making payments, awarding contracts to the lowest bidder, and changing orders during construction), and labour (shortage of manpower). Contractors’ financial difficulties (ineffective cash flow management) was ranked as the first major risk factor in this study. Shash and Qarra [71] conducted a study that revealed that 40% of contractors in Saudi Arabia experience financial failure due to poor cash flow management. Saudi contractors’ classification system classifies contractors to a five-grade scale. Although these grades determine the maximum project budget size that allow contractors to bid for (an upper limit), it does not consider the maximum number of projects (the total financial limit of all awarded projects) [39]. Consequently, some contractors use the cash flow of one project to finance different project deficits [71]. This result is in line with some of the investigated studies [2,71,72,73]. The Saudi contractors need to adopt effective cash flow management practices that require planning, monitoring, and controlling cash inflow and outflow at both the company and project levels to achieve financial success and avoid project deficits.
The second ranked risk factor is the owners’ delay in making progress payments to the contractor for completed works (payment delays). Most Saudi construction contractors suffer from progress payment delays. Although Saudi contractors receive 5.0% of the contract price at the beginning as an advance payment from the project’s owner, the progress payments are the key sources of cash inflow to resolve deficit cash flow and avoid or minimise outsource finance. Delayed progress payments and high expenses of construction project leads to delaying construction work progress and increasing the project costs unless the contractor is capable financially. Approval process (65%) and bureaucracy (25%) are the primary reasons for delays in owners’ progress payments [71]. This result is supported by [52,60,71,74].
Contracts awarded to the lowest bidder was ranked as the third most significant risk to building construction projects in Saudi Arabia. This risk can be attributed to the government’s tender and procurement system and the contractors’ classification system in Saudi Arabia. This practice creates uncertainty due to a lack of experience, lack of financial capability, incompetent contractors, and suicide tendering. It is supported by studies in different contexts and was also identified by [7,60,74] in Saudi Arabia as the most important significant risk factor in Saudi Arabia.
Changing orders during construction were considered the fourth most important risk for project delay in this study. It was also identified by [7] Assaf in Saudi Arabia and by [75] in Kuwait as the most significant risk factor causing project delays. Change orders usually lead to change project schedules and contract prices, claims and disputes, and poor quality of work. Khalifa and Mahamid [20] identified the factors causing change orders in Saudi Arabia. The top causes of change orders are owners’ additional work, design errors and omissions, lack of coordination, defective workmanship, owners’ financial difficulties, and differing site conditions.
Ineffective project planning and scheduling by contractors was ranked as the fifth among the top risk factors in this study. It was also identified by [7,70,74] in Saudi Arabia and by [2] in Malaysia as the most important risk factor. The shortage of manpower (skilled, semi-skilled, and unskilled) was ranked the sixth major risk factor in this study, which is similar to the findings observed in [42]. However, studies [68,76] identified shortage of labour as being less influential compared to the other factors among the top ten terms of risk. Disruptions in supply chain and movement of labour due to the recent COVID-19 pandemic could be one of the reasons for the higher ranking for shortage of labour. Although COVID-19 may be considered as a force majeure risk, the impact it caused may affect all three stakeholders, including clients, consultants, and contractors. Furthermore, the number of risk factors identified in Saudi Arabia in previous studies [68,76,77] was from 45 to 60, and they were mostly related to owners (clients) and contractors. Finally, contractors’ poor site management and supervision was ranked as the seventh most important risk factor in this study. It was identified by [72] in Vietnam and by [2] in Malaysia.
Changing orders during construction and contracts awarded to the lowest bidder were ranked as the first and second most significant risks to construction projects in Saudi Arabia that caused project cost overruns, which were client-related risks. This result is supported by previous research conducted by [52,54].
Furthermore, from the perspective of the three groups of respondents (clients, consultants, and contractors), they indicated the risks related to their areas with low RI compared to the other groups (as shown in Table A3, Appendix B). For instance, RI for almost all the client-related risks was less than 0.6, as rated by the participants who were in this category, whereas some of these risks were rated with an that was RI more than 0.6 by consultants and contractors. However, no major differences among the groups were identified in rating the risks pertaining to designer-related, labour-related, material-related, equipment-related, and external risk factors. Table A3 (Appendix B) presents the ranking according to the perspectives of the three groups of respondents.
Among the identified risk groups, contractor-related risks were identified to be the major risk factors causing both time and cost overruns. Considering the remaining categories, materials-related, labour-related, consultant-related, and external risks had greater impact on cost overruns; materials-related, force-majeure, and consultant-related risks had greater impact of time overruns. The findings clearly indicated the disruptions in supply chain, which may be attributed to the recent pandemic and issues in planning and implementation.
In addition, analysing the risks of each group in order to identify the most important group of risk in building projects in Saudi Arabia, as shown below in Table 4.
The results revealed four groups as the most important groups with score more than 0.45, which include client-related risks, contractor-related risks, labour-related risks, and design-related risks, all of which were found to have a greater impact on both cost and time overruns. Client-related risks were ranked highest in government-funded projects. However, this finding contrasts with some studies on Saudi Arabian construction where contractor-related risks were given the highest importance [69,74], while in [22] client-related risks were identified as being in this place. Contractor-related risks have been elicited as being the second most important risk in this study, which contrasts with its rankings in other studies [69,70,74]; however, it was identified as being one of the most significant risks in [43]. Moreover, labour- and design-related risks were identified as being significant in studies [43,78] conducted in Saudi Arabia, while other studies [69,70,74] did not find this to be the case.
The risk factors identified in this study, although they reflected similar risks identified in other recent studies in different project types in Saudi Arabia, had few differences identified in terms of the nature of significant risks and their priority. For instance, in the study focusing on the oil and gas industry [15], client-related risks included changes in design and contractor-related risk, and poor planning and implementation were identified as the significant risks; On the other hand, in the study focusing on manufacturing and building projects [17], contractor-related risks including financial difficulties and delays in procurement of raw-materials were identified to be significant risks. In another project related to roads construction, poor planning and poor labour productivity and unskilled labour were identified to be the significant risks. Lean practices can be an effective approach in this context for improving the planning and implementation of construction projects in Saudi Arabia, as it can result in social, economic, and environmental benefits [79]. Although lean practices were identified to be effective in different countries [79,80], different barriers such as traditional practices, client related, technological, performance and knowledge, and cost-related barriers were identified, which limit the implementation of lean practices in Saudi Arabia [81]. Therefore, there is a need to address these barriers for effective implementation of lean practices for addressing the various types of risks in Saudi Arabian construction industries. It is evident from these studies that the nature of risks and its significance may change with the types of projects and countries; therefore, risk management strategies and approaches have to be adjusted accordingly.
These research findings provide a good lesson to not only Saudi Arabia but also the construction industries in other countries, especially the Middle East countries, where there is a lack of skilled resources, high dependency on expatriates, and rising demand for new construction projects. Furthermore, the findings in this study contrasted with studies conducted in other developing countries. For instance, in Malaysia [2,61], design and contract risks were identified to be of high priority, followed by labour risks. However, with increase in FDIs, the clients of the governments may require different changes or raise issues in agreements that may lead to an increase in such risks, as identified in this study in Saudi Arabia, which is focusing on acquiring huge FDIs. Similar results may be identified in China [59], where client risks and contractor-related risks were identified to be the significant risks. Therefore, for developing countries looking for FDIs in the construction industry, client-related risks may emerge as top risks in the near future. While other risks such as material and labour-related risks would be commonly identified in developing countries with limited technical and human resources [55].

4.3.1. Reliability of Factor Analysis

It was calculated for the nine groups and the overall factors, as shown in Table 3. The results of Cronbach’s alpha were all more than 0.8, thus indicating an acceptable level of reliability was achieved, as shown in Table 5.

4.3.2. Agreement Analysis

As shown in Table 6, the results indicate positive agreement between the pairs of parties, with the highest level being between the client and consultant, at 82.8%, and 73.8% agreement between the consultant and contractor, and then 64.1% agreement between the client and contractor. The lowest degree of agreement appears to between client and contractor (43.3% with impact on project cost overruns and 34.1% with risk importance of cost overrun). The overall agreements between the parties in ranking the risk factors and other major findings in this study can be used for further research and analysis.
Regarding the level of agreement amongst the different stakeholders, it is evident from Table 6 that client–consultant had the highest, while client–contractor had average levels of agreement, thus indicating the major issues relating to the clients–contractors’ relationships and transactions. The low probability in client and contractor relationship can be understood in different perspectives and interests. The relationship between client and contractor can be influenced by various factors. For instance, commitments from the contractors and competence trust of the clients are very volatile, which can significantly affect the relationship between them [82]. While time, cost, and quality were considered as important client values, they were not considered as exclusive values for assessing contractors service, indicating the differences in the values, attitudes of both parties, and the relationships between them [83]. The major issues identified in this study and previous ones [68,76,77] have revealed that the majority of the risk factors of high priority pertain to client–contractor relationships. Hence, it can be concluded that the companies and consultants in Saudi Arabian construction industry should focus on improving the client/contractors’ relationships, the tendering process, project planning and execution, and financing.

5. Conclusions

The construction industry in Saudi Arabia has suffered from completion delays and cost overruns, which have caused financial losses for all parties involved in such a competitive environment. The survey results revealed the seven risk factors that were the most significant risk factors contributing to the completion delays of building construction projects out of the eighty-three risk factors identified from literature review. These risk factors included contractors’ financial difficulties, owners’ delay in making progress payments for completed works, contracts awarded to the lowest bidder, change orders during construction, ineffective project planning and scheduling by contractor, shortage of manpower, and contractors’ poor site management and supervision. Additionally, changing orders during construction and contracts awarded to the lowest bidder were the most significant risks that caused projects cost overrun, which were client-related risks. It revealed four risk groups as the most significant: client-related risks, contractor-related risks, labour-related risks, and design-related risks. Each group was found to have a notable impact on both cost and time overruns. The statistical analyses revealed an acceptable level of reliability of the identified risk factors and a positive agreement between the clients, consultants, and contractors.
The findings have revealed issues in the client/contractor relationship and tender allocation process, which may help industry experts and government agencies in future plans to mitigate the risks identified in this study. Furthermore, with uncertainty continuing due to the COVID-19 pandemic and the opening of the markets, future studies could focus on investigating the force majeure risks and the impact these have on the relationships between the stakeholders and supply chain systems in the Saudi Arabian construction industry. To achieve sustainable development, client-, contractor-, and labour-related risks must be effectively managed.
The novelty of contributions in this study can be reflected in the findings achieved in specific to government funded building construction projects in Saudi Arabia, which previous studies have not focused, although the difference in the risk factors with project types were highlighted in previous studies. Furthermore, the findings of this study are novel, due to the situations created by external factors such as COVID-19 pandemic, which has greatly affected resource management and continuity in construction. However, there are certain limitations that can be observed in this study. This study adapted snowball sampling methods and only considered government-funded building construction projects through SPWC processes, while there are also other project types. These limitations can be addressed in future research works. Future research can focus on another project types in the context of Saudi Arabia, such as roads, industrial projects, etc. However, various implications can be drawn from the findings in this study. Firstly, the results from this study aids decision makers to better understand the impact of the COVID-19 pandemic on the construction industry, based on which necessary policy-related decisions may be taken to strengthen the construction industry and better implement vision 2030 objectives. Secondly, the findings in this study contribute to the literature on the risk factors by project types, as this study focused only on government-aided building construction projects.

Author Contributions

S.A. was the primary researcher responsible for the designing the study and conducting the majority of the work. K.A.-G. was the principal supervisor who contributed to the research design and revised the paper on several occasions. A.A. contributed by revising the overall structure and content of the survey. All authors have read and agreed to the published version of the manuscript.

Funding

This research was funded by the Deanship of Scientific Research (DSR), King Saud University (KSU).

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

The data presented in this study are available on request from the corresponding author.

Acknowledgments

The author would like to thank the Deanship of Scientific Research (DSR), King Saud University (KSU), for supporting and funding this research.

Conflicts of Interest

The authors declare no conflict of interest.

Appendix A

Table A1. List of major risk factors identified from the literature review.
Table A1. List of major risk factors identified from the literature review.
StudiesMethodologiesCountryNo. of Factors IdentifiedMajor Risk FactorsImpact on Construction Projects
Memon et al. (2012) [61]Interviews and surveysMalaysia35Design and documentation issues, financial resource management, project management and contract administration, contractors site management, information and communication technology, material and machinery resource, labour (human) resource, external factorsTime and cost overrun
Aljohani et al. (2017) [52]Literature ReviewMultiple countries173Increase in material cost, inaccurate material estimates, shortage of skilled labour, client’s late contract award, project complexity, increase in labour costs, bidding differences, shortage manpower, design issues, poor planning and implementation, lack of talent resourcesCost overrun
Allahaim and Liu (2015) [14]Literature Review and SurveysSaudi Arabia41Market conditions, unrealistic estimations, decision-making errors, payment issues, project size, lack of talent resources, poor planning and implementation, waste on site, currency fluctuations, lack of technology and material resources, changes in design and scope, political obstacles, poor strategiesCost overrun
Creedy et al. (2010) [57]Case studiesAustralia37Design issues, political issues, requirements changes, cultural issues, material costs increase, contract failures, administration issues, location changes, inflationTime, cost, quality, performance
Jackson (2002) [58]InterviewsUK341Design changes, project management, site conditions, commercial pressures, lack of talent resources, external factors, estimation methods, information availabilityTime, cost, quality, performance, planning, project management
Baloyi and Bekker (2011) [55]Literature Review and SurveysSouth Africa 18Increase in material cost, inaccurate material estimates, shortage of skilled labour, client’s late contract award, project complexity, increase in labour costs, bidding differences, shortage manpower, design issues, poor planning and implementation, labour issues, poor information availability, delay in approvalsTime, cost, quality, performance, planning, project management
Subramani et al. (2014) [63]Case studies and Literature ReviewIndia10Slow decision making, poor schedule management, increase in material/machine prices, poor contract management, poor design/ delay in providing design, rework due to wrong work, problems in land acquisition, wrong estimation/ estimation method, and long period between design and time of bidding/tenderingCost overrun
Memon et al. (2011) [2]Case studies and SurveyMalaysia30Practice of assigning contract to lowest bidder, contractor’s poor site management, cash flow and financial difficulties faced by contractors, ineffective planning and scheduling by contractors, problems with subcontractors, inadequate contractor experience, material procurement, poor estimate project duration, incompetent designers, shortage of site workers, lack of communication among parties, unforeseen ground condition, changes in scope of projects, low speed of decision making, frequent changes by owners, escalation of material prices, owner interference, change in managementTime overrun
Mahamid et al. (2015) [60]Survey and Literature ReviewSaudi Arabia31Bid awarded for lowest price, changes in material types and specifications during construction, contract management, duration of contract period, fluctuation of prices of materials, frequent changes in design, improper planning, inflationary pressure, lack of adequate manpower, long period between design and time of implementation, payments delay, poor labour productivity and reworkTime overrun
Mahamid (2017) [44]Case studies and surveySaudi Arabia34Improper planning, poor labour productivity, additional works, rework, and lack of contractor experience, disputes, arbitration, litigation, and poor qualityTime overrun, Performance
Tebeje Zewdu and Teka Aregaw (2015) [64]Survey and Literature ReviewEthiopia41Poor planning, fluctuation of price of materials, poor productivity, inflationary pressure and project financing, economic instability, lack of talented labourCost overrun, Performance
Sharma and Goyal (2019) [62]Literature Review and Expert opinionIndia55Fluctuation in price of materials, lowest bid procurement policy, inflation inappropriate govt. Policy, mistakes and discrepancies in the contract document, inaccurate time and cost estimate, additional work, frequent design change, unrealistic contract duration and financial difficulty faced by contractorsCost overrun, Performance
Cirovic and Sudjic (2012) [56]Literature Review and Case studiesMontenegro16Local market issues, Montenegrin legislation, local infrastructure, poor resources management, delay in approvals, lack of planning, lack of labourCost and duration overrun
Bahamid et al. (2019) [54]Literature ReviewMultiple countries111Inflation/price fluctuation, technology issues, incomplete design scope, changes, labour equipment, delays in approvals, financial issues, poor estimations, poor designs, political instability, criminal acts, poor communication, poor planning and controlTime, cost, quality, performance, planning, project management
Liu et al. (2016) [59]Survey and Literature ReviewChina20Host government–related risk, contractor’s lack of experience, and lack of managerial skills had significant effect on project cost, quality, and schedule objectives, resource price fluctuationTime, cost, quality, performance, planning, project management
Iqbal et al. (2015) [4]SurveyPakistan24Financial issues for projects, accidents on site and defective design, subcontractors, labour, machinery, availability of materials and quality, issues related to design documents, changes in codes and regulations, political instability, and scope of workTime, cost, quality, performance, planning
Zhao et al. (2016) [65]SurveySingapore28Inaccurate cost estimation, cost overrun, poor planning, external factorsTime, cost, quality

Appendix B

Table A2. RII for risk factors of building construction projects and ranking.
Table A2. RII for risk factors of building construction projects and ranking.
NoCodeRisk FactorsProbabilityImpact on TimeImpact on CostRisk Importance (RI)
Project DelayCost OverrunOverall RI
RIIRankRIIRankRIIRankRIRankRIRankRIRank
Clients-Related Risks
1G1R1Client’s lack of experience about construction project. 0.665330.724400.713250.482350.474250.48239
2G1R2Excessive bureaucracy in owner’s administration 0.735110.742330.665440.545180.489190.54518
3G1R3Client’s financial difficulties 0.665330.81880.720190.544190.479220.54419
4G1R4Owner’s delay in making progress payments for completed works (payment delays)0.76730.87610.684370.67220.525120.6722
5G1R5Selecting consultant, or designer, based on the lowest price 0.76040.756290.742110.575140.56440.57514
6G1R6Contract awarded to the lowest bidder 0.81810.771240.735130.63130.60120.6313
7G1R7Unrealistic/Inadequate original contract duration (tight schedule) 0.702190.82250.720190.577130.505160.57713
8G1R8Political pressure to complete the project and speed up construction processes 0.549710.644700.75390.353680.413490.41358
9G1R9Delay in land acquisition/Handover to the contractor 0.571650.684550.524770.390610.299760.39064
10G1R10Difficulties in obtaining work permits from the authorities 0.640440.760270.589690.486310.377550.48635
11G1R11Change orders during construction 0.75650.82930.82210.62740.62210.6274
12G1R12Scope of work reduction by owner during execution phase 0.535720.545790.575740.292800.307750.30778
13G1R13Delay penalty clause in the Saudi Public Works Contract is inefficient 0.582600.680570.596650.396580.347620.39661
14G1R14Inaccurate estimation of construction cost by owner0.684240.669630.77130.457430.527100.52727
15G1R15Project suspension by owner0.556680.789170.684370.439460.380530.43947
16G1R16Delays due to dispute resolution 0.673310.789170.698310.531240.470280.53124
Designer-Related Risks
17G2R1Unclear and inadequate drawings, specifications, bills of quantities (BOQ)0.724130.804120.76740.582110.55550.58211
18G2R2Discrepancies between project documents (contract, BOQ, specifications, and drawings) 0.647410.749310.738120.485320.478230.48536
19G2R3Mistakes and deficiencies in design documents 0.651400.742330.727180.483340.473260.48338
20G2R4Inaccurately estimated quantities (BOQ) 0.680260.695510.76450.472400.519130.51928
21G2R5All existing underground utilities information not available on the design documents (e.g., live cables and pipelines) for the contractor 0.687230.782210.705280.537200.485200.53720
22G2R6Inadequate geotechnical investigations report about ground conditions of the project site (if available) 0.647410.731390.77820.473390.504170.50432
23G2R7Complexity of design0.495790.665640.665440.329740.329680.32974
24G2R8Absence of contractor’s involvement in the design stage0.615490.509820.524770.313760.322700.32276
25G2R9Speeding up of design phase’s schedule 0.676280.665640.691340.450450.467300.46743
26G2R10Limited budget for design0.647410.662660.676420.428500.438380.43848
Consultant-Related Risks
27G3R1Lack of experience and competence of consultant’s staff.0.691220.764260.680390.528260.470270.52826
28G3R2Slowness in decision making for approval (shop drawings, submittals, sample materials, change orders, etc.) 0.716170.793140.655460.568150.469290.56815
29G3R3Consultant’s rejection of submittals (shop drawings, equipment, and material samples) 0.596520.720430.607600.429490.362570.42953
30G3R4Consultant’s delay in performing inspection and testing, and giving instructions0.567660.695510.571750.394590.324690.39462
31G3R5Poor coordination and communication between consultant and other parties0.636460.753300.615590.479370.391510.47941
32G3R6Poor quality control and assurance0.662370.684550.687350.452440.455320.45546
33G3R7Consultant’s corruption0.585580.724400.720190.424520.422460.42455
34G3R8Inflexibility (rigidity) of consultant0.575640.676590.560760.389630.322710.38965
35G3R9Excessive safety consideration 0.447810.505830.491830.226830.220830.22683
36G3R10Internal company problems (at consultant company’s head office)0.535720.604770.509800.323750.272800.32375
Contractor-Related Risks
37G4R1Inadequate contractor experience (lack of experience, and managerial skills) 0.724130.82260.731150.59580.52980.5958
38G4R2Contractor’s financial difficulties (ineffective cash flow management) 0.78920.87610.75670.69210.59730.6921
39G4R3Contractor’s poor site management and supervision 0.731120.82260.720190.60170.526110.6017
40G4R4Ineffective planning and scheduling of project by contractor0.75650.82930.698310.62740.52890.6274
41G4R5Ineffective control of the project progress0.676280.782210.676420.529250.457310.52925
42G4R6Delays in sub-contractors’ work or caused by suppliers0.74590.789170.636510.58890.474240.5889
43G4R7Delay in preparation of shop drawings and material samples0.709180.782210.604620.554160.428450.55416
44G4R8Delay in site mobilization. 0.662370.698490.524770.462410.347630.46244
45G4R9Rework and wastage on site, due to errors or quality of work (poor quality of workmanship)0.665330.749310.680390.498300.453340.49834
46G4R10Variations in quantities0.684240.629730.731150.430470.500180.50033
47G4R11Cost of penalties0.589530.582780.622540.343710.366560.36669
48G4R12The contractor does not carry out a field visit to the site during the bidding process 0.655390.724400.695330.474380.455330.47442
49G4R13New existing underground utilities not mentioned on the design documents (e.g., live cables and pipelines) 0.676280.793140.75670.536210.512150.53621
50G4R14Health and Safety requirements (in light of COVID-19) 0.589530.629730.585700.371660.345640.37168
51G4R15Accidents on site 0.524740.524810.509800.274810.267810.27481
52G4R16Conflict between contractor and consultant 0.702190.735370.622540.516280.436400.51630
53G4R17Tender-winning prices are unrealistically low (suicide tendering) 0.640440.804120.749100.514290.479210.51431
54G4R18Unavailability of incentives for contractor for finishing ahead of schedule or to reduce the cost0.720150.673610.625520.484330.450350.48437
Labour-Related Risks
55G5R1Shortage of manpower (skilled, semi-skilled, and unskilled) 0.75370.807100.705280.60860.53170.6086
56G5R2Unqualified/inexperienced workers 0.74590.789170.735130.58890.54860.5889
57G5R3Low productivity level of manpower/labourers 0.720150.807100.713250.581120.513140.58112
58G5R4Low payment for labour force 0.665330.640710.622540.426510.414480.42654
59G5R5Injuries to labourers on the construction site0.556680.545790.505820.303770.281790.30379
60G5R6Delayed salary payments to staff by the contractor 0.75370.735370.596650.553170.449370.55317
61G5R7High turn-over of personnel0.622470.651690.578720.405560.360590.40559
62G5R8Labour strikes0.498780.709450.622540.353690.310740.35371
Materials-Related Risks
63G6R1Shortage of construction materials—special building materials not available in the local market 0.509760.705460.655460.359670.333670.35970
64G6R2Delay in delivery of materials 0.622470.738350.607600.459420.378540.45945
65G6R3Delay in the special manufacture of building materials/equipment 0.673310.793140.647490.533230.435410.53323
66G6R4Delay in procurement of materials 0.680260.760270.604620.517270.410500.51729
67G6R5Damage to material in storage/at site 0.487800.618760.644500.301780.314730.31477
68G6R6Rejecting materials’ submittals 0.585580.713440.585700.417530.343650.41756
Equipment-Related Risks
69G7R1Inadequate or inefficient equipment, tools, and plants 0.582600.687530.604620.400570.351610.40060
70G7R2Equipment availability and failure 0.578630.676590.593680.391600.343660.39163
External Risks
71G8R1Economic instability 0.582600.738350.713250.429480.415470.42952
72G8R2High fluctuation in cost (e.g., money exchange rate; taxes and burdens; and interest rates charged by bankers on loan) 0.589530.662660.731150.390620.431440.43151
73G8R3Inflation (e.g., material, equipment, and labour prices) 0.607500.633720.720190.384640.437390.43749
74G8R4Changes in government regulations and laws (e.g., economy, tax, safety, environment, industrial, recruitment and workers’ visas, and localization) 0.604510.687530.720190.415550.435420.43550
75G8R5Delay in connecting services with external parties (e.g., electricity, water, sewage, etc.)0.695210.771240.625520.535220.434430.53522
76G8R6Delay in recruitment and workers’ visa approval0.589530.705460.596650.416540.351600.41657
77G8R7Corruption (fraudulent practices, kickbacks, and lack of respect for the law)0.560670.622750.687350.348700.385520.38566
78G8R8Legal disputes between various parties0.556680.680570.651480.378650.362580.37867
79G8R9Import/Export restrictions 0.516750.662660.618580.342730.319720.34273
Force Majeure Risks
80G9R1Earthquakes, fires, and floods 0.356830.702480.702300.250820.250820.25082
81G9R2Severe weather conditions0.509760.673610.578720.342720.294770.34272
82G9R3Wars in region/Political instability 0.425820.698490.680390.297790.289780.29780
83G9R4Spreading of disease, epidemic or pandemic (e.g., COVID-19) 0.589530.81590.76450.480360.450360.48040
Table A3. Risk Importance (RI) for risk factors of building construction projects and ranking, according to the perspective of the three groups of respondents.
Table A3. Risk Importance (RI) for risk factors of building construction projects and ranking, according to the perspective of the three groups of respondents.
NoCodeRisk FactorsClientConsultantContractorRI Overall
RIRankRIRankRIRankRIRank
Client-Related Risks
1G1R1Client’s lack of experience about the construction project. 0.504290.497400.438650.48239
2G1R2Excessive bureaucracy in owner’s administration. 0.538160.529320.581290.54518
3G1R3Client’s financial difficulties. 0.489340.566230.71360.54419
4G1R4Owner’s delay in making progress payments for completed works (payment delays). 0.63210.68020.80910.6722
5G1R5Selecting consultant, or designer, based on the lowest price. 0.527170.64090.70070.57514
6G1R6Contract awarded to the lowest bidder. 0.59360.67630.74340.6313
7G1R7Unrealistic/Inadequate original contract duration (tight schedule). 0.556130.577200.656130.57713
8G1R8Political pressure to complete the project and speed up construction processes. 0.397580.403620.474550.41358
9G1R9Delay in land acquisition/Handover to the contractor. 0.406550.315760.440640.39064
10G1R10Difficulties in obtaining work permits from the authorities. 0.450430.495420.595250.48635
11G1R11Change orders during construction. 0.59190.65760.675110.6274
12G1R12Scope of work reduction by owner during execution phase. 0.290770.308790.325780.30778
13G1R13Delay penalty clause in the Saudi Public Works Contract is inefficient. 0.508270.308780.281810.39661
14G1R14Inaccurate estimation of construction cost by owner.0.523200.530310.578310.52727
15G1R15Project suspension by owner.0.413520.432540.532390.43947
16G1R16Delays due to dispute resolution. 0.435440.64680.619190.53124
Designer-Related Risks
17G2R1Unclear and inadequate drawings, specifications, bills of quantities (BOQ)0.59270.586160.638150.58211
18G2R2Discrepancies between project documents (contract, BOQ, specifications, and drawings). 0.472380.511370.574330.48536
19G2R3Mistakes and deficiencies in design documents. 0.486350.505380.520420.48338
20G2R4Inaccurately estimated quantities (BOQ). 0.524190.505380.638150.51928
21G2R5All existing underground utilities information not available on the design documents (e.g., live cables and pipelines) for the contractor. 0.508270.596130.495500.53720
22G2R6Inadequate geotechnical investigations report about ground conditions of the project site (if available). 0.495320.566230.371720.50432
23G2R7Complexity of design.0.326720.361700.338770.32974
24G2R8Absence of contractor’s involvement in the design stage.0.362660.260820.316790.32276
25G2R9Speeding up of design phase’s schedule. 0.516230.459480.374710.46743
26G2R10Limited budget for design.0.429460.459470.471570.43848
Consultant-Related Risks
27G3R1Lack of experience and competence of consultant’s staff. 0.499300.596140.540380.52826
28G3R2Slowness decision making for approval (shop drawings, submittals, sample materials, change orders, etc.) 0.520210.620110.598230.56815
29G3R3Consultant’s rejection of submittals (shop drawings, equipment, and material samples). 0.430450.411600.471570.42953
30G3R4Consultant’s delay in performing inspection and testing and giving instructions.0.378640.404610.453590.39462
31G3R5Poor coordination and communication between consultant and other parties.0.427480.586160.531400.47941
32G3R6Poor quality control and assurance.0.464390.490430.446630.45546
33G3R7Consultant’s corruption.0.394600.517360.413680.42455
34G3R8Inflexibility (rigidity) of consultant.0.359670.381660.516430.38965
35G3R9Excessive safety consideration. 0.227820.227830.273830.22683
36G3R10Internal company problems (at consultant company’s head office).0.257790.449510.344760.32375
Contractor-Related Risks
37G4R1Inadequate contractor experience (lack of experience, and managerial skills). 0.569110.66640.574330.5958
38G4R2Contractor’s financial difficulties (ineffective cash flow management). 0.62720.79810.76320.6921
39G4R3Contractor’s poor site management and supervision. 0.59270.66450.553360.6017
40G4R4Ineffective planning and scheduling of project by contractor.0.59850.65770.67890.6274
41G4R5Ineffective control of the project progress.0.556120.552290.453590.52925
42G4R6Delays in sub-contractors work or due to suppliers.0.570100.562270.675110.5889
43G4R7Delay in preparation of shop drawings and material samples.0.526180.595150.616200.55416
44G4R8Delay in site mobilization 0.489330.473450.375700.46244
45G4R9Rework and wastage on site, due to errors or quality of work (poor quality of workmanship).0.456410.521340.591280.49834
46G4R10Variations in quantities.0.511250.520350.508450.50033
47G4R11Cost of penalties. 0.369650.400630.300800.36669
48G4R12The contractor does not carry out a field visit to the site during the bidding process. 0.499300.465460.488530.47442
49G4R13New existing underground utilities not mentioned on the design documents (e.g., live cables, pipelines). 0.518220.566230.580300.53621
50G4R14Health and Safety requirements (in light of COVID-19). 0.338700.364690.506460.37168
51G4R15Accidents on site. 0.250810.284800.413670.27481
52G4R16Conflict between contractor and consultant.0.464400.579180.595250.51630
53G4R17Tender-winning prices are unrealistically low (suicide tendering). 0.481360.557280.595250.51431
54G4R18Unavailability of incentives for contractor for finishing ahead of schedule or to reduce the cost.0.410540.497400.74430.48437
Labour-Related Risks
55G5R1Shortage of manpower (skilled, semi-skilled, and unskilled).0.61630.612120.67890.6086
56G5R2Unqualified/inexperienced workers. 0.61040.579190.630170.5889
57G5R3Low productivity level of manpower/labourers. 0.553140.629100.616200.58112
58G5R4Low payment for labour force. 0.429470.422570.523410.42654
59G5R5Injuries to labourers on the construction site.0.292760.309770.359740.30379
60G5R6Delayed salary payments to staff by the contractor. 0.548150.562260.68080.55317
61G5R7High turnover of personnel.0.419490.387650.489520.40559
62G5R8Labour strikes. 0.320730.397640.474550.35371
Materials-Related Risks
63G6R1Shortage of construction materials—special building materials not available in the local market. 0.327710.373680.495500.35970
64G6R2Delay in delivery of materials. 0.454420.436530.578310.45945
65G6R3Delay in the special manufacture of building materials/equipment. 0.512240.568220.598230.53323
66G6R4Delay in procurement of materials. 0.509260.552290.560350.51729
67G6R5Damage to material in storage/at site. 0.339690.315750.281810.31477
68G6R6Rejecting materials’ submittals. 0.412530.375670.553360.41756
Equipment-Related Risks
69G7R1Inadequate or inefficient equipment, tools, and plants. 0.418510.350720.504470.40060
70G7R2Equipment availability and failure. 0.404560.338730.504470.39163
External Risks
71G8R1Economic instability. 0.386620.442520.613220.42952
72G8R2High fluctuation in cost (e.g., money exchange rate; taxes and burdens; and interest rates charged by bankers on loan). 0.378630.422580.630170.43151
73G8R3Inflation (e.g., material, equipment and labour prices). 0.403570.459490.503490.43749
74G8R4Changes in government regulations and laws (e.g., economy, tax, safety, environment, industrial, recruitment and workers’ visas, and localisation). 0.418500.450500.453590.43550
75G8R5Delay in connecting services with external parties (e.g., electricity, water, sewage, etc.)0.473370.570210.656130.53522
76G8R6Delay in recruitment and workers’ visa approval.0.355680.474440.516430.41657
77G8R7Corruption (fraudulent practices, kickbacks, and lack of respect for law).0.396590.414590.356750.38566
78G8R8Legal disputes between various parties.0.313750.432540.488530.37867
79G8R9Import/export restrictions. 0.320730.359710.450620.34273
Force Majeure Risks
80G9R1Earthquakes, fires, and floods. 0.225830.277810.360730.25082
81G9R2Severe weather conditions.0.267780.424560.435660.34272
82G9R3Wars in region/political instability. 0.252800.334740.407690.29780
83G9R4Spreading of disease, epidemic, or pandemic (e.g., COVID-19). 0.386610.523330.73650.48040

References

  1. Luong, D.; Tran, D.; Nguyen, P. Optimizing multi-mode time-cost-quality trade-off of construction project using opposition multiple objective difference evolution. Int. J. Constr. Manag. 2018, 21, 271–283. [Google Scholar] [CrossRef]
  2. Memon, A.H.; Rahman, I.A.; Abdullah, M.R.; Aziz, A.A.A. Time Overrun in Construction Projects from the Perspective of Project Management Consultant (PMC). J. Surv. Constr. Prop. 2011, 2, 1–13. [Google Scholar] [CrossRef] [Green Version]
  3. Lotfi, R.; Yadegari, Z.; Hosseini, S.; Khameneh, A.; Tirkolaee, E.; Weber, G. A robust time-cost-quality-energy-environment trade-off with resource-constrained in project management: A case study for a bridge construction project. J. Ind. Manag. Optim. 2022, 18, 375. [Google Scholar] [CrossRef]
  4. Iqbal, S.; Choudhry, R.; Holschemacher, K.; Ali, A.; Tamošaitienė, J. Risk management in construction projects. Technol. Econ. Dev. Econ. 2015, 21, 65–78. [Google Scholar] [CrossRef]
  5. Maqsoom, A.; Choudhry, R.; Umer, M.; Mehmood, T. Influencing factors indicating time delay in construction projects: Impact of firm size and experience. Int. J. Constr. Manag. 2019, 21, 1251–1262. [Google Scholar] [CrossRef]
  6. Yap, J.; Goay, P.; Woon, Y.; Skitmore, M. Revisiting critical delay factors for construction: Analysing projects in Malaysia. Alex. Eng. J. 2021, 60, 1717–1729. [Google Scholar] [CrossRef]
  7. Assaf, S.A.; Al-Hejji, S. Causes of delay in large construction projects. Int. J. Proj. Manag. 2006, 24, 349–357. [Google Scholar] [CrossRef]
  8. Kaliba, C.; Muya, M.; Mumba, K. Cost escalation and schedule delays in road construction projects in Zambia. Int. J. Proj. Manag. 2009, 27, 522–531. [Google Scholar] [CrossRef]
  9. Arditi, D.; Akan, G.T.; Gurdamar, S. Reasons for delays in public projects in Turkey. Constr. Manag. Econ. 1985, 3, 171–181. [Google Scholar] [CrossRef]
  10. Kraiem, Z.M.; Diekmann, J.E. Concurrent Delays in Construction Projects. J. Constr. Eng. Manag. 1987, 113, 591–602. [Google Scholar] [CrossRef]
  11. Azhar, N.; Farouqui, R.U. Cost Overrun Factors in Construction Industry of Pakistan. In Proceedings of the First International Conference on Construction in Developing Countries (ICCIDC–I) “Advancing and Integrating Construction Education, Research & Practice”, Karachi, Pakistan, 4–5 August 2008. [Google Scholar]
  12. Wang, M.-T.; Chou, H.-Y. Risk Allocation and Risk Handling of Highway Projects in Taiwan. J. Manag. Eng. 2003, 19, 60–68. [Google Scholar] [CrossRef]
  13. Barrie, D.S.; Paulson, B.C., Jr. Professional Construction Management: Including Contracting CM, Design-Construct, and General Contracting; McGraw-Hill: New York, NY, USA, 1992. [Google Scholar]
  14. Allahaim, F.S.; Liu, L. Causes of cost overruns on infrastructure projects in Saudi Arabia. Int. J. Collab. Enterp. 2015, 5, 32. [Google Scholar] [CrossRef]
  15. Seddeeq, A.; Assaf, S.; Abdallah, A.; Hassanain, M. Time and Cost Overrun in the Saudi Arabian Oil and Gas Construction Industry. Buildings 2019, 9, 41. [Google Scholar] [CrossRef] [Green Version]
  16. Long, R.J. Typical Problems Leading to Delays, Cost Overruns, and Claims on Process Plant and O Shore Oil and Gas Projects. Available online: https://www.long-intl.com/wp-content/uploads/2014/02/Long-Intl-Typical-Problems-Leading-to-Delays-Cost-Overruns-Claims.pdf (accessed on 9 July 2021).
  17. Abdellatif, H.; Alshibani, A. Major Factors Causing Delay in the Delivery of Manufacturing and Building Projects in Saudi Arabia. Buildings 2019, 9, 93. [Google Scholar] [CrossRef] [Green Version]
  18. Mahamid, I.; Laissy, M. Time Overrun in Construction of Road Projects in Developing Countries: Saudi Arabia as a Case Study. Int. J. Eng. Inf. Syst. (IJEAIS) 2019, 3, 18–23. [Google Scholar]
  19. Velumani, P.; Nampoothiri, N.; Urbański, M. A Comparative Study of Models for the Construction Duration Prediction in Highway Road Projects of India. Sustainability 2021, 13, 4552. [Google Scholar] [CrossRef]
  20. Khalifa, W.M.A.; Mahamid, I. Causes of Change Orders in Construction Projects. Eng. Technol. Appl. Sci. Res. 2019, 9, 4956–4961. [Google Scholar] [CrossRef]
  21. Dixit, S.; Sharma, K.; Singh, S. Identifying and Analysing Key Factors Associated with Risks in Construction Projects. In Emerging Trends in Civil Engineering; Springer: Singapore, 2020; pp. 25–32. [Google Scholar] [CrossRef]
  22. Kartam, N.A.; Kartam, S.A. Risk and its management in the Kuwaiti construction industry: A contractors’ perspective. Int. J. Proj. Manag. 2001, 19, 325–335. [Google Scholar] [CrossRef]
  23. Ranns, R.H.B.; Ranns, E.J.M. Practical Construction Management, 1st ed.; Routledge: Oxfordshire, UK, 2016; p. 4. [Google Scholar]
  24. Global Construction Outlook to 2023—Q3 2019 Update. Available online: https://www.reportlinker.com/p05582683/Global-Construction-Outlook-to-Q3-Update.html?utm_source=PRN (accessed on 16 December 2021).
  25. Future-Ready Index. Global Construction Survey 2019. Available online: https://assets.kpmg/content/dam/kpmg/xx/pdf/2019/04/global-construction-survey-2019.pdf (accessed on 15 December 2021).
  26. Global Construction 2030: A Global Forecast for the Construction Industry to 2030. Available online: https://www.pwc.com/vn/en/industries/engineering-and-construction/pwc-global-construction-2030.html (accessed on 12 December 2021).
  27. Robinson, G. Global Construction Market to Grow $8 trillion by 2030: Driven by China, US and India. Global Construction Perspectives and Oxford Economics, UK. Available online: https://www.ice.org.uk/ICEDevelopmentWebPortal/media/Documents/News/ICE%20News/Global-Construction-press-release.pdf (accessed on 16 December 2021).
  28. Meisels, M. 2018 Global Construction Industry Overview. Global Construction Industry: A Positive Outlook. Deloitte Report (GPOC). Available online: https://www2.deloitte.com/us/en/pages/energy-and-resources/articles/global-construction-industry-overview.html (accessed on 14 December 2021).
  29. Impact of COVID-19 on the Construction Sector. 2021. Available online: https://www.ilo.org/wcmsp5/groups/public/---ed_dialogue/---sector/documents/briefingnote/wcms_767303.pdf (accessed on 28 August 2021).
  30. COVID-19’s Impact on the Engineering & Construction Sector|Deloitte Global. Deloitte. 2021. Available online: https://www2.deloitte.com/global/en/pages/about-deloitte/articles/covid-19/understanding-the-sector-impact-of-covid-19--engineering---const.html (accessed on 28 August 2021).
  31. Mordor Intelligence. Saudi Arabia Construction Market—Growth, Trends, and Forecast (2019–2024). Available online: https://www.mordorintelligence.com/industry-reports/saudi-arabia-construction-market-growth-trends-and-forecast-2019-2024 (accessed on 19 December 2021).
  32. Davids, G. Potential for Construction Sector in GCC—Linesight. Available online: https://meconstructionnews.com/36485/ksa-holds-greatest-potential-for-construction-sector-in-gcc-linesight (accessed on 19 December 2021).
  33. Almutairi, Y.; Arif, M.; Khalfan, M. Moving towards managing offsite construction techniques in the Kingdom of Saudi Arabia: A review. Middle East J. Manag. 2016, 3, 164. [Google Scholar] [CrossRef]
  34. Algahtany, A.; Alhammadi, Y.; Kashiwagi, D. Introducing a New Risk Management Model to the Saudi Arabian Construction Industry. Procedia Eng. 2016, 145, 940–947. [Google Scholar] [CrossRef]
  35. Alrashed, I.; Alrashed, A.; Taj, S.A.; Kantamaneni, M.P.K. Risk Assessments for Construction projects in Saudi Arabia. Res. J. Manag. Sci. 2014, 3, 1–6. [Google Scholar]
  36. Research & Markets. Construction in Saudi Arabia—Key Trends and Opportunities to 2025 (Q2 2021). 2021. Available online: https://www.researchandmarkets.com/reports/5367699/construction-in-saudi-arabia-key-trends-and?utm_source=BW&utm_medium=PressRelease&utm_code=rbmm66&utm_campaign=1566018+-+Saudi+Arabia+Construction+Market+Report+2021%3a+Key+Trends+and+Opportunities+to+2025%2c+Q2+2021+Update&utm_exec=chdo54prd (accessed on 7 September 2021).
  37. Puri-Mirza, A. Saudi Arabia: Growth Value of Planned Construction Contract Awards 2022|Statista. 2021. Available online: https://www.statista.com/statistics/1100182/saudi-arabia-growth-value-of-plannned-construction-contract-awards/ (accessed on 7 September 2021).
  38. Puri-Mirza, A. Saudi Arabia: Value of Planned Buildings Contract Awards 2022|Statista. 2021. Available online: https://www.statista.com/statistics/1100216/saudi-arabia-value-of-planned-buildings-contract-awards/ (accessed on 7 September 2021).
  39. MOMRA. Contractors Classification Agency. Available online: https://contractors.momra.gov.sa (accessed on 12 December 2021).
  40. Silva, G.A.; Warnakulasooriya, B.N.F.; Arachchige, B. Criteria for Construction Project Success: A Literature Review. In Proceedings of the University of Sri Jayewardenepura, Sri Lanka, 13th International Conference on Business Management (ICBM), Nugegoda, Sri Lanka, 8 December 2016; Available online: https://ssrn.com/abstract=2910305 (accessed on 17 December 2021).
  41. Ramlee, N.; Tammy, N.J.; Raja Mohd Noor, R.N.; Ainun Musir, A.; Abdul Karim, N.; Chan, H.B.; Mohd Nasir, S.R. Critical success factors for construction project. AIP Conf. Proc. 2016, 1774, 030011. [Google Scholar]
  42. Alzara, M.; Kashiwagi, J.; Kashiwagi, D.; Al-Tassan, A. Using PIPS to Minimize Causes of Delay in Saudi Arabian Construction Projects: University Case Study. Procedia Eng. 2016, 145, 932–939. [Google Scholar] [CrossRef]
  43. Baghdadi, A.; Kishk, M. Saudi Arabian Aviation Construction Projects: Identification of Risks and Their Consequences. Procedia Eng. 2015, 123, 32–40. [Google Scholar] [CrossRef] [Green Version]
  44. Mahamid, I. Schedule Delay in Saudi Arabia Road Construction Projects: Size, Estimate, Determinants and Effects. Int. J. Arch. Eng. Constr. 2017, 6, 51–58. [Google Scholar] [CrossRef] [Green Version]
  45. Sha’Ar, K.; Assaf, S.; Bambang, T.; Babsail, M.; El Fattah, A.A. Design—Construction interface problems in large building construction projects. Int. J. Constr. Manag. 2016, 17, 238–250. [Google Scholar] [CrossRef] [Green Version]
  46. Al-Emad, N.; Rahman, I.A.; Nagapan, S.; Gamil, Y. Ranking of Delay Factors for Makkah’s Construction Industry. MATEC Web Conf. 2017, 103, 3001. [Google Scholar] [CrossRef] [Green Version]
  47. Arditi, D.; Nayak, S.; Damci, A. Effect of organizational culture on delay in construction. Int. J. Proj. Manag. 2017, 35, 136–147. [Google Scholar] [CrossRef]
  48. Elawi, G.S.A.; Algahtany, M.; Kashiwagi, D. Owners’ Perspective of Factors Contributing to Project Delay: Case Studies of Road and Bridge Projects in Saudi Arabia. Procedia Eng. 2016, 145, 1402–1409. [Google Scholar] [CrossRef] [Green Version]
  49. Sánchez, O.; Castañeda, K.; Mejía, G.; Pellicer, E. Delay Factors: A Comparative Analysis between Road Infrastructure and Building Projects. In Proceedings of the Construction Research Congress, Tempe, AZ, USA, 8–10 March 2020; pp. 223–231. [Google Scholar] [CrossRef]
  50. Sanni-Anibire, M.O.; Zin, R.M.; Olatunji, S.O. Causes of Delay in Tall Building Projects in GCC Countries. In Proceedings of the 8th International Conference on Construction Engineering and Project Management, Hong Kong, China, 7–8 December 2020. [Google Scholar]
  51. Mohammed Gopang, R.K.; Alias Imran, Q.B.; Nagapan, S. Assessment of Delay Factors in Saudi Arabia Railway/Metro Construction Projects. Int. J. Sustain. Constr. Eng. Technol. 2020, 11, 225–233. [Google Scholar] [CrossRef]
  52. Aljohani, A. Construction Projects Cost Overrun: What Does the Literature Tell Us? Int. J. Innov. Manag. Technol. 2017, 8, 137–143. [Google Scholar] [CrossRef]
  53. Ahady, S.; Gupta, S.; Malik, R.K. A critical review of the causes of cost overrun in construction industries of developing countries. Int. Res. J. Eng. Technol. 2017, 4, 2550–2558. [Google Scholar]
  54. Bahamid, R.A.; Doh, S.I.; Al-Sharaf, M.A. Risk factors affecting the construction projects in the developing countries. IOP Conf. Ser. Earth Environ. Sci. 2019, 244, 012040. [Google Scholar] [CrossRef]
  55. Baloyi, L.; Bekker, M. Causes of construction cost and time overruns: The 2010 FIFA World Cup stadia in South Africa. Acta Structilia J. Phys. Dev. Sci. 2011, 18, 51–67. [Google Scholar]
  56. Cirovic, G.; Sudjic, S. Risk Assessment in Construction Industry. Available online: https://www.irbnet.de/daten/iconda/CIB15854.pdf (accessed on 11 December 2019).
  57. Creedy, G.D.; Skitmore, M.; Wong, J.K.W. Evaluation of risk factors leading to cost overrun in delivery of highway construction projects. J. Constr. Eng. Manag. 2010, 136, 528–537. [Google Scholar] [CrossRef] [Green Version]
  58. Jackson, S. Project cost overruns and risk management. In Proceedings of the Association of Researchers in Construction Management 18th Annual ARCOM Conference, Newcastle, UK, 2–4 September 2002; Volume 1, pp. 99–108. [Google Scholar]
  59. Liu, J.; Zhao, X.; Yan, P. Risk Paths in International Construction Projects: Case Study from Chinese Contractors. J. Constr. Eng. Manag. 2016, 142, 05016002. [Google Scholar] [CrossRef]
  60. Mahamid, I.; Al-Ghonamy, A.; Aichouni, M. Risk Matrix for Delay Causes in Construction Projects in Saudi Arabia. Res. J. Appl. Sci. Eng. Technol. 2015, 9, 665–670. [Google Scholar] [CrossRef]
  61. Memon, A.H.; Rahman, I.A.; Azis, A.A.A. Time and Cost Performance in Construction Projects in Southern and Central Regions of Peninsular Malaysia. Int. J. Adv. Appl. Sci. 2012, 1, 45–52. [Google Scholar] [CrossRef]
  62. Sharma, S.; Goyal, P.K. Fuzzy assessment of the risk factors causing cost overrun in construction industry. Evol. Intell. 2019, 1–13. [Google Scholar] [CrossRef]
  63. Subramani, T.; Sruthi, P.; Kavitha, M. Causes of Cost Overrun in Construction. IOSR J. Eng. 2014, 3, 1–7. [Google Scholar] [CrossRef]
  64. Zewdu, Z.T.; Aregaw, G.T. Causes of Contractor Cost Overrun in Construction Projects: The Case of Ethiopian Construction Sector. Int. J. Bus. Econ. Res. 2015, 4, 180. [Google Scholar] [CrossRef] [Green Version]
  65. Zhao, X.; Hwang, B.G.; Gao, Y. A fuzzy synthetic evaluation approach for risk assessment: A case of Singapore’s green projects. J. Clean. Prod. 2016, 115, 203–213. [Google Scholar] [CrossRef]
  66. Saunders, M.; Lewis, P.; Thornhill, A. Research Methods for Business Students, 8th ed.; Pearson: New York, NY, USA, 2019. [Google Scholar]
  67. Taber, K.S. The use of Cronbach’s alpha when developing and reporting research instruments in science education. Res. Sci. Educ. 2018, 48, 1273–1296. [Google Scholar] [CrossRef]
  68. Alsuliman, J.A. Causes of delay in Saudi public construction projects. Alex. Eng. J. 2019, 58, 801–808. [Google Scholar] [CrossRef]
  69. Ikediashi, D.I.; Ogunlana, S.O.; Alotaibi, A. Analysis of project failure factors for infrastructure projects in Saudi Arabia: A multivariate approach. J. Constr. Dev. Ctries. 2014, 19, 35. [Google Scholar]
  70. Al-Khalil, M.I.; Al-Ghafly, M.A. Important causes of delay in public utility projects in Saudi Arabia. Constr. Manag. Econ. 1999, 17, 647–655. [Google Scholar] [CrossRef]
  71. Shash, A.A.; Qarra, A.A. Cash flow management of construction projects in Saudi Arabia. Proj. Manag. J. 2018, 49, 48–63. [Google Scholar] [CrossRef]
  72. Le-Hoai, L.; Dai Lee, Y.; Lee, J.Y. Delay and cost overruns in Vietnam large construction projects: A comparison with other selected countries. KSCE J. Civ. Eng. 2008, 12, 367–377. [Google Scholar] [CrossRef]
  73. Abd El-Razek, M.E.; Bassioni, H.A.; Mobarak, A.M. Causes of delay in building construction projects in Egypt. J. Constr. Eng. Manag. 2008, 134, 831–841. [Google Scholar] [CrossRef] [Green Version]
  74. Albogamy, A.; Scott, D.; Dawood, N. Addressing construction delays in the Kingdom of Saudi Arabia. Int. Proc. Econ. Dev. Res. 2012, 45, 148–153. [Google Scholar]
  75. Koushki, P.A.; Al-Rashid, K.; Kartam, N. Delays and cost increases in the construction of private residential projects in Kuwait. Constr. Manag. Econ. 2005, 23, 285–294. [Google Scholar] [CrossRef]
  76. Assaf, S.A.; Al-Khalil, M.; Al-Hazmi, M. Causes of Delay in Large Building Construction Projects. J. Manag. Eng. 1995, 11, 45–50. [Google Scholar] [CrossRef]
  77. Hammadi, S.; Nawab, M. Study of Delay Factors in Construction Projects. Int. Adv. Res. J. Sci. Eng. Technol. 2016, 3, 87–93. [Google Scholar] [CrossRef]
  78. Arain, F.M.; Pheng, L.S.; Assaf, S.A. Contractors’ Views of the Potential Causes of Inconsistencies between Design and Construction in Saudi Arabia. J. Perform. Constr. Facil. 2006, 20, 74–83. [Google Scholar] [CrossRef] [Green Version]
  79. Babalola, O.; Ibem, E.; Ezema, I. Implementation of lean practices in the construction industry: A systematic review. Build. Environ. 2019, 148, 34–43. [Google Scholar] [CrossRef]
  80. Bajjou, M.S.; Chafi, A. Lean construction implementation in the Moroccan construction industry: Awareness, benefits and barriers. J. Eng. Des. Technol. 2018, 16, 533–556. [Google Scholar] [CrossRef]
  81. Sarhan, J.; Xia, B.; Fawzia, S.; Karim, A.; Olanipekun, A. Barriers to implementing lean construction practices in the Kingdom of Saudi Arabia (KSA) construction industry. Constr. Innov. 2018, 18, 246–272. [Google Scholar] [CrossRef] [Green Version]
  82. Jagtap, M.; Kamble, S. The effect of the client–contractor relationship on project performance. Int. J. Product. Perform. Manag. 2019, 69, 541–558. [Google Scholar] [CrossRef]
  83. Aliakbarlou, S.; Wilkinson, S.; Costello, S. Rethinking client value within construction contracting services. Int. J. Manag. Proj. Bus. 2018, 11, 1007–1025. [Google Scholar] [CrossRef]
Figure 1. Research methodology process.
Figure 1. Research methodology process.
Buildings 12 00902 g001
Table 1. Participants’ demographic details.
Table 1. Participants’ demographic details.
CategoryRespondent NumberPercentageCategoryRespondent NumberPercentage
Years of Experience Sector/Entity
Less than 5 years11.82%Public sector3054.55%
6–15 years1934.55%Private sector1934.55%
16–25 years2647.27%Semi-government sector35.45%
More than 25 years916.36%Academic and research institutions35.45%
100.00% 100.00%
Educational Background Role
Civil Engineering3360.00%Owner/government agency 2749.09%
Architecture712.73%Designer23.64%
Electrical Engineering59.09%Consultant1629.09%
Mechanical Engineering1018.18%Contractor814.55%
Others23.64%
100.00% 100.00%
Table 2. Performance of building construction projects.
Table 2. Performance of building construction projects.
Project DelaysProject Cost Overruns
CategoryRespondent NumberPercentageCategoryRespondent NumberPercentage
% Projects Exposed to Delays% of Projects Exposed to Cost Overruns
Never00Never11.82%
Less than 10%11.82%Less than 10%1120.00%
11–20%916.36%11–20%1120.00%
21–30% 47.27%21–30% 1323.64%
31–40%1120.00%31–40%916.36%
More than 40%3054.55%More than 40%1018.18
55100.00% 55100.00%
Average delay %Average cost overruns %
Never00%Never11.82%
Less than 10%11.82%Less than 5%610.91%
11–20%1018.18%6–10%1934.55%
21–30% 1934.55%11–15%1018.18%
31–40%1018.18%16–20%814.55%
More than 40%1527.27%21–25%814.55%
More than 25%35.45%
55100.00% 55100.00%
Table 3. Top 10 Risk factors that lead to delay and cost overruns in building construction projects.
Table 3. Top 10 Risk factors that lead to delay and cost overruns in building construction projects.
NoCodeRisk FactorsRisk ImportanceCategory
Project DelayProject Cost OverrunsOverall
RIRankRIRankRIRank
38G4R2Contractor’s financial difficulties (ineffective cash flow management)0.69210.59730.6921Contractor-related
4G1R4Owner’s delay in making progress payments for completed works (Payment delays)0.67220.525120.6722Client-related
6G1R6Contract awarded to lowest bidder0.63130.60120.6313
11G1R11Change orders during construction0.62740.62210.6274
40G4R4Ineffective planning and scheduling of project by contractor0.62750.52890.6275Contractor-related
55G5R1Shortage of manpower (skilled, semi-skilled, unskilled)0.60860.53170.6086Labour-related
39G4R3Contractor’s poor site management and supervision0.60170.526110.6017Contractor-related
37G4R1Inadequate contractor experience (lack of experience, and managerial skills)0.59580.52980.5958
42G4R6Delays in sub-contractors’ work or suppliers0.58890.474240.5889
56G5R2Unqualified/inexperienced workers.0.588100.54860.58810Labour-related
Table 4. The most important group of risk factors.
Table 4. The most important group of risk factors.
Group No.Risk Factor GroupRIRankCategory
G1Client-related Risks0.551Internal
G4Contractor-related Risks0.5052Internal
G5Labour-related Risks0.4773External
G2Designer-related Risks0.4554Internal
G6Materials-related Risks0.4315External
G3Consultant-related Risks0.4216Internal
G8External Risks0.3977External
G7Equipment-related Risks0.3958External
G9Force Majeure Risks0.3429External
Table 5. Reliability analysis (Cronbach’s alpha) for the risk factors.
Table 5. Reliability analysis (Cronbach’s alpha) for the risk factors.
Group No.Risk Factor GroupNo. of Risk FactorsProbability (P)Impact on Time (IT)Impact on Cost (IC)
ResultResultResult
G1Client-related Risks160.825Good0.813Good0.847Good
G2Designer-related Risks100.862Good0.824Good0.842Good
G3Consultant-related Risks100.866Good0.865Good0.897Good
G4Contractor-related Risks180.915Excellent0.906Excellent0.940Excellent
G5Labour-related Risks80.860Good0.847Good0.901Excellent
G6Materials-related Risks60.867Good0.884Good0.937Excellent
G7Equipment-related Risks220.853Good0.837Good0.841Good
G8External Risks90.873Good0.828Good0.877Good
G9Force Majeure Risks40.839Good0.864Good0.862Good
Overall0.9858Excellent
Table 6. Spearman’s rank correlation coefficient between parties **.
Table 6. Spearman’s rank correlation coefficient between parties **.
PartiesSpearman Rank Correlation Coefficient
Client and Consultant0.834
Client and Contractor0.653
Consultant and Contractor0.736
PartiesProbability
(P)
Impact (I)Risk Importance (RI)
Project DelayProject Cost
Overruns
Project DelayProject Cost OverrunsOverall
Client and Consultant0.8140.7780.7880.8170.8300.828
Client and Contractor0.6500.6330.4330.6550.3410.641
Consultant and Contractor0.7560.6830.6100.7650.5480.738
** Correlation is significant at the 0.01 level (2-tailed).
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Alshihri, S.; Al-Gahtani, K.; Almohsen, A. Risk Factors That Lead to Time and Cost Overruns of Building Projects in Saudi Arabia. Buildings 2022, 12, 902. https://doi.org/10.3390/buildings12070902

AMA Style

Alshihri S, Al-Gahtani K, Almohsen A. Risk Factors That Lead to Time and Cost Overruns of Building Projects in Saudi Arabia. Buildings. 2022; 12(7):902. https://doi.org/10.3390/buildings12070902

Chicago/Turabian Style

Alshihri, Saad, Khalid Al-Gahtani, and Abdulmohsen Almohsen. 2022. "Risk Factors That Lead to Time and Cost Overruns of Building Projects in Saudi Arabia" Buildings 12, no. 7: 902. https://doi.org/10.3390/buildings12070902

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
