Requirements Analysis for Development of Off-Site Construction Project Management System: Focusing on Precast Concrete Construction
Abstract
:1. Introduction
1.1. Background and Objectives of Research
1.2. Scope and Method of Research
2. Literature Review
2.1. OSC Project Management
2.2. OSC Project Management System

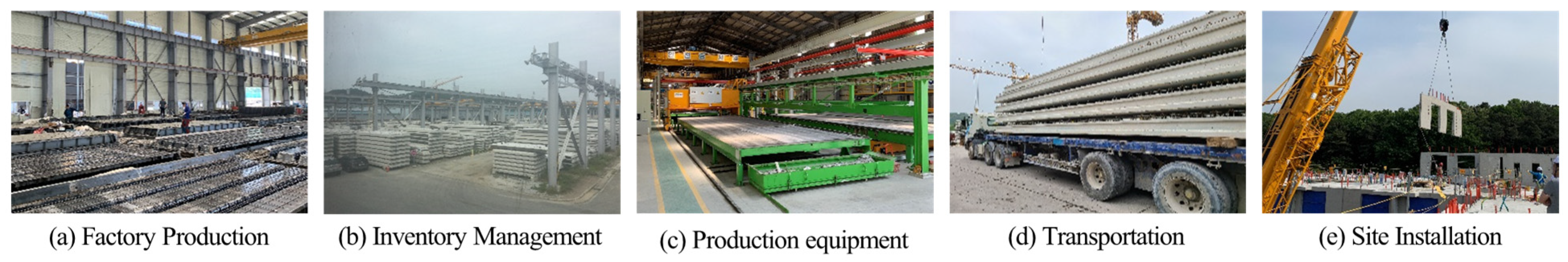

3. Analysis on Managerial Characteristics in OSC Projects

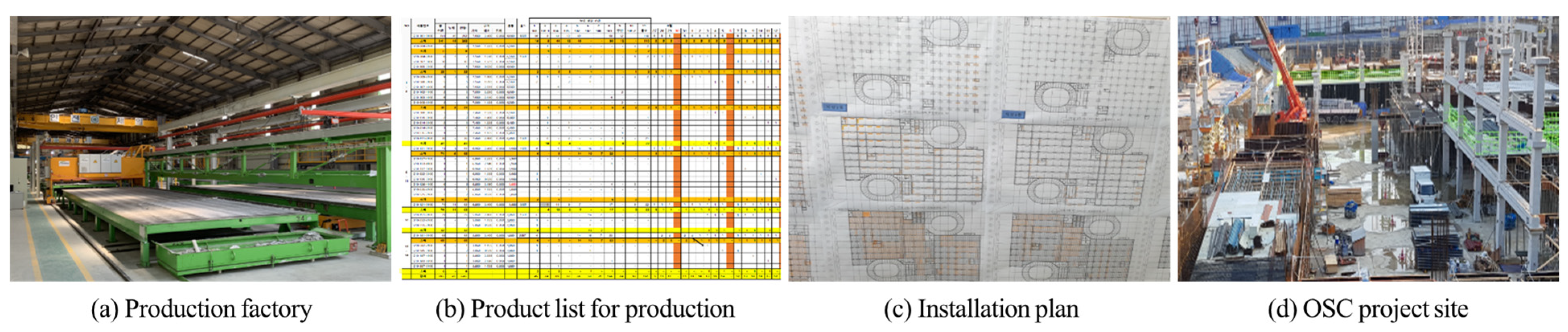

3.1. PC Construction Process Analysis
3.2. Managerial Characteristics of OSC Projects
3.2.1. Production Place and Time
3.2.2. Production Process
3.2.3. Production Method of Construction
3.2.4. Production Method
3.2.5. Production Entity and Facilities
3.2.6. Production Environment
4. Derivation of Requirements for Development of OSC Management System
4.1. System Development Requirements
4.1.1. Production Method Aspect
4.1.2. Aspect in Connection to Factory Production-Transport-Site Installation
4.1.3. Supply Chain Aspect
4.1.4. Equipment Plan and Management Aspect
4.1.5. Information Integration Aspect
4.2. Requirement Specification

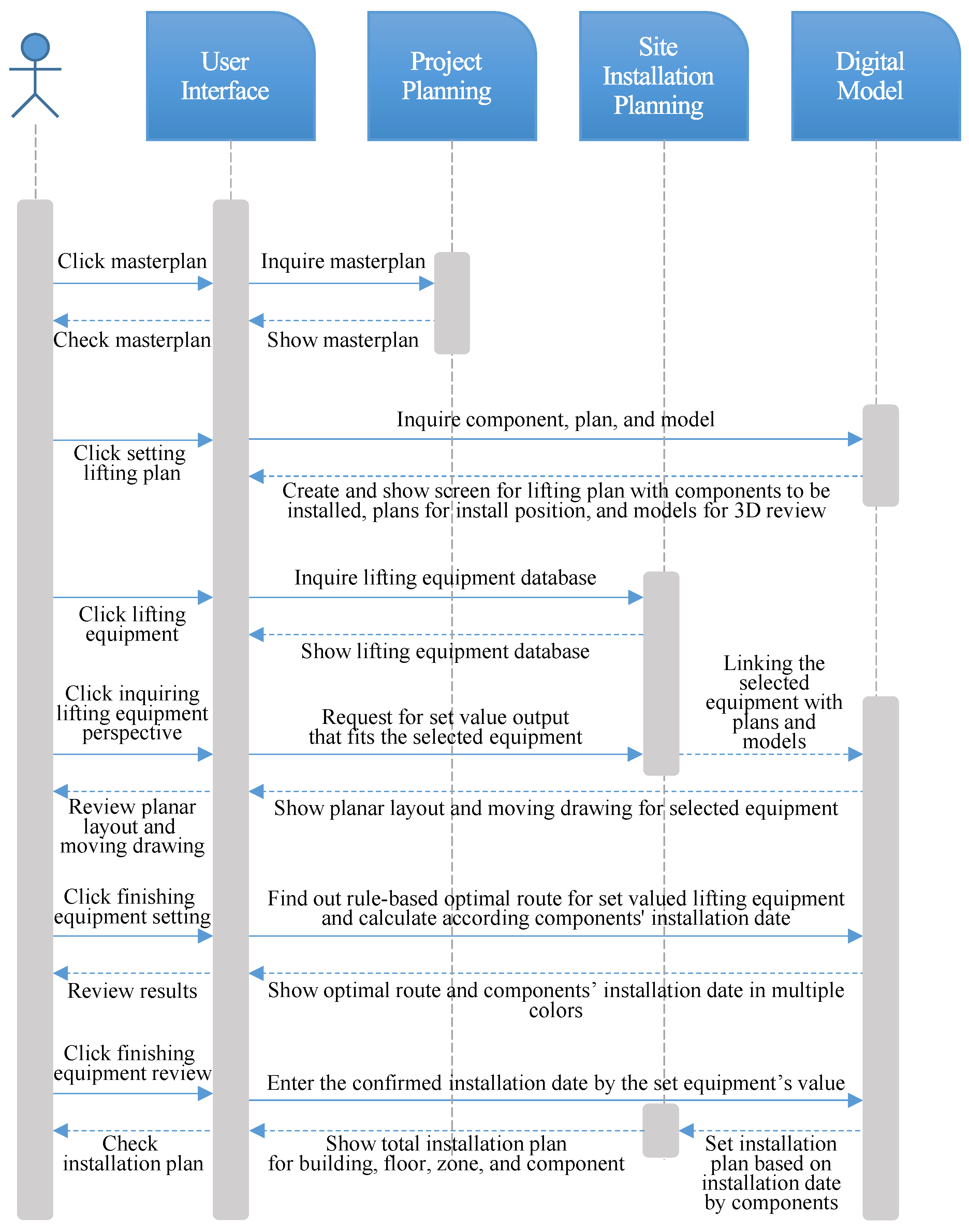

4.2.1. Establishment of Installation Plan
- (1)
- Inquire Masterplan: When a user selects the “Master Plan” menu to call the master plan, which is the basis for the installation plan, the result of the master plan is requested through the project planning module, which is displayed through the user interface.
- (2)
- Inquire Component, Plan, and Model: When a user selects the “Setting Lifting Plan” menu, the drawing to identify the installation location of lifting equipment, and the digital model of the building to review the lifting equipment are used from the database of the management system, displaying a screen showing the components to be installed and lifting equipment plan on the user interface.
- (3)
- Inquire Lifting Equipment Database: When a user selects the “Select Lifting Equipment” menu, the information on lifting equipment stored in the database is requested and outputted onto the user interface. When the user further selects one of the displayed information items on lifting equipment, and then the “Inquire and Select Specification of Lifting Equipment” menu, the specification data for the target equipment are presented, which are linked with the drawing and digital model called at the previous stage.
- (4)
- Find Out Rule-based Optimal Route: When a user selects the “Completion of Lifting Equipment Setting” menu, the lifting equipment plan, and the corresponding route and installation schedule of the lifting equipment are automatically established, considering the type, number of units, installation location, and duration of the equipment selected in the previous stage.
- (5)
- Enter the Confirmed Installation Date: When a user selects the “Completion of Lifting Equipment Review” menu, the installation plan for each component according to the lifting equipment plan set in the previous stage is updated to the digital model and site installation plan, and further displayed on the user interface. The user can select the component from the screen to adjust the schedule, or, conversely, request the date first to set the component. In this manner, this interactive function can be utilized to retrieve or modify the scheduled date of installation for each component.

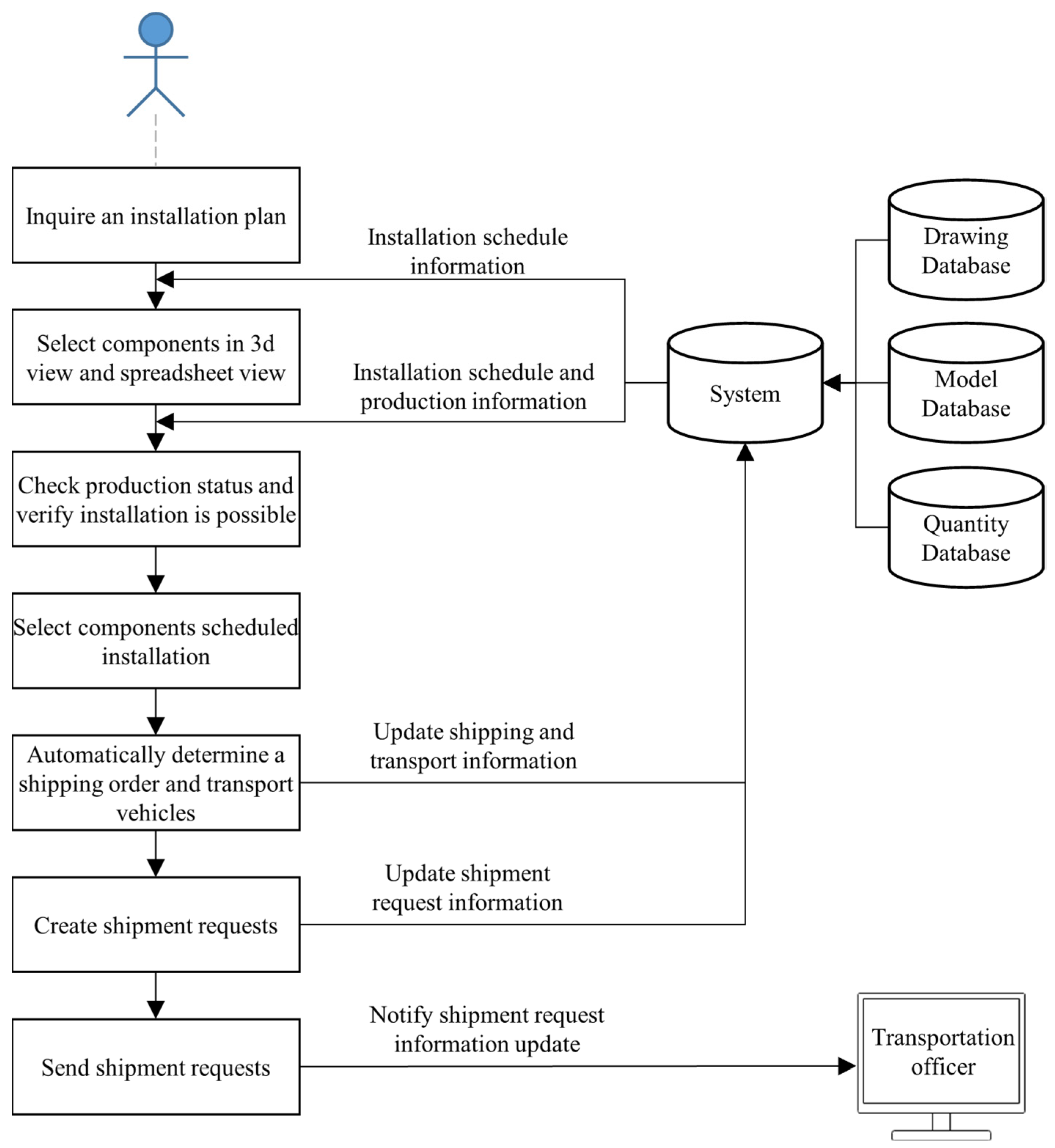

4.2.2. Request for Transport
- (1)
- Request an Installation Plan: When a user in the construction site selects the “Installation Plan” menu, the existing installation plan is inquired in the database of the system, which is displayed on the user interface in the format of 3D model or spreadsheet.
- (2)
- Select Components in 3D View and Spreadsheet View: The user selects the desired component from the inquiry results on the installation plan in a 3D model or spreadsheet format.
- (3)
- Check Production Status and Verify Installation is Possible: The user checks when the scheduled installation date of the selected components, and whether their production has been completed to determine when their installation is available.
- (4)
- Select Components Scheduled Installation: The user monitors the scheduled installation date of the selected components, and whether their production has been completed to finalize the selection of the components to be installed.
- (5)
- Automatically Determine a Shipping Order and Transport Vehicles: When the user selects “Shipping Request” menu, the management system automatically determines the sequence of receipts regarding the selected components and assigns the transport vehicle by considering the characteristics of the transport vehicle, as well as the size of the components. Furthermore, the system determines the sequence of transport of the vehicles and stores it into itself.
- (6)
- Create Shipment Requests: The management system automatically generates a transport request depending on the previously determined component, and the transport sequence of the vehicles, and stores the information in itself.
- (7)
- Send Shipment Requests: When the user selects the “Send Shipment Requests” menu, a notification for confirmation of shipment requests is sent to the transport manager in the factory.
4.3. Requirement Validation
