Article

Improving the Model for Estimating the Number of Construction Workers for Apartment Construction

Department of Safety Engineering, Seoul National University of Science and Technology, Seoul 01811, Republic of Korea
*
Author to whom correspondence should be addressed.
Sustainability 2023, 15(9), 7150; https://doi.org/10.3390/su15097150
Submission received: 27 February 2023 / Revised: 3 April 2023 / Accepted: 3 April 2023 / Published: 25 April 2023
(This article belongs to the Special Issue Sustainable Construction Management and Computer Simulation)

Abstract

:
Because the construction industry is labor-intensive, predicting the number of workers is important for estimating various factors that influence construction, such as the construction worker fatality rate and construction financing plan. In South Korea, the number of full-time workers is estimated based on the total construction cost; however, this estimation method does not reflect the characteristics of specific construction types. This study presents a simple model that uses real data to predict the number of construction workers and calculates correction factors in two ways to improve reliability. This study involved three steps: (1) collecting data, (2) calculating and validating the estimated labor rate, and (3) calculating correction factors. The model predicted the number of workers with an average error rate of 7.60% without correction factors. To improve reliability, this research suggests two-way correction factors, and the results show that correction factor one reduces the average error rate to 0.06% and correction factor two reduces the average error rate to 0.00%. The proposed model can be used for estimating project costs and predicting construction worker fatalities for a project.

1. Introduction

Construction is a labor-intensive industry. Therefore, the number of workers is used to calculate various factors, such as construction cost, duration, and number of safety breaches [1]. Therefore, many countries have tried to estimate the number of workers in different ways. In the United Kingdom, the number of construction workers is estimated through surveys and sampling inspections [2]. The number of construction workers in China is estimated in the same way as in the United Kingdom [3], whereas the number of construction workers in Singapore is estimated through a survey conducted by the Labor Force Survey [4]. In South Korea, the number of workers is calculated using an equation known as the full-time equivalent worker, according to South Korean law [5].
The number of workers is used for various reasons in the construction industry. The first is inspecting the fatality rate in South Korea, according to a report on industrial accidents in 2021 by the Korea Occupational Safety and Health Agency. The construction industry has a 1.13% injury rate and 1.75‱ fatality rate. Consequently, the construction industry is more dangerous than others [6]. Full-time equivalent workers, which are calculated using construction cost, labor ratio, and labor cost, are used to calculate the injury and fatality rates [7]. However, this is problematic because a fixed labor ratio is applied regardless of the type of construction. Therefore, this method produces unreliable results [8]. Hence, labor ratios that consider construction type must be developed. Many workers are involved in high-rise construction. High-rise construction involves various stages, such as earthwork, structural work, and finishing work. Among these stages, the structural work requires more labor-intensive tasks performed mainly by workers. Conversely, in road construction, construction machinery is primarily used, which reduces the number of required workers. Therefore, the number of workers required in high-rise construction is generally higher than in road construction [9]. Second, labor costs account for a significant portion of the total construction costs, typically 40–60% [10]. The labor ratio is an important factor in calculating labor costs. Therefore, the reliability and accuracy of the labor ratio are valuable factors for assessing the total construction cost [11,12]. As mentioned above, in South Korea, the number of construction workers is calculated using the labor ratio. To obtain reliability and accuracy of labor or labor costs, previous studies have attempted to estimate labor or labor costs using methods such as machine learning, uncertainty analysis, and regression analysis. For example, Huang and Hsieh [13] attempted to predict labor costs using a random forest and linear regression. The authors used a completed building information modeling (BIM) project to develop a prediction model for labor costs. However, it is difficult for non-experts to use machine learning or BIM.
Third, most countries conduct sampling inspections to investigate the number of construction workers [14]. However, sampling inspection has low reliability and accuracy compared to real data. Therefore, a method for estimating the number of workers with high accuracy is required.
Considering all points of view, estimating the number of construction workers involved is very important. As mentioned above, conventional methods have several limitations, such as low accuracy and difficulty for nonexperts. To overcome these limitations, this study developed a simplified estimation model for the number of workers using a correction factor based on real data. Thus, this research shows that the number of construction workers can be easily estimated with high accuracy and reliability in the construction work package based on real data. The research question was: How can the number of workers be estimated based on real data? The main contribution of this study is as follows:
(i)
Development of a model that estimates the number of workers based on real data
(ii)
Considering different labor ratios for each work package type in apartment construction
(iii)
Suggestion of correction factors based on a statistical method. These factors improve the reliability of estimating the number of workers available to construction sites

2. Literature Review

2.1. Status of Previous Research

This study estimates the number of construction workers with high reliability and accuracy using a correction factor for work package types in an apartment construction project. Therefore, to improve research quality, this study investigates previous studies to suggest research insights into limitations for estimating the number of construction workers by construction work package type. Previous studies can be categorized as follows: (i) research related to estimating the labor cost in the construction work package and (ii) research related to estimating the number of workers in the construction work package (see Table 1).
A few studies have attempted to estimate the labor cost in the construction industry [13,14,15,16]. Huang and Hsieh [13] used various methods to estimate the labor costs of BIM projects. The authors used 19 BIM projects and suggested a methodology that merges simple linear regression and random forest to estimate BIM labor costs. The authors introduced methods for collecting and clustering data and a training method to estimate BIM labor costs. To collect the data, they used the proposed cost breakdown structure, divided the details of the data on the BIM project, and used linear regression to improve stability. Using different numbers of BIM projects, the authors compared the accuracy of the random forest model with that of the linear regression model, and the linear regression model was superior [13]. Dyacova et al. [15] used standardization and market pricing methods to estimate labor costs in construction projects and built a nine-step algorithm model to reflect labor characteristics, such as employee labor behavior and production tasks in the design and construction stages [15].
The number of workers in the construction industry have been analyzed [12,16]. The Korea Occupational Safety and Health Agency (KOSHA) studied the estimation of the number of full-time workers at construction sites. The study suggested a method for estimating the number of workers in the construction work package that corrects the labor rate work package type. South Korea’s standard labor rate for the estimated number of workers is 27% regardless of project type or work package type. However, the authors suggested a different correction rate by industry type (civil (89.0%), construction (104.6%), and others (104.6%)) and multiplied it by 12 months to calculate the number of workers [16]. In South Korea, the number of workers is required to calculate the fatality rate. The author analyzed the number of workers to calculate the national fatality rate. Japan, the United Kingdom, and Singapore use sampling inspection; however, South Korea calculates the number of workers by multiplying the labor rate (27%) by the total construction cost and dividing by the average monthly wage [12].
Building-based estimations have also been studied [17,18,19]. Huang and Hao [14] developed a CNN-based visual recognition sensor and installed it on an air conditioner. The author suggests measuring four impact quantities, distance, and angle of indoor human users essential for controlling air conditioners using visual cameras and CNNs [17]. Zhao and Li [18] analyzed seventy-eight literature reviews on buildings from 2011 to 2021 to estimate building impacts. The authors analyzed the inspection accuracy and methodology. Most of the reviewed papers used machine-learning methods and cameras for estimations [18]. Guo and Amayri [19] introduced occupancy estimation using predictive modeling in imbalanced domains. The authors suggest occupancy estimation using oversampling and predictive distribution. In addition, the results show that the six-sample model with oversampling has an accuracy of 78.94%, which is better than that of the model without sampling (71.06%). Therefore, assuming a lack of data, oversampling, and the suggested framework, the accuracy is higher [19].

2.2. Research Gap

Although previous studies have provided valuable insights, they have several limitations. First, previous studies used BIM or machine learning and used statistics to estimate labor costs. However, unlike previous studies that used machine learning or statistical methods, the proposed model is user-friendly and can be easily used by non-experts. Additionally, the model takes into account the specific characteristics of each work package type, which is an improvement over previous methods that applied a fixed labor ratio regardless of the type of construction. The use of real data and the development of correction factors also contribute to the model’s reliability and accuracy. Therefore, this study provides a new approach to estimating the number of construction workers that can be more easily implemented in practice and provide more accurate results. Second, the construction workers involved differ according to the construction work package type. However, previous studies have estimated the number of workers at the project or country level. To enhance accuracy, the number of workers was estimated at the work level.
To reduce the gap between previous studies and this study, this study developed a user-friendly, simplified estimation model for the number of construction workers with high reliability and accuracy based on real data.

3. Problem Statement

This study shows the development of a model for estimating the number of workers for each work package type. Previously, several countries did not suggest a labor ratio or calculation for estimating the number of workers. In addition, there are no labor ratios for work package types [8].
This uses the following steps to develop an estimation model (See Figure 1):
  • Estimating the labor ratio by work package type for the construction of an apartment building
  • Development of correction factors to improve reliability, comparing the estimated data to real data

3.1. Summary of the Mathematical Model

A common practice in South Korea is to use an equation for estimating the number of workers, as shown in Equation (1) [6].
E s t i m a t e d   n u m b e r   o f   w o r k e r s = C o n s t r u c t i o n   t o t a l   c o s t   ( y e a r l y )   ×   l a b o r   r a t i o M o n t h l y   w o r k e r   w a g e   ×   12
In contrast, this study used real data from “B”, a company in the South Korean construction industry which has completed 24 apartment construction projects. The data collected included the total cost and number of workers for each work package and construction type. Therefore, this study used reverse tracking to estimate the labor ratio. Further, this study classifies 15 types of work package, from “Interior Architecture Works” to “Electrical Work” based on the “Framework Act on the Construction Industry”, “Electrical Construction Business Act”, “Telecommunication Business Act”, and “Firefighting Facility Construction Act” in South Korea. Subsequently, the study classified 28 work types, from “Carpentry” to “Electronic wire work” that were included in each work package based on “Enforcement Decree of the Framework Act on the Construction Industry”. In addition, “Initial Cleaning” and “Working with construction equipment” were added as construction work types to “Non-categorized” as a work package type, because “Non-categorized” is not mentioned in “Enforcement Decree of the Framework Act on the Construction Industry” but is necessary work in construction sites [20]. Therefore, this study considered 16 types of work packages and 30 types of construction work. Subsequently, the study selects the activity types of each work based on “Project Cost Estimating 2022” [21]. According to the Construction Association of Korea [22], average worker wages and the number of construction workers classified based on work package were collected in this study. Also, notations used in calculation have shown in Table 2.

3.2. Calculation and Validation of the Estimated Labor Ratio

Based on the previous section, this section calculates the estimated labor cost by multiplying the number of workers with the Wj based on 24 construction sites that are collected from the “B” construction company by Equation (2).
C l i j = N i j × W j
where Clij is the estimated labor cost of the j-th work package type in the i-th construction site, Nij is the number of workers for work package type j in construction site i, and Wj is the average wage for work package type j.
Reij is calculated by dividing the estimated labor cost by the total work package cost and multiplying it by 100 to obtain a percentage. The average estimated labor ratio is referred to as Rej per work package type.
R i j ( % ) = C l i j C t i j × 100
R e j = lim i 24 i = 1 24 R i j i
where Reij is the estimated labor ratio of the j-th work package type in the i-th construction site, Clij is the estimated labor cost of the j-th work package type in the i-th construction site, Ctij is the total work package cost of the j-th work package type in the i-th construction site, and the number of construction sites i is the number of construction sites, including construction sites with the j-th work package type.
To estimate the number of workers, the type of cost of the type of work packages is multiplied by the estimated labor ratio for that work packages type and divided by the average worker wage for the work package type. The calculated value is called Neij for each type of work package.
N e j = C t j × R e j W j
where Nej is the estimated the number of workers for work package type j in construction site i.
To demonstrate the accuracy of the estimated number of workers for a given type of work package, this study employs the error rate in Equation (6). The error rate can be compared between the estimated and actual number of workers based on real data.
E r r o r   r a t e i j = N i j N e i j N i j × 100

3.3. Calculation of Correction Factors

To guarantee the high reliability and accuracy of the number of estimated workers, this study calculates the correction factor. The correction factor is obtained in the two subsections below.

3.3.1. Calculation of Fmj

The mean square error (MSE) is the sum of the square differences of real and estimated values [21]. Also, Equation (7) indicates the mean square error (MSE), the difference between the real value and the estimated value. Therefore, this study employed Fmj, which is one of the factors, to determine the minimum MSE for the number of estimated workers. The minimum MSE was calculated using Equation (8).
M S E = 1 n i = 1 n Y i ^ Y i 2
F m i j = M i n lim n 24 1 n i = 1 n N i j F m j N e i j 2
where Nj is the number of workers for work package type j and Fmj is the minimization MSE for work package type j in construction site i.
After using Fmj to calculate the minimum MSE, the error rate was calculated using Equation (5).

3.3.2. Calculation of Fecj

In addition, this study suggests the use of Fecj, which can reduce the error rate in any type of work package. So, Equation (9) shows the number of workers for industry type, in classified construction costs, indicating the average of the number of workers for industry type in construction sites, classified by construction cost. Also, Equation (10) shows the estimated number of workers for industry type in classified construction costs, indicating the average of the estimated number of workers for industry type in construction sites, classified by construction cost.
When applying Fecj, the minimum error rate for each work package type can be determined using Equation (11).
N c j = A v g   N c i j
N e c j = A v g   N e c i j
F e c j = M i n   N c j F e c j N e c j N c j
where Fecj is the minimization error rate for work package type j in classified construction cost c.
The Fecj differs from the range of work package costs. It is difficult to determine the minimum error rate in terms of the total work package cost. This is because the input of construction workers is different for different work packages. Therefore, this study classifies work package costs into five ranges. The ranges are presented in Section 4.2.2.

4. Results

4.1. Results of Estimating the Labor Ratio for Work Package Type in Apartment Construction

This study collected real data from the “B” construction company in South Korea, which has completed 24 construction projects. The data included the total cost and number of workers for each type of work package and work type. This study considers 16 types of work packages and 30 types of work. Subsequently, the study selected the activity types that were included in each work type based on “Project Cost Estimating 2022”. Considering the Construction Association of Korea, the average wages of workers and number of construction workers classified based on work package were collected (see Table 3).
First, this study considers 16 types of work package. Because there is a lack of data on road pavement work, this study removed road pavement work to ensure the reliability of the results. Finally, this study considered 15 types of work packages, from interior architecture work to electronic work. Further, considering the collected data, the data not provided were excluded to ensure the reliability of the results.
We calculated the estimated labor ratio using Equations (2)–(4) (see Table 4). The results revealed that the estimated labor ratio for the type of work package was high: 62.24% for “Reinforced concrete work”, 38.8% for “Plastering and waterproof work”, and 26.96% for “Scaffolding, demolition work”. In contrast, the estimated labor ratio for work package was low: 4.23% for “Metal structure, window and doors work”, 5.22% for “Elevator and escalator installation work”, and 10.72% “Gas facilities work”. Considering all types of work packages, the average estimated labor ratio was 20.39%. The estimated labor ratio is utilized in Equation (5) to calculate the estimated number of workers. Table 5 presents the results.
Referring to Table 5, Nj and Nej were calculated using Equation (5). The number of workers for work package type was calculated from real data. To compare Nj with Nej, Equation (6) was used.
The results are shown in Figure 2 and Table 5. For the average error rate, the three types of work package with the lowest error rate were “Non-categorized work” (0.30%), “Facilities and mechanical work and Fire system installation work” (0.92%), and “Plastering and waterproofing, masonry work” (1.05%). In contrast, the three types of work packages with the highest error rates were “Roofing, sheet metal, prefabrication work” (26.44%), “Stone work” (18.33%), “Metal structure, window and doors work” (17.95%). Additionally, the minimum and maximum error rates for the 15 types of work package at each construction site were analyzed. For each construction site, the maximum error rate represents the highest error rate among the 24 construction sites. In addition, the minimum error rate indicates the lowest error rate among the 24 construction sites. The three work package types with the highest maximum error rates were scaffolding and demolition (1117.70%), landscape gardening (1079.78%), and elevator and escalator installation (689.93%). On the contrary, for the minimum error rate, three types of work package had the lowest error rate: “Facilities and mechanical work, firefighting system installation” (0.08%), “Gas facilities work” (0.14%), and “Metal structure, window and doors work” (0.42%).
A comparison of Table 5 and Table 6 shows a very large deviation in the error rate. On average, the error rate was confirmed to be acceptable. However, the error rate at each construction site was not acceptable. Therefore, to estimate the number of construction workers with high reliability and accuracy, the error rate must be reduced at each construction site. Therefore, this study suggests two approaches using correction factors.

4.2. Results of the Correction Factors

4.2.1. Value of Fmj

A correction factor was used in two ways in this study to reduce the error rate. First, this study suggests Fmj, which can reduce the MSE for work package type at each construction site and is given by Equation (8). This correction factor makes it possible to guarantee high reliability and accuracy.
After applying Fmj, the estimated number of workers Nfmj was calculated. And Equation (12) shows the estimated number of workers; applied Fmj.
N f m i j = F m j N e i j
The results revealed the MSE and Fmj presented in Table 7, and the Nj, Nej, Nfmj are compared in Table 8.

4.2.2. Value of Fecj

Second, considering the range of total work package costs for each type of work package, this paper proposes Fecj to reduce the error rate. Fecj is given in Table 9 and calculated using Equation (11).
After Fecj was calculated, it was used to calculate the number of estimated workers Nfecij for the type of work package at each construction site. Equation (13) shows the estimated number of workers; applied Fecj.
N f e c i j = F e c j N e c i j
And Table 10 shows Nj, Nej, and Nfej.

4.3. Analysis of the Correction Factors

4.3.1. Analysis of Fmj

The error rate between Nj and Nfmj was calculated using Equation (6) (see Figure 3). As shown in Figure 3, the error rate and error rate with Nfmj, which indicate the error rate between Nj and Nfmj, are comparable. Further, Figure 3 also includes the difference between the error rate and the error rate with Nfmj and without Nfmj.
The error rate can be reduced by applying Fmj; for the maximum error, three work package types had the highest error rates: scaffolding and demolition (865.54%), elevator and escalator installation work (570.46%), and stone work (399.46%). In contrast, for the minimum error rate, three types of work package had the lowest error rates: “electronic work” (0.00%), “stone work” (0.27%), and “earth work” (0.31%). Compared to Table 11, the error rate of the variation can be reduced.
As mentioned above, the category with the highest maximum error rate was “Scaffolding, Demolition work” (1117.70%). However, after applying Fmj, the category with the highest maximum error rate was “Scaffolding, demolition work” (865.54%). Therefore, Fmj made it possible to more accurately estimate the number of workers for each type of work package at each construction site.

4.3.2. Analysis of Fecj

Figure 4 shows the error rates without and with Fecj, which indicates the error rate between Nj and Nfej. Also, Figure 4 includes the difference between the error rates without and with Fecj.
After applying Fecj, the error rate and error rate of variation can be simultaneously reduced. “Scaffolding, demolition work” (847.92%), “Elevator and escalator installation work“ (725.37%), and “Stone work” (582.29%) had the highest maximum error rates. In contrast, three work package types had the lowest minimum error rates. The error rate was 0.00% for six work package types: “Interior architecture work”, “Earth work”, “Reinforced concrete work”, “Facilities and mechanical work, firefighting system installation work”, “Non-categorized work”, and “Electric work”.
The error rate was lowest with Fecj.
As mentioned above, the category with the highest maximum error rate was “Scaffolding, demolition work” (1117.70%). However, after applying Fecj, the category with the highest maximum error rate was “Scaffolding, demolition work” (847.92%). Therefore, using Fecj increases the accuracy of the estimation of the number of for each work package type at each construction site (Refer to the Table 12).

4.4. Discussion

The results of this study suggest a simplified estimation model by work package type using a correction factor based on real data from twenty-four apartment projects.
The results revealed that the type of work package with the highest labor ratio was reinforced concrete work (62.24%). Previous studies have shown that many construction workers are involved in reinforced concrete work, such as rebar, concrete, and form workers. When different types of workers were considered, worker input was higher than that in other types of work packages. Therefore, reinforced concrete work has the highest labor ratio compared with other types of work.
Three methodologies were used in this study to estimate the number of workers. The error rate was used to select the best methodology. First, the estimated number of workers was calculated using the estimated labor ratio. The error rate ranged from 1117.70% to 0.14%. This methodology had low accuracy in estimating the number of construction workers. Second, this methodology was employed to estimate the labor ratio and minimum MSE. Hence, to reduce the variation error rate, the correction factor, which can reduce the MSE for each type of work package at each construction site, was applied. The error rate for Fmj ranged from 865.54% to 0.00%. The number of workers was estimated more accurately than the error rate. Third, this methodology was used to calculate the estimated labor ratio and Fecj for the minimum error rate of the total work package cost for each type of work package at each construction site. The error rate for Fecj ranged from 847.92% to 0.00%. Compared to the methods, this method had the lowest error rate variance.
Considering the three methods, this study suggests the third method as the best method for estimating the number of construction workers. Previous studies attempted to estimate the number of workers more accurately. However, they lacked real data, and their methods were difficult to use for non-experts. Given the limitations of previous studies, this study proposes a user-friendly, simple estimation model based on real data for the type of work package to ensure high reliability and accuracy.
Various areas were addressed using the estimated number of workers. First, the fatality rate in the construction work package can be calculated accurately for each work package type. At present, national reports on fatality rates only provide fatality rates for the entire construction industry. This is because they have no data on the number of workers in each type of work package. Therefore, if the most hazardous work package is identified, safety management can be strengthened for the work package to reduce the fatality rate. Second, the total construction cost in the pre-construction phases can be estimated based on the number of workers. Since labor costs account for 40–60% of the total cost, accurately estimating the labor cost for each work package type is important. In addition, when using Fecj, the number of construction workers can be estimated from the total work package cost. Previous studies estimated the number of workers using multiple regression widely. To verify the novelty of this model, this paper compared the result of the suggested model and the result using multiple regressor analysis and mean absolute error (MAE). Multiple regression analysis is a statistical method used to examine the relationship between a dependent variable and two or more independent variables. It is a powerful tool that allows researchers to assess the strength and direction of the relationship between the variables and to make predictions about the dependent variable based on the independent variables [23]. This paper used wage and construction cost as a dependent variable and the number of estimated workers as an independent variable. The result revealed that the equation was, following Equation (14):
y = 4.35 × 10 10 × x 1 + 1.09 × 10 3 × x 2 + 0.10
where y is the estimated number of estimated workers, x1 is the wage for type of section, and x2 is the construction cost for type of section.
MAE is 467.4 and average error rate shows 48.2% and maximum error rate is 173.14%, minimum error rate is 2.56%. So, the suggested model is more accurate compared to multiple regression.

5. Managerial Insights and Practical Implications

If the manager of a construction company is available to adjust this model for cost planning or safety management, the model can be used to estimate the labor cost per work package type or the estimated number of workers to derive the fatality rate per work package type at construction sites. Details of the use of the model are as follows.

5.1. Economic Implication

In the design state, the manager plans a budget for construction costs. With the proposed model, the manager can more accurately budget for labor costs per work package type. The manager inputs the construction costs for work package type, uses the labor ratio obtained in this study for each work package type, and estimates the labor cost of the total construction project.

5.2. Safety Implication

The manager must manage the construction site to ensure safety management. However, managers often have limited human resources, budget, and time for managing the entire construction site. Therefore, this framework can be used to calculate the reliability of fatality rate estimates [16] or identify high-risk work package types at construction sites, which allows the manager to use their limited resources efficiently

6. Conclusions

The construction industry is labor-intensive, making the accurate estimation of the number of workers important. However, previous studies did not use real data, and their proposed methods were challenging for non-experts to use. To address these issues, this study developed a simple estimation model for the number of workers per work package type using a correction factor based on real data from an apartment project.
This study contributes to the literature in several ways. First, the proposed methods can be used in a framework to estimate the number of workers per work package type. Second, through the labor ratio of each work package type, the number of workers can be estimated with greater accuracy. In addition, this study suggests a framework for estimating the labor ratio of the total construction costs. Therefore, this framework can help decision makers plan for a construction project or calculate costs using factors such as construction costs or average wages. This framework can be applied to other work packages and countries using average wages, used to classify work packages by local law, and estimate construction costs. Furthermore, this study suggests a framework that enhances reliability using statistical methods.
This study has the following limitations. This study’s limitations include the limited data collection from a single construction company in South Korea and the need for further research to develop a more comprehensive estimation model that considers the entire construction project. Also, the proposed estimation model mainly focuses on the labor ratio by work package type and does not consider other factors that may affect the number of workers required for a construction project. Future studies could expand upon this research by collecting real data from multiple construction companies in various countries and industries to increase the generalizability of the proposed method. Additionally, the development of an estimation model that considers a wider range of variables, such as project complexity and workforce diversity, could be an area of future research.

Author Contributions

Methodology, H.M. and J.J. (Jaemin Jeong); Formal analysis, H.M. Resources, H.M. and J.J. (Jaemin Jeong); Visualization, H.M. and J.J. (Jaemin Jeong); Writing—original draft, H.M. and J.J. (Jaemin Jeong); Conceptualization, J.J. (Jaewook Jeong); Supervision, J.J. (Jaewook Jeong); Project administration, J.J. (Jaewook Jeong); Writing—review and editing, J.J. (Jaewook Jeong). All authors have read and agreed to the published version of the manuscript.

Funding

This work was supported by the Ministry of Trade, Industry, and Energy (MOTIE) and the Korea Institute for Advancement of Technology (KIAT) through the International Cooperative R&D Program. (Project No. P0017191).

Data Availability Statement

The data generated and analyzed during this research are available from the corresponding author upon reasonable request.

Conflicts of Interest

The authors declare no conflict of interest.

Nomenclature

i Index of construction sites i I = 1,2 , . . . , 24
j Index of work package type j J = 1,2 , . . . , 15
c Index of classified construction cost c C = 1,2 , . . . , 6
WjAverage wage for work package type j
NijThe number of workers for work package type j in construction site i
ClijLabor cost for work package type j in construction site i
CtijConstruction total cost for work package type j in construction site i
RijLabor ratio for work package type j in construction site i
NeijEstimated the number of workers for work package type j in construction site i
RejAverage labor ratio for work package type j
FmjMinimization MSE for work package type j in construction site i
FecjMinimization error rate for work package type j in classified construction cost c
NfmijEstimated number of workers obtained by applying applied Fmj for work package type j at construction site i
NfecijEstimated number of workers obtained by applying Fecj for work package type j in construction site i classified by construction cost c

References

  1. El-Gohary, K.M.; Aziz, R.F. Factors influencing construction labor productivity in Egypt. J. Manag. Eng. 2014, 30, 1–9. [Google Scholar] [CrossRef]
  2. Office for National Statistics (ONS). Annual Population Survey (APS). Available online: https://www.ons.gov.uk/employmentandlabourmarket/peopleinwork/employmentandemployeetypes/methodologies/annualpopulationsurveyapsqmi (accessed on 21 March 2021).
  3. The National Bureau of Statistics of China. Available online: http://www.stats.gov.cn/ (accessed on 21 March 2021).
  4. Ministry of Manpower (MOM). Workplace Safety and Health Report. Available online: https://www.mom.gov.sg (accessed on 28 February 2021).
  5. Ministry of Employment and Labor (MOEL). Occupational Safety and Health Act, South Korea. Available online: https://elaw.klri.re.kr/kor_service/lawView.do?hseq=55395&lang=ENG (accessed on 2 February 2021).
  6. Korea Occupational Safety and Health Agency (KOSHA). 2021 Industry Injury Analysis, South Korea. Available online: https://www.kosha.or.kr/kosha/data/industrialAccidentStatus.do?mode=view&articleNo=428212&article.offset=0&articleLimit=10 (accessed on 12 March 2021).
  7. Ministry of Employment and Labor (MOEL). Labor Standards Act, South Korea. Available online: https://elaw.klri.re.kr/kor_service/lawView.do?hseq=56543&lang=ENG (accessed on 2 February 2021).
  8. Yi, K.J. New construction accident index based on number of accident and progress payments. J. Korea Inst. Build. Constr. 2022, 22, 293–303. [Google Scholar] [CrossRef]
  9. Jeong, J.; Jeong, J. Novel approach of the integrated work & risk breakdown structure for identifying the hierarchy of fatal incident in construction industry. J. Build. Eng. 2021, 41, 102406. [Google Scholar] [CrossRef]
  10. Buchan, R.D.; Kelly, J.R.; Fleming, F.W. Estimating for Builders and Quantity Surveyors, 1st ed.; Newnes: Oxford, UK, 1991; p. 16. [Google Scholar]
  11. Proverbs, D.; Holt, G.; Olomolaiye, P. A method for estimating labour requirements and costs for international construction projects at inception. Build. Environ. 1998, 34, 43–48. [Google Scholar] [CrossRef]
  12. Shim, Y.; Jeong, J.; Jeong, J.; Lee, J.; Kim, Y. Comparative analysis of the national fatality rate in construction industry using time-series approach and equivalent evaluation conditions. Int. J. Environ. Res. Public Health 2022, 19, 2312. [Google Scholar] [CrossRef]
  13. Huang, C.-H.; Hsieh, S.-H. Predicting BIM labor cost with random forest and simple linear regression. Autom. Constr. 2020, 118, 103280. [Google Scholar] [CrossRef]
  14. Akintoye, A. Analysis of factors influencing project cost estimating practice. Constr. Manag. Econ. 2000, 18, 77–89. [Google Scholar] [CrossRef]
  15. Dyakova, O.V.; Vasilenko, Z.A.; Usatkina, O.I.; Alexandria, A.V. Economic-mathematical model for calculating the labor cost as a part of the investment construction project’s cost on the estimated standardization and market pricing methods” basis. IOP Conf. Ser. Mater. Sci. Eng. 2020, 913, 052019. [Google Scholar] [CrossRef]
  16. Korea Occupational Safety and Health Agency (KOSHA). Study on Estimation of the Number of Full-time Workers in the Construction Site. Available online: https://oshri.kosha.or.kr/oshri/publication/researchReportSearch.do?mode=view&articleNo=419771&article.offset=0&articleLimit=10&srSearchVal=%EC%83%81%EC%8B%9C (accessed on 12 October 2022).
  17. Huang, Q.; Hao, K. Development of CNN-based visual recognition air conditioner for smart buildings. J. Inf. Technol. Constr. 2020, 25, 361–373. [Google Scholar] [CrossRef]
  18. Zhao, L.; Li, Y.; Liang, R.; Wang, P. A State of Art Review on Methodologies of Occupancy Estimating in Buildings from 2011 to 2021. Electronics 2022, 11, 3173. [Google Scholar] [CrossRef]
  19. Guo, J.; Amayri, M.; Najar, F.; Fan, W.; Bouguila, N. Occupancy estimation in smart buildings using predictive modeling in imbalanced domains. J. Ambient. Intell. Humaniz. Comput. 2022, 1–13. [Google Scholar] [CrossRef]
  20. Jeong, J.; Jeong, J. Quantitative risk evaluation of fatal incidents in construction based on frequency and probability analysis. J. Manag. Eng. 2022, 38, 04021089. [Google Scholar] [CrossRef]
  21. Construction Digital Library (CODIL), Project Cost Estimating, South Korea. 2022. Available online: https://www.codil.or.kr/helpdesk/read.do;jsessionid=ORacB06PBGNl5xI8DzKkFwy9vIxQJuvbJQFgR8vtJcJE1O8fbOuaEGApTj1z16o3.codil_servlet_engine1?bbsId=BBSMSTR_900000000202&nttId=12517&searchWrd= (accessed on 22 October 2022).
  22. Construction Association of Korea, Construction Average Wage, South Korea, 2014–2019. Available online: http://www.cak.or.kr/board/boardList.do?boardId=spend_wage&menuId=61 (accessed on 21 December 2022).
  23. Mark, J.; Goldberg, M.A. Multiple regression analysis and mass assessment: A review of the issues. Apprais. J. 1988, 56, 89–109. [Google Scholar]

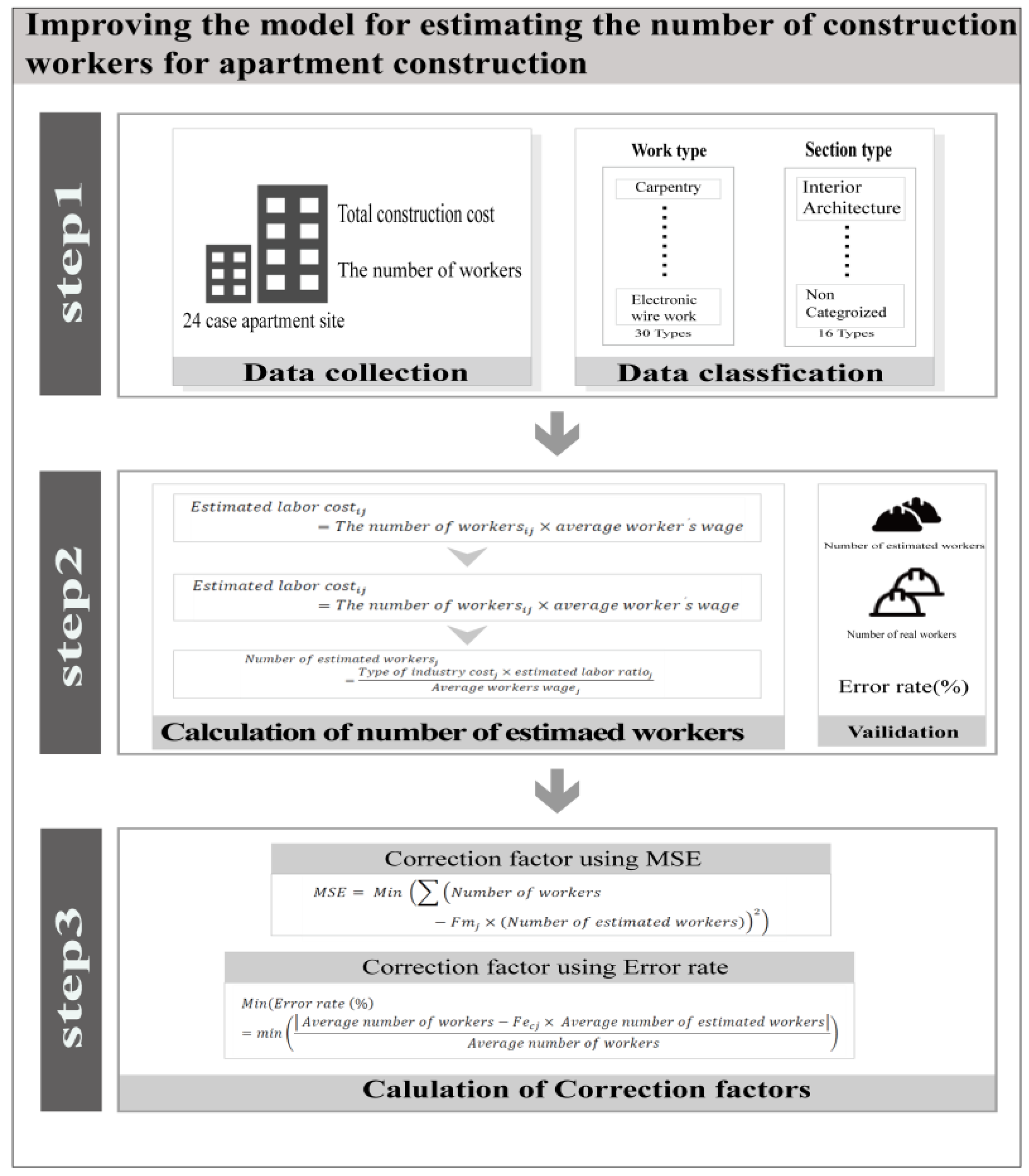

Figure 1. Research flow.
Figure 1. Research flow.
Sustainability 15 07150 g001

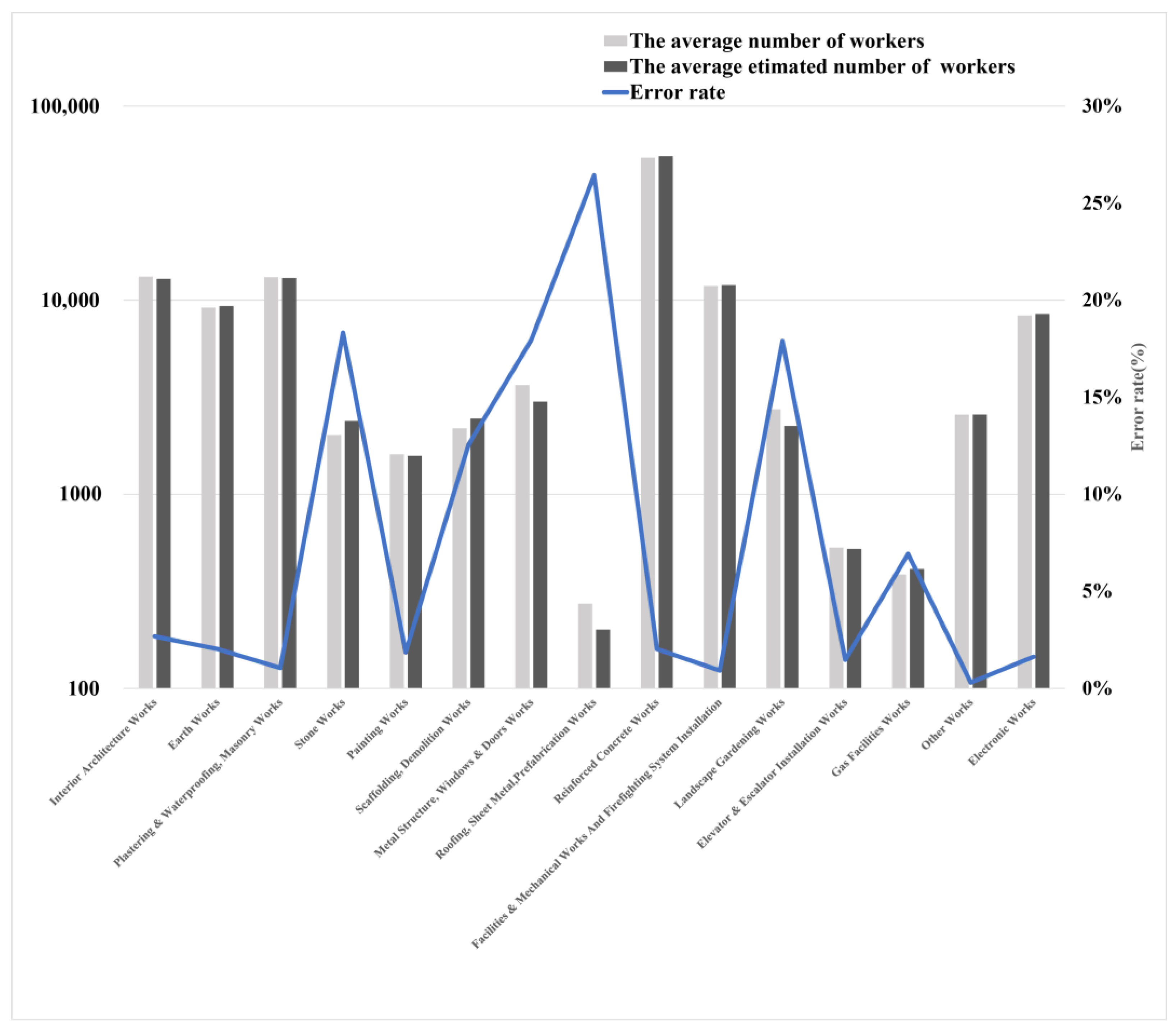

Figure 2. Comparison of the number of workers and error rate.
Figure 2. Comparison of the number of workers and error rate.
Sustainability 15 07150 g002

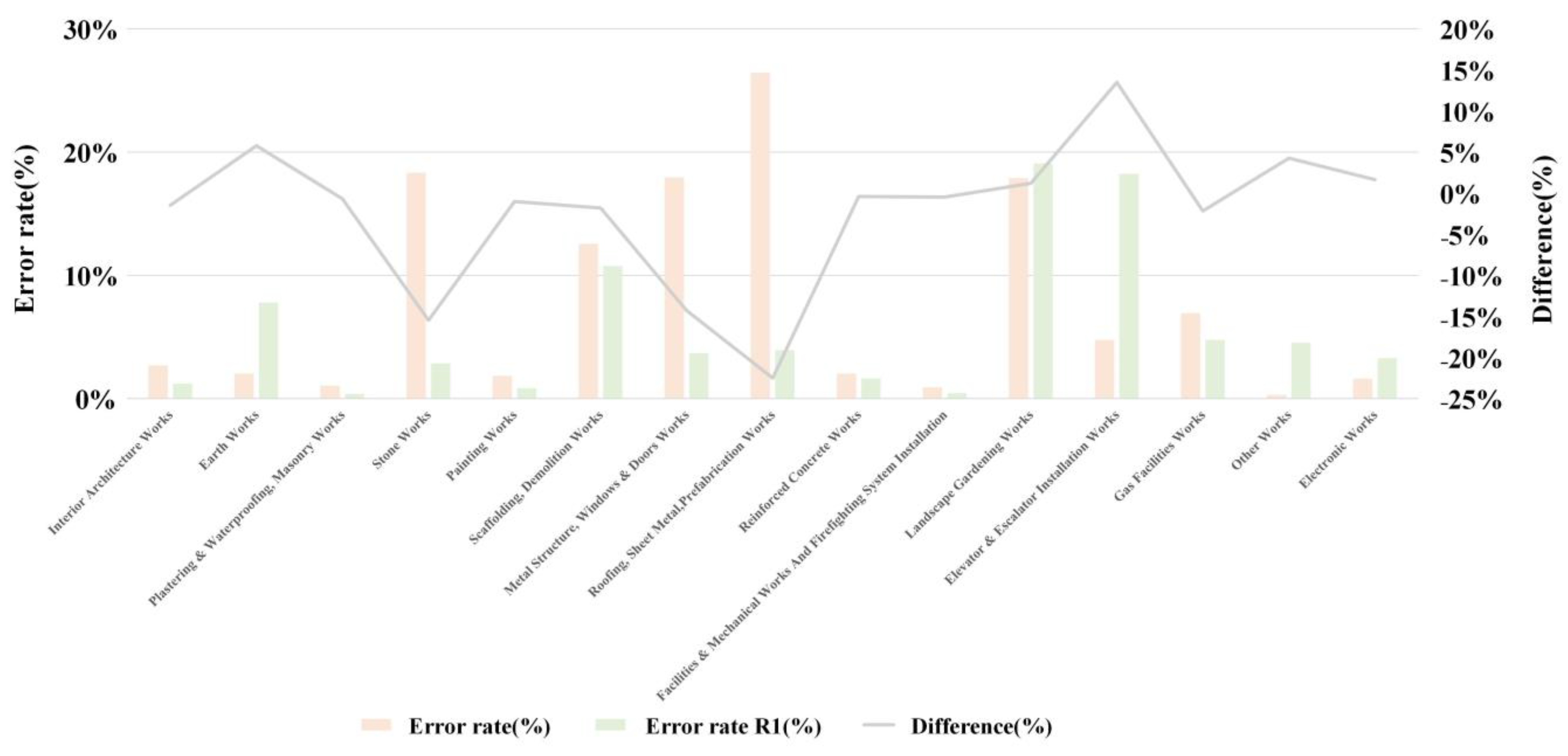

Figure 3. Comparison error rate depending on applying Fmj.
Figure 3. Comparison error rate depending on applying Fmj.
Sustainability 15 07150 g003

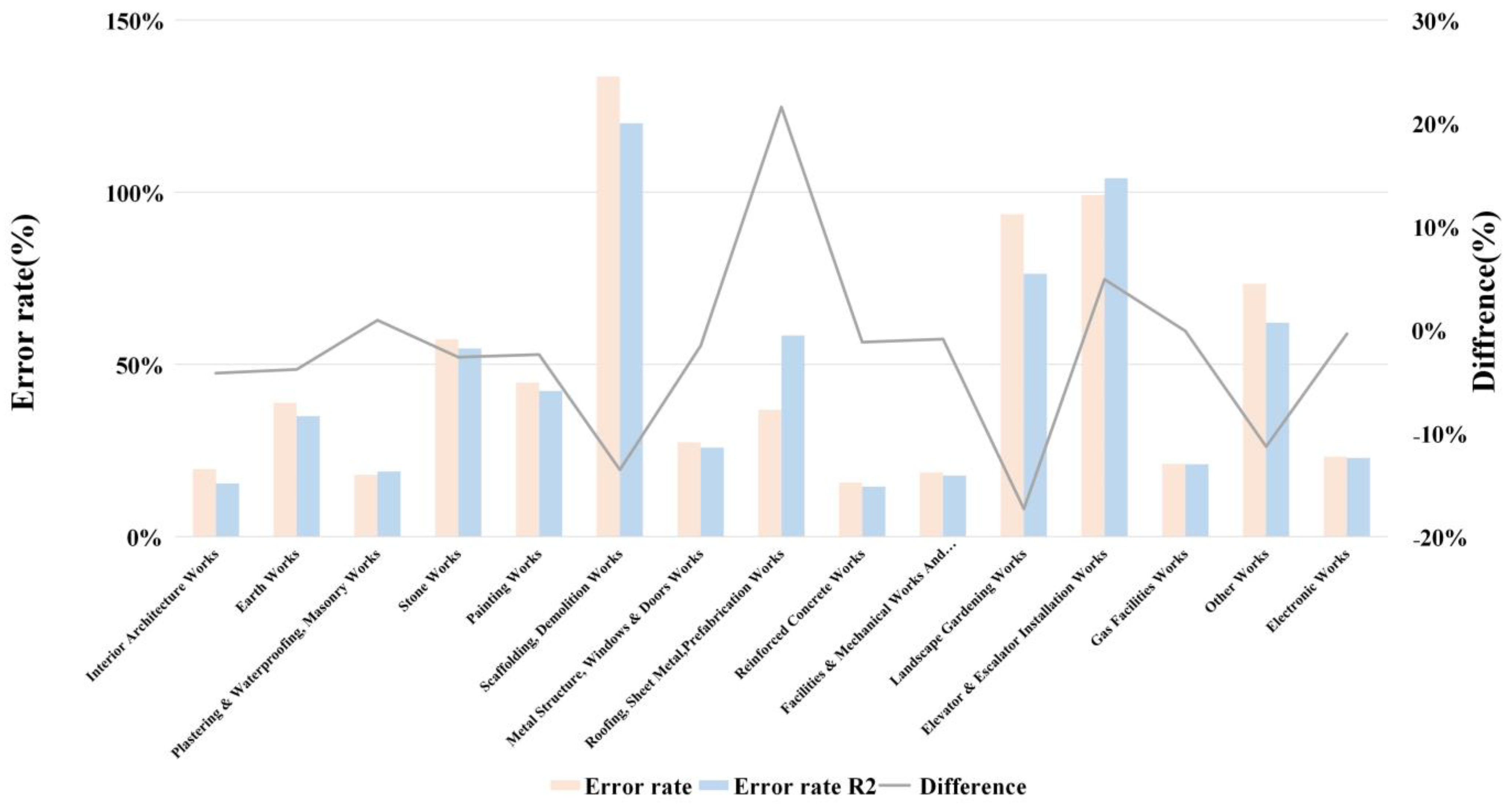

Figure 4. Comparison error rate depending on applying Fecj.
Figure 4. Comparison error rate depending on applying Fecj.
Sustainability 15 07150 g004
Table 1. Literature review.
Table 1. Literature review.
No.ReferencePurposeResearch Gap
Research related to estimating labor cost
1Huang et al.
[13]
The authors suggested the method for estimating labor cost used in nine BIM projects. This study analyzed the estimated labor cost rate using real data
2Dyacova et al. [15]The authors used standardization and market pricing methods to estimate labor costs in construction project costs.
Research related to estimating the number of workers
3Kosha guide [16]The author suggested a labor cost rate to improve the reliability of the estimation of the number of workers.This study suggests an estimated labor cost rate by work package type and calculates a correction factor to improve reliability
4Sim et al.
[12]
The authors analyzed the national method of estimating the number of workers.
Research related to estimating methods used in building factors
5Huang et al. [17]The authors developed an air conditioner with a visual recognition capacity using a convolutional neural network (CNN). The visual recognition system can recognize human bodies through a camera. This study suggests a simple estimation model using calculations
6Zhao et al. [18]The author analyzed methods presented in 78 literature reviews related to estimating building occupancy and their accuracies.
7Guo et al. [19]The authors analyzed small and imbalanced datasets of estimations in buildings using predictive modeling.
This researchThis study estimates the number of construction workers with high reliability and accuracy using a correction factor for work package types in an apartment project.-
Table 2. Notation list.
Table 2. Notation list.
TypeParameterUnit
ParameterWjDollar/Person
NijPerson
ClijDollar/Site
CtijDollar/Site
Rij%
Decision variablesNeijPerson
Rej%
FmjNum
FecjNum
NfmijPerson
NfecijPerson
Table 3. Value of Wj.
Table 3. Value of Wj.
Type   of   Work   Package   ( j ) 2013201520162017
Interior architecture work81.9490.0299.88106.39
Earth work79.5787.4795.00102.64
Plastering and waterproofing, masonry work79.0986.7096.45103.48
Stone work83.5089.6399.11105.91
Painting work76.4583.5191.6198.21
Scaffolding, demolition work83.2090.6299.69106.85
Metal structure, window and doors work81.4388.7897.96104.58
Roofing, sheet metal, prefabrication work 77.8083.3392.6199.10
Reinforced concrete work88.62100.81111.36119.23
Facilities and mechanical works, firefighting system installation work77.4984.5692.7699.37
Landscape gardening work78.9287.9994.98101.78
Elevator and escalator installation works79.8089.3097.75104.83
Gas facilities work90.6598.67108.82114.42
Non-categorized work75.5981.4590.0696.20
Electronic work74.5981.0489.3795.60
Table 4. Value of Rej.
Table 4. Value of Rej.
Type   of   Work   Package   ( j ) Rej
Interior architecture work13.50%
Earth work26.96%
Plastering and waterproofing, masonry work38.08%
Stone work18.35%
Painting work19.42%
Scaffolding, demolition work23.08%
Metal structure, window and doors work4.23%
Roofing, sheet metal, prefabrication work15.02%
Reinforced concrete work62.24%
Facilities and mechanical work, firefighting system installation21.72%
Landscape gardening work13.72%
Elevator and escalator installation work5.22%
Gas facilities work10.72%
Other work12.79%
Electronic work22.46%
Table 5. Value of Nj and Nej and error rate.
Table 5. Value of Nj and Nej and error rate.
Type   of   Work   Package   ( j ) NjNejError Rate
Interior architecture work13,25212,8972.68%
Earth work915393382.03%
Plastering and waterproofing, masonry work13,15713,0181.05%
Stone work2019238918.33%
Painting work160815781.85%
Scaffolding, demolition work2185246012.55%
Metal structure, window and doors work3655299917.95%
Roofing, sheet metal, prefabrication work 27320126.44%
Reinforced concrete work54,21055,3082.03%
Facilities and mechanical work, firefighting system installation11,84311,9520.92%
Landscape gardening work2740224917.90%
Elevator and escalator installation work5315231.47%
Gas facilities work3864126.93%
Other work256925770.30%
Electronic work835784931.63%
Table 6. Error rate per work package type at 24 construction sites.
Table 6. Error rate per work package type at 24 construction sites.
Type   of   Work   Package   ( j ) MaxMin
Interior architecture work74.58%2.98%
Earth work238.50%5.55%
Plastering and waterproofing, masonry work44.72%1.74%
Stone work508.60%3.23%
Painting work321.58%2.93%
Scaffolding, demolition work1117.70%7.88%
Metal structure, window and doors work81.33%0.42%
Roofing, sheet metal, prefabrication work103.23%3.11%
Reinforced concrete work54.41%4.94%
Facilities and mechanical work, firefighting system installation50.67%0.08%
Landscape gardening work1079.78%5.23%
Elevator and escalator installation Work680.93%1.50%
Gas facilities work69.58%0.14%
Other work417.64%2.97%
Electronic work91.59%1.55%
Table 7. Values of MSE and Fmj.
Table 7. Values of MSE and Fmj.
Type   of   Work   Package   ( j ) MSEFmj
Interior architecture work10,600,897 1.04
Earth work15,004,013 0.90
Plastering and waterproofing, masonry work7,818,7331.01
Stone work425,4680.82
Painting work403,8561.03
Scaffolding, demolition work2,362,6080.79
Metal structure, window and doors work1,315,1731.26
Roofing, sheet metal, prefabrication works24,6021.31
Reinforced concrete work92,460,4600.96
Facilities and mechanical work, firefighting system installation8,273,0490.99
Landscape gardening work12,511,4721.45
Elevator and escalator installation work152,2580.98
Gas facilities work13,4690.86
Other work1,393,5650.98
Electronic work3,709,8510.95
Table 8. Value of Nfmj.
Table 8. Value of Nfmj.
Type   of   Work   Package   ( j ) NjNejNfmj
Interior architecture work13,25212,89713,412
Earth work915393388440
Plastering and waterproofing, masonry work13,157 13,018 13,207
Stone work201923891962
Painting work160815781622
Scaffolding demolition work218524601950
Metal structure window and doors work365529993789
Roofing, sheet metal, prefabrication work273201262
Reinforced concrete work54,210 55,308 53,333
Facilities and mechanical work, firefighting system installation11,84311,95211,791
Landscape gardening work274022493262
Elevator and escalator installation work549523449
Gas facilities work386412404
Other work256925772453
Electronic work835784938083
Table 9. Value of Fecj.
Table 9. Value of Fecj.
Type   of   Work   Package   ( j ) Total Construction Cost(c)
(100 Thousand USD $)
Fecj Work   Package   Type   ( j ) Total Construction Cost(c)
(100 Thousand USD $)
Fecj
Interior architecture workUnder 11.00Reinforced concrete workUnder 11.00
1 to 50.741 to 51.21
5 to 101.025 to 101.01
10 to 150.8710 to 150.96
Over 201.19Over 200.96
Earth workUnder 10.90Facilities and mechanical work, firefightingUnder 11.00
1 to 50.661 to 51.00
5 to 101.065 to 101.11
10 to 151.0110 to 150.94
Over 200.59Over 201.22
Plastering and waterproofing, masonry workUnder 11.00System installationUnder 11.00
1 to 51.001 to 51.00
5 to 101.005 to 100.57
10 to 151.0710 to 151.30
Over 200.94Over 201.00
Stone workUnder 11.00Landscape gardening workUnder 11.00
1 to 51.001 to 51.00
5 to 101.005 to 101.00
10 to 151.1210 to 150.98
Over 200.80Over 201.06
Painting workUnder 11.00Elevatorand escalator installation workUnder 11.00
1 to 51.001 to 51.00
5 to 101.005 to 101.00
10 to 151.0010 to 151.00
Over 200.90Over 200.94
Scaffolding, demolition workUnder 11.09Gas facilities workUnder 11.00
1 to 51.001 to 51.00
5 to 101.005 to 101.00
10 to 151.0010 to 151.00
Over 201.00 Over 201.00
Metal structure, window and doors workUnder 11.39Other workUnder 10.26
1 to 50.781 to 51.01
5 to 101.005 to 100.94
10 to 151.0010 to 151.00
Over 201.00Over 201.00
Roofing, sheet metal, rrefabrication workUnder 11.30Electronic workUnder 11.05
1 to 51.001 to 50.96
5 to 101.005 to 100.82
10 to 151.0010 to 151.00
Over 201.00Over 201.00
Table 10. Result of the error rate with Fej for work package type at a construction site.
Table 10. Result of the error rate with Fej for work package type at a construction site.
Type   of   Work   Package   ( j ) NjNejNfejStandard
Deviation
Average
Error Rate
Interior architecture work13,25212,89713,2526476.6215.42%
Earth work9153933891584404.6634.98%
Plastering and waterproofing, masonry work13,15713,01813,1574668.1518.88%
Stone work2019238920191797.7354.62%
Painting work160815781608606.0442.27%
Scaffolding, demolition work218524602185717.66120.02%
Metal structure, window and doors work3655299936551789.7325.84%
Roofing, sheet metal, prefabrication work 273201273125.5658.38%
Reinforced concrete work54,21055,30854,21018,010.8614.50%
Facilities and mechanical work, firefighting system installation11,84311,95211,8435019.1517.73%
Landscape gardening work2740224927401725.5076.27%
Elevator and escalator installation Work549523549251.80104.04%
Gas facilities work386412386163.8220.98%
Other work2569257725691081.5662.08%
Table 11. Calculation of the error rate with Fmj for work package types at construction sites.
Table 11. Calculation of the error rate with Fmj for work package types at construction sites.
Work Package TypeMaxMin
Interior architecture work81.55%1.29%
Earth work205.94%0.31%
Plastering and waterproofing, masonry work46.81%2.01%
Stone work399.64%0.27%
Painting work333.13%2.27%
Scaffolding, demolition work865.54%1.89%
Metal structure, window and doors work129.14%16.48%
Roofing, sheet metal, prefabrication works165.43%3.89%
Reinforced concrete work48.90%0.32%
Facilities and mechanical work, firefighting system installation works48.64%38.17%
Landscape gardening work100.00%3.53%
Elevator and escalator installation work570.46%0.31%
Gas facilities work66.16%2.19%
Non-categorized work392.66%0.51%
Electronic work82.34%0.00%
Table 12. Error rate with Fecj per work package type in a construction site.
Table 12. Error rate with Fecj per work package type in a construction site.
Type of Work PackageMaxMin
Interior architecture work78.98%0.00%
Earth work259.16%0.00%
Plastering and waterproofing, masonry work54.30%0.30%
Stone work582.29%1.00%
Painting work278.60%0.69%
Scaffolding, demolition work847.92%0.40%
Metal structure, window and doors work79.13%0.14%
Roofing, sheet metal, prefabrication work159.50%18.34%
Reinforced concrete work48.51%0.00%
Facilities and mechanical works, firefighting system installation work52.69%0.00%
Landscape gardening work578.09%3.43%
Elevator and escalator installation work725.37%0.32%
Gas facilities work58.59%0.39%
Non-categorized work421.58%0.00%
Electronic work100.34%0.00%
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Mun, H.; Jeong, J.; Jeong, J. Improving the Model for Estimating the Number of Construction Workers for Apartment Construction. Sustainability 2023, 15, 7150. https://doi.org/10.3390/su15097150

AMA Style

Mun H, Jeong J, Jeong J. Improving the Model for Estimating the Number of Construction Workers for Apartment Construction. Sustainability. 2023; 15(9):7150. https://doi.org/10.3390/su15097150

Chicago/Turabian Style

Mun, Hyeongjun, Jaewook Jeong, and Jaemin Jeong. 2023. "Improving the Model for Estimating the Number of Construction Workers for Apartment Construction" Sustainability 15, no. 9: 7150. https://doi.org/10.3390/su15097150

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
