4.1. Ranking of Hindrances to BIM Implementation
The Cronbach’s alpha coefficient was 0.974, much higher than the threshold of 0.70 [
47]. Thus, the data collected in this study had high reliability. The ranking of the 47 hindrances to BIM implementation in the Singapore construction industry was shown in
Table 3. A few methods were adopted to identify the critical factors when Likert scale data were collected in previous studies, but none of them was established as a standardized method. The threshold value was also not determined. Magal et al. [
48] recognized all the factors that were deemed critical in previous studies. No cutoff point was established in this said study. Shen and Liu [
49] set a cutoff value of 4 because it represented “significant” in the five-point scale in this study. Nitithamyong and Skibniewski [
50] used the middle value of the Likert scale as the threshold. Xu et al. [
51] and Zhao et al. [
43] chose the factors with normalized values of 0.50 and above as the critical factors. Won et al. [
52] selected the factors with mean values exceeding the total mean value of the data as the critical factors.
In this study, the mean scores of the 47 hindrances to BIM implementation in Singapore were normalized, as shown in
Table 3. The hindrances that obtained normalized values of 0.50 or above were recognized as critical ones. The results implied that out of the 47 factors, 21 were critical in hindering BIM implementation in building projects in Singapore. Besides, all the mean scores (3.494 and above) of the 21 critical hindrances exceeded 3.451 which was the total mean value of all the 47 hindrances. However, the 22nd hindrance (H37) obtained a mean score (3.448) below this total mean value. Thus, the results of applying the “comparing mean scores with the total mean value” method supported the normalization method which was adopted in this study. Among the critical hindrances, “need for all key stakeholders to be on board to exchange information” (H12) was ranked top. This result echoed El Asmar et al. [
53], which found that early involvement of the contractors to share expertise and information upfront is key to creating optimal design models early in a building project. In the post-survey interviews, the experts mentioned that in Singapore downstream parties were generally not involved upfront, and also suggested that BIM implementation would be efficient if the entire team (the owner, the designers, the contractors, and the facility manager) could actively participate from the beginning of the design stage. Indeed, lots of details need to be developed by specialist contractors who, however, usually used the traditional approach in design detailing. Based on the ranking of the critical hindrances in
Table 3, the practitioners would have a clear knowledge of the areas of activities of BIM implementation deserving more attention, and establish resources allocation priorities accordingly.
4.2. Underlying Hindrance Groupings

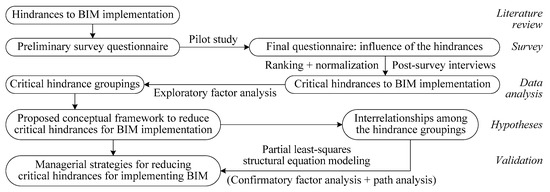

In this study, exploratory factor analysis (EFA) was conducted to obtain a manageable set of hindrance groupings. Such groupings should well represent the 21 critical hindrances to BIM implementation. The appropriateness of performing EFA with the data collected in this study was assessed. The Kaiser-Meyer-Olkin value was 0.911, suggesting that the critical hindrances had a high common variance. The value of the test statistic (chi-square) for Bartlett’s sphericity was 1265.756, with a
p-value of 0.000, indicating that sufficient correlations existed among the hindrances to proceed with EFA. Thus, the data were appropriate for EFA. The EFA process was terminated after meeting its widely-used threshold values: (1) 0.60 for cumulative percentage of variance (CPV), indicating that all the extracted hindrance groupings together should explain at least 60% of the variance of all the critical hindrances; (2) 0.50 for communalities of all the critical hindrances; and (3) ±0.40 for factor loadings of all the hindrances to be significant [
54,
55]. The communality of a critical hindrance presents the total amount of variance that this critical hindrance shares with the rest critical hindrances, and the factor loadings of a critical hindrance refer to the correlation between this hindrance and the hindrance groupings.
EFA was conducted using the software IBM SPSS Statistics 20 and the results indicated a well-defined three-factor structure, as shown in
Table 4. The CPV explained from the three extracted groupings was 64.070%. Additionally, all the factor loadings of the hindrances were above 0.40 and the communalities above 0.50, indicating a robust EFA. The hindrance groupings were named as “lack of collaboration and model integration”, “lack of continuous involvement and capabilities”, and “lack of executive vision and training”, respectively.
4.2.1. Lack of Collaboration and Model Integration
This critical hindrance grouping accounted for about 53% of the total variance of the 21 critical hindrances and included 10 hindrances. All the 10 hindrances could be related to the collaboration and model integration of BIM implementation in the building project. The widely-accepted definition of BIM proposed by the National Institute of Building Sciences (NIBS) stated that “a basic premise of BIM is collaboration by different stakeholders at different phases of the life cycle of a facility to insert, extract, update or modify information in the BIM to support and reflect the roles of that stakeholder” [
56]. The hindrance with the highest factor loading was “BIM model issues (such as ownership and management)” (H34). Even BIM technology has been used by the designers and possibly the contractors, the technological process has been suffering from physical and information fragmentation in different stages of the project. The creation, integration, and use of digital design models would potentially raise many liability issues because little collaboration was built within the typical project team [
12], such as the anxiety about providing wrong information by the designers [
26] and about offering advice by the contractors. The professionals involved in the post-survey interviews observed that due to potential liabilities, the team members do not fully exchange data. For instance, as the principal role in the Singapore context, the architect may change the design frequently without informing other designers and the contractors, hindering the creation of a composite design and construction model, whereby, all the parties can work on it. Such issues urged the roles and responsibilities in the model management process to be established in standard contracts. Even so, the liabilities may not be solved without trust-based collaboration and proper risk sharing among the key stakeholders. As mentioned earlier, the building contracts in Singapore are still developed on the basis of the adversarial contractual system, leading to individualism and isolated working environment. Thus, three critical hindrances (H27, H28, and H33) that described the fragmented contractual relationships were related to the trust-based collaboration needed for BIM implementation among the team.
“Lack of sufficient evidence to warrant BIM use” (H09) obtained the second highest loading. The post-survey interviewees highlighted that due to the lack of project-wide collaboration, BIM implementation appeared to remain in an early stage in Singapore; it is unrealistic to expect that in the short term, the project team can fully reap the benefits that BIM implementation brings. The lonely BIM adoption among the major stakeholders could also be attributed to the poor understanding of collaboration and data integration. Thus, “poor understanding of off-site manufacture (OSM) process and its associated costs” (H35) was also included in this grouping.
To implement BIM along with OSM, the digital models should be fixed early and fit for off-site fabrication and on-site assembly (H36), because any changes would be costly after the fabrication commences [
25]. However, design environments were difficult for multi-disciplinary integration at the construction level (H45) [
7] due to “interoperability issues such as software selection and insufficient standards” (H43) [
37]. In addition, the multi-discipline model integration also requires “technical expertise, protocols, and infrastructure for multiuser model access” (H46) [
9,
22]. The post-survey interviewees also suggested that in Singapore different parties tended to use various software or software versions, creating a difficulty in integrating digital models across disciplines.
4.2.2. Lack of Continuous Involvement and Capabilities
This grouping explained about 6% of the total information of the 21 critical hindrances and included six of them. Among these, two significant hindrances (H12 and H32) were closely related to the continuous involvement of the major stakeholders. “Need for all key stakeholders to be on board to exchange information” (H12) obtained the highest factor loading. The early and continuous involvement of the owner and the key designers and contractors from early design through project completion has been advocated for BIM implementation [
53]. This would pave the way for the project-wide collaboration in the subsequent stages of the project. Another high-loading hindrance was “assignment of responsibility/risk to constant updating for broadly accessible BIM information” (H32). In the collaborative project team, the processes of creating digital models in the design stage and using, updating, and managing the models in the construction and operations and maintenance stages would assign liabilities to different participants as the project proceeds.
Four significant hindrances (H07, H14, H31, and H42) were associated with relevant capabilities that are necessary for successful implementation of BIM. As recommended by the BIM Project Execution Planning Guide, the capabilities of each party can be defined as resources (personnel, tools and their training, and information technology support), competencies, and experience [
57]. The second highest factor loading hindrance “entrenchment in two-dimensional (2D) drafting and unfamiliarity to use BIM” (H07) revealed that in Singapore many firms lacked competencies and experience to use BIM [
32]. For example, the upfront BIM operators tend to lack enough field knowledge to know what they are modeling and its constraint in the actual construction (H14); consequently, the digital models may not be developed correctly. In addition, capital investment should also be included in the resources [
42]. Thus, “firms’ unwillingness to invest in training” (H31) and “costly investment in BIM hardware and software solutions” (H42) could also be related to the capabilities of the participants. Compared with the biggest firms in Singapore that can make most use of BIM, a huge number of SMEs face adoption challenges such as lacking the capital investment to build up BIM competencies [
8]. The experts involved in the post-survey interviews also stressed the importance of the BIM implementers’ financial capabilities, especially for the SMEs and foreign firms based in Singapore.
4.2.3. Lack of Executive Vision and Training
This hindrance grouping represented about 5% of the total variance and included five hindrances. “Executives failing to recognize the value of BIM-based processes and needing training” (H01), “concerns over or uninterested in sharing liabilities and financial rewards” (H02), and “industry’s conservativeness, fear of the unknown, and resistance to change comfortable routines” (H05) were associated with the lack of executive vision among firms, resulting in negative mindsets and behaviors. In particular, H01 achieved the highest factor loading, which described that the executives may not commit on the new working method. In the Singapore context, they tended not to see BIM implementation as mainstream activity but as additional workload. This value proposition established the conservative and unsupportive culture of most firms (H05), hindering BIM implementation in Singapore. This finding was consistent with Khosrowshahi and Arayici [
7] which found inadequate marginal utility to be realized by using BIM. Another high-loading hindrance was H02. It was unrealistic to expect the major stakeholders to be willing to share both liabilities and rewards, although such sharing would help build transparency, trust, and collaboration within the team.
In addition to the need for training the executives (H01), “lack of skilled employees and need for training them on BIM and OSM” (H04) was also related to training. Very often the employees tended to be reluctant to adopt the new technology and participate in the new workflow [
37], while the post-survey interviewees highlighted the concern about the executives’ willingness to train their employees in Singapore. One example of such reluctance is that many firms could not take advantage of the commonly-used data exchange format (Industrial Foundation Classes, IFC), and still use proprietary formats (H47) which would not enable smooth data exchange with other parties.
4.3. Conceptual Framework and Validation
The conceptual framework was constructed to depict the critical hindrances to BIM implementation and the hypothetical influence paths among the hindrances groupings (
Figure 2). Three hypotheses were involved in the framework:
Hypothesis 1. Lack of executive vision and training positively contributes to lack of continuous involvement and capabilities.
Hypothesis 2. Lack of continuous involvement and capabilities positively contributes to lack of collaboration and model integration; and
Hypothesis 3. Lack of executive vision and training positively contributes to lack of collaboration and model integration.
Structural equation modeling (SEM) has been recognized as a good technique in terms of relationship analysis among variables [
42,
58]. A SEM model includes structural and measurement models. The measurement model presents the relationships between measured variables (the critical hindrances) and latent variables or constructs (the hindrance groupings), and the structural one specifies the relationships among the three hindrance groupings. Two types of SEM are commonly-used: covariance-based SEM (CB-SEM) and partial least-squares structural equation modeling (PLS-SEM). Compared with CB-SEM, PLS-SEM: (1) ensures a good statistical power when the sample size is small [
59]; (2) can deal with non-normal data sets [
60,
61]; and (3) can identify key driving constructs [
62]. In this study, PLS-SEM was used as the sample size (87) tended to be inadequate for CB-SEM, and this study primarily aimed to investigate the intergroup relationships and driving hindrance groupings. In addition, this approach was widely used in project management research conducted both in Singapore [
42,
58] and globally [
63,
64].
SEM can efficiently fit the data and the SEM model. This was because confirmatory factor analysis (CFA) and path modeling analysis were simultaneously conducted. CFA was performed to test whether the 21 critical hindrances could represent well the three hindrance groupings. Furthermore, to check whether the path coefficients (related to hypotheses) were statistically significant, the bootstrapping technique [
65] was applied in this study. Hair et al. [
62] suggested that 5000 bootstrap subsamples should be used, which were randomly drawn from the 87 data sets.
The PLS-SEM analysis results required the following interpretations: (1) reliability and validity testing; and (2) relationships assessment according to the path coefficients obtained from the analysis. The reliability and validity of the measurement model should be assessed using the indicators and their thresholds: (1) 0.70 for the Cronbach’s alpha coefficients [
47]; (2) 0.55 for the factor loadings of the measured variables [
66]; (3) 0.50 for the average variances extracted (AVEs) of the latent variables [
67]; and (4) 0.70 for composite reliability (CR) scores [
62]. In addition, discriminant validity should be assessed to test a construct’s distinction from others. Two traditional methods were widely used in previous studies: (1) the Fornell-Larcker criterion that the square root of the AVE of each construct should exceed the correlation between this construct and any other constructs [
67]; and (2) the cross-loading assessment that a measured variable’s factor loading on its respective construct should be greater than its cross-loadings [
68].
However, Henseler et al. [
69] found that the two traditional assessment methods are not reliable in terms of detecting the lack of discriminant validity in PLS-SEM. This is because such methods would result in an unacceptably low sensitivity, especially in the situation that the AVE is low. Instead, this said study proposed that heterotrait-monotrait ratio of correlations (HTMT) should be a new approach. The HTMT is the average of the heterotrait-heteromethod correlations (the correlations of the measured variables across the constructs that measure different phenomena). The HTMT can be used in two ways: (1) being a criterion; or (2) being a statistical test. If the value of the HTMT is higher than a predefined cutoff point (0.85 or 0.90), this suggests that the SEM model lacks discriminant validity. Henseler et al. [
69] suggested that 0.90 is more suitable (referred to HTMT
0.90) when the sample size is around 100 and the AVE values are not high. Alternatively, the HTMT can form the foundation of a statistical discriminant validity test. The bootstrapping procedure allows that confidence intervals for the HTMT can be constructed to test the null hypothesis (H0: HTMT ≥ 1.0) against the alternative hypothesis (H1: HTMT < 1.0). If 1.0 (held in the H0) falls within a confidence interval, it can be concluded that the SEM model lacks sufficient discriminant validity; conversely, if 1.0 does not fall within the range of the interval, one may conclude that two constructs are empirically distinct.
Table 5 and
Table 6 show the results of CFA which was conducted using the software SmartPLS 3. As indicated in
Table 5, all the factor loadings were greater than 0.55, which were significant at the 0.05 level (critical
t-value = 1.96). Besides, all the values of the Cronbach’s alpha, AVE, and CR exceeded their respective cutoff values. Meanwhile, it could be seen from
Table 6 that the
p-values for the HTMT tests among the three hindrance groupings were below 0.05, and that the HTMT values were smaller than 0.90. Therefore, both the HTMT test and the HTMT
0.90 criterion indicated that the SEM model met the requirements of the discriminant validity. Thus, the measurement model was reliable and valid for the structural path modeling. In addition, the absolute model fit statistics that were available in the PLS-SEM outputs were acceptable. Standardized root mean residual was 0.066, below 0.10 which, as recommended by Hair et al. [
55], was the cutoff point, and the Chi-Square value (320.029) was large. Furthermore, the bootstrapping results in
Figure 2 suggested that all the path coefficients (0.719, 0.449, and 0.414, respectively) for the three hypotheses were positive, with the
p-values of 0.000. The coefficients of determination (
R2) for lack of collaboration and model integration and lack of continuous involvement and capabilities were 0.712 (with
t-value at 11.662 and
p-value at 0.000) and 0.512 (with
t-value at 4.671 and
p-value at 0.000), respectively. Hence, these statistics validated the conceptual framework (
Figure 2). The subsequent sections will discuss this framework’s rationale.
4.3.1. Hypothesis 1
This hypothesis that the lack of executive vision and training positively contributes to the lack of continuous involvement and capabilities was supported by the PLS-SEM analysis results. BIM implementation requires not only sufficient resources such as costly infrastructure, but also competent and experienced personnel that can be trained or engaged from the market [
57]. Insufficiency of any kind of the capabilities would hinder BIM implementation. This tallies with the post-survey interviews that in practice the practitioners in Singapore should be provided with training and education programs as well as technical support for BIM adoption. This is because they may not be knowledgeable and experienced about a higher level of BIM implementation. In most cases, the executives can determine the allocation of the capital investment to purchase and upgrade the infrastructure, and the sponsorship of training programs [
42]. However, the post-survey interviewees also reported that the management of many firms in Singapore tend to keep things under control as they previously did, because compared with the relatively straightforward implementation cost, the benefits of BIM implementation tend not to be so concrete. Thus, without the executive support (H01), training sessions could not be arranged (H04 and H47), and a higher resource allocation priority could not be obtained, leading to the lack of the capabilities among the major stakeholders (H07, H14, H31, and H42).
In addition, the continuous involvement of the major stakeholders is crucial to BIM implementation [
53]. Nonetheless, the professionals involved in the post-survey interviews pointed out that in the Singapore context, the downstream parties are often vary of providing professional advice in the design modeling due to potential liabilities, and the upfront parties are cautious about providing design information in the later stages. The stakeholders are unaware of or unwilling to internally waive the liabilities in the project team (H02), and tend to be reluctant to change their customized ways of working and blaming (H05). Nothing is more critical to BIM implementation than a supportive project culture, which depends largely on the project leadership team. Thus, the lack of executive vision and mission would hinder the continuous involvement of the key stakeholders (H12) and the constant model updates (H32).
4.3.2. Hypothesis 2
The hypothesis that the lack of continuous involvement and capabilities positively contributes to the lack of collaboration and model integration was supported. Collaboration is the precondition to BIM implementation because the major stakeholders need to communicate and exchange information with others to complete their scopes of work. The early and active involvement of the downstream stakeholders is critical to building trust and sharing knowledge with others, which facilitates the project-wide collaboration needed for multidisciplinary model integration [
53]. Thus, the lack of continuous stakeholder participation (H12) prevents the team from working collaboratively (H27). On the other hand, the collaboration between the design team and the construction team will not intrinsically lead to a blending of disciplines [
16]. In the Singapore context, even in the construction phase, there was generally insufficient collaboration between the design consultants and the contractors. The communication between the designers and site managers was weak. Under the current contractual framework of Singapore, the relationships tend to be adversarial. The constant updating and management of broadly accessible digital information would potentially subject the designers and the contractors to increased liabilities as the project proceeds [
26]. Therefore, the lack of proper assignment of responsibilities and allocation of risks (H32) would point to the need for collective risk management and model management (H28, H33, and H34). In addition, plenty of resources upfront are also needed to create and fix the model early (H36). Thus, the lack of capital resources (H31 and H42) creates a difficulty in the model integration (H43, H45, and H46). Moreover, the staff may unconsciously evaluate whether their knowledge, skills, and experience are good enough to enable them to be involved in the BIM-based work practices. If they regard themselves as less competent and experienced individuals in working with BIM (H07 and H14) or have not yet learnt about similar success stories, they would not actively use BIM (H09). Because of human nature, the negative mindset and passive behavior may in turn keep their inertia to continuously learn about relevant processes (H35). This would result in fragmented or discipline-specific BIM implementation, rather than project-wide collaboration and multidisciplinary design modeling and integration. In the post-survey interviews, the experts also emphasized the importance of building a high level of capabilities in the project team, as experienced and skilled personnel that can lead BIM modeling teams are still lacking in the current market in Singapore.
4.3.3. Hypothesis 3
This hypothesis that the lack of the executive vision and training positively contributes to the lack of collaboration and model integration was also supported. It is worth noting that when faced with change, people would possibly react in their accustomed and comfortable ways as well as be biased against the reality [
70]. The executives may be unwilling to change (H01) when they have long been psychologically entrenched in the traditional drafting practices [
7] and cannot see the value of BIM in increasing inter-organizational collaboration and improving work efficiency [
1]. It has been verified in numerical studies and projects that BIM implementation can facilitate information integration across the lifecycle, and close collaboration among the participants [
71,
72]. People may still bias or ignore the reality (H09) and be reluctant to learn the new working method (H35). The post-survey interviewees also highlighted that although the executives of many firms in Singapore change to use 3D tools, the leadership style appeals to continue to keep a 2D mindset (H05). Additionally, without the pre-agreed liabilities and rewards sharing arrangements (H02), the downstream parties, if involved upfront, would work financially at risk (H28 and H33) and lack motivation and enthusiasm to work collaboratively with others (H27). Some stakeholders may take advantage of information asymmetry at the cost of other stakeholders. They think that the efforts spent in collaborating with others toward a “win–win situation” would discourage them from optimizing the benefits they could have obtained [
8]. Consequently, the project-wide transparency and collaboration cannot be built; the construction and operations expertise cannot be incorporated into the upfront design modeling and multi-disciplinary coordination (H36), and potential liability issues would inevitably be raised in the dynamic model management in different phases (H34). Furthermore, if the IFC data exchange format is not used by all the parties (H47), the cross-enterprise design integration would be difficult (H43 and H45). Besides the interoperability standards and guidelines, local experimentation and continuous learning play a central role in BIM implementation [
1]. Thus, the lack of training programs (H04) hinders the continuous improvement of the skill sets (H46) required by the model integration and management throughout the project.
4.4. Managerial Strategies
To reduce the 21 critical hindrances to BIM implementation, six managerial strategies (
Figure 2) have been proposed based on the data analysis results. These strategies can not only help the leadership teams of building projects in Singapore to reduce possible hindrances in their BIM implementation practices, but also provide insights for the local government to refer to when rolling out new regulations related to BIM implementation.
Executive commitment (MS1). The planning, design, construction, and operations and maintenance processes have been increasingly relying on the information models [
26]. The executives of the primary project participants should recognize the inevitable change to adapt to the information-oriented project delivery and continually commit on BIM diffusion which will probably be stunted if the participants cannot implement their part of BIM (H01 and H09). With the tone of changing at the top, the employees who carry out day-to-day work on the shop floor must change their passive mindsets and behaviors (H05). Moreover, the willingness of implementing BIM is also affected by the Singapore government’s policies, competitor motivation, financial incentives, and technical support [
9]. The post-survey interviewees recommended that in addition to the existing government mandate and support in Singapore, incentives such as additional GFA for the owner and a series of objective performance milestones for the designers and contractors need to be formulated.
Involvement and integration (MS2). The participants should be early involved and physically collocated to build trust and collaboration as the BIM adoption in Singapore tended to be firm-based. Specifically, the key contractors, manufacturers, and facility management team downstream can contribute their knowledge and experience in the digital design modeling upfront (H12), which enables to fix the design early and build constructability in the design (H36). Otherwise, problems may occur in the subsequent stages where design changes would be costly. The close collaboration and frequent communication upfront may help address the interoperability issues such as by using predetermined software or software versions and interoperability standards (H43). This can align fragmented BIM adoptions in different participants by integrating their discipline-specific models. Furthermore, these preparatory work would also serve as the basis of collaboratively managing the digital model in the later stages (H34).
Standard contract (MS3). An updated version of the BIM Particular Conditions in Singapore should be developed as the standard contract (H33) to incorporate the BIM work processes into the local contractual framework because the current version was partly completed [
73]. As mentioned earlier, currently, the design processes may not be collaborative because the design team and the construction team in Singapore tend to individually create different models. The new multi-party contract should be set by the local government and incentivize the participants to openly share data, which helps improve the contractual relationships (H27) among these primary participants because they can act as a collaborative team (H28). Besides, the flow of information can also be ensured in the model management. In addition, the owner should set relevant contractual requirements on BIM when building the project team. Otherwise, the service providers’ motivation and willingness of implementing BIM in practice would be affected [
33].
Aligning business interests (MS4). Sharing business interests should be agreed on by all the key stakeholders (H02) in the contract. This will build the necessary trust and the continuous collaboration among the participants [
53]. All the participants should have a clear understanding of the opportunities, risks, and responsibilities when incorporating BIM work practices into the project workflow in Singapore. Sharing risks (H32) forces them to be responsible for the project rather than shifting risks or blaming their partners, whereas sharing rewards drives the team to think and behave in a best-for-project manner. These avoid the downstream parties from working at risk upfront. Furthermore, the individual corporate goals are bound with the project outcomes. It is worth noting that individual parties can leverage BIM only when it is successfully implemented in the project.
Sufficient resources (MS5). The management should allocate sufficient resources which are not limited to the skilled personnel, tools (H45 and H46), and information technology support, but also the capital investment (H31 and H42). For example, BIM software have been constantly improving to enable the cross-discipline integration at the construction level. The post-survey interviewees, however, reported that the hardware in many firms in Singapore cannot support the advanced software applications efficiently. In addition to the local government’s subsidies, the primary participants should also invest in improving their infrastructure. It should be noted that BIM implementation may span many years; those who achieve enhanced BIM implementation will gain a competitive advantage when bidding for building projects in future, which in turn helps convince them to guarantee the sufficiency of the resources [
74].
Training for competencies (MS6). Apart from the awareness and willingness to implement BIM, technical knowledge and ability is also needed [
8]. Training programs should be provided to build the staff’s competencies (H04, H07, H14, H35, and H47) and thus reduce their anxieties about their qualifications for being involved in the new project workflow in Singapore. Once the project team is built, the owner may provide trainings to the service providers on how to use new software applications, reinvent workflow, assign responsibilities, and collaborate with others using interoperability tools like IFC. For instance, it is imperative in practice to maintain integrity across design models, because changes are made to the different models by their respective disciplines. Both manual updates using IFC and smart automated transactions in BIM servers require specialized expertise. In addition, the major stakeholders should also arrange constant in-house training and education programs to help their staff adapt to new policies and work rules and procedures.
