Article

Performance Measurement and Analysis of Building Information Modeling (BIM) Applications in the Railway Infrastructure Construction Phase

1
Department of Railroad Construction System Engineering, Woosong University, Daejeon 34606, Republic of Korea
2
School of Architecture & Architectural Engineering, Hanyang University, ERICA Campus, Ansan 15588, Republic of Korea
*
Authors to whom correspondence should be addressed.
Appl. Sci. 2024, 14(2), 502; https://doi.org/10.3390/app14020502
Submission received: 6 December 2023 / Revised: 29 December 2023 / Accepted: 3 January 2024 / Published: 5 January 2024

Abstract

:
Building information modeling (BIM) is acknowledged for enhancing efficiency and collaboration in the construction industry. However, its application in the construction phase of railway projects faces challenges. This study, utilizing quantitative and qualitative analyses, explores the advantage of BIM consulting services in the railway infrastructure projects. A comparative analysis of similar-scale projects shows that BIM significantly boosts construction efficiency, yielding a 197.6% economic benefit in pilot projects. This study also delves into the BIM application environment in railway construction. Our findings provide valuable insights into BIM’s advantages and challenges, emphasizing the need for further research. The results will contribute to advancing railway infrastructure and promoting BIM’s application, aiding decision makers and practitioners in understanding its potential contributions to a more efficient and sustainable industry.

1. Introduction

1.1. Background

Building information modeling (BIM) is a digital process involving the creation and management of a virtual model throughout the entire lifecycle of a construction or infrastructure project [1]. By sharing the model information, it significantly enhances work efficiency and enables collaborative management [2]. This is evident in stakeholders optimizing designs and construction processes through the visualization and simulation of construction processes, enabling the identification of potential issues [3,4]. Moreover, it facilitates communication and coordination among architects, engineers, contractors, and owners throughout the entire construction project [3]. Despite the proven advantages of BIM applications in various studies, there remain challenges in precisely measuring the details of BIM’s specific application’s environmental and economic benefits during the construction phase [5].
Several countries and organizations worldwide have developed BIM standards and guidelines to overcome challenges and promote BIM usage. For instance, the International Organization for Standardization (ISO) updated the global BIM standards in 2020 [6]. The UK has adopted three different levels of BIM standards [7], while countries like the United States, Finland, Norway, Singapore, and South Korea have issued their national BIM application standards to establish BIM working environments. These guidelines serve as blueprints for BIM implementation, assigning roles and responsibilities to various stakeholders. Despite widespread BIM applications in recent years [8], most of the literature analyzing BIM concentrates on architectural projects, with limited focus on infrastructure construction, building maintenance, and protection. In earlier publications [9], the authors explored the advantages of BIM applications in the design phase of the railway infrastructure, providing examples through quantitative research analyzing cost, work hours, and labor differences during the design phase. Additionally, qualitative research analyzed the primary tasks involved, offering insights into the application of BIM in the design phase of railway infrastructure.
However, due to higher demands on personnel, work hours, and costs during the construction phase when compared to the design phase, whether the use of BIM in the construction phase offers advantages in terms of cost and time savings is a question that this study attempts to address. Thus, to evaluate the performance of BIM applications during the construction phase of railway infrastructure projects. To achieve this, the authors conducted in-depth investigations and interviews, collecting data on the application of BIM during the construction phase from two ongoing railway infrastructure projects and the involved BIM consulting companies. Through data analysis, a quantitative assessment was performed by comparing the cost-effectiveness, work hours, and differences in the number of workers between situations where construction companies independently used BIM and cases where professional BIM consulting services were engaged. A qualitative analysis was conducted on the specific tasks, information data, location information, software used, and other aspects of BIM participation in the work, aiming to identify the specific advantages in terms of economic benefits gained from using BIM during the construction phase of railway infrastructure projects.

1.2. Research Review

To gain a comprehensive understanding of the advantages of BIM applications in railway construction projects, the authors conducted a literature review on the relevant research, with a particular focus on cost-effectiveness and studies involving practical case applications. Within our analysis of the Web of Science database (WoS) of the combination of “building information modeling (BIM)” (title) and “construction industry” (topic), there are 1076 article publications (Dec 29, 2023). The result distribution by country and region show there are 276 papers published in China (25.65%), 158 papers in England (14.68%), and 133 papers in the USA (12.36%); the publication of South Korea has 66 papers which make up 6.13% (Figure 1). We selected and analyzed some of the publications that related to BIM application in railway construction. On the other side, the publications of WoS by research area show that there are 714 (66.357%) papers in the engineering area were published, construction buildings have 393 papers set up by 35.524%, and business economics have 145 papers set up by 13.476% (Figure 2).
In these related publications, Sholeh, M. N. et al. proved that BIM applications could reduce 50% of time costs and reduce costs by 52.36% [10]. Azhar, S. et al. revealed the critical importance of accurate cost estimation and quantity surveying for effective budgeting and cost control in achieving cost benefits [11]. BIM application through collision detection allows for the early identification of design errors, ensuring timely issue resolution before construction. Due to technical staff checking for errors in advance, thereby reducing additional construction periods and saving costs in a railway subject. Thus, the integration of BIM into the rail industry is becoming a global trend [12]. Additionally, BIM contributes to construction planning and constructability analysis, enabling efficient project scheduling and construction process planning [13]. With BIM, the on-site validation, guidance, and tracking of construction activities become more straightforward, leading to increased productivity and quality control [14,15]. Shin, M. H. et al. emphasized the cost savings and project outcome improvements that implementing BIM in railway construction projects in the design phase may bring [16]. Moreover, BIM has gained recognition in multiple railway construction projects. For instance, Taiwan High-Speed Rail Corporation, in which BIM technology was used in the construction of the Changhua Station [17] and the Honam High-Speed Railway Lot No. 4-2 in Korea [18] successfully applied BIM in railway infrastructure construction [19].
These referenced studies delve into the application advantages of BIM in project construction, discussing how BIM supports the design, construction, and maintenance of railway construction projects, as well as how it yields economic benefits and cost savings. Integrating BIM into railway projects offers numerous advantages, including collaboration, time savings, cost optimization, conflict prevention in networks, facility management optimization, and enhanced engineering quality [12]. Leveraging BIM in railway construction projects empowers stakeholders to enhance decision-making processes, streamline project delivery, save costs, and enhance the overall efficiency of the industry [20].

2. Materials and Methods

Following is the methodology we used for this study, which is divided into two parts: qualitative research and quantitative research. In recent years, there have been plenty of publications on the effectiveness of BIM applications in the Web of Science, drawing significant attention from researchers. However, by searching WoS with topics “quantitative” and “railway”, there is only one publication result [16] that proved a lack of cost-effective quantitative research on the performance evaluation of BIM application in the field of railway infrastructure construction. Therefore, there is strong research significance in qualitatively and quantitatively studying the performance of BIM application environments [21,22,23]. Unlike previous studies, Ref. [16] which examined applications in the design phase, this study is about the construction phase. On the other hand, considering that railway construction projects typically involve longer durations, broader scopes of work, larger scales, and bureaucratic challenges compared to building projects, enterprises tend to retain traditional working environments. From this perspective, this study seeks to confirm the specific advantages of using BIM professional consulting in the railway construction industry and whether BIM consulting can offer better support for infrastructure construction projects in future BIM applications.
This study conducted a comparative analysis on two railway construction projects of similar scale to explore the advantages of BIM professional consulting services in the performance of the construction phase. However, for information security reasons, the report refers to these projects as “Project 1” and “Project 2”, as they are currently in the implementation phase. Both projects commenced simultaneously in July 2021. Project 1 spans 1.948 km, comprising two tunnels and three bridges, while Project 2 spans 2.810 km, including one tunnel and one overpass bridge.
Due to the extended duration of the construction projects, data collection for this measurement study spanned ten months. Quantitative data were collected by BIM consulting companies and construction enterprises. Separately, the project manager collects data based on the questions in the monthly project plan and quantitative template and provides it to the researcher each month, while qualitative data were obtained through in-depth interviews and surveys conducted by researchers with the construction project manager, BIM consulting company manager, and technical personnel. The researcher conducted in-depth interviews with engineers who were actually involved in the construction of the project according to the questions in the qualitative survey template, which consisted of a total of three interviews that lasted a total of ten months (the first month, the fifth month, and the tenth month). The number of interviews was based on twenty people. To ensure the objectivity of the data, the researchers were conducted anonymously in groups of three to the engineers involved in Project 1 and Project 2, respectively.

Measurement Template

In order to showcase the comprehensiveness of the research project, the researchers designed a survey template addressing both qualitative and quantitative analysis questions. The measurement template was crafted to cover aspects such as BIM deliverables, project duration, quality assessment, labor costs, BIM human capital, BIM investment factors, etc. Through in-depth interviews and discussions with BIM consulting companies and construction enterprise managers, the measurement template was refined and finalized. Quantitative measurement questions were categorized into 7 groups, comprising 16 aspects and a total of 21 questions. Qualitative measurement questions were organized into 4 groups, covering 8 aspects and a total of 15 questions. These questions cover personal information of the respondents, their BIM experience, salary levels, work-related details, and other relevant aspects (Table 1 and Table 2).
According to the quantitative measurement template, the authors devised formulas for quantitative measurements during the construction phase, as illustrated in Table 3. Data for this section will be recorded by the construction unit and professional BIM consulting companies during the construction process. Considering the unique nature of construction phase projects and assuming other costs, such as materials and equipment, remain constant, the most influential factors on costs are delays in project duration and labor costs. Therefore, cost calculations primarily involve three fundamental values: (a) base costs; (b) labor costs based on different skill levels; and (c) working days. It is worth noting that some factors among these, irrespective of BIM participation, have a minimal impact on performance calculation results. Examples include rework and rebuilding costs, rework prevention costs, BIM training, BIM support, and BIM investment.

3. Analysis and Results

3.1. Quantitative Analysis

3.1.1. Comparative Analysis of Investment Cost

Although questions involving 16 areas were designed for quantitative research when the researchers developed the quantitative research template. However, in analyzing the results, it was found that there were some data virtually unchanged with or without the involvement of a professional BIM consultancy (e.g., code a–d), or had very little impact (e.g., code k–p). In addition, because railway engineering construction is a large and complex project, this process involves a very complicated amount of work; in order to simplify the calculation, we assume that all other conditions are fixed situation, selected the three aspects of the greatest impact on the project investment to measure the comparison (e–g).
The cost-effectiveness of BIM in the construction phase primarily manifests in labor costs and construction duration. With the intervention of BIM information, it becomes possible to proactively prevent common occurrences in the construction process, such as clashes, design inconsistencies, or other issues leading to design changes. This proactive approach helps reduce construction duration and lower costs. However, it is crucial to note that rework caused by issues like substandard construction quality is something BIM cannot entirely prevent. To conduct a comprehensive cross-sectional analysis of the impact on cost-effectiveness between the involvement of professional BIM consulting services and the use of BIM by construction companies themselves, the quantitative survey focuses on factors that significantly affect economic benefits under professional BIM consulting involvement. Factors with relatively minor impacts, such as BIM training costs and BIM investment costs, are excluded from the analysis. For clarity in the following discussion, “BIM” will represent the scenario where professional consulting services are involved, while “Non-BIM” will represent situations where construction companies use BIM on their own. During data collection, professional BIM consulting companies and construction companies selected similar-scale work content from Project 1 and Project 2 for measurement.
On the other hand, some literature indicates that BIM technology has not been widely disseminated and applied in the South Korean construction industry, particularly in construction projects [24]. On-site construction management personnel still exhibit hesitation toward adopting BIM technology [25]. This observation was confirmed through in-depth interviews with BIM consulting companies and management personnel from construction companies. Presently, the practical application of BIM in South Korean construction projects is primarily limited to the design phase. Due to technological imperfections and a lack of experience, a significant gap exists in the actual application of BIM for most construction companies. Therefore, the focus of this quantitative analysis is primarily on (e) labor costs; (f) costs of resolving clashes and preventing delay; and (g) rework costs incurred due to design changes and errors. These aspects are considered critical areas that require special attention in the application of BIM during the construction phase.
In the case of rework resulting from design changes and errors, it involves modifying existing models and adding detailed models. Labor costs are composed of the quantity of labor and the corresponding work details on the construction site, reviewed by on-site construction management. Regarding the costs associated with resolving clashes and preventing construction delays, this includes measures such as proactively addressing clash issues and preventing delays in the construction schedule. These measures involve creating and simulating safety-integrated models, updating data, and similar actions.
According to Table 4, in the investigation of labor costs, it was found that, with the participation of professional BIM consulting, the labor costs in Project 1 were USD 12,395, and in Project 2, they were USD 17,600. Without BIM consulting, the labor costs were USD 61,976 and USD 51,646, respectively. Regarding the cost of resolving collision issues and preventing delays, during the BIM consulting period, the construction cost for Project 1 was USD 30,643, and for Project 2, it was USD 15,838. The costs without BIM consulting were USD 45,965 and USD 24,445, respectively, which was significantly higher than the working environment with the participation of professional BIM consulting.
In terms of rework when design changes and errors occur, the rework costs for projects 1 and 2 with BIM consulting were USD 24,790 and USD 44,415, respectively. The costs without BIM consulting were USD 37,185 and USD 66,623, significantly higher than the construction costs for contractors using BIM. For performance measurement analysis, in “Cost Measurement with BIM Consulting,” each cost is defined as an investment cost in the construction phase. In “Cost Measurement by Contractors,” each cost is defined as a basic cost in the construction phase. The percentage increase in costs can be calculated by dividing basic costs by investment costs.
As shown in Table 5, the investment percentage for Project 1 is 214.0%, resulting in a cost efficiency improvement of 114.0%. For Project 2, the percentage is 183.3%, leading to an 83.3% improvement in cost efficiency. In terms of the average total costs, with the participation of a BIM consulting company, the calculated average investment cost in the construction phase is approximately USD 72,840, including labor costs, costs of resolving collision issues and preventing delays, and rework costs when design changes and errors occur. On average, if constructed solely by contractors, the average basic cost in the construction phase is approximately USD 143,920. When a professional BIM consulting company is involved, the average total investment cost percentage is 197.6%, resulting in a cost efficiency improvement of about 97.6%.

3.1.2. Comparative Analysis of Working Days and Worker Numbers

To further understand the impact of BIM applications on labor quantity and construction time, Table 6 compares the changes in the number of workers and working days between scenarios with and without the participation of professional BIM consulting. These data are collected from measurements conducted separately by the construction units and BIM consulting units of the two projects. For readability, unchanged data are represented by “—”.
The results indicate that, in terms of the number of workers, the scenarios of addressing collision issues, preventing delays, and rework costs due to design changes and errors did not result in changes, regardless of the participation of professional BIM consulting companies. However, with the involvement of BIM consulting, the number of workers increased by one person and three persons at the two construction sites (from two to three persons and from two to five persons, respectively). Although the number of construction personnel increased when compared to self-construction by the construction units, the total working days at the two sites reduced from 120 days to 24 days and from 100 days to 18 days, respectively.
Comparing the data from the two construction sites, the total number of workers slightly increased when BIM consulting was involved, from 31 to 32 persons for Project 1, and from 25 to 28 persons for Project 2. The average total number of workers also slightly increased from 28 to 30 persons. However, the total working days at the construction site of Project 1 rapidly decreased by 96 days, from 197 days to 101 days, and the construction site of Project 2 also reduced by 82 days, from 207 days to 125 days. The average total days decreased significantly from 202 days to 113 days, a reduction of 89 days. This indicates that the involvement of BIM consulting companies, while increasing the average number of workers, effectively shortens the working time, thereby reducing the overall investment cost of construction projects.

3.2. Qualitative Analysis

Based on the qualitative survey questions, we have organized our survey results into the following areas.

3.2.1. The Content of Work and Time Spent on BIM Usage

To understand the content of using BIM, the researchers collected information on the tasks involved in the construction phase BIM participation and the time spent on BIM. These tasks were detailed into additional detailed modeling, constructability review, process management, construction cost management, and site management. A total of 379 work items were collected from Project 1, and 410 work items were collected from Project 2 (Table 7).
The results show that, in terms of the content of BIM work, Project 1 had a higher number of additional detailed modeling tasks (173 items), accounting for 45.65% of all work, followed by construction cost management (67 items), and the least was process management (41 items). Similarly, in Project 2, the highest number of tasks was related to additional detailed modeling (205 items), accounting for 52.35%, followed by process management (83 items), and the least was constructability review (19 items). In terms of time spent, Project 1 invested the most time in additional detailed modeling (675.5 h), accounting for 46.30% of all work. Process management and site management took the least time, constituting only about 8% of the total work time. Similarly, Project 2 spent the most time on additional detailed modeling (860.2 h), accounting for 52.35% of all work. The least time was spent on constructability review (56 h), representing only 3.41% of the total work time.
Therefore, it can be observed that in the specific tasks of BIM applications in the construction phase of railway projects, the main focus is on additional detailed modeling, which nearly constitutes half of all BIM work and is also the most time-consuming part of the work.

3.2.2. Categories by Location Information

During the measurement phase of the pilot project, researchers investigated the location information and work proportions of the issues handled by BIM (Figure 3). Apart from uncategorized information, the issues in Project 1 were, in order, tunnel (21.90%), construction road (5.01%), and existing structure (2.64%). In Project 2, the issues were, in order, tunnel (58.05%), underground passage (6.83%), and existing structure (6.10%). Therefore, it can be observed that in the construction phase of railway projects applying BIM, the most commonly addressed issues are related to tunnels.

3.2.3. Detail Information of BIM

Based on the historical data of on-site BIM-related work, detailed information was classified, and its weight throughout the entire process was examined. In Project 1, the main issues addressed by BIM were modeling (33.25%), followed by quantity verification (17.68%) and modeling materials (10.29%) (Figure 4). Similarly, in Project 2, the primary issues were modeling (35.61%), followed by quantity verification (13.41%) and process schedules (9.76%). Therefore, in both construction projects, tasks related to modeling constitute the largest proportion of BIM-related work.

3.2.4. Usage of BIM Software

Researchers categorized the software used in experimental on-site work and examined its proportion throughout the entire process. The top three applications used in Project 1 were Revit (45.12%), Navisworks (26.76%), and Excel (12.30%) (Figure 5). These applications were utilized for additional detailed modeling, construction feasibility reviews, process management, cost management, and on-site management tasks.
In Project 2, the predominant BIM software was Revit, accounting for 53.45%, followed by Navisworks (13.78%) and AutoCAD (13.59%). Overall, Revit emerged as the most commonly used BIM application in construction projects, likely due to its primary association with modeling tasks in the field of architectural engineering.

3.2.5. Effects of BIM Application

Researchers conducted in-depth interviews to investigate the effectiveness of BIM applications in solving problems based on work content categories during the pilot work at the construction site. For further detailed modeling, precise quantities could be calculated, and model quality could be improved through thorough inspections of individual objects, enabling comprehensive material management. In the process of construction feasibility reviews, errors could be identified to enhance the accuracy of information, and stability reviews could identify the risk areas, leading to design changes as required by the data. During process management, issues could be easily seen by others due to information sharing, promoting interdisciplinary communication. Task history records facilitated monthly manpower checks (M/M). When calculating quantity data, comparing and reviewing construction cost management tasks allowed for sharing the work status with the headquarters, enabling on-site managers to inspect monthly work progress and visually confirm the 4D construction status of each process (Table 8).

4. Discussion

This analysis of investment costs in this study primarily focused on labor costs and rework costs, overlooking other critical aspects within the comprehensive and intricate processes of the construction phase. The intricacies of the construction phase encompass various factors, including material costs, construction machinery and equipment costs, construction network scheduling, process management, construction quality management, safety management, and operation and maintenance. These factors play a pivotal role throughout the construction process, significantly influencing the cost-effectiveness of the project.
Material costs represent a significant component of the construction phase, directly impacting the economic and sustainable aspects of the project. The application of BIM can optimize material selection and management, enhance material utilization, and reduce waste, ultimately leading to a reduction in material costs [26]. Additionally, the simulation and optimization of construction machinery and equipment through BIM technology can effectively lower equipment costs and improve construction efficiency [27].
Construction network scheduling plays a crucial role in project success, and the utilization of BIM in this aspect is expected to enhance the visualization and planning capabilities of the construction process. This improvement makes tasks clearer and more controllable, thereby reducing delays and improving schedule efficiency. Process management, construction quality management, and safety management are equally vital aspects of the construction phase that cannot be overlooked [28]. The application of BIM, through real-time monitoring and simulation, has the potential to elevate management levels, mitigate potential risks, and ensure the quality and safety of the project. This area provides a compelling avenue for future research into the application of BIM in the construction phase.
Furthermore, exploring the application of BIM in operation and maintenance during the construction phase is a noteworthy direction. By establishing a comprehensive information model during the construction phase, post-project delivery can be more effectively managed for operation and maintenance, achieving full lifecycle management [29]. This approach can lead to a reduction in operating costs and an extension of the facility’s lifespan.
However, in the current research, these factors have not been adequately addressed, potentially oversimplifying the application of BIM in the construction phase. Therefore, to enhance the level of BIM implementation in the construction phase in South Korea, there is a need to bolster training and technical support to improve the BIM skills of industry professionals. Only by augmenting the practical application capabilities of BIM on construction sites can the full potential advantages of BIM throughout the entire lifecycle of construction projects be comprehensively realized, resulting in more significant economic benefits. This also underscores the necessity for a more in-depth and comprehensive exploration of the promotion and practical application of BIM in the construction phase within the South Korean construction industry in the future. In addition, the construction projects involved in BIM will generate a large amount of data due to a large number of model modifications, and how to efficiently process the data, share the data, and store the data is also a great challenge in the practical application of BIM.
In summary, although this study has addressed the aspect of investment costs, the complexity of the construction phase presents broader and deeper challenges to the application of BIM. Future research should adopt a more comprehensive approach, taking into account various factors, to explore the full potential advantages of BIM in the construction phase and propose corresponding solutions. This effort aims to facilitate a more comprehensive and in-depth application of BIM in the construction industry in South Korea and globally. Long-term attention and thorough research in this field will contribute to continually refining the application of BIM technology in the construction phase, providing more reliable support for the sustainable development of the construction industry.

5. Conclusions

This study, building upon previous research on performance measurement methods for BIM projects both domestically and internationally, developed a performance measurement survey template for the construction phase of railway construction projects based on quantifiable performance measurement factors (BIM deliverables, duration, quality assessment, labor costs, BIM human capital, and BIM investment factors). The quantitative measurement involved twenty-one questions categorized into seven groups with sixteen aspects, while the qualitative measurement comprised fifteen questions across four groups with eight aspects. By comparing and analyzing the construction input costs, labor costs, and duration with or without the participation of professional BIM consulting companies, this study determined the final economic benefits.
The findings indicated that, during the construction phase of railway projects, construction companies experienced a cost benefit of 197.6% when engaging professional BIM consulting services. However, the extent of the ultimate cost benefit hinged on various factors, including project complexity, workload, construction review, and the expertise of BIM technical personnel. Furthermore, the involvement of BIM consulting firms resulted in a reduction in work time, leading to time savings. Analysis of on-site inspection reports revealed that BIM work primarily focused on additional detailed modeling, consuming nearly half of the total work time. Other prominent aspects included construction cost management, process management, and further detailed modeling. In terms of BIM software usage, Revit emerged as the predominant application on both construction sites, likely attributed to its significant role in additional detailed modeling. The precision in quantity calculation and intricate modeling facilitated by BIM contributed to enhanced work efficiency. Moreover, this study identified tunnels as the primary location where BIM effectively addressed issues, possibly due to the intricate nature of tunnel construction.

Author Contributions

Methodology, H.-Y.K.; Data curation, M.-H.S.; Writing—original draft, J.-F.L.; Writing—review and editing, J.-F.L.; Project administration, H.-Y.K.; Funding acquisition, M.-H.S. All authors have read and agreed to the published version of the manuscript.

Funding

This research was funded by the Ministry of Land, Infrastructure, and Transport in South Korea (Grant number: 22RBIM-C158185-03).

Data Availability Statement

The data presented in this study are available on request from the corresponding author. The data are not publicly available due to privacy.

Conflicts of Interest

The authors declare no conflicts of interest.

References

  1. Azhar, S. Building information modeling (BIM): Trends, benefits, risks, and challenges for the AEC industry. Leadersh. Manag. Eng. 2011, 11, 241–252. [Google Scholar] [CrossRef]
  2. Olanrewaju, O.I.; Chileshe, N.; Babarinde, S.A.; Sandanayake, M. Investigating the barriers to building information modeling (BIM) implementation within the Nigerian construction industry. Eng. Constr. Archit. Manag. 2020, 27, 2931–2958. [Google Scholar] [CrossRef]
  3. Becerik-Gerber, B.; Jazizadeh, F.; Li, N.; Calis, G. Application areas and data requirements for BIM-enabled facilities management. J. Constr. Eng. Manag. 2012, 138, 431–442. [Google Scholar] [CrossRef]
  4. Bynum, P.; Issa, R.R.; Olbina, S. Building information modeling in support of sustainable design and construction. J. Constr. Eng. Manag. 2013, 139, 24–34. [Google Scholar] [CrossRef]
  5. Gamil, Y.; Rahman, I.A.R. Awareness and challenges of building information modelling (BIM) implementation in the Yemen construction industry. J. Eng. Des. Technol. 2019, 17, 1077–1084. [Google Scholar] [CrossRef]
  6. ISO 19650-3:2020; Organization and Digitization of Information about Buildings and Civil Engineering Works, including Building Information Modelling (BIM). ISO: Geneva, Switzerland, 2020.
  7. Edirisinghe, R.; London, K. Comparative analysis of international and national level BIM standardization efforts and BIM adoption. In Proceedings of the 32nd CIB W78 Conference, Eindhoven, The Netherlands, 27–29 October 2015. [Google Scholar]
  8. Lee, S.; Tae, S.; Roh, S.; Kim, T. Green template for life cycle assessment of buildings based on building information modeling: Focus on embodied environmental impact. Sustainability 2015, 7, 16498–16512. [Google Scholar] [CrossRef]
  9. Shin, M.-H.; Jung, J.-H.; Kim, H.-Y. Quantitative and Qualitative Analysis of Applying Building Information Modeling (BIM) for Infrastructure Design Process. Buildings 2022, 12, 1476. [Google Scholar] [CrossRef]
  10. Sholeh, M.N.; Fauziyah, S.; Khasani, R.R. Effect of Building Information Modeling (BIM) on reduced construction time-costs: A case study. In Proceedings of the 5th International Conference on Energy, Environmental and Information System (ICENIS 2020), Online, 12–13 August 2020. [Google Scholar]
  11. Azhar, S.; Khalfan, M.; Maqsood, T. Building information modeling (BIM): Now and beyond. Australas. J. Constr. Econ. Build. 2012, 12, 15–28. [Google Scholar]
  12. Bensalah, M.; Elouadi, A.; Mharzi, H. Overview: The opportunity of BIM in railway. Smart Sustain. Built Environ. 2019, 8, 103–116. [Google Scholar] [CrossRef]
  13. Kaewunruen, S.; Xu, N. Digital twin for sustainability evaluation of railway station buildings. Front. Built Environ. 2018, 4, 77. [Google Scholar] [CrossRef]
  14. Koseoglu, O.; Nurtan-Gunes, E.T. Mobile BIM implementation and lean interaction on construction site: A case study of a complex airport project. Eng. Constr. Archit. Manag. 2018, 25, 1298–1321. [Google Scholar] [CrossRef]
  15. Park, J.; Cho, Y.; Kim, K. Field construction management application through mobile BIM and location tracking technology. In Proceedings of the 33rd ISARC International Symposium on Automation and Robotics in Construction, Auburn, AL, USA, 18–21 July 2016. [Google Scholar]
  16. Shin, M.H.; Lee, H.K.; Kim, H.Y. Benefit–cost analysis of building information modeling (BIM) in a railway site. Sustainability 2018, 10, 4303. [Google Scholar] [CrossRef]
  17. Lee, W.; Kang, S.; Moh, R.; Wu, R.; Hsieh, H.; Shu, Z. Application of BIM coordination technology to HSR Changhua station. Vis. Eng. 2015, 3, 5. [Google Scholar] [CrossRef]
  18. Cho, H.; Lee, K.H.; Lee, S.H.; Lee, T.; Cho, H.J.; Kim, S.H.; Nam, S.H. Introduction of Construction management integrated system using BIM in the Honam High-speed railway lot No. 4-2. In Proceedings of the 28th ISARC, Seoul, Republic of Korea, 29 June–2 July 2011. [Google Scholar]
  19. Abdal Noor, B.; Yi, S. Review of BIM literature in construction industry and transportation: Meta-analysis. Constr. Innov. 2018, 18, 433–452. [Google Scholar] [CrossRef]
  20. Inzerillo, L.; Acuto, F.; Pisciotta, A.; Dunn, I.; Mantalovas, K.; Zeeshan, M.; Di Mino, G. Virtual Reality and Bim for Infrastructures. Int. Arch. Photogramm. Remote Sens. Spat. Inf. Sci. 2023, XLVIII-2/W3-2023, 81–88. [Google Scholar] [CrossRef]
  21. Vilutienė, T.; Kiaulakis, A.; Migilinskas, D. Assessing the performance of the BIM implementation process: A case study. Rev. Constr. 2021, 20, 26–36. [Google Scholar] [CrossRef]
  22. Maraqa, M.J.; Sacks, R.; Spatari, S. Quantitative assessment of the impacts of BIM and lean on process and operations flow in construction projects. Eng. Constr. Archit. Manag. 2021, 28, 2176–2198. [Google Scholar] [CrossRef]
  23. Mosse, H.N.; Njuguna, M.; Kabubo, C. Influence of building information modelling (BIM) on engineering contract management in Nairobi, Kenya. World J. Eng. Technol. 2020, 8, 329–346. [Google Scholar] [CrossRef]
  24. Son, H.; Lee, S.; Kim, C. What Drives the Adoption of Building Information Modeling in Design Organizations? An Empirical Investigation of the Antecedents Affecting Architects’ Behavioral Intentions. Autom. Constr. 2015, 49, 92–99. [Google Scholar] [CrossRef]
  25. Park, E.; Kwon, S.J.; Han, J. Antecedents of the Adoption of Building Information Modeling Technology in Korea. Eng. Constr. Archit. Manag. 2019, 26, 1735–1749. [Google Scholar] [CrossRef]
  26. Nadeem, A.; Wong, A.; Akhanova, G.; Azhar, S.; Wong, S. Application of Building Information Modeling (BIM) in Site Management—Material and Progress Control; Springer: Cham, Switzerland, 2018; pp. 289–297. [Google Scholar]
  27. Sun, C.; Wang, M.; Zhai, F. Research on the Collaborative Application of BIM in EPC Projects: The Perspective of Cooperation between Owners and General Contractors. Adv. Civ. Eng. 2021, 2021, 14. [Google Scholar] [CrossRef]
  28. Jiang, Y. Intelligent Building Construction Management Based on BIM Digital Twin. Comput. Intell. Neurosci. 2021, 2021, 11. [Google Scholar] [CrossRef]
  29. Zhang, Y.; Dung, V.P. Monitoring and Maintenance of Highway Super-Large Bridge Based on BIM Technology. Wirel. Commun. Mob. Comput. 2023, 2021, 5495549. [Google Scholar] [CrossRef]

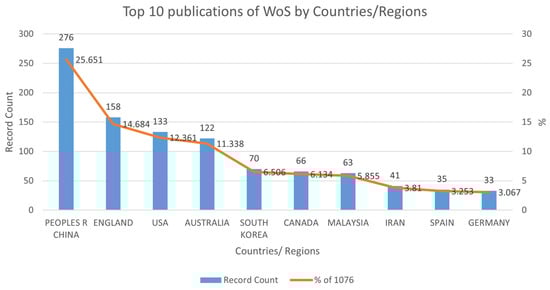

Figure 1. Top 10 publications of WoS by Countries/Regions.
Figure 1. Top 10 publications of WoS by Countries/Regions.
Applsci 14 00502 g001

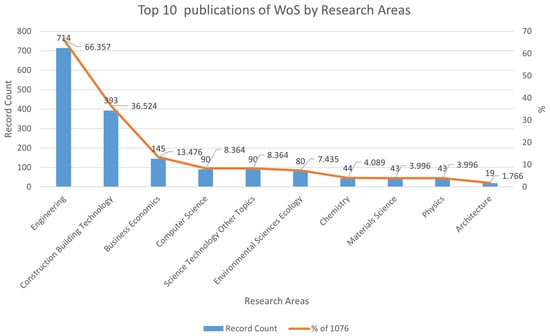

Figure 2. Top 10 publications of WoS by Research Areas.
Figure 2. Top 10 publications of WoS by Research Areas.
Applsci 14 00502 g002

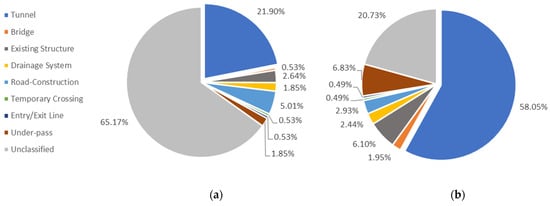

Figure 3. (a)The proportion of location information in Project 1. (b) The proportion of location information in Project 2.
Figure 3. (a)The proportion of location information in Project 1. (b) The proportion of location information in Project 2.
Applsci 14 00502 g003

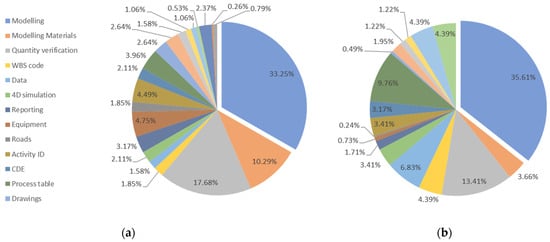

Figure 4. (a) The proportion of detail information in Project 1. (b) The proportion of detail information in Project 2.
Figure 4. (a) The proportion of detail information in Project 1. (b) The proportion of detail information in Project 2.
Applsci 14 00502 g004

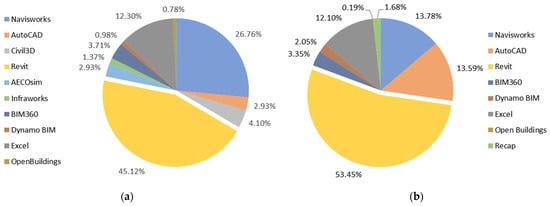

Figure 5. (a) The percentage of BIM software usage in Project 1. (b) The percentage of BIM software usage in Project 2.
Figure 5. (a) The percentage of BIM software usage in Project 1. (b) The percentage of BIM software usage in Project 2.
Applsci 14 00502 g005
Table 1. Measurement survey template.
Table 1. Measurement survey template.
Quantitative Measurement
CategoriesArea of QuestionsCode
4D Simulation of Construction Information 1Cost of Building Collaborative Environmenta
Cost of Initial Clash Checks 3b
Cost of Shop Drawing Information Workc
Cost of Coordinating and Resolving Other Issuesd
5D Simulation of Cost
Estimation 2
Labor Costse
BIM Coordination in
Construction Projects
Costs of Resolving Clashes and Preventing Delaysf
Rework Costs Incurred due to Design Changes and Errorsg
Risks Costs Arising from Design Errorsh
Costs of Rebuilding after Reworki
Costs of Preventive Measures for Reworkj
Organizational Human
Resources
Costs of BIM-Related Support Department Involvementk
BIM Investment CostsSoftware and Hardware Procurementl
Software and Hardware Upgrades and Maintenancem
Creating BIM Models from 2D DrawingsCosts of Quantity and Drawing Preparationn
Operational Costs in Case of Data Losso
BIM TrainingEmployee Skill Development and BIM Trainingp
Qualitative Measurement
CategoriesArea of Questions
BIM Implementation Overview4D Simulation for Construction Sequencing
History of Construction Projects with BIM Implementation
Support for BIM Implementation
Team and PersonnelTeam Members’ Experience
Team Composition and Role Allocation
Financial AspectsInvestment for BIM Implementation
Impact AssessmentBenefits of BIM Adoption
Effects of BIM Application
1 The 4D BIM is the process of using 3D models combined with time and schedule-related information such as programs, site surveys, and logistics models to create a virtual construction sequence. 2 The 5D BIM dimension integrates the information further with cost data by bringing detailed cost information into the project. These cost data may include schedules, prices, and quantities. 3 Clash issues refer to spatial collisions and conflicts occurring between structural components and various specialty equipment pipelines during the construction process.
Table 2. Measurement survey questions.
Table 2. Measurement survey questions.
Quantitative Element Survey Questions
CategoriesQuestions
4D Simulation of Construction InformationHow many people are involved, and what are the costs for establishing a collaborative working environment?
What are the costs associated with clash detection during the 3D model construction process?
How much time and cost are involved in meetings for adjustments in case of changes or additional issues?
What are the costs for adding information and editing work for Shop Drawings?
5D Simulation of Cost EstimationWhat are the costs associated with the extraction and modification of quantity information for each component based on the Level of Development (LOD) of the 3D model?
BIM Coordination in Construction ProjectsWhat is the cost of resolving clashes and preventing air delays on the construction site?
In the construction process, what are the costs associated with design changes and errors that result in rework?
How much do delays in time and costs occur due to the resolution of design errors?
What are the costs associated with demolition and additional work due to on-site construction issues?
Evaluation of BIM contribution for each Request for Information (RFI) using the Likert scale:
-Can be confirmed without BIM application
-Can be confirmed without BIM application but -meaningful
-Average
-Difficult to confirm without BIM application
-Difficult to confirm without BIM application and results in rework
What is the cost of original construction for each RFI?
For BIM operation, what is the labor cost for personnel deployed by the construction company for BIM management?
Organizational Human ResourcesHow many personnel are in the BIM department?
What is the ratio of BIM department personnel to the total number of personnel?
How does the labor cost in the BIM department compare to other departments?
BIM Investment CostsWhat is the unavoidable initial investment cost in the early stages of BIM implementation?
What are the maintenance costs for BIM software and hardware?
Creating BIM Models from 2D DrawingsWhat is the cost associated with the Level of Development (LOD) of drawings for each trade?
How much does it cost to quantify from the BIM model?
What is the manpower and time investment for rework due to common format conversion for data sharing?
BIM TrainingIf separate BIM personnel training is conducted, what is the training frequency and cost?
Qualitative Element Survey Questions
Area of QuestionsQuestions
4D Simulation for Construction SequencingHow do you primarily use BIM in your work?
How is data classified when requesting BIM information?
What is the purpose when requesting BIM information?
How is the requested BIM information data utilized?
What types of information are utilized in responding to BIM RFI data?
In what form is the information utilized in responding to BIM RFI data?
History of Construction Projects with BIM ImplementationHow many BIM technicians were involved in previous projects that utilized BIM?
Team Members’ ExperienceWhat is the rank and salary of BIM technicians in your company?
Team Composition and Role AllocationHow is the role distribution and ratio of team members in your team?
Support for BIM ImplementationWhat support measures exist at the government level to enhance the use of BIM?
What support measures exist at the company level to enhance the use of BIM?
Does your company have plans for workshops or support to enhance understanding and expertise in BIM?
Investment for BIM ImplementationWhat software do you use when employing BIM?
Benefits of BIM AdoptionAre there advantages obtained by using BIM compared to the methods employed before BIM implementation?
Effects of BIM ApplicationAre there areas of improvement identified by applying BIM during the construction phase compared to not using BIM?
Note: The two project sites will be surveyed using the same set of questions.
Table 3. Quantitative measurement calculation formulae.
Table 3. Quantitative measurement calculation formulae.
Area of QuestionsCalculation FormulaCode
Cost of Building Collaborative EnvironmentAverage Labor Cost per Rank × Number of Workers × Working days + Other Expenses 1a
Cost of Initial Clash Checksb
Cost of Shop Drawing Information Workc
Cost of Coordinating and Resolving Other Issuesd
Labor Costse
Costs of Resolving Clashes and Preventing Delaysf
Rework Costs Incurred due to Design Changes and Errorsg
Risks Costs Arising from Design Errorsh
Costs of Rebuilding after ReworkAverage labor cost per rank × Number of workers × Working days + Material cost + Other expensesi
Costs of Preventive Measures for ReworkAverage labor cost per rank × Number of workers × Working days + Other expenses + Service feej
Costs of BIM-Related Support Department InvolvementAverage labor cost per BIM department × Total number of employeesk
Software and Hardware ProcurementBIM software acquisition cost + BIM hardware acquisition costl
Software and Hardware Upgrades and MaintenanceBIM software maintenance cost + BIM hardware maintenance costm
Costs of Quantity and Drawing PreparationAverage labor cost per rank × Number of workers × Working days + Other expensesn
Operational Costs in Case of Data Losso
Employee Skill Development and BIM TrainingTraining cost × Number of training sessionsp
1 Other expenses: According to the state regulations should be paid in the project construction investment and included in the cost. Such as management fees, subsidies, transport costs, taxes, etc.
Table 4. Comparative measurement cost between participation in BIM consultancy and non-BIM participation.
Table 4. Comparative measurement cost between participation in BIM consultancy and non-BIM participation.
BIM Task
Categories
CodeDescriptionsNon-BIM (Unit: USD)BIM (Unit: USD)
Project 1Project 2Project 1Project 2
5D Simulation of Cost EstimationeLabor Costs61,97651,64612,39517,600
BIM Coordination in Construction ProjectsfCosts of Resolving Clashes and Preventing Delays45,96524,44530,64315,838
gRework Costs Incurred due to Design Changes and Errors37,18566,62324,79044,415
Total145,126142,71467,82877,853
Average total cost143,92072,840
Note: The measured amount, converted to US dollars based on real-time exchange rates, may incur discrepancies.
Table 5. Comparative analysis of investment cost percentage.
Table 5. Comparative analysis of investment cost percentage.
TitleDivisionCostPercentage (%)
Project 1Basic Cost145,126214.0
Investment Cost67,828
Project 2Basic Cost142,714183.3
Investment Cost77,853
Average total costBasic Cost143,920197.6
Investment Cost72,840
Table 6. Difference in worker numbers and working days between using BIM and non-BIM.
Table 6. Difference in worker numbers and working days between using BIM and non-BIM.
CodeNon-BIMBIM
Project 1Project 2Project 1Project 2
Worker NumbersWorking DaysWorker NumbersWorking DaysWorker NumbersWorking DaysWorker NumbersWorking Days
e21202100324518
f1748946
g12291461
Total31197252073210128125
Average of
total workers
28 people30 people
Average of working days202 days113 days
Note: Worker numbers are calculated per working day.
Table 7. The content of work and time spent on BIM usage.
Table 7. The content of work and time spent on BIM usage.
ProjectWork ItemCountPercentage (%)TimePercentage (%)
Project 1Additional Detailed Modeling17345.65675.546.30
Constructability Review5013.19173.511.89
Process Management4110.82127.58.74
Construction Costs Management6717.68365.525.05
On-Site Management4812.661178.02
Total379100.001459.00100.00
Project 2Additional Detailed Modeling20550.00860.252.35
Constructability Review194.6356.03.41
Process Management8320.24353.421.51
Construction Costs Management5513.41243.014.79
On-Site Management4811.71130.57.94
Total410100.001643.10100.00
Table 8. Effects of working on pilot site application BIM.
Table 8. Effects of working on pilot site application BIM.
ItemEffect
Additional Detailed ModelingAccurate quantities when reviewing quantities.
Through object separation, each object can be checked in detail.
Improve quality with detailed revisions and reviews, including interference and dimensions between each structure.
Consolidate materials that were previously in different files.
Constructability
Review
Improve information accuracy by finding and correcting errors.
Verify processes through simulation.
View details of work.
Identify risk zones in design stability reviews.
request design changes based on data.
Process ManagementThe construction process can be checked in 4D.
Check M/M by task history.
Easier to see issues and communicate with each other.
Aggregate files and simulate processes with Navisworks.
Simulation work is smooth by entering the code in the same way as the process and CSV.
Construction Costs ManagementVerification is possible when calculating quantity data.
It is possible to compare and review design quantity and BIM quantity.
On-Site ManagementShare headquarters work status.
Visual confirmation is possible through 4D construction for each process.
Smooth confirmation of monthly work performance
Increase the accuracy and granularity of BIM, making it more usable and efficient.
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Shin, M.-H.; Kim, H.-Y.; Liao, J.-F. Performance Measurement and Analysis of Building Information Modeling (BIM) Applications in the Railway Infrastructure Construction Phase. Appl. Sci. 2024, 14, 502. https://doi.org/10.3390/app14020502

AMA Style

Shin M-H, Kim H-Y, Liao J-F. Performance Measurement and Analysis of Building Information Modeling (BIM) Applications in the Railway Infrastructure Construction Phase. Applied Sciences. 2024; 14(2):502. https://doi.org/10.3390/app14020502

Chicago/Turabian Style

Shin, Min-Ho, Hwan-Yong Kim, and Jian-Feng Liao. 2024. "Performance Measurement and Analysis of Building Information Modeling (BIM) Applications in the Railway Infrastructure Construction Phase" Applied Sciences 14, no. 2: 502. https://doi.org/10.3390/app14020502

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
