Measured Spatiotemporal Development and Environmental Implications of Ground Settlement and Carbon Emissions Induced by Sequential Twin-Tunnel Shield Excavation

1
Jilin Municipal Construction Group Co., Ltd., Jilin 132011, China
2
School of Engineering, RMIT University, Melbourne, VIC 3000, Australia
3
School of Built Environment, Massey University, Turitea 0614, New Zealand
4
College of Fine Arts, Beihua University, Jilin 132013, China
*
Author to whom correspondence should be addressed.
Buildings 2026, 16(1), 25; https://doi.org/10.3390/buildings16010025 (registering DOI)
Submission received: 20 November 2025 / Revised: 14 December 2025 / Accepted: 18 December 2025 / Published: 20 December 2025

Abstract

Sequential twin-tunnel excavation has become increasingly common as urban rail networks expand, making both deformation control and construction-phase carbon management essential for sustainable underground development. This study investigates the spatiotemporal development of ground settlement induced by parallel Earth Pressure Balance shield tunnelling in a twin-tunnel section of the Hangzhou Metro, based on long-term field monitoring. The settlement process is divided into three stages—immediate construction settlement, time-dependent additional settlement, and long-term consolidation—each associated with distinct levels of energy input, grouting demand, and embodied-carbon release. Peck’s Gaussian function is used to model transverse settlement troughs, and Gaussian superposition is applied to separate the contributions of the leading and trailing tunnels. The results indicate that the trailing shield induces ahead-of-face settlement at approximately two excavation diameters and produces a deeper–narrower settlement trough due to cumulative disturbance within the overlapping interaction zone. A ratio-type indicator, the Twin-Tunnel Interaction Ratio (TIR), is proposed to quantify disturbance intensity and reveal its environmental implications. High TIR values correspond to amplified ground response, prolonged stabilization, repeated compensation grouting, and increased embodied carbon during construction. Reducing effective TIR through coordinated optimization of shield attitude, face pressure, and grouting parameters can improve both deformation control and carbon efficiency. The proposed framework links geotechnical behaviour with environmental performance and provides a practical basis for risk-controlled, energy-efficient, and low-carbon management of sequential shield tunnelling.

1. Introduction

Urban rail transit construction is accelerating and has become critical infrastructure supporting urban functioning and spatial expansion [1]. As overall travel demand and network size grow together, controlling construction-induced ground settlement in densely developed urban areas and soft ground is a prerequisite for network expansion [2]. The shield tunnelling method, characterized by full-face mechanized excavation and segmental lining, is the method of choice for underground works in urban cores and can effectively limit surface deformation [3]. Nevertheless, under complex site conditions, near existing facilities, and when multiple construction disturbances act together, cumulative settlement may still occur. Such millimeter-scale, persistent subsidence can threaten adjacent buildings [4] and has become a key constraint on metro network expansion in high-density cities. In this context, parallel twin tunnels are commonly driven sequentially within short intervals; the first and second tunnels create a near-surface superposition zone that is prone to peak amplification, asymmetric settlement troughs, and a narrowed operational tolerance [5]. Meanwhile, because the construction stage accounts for most life-cycle carbon emissions in underground works, improving excavation efficiency and reducing repeated grouting or corrective operations are also important for lowering embodied carbon. This underscores the need to integrate deformation control with construction-phase energy and material efficiency when evaluating sequential twin-tunnel behaviour.
The effects of twin-tunnel excavation on ground settlement have been widely investigated through laboratory model tests [6,7,8,9], field monitoring [10,11,12,13,14], finite-element analyses [15,16,17,18], and analytical solutions [19,20,21,22,23,24]. In lab-based studies, Chapman et al. [6] identified an overlapping disturbance zone between the two tunnels. The settlement trough induced by the second tunnel becomes deeper and narrower, and the final surface settlement profile shifts toward it. In numerical simulations, Addenbrooke et al. [15] and Do et al. [16] used finite-element analysis to evaluate the influence of sequential excavation on surface settlement, showing that the coupling associated with construction sequencing plays a critical role in producing an asymmetric settlement trough. Meanwhile, Kong et al. [23] derived an elastic analytical solution for shallow twin tunnels based on a unified displacement function, further revealing how inter-tunnel spacing and excavation sequence govern settlement superposition and trough asymmetry. Among these approaches, field monitoring plays a central role because it directly captures deformations during both construction and operation, providing reliable and comprehensive evidence of shield-induced settlement behavior. Chen et al. [10] showed that the secondary disturbance induced by the second tunnel shifts the axis of symmetry of the final settlement trough towards the trailing tunnel. Based on observations from the Bangkok Metro, Suwansawat and Einstein [21] reported that while settlement induced by a single tunnel can be well fitted with a Gaussian function, twin-tunnel settlement is typically asymmetric and can be approximated by the superposition of two Gaussian functions. Consistent with this, Gong et al. [11] reported from a Shanghai twin-tunnel case that the settlement trough deepens further and shifts toward the trailing side after the completion of both drives. Similarly, Li and Yao [12] monitored parallel twin tunnels in Changchun and quantified how centerline spacing and excavation sequence affect the influence zone and interaction characteristics. Their results confirmed that overlapping disturbances lead to asymmetric settlement troughs, providing benchmarks for Gaussian superposition and index-based analyses. Furthermore, Shi et al. [25] evaluated carbon emissions during slurry shield tunnelling using a hybrid life-cycle assessment approach, highlighting the environmental impact of sequential tunnelling and emphasizing the importance of integrating carbon management with construction control to reduce embodied carbon emissions.
Building on these case-specific and methodological studies, several recent works have further advanced the understanding of twin-tunnel interaction. Islam and Iskander [26] provided the most recent comprehensive review specifically focused on twin-tunnelling-induced ground settlements, synthesising how geometric configuration, soil conditions, and construction sequencing jointly govern interaction effects. In contrast, Huat et al. [27] offered a broader settlement-centred review covering both single and twin tunnels, emphasising multi-factor coupling—such as soil–structure–operation interactions—and the increasing integration of empirical, numerical, and data-driven approaches. On the modelling side, Li et al. [28] and Wang et al. [29] extended Peck-type formulations to double-track tunnels by introducing geometry-dependent correction factors to account for asymmetric superposition and settlement amplification, whereas Jiang et al. [30] performed detailed numerical analyses of close-buried double-line tunnels under different excavation conditions and quantified how sequencing affects the relative settlements induced by the first and second tunnels. These studies represent important progress in understanding twin-tunnelling-induced deformation.
Previous studies have identified typical deformation patterns in sequential twin-tunnel excavation, particularly the development of an interaction zone between the two tunnels and the deeper, narrower, and more asymmetric settlement trough induced by the trailing tunnel. However, existing research has largely focused on static transverse sections or isolated disturbance events, providing limited quantitative insight into the temporal coupling between the leading and trailing excavations and insufficient comparison across multiple monitoring sections. For quantifying the superposition effects of twin-tunnel construction, most current approaches rely on geometric descriptors or case-specific amplification coefficients, yet a unified, monitoring-based interaction index capable of tracking interaction strength along the alignment and over time remains lacking. In addition, no practical framework is available to translate routinely monitored settlement data into process-level indicators of construction energy use or carbon intensity.
To address these research gaps, this study utilizes long-term monitoring data from a twin-tunnel section of the Hangzhou Metro to systematically analyze the ground settlement induced by sequential excavation from both temporal and spatial perspectives. The analysis emphasizes two key aspects: the staged development of longitudinal settlement over time and the morphological characteristics of transverse settlement troughs in space. On a unified time basis, the construction-induced settlement process is quantitatively characterized and divided into three distinct phases—immediate settlement, time-dependent settlement, and long-term consolidation. By combining Gaussian superposition with near-axis analytical separation, the respective contributions of the leading and trailing tunnels are isolated and quantified, revealing how pre-disturbance from the first drive alters the stress path and amplifies the settlement response during the second. Furthermore, we establish the Twin-tunnel Interaction Ratio (TIR) with consistent acceleration-window and rebound-sensitivity definitions. TIR provides a unified interaction measure that can be tracked along the alignment and over time, enabling continuous mapping of interaction strength. We further propose empirical thresholds to classify weak, moderate, and strong interaction levels, offering a practical tool for construction control. Additionally, we introduce a process-based carbon-intensity proxy Ic that leverages field-derived settlement metrics to support energy-efficient, low-carbon tunnelling, with TIR serving as an operational proxy for input intensity.

2. Engineering Cases

2.1. Project Description

The studied section of the Hangzhou Metro extends approximately 2346 m and consists of two parallel circular shield tunnels, referred to as the left and right tunnels. The geometric arrangement of the twin tunnels is illustrated in Figure 1, where the center-to-center spacing is 15.0 m, with a clear spacing of 9.0 m between the outer linings.

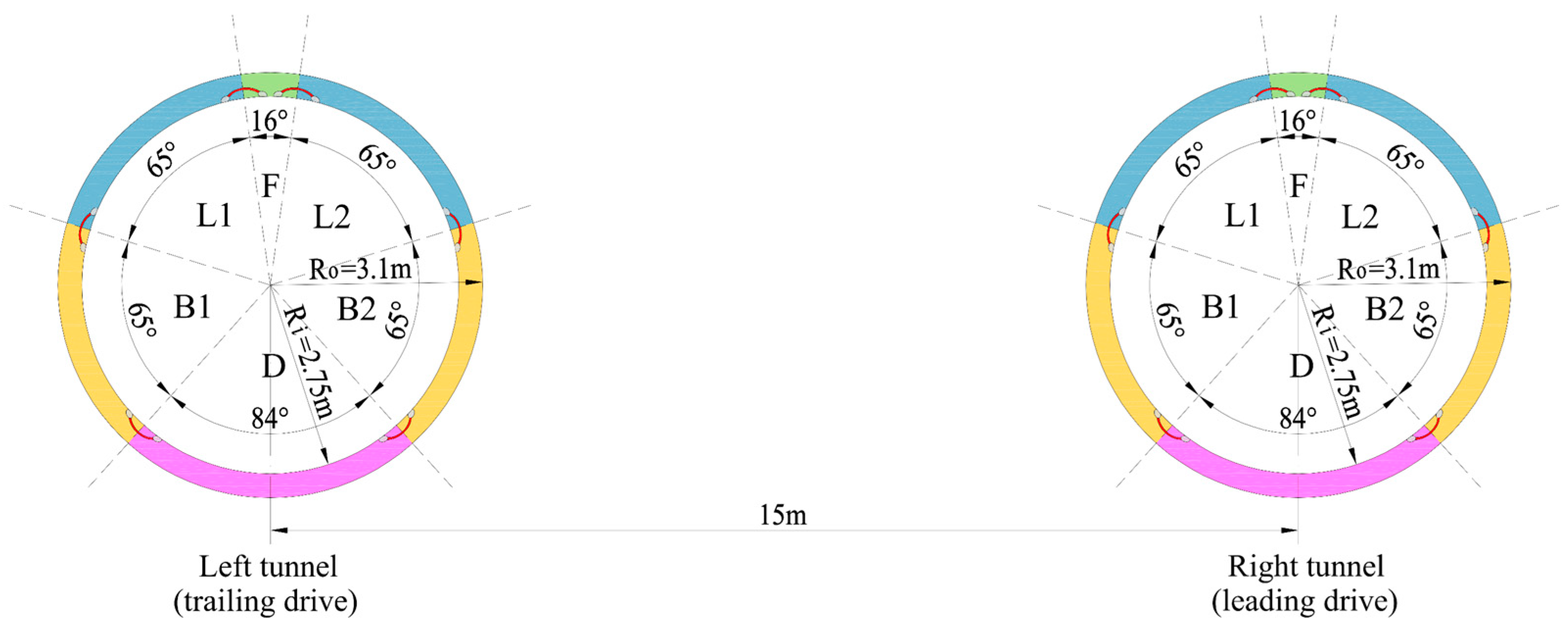

Two Earth Pressure Balance (EPB) shield machines with a cutting diameter of 6.43 m were employed for excavation. The right-tunnel drive was excavated first, with the left-tunnel following approximately 50 days later. The finished tunnels have an outer diameter of 6.2 m and inner diameter of 5.5 m. The lining consists of precast reinforced concrete segments, with each ring 1.2 m wide and 0.35 m thick. Each ring consists of three standard segments, two adjacent segments, and one key segment, assembled in a staggered pattern and connected with high-strength bolts. Waterproofing was achieved through rubber gaskets and hydrophilic swelling strips at the segment joints.
Because the shield machine’s outer diameter exceeds that of the lining, a tail void inevitably forms behind the shield, and its closure is a major source of construction-induced ground loss and immediate settlement, often amplified by early grout shrinkage. A synchronous grouting system was therefore used to promptly fill the void with cement-based grout, reducing ground deformation and limiting the embodied carbon associated with excessive or repeated grouting.

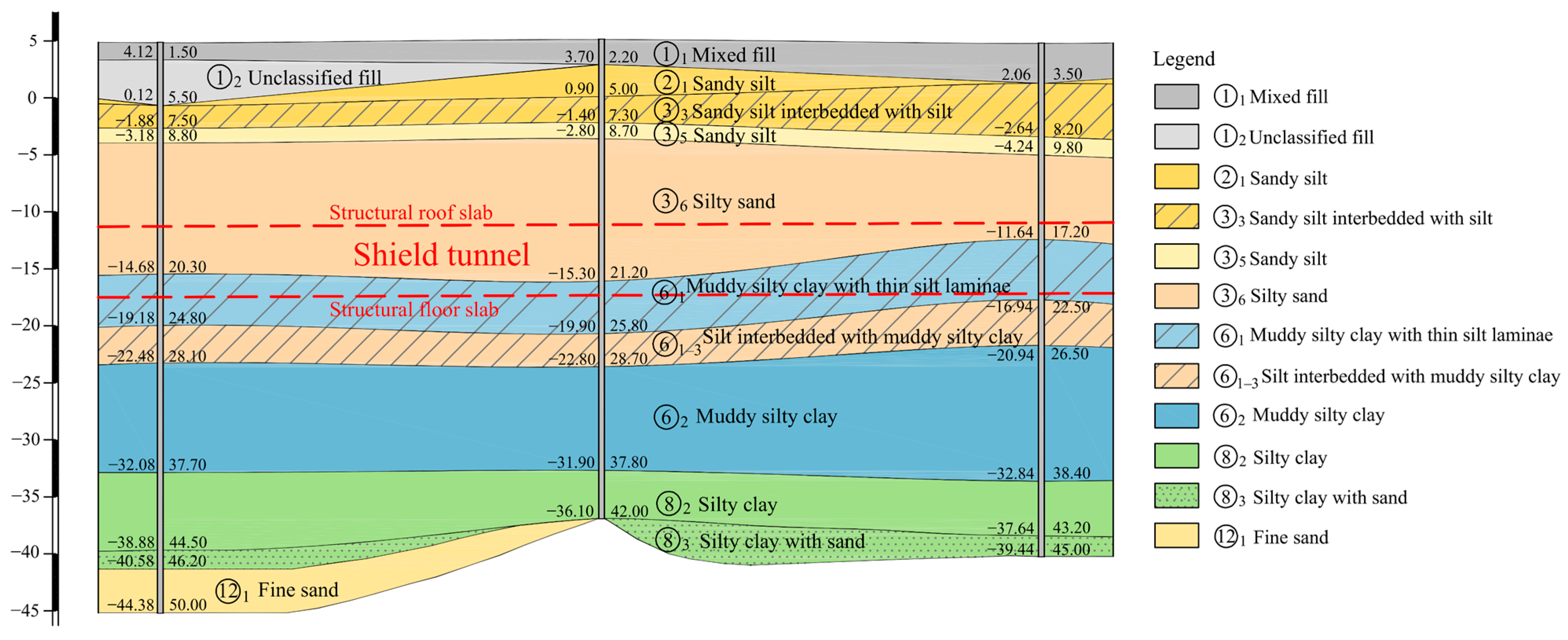

2.2. Geological Background

The project area is characterized by an estuarine–marine alluvial plain. A representative geological profile is shown in Figure 2, and the physical and mechanical properties of each soil layer are summarized in Table 1.
The tunnel centerlines lie at depths of approximately 17.5–18.1 m below the ground surface, traversing strata that transition between the ③6 silty sand layer and the ⑥1 muddy silty clay interbedded with thin silt laminations.
The upper ③6 silty sand layer is in a slightly dense to medium-dense state, exhibiting relatively high permeability and sensitivity to groundwater fluctuations. The underlying ⑥1 muddy silty clay interbedded with thin silt layers is of soft to plastic consistency, with low permeability. Compared with the overlying silty sand, this lower layer is softer and more thixotropic, and creep settlement tends to occur following shield passage, requiring long-term monitoring.

3. Monitoring Methods

Field monitoring is the most direct approach to quantify the ground response to shield tunnelling. Accordingly, to capture the evolution of ground-surface settlement during sequential twin-tunnel excavation, settlement monitoring points were installed at ground level. Longitudinal settlement points were arranged along each tunnel centerline, and transverse arrays were laid out perpendicular to the centerlines. This study focuses on the interval from K2 + 378 to K2 + 522, and the monitoring layout is shown in Figure 3.

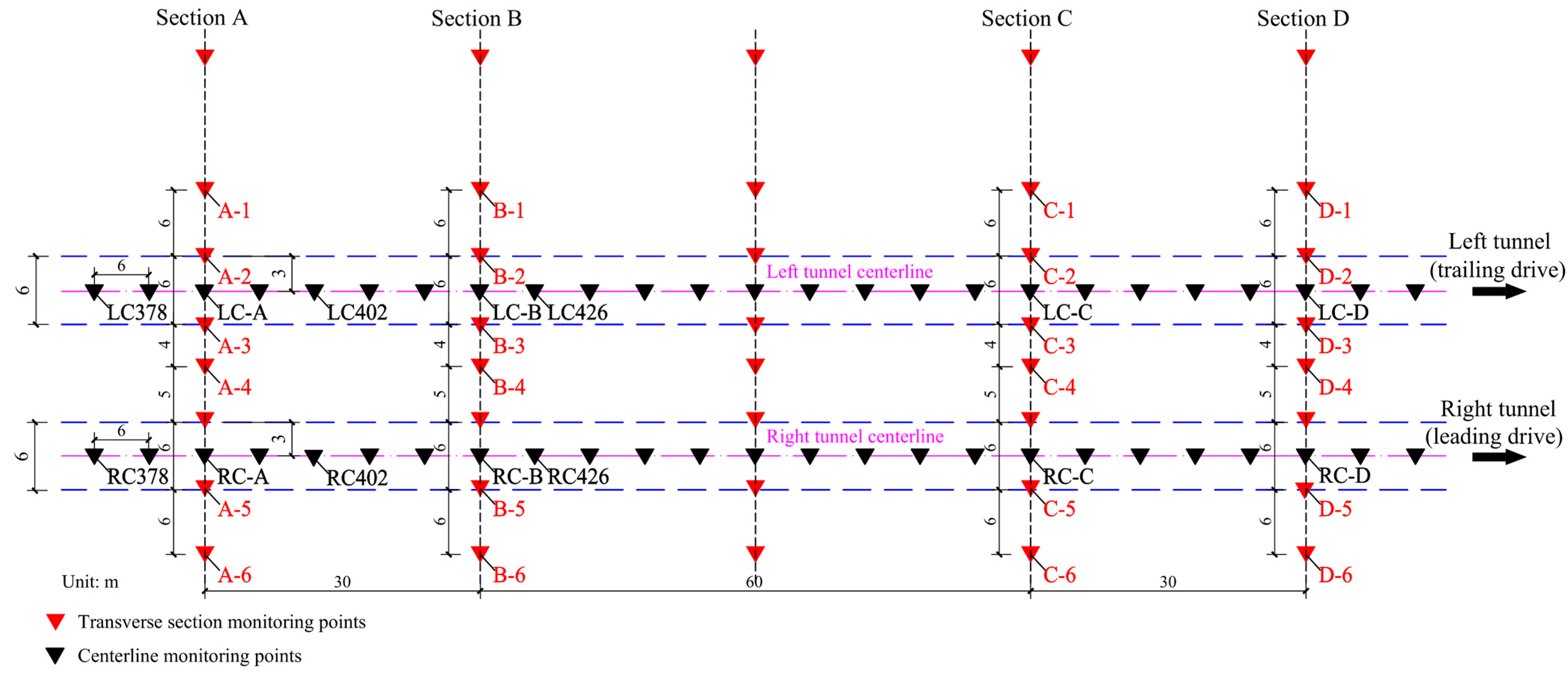

The spacing between adjacent transverse sections is 30 m. Preliminary analysis indicated that the section at K2 + 450 exhibited no pronounced settlement features. Stable construction control reduced the peak settlement rate and broadened the response window within the observation period, resulting in a less distinct inflection point in the curves. Therefore, four transverse sections—K2 + 390, K2 + 420, K2 + 480, and K2 + 510—were selected for detailed analysis and are hereafter referred to as Sections A, B, C, and D, respectively. Within each transverse section, the spacing between adjacent monitoring points is 4–12 m. To present the deformation characteristics clearly, eight representative points were analyzed in each section. Along the tunnel centerlines, longitudinal settlement points were installed at 6 m intervals. For analysis, three representative points were selected on each centerline (left and right) at K2 + 378, K2 + 402, and K2 + 426. Monitoring commenced 1–3 days before the shield face approached each transverse section, at a frequency of twice daily, and continued until approximately 20 days after the trailing (left) shield had passed.

4. Field Measurements and Analysis

4.1. Development of Ground Settlement over Time

Figure 4, Figure 5, Figure 6 and Figure 7 present the time-history curves of surface settlement at monitoring points in Sections A–D. Because the sections exhibit broadly similar patterns, Section A is discussed in detail as representative, with particular attention to how the time-dependent settlement process corresponds to variations in shield energy consumption and construction-phase efficiency.
The time-dependent development of surface settlement at each monitoring point in Section A is shown in Figure 4, capturing the characteristic response of soft clay under sequential twin-shield excavation. After the right shield advanced first, settlement at the tunnel centerline (RC-A) and adjacent points (A-4, A-5) increased rapidly; in contrast, points farther from the right tunnel centerline (A-1, A-2, LC-A, A-3) exhibited smaller magnitudes, with a few showing slight early heave (A-6). This contrast reflects the spatially non-uniform disturbance induced by the leading excavation and the formation of a pre-disturbed zone that governs the response to the trailing excavation.
For quantitative analysis of the spatial attenuation and post-construction development following the construction-induced immediate settlement, the moment when the right shield tail passed the section was defined as t = 0. Settlement readings at t = 10 d and t = 40 d were selected to calculate the incremental settlement Δt10d–40d, representing the consolidation-controlled settlement stage unaffected by the subsequent excavation of the left tunnel. Taking the right tunnel axis (yR) as the transverse reference coordinate, the zone within approximately one settlement-trough width on each side of the axis (W is typically ≈ 6–8 m) was defined as the primary disturbance zone. Within this zone, the mean incremental settlement was −14.37 mm, about 1.9 times the mean −7.44 mm outside the zone, indicating pronounced transverse attenuation of disturbance. Even after t > 10 d, settlement continued to develop slowly under consolidation and time-dependent effects. From an energy-efficiency perspective, the larger deformation magnitude near the tunnel axis implies higher shield energy input and material intensity, marking these zones as mechanically and environmentally critical.
Under soft-clay–EPB conditions, the settlement–time curve shows two segments: rapid early development followed by slow progression. Based on extensive field measurements from the Taipei Metro, Hwang and Moh [31] employed logarithmic and hyperbolic models to extrapolate long-term settlement trends, dividing the process into an immediate settlement phase and a subsequent consolidation phase. Deng et al. [32] reported, for a Suzhou Metro case, that most monitoring points stabilized at t ≈ 10 d after tail passage and then entered a consolidation-dominated stage. Hence, this study adopts 8–10 days after shield passage as the empirical boundary between these phases, verified by the first inflection of the settlement-rate curve. From an energy and environmental perspective, this temporal evolution mirrors the changing intensity of shield operation and its carbon output. During the rapid-settlement phase, high thrust, torque, and grouting frequency drive deformation rates and electricity consumption, representing the most carbon-intensive portion of tunnelling. As the excavation face moves away and the system enters the consolidation-controlled stage, mechanical activity subsides and energy demand declines, marking a transition to a low-emission regime.
In terms of spatial configuration, the transverse settlement trough at t = 10 d aligns well with the analytical profile proposed by Loganathan and Poulos [33], indicating that settlement during this stage is primarily governed by tail-void closure, early-age shrinkage of the tail grouting, and local stress redistribution. These processes represent energy dissipation within the soil–structure interface. The extent and rate of consolidation therefore describe both deformation recovery and the progressive reduction in embodied energy as soil equilibrium is restored. Subsequently, surface settlement near the right tunnel axis continued to evolve slowly; by t = 40 d, additional settlement was still recorded, suggesting ongoing soil consolidation and creep deformation consistent with the time-dependent behavior of soft clays described by Vardanega and Bolton [34]. In contrast, monitoring points farther from the axis showed nearly stable behavior, further demonstrating that the influence of shield tunnelling disturbance decays significantly with distance. Meanwhile, the slow continuation of settlement implies a prolonged phase of residual energy dissipation within the ground and a gradual return toward energy-efficient equilibrium. This gradual decay in deformation rate corresponds to a sustained decline in construction-phase energy intensity.

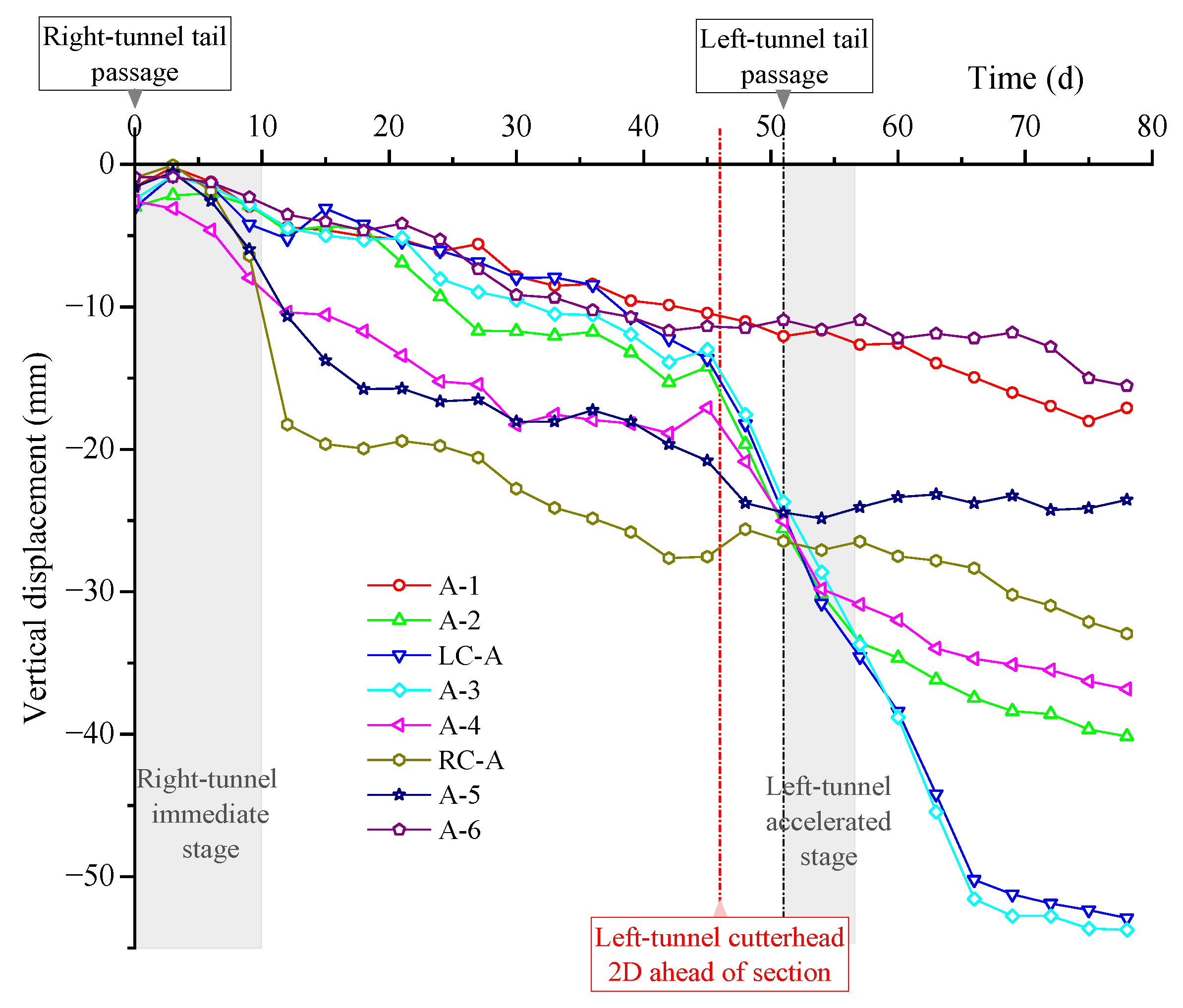

The left shield cutterhead reached the monitoring section approximately 48 days after the right shield had passed. As shown in Figure 4, when the cutterhead of the left shield was still about two excavation diameters from the section (approximately 12–15 m), settlements near the left tunnel centerline had already begun to develop noticeably. Within 2–3 days before arrival, additional settlements of about 6.3 mm, 5.9 mm, and 6.1 mm were recorded at LC-A, A-2, and A-3. Mair [35] described the three-dimensional ground response induced by shield excavation, noting that ground movements can occur in advance of the cutter face within several excavation diameters O(D); detectable settlements typically appear within about 1–2D (where D is the excavation diameter). This so-called ahead-of-face settlement is influenced by soil permeability, face support pressure, grouting control, and volume loss. Likewise, the analytical solution of Loganathan and Poulos [33] for surface settlement above circular tunnels in clay provides a theoretical basis for the observed spatial differentiation—most pronounced near the tunnel centerline and gradually diminishing with increasing transverse distance. The observed onset at approximately 2D in this section is consistent with this range. The slightly earlier response at some points is attributed to pre-disturbance and structural weakening caused by the prior right-tunnel excavation, which reduced soil stiffness and increased sensitivity to subsequent loading. From a sustainability viewpoint, such premature deformation indicates localized zones of mechanical over-activation, where repeated pressurization and compensation grouting raise energy demand and carbon intensity without proportional gains in stability. Targeted control of these early-response zones can therefore improve both deformation control and energy efficiency.
Following the left-shield tail passage, the settlement rate at points near the left tunnel centerline increased markedly. Over the accelerated stage t = 51–57 d, the additional settlements were approximately 9.5 mm and 10.0 mm at LC-A and A-3, respectively, while A-2 and A-4 exhibited increases of about 8.0 mm and 5.9 mm over the same period. LC-A, located directly above the left tunnel axis, is primarily governed by the disturbance induced by the left-line excavation, whereas A-3 lies in the core region between the two tunnels where the superimposed effects of sequential tunnelling are strongest. Consequently, both points show the largest settlement acceleration and cumulative deformation. As the shield moved away, rates at all points—except those close to the centerline—fell rapidly, then shifted to a slow, consolidation-dominated stage. This indicates that the primary disturbance zone is concentrated within roughly one settlement-trough width on either side of the centerline, consistent with the spatial distribution of the measurements. This significant and persistent additional settlement observed at LC-A and A-3 is consistent with the overlapping disturbance zone described by Chapman et al. [6] and Chen et al. [10], in which successive excavations subject the soil to two rounds of stress redistribution and a complex three-dimensional stress path, producing persistent, hard-to-stabilize deformation. Such zones can be regarded as construction-phase “carbon hotspots”, requiring repeated grouting and extended shield operation, and thus disproportionate energy and material input. Recognizing and controlling these zones is therefore critical for both risk mitigation and emission reduction.

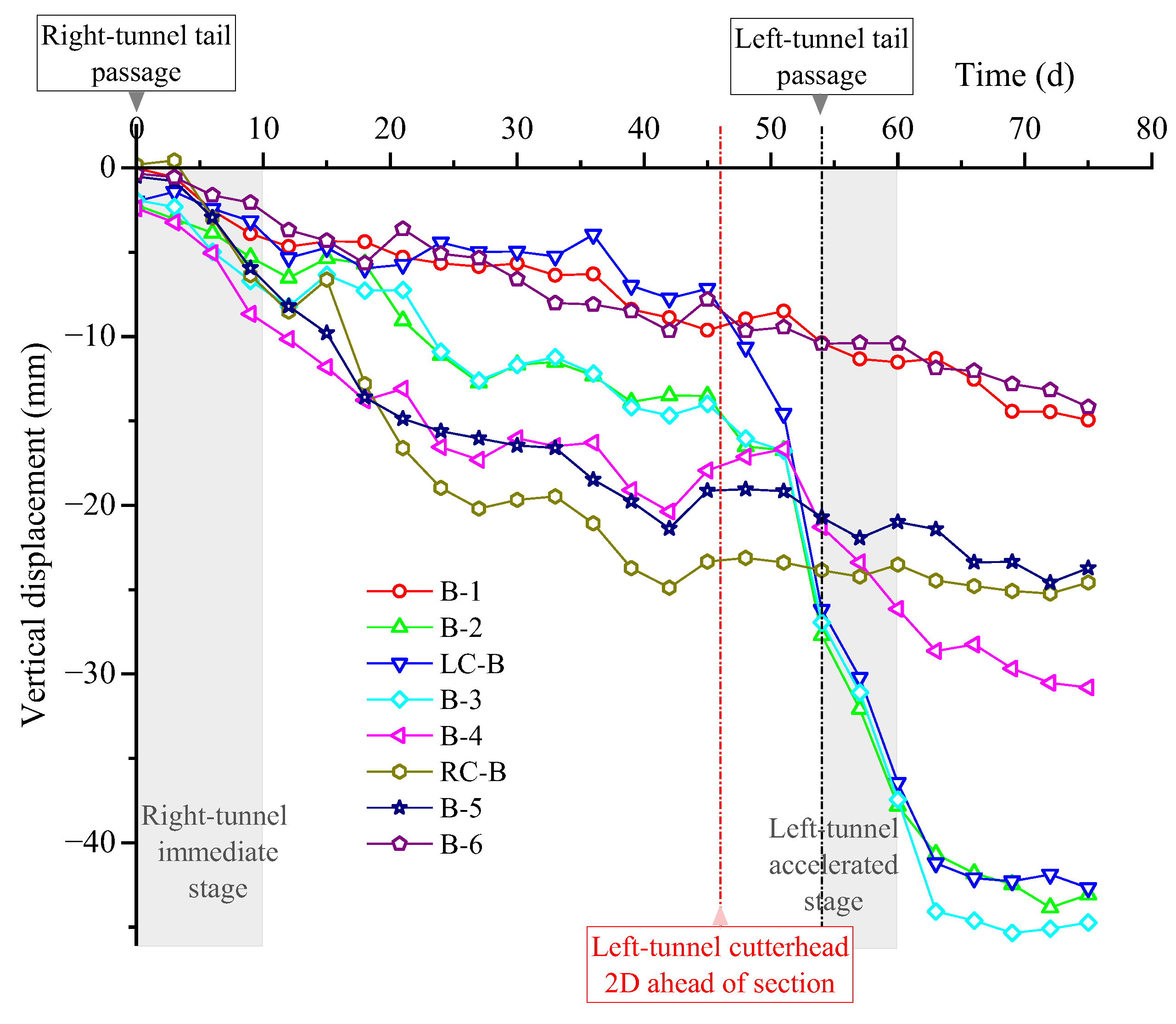

The time-dependent settlement behaviour at the Section B monitoring points is broadly consistent with Section A, as shown in Figure 5. After the right shield passed, a short-term construction-induced disturbance produced 4–8 mm of settlement within eight days—slightly smaller than in Section A—and then quickly stabilized as the tail moved away. This indicates effective control through advance-parameter optimization, attitude adjustments, and timely synchronous grouting, which also minimized redundant energy input and material consumption at this stage. During the arrival and passage of the left shield, a secondary disturbance with localized accelerated settlement developed. In particular, points near the left tunnel centerline (LC-B, B-2, B-3) exhibited a distinct accelerated stage, with additional cumulative settlement of approximately 24–30 mm, confirming that the principal risk remains concentrated within the interaction zone near the left tunnel. As the excavation face moved away, settlement rates at all points declined quickly and tended toward stabilization; at a few points, a slight rebound/reconsolidation of <1 mm was observed.

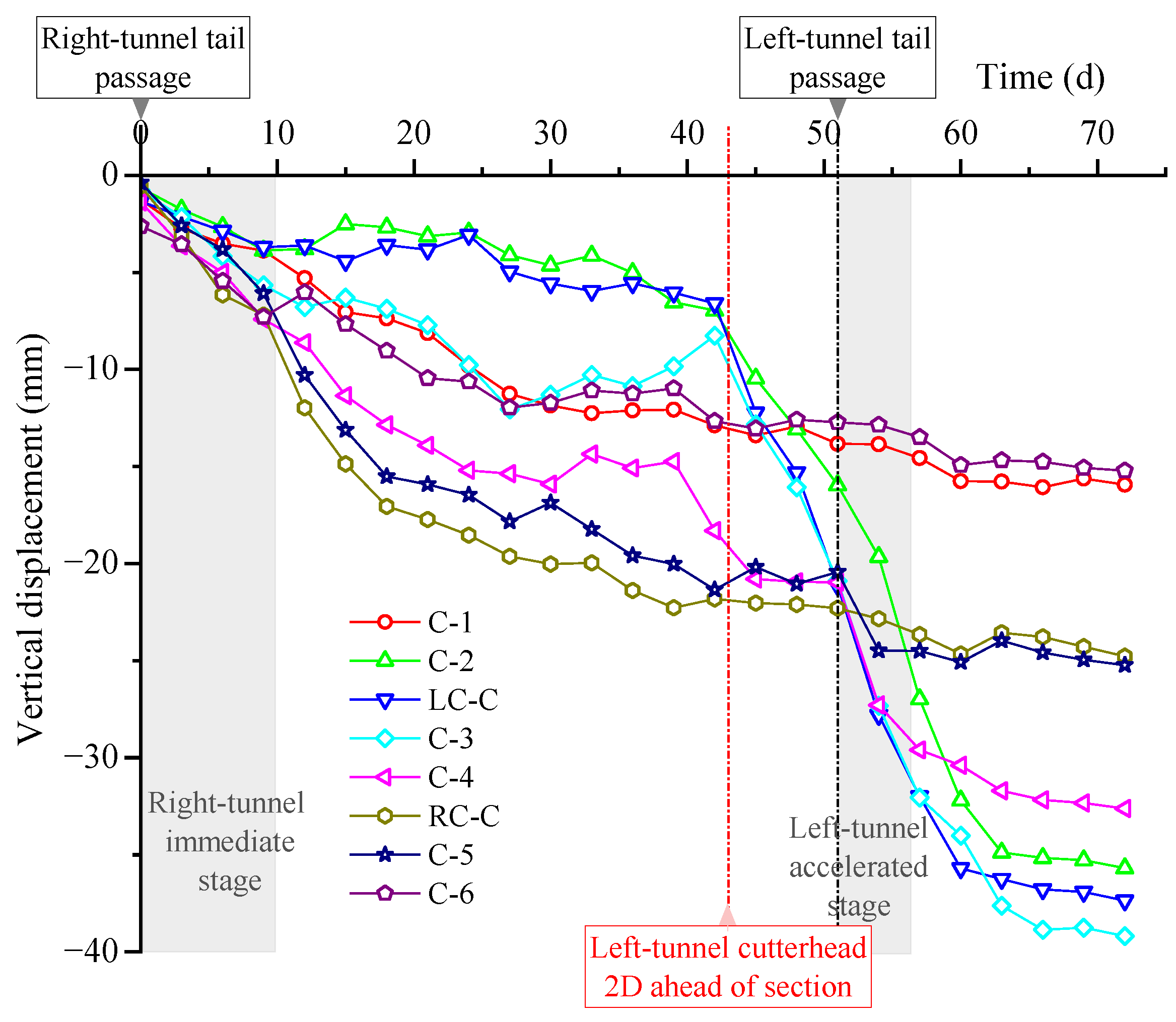

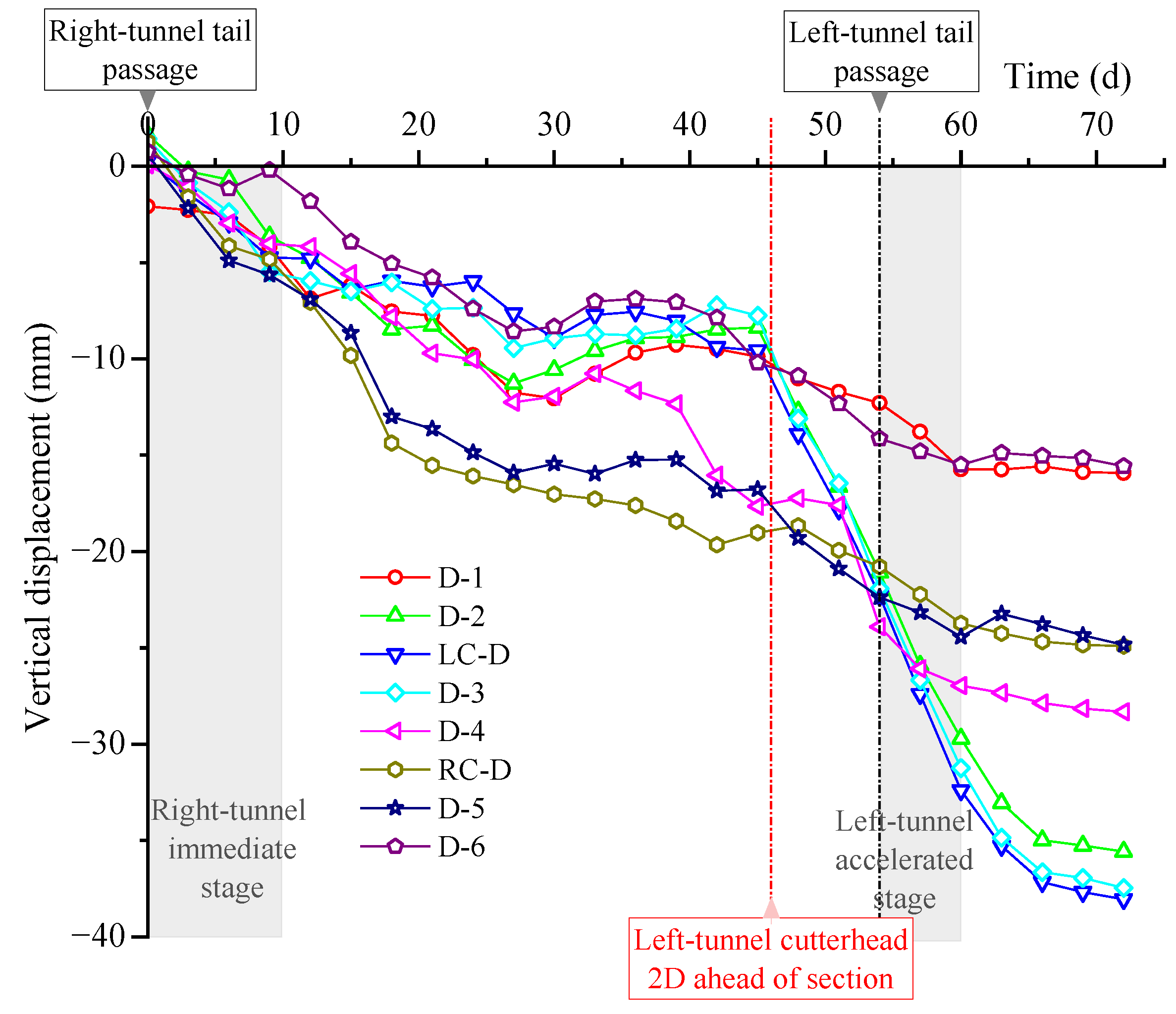

The evolution patterns of the monitoring points in Sections C and D (Figure 6 and Figure 7) are broadly similar during the sequential excavation of twin shields. After the right shield passed first, an immediate settlement phase developed at the centerline and on both sides within 8 days, with maximum values of 6.8 mm at RC-C and 7.9 mm at D-5. Thereafter, the response transitioned into a time-dependent additional settlement stage. Driven by tail-grout bleeding, hydration shrinkage, progressive tail-void closure, and excess pore-pressure dissipation in soft clay, points near the centerline maintained relatively high daily settlements during 8–20 days, and only after about 20 days did the curves gradually enter secondary consolidation. Jin et al. [36] systematically validated this displacement staging of “immediate settlement–time-dependent settlement” through field monitoring and three-dimensional numerical comparisons. During this period, the energy demand of propulsion and pumping systems gradually decreased, mirroring the mechanical consolidation of the ground. In Section C, a short-term rebound of about 1–3 mm was observed at LC-C and C-2 during days 20–35 prior to the arrival of the left shield, indicating that the stabilizing effects of face-pressure adjustments and secondary grouting were slightly weaker than in Section D. Prior to the arrival of the left shield, the maximum cumulative settlements reached 17.6 mm (RC-C) and 20.3 mm (RC-D), representing increases of more than 150% relative to the values at day 8. Compared with Sections A and B, Sections C and D exhibited faster settlement development during this stage, with greater difficulty in stabilization and noticeably delayed convergence. When the left shield passed, additional settlement continued to accumulate on both sides of the left tunnel centerline and within the interaction zone. As the excavation face moved away, the slopes of the settlement–time curves dropped rapidly and tended toward a plateau. The final maximum settlements were 39.2 mm at C-3 and 38.1 mm at LC-D, approaching but within code limits, and thus remaining under control. Synchronized control of face pressure, shield attitude, and grouting efficiency is thus essential to ensure both stability and construction-phase energy efficiency.

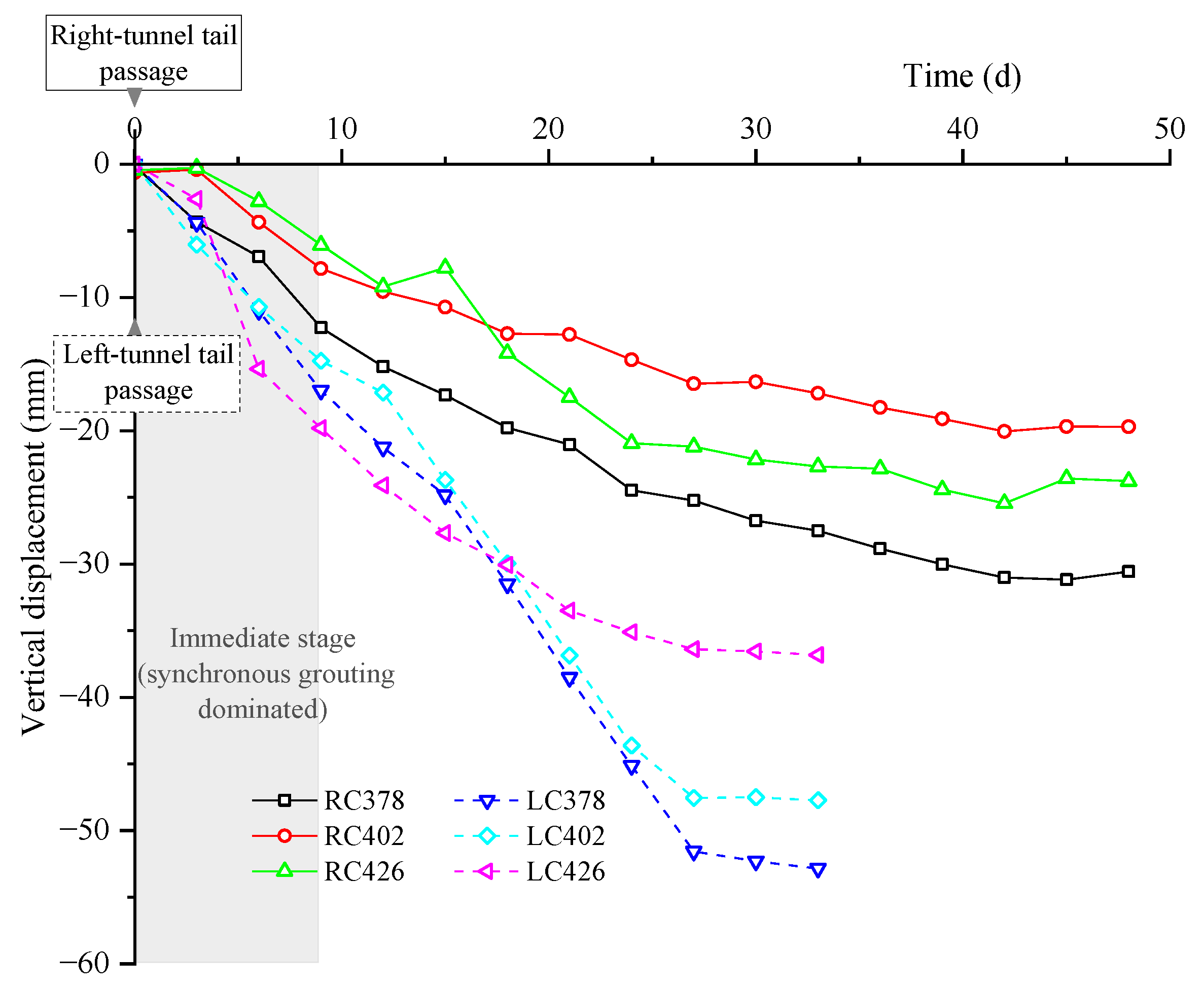

Figure 8 presents the time histories of surface settlement at the centerline monitoring points of the left and right tunnels at K2 + 378, K2 + 402, and K2 + 426. Along the right tunnel centerline, early settlement is characterized by an immediate settlement phase over the first 8–10 days, followed by time-dependent settlement at some points. Along the left tunnel centerline, the leading (right) drive induced only minor pre-settlement; settlement then accelerated markedly as the trailing (left) shield approached, with the principal increment occurring during the left-shield passage. From the observed settlement development, surface monitoring points began to register the influence of the trailing shield approximately 2 days before its arrival, corresponding to an ahead-of-face distance of about 2–3D. To separate the effects of the two disturbances, the settlement value at t = −2 d (relative to the left-shield passage) was set as the datum (zero), and subsequent centerline settlement was attributed primarily to the trailing shield.
Based on the monitoring results, settlements along the left tunnel centerline are generally greater than those along the right tunnel centerline, and after the shields passed the monitoring sections, the settlement rate at points along the left tunnel centerline remained noticeably higher than that at points along the right tunnel centerline. Taking the K2 + 402 section as an example, within 8 days after the passage of each shield, the settlement values at RC402 and LC402 reached 7.4 mm and 12.7 mm, respectively, with the latter being about 1.7 times greater. This indicates that LC402 was affected by two successive tunnelling disturbances, during which the soil structure was weakened and its density reduced, leading to larger surface settlement under the influence of the trailing shield. This agrees with Islam and Iskander [26], who observed that settlement above the trailing tunnel tends to increase significantly in twin-tunnel construction. Mechanically, this intensified phase coincided with peak operational energy and higher short-term carbon intensity. As the face advanced beyond the section, both settlement rate and energy demand declined, indicating recovery of mechanical and energy equilibrium. From a long-term perspective, compared with RC402, the settlement at LC402 tended to stabilize more rapidly after the excavation face moved away, consistent with the two-stage “short-term rapid—long-term slow” response under soft-soil conditions reported by Jin et al. [36] based on field and numerical evidence. The underlying mechanism can be attributed to the fact that during the excavation of the right tunnel, a disturbance zone and grout body had already formed near the tunnel axis. The second (left) drive advanced through a “disturbed and partially consolidated” stratum, resulting in a larger equivalent volume loss and greater peak settlement. Meanwhile, the shortened drainage path and faster closure of the tail void led to a quicker transition to the stabilization stage. In addition, the duration of time-dependent settlement is closely related to the soil characteristics: in zones dominated by silty sand, dissipation of pore water pressure occurs more rapidly and settlement convergence is achieved sooner; whereas in zones dominated by soft clay, slower pore-pressure dissipation causes prolonged consolidation and delayed convergence. Other monitoring points along the tunnel centerline exhibit similar patterns, further confirming that tunnelling of the trailing shield through already disturbed ground tends to induce greater surface settlement and transiently higher energy use.

4.2. Transverse Ground Settlement Analysis

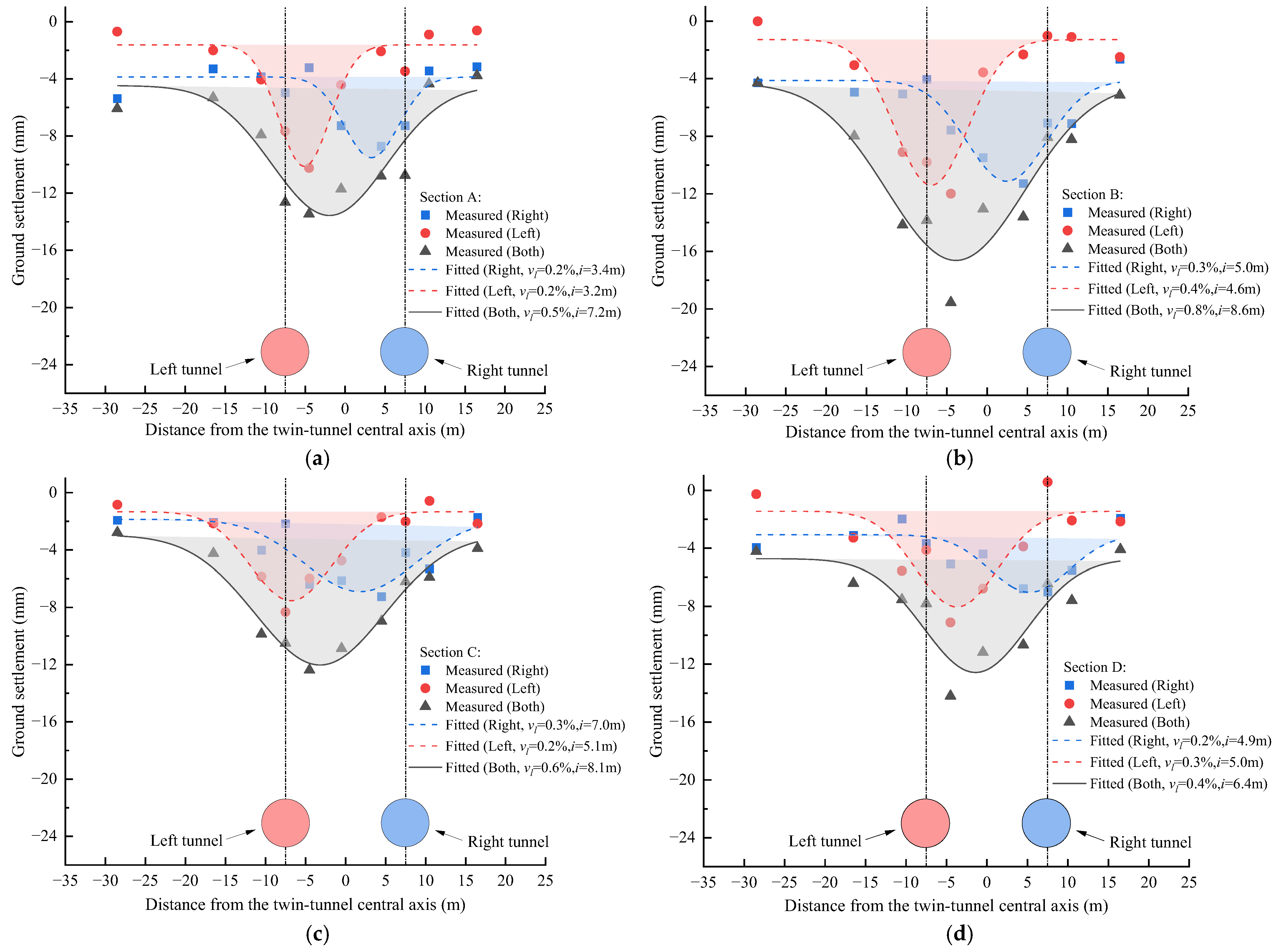

Figure 9 shows the transverse surface settlement curves at each monitoring section before and after the passage of the twin shields. Drawing on previous field observations [31,32] and the time-history analysis above, 8–10 days after shield passage is adopted as an empirical boundary at which construction-induced immediate settlement is essentially complete. Accordingly, the ground-monitoring data 10 days after the right-tunnel and left-tunnel passages, respectively, are taken to represent the post-passage transverse settlement state. This temporal boundary also marks the transition from a high-intensity tunnelling stage to a consolidation-dominated, lower-energy regime, aligning mechanical staging with construction-phase energy efficiency.
To obtain the settlement distribution induced solely by the disturbance from the trailing (left) drive, the net settlement increment at any transverse position x along the section is defined as
S r e f x = S r e f x , t + 10 d S r e f x , t 2 d
where t+10d is the 10th day after the cutterhead of the left shield passed the section; t−2d is two days before its arrival; and Sref is the cumulative settlement referenced to the time of the left-shield passage.
This differencing largely removes the pre-existing contribution of the leading (right) drive prior to the arrival of the left shield, leaving the incremental effect of the trailing drive. Consolidation-related, time-dependent settlement caused by the right shield will continue after the left-shield passage and cannot be completely removed. However, time-history analysis shows that this contribution decays rapidly; by approximately the 10th day after the left-shield passage, the observed increment is predominantly governed by the trailing drive. Based on this, we preprocess the records using Equation (1), construct the transverse settlement troughs ΔSref(x) for each section, and fit them with the Gaussian function recommended by Peck [37]. In energy terms, Equation (1) isolates the disturbance window in which operational energy input and grouting effort are primarily attributable to the trailing shield, providing a cleaner mapping between deformation increment and construction-phase energy demand.
Peck [37] showed that tunnel-induced surface settlement can be represented by a Gaussian curve:
S = S m a x e x p ( y 2 2 i 2 ) ,   S m a x = π R 2 v l 2 π i
Equation (2) can be rewritten as
S = 2 π D 2 v l 8 i   e x p ( y 2 2 i 2 )
where S is the surface settlement (mm); Smax is the maximum settlement at the tunnel centerline (mm); y is the transverse offset from the axis (m); i is the distance from the centerline to the point of inflection of the settlement trough (m); R is the tunnel excavation radius (m); D is the shield excavation diameter (m); and vl is the volume-loss ratio.
From Figure 9, both the individual-tunnel curves and the superposed (twin-tunnel) curve are satisfactorily fitted by Peck’s Gaussian function. The model uses few physically interpretable parameters and captures the principal shape of the settlement troughs. Nevertheless, because it was developed for single tunnels, it has limitations for twin-tunnel superposition and local heterogeneity. Accordingly, we analyze the trough parameters for the right and left tunnels separately, and then for the superposed (twin-tunnel) response. In view of this framework, Smax and i serve as compact spatial indicators for targeting zones prone to concentrated effort and for supporting parameter optimization.
From the fitted curves, a consistent pattern emerges across all sections except Section D: the settlement trough induced by the trailing (left) drive is characterized by a smaller trough width i than that of the leading (right) drive, while the maximum settlement Smax is larger. This “deeper–narrower” trough form agrees with the observations of Chen et al. [10] for Hangzhou Metro Line 2. Mechanistically, stress unloading and structural degradation caused by the leading shield do not fully recover in the short term; when the trailing shield advances within the same influence zone, the soft ground exhibits heightened disturbance sensitivity, producing faster settlement growth and more localized deformation, hence a smaller i relative to the leading stage. A larger Smax combined with a smaller i implies higher instantaneous energy input and grouting intensity per unit width—an indicator of potential “carbon hotspots”. At Section D, by contrast, the trailing (left) drive yields a slightly wider trough than the leading (right) drive, yet still with a markedly larger Smax. This is mainly attributed to higher backfill–reconsolidation stiffness in the inter-tunnel ground, resulting from tail-void grouting and the initial disturbance from the leading right tunnel. During the left-tunnel drive, grout can preferentially spread along pre-existing loosened paths and sandy interbeds, enlarging the outward diffusion radius and widening the effective influence zone, while the superposition of disturbances elevates the surface peak. From an engineering perspective, tracking i(t) and Smax(t) in real time can flag periods of excessive energy/material consumption and guide co-optimization of chamber pressure and primary/secondary grouting.
Inspection of the twin-tunnel superposed curves shows that the superposition-fitted settlement trough is, in general, not symmetric about the mid-point between the two tunnels; the extremum shifts toward the trailing (left) side, with the shift more pronounced at Sections B and C. This is consistent with the field-based analysis of Sun et al. [38]. Before the cutterhead of the trailing shield actually crosses the section, it already generates an ahead-of-face disturbance that amplifies both the magnitude and the duration of deformation within the interaction zone, thereby displacing the maximum toward the trailing side and enhancing asymmetry. Mechanistically, the leading (right) drive creates an unloading/structural-weakening zone between the tunnels, while tail-void grout dewatering/shrinkage and consolidation dissipation are not fully recovered. When the trailing (left) drive advances within this domain, the effective volume loss increases and the peak settlement rises; the Gaussian superposition of the two troughs then causes the composite trough extremum to migrate to one side. Meanwhile, loosened pathways formed during the leading stage enlarge the lateral influence radius of the trailing drive, thickening the left-side “tail” and further breaking symmetry. Lu et al. [9] also showed via centrifuge modeling that when the monitoring section is oblique to the tunnelling direction, the transverse settlement trough tends to become more asymmetric. For Sections A–C, the fitted volume-loss ratios for the superposed troughs, vl (0.50%/0.82%/0.57%), are slightly higher than the sum of the left- and right-tunnel values (0.36%/0.62%/0.52%), indicating a cooperative amplification. By contrast, at Section D the superposed vl (0.39%) is slightly lower than the left + right sum (0.41%), consistent with adequate compensation (face-pressure/grouting), a broader–shallower trough, and stronger rebound at the outer margins–together yielding a partial offset of superposition effects. Thus, sections with vl (superposed) > vl (left) + vl (right) are likely to experience excess energy/material usage, whereas vl deficit (as at Section D) signals better compensation control and improved construction-phase energy efficiency. When monitoring reveals trailing-side dominance and a clear shift in the composite trough, enhanced attention is required in the inter-tunnel ground and near the trailing axis, and shield attitude, face pressure, and primary/secondary grouting should be jointly optimized.

4.3. Superimposed Disturbance Effects

To quantitatively characterize the superposition of disturbances induced by sequential twin-tunnel construction, we propose a ratio-type index, defined herein as the Twin-Tunnel Interaction Ratio (TIR):
T I R = S L S R
where ΔSL is the incremental settlement (mm) within the construction acceleration window recorded when the left-line excavation face passes the monitoring section; ΔSR is the incremental settlement (mm) within the same, consistently defined acceleration window recorded when the right-line excavation face passes the same section; and TIR is a dimensionless ratio that represents the degree of settlement amplification of the trailing line relative to the leading line.
Building upon previous comparative or ratio-based approaches used to interpret twin-tunnel behaviour [29,30], we establish the TIR framework by employing field-measured incremental settlements within a unified acceleration window. This enables a consistent quantification of superposition intensity along both time and alignment and provides a more comparable, monitoring-based evaluation of interaction effects. Operationally, higher TIR values reflect more intense sequential disturbance and typically coincide with concentrated thrust, pressurization, and grouting effort during the acceleration window.
In addition, to account for the influence of short-term rebound during monitoring on the acceleration-window increment, a rebound-sensitivity evaluation is introduced, based on which two definitions of settlement increment are established:
S n e t = k m a x ( η k η k 1 , 0 ) , t [ t 1 , t 2 ]
S e n v = max t [ t 1 , t 2 ] η ( t ) min t [ t 1 , t 2 ] η ( t )
where ΔSnet is the net settlement increment (mm) excluding rebound; ΔSenv is the total envelope settlement increment (mm) including rebound; ηk is the settlement value (mm) recorded at the k-th observation; and [t1, t2] denotes the time window (d) corresponding to the instantaneous construction-acceleration stage.
To minimize subjectivity and ensure comparability across monitoring sections, the acceleration window ω was defined using a fully objective two-parameter criterion. The settlement-rate threshold was set to λ = 0.30 mm/d, corresponding to the 95th-percentile upper bound of consolidation-stage rates and thus distinguishing genuine construction-induced acceleration from post-passage consolidation. To exclude transient fluctuations, the elevated-rate period was required to persist for at least τ = 1.0 day. The acceleration window ω was then taken as the longest continuous segment of the settlement–time curve satisfying both conditions. For all sections, the resulting ω ranged from 2.5 to 3.5 days, consistent with construction records of high-thrust advancement and synchronous grouting. This unified and reproducible definition provides the technical basis for computing ΔSnet and ΔSenv in Equations (5) and (6).
Accordingly, two sets of ratio indices are defined:
T I R n e t = S L , n e t S R , n e t ,   T I R e n v = S L , e n v S R , e n v
To further incorporate rebound sensitivity into the evaluation framework, the rebound ratio (ρ) is defined as
ρ = S e n v S n e t S e n v
Because no classification criteria for twin-tunnel interaction have been established in existing studies, empirical thresholds are adopted based on the statistical characteristics of the measured TIR values to meet practical engineering needs. These thresholds are used to classify the TIR into three levels:
  • If max (TIRnet, TIRenv) < 0.75, the condition is classified as a weak overlapping effect;
  • If 0.75 ≤ max (TIRnet, TIRenv) < 1.5, it is classified as a moderate overlapping effect;
  • If max (TIRnet, TIRenv) ≥ 1.5, it is classified as a strong overlapping effect.

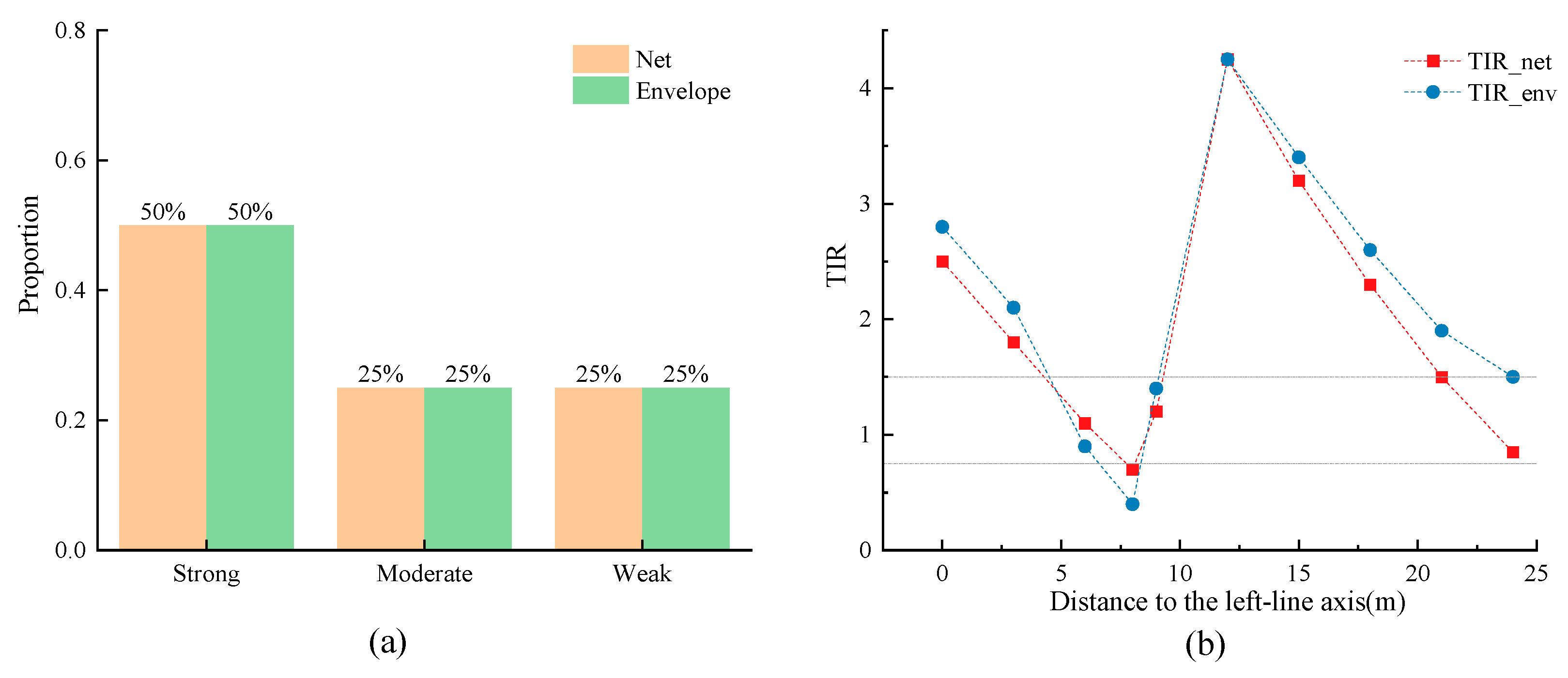

To enhance the robustness of the classification, critical threshold bands [0.75 ± ε] and [1.50 ± ε] are defined, with a recommended ε = 0.05. If the TIR value at any monitoring point—under either increment definition—falls within the critical band and satisfies ρ > 0.15 or ΔTIR = TIRenvTIRnet > δ (recommended δ = 0.20), it is also classified as a strong overlapping condition for pre-control purposes.
Thus, the tiered TIR classification serves not only as a risk trigger but also as a pragmatic proxy for targeting energy-efficient control actions (e.g., low-threshold alerts and focused supplementary grouting).
Building on Peck’s Gaussian trough formulation (Equations (2) and (3)), surface settlement can be characterised by volume loss ratio vl and trough width i. To analyse disturbance intensity during the construction acceleration window, we introduce the volumetric increment ΔVL for this period, representing the corresponding ground loss. The incremental settlement during the acceleration phase can be expressed as
S ( y ) V L L 2 π i e x p ( y 2 2 i 2 )
where ΔVL is the volumetric increment (m2), i is the trough width (m), and y is the transverse distance from the tunnel axis (m). Denoting the left and right tunnel parameters as (ΔVLL, iL), (ΔVLR, iR, respectively, the first-order approximation of TIR becomes
T I R ( y ) V L L V L R · i R i L · e x p [ y 2 2 ( 1 i L 2 1 i R 2 ) ]
Equation (10) reveals three components governing TIR:
  • Volume ratio term (ΔVLLVLR): The dominant factor reflecting volumetric amplification when the second tunnel advances through pre-disturbed ground.
  • Trough convergence term (iR/iL): Amplifies TIR when iL < iR, capturing the deeper and narrower characteristics of the trailing tunnel response.
  • Spatial distribution term exp[–y2/2(1/iL2–1/iR2)]: When iL < iR, TIR(y) reaches its maximum at the tunnel axis, decreases within approximately one trough width (|y| ≈ i), exhibits a secondary rise near the trailing tunnel axis, and gradually diminishes in far-field region (|y| ≥ 2i). This trend aligns with field observations from EPB twin tunnelling in soft clay [31] and corroborates the deeper, narrower, and offset pattern identified in the transverse settlement analysis.
In practice, the volume-ratio and trough-convergence terms jointly map to short-term operational intensity; sections with persistently high TIR during the acceleration window tend to require greater instantaneous power and grout delivery.
To examine the classification robustness against rebound definitions and reveal the spatial distribution of superposition effects, Section A is analysed as an example. Figure 10 presents the proportions of strong, moderate, and weak TIR classifications under both ΔSnet and ΔSenv definitions, along with their variation with transverse distance from the left tunnel axis (including binned means and 95% confidence intervals). The overall classification proportions remain consistent between definitions (approximately 50%/25%/25% for strong/moderate/weak), indicating that the classification is insensitive to the choice of definition. Both TIR-y curves exhibit similar peak-valley-peak patterns, with ΔSenv values only slightly higher in far-field regions (≥ 20–25 m), suggesting that rebound effects primarily influence minor fluctuations at greater distances while having limited impact on near-axis classification.
The spatial zonation of TIR provides guidance for construction control strategies. Within the tunnel axis and trough width zone (|y| ≤ i), superposition effects are most pronounced, requiring designation as a high-sensitivity control zone. In the intermediate zone of 1–2 trough widths (i < |y| < 2i), TIR exhibits a secondary peak reflecting disturbance reconcentration, warranting optimised face pressure and grouting strategies. In far-field regions (|y| ≥ 2i), TIR decreases rapidly with distance, allowing standard monitoring frequencies, though the rebound ratio ρ should be evaluated to identify potential delayed rebound responses.

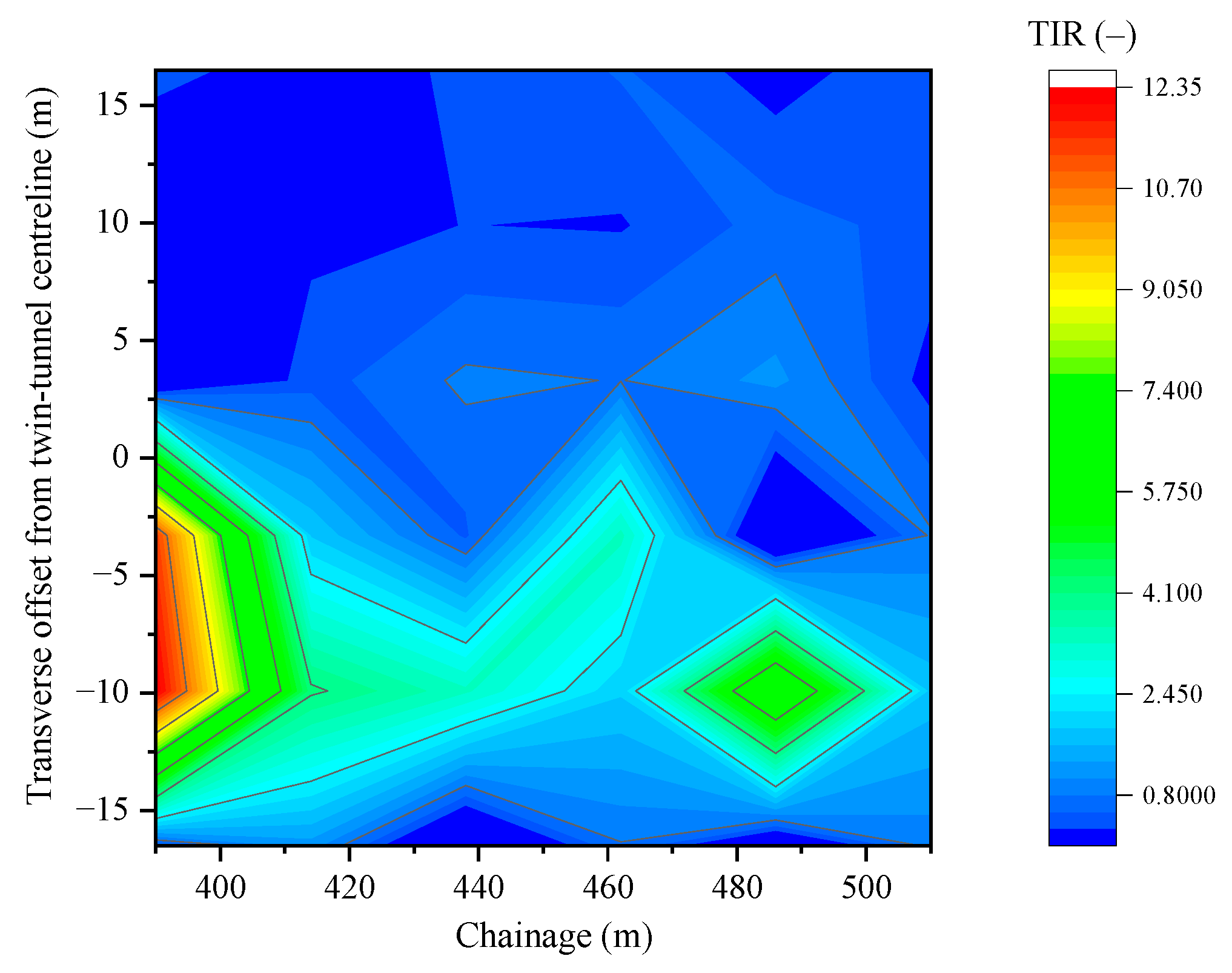

To complement the section-based TIR–y interpretation, a contour map is further provided to visualise the spatial distribution of interaction along the alignment (Figure 11). The map, constructed from monitoring-based max (TIRnet, TIRenv) values, highlights non-uniform “hotspots” of strong interaction between sections and confirms that elevated TIR is concentrated within the near-field band around the twin-tunnel centreline and decays rapidly with transverse distance. Beyond its mechanical meaning, TIR provides an operational proxy for construction input intensity; higher TIR generally implies greater electricity and grout use within overlapping disturbance zones. Section 4.4 builds on this proxy and quantifies the environmental implications (energy and carbon) associated with the observed TIR levels.

4.4. Environmental Implications and Carbon Efficiency of Sequential Twin-Tunnel Excavation

4.4.1. Methodological Basis for the Environmental Evaluation

To establish a methodological basis for interpreting the environmental implications of sequential disturbance, the construction-phase carbon emissions are formulated following the activity–emission structure used in life-cycle assessment (LCA):
C = ( A i f i )
where Ai denotes the intensity of construction activities (e.g., electricity use for TBM propulsion, grout consumption, corrective operations) and fi is the corresponding emission factor. LCA studies consistently show that electricity demand for shield operation and the production of cementitious materials dominate construction-stage emissions [24,39], typically accounting for more than 70–85% of the life-cycle total [40,41]. Representative emission factors—approximately 0.6 kg CO2/kWh for regional grid electricity and 0.8–0.9 kg CO2/kg for ordinary Portland cement—indicate that variations in energy demand and grout usage constitute the most carbon-sensitive components of mechanised tunnelling.
These relationships justify constructing a process-based proxy directly from field-measured deformation behaviour, because the dominant carbon sources are governed by the operational responses triggered by ground disturbance. Accordingly, the subsequent analysis focuses on identifying the deformation characteristics that best represent these disturbance-driven activity intensities. Based on the measured settlement development, the tunnelling process is divided into three construction-phase emission stages consistent with the observed mechanical behaviour:
  • Immediate settlement stage: corresponding to active shield propulsion, slurry circulation, and synchronous grouting. This period represents the peak in both energy input and settlement rate, dominated by mechanical excavation and high-frequency control of face pressure and grouting volume.
  • Time-dependent settlement stage: characterized by grout hydration and shrinkage, pore-pressure dissipation, and time-dependent soil deformation. Energy consumption gradually decreases but remains significant due to secondary grouting, continuous operation of support systems, and equipment standby during consolidation.
  • Secondary consolidation stage: reflecting minimal mechanical activity after the cessation of tunnelling works, with emissions mainly arising from monitoring, maintenance, and auxiliary system operation.
In addition to its mechanical relevance, the three stages correspond to distinct energy-demand patterns that underpin the environmental dynamics of tunnelling. Mechanically, the transformation of shield thrust and torque into ground deformation defines the efficiency of energy transfer. In weakly disturbed soils, most of the input energy contributes directly to advance, while in highly disturbed zones, part of the energy is dissipated as redundant cyclic stress and pore-pressure fluctuation, reducing energy productivity per unit excavation. This physical inefficiency explains why periods of accelerated settlement coincide with peaks in energy use and embodied-carbon output.
These energy-demand patterns provide the physical basis for linking ground-deformation behaviour to construction activity intensity. In EPB tunnelling, two mechanisms primarily govern the activity terms Ai: (i) the representative peak settlement, Smax,avg, reflecting the intensity of compensation actions typically required; and (ii) the active-control duration, ts, representing the period during which settlement rates remain high enough to necessitate continuous intervention.
These two mechanisms can be mapped to measurable settlement characteristics:
  • Disturbance magnitude, which controls the extent of compensation grouting, face-pressure correction, and thrust adjustment;
  • Duration of non-steady excavation, during which elevated energy consumption and repeated corrective actions persist.
Assuming the frequency and magnitude of corrective operations scale monotonically with disturbance intensity and duration, the activity term can be approximated as: AiSmax,avg ts.
To enable comparison among sections with different disturbance conditions, this activity-based term is normalised to a weak-interaction reference section (Section D), which serves as the baseline for defining the relative carbon-intensity index as
I c = S m a x , a v g × t s I c , D
The proposed Ic serves as a process-based, LCA-consistent indicator that links deformation behaviour with construction-phase environmental performance. Derived directly from field-measured settlement characteristics rather than detailed activity inventories, the index enables transparent and reproducible comparison of relative carbon intensity among sections. By anchoring the proxy to the dominant carbon sources and the disturbance-driven control actions that influence them, the framework provides a direct bridge between empirical monitoring and sustainability assessment, allowing in situ evaluation of the embodied-carbon implications of sequential tunnelling.

4.4.2. Environmental Effects of Sequential Disturbance

The sequential nature of twin-tunnel excavation introduces additional embodied carbon compared with single drives. As the trailing shield advances within an already disturbed and partially consolidated zone, duplicated grouting and energy-intensive correction measures are often required to maintain stability [42]. This cumulative disturbance—quantified by the TIR—can thus be regarded as a measure of “carbon inefficiency”. Sections exhibiting high TIR values correspond to zones of intensified ground–machine interaction and redundant energy input. From an environmental standpoint, these high-TIR areas can be interpreted as “carbon hotspots” where geotechnical and energy inefficiencies converge. Identifying such regions provides a practical pathway to link field monitoring with real-time sustainability management.
To quantitatively relate these interaction patterns to construction-phase carbon intensity, the deformation-derived index Ic was evaluated for four representative sections and summarised in Table 2.
Because the relative carbon-intensity index Ic is directly proportional to the product Smax,avg·ts (Equation (12)), any increase in disturbance magnitude and the duration of non-steady excavation will be reflected as a higher Ic. The IcTIR relationship summarised in Table 2 therefore follows directly from the disturbance-driven amplification of energy and grout demand.
Sections A and C, already classified as strong-interaction zones (TIR ≥ 1.5), exhibit both larger settlements (≈35–40 mm) and prolonged high-activity periods (≈250–260 d). Their normalised indices are approximately 2.6 and 3.1 times that of Section D, respectively, implying that these locations required substantially more repeated compensation actions. In operational terms, this corresponds to higher shield-energy consumption (sustained face-pressure control, thrust corrections, extended operation under non-steady attitude) and greater cementitious-material usage in synchronous and secondary grouting—both dominant contributors to embodied carbon during EPB tunnelling. By contrast, Section D (classified as weak interaction, TIR < 0.75) shows smaller peak settlement (≈24 mm) and a much shorter active-control window (≈140 d); it was therefore used as the baseline (relative index = 1.0). The moderate-interaction Section B falls in between (≈1.5× baseline). This non-linear increase in Ic with TIR reflects diminishing environmental efficiency: beyond a critical disturbance level, each unit of settlement control requires disproportionately higher energy and material input, compounding the environmental burden.
From a systems perspective, the co-location of mechanical risk and carbon intensity reveals that the same physical processes responsible for settlement amplification also govern environmental inefficiency. Integrating settlement monitoring into carbon-management frameworks can thus identify both deformation-sensitive and carbon-intensive zones in real time. This coupling enables adaptive control strategies—optimising face pressure, thrust rate, and grout dosage—to achieve concurrent stability enhancement and emission reduction. Such integration of geotechnical response and environmental performance aligns with the life-cycle sustainability principles of underground infrastructure.
From an engineering-control standpoint, TIR is thus not only a deformation-management index but also a sustainability indicator. High TIR (≥1.5) flags zones where advance face-pressure optimization, early micro-adjustment of shield attitude, and low-clinker/high-filler grouting blends can deliver dual benefits: reduced peak settlement and lower construction-phase embodied carbon. Overall, the findings suggest that ground behaviour, energy consumption, and carbon intensity are mutually reinforcing phenomena driven by the same disturbance dynamics. The proposed framework quantitatively links mechanical efficiency and environmental performance, but also provides a basis for broader comparisons and extensions beyond the present EPB case.
To extend the contextual relevance of the findings beyond EPB tunnelling, it is useful to relate the observed sequential-interaction mechanisms to other staged-excavation methods. The New Austrian Tunnelling Method (NATM) provides a representative comparison: its multi-step excavation and stress-redistribution cycles can also generate overlapping influence zones between successive stages. Monitoring-based NATM studies [43] report that the accumulation of stress redistribution across excavation steps can lead to asymmetric and difficult-to-stabilise ground responses, echoing the sequential interaction pattern associated with high TIR in this study. The main difference lies in disturbance distribution: NATM typically produces a broader but more diffuse influence zone due to greater stress release, whereas EPB tunnelling induces a more localised, deeper–narrower response governed by face-pressure confinement and synchronous grouting. This suggests that although the TIR framework is developed for mechanised EPB tunnelling, it represents a generic disturbance-superposition mechanism that could, with appropriate calibration, be adapted to other staged-excavation tunnelling methods.
Beyond the methodological comparison, the interaction mechanisms quantified in this study—such as ahead-of-face disturbance from the trailing excavation, cumulative ground response within overlapping influence zones, and the non-linear amplification reflected by high TIR—are governed primarily by soil–structure interaction and are therefore not exclusive to metro tunnels. Accordingly, similar effects may arise in highway tunnels when twin or closely spaced bores are excavated sequentially [44]. This implies that amplification and asymmetry of settlement troughs should be incorporated into design envelopes, that refined control of face pressure and excavation attitude is required during the trailing drive within predicted interaction zones, and that optimization of bore spacing or excavation timing can reduce duplicated disturbance and associated grouting demand. Consequently, the sequential-interaction framework established here offers a transferable basis for improving both deformation control and environmental performance in highway tunnel construction.
In addition to the above engineering implications, the environmental performance of sequential tunnelling can also be improved through the adoption of green construction materials and low-carbon technologies. In high-interaction (high-TIR) zones, where repeated grouting and intensified face-pressure control typically increase embodied carbon, the use of low-clinker or supplementary-cementitious-material (SCM) grouts can substantially reduce cement-related emissions while maintaining the required rheological and mechanical performance, as demonstrated in recent evaluations of SCM-based backfilling grouts for shield tunnelling [45]. Likewise, incorporating shield muck and other recycled constituents into backfilling mixtures offers a viable pathway to reduce the reliance on cementitious binders and enhance environmental sustainability without compromising engineering applicability [46]. Furthermore, emerging carbon-neutral technologies—such as electric or hybrid shield drive systems, energy-recovery hydraulic units, and real-time parameter optimization supported by digital monitoring—provide additional means of mitigating the energy peaks associated with sequential excavation. Integrating these material- and technology-based measures with the interaction-based control framework developed in this study can therefore enhance both deformation management and construction-phase carbon efficiency.

5. Conclusions

Based on long-term field monitoring of sequential twin-tunnel construction in the Hangzhou Metro, the main conclusions address the mechanical response, environmental and carbon-efficiency implications, and practical recommendations and future research.
  • Surface settlement induced by twin-tunnel excavation develops in three stages: immediate, time-dependent, and secondary consolidation. After the first (right) tunnel passes, rapid settlement occurs within 8–10 days and mainly affects a zone of about one trough width (6–8 m) on either side of the tunnel axis; subsequent development is controlled by grout behaviour, pore-pressure dissipation, creep, and long-term consolidation. Ahead-of-face settlement is observed at about 2D before the arrival of the second (left) tunnel, indicating pre-disturbance by the first drive. The trailing tunnel advances in disturbed and partially consolidated ground, leading to larger and longer-lasting peak settlements and a narrower, deeper trough than the leading tunnel. Transverse settlement profiles of both individual tunnels and their superposed response can be fitted with Peck’s Gaussian function; the composite trough is asymmetric about the tunnel-pair centreline, with the maximum shifted toward the trailing tunnel and showing a deeper, narrower, and offset pattern.
  • The Twin-tunnel Interaction Ratio (TIR) provides a quantitative index of superposition effects and can be linked to construction-phase carbon emissions through a process-based carbon-intensity proxy. On this basis, the monitoring sections are classified as strong-interaction, moderate-interaction, and weak-interaction sections. Strong-interaction sections exhibit larger mean peak settlements and longer active-control durations, with carbon-intensity levels about 2–3 times those of the weak-interaction baseline; moderate-interaction sections are about 1.5 times the baseline. These sections act as “carbon hotspots”, where repetitive disturbance, duplicated grouting, and prolonged high-intensity shield control cause electricity and material consumption to exceed those in weak-interaction zones. The three settlement stages correspond to immediate, time-dependent, and secondary emission stages, linking geotechnical monitoring to construction-phase carbon management and showing that high TIR values are unfavourable in both mechanical and environmental terms.
  • In practice, combining time–series settlement curves, Gaussian-fitted trough parameters, and TIR-based zonation provides an interaction-oriented control strategy. Early warning is recommended when TIR ≥ 1.5 or when monitoring points in critical zones show pronounced rebound. Within one trough width of the tunnel axis, superposition effects are strongest and graded adjustment of face and grout pressures, multi-point supplementary grouting, and intensified settlement monitoring should be adopted; in the secondary-peak zone at 1–2 trough widths, optimised control parameters can be used for refined adjustment; beyond two trough widths, standard monitoring frequencies are generally sufficient, using the rebound ratio ρ to identify delayed responses. The study is limited to a single EPB twin-tunnel project in soft ground, with empirical TIR thresholds and normalised carbon-intensity levels that require calibration for other ground conditions, tunnel sizes, and construction methods, and an environmental assessment based on a process-oriented proxy rather than a full life-cycle inventory. Future work should couple TIR and settlement-derived indicators with detailed records of shield energy use, grout volumes, and material flows to develop LCA-based emission models, validate and refine the proposed thresholds and zonation across a wider range of metro and highway tunnels, and examine the applicability of the TIR–carbon framework to other staged-excavation methods such as NATM.

Author Contributions

Conceptualization, X.Z., H.C. and Y.Z.; methodology, X.Z. and L.H.; validation, X.Z. and J.W.; formal analysis, X.Z.; investigation, X.Z. and S.D.; data curation, J.W.; writing—original draft preparation, X.Z.; writing—review and editing, H.C.; visualization, X.Z.; supervision, H.C. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Data Availability Statement

The data presented in this study are available on request from the corresponding author.

Conflicts of Interest

Author Xin Zhou was employed by the company Jilin Municipal Construction Group Co., Ltd. The remaining authors declare that the research was conducted in the absence of any commercial or financial relationships that could be construed as a potential conflict of interest.

References

  1. Lu, K.; Zhang, L.; Li, S.; Huang, Y.; Ding, X.; Hao, J.; Huang, S.; Li, X.; Lu, F.; Zhang, H. Urban Rail Transit in China: Progress Report and Analysis (2015–2023). Urban Rail Transit 2025, 11, 1–27. [Google Scholar] [CrossRef]
  2. Wang, Q.; Shen, C.; Tang, C.; Guo, Z.; Wu, F.; Yang, W. Machine learning-based forecasting of ground surface settlement induced by metro shield tunneling construction. Sci. Rep. 2024, 14, 31795. [Google Scholar] [CrossRef] [PubMed]
  3. He, R.; Zhou, Z.; Li, S.; Vanapalli, S. Investigating Surface Settlements During Shield Tunneling Using Numerical Analysis. Sustainability 2025, 17, 20. [Google Scholar] [CrossRef]
  4. Wang, H.-B.; Zhang, R.-J.; Tao, F.-J.; Zheng, J.-J. Study on long-term surface settlement induced by shield tunneling in under-consolidated soft ground. Tunn. Undergr. Space Technol. 2024, 148, 105772. [Google Scholar] [CrossRef]
  5. Pedro, A.; Cancela, T.; Almeida e Sousa, J.; Grazina, J. Deformations caused by the excavation of twin tunnels. In Geotechnical Aspects of Underground Construction in Soft Ground; Balkema: London, UK, 2018; pp. 203–213. [Google Scholar]
  6. Chapman, D.N.; Ahn, S.K.; Hunt, D.V. Investigating ground movements caused by the construction of multiple tunnels in soft ground using laboratory model tests. Can. Geotech. J. 2007, 44, 631–643. [Google Scholar] [CrossRef]
  7. Fang, Q.; Liu, X.; Zeng, K.; Zhang, X.; Zhou, M.; Du, J. Centrifuge modelling of tunnelling below existing twin tunnels with different types of support. Undergr. Space 2022, 7, 1125–1138. [Google Scholar] [CrossRef]
  8. Soomro, M.A. Influence of twin stacked tunnels on the performance of laterally loaded pile group. Can. Geotech. J. 2025, 62, 1–23. [Google Scholar] [CrossRef]
  9. Lu, H.; Shi, J.; Wang, Y.; Wang, R. Centrifuge modeling of tunneling-induced ground surface settlement in sand. Undergr. Space 2019, 4, 302–309. [Google Scholar] [CrossRef]
  10. Chen, R.P.; Zhu, J.; Liu, W.; Tang, X.W. Ground movement induced by parallel EPB tunnels in silty soils. Tunn. Undergr. Space Technol. 2011, 26, 163–171. [Google Scholar] [CrossRef]
  11. Gong, C.; Ding, W.; Xie, D. Twin EPB tunneling-induced deformation and assessment of a historical masonry building on Shanghai soft clay. Tunn. Undergr. Space Technol. 2020, 98, 103300. [Google Scholar] [CrossRef]
  12. Li, L.; Yao, A. Investigation on Response of Site of Typical Soil–Rock Composite Strata in Changchun Induced by Shield Construction of Parallel Twin Tunnels. Appl. Sci. 2024, 14, 500. [Google Scholar] [CrossRef]
  13. Rigamonti, S.; Previati, A.; Dattola, G.; Crosta, G.B. Assessing twin tunnel-induced ground settlements in alluvial deposits by InSAR data. Eng. Geol. 2025, 352, 108059. [Google Scholar] [CrossRef]
  14. Park, H.; Oh, J.-Y.; Kim, D.; Chang, S. Monitoring and Analysis of Ground Settlement Induced by Tunnelling with Slurry Pressure-Balanced Tunnel Boring Machine. Adv. Civ. Eng. 2018, 1, 5879402. [Google Scholar] [CrossRef]
  15. Addenbrooke, T.I.; Potts, D.M. Twin Tunnel Interaction: Surface and Subsurface Effects. Int. J. Geomech. 2001, 1, 249–271. [Google Scholar] [CrossRef]
  16. Do, N.A.; Dias, D.; Golpasand, M.-R.B.; Dang, V.K.; Nait-Rabah, O.; Pham, V.V.; Dang, T.T. Numerical analyses of twin stacked mechanized tunnels in soft grounds—Influence of their position and construction procedure. Tunn. Undergr. Space Technol. 2022, 130, 104734. [Google Scholar] [CrossRef]
  17. Hu, Y.; Tang, H.; Xu, Y.; Lei, H.; Zeng, P.; Yao, K.; Dong, Y. Ground settlement and tunnel response due to twin-curved shield tunnelling in soft ground with small clear distance. J. Rock Mech. Geotech. Eng. 2024, 16, 3122–3135. [Google Scholar] [CrossRef]
  18. Yun, J.-s.; Kim, H.-e.; Yoo, H.-k. Three-Dimensional Modeling and Analysis of Ground Settlement Due to Twin Tunneling Using GIS. Sustainability 2024, 16, 5891. [Google Scholar] [CrossRef]
  19. Zhang, J.; Pan, T.; Ma, K.; Xu, Q.; Kong, C. Modified stochastic medium prediction model for the deformation response of concealed underground stations under existing pipelines. Sci. Rep. 2023, 13, 9843. [Google Scholar] [CrossRef]
  20. Xu, Q.; Lei, S.; Zhu, Y.; Zhao, W.; Wang, C.; Wang, D. Theoretical Prediction Model for Surface Settlement Caused by the Excavation of New Tunnels Undercrossing Existing Tunnels Based on Modified Stochastic Medium Theory. KSCE J. Civ. Eng. 2022, 26, 4136–4145. [Google Scholar] [CrossRef]
  21. Suwansawat, S.; Einstein Herbert, H. Describing Settlement Troughs over Twin Tunnels Using a Superposition Technique. J. Geotech. Geoenviron. Eng. 2007, 133, 445–468. [Google Scholar] [CrossRef]
  22. Liu, Y.; Li, Y.; Chen, G.; Li, Y.; Li, J.; Jin, J. Theoretical Analysis of Surface Settlement During Parallel Construction of a Double-Track Tunnel with Small Spacing. Buildings 2025, 15, 1143. [Google Scholar] [CrossRef]
  23. Kong, F.; Lu, D.; Du, X.; Shen, C. Elastic analytical solution of shallow tunnel owing to twin tunnelling based on a unified displacement function. Appl. Math. Model. 2019, 68, 422–442. [Google Scholar] [CrossRef]
  24. Wang, G.; Fang, Q.; Wang, J.; Li, Q.; Zhou, M. Ground movement prediction for twin tunnels with minimum total potential energy principle considering volumetric change of soil. Transp. Geotech. 2024, 49, 101452. [Google Scholar] [CrossRef]
  25. Shi, X.; Kou, L.; Liang, H.; Wang, Y.; Li, W. Evaluating Carbon Emissions during Slurry Shield Tunneling for Sustainable Management Utilizing a Hybrid Life-Cycle Assessment Approach. Sustainability 2024, 16, 2702. [Google Scholar] [CrossRef]
  26. Islam, M.S.; Iskander, M. Twin tunnelling induced ground settlements: A review. Tunn. Undergr. Space Technol. 2021, 110, 103614. [Google Scholar] [CrossRef]
  27. Huat, C.Y.; Armaghani, D.J.; Lai, S.H.; Motaghedi, H.; Asteris, P.G.; Fakharian, P. Analyzing surface settlement factors in single and twin tunnels: A review study. J. Eng. Res. 2025, 13, 2096–2108. [Google Scholar] [CrossRef]
  28. Li, Y.; Lin, J.; Yan, S.; Du, J. Modification of the Peck Formula for a Double-Track Shield Tunnel under Expressway Subgrade. Symmetry 2022, 14, 1904. [Google Scholar] [CrossRef]
  29. Wang, S.; Song, Z.; Tian, X.; Sun, Y.; Zhang, Y. Prediction for the surface settlement of double-track subway tunnels for shallow buried loess based on peck formula. Front. Earth Sci. 2023, 11, 2023. [Google Scholar] [CrossRef]
  30. Jiang, Z.; Wang, Y. Numerical Analysis of Ground Settlement of Close Buried Double-Line Shield Tunnels Under Different Excavation Conditions. Appl. Sci. 2025, 15, 1936. [Google Scholar] [CrossRef]
  31. Richard, N.H.; Za-Chieh, M. Prediction of Long-Term Settlements Induced by Shield Tunneling. J. Geoengin. 2006, 1, 63–70. [Google Scholar] [CrossRef]
  32. Deng, L.-C.; Zhang, W.; Deng, L.; Shi, Y.-H.; Zi, J.-J.; He, X.; Zhu, H.-H. Forecasting and early warning of shield tunnelling-induced ground collapse in rock-soil interface mixed ground using multivariate data fusion and Catastrophe Theory. Eng. Geol. 2024, 335, 107548. [Google Scholar] [CrossRef]
  33. Loganathan, N.; Poulos, H.G. Analytical Prediction for Tunneling-Induced Ground Movements in Clays. J. Geotech. Geoenvironmental Eng. 1998, 124, 846–856. [Google Scholar] [CrossRef]
  34. Vardanega, P.J.; Bolton, M.D. Stiffness of Clays and Silts: Normalizing Shear Modulus and Shear Strain. J. Geotech. Geoenvironmental Eng. 2013, 139, 1575–1589. [Google Scholar] [CrossRef]
  35. Mair, R.J. Tunnelling and geotechnics: New horizons. Géotechnique 2008, 58, 695–736. [Google Scholar] [CrossRef]
  36. Jin, H.; Yuan, D.; Zhou, S.; Zhao, D. Short-Term and Long-Term Displacement of Surface and Shield Tunnel in Soft Soil: Field Observations and Numerical Modeling. Appl. Sci. 2022, 12, 3564. [Google Scholar] [CrossRef]
  37. Peck, R.B. Deep excavations and tunnelling in soft ground. In Proceedings of the 7th International Conference on Soil Mechanics and Foundation Engineering, Mexico City, Mexico, 22–30 August 1969; A.A. Balkema: London, UK, 1969; pp. 225–290. [Google Scholar]
  38. Sun, F.; Jin, Z.; Wang, C.; Gou, C.; Li, X.; Liu, C.; Yu, Z. Case Study on Tunnel Settlement Calculations during Construction Considering Shield Disturbance. KSCE J. Civ. Eng. 2023, 27, 2202–2216. [Google Scholar] [CrossRef]
  39. Wang, G.; Lu, D.; Ji, G.; Liang, X.; Lin, Q.; Lv, J.; Du, X. A lifecycle carbon emission evaluation model for urban underground highway tunnel facilities. Undergr. Space 2025, 24, 352–370. [Google Scholar] [CrossRef]
  40. Zheng, S.; Xie, X.; Zhou, B. Accounting Method and Indicators of Multilevel CO2 Emissions Based on Cost During Construction of Shield Tunnels. Appl. Sci. 2024, 14, 9552. [Google Scholar] [CrossRef]
  41. Rodríguez, R.; Bascompta, M.; García, H. Carbon Footprint Evaluation in Tunnels Excavated in Rock Using Tunnel Boring Machine (TBM). Int. J. Civ. Eng. 2024, 22, 995–1009. [Google Scholar] [CrossRef]
  42. Li, W.; Kou, L.; He, X.; Wang, Y.; Shi, X.; Liang, H. Investigation of carbon emission in slurry shield tunnel construction based on modified process analysis method. Low-Carbon Mater. Green Constr. 2023, 1, 18. [Google Scholar] [CrossRef]
  43. Kontogianni, V.A.; Stiros, S.C. Induced deformation during tunnel excavation: Evidence from geodetic monitoring. Eng. Geol. 2005, 79, 115–126. [Google Scholar] [CrossRef]
  44. Chakeri, H.; Hasanpour, R.; Hindistan, M.A.; Ünver, B. Analysis of interaction between tunnels in soft ground by 3D numerical modeling. Bull. Eng. Geol. Environ. 2011, 70, 439–448. [Google Scholar] [CrossRef]
  45. Liu, C.; Li, Y.; Bezuijen, A.; Cachim, P.; Mei, G. Rheological characteristics and model applicability of shield tunnel backfilling grouts with supplementary cementitious materials. Tunn. Undergr. Space Technol. 2024, 154, 106121. [Google Scholar] [CrossRef]
  46. Yang, J.; Li, M.; Ma, S.; Xiao, M.; Jin, J. Eco-Friendly Shield Muck-Incorporated Grouting Materials: Mix Optimization and Property Evaluation for Silty Clay Tunnel Construction. Appl. Sci. 2024, 14, 8830. [Google Scholar] [CrossRef]
Figure 1. Schematic cross-section of the twin circular tunnels, illustrating the geometric arrangement of the leading (right) and trailing (left) drives and the segment configuration. Different colors indicate different segment types and positions within a lining ring.
Figure 1. Schematic cross-section of the twin circular tunnels, illustrating the geometric arrangement of the leading (right) and trailing (left) drives and the segment configuration. Different colors indicate different segment types and positions within a lining ring.
Buildings 16 00025 g001
Figure 2. Geological profile of the site.
Figure 2. Geological profile of the site.
Buildings 16 00025 g002

Figure 3. Layout of ground surface monitoring points.
Figure 3. Layout of ground surface monitoring points.
Buildings 16 00025 g003

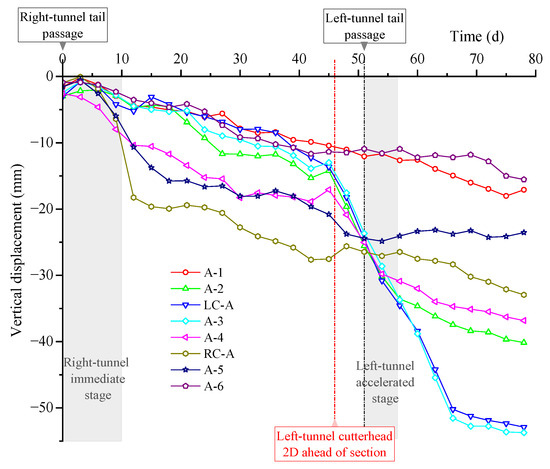

Figure 4. Development of surface settlement over time at monitoring points in Section A, with markers for tail passages, grouting stages, and the ahead-of-face response.
Figure 4. Development of surface settlement over time at monitoring points in Section A, with markers for tail passages, grouting stages, and the ahead-of-face response.
Buildings 16 00025 g004
Figure 5. Development of surface settlement over time at monitoring points in Section B, with markers for tail passages, grouting stages, and the ahead-of-face response.
Figure 5. Development of surface settlement over time at monitoring points in Section B, with markers for tail passages, grouting stages, and the ahead-of-face response.
Buildings 16 00025 g005
Figure 6. Development of surface settlement over time at monitoring points in Section C, with markers for tail passages, grouting stages, and the ahead-of-face response.
Figure 6. Development of surface settlement over time at monitoring points in Section C, with markers for tail passages, grouting stages, and the ahead-of-face response.
Buildings 16 00025 g006
Figure 7. Development of surface settlement over time at monitoring points in Section D, with markers for tail passages, grouting stages, and the ahead-of-face response.
Figure 7. Development of surface settlement over time at monitoring points in Section D, with markers for tail passages, grouting stages, and the ahead-of-face response.
Buildings 16 00025 g007
Figure 8. Development of surface settlement over time at monitoring points along the left and right tunnel centerlines.
Figure 8. Development of surface settlement over time at monitoring points along the left and right tunnel centerlines.
Buildings 16 00025 g008
Figure 9. Transverse surface settlement at Sections A–D. (a) Section A; (b) Section B; (c) Section C; (d) Section D.
Figure 9. Transverse surface settlement at Sections A–D. (a) Section A; (b) Section B; (c) Section C; (d) Section D.
Buildings 16 00025 g009
Figure 10. TIR classification (net vs. envelope) and spatial trend in section A. (a) Class proportions under net vs. envelope definitions of TIR; (b) TIR versus distance to the left-line axis.
Figure 10. TIR classification (net vs. envelope) and spatial trend in section A. (a) Class proportions under net vs. envelope definitions of TIR; (b) TIR versus distance to the left-line axis.
Buildings 16 00025 g010
Figure 11. Contour map of max(TIRnet, TIRenv) showing its spatial distribution along the tunnel alignment (Sections A–D).
Figure 11. Contour map of max(TIRnet, TIRenv) showing its spatial distribution along the tunnel alignment (Sections A–D).
Buildings 16 00025 g011
Table 1. Physical and mechanical properties of the soil strata.
Table 1. Physical and mechanical properties of the soil strata.
Soil LayerUnit Weight γ/kN/m3Water
Content
ω/%
Specific
Gravity
Gs
Void Ratio
e
Permeability Coefficient/10−6 cm/sCompression Modulus
Es0.1–0.2/MPa
Consolidated
Quick Shear
khkvc (kPa)φ (°)
1-------(3.0)(18.0)
2-------(8.0)(15.0)
119.127.62.700.80314.0274.011.67.727.1
319.426.32.690.76401.0371.012.16.128.7
519.525.42.690.73510.0452.012.85.129.9
619.724.52.680.70857.0794.013.44.232.1
118.038.02.731.10(2.0)0.813.614.19.5
1–319.126.22.680.77747.0(65.0)9.65.323.1
218.137.72.721.084.484.893.813.79.4
217.937.12.731.10--4.119.211.0
318.432.22.720.96--4.720.512.5
119.424.82.690.73--11.43.434.2
Table 2. Construction-phase disturbance intensity, active-control duration, and relative carbon-intensity index (Ic) among Sections A–D.
Table 2. Construction-phase disturbance intensity, active-control duration, and relative carbon-intensity index (Ic) among Sections A–D.
SectionTIR LevelMean Peak Settlement
Smax,avg (mm)
Active-Control Duration
ts (d)
Relative Carbon-
Intensity Index
Ic
Carbon Increase vs.
Weak Zone
AStrong
(TIR ≥ 1.5)
352502.6 × (baseline)+160%
BModerate
(0.75 ≤ TIR < 1.5)
281801.5 × (baseline)+50%
CStrong
(TIR ≥ 1.5)
402603.1 × (baseline)+210%
DWeak
(TIR < 0.75)
241401.0 (baseline)-
Note: Values are approximate representative averages derived from the monitoring data of each section and normalised to Section D. They are presented to illustrate relative magnitude and comparative trends rather than absolute measurements.
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Zhou, X.; Chen, H.; Zhou, Y.; Hou, L.; Wang, J.; Du, S. Measured Spatiotemporal Development and Environmental Implications of Ground Settlement and Carbon Emissions Induced by Sequential Twin-Tunnel Shield Excavation. Buildings 2026, 16, 25. https://doi.org/10.3390/buildings16010025

AMA Style

Zhou X, Chen H, Zhou Y, Hou L, Wang J, Du S. Measured Spatiotemporal Development and Environmental Implications of Ground Settlement and Carbon Emissions Induced by Sequential Twin-Tunnel Shield Excavation. Buildings. 2026; 16(1):25. https://doi.org/10.3390/buildings16010025

Chicago/Turabian Style

Zhou, Xin, Haosen Chen, Yijun Zhou, Lei Hou, Jianhong Wang, and Sang Du. 2026. "Measured Spatiotemporal Development and Environmental Implications of Ground Settlement and Carbon Emissions Induced by Sequential Twin-Tunnel Shield Excavation" Buildings 16, no. 1: 25. https://doi.org/10.3390/buildings16010025

APA Style

Zhou, X., Chen, H., Zhou, Y., Hou, L., Wang, J., & Du, S. (2026). Measured Spatiotemporal Development and Environmental Implications of Ground Settlement and Carbon Emissions Induced by Sequential Twin-Tunnel Shield Excavation. Buildings, 16(1), 25. https://doi.org/10.3390/buildings16010025

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Article metric data becomes available approximately 24 hours after publication online.
Back to TopTop
