Article

Identifying Dominant Inflation Risks in Residential Construction Projects Using Fuzzy Truth Qualification

Department of Civil Engineering, Zonguldak Bulent Ecevit University, Zonguldak 67100, Türkiye
*
Author to whom correspondence should be addressed.
Sustainability 2026, 18(3), 1317; https://doi.org/10.3390/su18031317
Submission received: 1 January 2026 / Revised: 26 January 2026 / Accepted: 27 January 2026 / Published: 28 January 2026

Abstract

Persistent inflation has intensified uncertainty in the construction industry, particularly in volatile economies. Inflation-driven risks affecting Turkish residential projects are examined in this study, focusing on rising costs, fluctuating labor and material prices, and associated risks. The power-based linguistic hedges were used to quantify dominant severity levels under uncertainty based on descriptive statistics and standard deviation thresholds. Results indicate that inflation mostly impacts projects through budget overruns and wage inflation, which exhibit the highest severity and crisis-level risk behaviors. A number of factors drive material price volatility, particularly macroeconomic instability, currency depreciation, and supply-chain disruptions. There is a sustained pressure on contractor profitability due to wage inflation. In contrast, inflation-related effects on schedule, quality, safety, and contractual disputes are secondary and context-dependent. The findings indicate a structural shift in the risk profile of Turkish residential construction, indicating a need for inflation-resilient cost management, adaptive contracting, and proactive labor planning.

1. Introduction

The construction industry plays a significant role in economic development by building homes and infrastructure [1], creating jobs, and supporting economic stability [2], but it is severely impeded by inflation and instability [3]. Inflation has a significant impact on the construction industry directly or indirectly [4]. Both developed and developing countries are prone to over-budgeting due to inflation [5]. Several researchers have studied the impact of inflation on the construction industry [6,7,8,9,10]. Building material prices, labor wages, and equipment rental costs are directly affected by inflation [11], resulting in a deviation from the project’s initial budget [12]. Several factors influence materials costs, including supply and demand, market conditions, transport and energy costs, raw materials, labor costs, crude oil prices, exchange rates, import duties, and inflation, resulting in a revision in the initial budget and projects’ outputs [11,12]. Another major resource for construction projects that influences budgets is labor wages [13]. Construction labor productivity is an important economic performance indicator in many countries because labor costs account for almost 30 to 60% of total construction costs [14]. According to Moyanga and Saka [3], to stabilize the construction industry, the government should implement fiscal and monetary measures to control inflation. In addition, it should increase local content to reduce construction costs to protect the sector from foreign exchange market fluctuations.
The housing sector has experienced a drop in investment due to rising interest rates and the withdrawal of public support schemes, which are significantly influencing construction investments.
In recent years, several macroeconomic factors, including rising interest rates, high inflation, and currency volatility, have contributed to a decline in housing investment and production in Türkiye. For instance, housing investment is projected to decrease by 7.7% in 2024 and by 3.9% in 2025 [15]. The Turkish government has played a significant role in the housing sector. The Housing Development Administration of the Republic of Türkiye (TOKİ) has historically supported large-scale social housing for low- and middle-income groups, delivering over one million units since the early 2000s; however, recent demand-stimulating policies have been constrained by high financing costs and ongoing macroeconomic volatility.
There have been numerous studies on the effects of inflation on construction, but relatively few have addressed the effects on residential construction, despite its heightened sensitivity to cost volatility and affordability constraints. Over the past five years, construction costs in Türkiye have increased substantially because of inflation and economic fluctuations. Accordingly, this study evaluates the impact of inflation on residential construction projects in Türkiye during the period 2020–2025, using data collected through a questionnaire survey administered to construction professionals, suppliers, and clients/owners. This study analyzes how inflationary pressures affect project costs, schedules, and resource allocation in residential construction projects, and examines the challenges faced by stakeholders during high inflation periods. It also examines strategies and risk management approaches to mitigate inflation’s negative impacts.
Most empirical studies on inflation impacts in construction rely on descriptive rankings or single-point statistical comparisons, which identify relevant factors but provide limited insight into their severity under prolonged and volatile inflationary conditions. Furthermore, inflation impacts are often treated as discrete events without accounting for the uncertainty and gradation inherent in perception-based assessments. The study contributes to the literature by examining residential construction projects, which are underrepresented and highly sensitive to inflation. It also integrates Relative Importance Index (RII) analysis with fuzzy truth qualification to allow severity-based interpretation under uncertain conditions.
Besides offering practical insights for policymakers, project managers, and industry professionals, the study also provides evidence-driven recommendations to enhance residential construction resilience and decision-making. Since severity assessments in construction management surveys are inherently subjective and influenced by experience and context, a fuzzy logic approach is used to improve interpretability and reliability. Rather than relying on rigid thresholds, the proposed framework operationalizes linguistic hedges as truth qualifiers using power-based operators. However, the study is limited to residential construction projects and does not address non-residential sectors like industrial or infrastructure construction, nor does it analyze global inflation trends beyond their local impacts.

2. Materials and Methods

A quantitative, questionnaire-based methodology is employed to examine how inflation affects residential construction projects. Responses were rated on a 5-point Likert scale according to how much they agreed with statements describing inflation’s impact on residential construction projects. Statistical analysis was conducted using Excel to determine the impact of inflation on these projects. The following are descriptions of the questionnaire, sampling strategy, data collection procedures, and statistical methods used to analyze Likert-scale data.

2.1. Research Design

The impact of inflation on residential construction projects was evaluated by developing 30 questions and dividing them into seven sections based on a thorough literature review and interview with experts: (A) Respondents’ profile, (B) Inflation’s impact overview, (C) Inflation impacts on budgets, (D) Inflation impacts on material prices, (E) Inflation impacts on labor wages, (F) Inflation-related project delays, and (G) Mitigation measures.
An online questionnaire was chosen as the most convenient method to deliver and collect responses in this study. This questionnaire was created using Google Forms and emailed to building construction professionals, suppliers, and clients/owners in Türkiye. There are four dominant methods of surveys extensively discussed in the literature: mail surveys, personal surveys, telephone surveys, and online surveys [16]. Data collection through online surveys has become more popular due to their ease of use [17], and online surveys can be significantly more effective than other formats when conducted properly [16]. Online surveys have many advantages, such as global reach, flexibility, speed, timeliness, technological innovations, convenience, ease of data entry and analysis, a diverse list of questions, low administration costs, and easy follow-up [16,18].
In this study, the majority of questions are closed-ended with Likert scales in this study: 18 have closed-ended with 1–5 point Likert scale, 1 has open-ended, 4 have multiple-response, and 7 have single-response.

2.2. Ethics Considerations

Zonguldak Bulent Ecevit University’s Human Research Ethics Committee approved this study on 25 June 2025/616484, protocol number 218. The online questionnaire included a consent form explaining the study’s purpose and explaining confidentiality terms.

2.3. Data Collection

A questionnaire designed to analyze the impact of inflation on residential building projects during the 2020–2025 period, characterized by high inflation, exchange-rate volatility, rising interest rates, and pandemic-related economic shocks, was distributed to 700 stakeholders involved in residential construction projects in Türkiye, yielding 363 valid responses. This resulted in a response rate of 52%. To ensure construct validity, data were cleaned up by excluding respondents who answered ‘no idea’ to more than 40% of items, and by excluding respondents who had variances less than or equal to 0.10. The remaining 264 samples were then analyzed.

2.4. Data Analysis

A summated Likert scale (multi-item Likert scale) was proposed by Likert [19] as a method of assessing survey respondents’ attitudes. It is composed of several Likert-type items that measure the same latent construct, usually by summing or averaging to produce one overall score. Likert-type items, on the other hand, are single questions that utilize some aspect of the original Likert response alternatives [20,21].
Likert-type and Likert scale data are analyzed differently. A variable can be measured on four different scales (the Steven’s scale): nominal, ordinal, interval, and ratio [22]. Nominal scales are used for categorical variables without order, such as gender, type of building, type of contract, or occupation. Categorization numbers serve only as labels. Ordinal scales are used when responses have a meaningful order and are ranked by some measure of magnitude. A number assigned to a group expresses a “greater than” relationship, but how much greater is not stated. Interval scale data also use numbers to indicate order and reflect a meaningful relative distance between points with equal intervals on a scale without an absolute zero. Ratio scales are similar to interval scales except that they have an absolute zero, such as age, years of experience, cost, duration, or height [22,23]. The interval data provides more information than the ordinal data, and the ordinal data provides more information than the nominal data [22]. In empirical research, Likert scales are commonly used to capture human attitudes and perceptions [24]. A Likert-type item falls into the ordinal measurement category. However, Likert scale data are analyzed on an interval measurement scale [20]. It is recommended by Boone and Boone [20] that Likert-type items be analyzed using the mode or median for central tendency, frequencies for variability, Kendall’s Tau-B or Tau-C for associations, and the chi-square test. Likert scale data, on the other hand, can be analyzed using the mean for central tendency, standard deviations for variability, Pearson’s r for associations, and t-test, ANOVA, and regression.
In this study, survey data were analyzed using descriptive and exploratory statistical techniques. This included calculating the means and standard deviations to identify central tendencies and variability. Outlier analysis was used to detect extreme responses, which improved the reliability of the results. Also, threshold-based comparisons (e.g., M ± SD) were performed to classify items based on their relative importance, allowing the study to distinguish between dominant, average, and low-priority inflation-related factors.

2.5. Fuzzy Decision-Support System

Fuzzy logic-based representations were used to address the inherent vagueness and subjectivity of expert judgments. Power-based operators were applied to fuzzy membership values to implement linguistic hedges, allowing nuanced differentiation between dominant and non-dominant severity levels [25]. The approach allows partial memberships to be systematically strengthened or weakened, providing a more interpretable and robust severity classification than crisp threshold-based approaches. Figure 1 illustrates the application of power-based truth qualifiers (Equations (1) and (2)) to fuzzy membership values for severity interpretation.
S μ = μ 2 V e r y   t r u e μ T r u e μ F a i r l y   t r u e
S μ = ( 1 μ ) 2 V e r y   f a l s e 1 μ F a l s e 1 μ F a i r l y   f a l s e
The fuzzy framework converts aggregated perception scores into linguistic severity classes, namely negligible, low, moderate, high, and critical. This approach distinguishes them based on their strength and dominance of membership degrees instead of treating risks with similar Relative Importance Index (RII) scores equally. Under crisp statistical measures, risks can be differentiated based on their decision urgency and management priority.

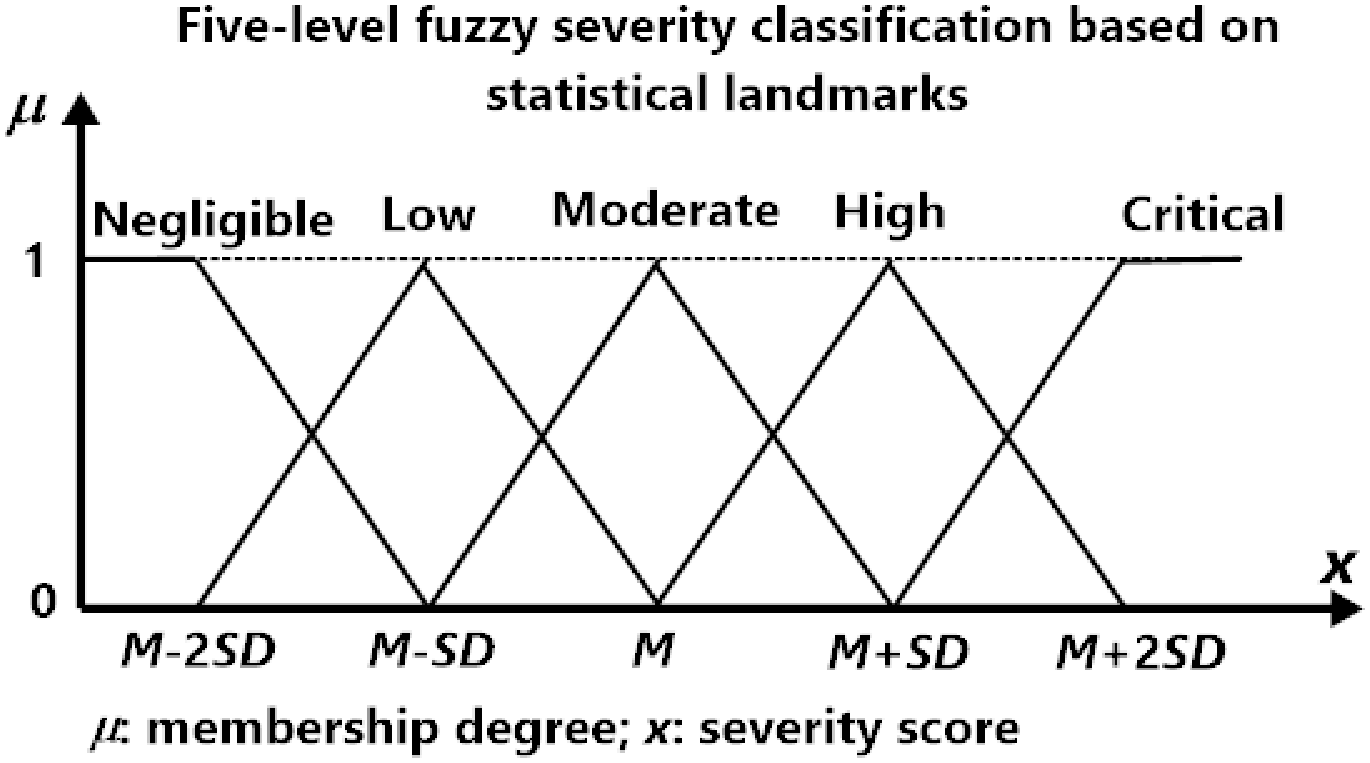

A five-level fuzzy risk severity classification was developed using statistical landmarks, with triangular membership functions centered around the sample mean and its standard deviation. These membership functions form a symmetric fuzzy partition of severity levels, ranging from negligible to critical. Figure 2 illustrates the proposed fuzzy severity classification framework.
Linguistic truth levels are determined using a hierarchical decision mechanism, as described in Equation (3). The associated membership functions are evaluated sequentially from the strongest linguistic hedge (‘very true’) to ‘not true’, and the first satisfied condition determines the assigned linguistic truth level.
i f   μ 2 0.75 ,   V e r y   t r u e E l s e   i f   μ 0.50 , T r u e E l s e   i f   μ 0.5 0.25 , F a i r l y   t r u e E l s e , N o t   t r u e
Although conventional descriptive statistics and RII rankings are effective for identifying and ordering inflation-related risks, they provide limited insight into severity dominance and decision relevance under uncertainty. The fuzzy truth qualification framework does not modify the ranking hierarchy produced by RII analysis, but rather it introduces an additional analytical layer that characterizes the degree of severity associated with each risk. Gradual reasoning provides a more realistic basis for adaptive risk management than threshold-based approaches in prolonged inflationary environments where costs are volatile and forecasting precision is limited.
The fuzzy framework adds value by identifying crisis-level risks more effectively because it uses dominant severity memberships rather than an arbitrary threshold, and it treats inflation-related risks as continuous phenomena rather than discrete events. This approach enhances interpretability and supports decision-making, particularly in contexts where quantitative forecasts are uncertain and qualitative judgments are required.

2.6. Frequency Index (FI)

Survey data can be summarized using a frequency index (Equation (4)) by expressing how often each response occurs in relation to the total number of responses. A frequency index converts raw counts into a relative measure, often expressed as a proportion or percentage, which helps standardize comparisons. The most common opinions or trends in survey data are often highlighted in this way.
F I i = n i N , o r   F I i ( % ) = 100 n i N ,
where FIi is the frequency index of category i, yielding a value between 0 and 1, or 0% and 100%, ni is the number of respondents choosing category i, and N is the total number of respondents or total responses, in this case N indicates the total number of respondents.

2.7. Relative Importance Index (RII)

A relative or normalized score index, sometimes called a relative importance index (Equation (5)), is often used for comparing responses across items. It converts multiple items into a 0–1 or 0–100% value that can be compared easily. It is useful if Likert items have different numbers of response options, and is often used in construction, project management, and social science surveys to rank importance or impact.
R I I = 1 5 N i = 1 5 a i n i , o r   R I I % = 100 5 N i = 1 5 a i n i ,
where RII is the relative important index or normalized score index, yielding a value between 0 and 1, or 0% and 100%, ai is a numeric value of Likert category i (e.g., for a 5-point scale, i = 1, …, 5), ni is the number of responses in category i, and N is the total number of respondents.

2.8. Validity and Reliability Assessment

A researcher’s data collection and analysis are evaluated for reliability and validity [26]. Validity and reliability are the two validation strategies widely used in measuring instrument evaluation. Validity describes how well measures define the concept, while reliability describes how consistent the measures are. Most widely accepted forms of construct validation involve assessing measures for convergent validity, discriminant validity, and nomological validity [27,28], and one form of construct validity is content or face validity [28]. The Coefficient (Cronbach’s) Alpha is probably the most commonly used reliability measurement [28,29].

2.9. Content Validity

Content validity assessment involves applying both development and judgment processes to determine whether an item represents or is relevant to content. Using this two-stage process to determine and qualify content validity is fundamental to instrument validation [30]. Researchers usually evaluate content validity qualitatively, through an expert committee assessment, and then quantitatively, using the content validity index [31]. The questionnaire’s content in this study was determined through a literature review, then discussed and finalized with industry practitioners and academic experts to ensure its validity. However, even if content validity is a fundamental requirement of all assessment instruments, measures cannot be validated solely based on content validity [32].

2.10. Reliability

Even when validity is assured, the researcher must still consider the reliability of the measurements. Reliability refers to a measure’s consistency. Generally, more reliable measures are more consistent than less reliable measures [28]. Cronbach [33] introduced Coefficient Alpha (Cronbach’s α) to measure internal consistency reliability, and it has become the most commonly used measure [28]. A general formula used in the study by Cronbach [33] was as follows (Equation (6)).
α = n n 1   1 i V i V t ,
where n is the number of items (in this case, k is used to indicate the number of items instead of n), i represents an item, Vi is the variance of item scores after weighting, and Vt is the variance of test scores. It is generally accepted that Cronbach’s alpha should not be lower than 0.70 [34].

3. Results

This section presents the empirical results of the questionnaire survey on the perceived impacts of the recent five-year inflation on residential construction projects, including material prices, labor wages, cost and time performance, and mitigation strategies adopted by practitioners. Descriptive statistics are presented first to summarize the profile of respondents and their organizations, then results are discussed in detail, including inflation perceptions, project impacts, and risk management practices.

3.1. Questionnaire Reliability Analysis

A reliability analysis was conducted to evaluate the internal consistency of the Likert-scale items across eight thematic categories. The Cronbach’s alpha values in Table 1 ranged from 0.71 to 0.99, indicating that the study was generally reliable. Categories (a) to (f), which assessed the price impact, consequences, and drivers of inflation, all achieved alpha values between 0.95 and 0.97, demonstrating excellent internal consistency. This category, which encompassed a wider set of inflation-related items, had an alpha of 0.71, which indicates acceptable reliability. Lastly, the overall reliability of all the 57 items in category (h) was highly reliable, with a Cronbach’s alpha of 0.99. These results confirm that the questionnaire exhibits strong internal consistency across its measurement dimensions.

3.2. Profile of Respondents

Participants in the survey represented a broad cross-section of stakeholders involved in residential construction projects, reflecting perspectives from both the supply side, such as contractors, technical staff, and laborers and the demand side, such as clients, project developers, and regulators. The sample is dominated by practitioners in their early careers and mid-careers, while retaining a significant portion of highly experienced professionals. Respondents reported primarily working on low-rise and medium-rise building projects. The majority of respondents were employed in small businesses, followed by medium-sized companies and large companies, reflecting the prevalence of small and medium-sized businesses in the residential sector. Most respondents are actively engaged in multiple ongoing projects and are well-positioned to assess inflation’s impacts. The majority of respondents were employed in small businesses, followed by medium-sized companies and large companies, reflecting the prevalence of small and medium-sized businesses in the residential sector. Respondents are actively engaged in ongoing projects and are well-positioned to assess inflation’s impacts on residential construction projects. Detailed data are presented in Table 2.

3.3. Overall Perceived Impact of Inflation

Statistical analysis indicates that inflation over the past five years has had a substantial impact on residential construction, with a predominant perception ranging between very high and moderate impacts (‘very high’ = 21%, ‘high’ = 35%, and ‘moderate’ = 0.25).

3.4. Most Affected Cost Categories and Components

Inflation has the greatest impact on direct construction expenses, especially those involving materials and resources. Inflation is perceived to have the greatest impact on building materials costs, as evidenced by the highest mean score and RII. The relatively high variance and SD indicate a notable dispersion of opinions, reflecting differing project types or market exposures. Machine operation and energy-related costs are sensitive to inflation, as evidenced by the second-place ranking for equipment rental and fuel. As a result of escalating fuel prices and supply chain disruptions, logistics and transportation ranked third. Figure 3 illustrates this sensitivity of cost structures, reinforcing the dominance of material and energy. On the other hand, although labor costs are affected by inflation, they are perceived as less sensitive than material and equipment costs. Consultancy/professional fees and permit and compliance costs rank fifth and sixth, respectively. According to their lower RII scores and mean values, these costs are less affected by inflation than other costs.

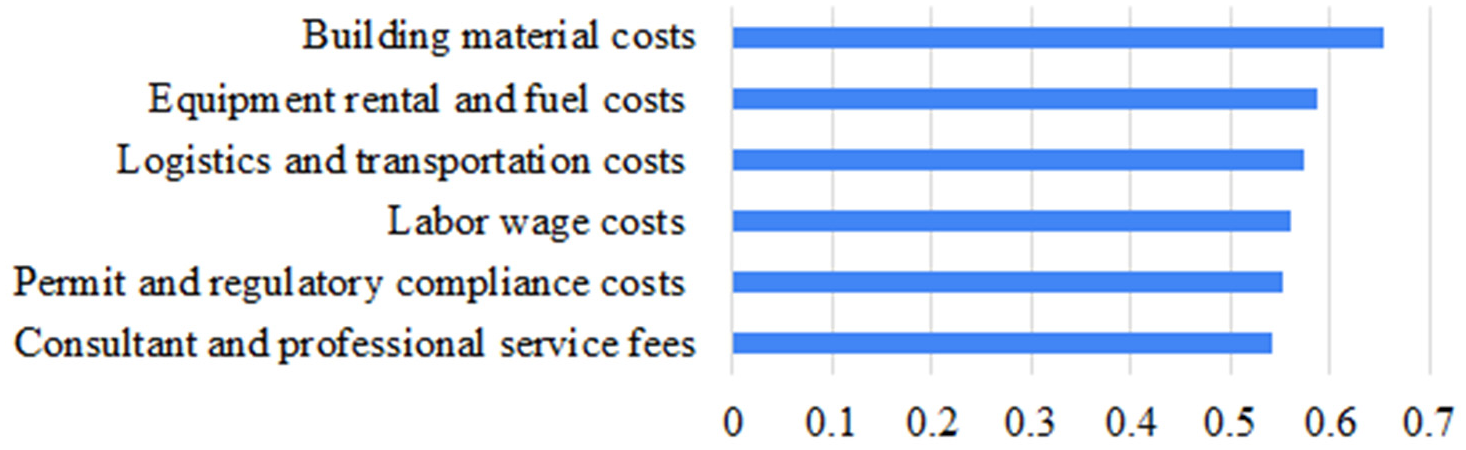

A comprehensive statistical summary of inflation-affected cost categories is presented in Appendix A, Table A1.

3.5. Inflation-Related Consequences Affecting Residential Projects

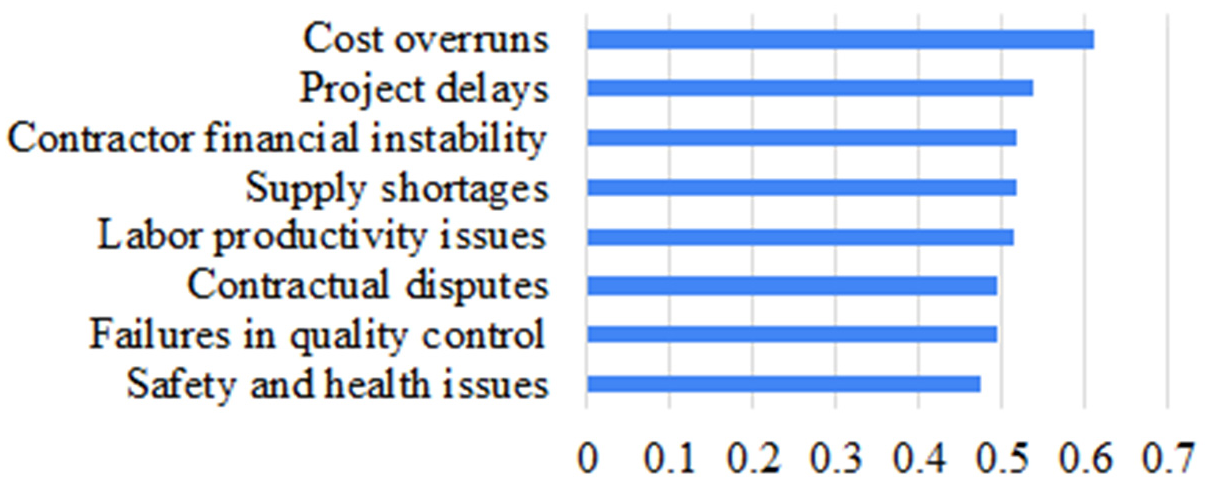

Figure 4 indicates that financial and schedule-related impacts dominate quality-, safety-, and dispute-related consequences. Price increases directly translate into project budgets exceeding initial estimates, causing cost overruns to be the most significant inflation-induced consequence. Elevated costs and increased uncertainty regarding resource availability are also associated with substantial schedule disruptions. As a result of persistent inflation, contractors’ cash flow and profitability are threatened, potentially posing a threat to the continuity of their projects.
Inflation has also an indirect effect on supply chains and construction progress. The workforce is also affected by inflation, though to a lesser extent than material- and finance-related factors. Contractual, organizational, and quality consequences are perceived to be moderately significant. There is no primary inflationary effect in these outcomes; they are rather adaptive or reactive responses to rising costs. Inflation-related quality control failures and suspended or canceled projects indicate that while serious, these consequences are less frequent.
On-site theft, damage, or loss of materials, and safety and health issues rank lowest in the RII and mean, suggesting respondents perceive these impacts as relatively minor. These findings emphasize the need for robust cost control, contingency planning, and financial risk management strategies to mitigate inflation-related risks in residential construction.
Table A2 provides a quantitative overview of the perceived consequences of inflation on residential construction projects.

3.6. Budget Impacts and Budgeting Practices

The findings indicate that inflation plays a decisive role in budget escalation in residential construction projects. Respondents demonstrated a high level of confidence in evaluating inflation’s budgetary implications. Notably, inflation alone accounts for approximately one-quarter to one-third of total budget increases in a substantial share of projects, as reflected by the highest frequency index (FI = 35.61%). In addition, a considerable proportion of projects experienced budget overruns in the range of 11–20% (FI = 28.41%), underscoring the significant contribution of inflation to overall cost growth. Although less prevalent, a noteworthy number of projects were subjected to severe cost escalation exceeding 30% (FI = 21.97%), highlighting the pronounced impact of inflationary pressures on residential construction budgets.

3.7. Material Price Escalation and Its Drivers

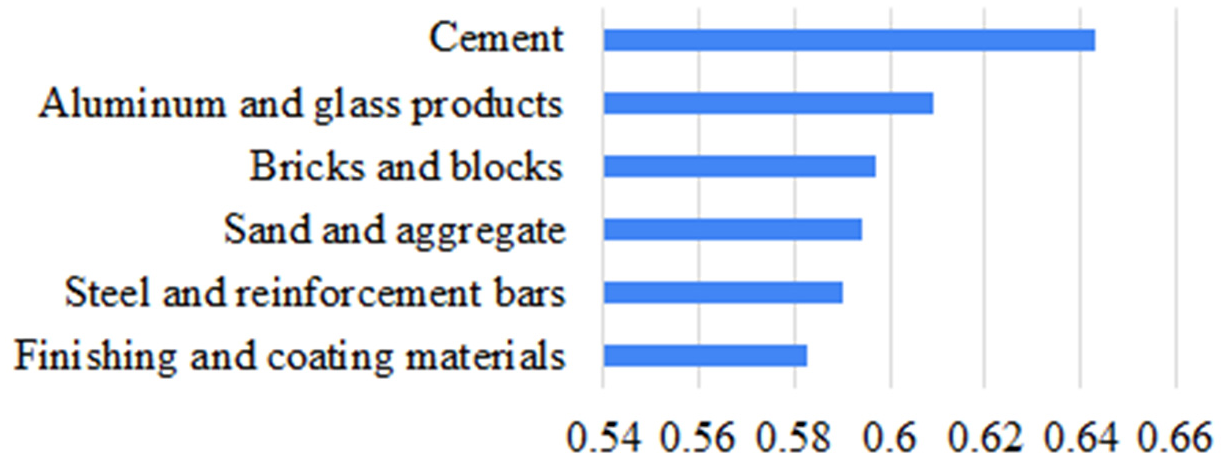

Figure 5 indicates that core structural materials—most notably cement—together with aluminum and glass products are perceived as the most affected by price increases, reflecting pervasive inflationary pressures within the construction industry. This finding underscores the critical role of cement in construction activities and its pronounced sensitivity to inflation, energy costs, and supply–demand imbalances. Similarly, aluminum and glass products exhibit substantial price escalations, particularly for materials used in façades, windows, and finishing applications, which are strongly influenced by global market conditions and energy-intensive production processes. In contrast, steel and reinforcement bars demonstrate moderate to high inflationary effects, largely attributed to volatility in global steel markets.
Collectively, these findings emphasize the importance of targeted cost control and strategic procurement measures focused on high-impact material categories to effectively manage inflation risks in residential construction projects.
Table A3 reports the quantitative ranking of major material categories affected by price increases.

3.8. Factors Contributing to Material Price Increases

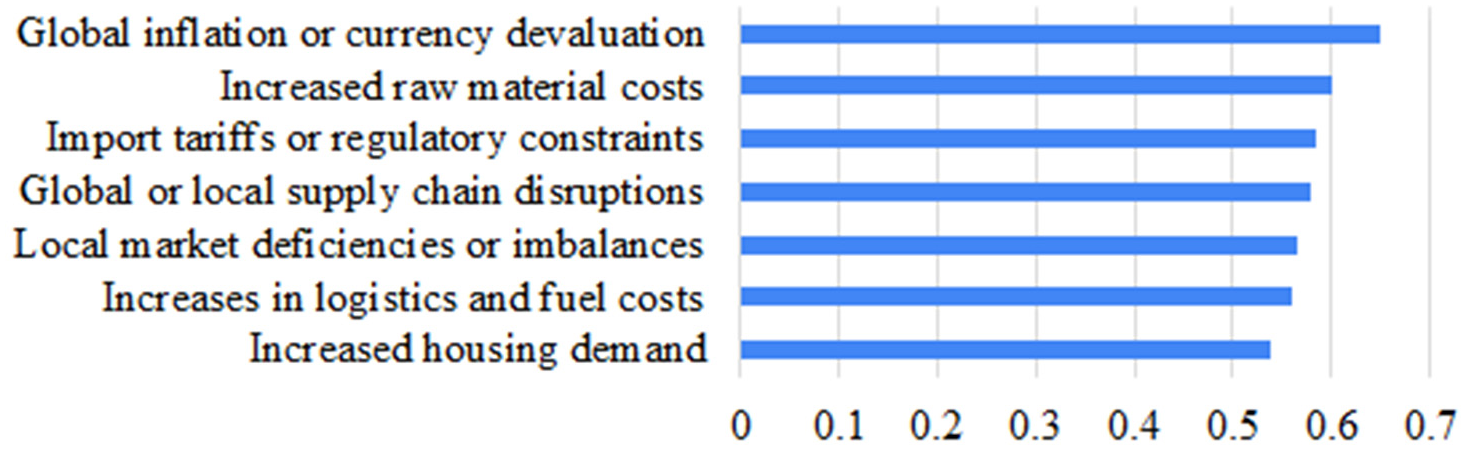

The RII-based ranking of key drivers of material price inflation in residential construction is shown in Figure 6, which provides further information on perceived drivers of material price inflation in residential construction. Respondents overwhelmingly perceive broader economic conditions and global inflationary trends as the most influential contributors to rising material prices, followed by rising raw material costs and trade-related factors. Regulatory constraints and trade policies play a significant role in driving up material costs, particularly for imported construction materials. Global or local supply chain disruptions reflect ongoing logistical bottlenecks that affect product availability and pricing. The domestic market also contributes to price increases, though to a lesser extent than the broader economy. According to the findings, increasing transportation and energy costs have a moderate impact on material prices. Housing demand-side pressures are seen as less significant than macroeconomic, supply-side, and regulatory factors. These findings emphasize that developing mitigation strategies for inflation-induced price escalation requires construction stakeholders to account for external economic volatility and supply chain risks.
Statistical analysis of key factors influencing material price inflation in residential construction can be found in Table A4.

3.9. Issues About Rising Material Costs

The most common challenges encountered by residential construction projects are in response to rising building material costs. The listed challenges reflect financial, operational, contractual, and client-related difficulties that emerge when material prices increase. It was found that payment disputes with clients and reduced profit margins were among the most critical challenges with FI = 40% and FI = 36%, respectively. It indicates that contractors’ financial stability and ability to fulfill contractual obligations are greatly affected by escalating material prices.
Operational challenges are also highly evident. It is difficult to secure suppliers (FI = 33%), and procurement delays (FI = 29%) complicate purchasing decisions and scheduling when inflationary conditions prevail. The resulting budget overruns (FI = 31%) further exacerbate financial risks and undermine the feasibility of projects.
Furthermore, project redesign or scope reduction (FI = 22%) emerged as a notable response to rising material costs, suggesting that project teams often resort to value engineering or design modifications to contain escalating expenses. Such adjustments, however, may negatively affect the quality or functionality of the project.
From a client perspective, client dissatisfaction (FI = 20%) and project abandonment (FI = 20%) indicate that sustained material price increases have broader effects on stakeholder relationships. These outcomes reflect the cumulative effect of cost overruns, delays, and compromised project scope.
Consequently, rising material costs present a number of challenges, including financial strain, supply chain disruptions, and client-related issues.

3.10. Labor Wage Inflation and Its Drivers

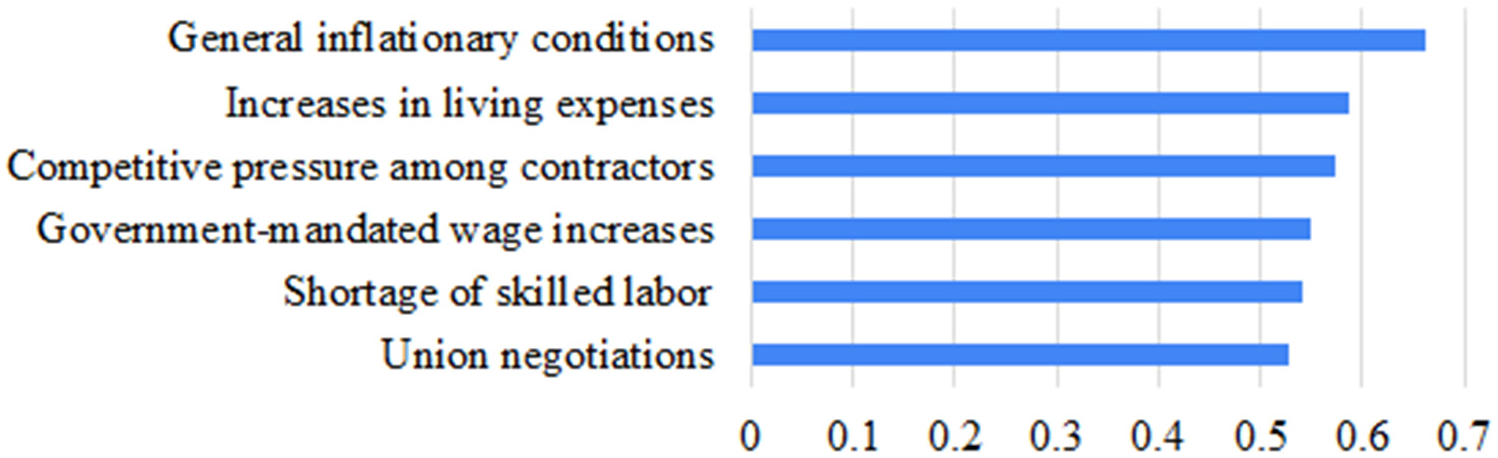

Figure 7 presents respondents’ perceptions of the key factors contributing to labor wage increases in construction projects. It appears that macroeconomic conditions and cost-of-living pressures are the primary drivers of wage increases, with market competition and policy-driven wage adjustments playing secondary roles. Strong consensus among respondents indicates that general inflationary trends directly translate into higher wage demands and labor costs in the construction sector. As living expenses rise, workers are forced to seek higher wages to maintain purchasing power. It appears that competition among contractors for available labor contributes to upward pressure on wages. Government-mandated wage increases suggest that regulatory interventions play a moderate but notable role in shaping wage levels. Additionally, shortages of skilled workers contribute to wage escalation to a lesser extent than broader economic and regulatory factors. The influence of union negotiations on wage increases is perceived as having the least impact.
Table A5 contains a statistical analysis of the main reasons for labor wage increases.

3.11. Consequences of Rising Labor Wages on Project Performance

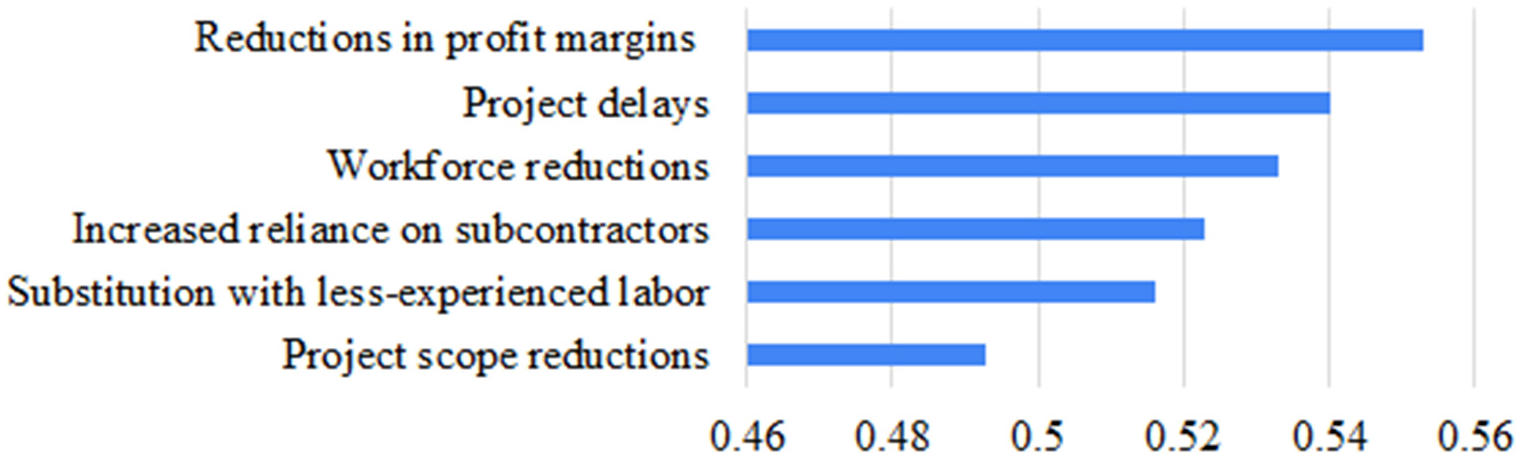

Figure 8 indicates that financial and schedule-related impacts are the most prominent consequences of rising labor wages, although the overall mean scores suggest moderate significance levels. Increasing labor wages primarily affects project profitability, confirming that labor cost escalation directly erodes contractors’ margins. High labor costs can also disrupt project schedules, possibly due to workforce adjustments or cost-related decision-making delays. Modifying labor allocation, such as resizing crews or changing labor intensity are common responses to wage increases by contractors. The increased use of subcontractors reflects the trend toward outsourcing certain activities as a cost-management strategy. By substituting less experienced workers for skilled ones, labor costs could be contained, but quality and productivity may suffer. Scope reduction, although still relevant, is perceived as having the lowest impact on labor wage increases.
A detailed statistical analysis of the impacts of rising labor wages on project performance can be found in Table A6.

3.12. Client Reactions to Wage-Related Cost Increases

A further study examined how clients react to wage-related cost increases, indicating that rising labor wages frequently result in disputes and project delays or cancelations, rather than cooperative responses such as budget acceptance or redesign. Respondents to wage-related cost escalation exhibit a variety of contractual, managerial, and behavioral reactions. Around half of respondents reported that wage-driven cost escalation often leads to disagreements between clients and contractors regarding payment responsibilities, contract adjustments, or claims. It is likely (FI = 39%) that budget constraints or increased financial uncertainty are leading some clients to postpone project initiation or suspend ongoing work due to higher labor costs. A significant proportion of respondents (FI = 23%) also reported no significant reaction, indicating that some clients are either financially resilient or contractually prepared to accept wage-related costs without major changes to the project. Additionally, some respondents (FI = 22%) requested a redesign of the project in an attempt to reduce labor costs through scope modification or value engineering measures, while 15% accepted revised budgets, a more cooperative response in which clients acknowledge and accommodate the increase. A relatively small percentage of respondents (FI = 14%) were uncertain about how wage-related cost increases would affect clients’ behavior.

3.13. Impact of Rising Labor Wages on Project Budgets

Labor wage increases commonly lead to moderate to severe budget escalations in construction projects, with the majority of projects experiencing cost increases exceeding 10%. About 39% of projects have experienced labor wage increases, resulting in an 11–20% increase in budget over the initial estimate. In almost half (46.22%) of the projects, budget overruns exceeded 20%, demonstrating the severity of labor cost inflation. Only a minority of respondents (7.20%) reported that labor wage increases did not affect their project budgets. This finding highlights the importance of incorporating wage inflation allowances and labor cost risk management strategies into the project budgeting and cost planning processes.

3.14. Inflation-Related Project Delays

The findings indicate that schedule delays are prevalent in residential construction projects, although their severity and frequency vary. The majority of respondents (approximately 65%) reported that schedule delays occurred from sometimes or often, whereas a smaller proportion, nearly 8%, reported that their projects were always delayed. In contrast, only about 7% indicated that schedule delays never occurred.
Survey respondents were asked to estimate the percentage increase in contract duration attributed to labor wage fluctuations. The results indicated that approximately 83% of contracts experienced schedule delays associated with labor wage–related factors. Among these, about 7% reported minor duration extensions of less than 10%, while 5% reported severe extensions exceeding 100%. In contrast, 17% of respondents indicated no schedule delay.
Schedule delays associated with material price fluctuations show a broadly similar pattern. The results indicated that approximately 77% of contracts experienced project delays caused by material price fluctuations. Among these, about 6% reported minor duration extensions of less than 10%, while 3% reported severe extensions exceeding 100%. In contrast, 23% of respondents indicated no schedule delay.
Schedule delays are common in residential construction, with cost-related factors amplifying their occurrence. Labor wage fluctuations have the strongest impact, affecting approximately 83% of projects, followed by material price fluctuations at 77%. In contrast, almost 65% of projects experience general delays from sometimes or often. Severe delays are relatively rare, while a notable share of projects, particularly those affected by material price fluctuations, experience no delay, indicating variability in cost sensitivity and project management effectiveness.

3.15. Mitigation Measures and Their Perceived Effectiveness

Practitioners adopt a range of budget management strategies to mitigate inflationary pressures. Early procurement and bulk purchasing were reported by 34% of respondents, reflecting a proactive approach to securing materials before further price escalation. An equivalent proportion indicated the use of alternative or locally sourced materials and the regular forecasting and review of project budgets. In addition, 31% explicitly incorporated inflation allowances into their cost estimates. These reports suggest that many organizations attempt to anticipate inflationary effects and update their financial plans as revised price information becomes available. Nearly one-third of respondents employed re-measurable or cost-plus contract arrangements to partially transfer inflation risk between clients and contractors. Schedule adjustments (25%) and cost-driven redesign measures (20%) were less frequently applied, whereas contract renegotiation was relatively uncommon (12%). In general, the findings indicate that practitioners predominantly rely on procurement-based and financial planning strategies, complemented by contractual and design interventions, to manage inflation-induced budget uncertainty.
Practitioners have adopted a range of labor management strategies in response to rising wage levels. Labor-saving techniques and labor contract renegotiation were the most frequently reported measures (36%), reflecting efforts to reduce on-site labor intensity and manage wage escalation. The use of prefabricated components and multi-skilled workers was reported by 28% of respondents, indicating a shift toward improved workforce efficiency and flexibility. Workforce scheduling optimization (25%) and client-side cost-sharing arrangements (20%) were applied less frequently to mitigate labor cost pressures.
Respondents also assessed the effectiveness of their inflation mitigation strategies. Overall, 70% rated these measures as moderately to very highly effective, while 17% perceived them as only slightly beneficial. These results indicate that most practitioners consider inflation management strategies to provide measurable benefits, although a notable proportion views their impact as limited. Approximately one-third regard the measures as highly or very highly effective at mitigating inflation-related cost and schedule pressures.

3.16. Key Cost Components and Inflation Perceptions

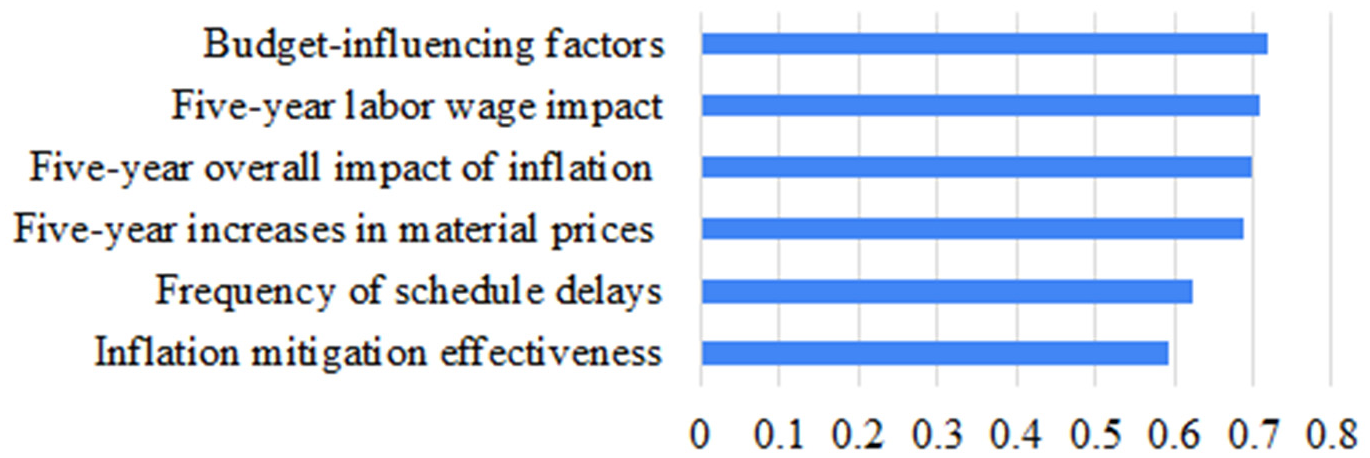

A consolidated view of respondents’ perceptions of inflation impacts on key cost components, project budgets, schedule performance, and mitigation measures can be found in Figure 9. It appears that inflation exerts a strong influence on project budgets, particularly through direct cost escalation. Inflation-related factors are widely perceived to increase residential project budgets, reflecting a strong consensus on inflation’s budgetary impact. A five-year inflation impact on labor wages and an overall five-year inflation impact on residential construction were both rated as highly significant, illustrating labor cost escalation as a major inflationary pressure. Materials prices have also risen over the past five years, affecting project budgets. Unfortunately, the effectiveness of inflation mitigation strategies received the lowest ranking, implying that although mitigation measures are in place, their perceived effectiveness in offsetting inflation-induced cost and time pressures remains limited.
Schedule-related impacts, on the other hand, were perceived as less severe. Schedule delays caused by labor and material price fluctuations were less frequent than those caused by inflation, suggesting inflation primarily affects cost performance rather than time performance. There is limited consensus regarding a direct correlation between inflation and project delays triggered by fluctuations in material prices or labor wages, with more “no idea” responses and larger variances in these responses.
The findings clearly demonstrated a clear hierarchy of inflation impacts, with budget escalation, driven mainly by labor and material cost increases, perceived as the most critical issue, while schedule impacts and the effectiveness of mitigation measures are viewed as secondary and more uncertain. This pattern reinforces the dominance of cost-related inflation risks in residential construction projects.
Detailed statistics can be found in Table A7.

3.17. Analyzing Critical Outliers and Severity Differentiation

Figure 10 presents the distribution, central tendency, and dispersion of mean scores for individual Likert-scale items across the questionnaire. Statistical outliers are observations that deviate substantially from the majority of data in a survey-based analysis, whereas values within the distribution but showing substantially higher or lower means reflect differences in perceived severity rather than statistical anomalies [35,36].
Outliers are items whose mean values exceed the upper or lower bounds of ‘M ± 2SD’ (or, more conservatively, ‘M ± 3SD’) [37]. Consistent with standard statistical conventions, this study defines statistical outliers as items whose mean values exceed the upper or lower bounds of ‘M ± 2SD’. Such values represent extreme departures from the central tendency and may indicate atypical or crisis-level conditions rather than normal variation in respondent perceptions.
In contrast, items with mean values falling between ‘M ± SD’ and ‘M ± 2SD’ are not treated as statistical outliers. They are instead interpreted as items with high- or low-severity items, reflecting perceptions significantly stronger or weaker than the dataset average while still within the expected range of variation. It is especially important for Likert-scale data, which capture subjective judgments rather than sharp statistical discontinuities.
Accordingly, items with mean values above ‘M + SD’ are considered high-severity issues, indicating that respondents perceive these factors as significantly more serious than the average issue. It is therefore important to prioritize these items in inflation management strategies. Items exceeding ‘M + 2SD’ are classified as extreme statistical outliers, suggesting exceptional conditions that may reflect systemic or crisis-level impacts rather than routine inflationary effects.
Conversely, items with mean values below ‘MSD’ are interpreted as low-severity issues, indicating that respondents generally do not see inflation as a major threat. These items are considered a lower priority in inflation mitigation efforts. Items in the present dataset do not fall below ‘M − 2SD’, indicating that the responses are neither extremely low nor statistically anomalous.
This severity-based interpretation directly informs the Fuzzy Severity Classification Framework (Figure 2), which models graduated transitions in perceived impact rather than detecting statistical outliers. This framework relies on empirical thresholds derived from item means distributions.
For this survey, Table 3 includes short descriptions of Likert scale items. Figure 2 illustrates the distribution, central tendency, and dispersion of mean scores for individual Likert-scale items across the questionnaire. The following items are all above the ‘M + SD’: ‘(8) Five-year overall inflation impacts’, ‘(9_1) Building materials’, ‘(14_1) Cement’, ‘(15_1) Currency devaluation or global inflation’, ‘(17) Five-year inflation-related material price increases’, ‘(18) Impact of rising material prices on project budgets’, ‘(19_1) General inflation’, and ‘(23) Impact of rising labor wages on project budgets’. These issues should be treated as urgent, pressing, and dominating issues because they are considered much more severe than the average issues in the dataset. There are, however, two extreme outliers above ‘M + 2SD’: the items ‘(11) Inflation-related factors causing budget increases’ and ‘(22) Five-year inflation impact on labor wages’. It appears that these points are more indicative of a systemic crisis than of normal fluctuations.
On the other hand, ‘(10_3) Suspended or canceled projects’, ‘(10_6) Material specification changes’, ‘(10_7) Failures in quality control’, ‘(10_9) Subcontractor failure or performance issues’, ‘(10_10) Contractual disputes’, ‘(10_11) Safety and health issues’, ‘(10_12) On-site theft, damage, or loss of materials’, and ‘(20_2) Reduction of scope’ are all below the ‘MSD’ line, indicating that respondents do not consider these major inflation-related threats as major threats, and they are not priorities in managing inflation. It should, however, be noted that there is no point below ‘M − 2SD’.

3.18. Fuzzy Severity Classification Using Linguistic Hedges

Expert judgments are often expressed with inherent uncertainty and gradation rather than precise numerical values. This characteristic can be addressed through fuzzy logic-based transformations of membership values that use linguistic hedges as truth qualifiers. It preserves the gradual nature of expert evaluations while enabling a more realistic representation of risk severity by identifying dominant and non-dominant severity levels.
To account for the uncertainty and subjectivity inherent in construction management survey responses, a fuzzy logic–based approach was adopted in which linguistic hedges were used as truth qualifiers through power-based transformation of membership values to determine predominant severity levels.
The study uses linguistic hedges as truth qualifiers by applying power-based operators to fuzzy membership values. The power-based linguistic hedge operators are applied to membership values and interpreted as truth qualifiers (‘very true’, ‘true’, and ‘fairly true’).
Table 4 summarizes the non-dominant and dominant severity classifications for each item, together with their associated linguistic hedges, as determined using the maximum membership (max − μ) principle applied to the hedge operators μ2, μ, and μ0.5. The complete fuzzy hedge membership values are reported in Table A8.
The interpretation of dominant severity classifications based on Table 4 can be exemplified as follows.
(1)
Item 8’s dominant severity membership is critical, which is ‘very true’.
(2)
Item 9(1)’s non-dominant severity membership is critical, which is ‘fairly true’, whereas the dominant severity membership is high, which is ‘true’.
Similar patterns are observed for the remaining items, where the dominant severity classes are identified by the highest membership values after applying linguistic hedge operators.

4. Discussion and Limitations

During the last five years, Turkish residential construction projects have experienced profound and systemic inflation, primarily due to cost-escalation mechanisms rather than schedule and quality degradation. The findings indicate that inflation-related cost increases, particularly budget escalation and wage inflation, pose the greatest challenge to residential construction. It appears that respondents perceive these factors as crisis-level risks rather than as normal project variability since their mean values are highest and observations exceed the upper variability bounds. Continuous inflation fundamentally undermines the predictability of costs and the reliability of fixed-price estimations under such conditions.
The findings demonstrate that inflation substantially compromises the accuracy of initial cost estimates, as cumulative increases in material prices, labor wages, and indirect costs generate significant deviations over the project lifecycle. The limited integration of inflation-adjusted cost estimation into standard financial planning frameworks exacerbates exposure to budget overruns and financial instability. This observation is consistent with prior studies highlighting the vulnerability of fixed-price construction contracts under prolonged inflationary conditions, particularly when cost escalation is driven by macroeconomic rather than project-level factors [12,38].
Material price volatility emerged as the most influential contributor to inflation-related risk, with cement, aluminum, and glass products identified as the most affected material categories. Participants consistently attribute these increases to macroeconomic and global supply-chain forces, including currency devaluation, global inflation, and rising raw material costs, rather than project-level inefficiencies. The high concentration reinforces the characterization of material price volatility as a structural and systemic condition affecting the residential construction sector as a whole. These effects are exacerbated by energy-intensive production processes, imported inputs, and international market fluctuations. Similar impacts have been observed in other construction domains facing inflationary and supply-chain disruptions, including transportation infrastructure projects [11,39,40,41].
Contract design and risk allocation are directly affected by the findings in this context. According to research [42] from the highway construction sector, price adjustment clauses (PACs) can be more effective when used within construction contracts to manage material price volatility, demonstrating that the vast majority of U.S. state transportation agencies use PACs to mitigate material price uncertainty, particularly for fuel, asphalt, steel, and cement. Owners and contractors can apply these mechanisms to reduce the speculative risks embedded in bids, improve price transparency, and allocate inflation risks more equitably. Residential construction projects differ in scale and institutional structure, but similar inflation dynamics identified in this study can enhance cost resilience and reduce adversarial risk transfer in residential procurement contexts.
The second major inflationary pressure identified in this study is wage inflation, driven primarily by general inflation and rising living costs. Due to their continual and cumulative impact on contractor cash flow throughout project execution, labor-related risks rank among the most severe impacts. Contrary to material costs, which can be partially mitigated through early procurement or supplier diversification, wage inflation continues throughout the entire construction process. It appears that contractors respond by reducing profit margins, restructuring labor deployment, and relying more on subcontractors rather than by suspending projects or significantly compromising quality. Although these adaptive strategies may preserve short-term project continuity, they also pose long-term risks relating to workforce stability, productivity, and skill retention [13,43]. It appears that labor cost indexing or hybrid contracting approaches, such as limited costs-plus components for labor-intensive activities, are complementary tools to material-based price adjustments.
By contrast, schedule delays, quality failures, contractual disputes, and safety-related issues are perceived as secondary inflation-induced consequences. Although delays linked to labor wage and material price fluctuations are reported, their lower mean values and higher dispersion suggest variability driven by project-specific sensitivity and managerial effectiveness. These results indicate that inflation primarily manifests as financial pressure, while time and quality impacts remain contingent on mitigation capacity and operational control [44].
Although various mitigation measures, such as early procurement, alternative material selection, inflation contingencies, flexible contracting arrangements, and labor-saving technologies, are reportedly employed, their perceived effectiveness remains limited. Although various mitigation measures, such as early procurement, alternative material selection, inflation contingencies, flexible contracting arrangements, and labor-saving technologies, are reportedly employed, their perceived effectiveness remains limited. Under prolonged and volatile inflationary conditions, these measures tend to provide short-term relief but are insufficient. It is evident from the findings that there is no integrated and systematic framework for managing inflation risk in the residential construction sector. In the construction sector, more robust strategies such as dynamic cost indexing, inflation-adjusted contracts, and proactive labor market planning can reduce uncertainty, discourage speculative pricing, and improve financial sustainability [39,40,45].
Methodologically, graded linguistic reasoning within a fuzzy decision support framework enables inflation-related risks to be evaluated as continuous and severity-dependent phenomena rather than binary or threshold events. Using power-based linguistic hedges as truth qualifiers, the proposed approach supports prioritization under uncertainty and reveals not only which risks are critical, but also how severe they are. Considering inflationary environments to be inherently volatile and ambiguous, rigid classification schemes may not be sufficient to make effective decisions.
There is no doubt that inflation has fundamentally altered the risk profile of residential construction projects in Türkiye. Material price volatility and labor wage inflation dominate cost escalation dynamics, while schedule and quality impacts remain secondary and context-dependent. The limited perceived effectiveness of existing mitigation measures underlines the need for more robust, strategic, and inflation-responsive project management approaches. Under prolonged inflationary conditions, residential construction projects will remain highly vulnerable unless advanced cost forecasting, inflation-sensitive contracting, and structured labor management strategies are integrated, resulting in significant implications for contractor sustainability and affordability [12,39,46].
Inflation-related risks are not uniformly vulnerable across stakeholders; however, the observations presented in this study reflect perceptions rather than statistically validated differences. It appears that organizational size, professional role, and experience influence perceptions of material price volatility and wage increase, but no inferential subgroup analysis (e.g., ANOVA, Chi-square, or non-parametric equivalents) was conducted to confirm statistically significant differences between organizational categories. Therefore, the findings should be considered descriptive rather than causal or predictive.
However, the study also has several limitations. The findings may be influenced by recall bias and recency effects inherent in retrospective inflation assessments, as well as anchoring effects arising from recent conditions of extreme inflation. In addition, perception-based evaluations may vary due to heterogeneity among respondents in terms of firm size, professional role, and experience. Accordingly, this study aims to capture perceived inflation-related risks rather than quantify objective cost magnitudes, and the findings should be interpreted within this perceptual and contextual framework. Research in the future should include inferential subgroup analysis designed a priori to formally evaluate stakeholder heterogeneity and validate perceived differences.

5. Conclusions

This study provides a comprehensive assessment of inflation-related risks in residential construction projects in Türkiye during a period of sustained economic volatility. An integrated approach to interpreting inflation-related risks under uncertainty using fuzzy severity classification and linguistic hedges is flexible and provides a decision-support structure. The graded linguistic approach supports more realistic risk prioritization in ambiguous and volatile environments.
The findings clearly demonstrate that inflation has emerged as a dominant and systemic risk, fundamentally reshaping the cost structure and financial stability of residential construction projects. The main impact of inflation on projects is cost escalations rather than schedule delays or construction quality degradations. Material price volatility and labor wage inflation are identified as the most critical drivers of budget overruns. Both exhibit extreme outlier behavior that reflects crisis-level severity rather than routine project uncertainties. In particular, cement, aluminum, and glass products are highly sensitive to macroeconomic factors, including currency depreciation, global inflationary pressures, and disruptions in supply chains. The persistent financial burden associated with labor wage inflation erodes contractor profitability throughout the project lifecycle and influences workforce restructuring decisions. Even though such adaptive responses may improve short-term financial resilience, they also present long-term risks related to productivity, workforce stability, and skill retention.
Inflation-induced impacts on schedules, quality performance, contractual disputes, and safety outcomes are perceived as secondary and context-dependent. Although labor and material cost fluctuations can contribute to project delays, their severity varies across projects. This suggests that managerial capability and operational flexibility play a moderating role. Overall, inflation is perceived primarily as a financial risk, while time and quality impacts can be partially mitigated through effective project management practices.
Despite the widespread adoption of mitigation measures, such as early procurement, alternative materials, inflation allowances, flexible contracts, and labor-saving techniques, their perceived effectiveness remains limited in periods of prolonged inflation. Such measures are predominantly tactical and short-term, indicating the absence of comprehensive and systematic frameworks for managing inflation-related risks in residential construction practice. These mitigation measures are constrained by structural and stakeholder-specific factors under prolonged inflationary conditions. The majority of commonly adopted strategies rely on short-term flexibility and assume relatively stable contractual and financial environments; however, in Türkiye these assumptions are undermined by persistent exchange-rate volatility, rapid cost pass-through, and rigid contract structures. Moreover, vulnerability to inflation-related risks is not uniform across stakeholders. Smaller firms with limited financial buffers are perceived to be more susceptible to material price shocks and wage escalations, whereas larger firms may absorb short-term volatility but remain vulnerable to cumulative cost pressures and margin erosion over longer project cycles. Consequently, organizational size, professional role, and experience, as reflected in the respondent profiles (Table 2), shape both the perceived effectiveness of mitigation measures and adaptive capacity, underscoring the need for a differentiated and scale-sensitive approach to inflation risk management.
This study shows that inflation-related risks in residential construction are mostly financial in nature and are best understood as continuous and severity-driven phenomena rather than discrete events. The proposed approach improves interpretability under uncertainty and supports more informed decision-making in prolonged inflationary environments by integrating conventional ranking methods with fuzzy truth qualification frameworks. Furthermore, the findings highlight the importance of inflation-sensitive contracting mechanisms and proactive labor market planning in enhancing sector resilience. Unless such strategies are implemented, residential construction projects will remain highly vulnerable, which will negatively impact contractor sustainability and housing affordability in the long run. Importantly, this study goes beyond acknowledging inflation-driven cost increases by identifying the predominant inflation drivers under extreme market volatility. The results demonstrate that currency-sensitive materials and labor wage escalation consistently dominate project financial performance under sustained inflationary conditions, while several commonly cited project risks become secondary. This severity-based insight enables more effective risk prioritization in highly volatile construction markets such as Türkiye.
Several factors contributed to the study’s limitations. The reliance on self-reported perceptions introduces potential respondent bias, sentiment effects, and retrospective interpretations, and the limited focus on residential construction practitioners limits the generalizability of the findings to the infrastructure, industrial, or commercial sectors. Moreover, perception-based assessments may differ depending on the firm size, role, and experience of respondents. Therefore, the study focuses on perceived inflation-related risks rather than objective cost magnitudes, and its conclusions should be interpreted accordingly.

Author Contributions

Conceptualization, B.O. and M.K.; Methodology, B.O. and M.K.; Validation, B.O.; Formal analysis, B.O. and M.K.; Investigation, B.O. and M.K.; Resources, M.K.; Data curation, M.K.; Writing—original draft, B.O. and M.K.; Writing—review & editing, B.O.; Visualization, B.O.; Supervision, B.O. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Institutional Review Board Statement

The study was conducted in accordance with the Declaration of Helsinki, and approved by the Ethics Committee of Zonguldak Bulent Ecevit University’s Human Research Ethics Committee (protocol code 616484 and date of approval 25 June 2025).

Informed Consent Statement

Informed consent was obtained from all subjects involved in the study.

Data Availability Statement

The original contributions presented in this study are included in the article. Further inquiries can be directed to the corresponding author.

Conflicts of Interest

The authors declare no conflict of interest.

Appendix A

Table A1. Most affected cost categories by inflation.
Table A1. Most affected cost categories by inflation.
iItem NamesNo
Idea
Likert ScaleStatisticsRanking
012345NMs2SDRIIR
9(1)Impact of inflation on building material costs8123374523551833.2733.6501.9100.6541
9(3)Impact of inflation on equipment rental and fuel costs3953513138522252.9333.0191.7380.5862
9(4)Impact of inflation on logistics and transportation costs2362504132562412.8762.7521.6590.5753
9(2)Impact of inflation on labor wage costs3088243030622342.8033.2471.8020.5604
9(5)Impact of inflation on permit
and regulatory compliance costs
2361594234452412.7632.5241.5890.5525
9(6)Impact of inflation on consultant
and professional service fees
2164555328432432.7162.4111.5530.5436
1 = not significant, …, 5 = very significant; M: average of the items; s2: variance; SD: standard deviation; RII: relative importance index; R: rank.
Table A2. Inflation-related consequences affecting residential projects.
Table A2. Inflation-related consequences affecting residential projects.
iItem NamesNo
Idea
Likert ScaleStatisticsRanking
012345NMs2SDRIIR
10(01)Cost overruns attributable to inflation7444313334481903.0583.5371.8810.6111
10(02)Project delays associated with inflation3675423042392282.6842.8191.6790.5362
10(08)Contractor financial instability3078503629412342.5942.6441.6260.5183
10(04)Material shortages, delivery delays, or unavailability4465523937272202.5862.5271.5900.5174
10(05)Labor shortages or reduced productivity2982414039332352.5742.5421.5940.5145
10(06)Inflation-driven revisions to material specifications3683453922392282.5132.6511.6280.5026
10(09)Subcontractor performance deficiencies2685483934322382.4962.4161.5540.4997
10(10)Contractual disputes arising from inflation3676563729302282.4782.4251.5570.4958
10(07)Quality control failures under inflationary conditions4085423628332242.4732.6141.6170.4949
10(03)Project suspension or cancelation due to inflation3087444330302342.4532.4031.5500.49010
10(12)Material loss, damage, or theft3793452822392272.4232.6851.6390.48411
10(11)Safety and health issues under inflationary pressures3993403334252252.3692.4451.5630.47312
Table A3. Ranking of the major material categories affected by price increases.
Table A3. Ranking of the major material categories affected by price increases.
iItem NamesNo
Idea
Likert ScaleStatisticsRanking
012345NMs2SDRIIR
14(1)Cement price escalation7227374925541923.2193.4961.8700.6431
14(8)Aluminum and glass product price escalation2250504826682423.0502.7951.6720.6092
14(5)Bricks and blocks price escalation3244603835552322.9872.8211.6800.5973
14(7)Plumbing and electrical material price escalation2547633538562392.9712.7091.6460.5944
14(2)Escalating prices for sand and aggregate3862303746512262.9733.1011.7610.5944
14(3)Steel and reinforcement bar price escalation2351653231622412.9502.7761.6660.5905
14(6)Paint, finishing, and coating material price escalation2558543926622392.9162.8551.6900.5836
14(4)Timber and plywood price escalation2358553931582412.9002.7541.6590.5807
Table A4. Ranking of the main reasons leading to material price increases.
Table A4. Ranking of the main reasons leading to material price increases.
iItem NamesNo
Idea
Likert ScaleStatisticsRanking
012345NMs2SDRIIR
15(1)Global inflation or currency devaluation7436313428611903.2473.7911.9470.6491
15(5)Increased raw material costs3263432236682323.0133.2631.8060.6022
15(6)Import tariffs or regulatory constraints3663452438582282.9253.1631.7780.5853
15(3)Global or local supply chain disruptions3062571838592342.8933.0381.7430.5784
15(4)Local market deficiencies or demand–supply imbalances2170502743532432.8312.7871.6690.5665
15(2)Increases in logistics and fuel costs2477431953482402.8002.8801.6970.5606
15(7)Increased housing demand2180473039472432.6952.7071.6450.5397
Table A5. Ranking of main reasons leading to labor wage increases.
Table A5. Ranking of main reasons leading to labor wage increases.
iItem NamesNo
Idea
Likert ScaleStatisticsRanking
012345NMs2SDRIIR
19(1)General inflationary conditions8230293923611823.3083.8681.9670.6611
19(4)Increases in living expenses2668442734652382.9333.0821.7560.5862
19(6)Competitive pressure among contractors2862464332532362.8642.8101.6760.5723
19(5)Government-mandated wage increases2964523742402352.7532.6291.6210.5504
19(2)Shortage of skilled labor2581422057392392.7112.7581.6610.5425
19(3)Union negotiations3372543427442312.6412.7241.6510.5286
Table A6. Impacts of rising labor wages on project performance.
Table A6. Impacts of rising labor wages on project performance.
iItem NamesNo
Idea
Likert ScaleStatisticsRanking
012345NMs2SDRIIR
20(4)Reductions in profit margins1974523133552452.7672.7481.6580.5531
20(1)Project delays6853424620351962.7042.9121.7070.5402
20(3)Workforce reductions2868603431432362.6652.6101.6150.5333
20(6)Increased reliance on subcontractors2476504136372402.6172.4801.5750.5234
20(5)Substitution with less-experienced labor2277534038342422.5832.3851.5440.5165
20(2)Project scope reductions2091444042272442.4672.2861.5120.4936
Table A7. Rank-ordered analysis of respondents’ perceptions of inflation impacts on key cost components.
Table A7. Rank-ordered analysis of respondents’ perceptions of inflation impacts on key cost components.
iItems NameNo
Idea
Likert ScaleStatisticsRanking
012345NMs2SDRIIR
11Inflation-related factors influencing project budgets017207594582643.59091.22361.10620.7181
22Five-year inflation impact on labor wages013297792532643.54171.16941.08140.7082
8Five-year overall impact of inflation021296693552643.51.36881.170.7003
17Five-year inflation-related increases in material prices015358281512643.4471.24431.11550.6894
23Impact of rising labor wages on project budgets019339061612643.42421.39351.18050.6845
18Impact of rising material prices on project budgets0173410076372643.31061.14271.0690.6626
13Five-year inflation impact on project budgets025587461462643.17051.50321.2260.6347
24Frequency of schedule delays018539280212643.1251.08321.04080.6258
26Project delays attributable to material price inflation6015261005672043.06862.30271.51750.6139
12Frequency of inflation-adjusted budgets0146410270142643.02270.93480.96690.60410
25Project delays attributable to labor wage inflation4619419748132182.97712.10471.45080.59511
29Effectiveness of inflation mitigation strategies035469764222642.96971.28421.13320.59312
Table A8. Fuzzy severity memberships and dominant linguistic hedge identification.
Table A8. Fuzzy severity memberships and dominant linguistic hedge identification.
iNon-Dominant
Severity
Very
True
TrueFairly
True
Non-Dominant
Hedge
Dominant
Severity
Very
True
TrueFairly
True
Dominant
Hedge
iNon-Dominant
Severity
Very
True
TrueFairly
True
Non-Dominant
Hedge
Dominant
Severity
Very
True
TrueFairly
True
Dominant
Hedge
8-----Critical1.001.001.00Very True14(8)Moderate0.220.470.69Fairly TrueHigh0.280.530.73True
9(1)Critical0.070.260.51Fairly TrueHigh0.540.740.86True15(1)Critical0.030.180.42Fairly TrueHigh0.680.820.91True
9(2)Low0.080.280.53Fairly TrueModerate0.520.720.85True15(2)Low0.080.290.54Fairly TrueModerate0.510.710.84True
9(3)High0.020.150.39Fairly TrueModerate0.720.850.92True15(3)High0.000.020.13Not TrueModerate0.960.980.99Very True
9(4)Low0.000.040.20Not TrueModerate0.920.960.98Very True15(4)Low0.030.180.43Fairly TrueModerate0.660.820.90True
9(5)Low0.170.410.64Fairly TrueModerate0.350.590.77True15(5)High0.170.410.64Fairly TrueModerate0.350.590.77True
9(6)Moderate0.190.440.66Fairly TrueLow0.320.560.75True15(6)High0.020.120.35Fairly TrueModerate0.770.880.94Very True
10(01)Moderate0.200.440.67Fairly TrueHigh0.310.560.75True15(7)Moderate0.140.370.61Fairly TrueLow0.400.630.79True
10(02)Moderate0.110.330.58Fairly TrueLow0.440.670.82True17High0.030.170.41Fairly TrueCritical0.690.830.91True
10(03)Negligible0.180.420.65Fairly TrueLow0.330.580.76True18Critical0.150.380.62Fairly TrueHigh0.380.620.78True
10(04)Moderate0.000.010.12Not TrueLow0.970.990.99Very True19(1)Critical0.140.380.61Fairly TrueHigh0.390.620.79True
10(05)Negligible0.000.030.16Not TrueLow0.950.970.99Very True19(2)Moderate0.180.420.65Fairly TrueLow0.330.580.76True
10(06)Negligible0.050.230.48Fairly TrueLow0.600.770.88True19(3)Moderate0.040.190.44Fairly TrueLow0.650.810.90True
10(07)Negligible0.130.360.60Fairly TrueLow0.410.640.80True19(4)High0.020.150.38Fairly TrueModerate0.730.850.92True
10(08)Moderate0.000.040.20Not TrueLow0.920.960.98Very True19(5)Low0.190.440.66Fairly TrueModerate0.310.560.75True
10(09)Negligible0.080.280.53Fairly TrueLow0.510.720.85True19(6)Low0.010.080.28Fairly TrueModerate0.850.920.96Very True
10(10)Negligible0.120.340.58Fairly TrueLow0.430.660.81True20(1)Moderate0.160.400.63Fairly TrueLow0.360.600.78True
10(11)Low0.090.300.55Fairly TrueNegligible0.490.700.84True20(2)Negligible0.140.380.61Fairly TrueLow0.390.620.79True
10(12)Low0.230.480.69Fairly TrueNegligible0.270.520.72True20(3)Moderate0.070.270.52Fairly TrueLow0.530.730.85True
11-----Critical1.001.001.00Very True20(4)Low0.160.390.63Fairly TrueModerate0.370.610.78True
12High0.200.440.66Fairly TrueModerate0.310.560.75True20(5)Moderate0.000.000.03Not TrueLow1.001.001.00Very True
13Moderate0.010.070.27Fairly TrueHigh0.860.930.96Very True20(6)Moderate0.010.110.34Fairly TrueLow0.790.890.94Very True
14(1)Critical0.010.080.29Fairly TrueHigh0.840.920.96Very True22-----Critical1.001.001.00Very True
14(2)High0.080.280.53Fairly TrueModerate0.520.720.85True23High0.060.240.49Fairly TrueCritical0.570.760.87True
14(3)High0.040.200.45Fairly TrueModerate0.630.800.89True24Moderate0.050.220.47Fairly TrueHigh0.600.780.88True
14(4)High0.000.040.20Not TrueModerate0.920.960.98Very True25High0.090.290.54Fairly TrueModerate0.500.710.84True
14(5)High0.110.330.57Fairly TrueModerate0.460.670.82True26Moderate0.170.410.64Fairly TrueHigh0.350.590.77True
14(6)High0.010.090.31Fairly TrueModerate0.820.910.95Very True29High0.070.270.52Fairly TrueModerate0.540.730.86True
14(7)High0.070.270.52Fairly TrueModerate0.530.730.85True

References

  1. Atakul, N. Exploring the Cash Flow Management Strategies of Turkish Construction Companies. J. Constr. Eng. Manag. Innov. 2022, 5, 168–180. [Google Scholar] [CrossRef]
  2. Aslam, B.; Maqsoom, A.; Inam, H.; Basharat, M.U.; Ullah, F. Forecasting Construction Cost Index through Artificial Intelligence. Societies 2023, 13, 219. [Google Scholar] [CrossRef]
  3. Moyanga, D.T.; Saka, N. Empirical Estimation of the Impacts of Inflation on the Construction Sector in Nigeria. J. Constr. Eng. Manag. Innov. 2023, 6, 176–191. [Google Scholar] [CrossRef]
  4. Akal, A.Y. Inflation and Reinforced Concrete Materials: An Investigation of Economic and Environmental Effects. Sustainability 2023, 15, 7687. [Google Scholar] [CrossRef]
  5. Maqsoom, A.; Prasittisopin, L.; Musarat, M.A.; Ullah, F.; Alqahtani, F.K. Construction Price Index Prediction through ARMA with Inflation Effect: Case of Thailand Construction Industry. Buildings 2024, 14, 1243. [Google Scholar] [CrossRef]
  6. Al-Hazim, N.; Salem, Z.A.; Ahmad, H. Delay and Cost Overrun in Infrastructure Projects in Jordan. Procedia Eng. 2017, 182, 18–24. [Google Scholar] [CrossRef]
  7. Johnson, R.M.; Babu, R.I.I. Time and Cost Overruns in the UAE Construction Industry: A Critical Analysis. Int. J. Constr. Manag. 2018, 20, 402–411. [Google Scholar] [CrossRef]
  8. Oz, B. Dissatisfaction Levels in Turkish Residential Buildings and Recommendations for Improving Quality. J. Perform. Constr. Facil. 2024, 38, 04024051. [Google Scholar] [CrossRef]
  9. Oz, B. A Novel Consensus-Based Likert Evaluation of Public Building Dissatisfaction Levels and Quality Recommendations. J. Constr. Eng. Manag. Innov. 2025, 8, 1–18. [Google Scholar] [CrossRef]
  10. Shah, R.K. An Exploration of Causes for Delay and Cost Overruns in Construction Projects: Case Study of Australia, Malaysia & Ghana. J. Adv. Coll. Eng. Manag. 2016, 2, 41. [Google Scholar] [CrossRef][Green Version]
  11. Musarat, M.A.; Alaloul, W.S.; Liew, M.S.; Maqsoom, A.; Qureshi, A.H. Investigating the Impact of Inflation on Building Materials Prices in Construction Industry. J. Build. Eng. 2020, 32, 101485. [Google Scholar] [CrossRef]
  12. Musarat, M.A.; Alaloul, W.S.; Liew, M.S. Impact of Inflation Rate on Construction Projects Budget: A Review. Ain Shams Eng. J. 2021, 12, 407–414. [Google Scholar] [CrossRef]
  13. Musarat, M.A.; Alaloul, W.S.; Liew, M.S. Inflation Rate and Labours’ Wages in Construction Projects: Economic Relation Investigation. Eng. Constr. Archit. Manag. 2021, 29, 2461–2494. [Google Scholar] [CrossRef]
  14. Calik, I.; Koc, K.; Şahin, O. Life Cycle Risk Management for Improving Labor Productivity in Construction Projects in Türkiye. Buildings 2025, 15, 484. [Google Scholar] [CrossRef]
  15. FIEC. Construction Activity in Europe (Edition 2025). Available online: https://fiec-statistical-report.eu/european-union (accessed on 14 December 2025).
  16. Evans, J.R.; Mathur, A. The Value of Online Surveys. Internet Res. 2005, 15, 195–219. [Google Scholar] [CrossRef]
  17. Callegaro, M.; Manfreda, K.L.; Vehovar, V. Web Survey Methodology; SAGE: Thousand Oaks, CA, USA, 2015; ISBN 9781473927292. [Google Scholar]
  18. Wright, K.B. Researching Internet-Based Populations: Advantages and Disadvantages of Online Survey Research, Online Questionnaire Authoring Software Packages, and Web Survey Services. J. Comput.-Mediat. Commun. 2006, 10, JCMC1034. [Google Scholar] [CrossRef]
  19. Likert, R. A Technique for Measurement of Attitudes. Arch. Psychol. 1932, 140, 5–55. [Google Scholar]
  20. Boone, H.; Boone, D. Analyzing Likert Data. J. Ext. 2012, 50, 48. [Google Scholar] [CrossRef]
  21. Clason, D.L.; Dormody, T.J. Analyzing Data Measured by Individual Likert-Type Items. J. Agric. Educ. 1994, 35, 31–35. [Google Scholar] [CrossRef]
  22. Ary, D.; Jabobs, L.C.; Razavieh, A. Introduction to Research in Education, 8th ed.; Thomson Wadsworth: Belmont, CA, USA, 2010; pp. 101–103. ISBN 0495008052. [Google Scholar]
  23. Bhandari, P. A Note on Survey Research Methods Levels of Measurement: Foundational Basis for Quantitative Analysis of Survey Data. Dhaulagiri J. Sociol. Anthropol. 2022, 16, 122–126. [Google Scholar] [CrossRef]
  24. Weng, L.-J.; Cheng, C.-P. Effects of Response Order on Likert-Type Scales. Educ. Psychol. Meas. 2000, 60, 908–924. [Google Scholar] [CrossRef]
  25. Klir, G.J.; Clair, U.S.; Yuan, B. Fuzzy Set Theory: Foundations and Applications; Prentice Hall, Inc.: Hoboken, NJ, USA, 1997; pp. 202–211. ISBN 9780133410587. [Google Scholar]
  26. Franklin, C.; Ballan, M. Reliability and Validity in Qualitative Research. In The Handbook of Social Work Research Methods; SAGE Publications, Inc.: Thousand Oaks, CA, USA, 2001; pp. 273–292. [Google Scholar]
  27. Peter, J.P. Construct Validity: A Review of Basic Issues and Marketing Practices. J. Mark. Res. 1981, 18, 133–145. [Google Scholar] [CrossRef]
  28. Hair, J.F., Jr.; Black, W.C.; Babin, B.J.; Anderson, R.E. Multivariate Data Analysis, 8th ed.; Cengage: Noida, India, 2018; ISBN 9353501350. [Google Scholar]
  29. Cortina, J.M. What Is Coefficient Alpha? An Examination of Theory and Applications. J. Appl. Psychol. 1993, 78, 98–104. [Google Scholar] [CrossRef]
  30. Lynn, M.R. Determination and Quantification of Content Validity. Nurs. Res. 1986, 35, 382–386. [Google Scholar] [CrossRef]
  31. Elangovan, N.; Sundaravel, E. Method of Preparing a Document for Survey Instrument Validation by Experts. MethodsX 2021, 8, 101326. [Google Scholar] [CrossRef]
  32. Sireci, S.G. The Construct of Content Validity. Soc. Indic. Res. 1998, 45, 83–117. [Google Scholar] [CrossRef]
  33. Cronbach, L.J. Coefficient Alpha and the Internal Structure of Tests. Psychometrika 1951, 16, 297–334. [Google Scholar] [CrossRef]
  34. Taber, K.S. The Use of Cronbach’s Alpha When Developing and Reporting Research Instruments in Science Education. Res. Sci. Educ. 2017, 48, 1273–1296. [Google Scholar] [CrossRef]
  35. Grubbs, F.E. Procedures for Detecting Outlying Observations in Samples. Technometrics 1969, 11, 1–21. [Google Scholar] [CrossRef]
  36. Jones, P.R. A Note on Detecting Statistical Outliers in Psychophysical Data. Atten. Percept. Psychophys. 2019, 81, 1189–1196. [Google Scholar] [CrossRef]
  37. Siraj-Ud-Doulah, M.; Islam, M.H. An Alternative Robust Measure of Outlier Detection in Univariate Data Sets. Res. Rev. J. Stat. 2019, 8, 1–11. [Google Scholar]
  38. Akomea-Frimpong, I.; Jin, X.; Osei-Kyei, R.; Tumpa, R.J. A Critical Review of Public–Private Partnerships in the COVID-19 Pandemic: Key Themes and Future Research Agenda. Smart Sustain. Built Environ. 2022, 12, 701–720. [Google Scholar] [CrossRef]
  39. Castelblanco, G.; Fenoaltea, E.M.; De Marco, A.; Chiaia, B. Influence of Macroeconomic Factors on Construction Costs: An Analysis of Project Cases. Constr. Manag. Econ. 2024, 43, 196–212. [Google Scholar] [CrossRef]
  40. Anireddy, A.R. Impact of Inflation on Construction Cost Estimation: Strategies to Account for Fluctuating Material Prices. Int. J. Multidiscip. Res. 2023, 5, IJFMR230410884. [Google Scholar] [CrossRef]
  41. Anireddy, A.R. Material Cost Fluctuations: Analyzing the Effects of Market Volatility on Civil Project Budgets. Int. J. Sci. Res. (IJSR) 2024, 13, 1606–1610. [Google Scholar] [CrossRef]
  42. Naghdi, M.; Erfani, A.; Geary, G.; Ashuri, B. Price Adjustment Clauses in Highway Construction: State of the Practice. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2026, 18, 04525119. [Google Scholar] [CrossRef]
  43. Alaloul, W.S.; Musarat, M.A.; Liew, M.S.; Qureshi, A.H.; Maqsoom, A. Investigating the Impact of Inflation on Labour Wages in Construction Industry of Malaysia. Ain Shams Eng. J. 2021, 12, 1575–1582. [Google Scholar] [CrossRef]
  44. Ding, M.J.; Jie, F. Mitigating the Supply Chain Uncertainties and Risks in the Construction Projects: Case Studies of Australian Construction Projects. Clean. Logist. Supply Chain 2025, 16, 100237. [Google Scholar] [CrossRef]
  45. Akhavan Chayjan, K.; Razmi, J.; Amin, S.H. An Analytical Investigation of Inflation’s Effects on Supply Chain Strategies. Supply Chain Anal. 2025, 12, 100168. [Google Scholar] [CrossRef]
  46. Rajabi, R.; Haji Yakhchali, S. Optimizing Cash Flow in Construction Portfolios: A Metaheuristic Approach from the Organization’s Perspective. Ain Shams Eng. J. 2025, 16, 103259. [Google Scholar] [CrossRef]
Figure 1. Power-based linguistic hedges for truth qualification, adapted from ‘Fuzzy Set Theory: Foundations and Applications’ [25].
Figure 1. Power-based linguistic hedges for truth qualification, adapted from ‘Fuzzy Set Theory: Foundations and Applications’ [25].
Sustainability 18 01317 g001
Figure 2. Graded severity assessment of inflation effects based on fuzzy logic.
Figure 2. Graded severity assessment of inflation effects based on fuzzy logic.
Sustainability 18 01317 g002
Figure 3. Inflation-affected cost categories based on the RII.
Figure 3. Inflation-affected cost categories based on the RII.
Sustainability 18 01317 g003
Figure 4. RII-based ranking of inflation-related consequences in residential construction projects.
Figure 4. RII-based ranking of inflation-related consequences in residential construction projects.
Sustainability 18 01317 g004
Figure 5. Material categories affected by inflation, ranked using the RII.
Figure 5. Material categories affected by inflation, ranked using the RII.
Sustainability 18 01317 g005
Figure 6. RII–based ranking of key drivers of material price inflation in residential construction.
Figure 6. RII–based ranking of key drivers of material price inflation in residential construction.
Sustainability 18 01317 g006
Figure 7. Main reasons for labor wage increases as ranked by RII.
Figure 7. Main reasons for labor wage increases as ranked by RII.
Sustainability 18 01317 g007
Figure 8. Rising labor wages on project performance as ranked by RII.
Figure 8. Rising labor wages on project performance as ranked by RII.
Sustainability 18 01317 g008
Figure 9. Inflation impacts on key cost components ranked-ordered by RII.
Figure 9. Inflation impacts on key cost components ranked-ordered by RII.
Sustainability 18 01317 g009
Figure 10. Central tendency, dispersion, and severity levels of Likert-scale items.
Figure 10. Central tendency, dispersion, and severity levels of Likert-scale items.
Sustainability 18 01317 g010
Table 1. Cronbach’s Alpha values based on various categories.
Table 1. Cronbach’s Alpha values based on various categories.
CkΣViVtCronbach’s AlphaInterpretation
(a)617.6090.500.97Excellent
(b)1231.71285.710.97Excellent
(c)823.31156.170.97Excellent
(d)721.63127.420.97Excellent
(e)617.8787.500.95Excellent
(f)615.4275.000.95Excellent
(g)1216.7648.540.71Acceptable
(h)57144.744494.810.99Excellent
C: categories; k: number of scale items; Vt: variance of test scores; ΣVi: sum of the variances of item scores after weighting.
Table 2. Survey participants’ demographics.
Table 2. Survey participants’ demographics.
ProfileniFIi
(%)
ProfileniFIi
(%)
Position
or
role:
Project developer3011Experience:Less than 5 years8633
Client/Owner26105–10 years7227
Contractor23911–20 years8231
Consultant/Building inspector3011More than 20 years249
Government/Building control officer3313Project types: Low-rise housing10439
Supplier228Medium-rise apartments12246
Project manager187High-rise buildings3814
Site engineer/Architect2710Organization
size:
Small (1–50 employees)7729
Site technician114Medium (51–200 employees)12347
Skilled laborer/Foreman114Large (201+ employees)6424
Quantity surveyor31Projects
Handled
each year
(avg.):
139737
Safety officer1354–610941
Human resource/Payroll manager135More than 65822
Others42
ni; number of respondents choosing category i; FIi; frequency index of category i.
Table 3. Likert scale items with brief descriptions.
Table 3. Likert scale items with brief descriptions.
iLikert Scale ItemsiLikert Scale ItemsiLikert Scale Items
8Five-year overall impact
of inflation
11Inflation-related factors
influencing project budgets
18Impact of rising material
prices on project budgets
9(1)Impact of inflation on
building material costs
12Frequency of
inflation-adjusted budgets
19(1)General inflationary
conditions
9(2)Impact of inflation on
labor wage costs
13Five-year inflation impact
on project budgets
19(2)Shortage of skilled labor
9(3)Impact of inflation on
equipment rental and fuel costs
14(1)Cement price escalation19(3)Union negotiations
9(4)Impact of inflation on logistics
and transportation costs
14(2)Escalating prices for
sand and aggregate
19(4)Increases in living
expenses
9(5)Impact of inflation on permit
and regulatory compliance costs
14(3)Steel and reinforcement
bar price escalation
19(5)Government-mandated
wage increases
9(6)Impact of inflation on consultant
and professional service fees
14(4)Timber and plywood
price escalation
19(6)Competitive pressure
among contractors
10(01)Cost overruns
attributable to inflation
14(5)Bricks and blocks
price escalation
20(1)Project delays
10(02)Project delays
associated with inflation
14(6)Paint, finishing, and coating
material price escalation
20(2)Project scope reductions
10(03)Project suspension or
cancelation due to inflation
14(7)Plumbing and electrical
material price escalation
20(3)Workforce reductions
10(04)Material shortages, delivery
delays, or unavailability
14(8)Aluminum and glass
product price escalation
20(4)Reductions in profit
margins
10(05)Labor shortages or
reduced productivity
15(1)Global inflation or
currency devaluation
20(5)Substitution with
less-experienced labor
10(06)Inflation-driven revisions to
material specifications
15(2)Increases in logistics and
fuel costs
20(6)Increased reliance on
subcontractors
10(07)Quality control failures under
inflationary conditions
15(3)Global or local
supply chain disruptions
22Five-year inflation impact
on labor wages
10(08)Contractor financial
instability
15(4)Local market deficiencies or
demand–supply imbalances
23Impact of rising labor
wages on project budgets
10(09)Subcontractor performance
deficiencies
15(5)Increased raw material costs24Frequency of schedule
delays
10(10)Contractual disputes
arising from inflation
15(6)Import tariffs or
regulatory constraints
25Project delays attributable
to labor wage inflation
10(11)Safety and health issues under
inflationary pressures
15(7)Increased housing demand26Project delays attributable
to material price inflation
10(12)Material loss, damage, or theft17Five-year inflation-related
increases in material prices
29Effectiveness of inflation
mitigation strategies
Table 4. Non-dominant and dominant severity classes with linguistic hedges.
Table 4. Non-dominant and dominant severity classes with linguistic hedges.
iNon-Dominant
Severity
Non-Dominant
Hedge
Dominant
Severity
Dominant
Hedge
iNon-Dominant
Severity
Non-Dominant
Hedge
Dominant
Severity
Dominant
Hedge
8--CriticalVery True14(8)ModerateFairly TrueHighTrue
9(1)CriticalFairly TrueHighTrue15(1)CriticalFairly TrueHighTrue
9(2)LowFairly TrueModerateTrue15(2)LowFairly TrueModerateTrue
9(3)HighFairly TrueModerateTrue15(3)HighNot TrueModerateVery True
9(4)LowNot TrueModerateVery True15(4)LowFairly TrueModerateTrue
9(5)LowFairly TrueModerateTrue15(5)HighFairly TrueModerateTrue
9(6)ModerateFairly TrueLowTrue15(6)HighFairly TrueModerateVery True
10(01)ModerateFairly TrueHighTrue15(7)ModerateFairly TrueLowTrue
10(02)ModerateFairly TrueLowTrue17HighFairly TrueCriticalTrue
10(03)NegligibleFairly TrueLowTrue18CriticalFairly TrueHighTrue
10(04)ModerateNot TrueLowVery True19(1)CriticalFairly TrueHighTrue
10(05)NegligibleNot TrueLowVery True19(2)ModerateFairly TrueLowTrue
10(06)NegligibleFairly TrueLowTrue19(3)ModerateFairly TrueLowTrue
10(07)NegligibleFairly TrueLowTrue19(4)HighFairly TrueModerateTrue
10(08)ModerateNot TrueLowVery True19(5)LowFairly TrueModerateTrue
10(09)NegligibleFairly TrueLowTrue19(6)LowFairly TrueModerateVery True
10(10)NegligibleFairly TrueLowTrue20(1)ModerateFairly TrueLowTrue
10(11)LowFairly TrueNegligibleTrue20(2)NegligibleFairly TrueLowTrue
10(12)LowFairly TrueNegligibleTrue20(3)ModerateFairly TrueLowTrue
11--CriticalVery True20(4)LowFairly TrueModerateTrue
12HighFairly TrueModerateTrue20(5)ModerateNot TrueLowVery True
13ModerateFairly TrueHighVery True20(6)ModerateFairly TrueLowVery True
14(1)CriticalFairly TrueHighVery True22--CriticalVery True
14(2)HighFairly TrueModerateTrue23HighFairly TrueCriticalTrue
14(3)HighFairly TrueModerateTrue24ModerateFairly TrueHighTrue
14(4)HighNot TrueModerateVery True25HighFairly TrueModerateTrue
14(5)HighFairly TrueModerateTrue26ModerateFairly TrueHighTrue
14(6)HighFairly TrueModerateVery True29HighFairly TrueModerateTrue
14(7)HighFairly TrueModerateTrue
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Oz, B.; Kocyigit, M. Identifying Dominant Inflation Risks in Residential Construction Projects Using Fuzzy Truth Qualification. Sustainability 2026, 18, 1317. https://doi.org/10.3390/su18031317

AMA Style

Oz B, Kocyigit M. Identifying Dominant Inflation Risks in Residential Construction Projects Using Fuzzy Truth Qualification. Sustainability. 2026; 18(3):1317. https://doi.org/10.3390/su18031317

Chicago/Turabian Style

Oz, Burak, and Merve Kocyigit. 2026. "Identifying Dominant Inflation Risks in Residential Construction Projects Using Fuzzy Truth Qualification" Sustainability 18, no. 3: 1317. https://doi.org/10.3390/su18031317

APA Style

Oz, B., & Kocyigit, M. (2026). Identifying Dominant Inflation Risks in Residential Construction Projects Using Fuzzy Truth Qualification. Sustainability, 18(3), 1317. https://doi.org/10.3390/su18031317

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
