Conceptual Framework of a Simulation-Based Manpower Planning Method for Construction Enterprises
Abstract
1. Introduction
- Setting the strategy by defining goals and the ways to achieve them, as well as policies for the personnel acquisition, development, and control in a long-term vision of the desired state and the associated system of tactical actions. The latter are expected to ensure the best use of human resources to achieve the long-term objectives of the organization;
- Manpower planning, fed with input from continuous monitoring of the organization’s workforce requirements and anticipation of their changes;
- Recruitment and retention of human resources, taking actions to balance the demand for resources with access to a skilled workforce;
- Dismissing employees [7].
2. Theoretical View
2.1. Manpower Planning Methods
- Expert judgement. This relies on the experience-based estimates furnished by team managers. They prompt the minimal and the optimal numbers of employees in their teams and list their initial qualifications and competencies. A modification of this technique is the Delphi method, which consists of collecting opinions of a group of experts and finding staffing solutions accepted by the majority of them.
- Trend analysis. This is used to predict the future human resource demand on the basis of trends discovered in historical data. It is an assessment of changes on the internal and external labor market. Such analysis is more suitable for estimating personnel changes within teams of physical workers. It is reliable only in times of a relatively stable labor market.
- Examining and standardizing work. This technique involves the analysis of tasks and the human resources required to perform them in a particular time. It is usually used when analyzing manual labor. It is often combined with other techniques.
- Work process modelling. This involves the use of econometric techniques: operations research, statistics, and simulation to construct models of labor requirements and estimation based on econometric and statistical data.
- Indicator method. Various types of indicators are used for planning the size or structure of employment, often determined on the basis of statistical data, e.g., determining the number of production workers per one administrative employee.
2.2. Manpower Planning and the Construction Enterprise
3. Materials and Methods
4. Results and Discussion
- Collecting the input to develop a model of the company’s production plan. The data needed for simulation modeling include:
- The types of ongoing construction projects (works) modeled by means of networks;
- The intensity of the arrivals (starting subsequent projects);
- The distribution types and parameters of process execution times;
- The list of key resources (their type and demand) to deliver the processes;
- The predefined limits on the availability of resources.

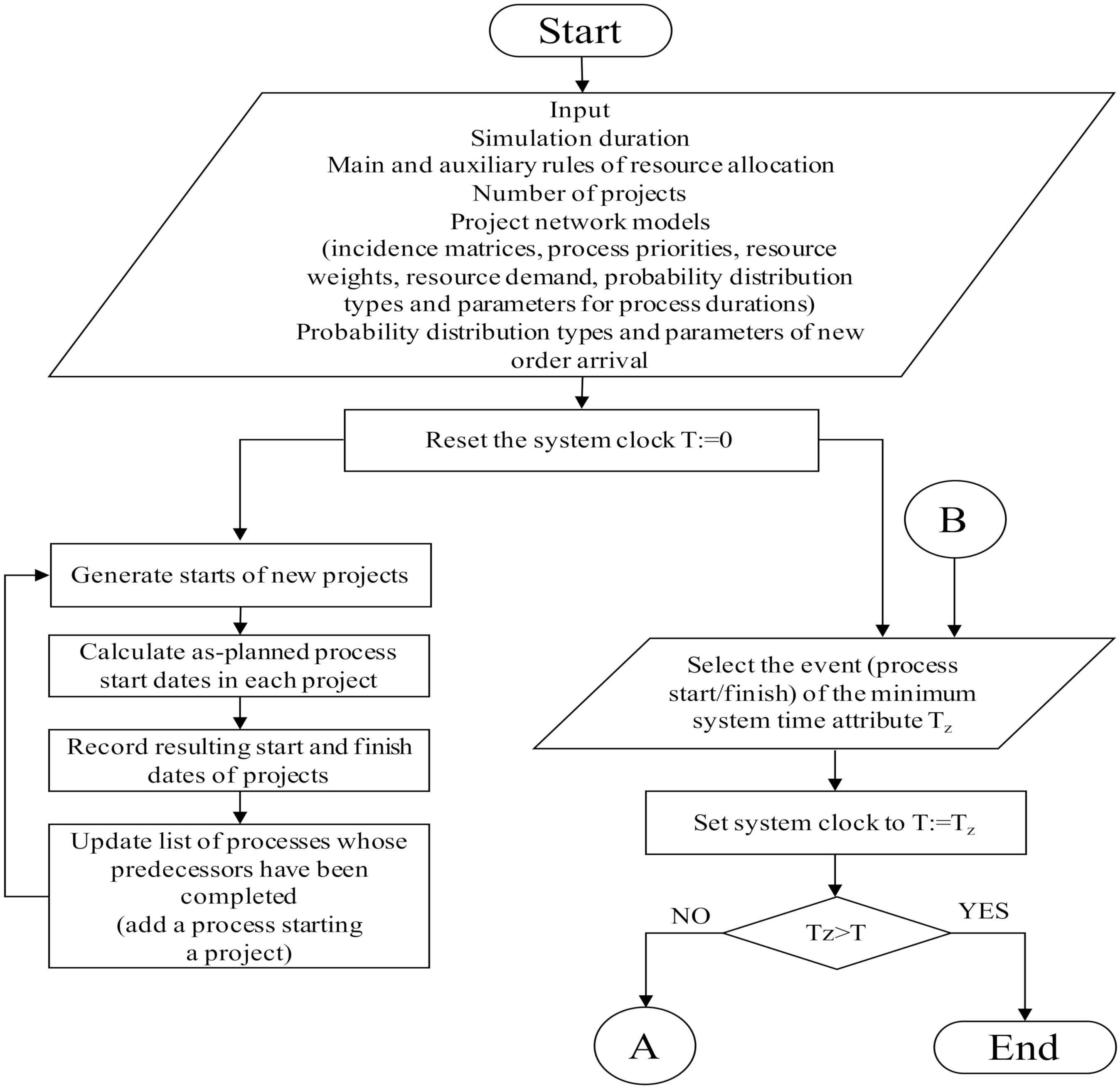

- Building the simulation model of the enterprise’s production plan. To model the enterprise’s production plan, one needs to determine the types of prospective projects and the desired number of projects. For each type of project, a generic network model is prepared. For instance, the typical orders taken by one of the studied construction enterprises, specializing in housing construction in a local market, could be classified into only four project types:
- III.

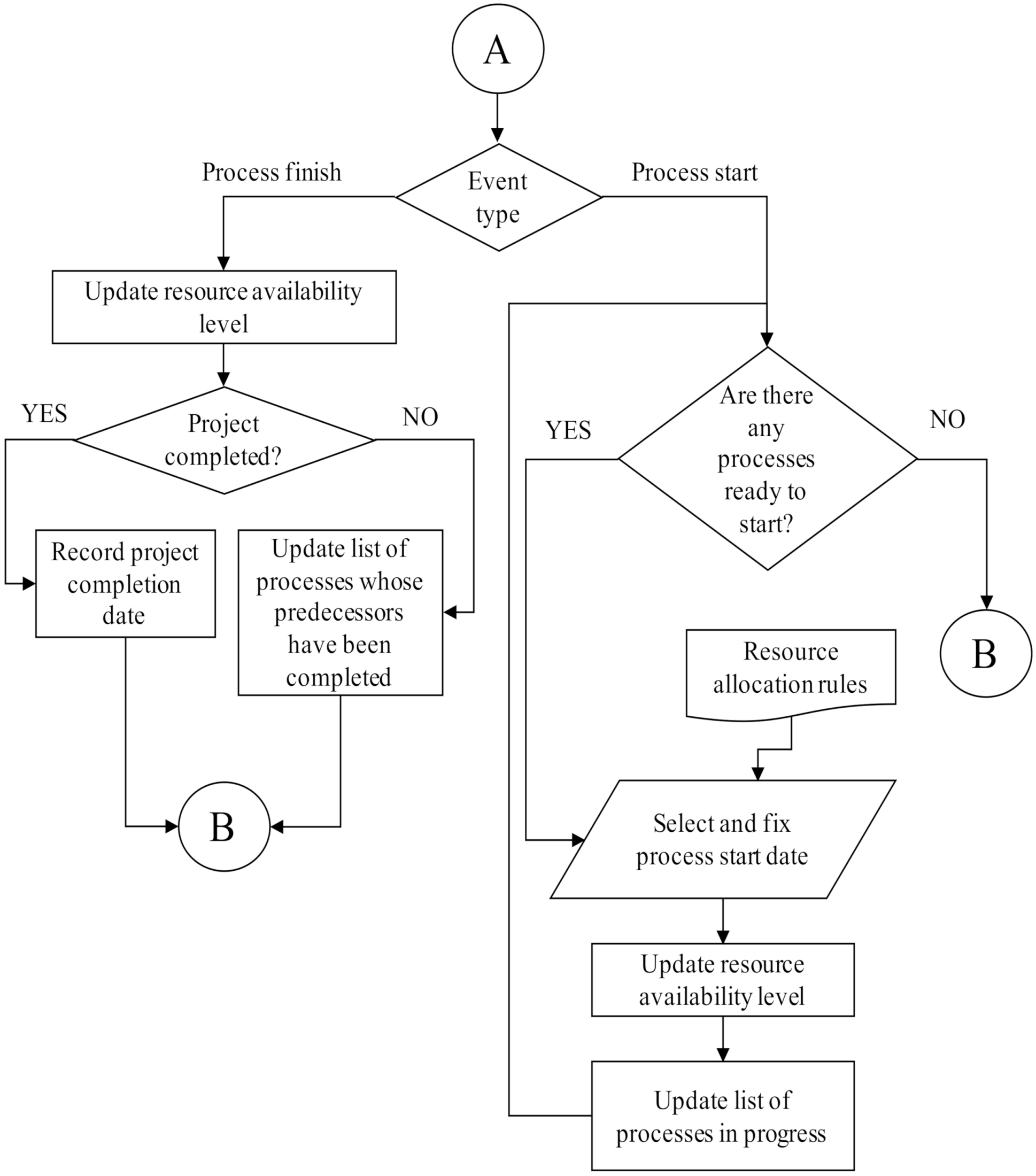

- Model verification and validation. The verification of the model should be conducted at the stage of the model’s computer implementation and as the model is completed to check if the model performs according to the conceptual description. Then, the model needs to be validated, i.e., checked to what degree it describes the real system [51].
- IV.
- Simulations. Simulation studies are designed to analyze the impact of input parameters (mainly the level of resource availability and the selected resource allocation heuristic rule) on the output parameters. Performance measures of the proposed solution should be consulted by the company’s management and be in line with the company’s strategy.
- the number of projects completed within a specified period;
- the average project duration;
- the average value of the extension of time;
- the number or cost of resource transfers from project to project;
- the resource utilization rates;
- the cost of resource idle time;
- the costs of delay penalties.
- —the cost of resource transfers from project to project for the scenario ,
- —the cost of resource idle time for the scenario ,
- —the costs of delay penalties for the scenario .
- V.
- Development of a monitoring system. Due to the natural changes in the company’s environment, it is necessary to continuously monitor changes of the market and update the model in terms of the types of prospective orders and the distribution parameters of their acquisition (arrivals to the system). Updates may be needed due to changes in the enterprise’s bidding strategy or decisions to enter new market segments. It is also necessary to analyze the possibility of increasing or decreasing the production potential of the enterprise by analyzing its financial standing. These actions must be in line with the company’s strategy.
- VI.
- Implementation. The numbers of units of the key human resource, the project durations, and differences between the as-planned and simulated completion dates can prompt the management’s rationale for the levels of employment and equipment of the construction enterprise. The results of the analysis help justify the need to invest in or to reduce the production potential and introduce changes in the management system.
- VII.
- Control. In the face of organizational changes and technological advances, it may be necessary to design new network models and re-estimate the construction process durations. Keeping records of completed construction processes and analyzing the reasons for discrepancies between the actual and the as-planned completion times may be helpful in this process. It may prove necessary to modify the simulation model and to account for more constraints, e.g., to consider the correlation between durations of processes affected by the same risks or factors, such as the season of the year. At this stage, practical validation of the developed method and simulation model is carried out. The analysis of the consistency of assumptions made in the construction of the model with the real values of the data mentioned in Point I allows modification of the model and an increase in the reliability of the obtained results.
