Skip to Content
SustainabilitySustainability
  • Review
  • Open Access

15 July 2022

55 Pages

A Systematic Review of the Extent to Which BIM Is Integrated into Operation and Maintenance

,
,
and
Department of Mechanical, Aerospace and Civil Engineering (MACE), University of Manchester, Manchester M13 9PL, UK
*
Author to whom correspondence should be addressed.
This article belongs to the Special Issue Sustainability in Operations Management

Abstract

Although a considerable amount of research has addressed the use of building information modelling (BIM) in facilities management (FM) within the past years, there is limited systematic review on investigating the potentials of BIM within the operation and maintenance (O&M) life cycle phase. Yet, this phase could account for approximately 60% of the total life cycle costs of assets. The purpose of this paper is to conduct a systematic literature review on the application of BIM in the O&M phase to identify current research trends, research gaps and future directions. This study achieves the aforementioned purpose by adopting the preferred reporting items for systematic review and meta-analysis protocols (PRISMA-P). It employs qualitative and quantitative techniques to analyse the articles from a combination of three multi-disciplinary research databases, namely—Scopus, Web of Science and Engineering Village, which also comprises Compendex, InSpec, GeoRef and GeoBase sub-databases. After an in-depth review of 196 selected journal articles, this study systemically presents: (1) bibliometric analyses of the literature in BIM and O&M; (2) research patterns and trends; (3) drivers and barriers to BIM–O&M integration; and (4) research gaps mapped into a standard project management lifecycle to guide future research directions. The content analysis reveals that BIM has mainly been integrated under seven functions: information management (IM), advanced technology (AT), maintenance and asset management (MAM), indoor management (IM), performance assessment (PA), visualisation (V), and lean management (LM). Findings of the study reveal that the UK, USA and China are the top ranked countries with regards to research outputs on BIM–O&M integrations. The majority of BIM integrations within O&M falls under the information management function, whereas the least research output was recorded under lean management. In addition, the majority of studies focused on institutional and infrastructure facility types, but residential, industrial and commercial buildings were underrepresented, despite their disproportionate physical dominance within most societies. Findings also show that potential drivers and barriers for BIM integrations within O&M can be classified into three main categories—technical, organisational, and legal/contractual. It is then concluded that the application of BIM within O&M is still emerging, which further emphasises the need for more studies that address value realization in the context of BIM in O&M, with particular focus on the specific O&M principles for different building types.

1. Introduction

Building information modelling (BIM) is changing the way facilities and infrastructure are conceived and managed. It has provided designers and builders with opportunities for successful project delivery, at a higher quality and a lower cost. BIM applications in design and construction have outgrown the research phase and are now deployed and implemented in different construction projects worldwide [1]. However, building owners and other construction project stakeholders usually focus on the initial investments from the design-to-construction phases because they occur within a relatively shorter time than other phases of the building life cycle. While the design-to-construction phases typically account for 2–5 years, the operations and maintenance (O&M) phase usually takes up to 20 years and even beyond, which makes it crucial to the realisation of a good return on investment (ROI) [2]. This indicates that the ongoing costs of building operations and maintenance far outweigh the capital investment on construction. This implies that there is a possibility for huge cost savings with BIM in O&M [3]. The sustainability of physical assets is highly dependent on their reliability and maintainability, especially in the O&M phase due to their high of return of investment (ROI). According to the National Institute of Standards and Technology (NIST), poor integration and interoperability results in as much as USD 15.8 billion worth of lost opportunity [4], with most of the losses (more than 60% on average) incurred by facility owners at the O&M phase. However, limited studies within the existing body of knowledge have explored the application of BIM during the O&M phase [5]. This indeed depicts the fact that the full potentials of BIM within the O&M phases are yet to be wholly harnessed [6,7]. This is perhaps why some more recent studies have begun to address BIM enhancements in space management, asset management and sustainability [8,9]. The studies mostly adjudged that BIM initiatives can provide enhancements beyond construction, for example, for maintenance decision making [10], energy utilisation [5], building commissioning and contingency response activities.
However, even though BIM in O&M has been acknowledged as far back as 2010, its adoption and utilisation during the O&M phase remains slow, owing to several justifications. Firstly, the absence of clear information needs that support the use of BIM in the O&M phase makes it difficult to support the integration. Facility managers do not have the BIM requirements in place to address their needs in the O&M phase [11]. Thus, when the integration takes place, these requirements are either missing or unclear. FM teams do not normally use BIM data models, either because these models do not include the required operational needs or because FM teams lack understanding of how to transfer information from BIM models to other systems. The reason behind that is the undefined principles for BIM with respect to people, processes and systems [12]. It is recommended that business owners and facility managers should engage at the early stages of building life cycles in order to optimise all aspects of design, construction, O&M and decommissioning [11]. Secondly, the compatibility between BIM and the different systems used during the building life cycle (e.g., CMMS, CAFM and BAS) is complex. This often leads to laborious manual interventions, which are time-consuming and critical to the success of the adoption process. Thirdly, since assessing the performance of the integration is critical to its success, the absence of key metrics that can actually assess the integration in the O&M phase, when it takes place, can further hinder the process. Many researchers have reported methodologies for assessing and monitoring building performance [13,14,15]. However, none have identified key performance indicators (KPI) for BIM in the O&M phase, although few authors, such as Eadie et.al. [16], investigated general KPIs for BIM, but were not focused on the O&M stage. Due to the aforementioned reasons, BIM integrations within the O&M phase remain slow and their applications are limited. This necessitated a state-of-the-art review that can capture the in-depth justifications behind the slow adoption for BIM in O&M. Furthermore, these aspects created a need to investigate the current BIM capabilities in supporting facility O&M by examining how each O&M activity can be leveraged by BIM and to what extent they actually support the O&M phase of the building life cycle. Although the information may be available at some points, questions around how to derive the usefulness of these data within BIM for O&M applications remain unanswered.
The aim of this research is to use a systematic approach to provide valuable insights regarding the current literature surrounding BIM in the O&M phase. It identifies, analyses and summarizes functions of these integrations with an in-depth analysis of the O&M scope. Initially, a detailed description of the methodology adopted for the systematic literature review (SLR) is presented, after which the key findings will be addressed under two distinct sections. The former section presents a bibliometric analysis of the search results, while the latter section provides a comprehensive content analysis of BIM–O&M integrations. Furthermore, the drivers and barriers hindering BIM–O&M adoption are then brought to the fore. Subsequently, the study identifies gaps in knowledge and then maps them against a standard project management lifecycle to guide future research directions for academics and industry professionals. Finally, the study presents concluding remarks to summarize the main findings and contributions to knowledge.

2. Research Methodology

The literature review methodology deployed for this study is based on preferred reporting items for systematic review and meta-analysis protocols (PRISMA-P). Systematic literature review (SLR) is often argued to provide the “most reliable and comprehensive statement about what works” [17]. The methodology ensures an effective description of the analytic approach of the review. A comprehensive protocol adapted from Moher et al. and Okoli [18,19,20,21] is followed and illustrated in this section.

2.1. Review Questions

The fundamental aim of the current study is to systematically review the existing literature on BIM applications, with keen interests in the extent to which such concepts are embedded into the O&M phase. Therefore, the review questions were formulated to be:
  • What is the current state of the art of BIM applications and to what extent are they integrated into the O&M phase?
  • What are the possible drivers and barriers to adopting BIM applications in O&M?
  • What are the emergent research gaps in the area of BIM–O&M integrations?

2.2. Inclusion and Exclusion Criteria

The core characteristics of SLRs are their justifications for each of the captured primary articles, which are often demonstrated via inclusion and exclusion criteria. Therefore, the inclusion criteria for this SLR are:
  • All available articles on BIM integration within the O&M phase of construction and infrastructure domains;
  • All available articles that address drivers and barriers to BIM–O&M integration;
  • Only journal papers were included due to their more rigorous peer-review process, higher reliability and validity [22];
  • This SLR was not constrained by a time frame so as to ensure a more encompassing approach to information tracking and data capturing;
  • Articles written in English.

2.3. Search Strategy

The three databases chosen as the main sources of information for this SLR were Scopus, Web of Science and Engineering Village, although Engineering Village also comprises additional engineering-specific databases, namely; InSpec, Compendex, Geobase and GeoRef. The selection of these databases was due to their efficient, easy and advanced searching options, as well as their reliable and comprehensive academic information in the specified area of this research. The methodology consists of five main stages, namely: scoping, identification, screening, eligibility and final records. In the first stage, the databases and research questions were formulated. In the second stage, the advanced keywords searching option was used with the following phrases ((“Building information model *” OR “building model *” OR “BIM”) AND (“operation and maintenance” OR “asset management” OR “facility * management” OR “maintenance information management” OR “maintenance management *” OR “computeri * maintenance management *”)). The total number of returned results were 669 articles which was further refined based on the inclusion criteria. A total of 413 articles were duplicated, and the remaining 256 were further screened in stage 3. In the third stage, the unrelated articles were excluded through title and abstract assessments. The penultimate stage entailed establishing the eligibility of the remaining 218 articles based on full-text availability, which in turn informed the 196 articles included in the fifth and final stage. Figure 1 provides a stepwise description of the research strategy deployed in this study.

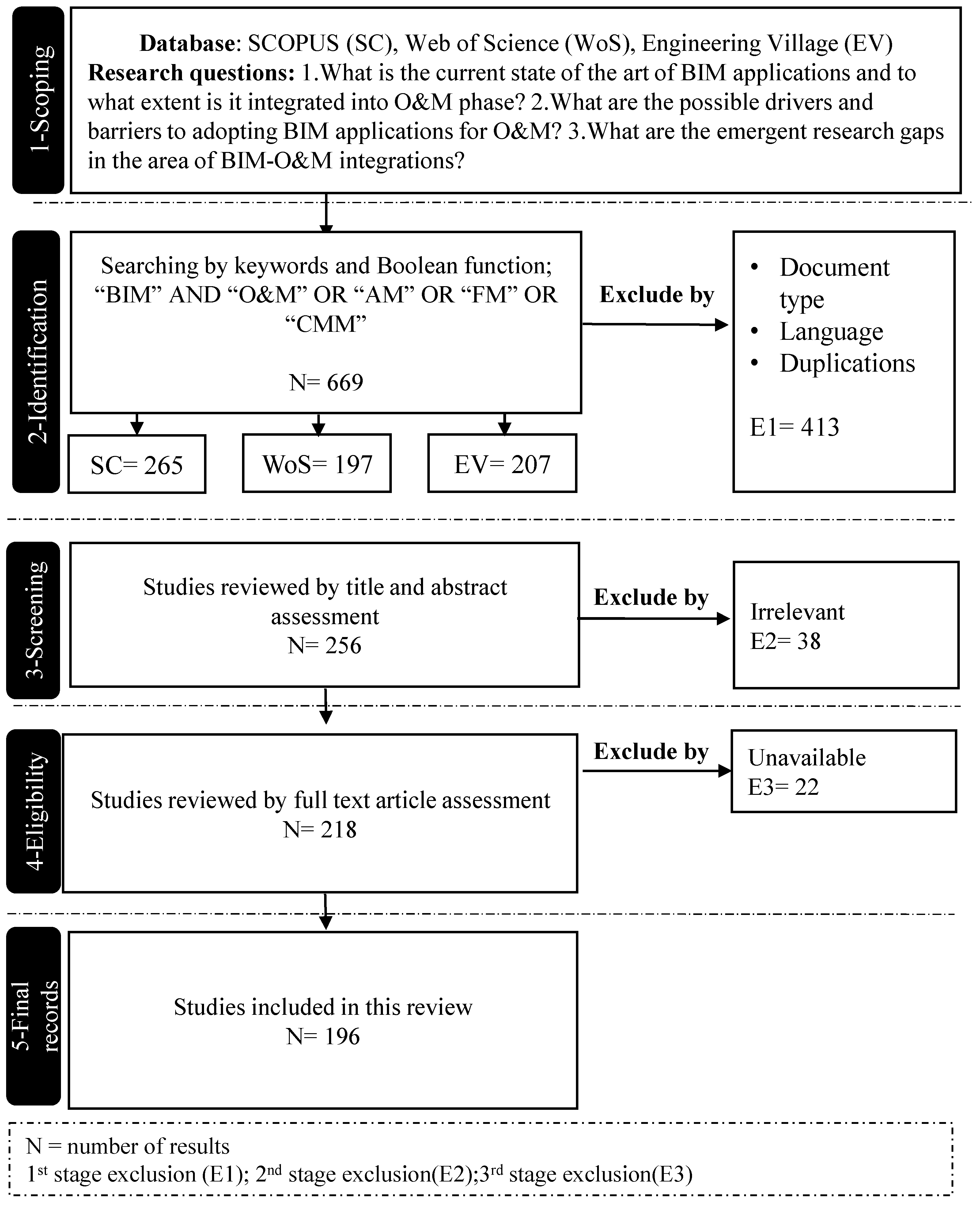

Figure 1. Flow chart for research methodology (PRISMA).

2.4. Screening

Although the inclusion and exclusion criteria defined earlier would have aided the definition of the primary articles, further assessment of relevance is also necessary to ensure maximum representativeness. As defined by PRISMA-P guidelines, screening entails brief scanning of titles and abstracts, but the full text of an article may also be examined if ambiguity is suspected. The following activities were implemented during the screening process:
  • Search results were filtered based on inclusion and exclusion criteria;
  • Duplicated articles were removed;
  • Each article title and, if required, its abstract/full assessment were reviewed to further establish relevance;
  • Related articles were then saved to a reference management platform (in this case Mendeley Desktop version);
  • The total number of included articles was recorded.

2.5. Data Extraction

The data extraction methods were a combination of qualitative and quantitative tools. The content analysis of this study draws on the methodology adopted in other review articles, such as [23,24]. This study analyses and categorises the existing research on BIM integrations within O&M by conducting quantitative and qualitative analyses. The bibliometric analysis in this review aims to provide the quantitative analysis element of the study by using statistical methods to analyse trends of academic publications to evaluate the existing research performance as well as understand the patterns [23,24]. The content analysis, on the other hand, provides the qualitative element by deriving themes based on the articles [23,24]. The study identifies seven main thematic functions from the content analysis which were drawn from the journal papers used in the systematic review.”

2.6. Quality Evaluation

The main forms of quality assessment implemented here were through the choice of search databases and the restriction of the included primary articles to just journals due to their higher reliabilities and validity resulting from their rigorous peer-review processes [22].

2.7. Synthesis

In this SLR, the text of each article was reviewed, and all relevant sections were critically examined in order to establish themes, sub-themes, relations, classifications and comparisons.

3. Findings and Discussions

3.1. Bibliometric Analysis

The bibliometric analysis results show that the first study addressing BIM in O&M was published in 2010, which coincides with the emergence of the concept of whole life/asset management strategies through the release of asset management standards, such as Publicly Available Specification 55 (PAS 55) in 2008/2009. In addition, Figure 2 shows growth in the number of publications on BIM applications within the O&M phases of construction and infrastructure over the last decade from just four articles in 2013 to 36 in 2019. Interestingly, 82% of these studies were published in the last five years, indicating that integrating BIM with O&M is still an emerging area of research.

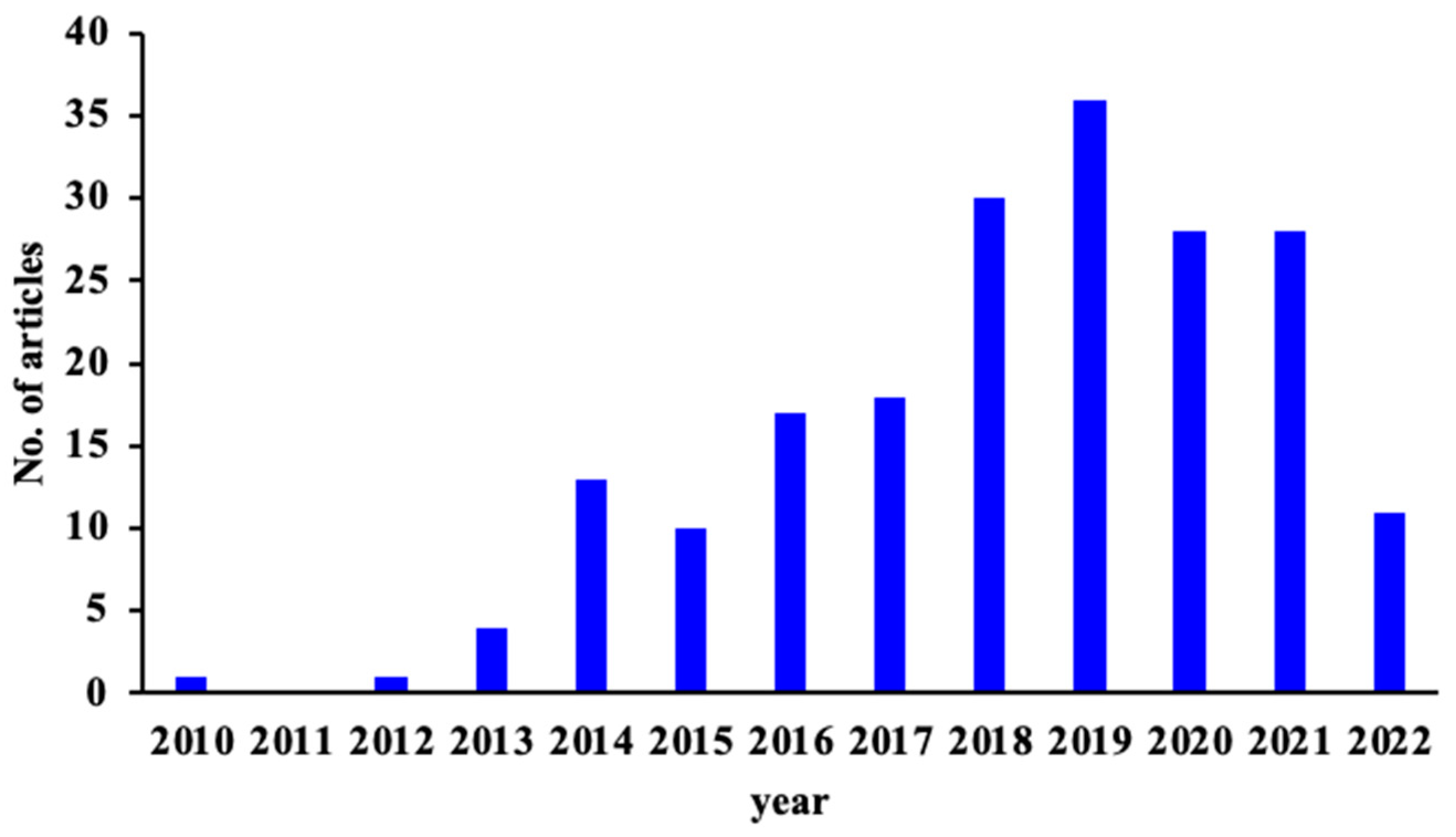

Figure 2. Annual distribution of articles.
Based on the search strategy and method (with outputs spanning over 13 years), the highest volume of publications focusing on BIM implementations in O&M were recorded in the “Automation in Construction” journal, with 30 papers of the total 196 articles selected for the study. This was followed by 19 articles from the “Facilities” journal and nine papers from the “Journal of Information Technology in Construction”. These top three journals account for almost 32% of the total number of publications. Moreover, the following three journals, namely “Built Environment Project and Asset Management”, “Buildings” and “Journal of Facilities Management”, published seven, six and six articles, respectively. In addition, “International Journal of Building Pathology and Adaptation”, “Journal of Building Engineering”, “Journal of Computing in Civil Engineering”, “Journal of Management in Engineering” and “Journal of Performance of Constructed Facilities” published five, six and four articles, respectively, as depicted by Figure 3. The remaining journals’ publication rates vary between one and three articles spread across 13 years (i.e., between 2010 and 2022). The bibliometric analysis further revealed that the largest number of publications originated from the United Kingdom (37), United States (36), China (16), Italy (16) and Canada (15), as shown in Figure 4. It does not come as a surprise that the UK and USA have the highest proportion of journal articles related to BIM applications in O&M. This could be because BIM was established in the USA and the UK government’s construction strategy advocates the adopting of BIM across all construction projects [25].

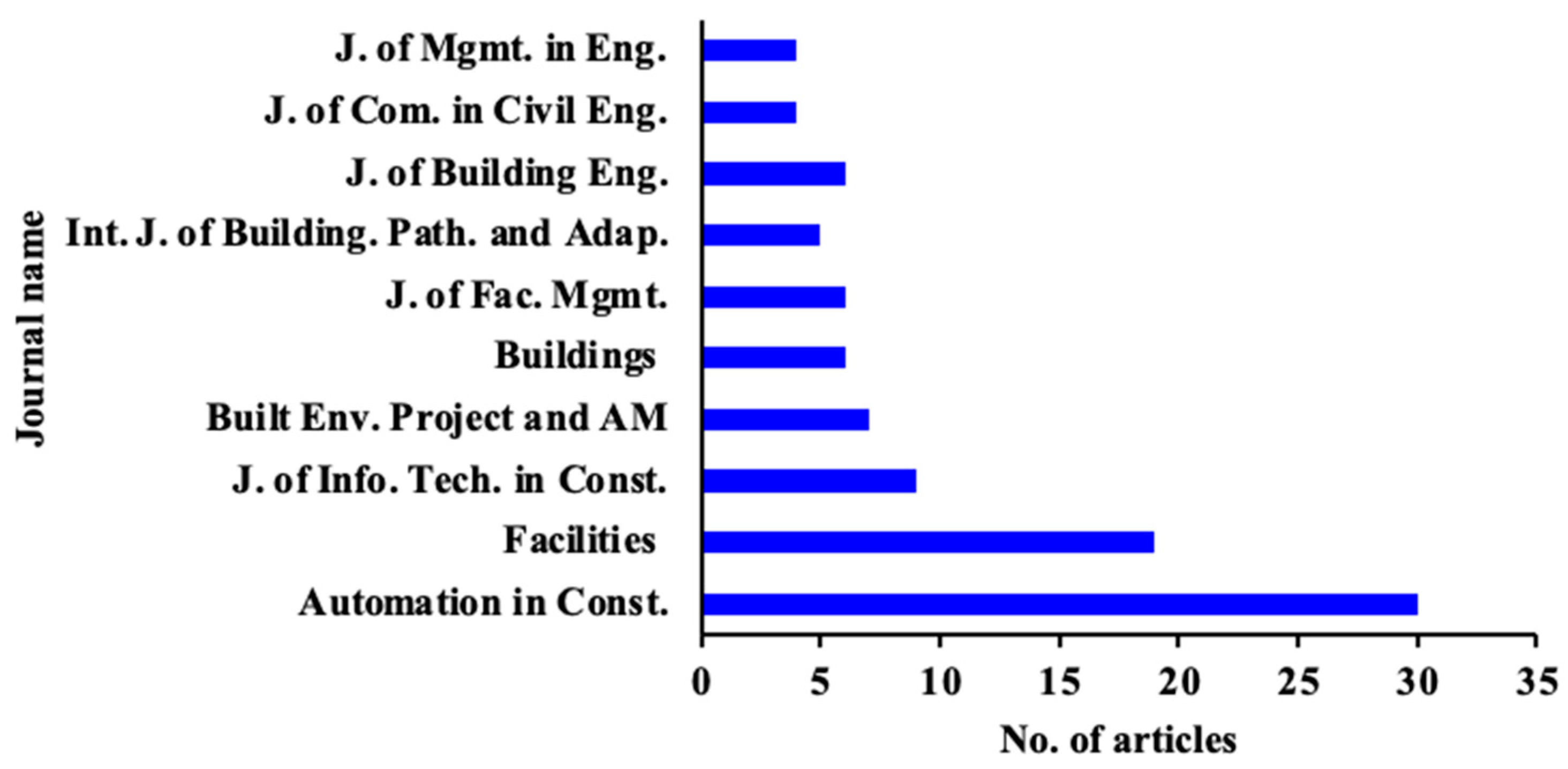

Figure 3. Top 10 journals with the highest research outputs.

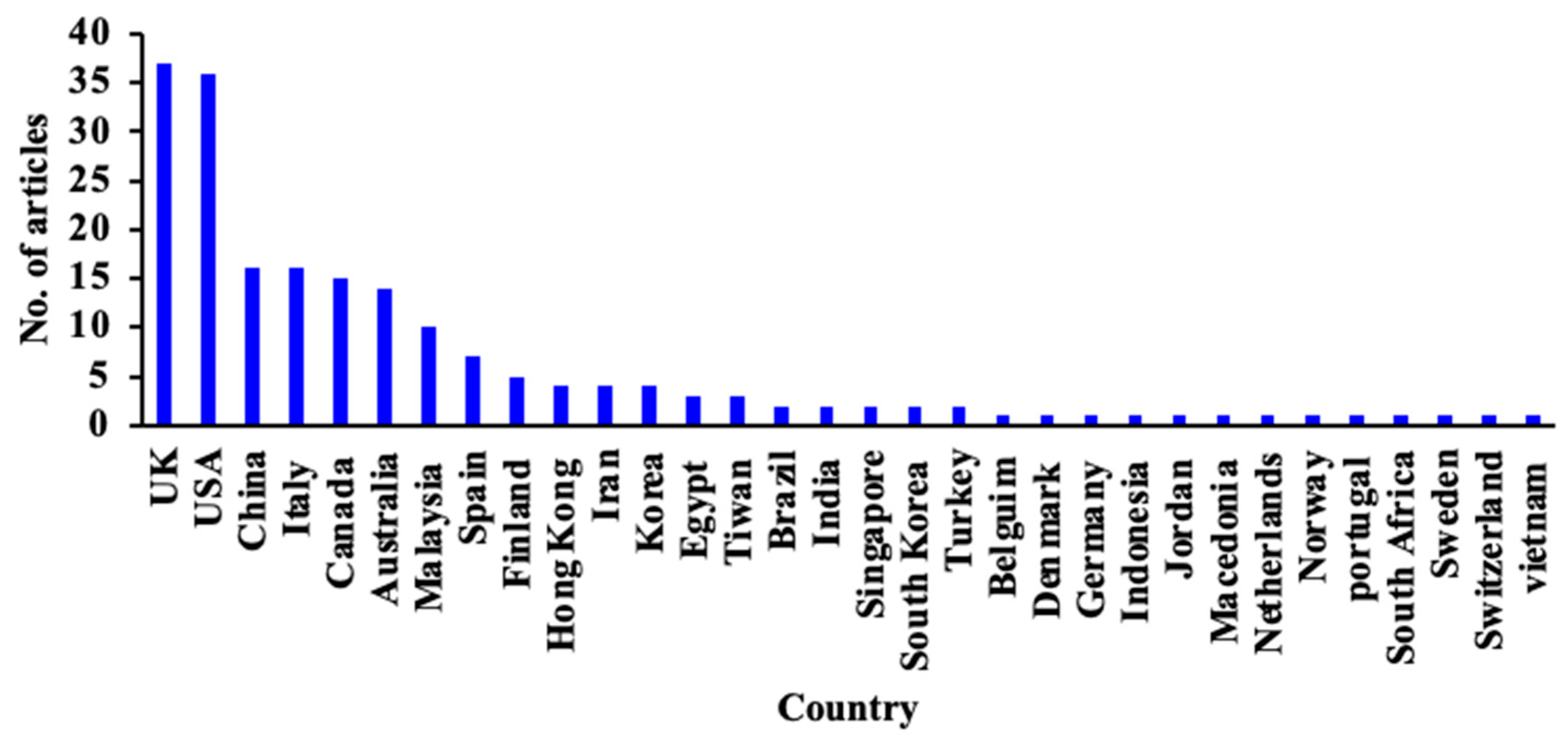

Figure 4. Number of publications per country.

3.2. Originality

Twenty of the 196 retained articles were literature reviews that focused on the integration of BIM in O&M. However, 15 of the 20 literature review articles addressed general BIM integration activities but were not specific to O&M. The areas covered include BIM for general FM and asset management [26,27], information technology [28,29,30], safety in facilities management [31], benefits and challenges for general FM practices with BIM [32,33,34] and interoperability [23]. These articles neither placed any emphasis on the actual use of BIM during the O&M phase nor addressed any specific features of maintenance. Thus, these reviews are limited in their discussions of BIM applications in the premise of O&M and they are very generic in their scopes, which clearly highlights that research gaps around the areas of improving BIM integration within O&M remain ambiguous.
Only the remaining five literature review articles [11,24,35,36,37] focused on reviewing the literature surrounding BIM in the O&M phase of construction and infrastructure, as presented in Table 1. According to Table 1, most of the studies regard FM as a unified set of functions rather than distinguishing specific activities. Despite the keyword phrases listed, very few studies have actually reviewed a specific maintenance feature or focused on an identified O&M scope. In fact, only two studies actually emphasized maintenance-related features. Marmo et al. [37] reviewed previous case studies that focused on the integration of BIM and O&M in order to develop a building performance assessment model to support maintenance planning and decision making along with the identification of clear information requirements, including their sources for each case study. However, their review did not identify the specific O&M features for the considered case studies. Xinghua and Pishdad-Bozorgi [24] classified BIM role into five main facets and proposed an interesting classification theme for maintenance and repairs, including information accessibility, augmented visualization, decision making support, root cause failure and maintainability analyses. Their review included 150 publications, but only 14 studies were explicitly devoted to BIM and maintenance. For this reason, one of the cornerstones of this SLR was to investigate what efforts have been directed towards identifying instances of BIM integration within O&M and to what level these integrations focused on specific O&M systems rather than general FM practices. To the best of the authors’ knowledge, there has been minimal emphasis on BIM applications with specific focuses on O&M systems. There are nearly no comprehensive reviews addressing the clear, specific and in-depth analysis of maintenance features and requirements with BIM. We, therefore, aim to close this gap through this review, as it provides detailed insights about the current efforts of BIM within the O&M phase, research trends and specific functions as well as sub-functions, which result in clearly identified research gaps.
Table 1. A summary of previous review studies with focus on BIM–O&M.

4. Content Analysis

In this stage, the 196 papers selected were rigorously reviewed. Each of the 176 primary articles (excluding the 20 review articles) was examined by identifying the aim of the research, year of publication, research methods deployed in the study, research questions or gaps addressed, main findings, critical overview of the strength(s) and limitation(s) of the studies, main function under which BIM was integrated with O&M, sub-function(s) corresponding to such integration(s), whether a specific maintenance scope was addressed or discussed, future recommendations, and whether the study highlights any possible barriers or obstacles to BIM adoption. In addition, the examination process identified all the different building types and infrastructures where BIM was integrated with O&M. In other words, this review paper critically examines the current literature to answer the research questions: (1) what is the current state of the art of BIM applications and to what extent are they integrated into the O&M phases? (2) What are the possible drivers and barriers to adopting BIM applications in O&M? (3) What are the emergent research gaps in the area of BIM–O&M integrations? In order to adequately answer these questions, the following additional sub-questions were posed to help guide the investigation process of the review: What are the main functions in integrating BIM with O&M? How are they defined? What are the sub-functions of these integrations? What types of building projects were studied, and under what functions were they targeted? Did the study focus on any maintenance-specific features? If so, what were they? What are the possible barriers to hinder such adoption?

4.1. Main Functions of Integrating BIM with O&M

Based on the content analysis, the articles were examined to identify themes and sub-themes based on their area of focus and scope within O&M. The analysis identified seven main functions for BIM integration with O&M. These functions are: information management (IM); advanced technology management (ATM); maintenance and asset management (MAM); indoor management (InM); performance assessment management (PAM); visualization management (VM); and lean management (LM). Additionally, an additional category was created to accommodate articles that more or less discuss BIM benefits and challenges within the broader field of FM. The seven identified thematic functions overlap and can be divided into: “what processes are managed”, “what in (these) processes is managed” (IM, VM), and “how (these) processes are managed” (LM). In other words, the seven thematic functions can be grouped into processes, functions and methods. The processes category includes all the activities and actions performed in order to achieve the integration of BIM within O&M. It includes advanced technology management (ATM); maintenance and asset management (MAM); indoor management (InM); and performance assessment management (PAM). The functions category deals with the specific scope of improving and optimising these processes, such as information management (IM) and visualization management (VM). Finally, the methods category includes the means of managing as well as conducting the functions and processes, such as lean management (LM). The classification of articles was based on a set of questions that fulfill each purpose or function, as shown in Table 2.
Table 2. BIM functions classifications.
Additionally, Figure 5 shows the percentage of publications under each function. One the one hand, there are indications that most research has been conducted on IM (38%), followed by ATM (23%) and then MAM (17%). On the other hand, the studies focusing on LM are relatively few with only three journal articles in total. Nevertheless, the classifications of the studies also revealed that among the selected articles, few studies discussed or emphasised a specific maintenance-related feature, activity, specification or purpose. This implies that almost 26% explored actual maintenance activities with BIM involvement, which further highlights that this is still a growing research area.
Figure 5. Percentage of BIM–O&M publications in each function.

4.2. Overview of Methods and Tools

The reviewed studies deployed various types of methods and tools within their innovative systems or proposed frameworks. Most of them used a mixture of approaches, for instance, case studies and programming or document analysis or simulation. However, the content analysis revealed 10 main methods from the literature, namely: case studies (CS), programming (P), expert-based methods (with data collection via survey, questionnaire, focus group and interviews), literature review (LR), document analysis (DA), technological methods (including videos, camera, sensors, etc.), simulation (SM), experiment (E), theories (grounded theory, technology-organisation-environment theory, activity theory) and reliability-based tools (fault tree analysis, failure mode and effect analysis FMEA, work breakdown structure WBS). Figure 6 provides details of the distribution of articles against methods, where it can be seen that majority of articles used case studies (93 articles), then programming (86 articles) and expert-based methods (63 articles).

Figure 6. Number of articles deploying each method.
Since almost 36% of the reviewed studies used expert-based methods with data collection via surveys (SV), questionnaires (Q), focus groups (F) and interviews (N), this review further investigated these methods by identifying: (1) the purpose of using each method; (2) profile of participants; (3) sample size; (4) scope; and (5) main BIM–O&M function considered, as can be seen in Table 3. Upon completing the analysis in Table 3, Figure 7 further shows that 41% of these methods included interviews, 19% used a mixture of tools, 16% applied surveys, 14% used focus groups and 10% used questionnaires. This emphasizes that interviews as well as expert judgment and opinions form a great source of information in the area of BIM–O&M research. Figure 8 presents the distributions of the average sample sizes that were considered reliable and sufficient with each method within the reviewed studies [43,44].
Table 3. Summary of expert-based tools, profile of participants, sample size and scope.
Figure 7. Percentage of each expert-based tool.

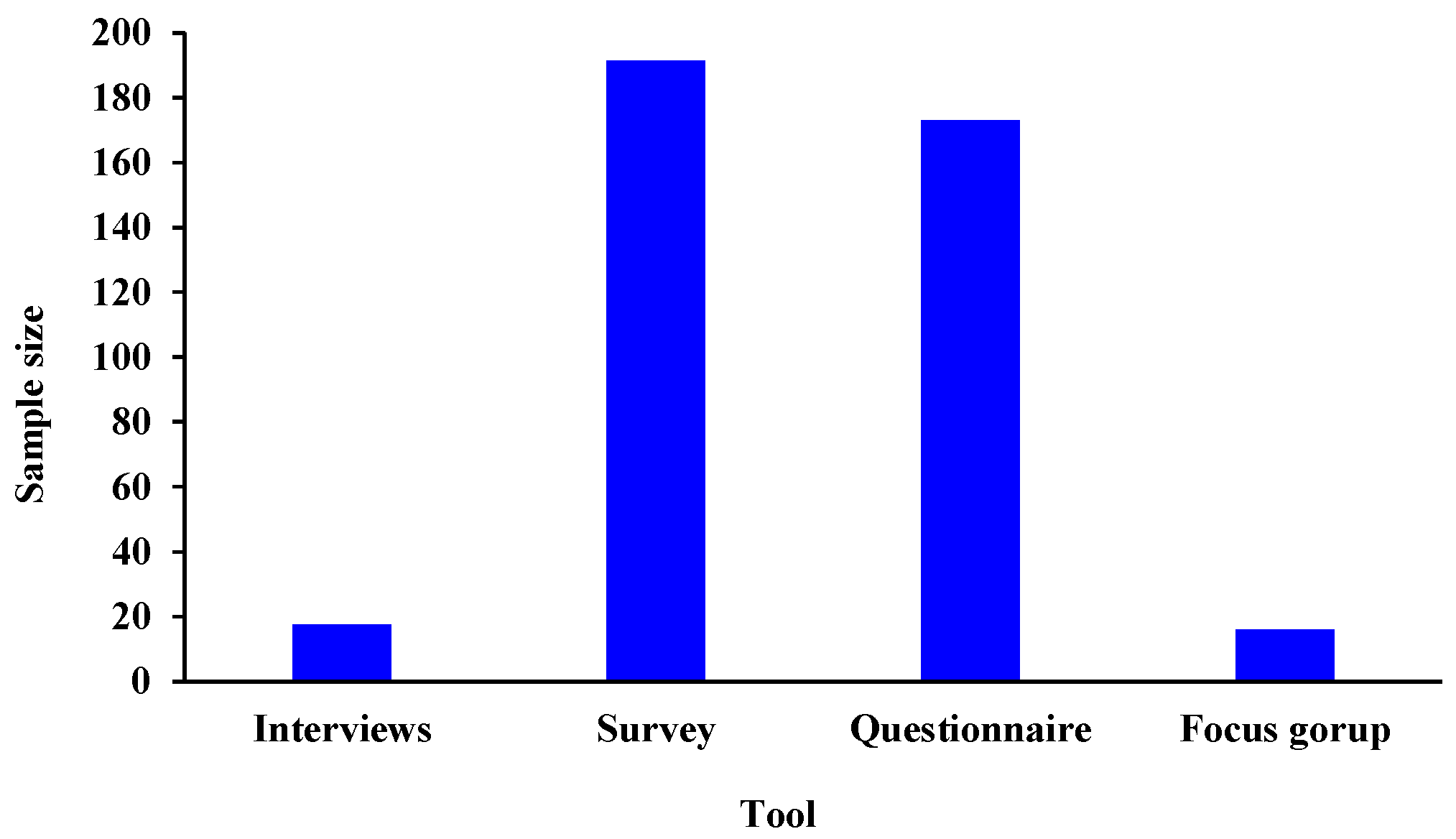

Figure 8. Average sample size for expert-based tools.
Additionally, Table 4 presents a matrix of the types of people-based tools that have been deployed under different integration functions. According to Table 4, the majority of the tools fall within the information management function, as it is one of the most crucial elements of asset management and BIM. Information is used to build asset registers and without accurate asset registers, there cannot be maintenance optimisation. Table 4 shows an opportunity to optimise O&M with BIM applications, especially in indoor management and visualisation.
Table 4. Number of studies using expert-based tools within individual functions.

4.3. Overview of Building and Facility Types

Figure 9 presents a distribution of the different types of buildings and infrastructure that have been considered by earlier studies, so as to better understand where research efforts have been concentrated as well as the underrepresented areas. For better comparisons, the buildings have been grouped into the following five main categories [20]. Residential buildings include different housing types, such as apartments, town houses or duplexes. Commercial buildings are generally used by businesses to sell products and services to clients and consumers. Examples are shopping malls, grocery stores and general stores. Industrial plants are mainly used to produce, store and distribute goods or services, such as manufacturing companies. Infrastructure indicates the physical structures required for the operation of certain enterprises, especially roads, bridges, HVAC systems and plumping systems. Institutional buildings refer to any type of building that fulfils the role of contributing to healthcare, education, recreation or public works. Examples include hospitals, universities and government buildings. As can be seen from Figure 10, the majority of the studies (44%) have focussed on institutional buildings, such as universities and hospitals, while 11% investigated how to enhance O&M with BIM in infrastructures and 9% explored the commercial sector. This indicates that further efforts can be given to explore BIM in improving the O&M phase in commercial, residential and industrial buildings.

Figure 9. Number of studies in each facility type.

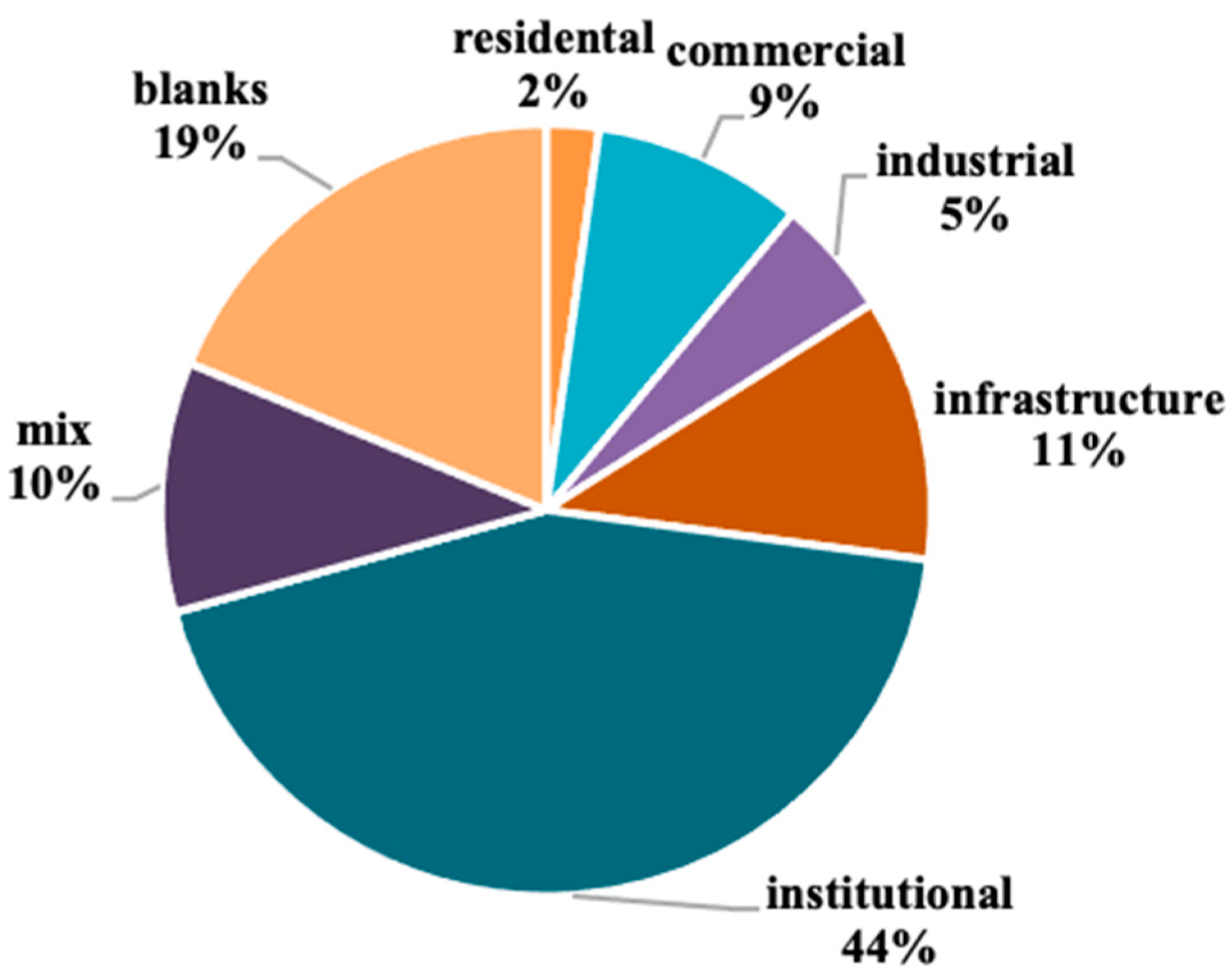

Figure 10. Percentage of studies on BIM–O&M in each building type.
In addition, the matrix in Table 5 shows what functions of BIM in O&M were explored with respect to building types, in which it is evident that information management (IM) recorded the largest portion of publications especially in institutional buildings, but that relatively low focus had been given to visualization management (VM) and lean management (LM). Another interesting finding is the lack of maintenance-focused BIM applications in residential and industrial facilities. The distribution also depicts a generally low research consideration for commercial facilities and infrastructure. Therefore, this matrix clearly highlights knowledge gaps regarding the classification of buildings covered and provides valuable means by which practical improvements can be implemented.
Table 5. Number of studies in each facility type in each function.

5. Overview of Existing Publications on BIM in the O&M Phase

Among the 196 articles retained (excluding the 20 review articles), 176 studies addressed different contributions in the field of operation and maintenance. These contributions have been classified into seven functions, as explained earlier in Section 4. In this Section, an overview of the contents of the individual studies within each of the seven functions will be provided, while further discussing their associated sub-functions to enhance the comprehensiveness of this SLR.

5.1. Information Management

Table A1 in Appendix A elaborates that the most notable research efforts of BIM applications within the O&M phase through information management can be classified under four areas—information requirements; data handling/exchange; failure analysis; and fault detection and diagnosis and O&M support.

5.1.1. Information Requirements

It is essential to have accurate and comprehensive data for FM teams to support effective decision making during the operations and maintenance phase. Many efforts have been devoted towards the definition of information requirements that can better drive the integration of BIM into O&M FM. Several researchers have focused on identifying clear information requirements for building handover processes. For instance, Thabet and Lucas [97] developed a seven-step handover framework to identify required data based on owner requirements for educational institutions, allowing clear data tracking throughout the integration process. However, further grouping of the proposed data would enhance the quality of data integration. Sadeghi et al. [98] used their framework to classify information requirements into five categories: location, specifications, warranty, maintenance instructions and construction specifications. However, the proposed model has been criticized for its lack of flexibility and its requirements for further customization and validations. Other classifications include those rendered by East et al. [99] whereby information was classified as either geometric-related or asset-related. Authors, such as Mayo and Issa [63], have focused on non-geometric information needs through the Delphi method but have not adequately considered the later O&M phase, as these identified information needs lack sufficient details in terms of which O&M systems/activities they relate to, and how to manage these needs once they are identified within the O&M systems. Nguyen et al. [90] claimed that the design, suppliers and BIM-FM teams are all key to the successful handover process. Additionally, the diversity of organisational needs were considered by [54,66,100]. Csavka et al. [66] presented a vibrant case study with numerous functions of FM practices and categorised information in alignment with organisational constructs, available technology, project artifacts and owner requirements. They [52] further categorised the level of information required in another study into: (1) maintenance personnel; (2) building management system; and (3) asset management. Hosseini et al. [65] proposed a typology matrix that shows: (1) ownership types of assets; (2) service delivery models offered; and (3) type of data and information. However, the finding of the study also needs to be tested within empirical settings to further validate applicability in real-life projects. Other efforts focused on addressing information needs for transportation [60], education [46,57,77,101] and cultural heritage [64,102]. In addition, information requirements and clients’ needs to improve asset management were investigated to enhance the BIM integration [62,84,103,104,105]. Most of these studies did not report back the benefits of such integrations on maintenance. Although these studies have focused on BIM within O&M, the justifications for quantifiable improvements, such as maintenance costs or maintenance scheduling, remain to be fully explored.

5.1.2. Data Handling

Other studies addressed data accessibility and handling issues which are also crucial for effective integration with BIM [82,106,107,108,109,110]. Lucas et al. [111,112] proposed a seven-model function to support facilities management in healthcare that allows better storage, retrieval and management of data. Interestingly, one of very few studies applied reliability analysis techniques, such as FMEA and FTA, to enhance the gathering of failure data. However, the study did not explore the later O&M phase as it did not show how learning from failures or how the collected data can relate to the optimisation of maintenance. Matarneh et al. [111] enhanced data handling by a reduction in manual data entry time through the integration of a computerised maintenance management system (CMMS) and computer-aided facility management system (CAFM). Alnaggar and Pitt [113] improved data flow by proposing a conceptual model based on applying basic project management theories. Yet, the full collaboration of policy makers especially towards standardising COBie is still lacking. Other attempts targeted the improvement of FM data collection by developing plug-in applications [58].

5.1.3. Failure Analysis and Fault Detection and Diagnosis (FDD)

The application of the principles of learning from failures (LFF) [114,115,116] to capture crucial maintenance activities and building deterioration characteristics has also gained traction over the past years. Regarding information management, Ismail et al. [89] integrated BIM with FDD and proposed an algorithm that reduces design specification defects for industrialized building systems (IBS) in Malaysia. Yang and Ergan improved the troubleshooting of HVAC systems issues by proposing a model process that generates a work order context, identifies applicable causes for reported HVAC problems and refines relevant causes. It is important to state that as valuable as these research contributions are to general BIM knowledge enhancement, they were more focused on how information was managed and integrated rather than exploring the required methods for capturing such data for FDD.

5.1.4. O&M Support

Several research endeavours around IM have considered how to safely and cost-effectively optimise O&M practices within BIM premises. Some of such notable studies include Ismail et al. [117] who identified five key features of maintenance management systems: defect assessment (DA), BIM maintenance assessing (BMA), expert defect diagnosis (EDD), remedial measures (RM) and database control centre (DCC). Shalabi and Turkanet [118] also investigated how to minimize the lead time of collecting high-quality data for corrective maintenance through IFC-BIM environments. Zhan et al. [119] improved the inspection and repair process through three key players—inspectors that routinely assess the actual conditions of assets through condition monitoring approaches, managers that make the ultimate decisions on resources and repairmen that execute the stipulated maintenance plans on site. However, despite the criticality of the identified job functions and their associated processes to the success of maintenance optimisation, the magnitude of improvements that can be realized regarding time and costs remains unclear. Additionally, the framework proposed by Zhan et al. [119] to improve information flow in the inspection-repair process through image classification algorithms is considered impractical, unless it allowed users to access the BIM knowledge repository from different computers over the internet. In addition, the framework has difficulties in recognizing similar images since any two identical microwaves would be difficult to differentiate according to the proposed algorithm. Liu and Issa [68] attempted to address the knowledge gap between design phase and FM by proposing a general facility maintenance knowledge database with an emphasis on the maintainability assessment at different life cycle phases and decreasing the number of maintenance interventions. However, no responses were obtained from professionals, such as structural engineers, fabricators or mechanical, electrical and plumbing (MEP) equipment manufacturers. Other areas of interests included location [120] and space management [121]. Safety in O&M was another emerging research aspect [122] with only two publications in 2018. Efforts to dynamically connect BIM-based H&S management system during O&M with programmed maintenance cycles for historical industrial plants was explored in [123]. Furthermore, safety by design to improve the O&M phase was studied in [124].
Among the selected articles under this function, very few publications have focused on specific O&M systems rather than general FM practices. It was found that most of the studies showed how to extract or link the data from a certain management system. However, this review reveals that very few studies addressed the fundamental problem of what data need to be acquired from specific O&M activities instead of general FM tasks prior to proposing a methodology for integration. In addition, most studies addressed information management efforts for general maintenance practices or general FM tasks; work on identifying information requirements for specific O&M tasks was scare. Examples can be seen in the study by Villa et al. [123], who specifically examined working from heights but without reference to O&M, unlike the study by Lee et al. [110] and Shalabi et al. [118] who considered in-depth corrective maintenance needs and Chen et al. [125] who focused on tunnel cleaning activities. There remains a lack of holistic guidance on how to collect data from O&M activities, what data to acquire, who should be responsible, which O&M activities are most critical and what resultant value is added to the integration with BIM.

5.2. Advanced Technology Management

It is vital to bridge the knowledge gap and the disconnection between the identified information requirements and their seamless integration across systems. The use of advanced technologies and techniques to allow for this integration through data processing and exchange between systems is extensively discussed within the literature, as summarised in Table A2 in Appendix A.

5.2.1. Augmented Reality (AR)

One of the earliest efforts are addressed by Lee and Akin [126] in 2010, who proposed a computational framework through the application of augmented reality (AR) to support computer-aided O&M. However, the proposed methodology only works for pre-defined physical markers, which limits its functionality in real-world applications. Additionally, the application is limited to the scenarios used in the experiment, which in turn necessitates further validations to better ascertain its robustness and proficiency. Gheisari and Irizarry [69] further advocated that locating building components and 3D visualisation are the most valuable aspects of BIM, as this was seen to fit with AR. In the same vein, Chen et al. [127] introduced a collaborative framework between BIM and AR through video streaming, thereby enabling current location of users, room identification, visualisation and interaction with surroundings in real time.
However, the application was not practical for outdoor environments or during power outages and suffered from quality resolution issues. This limitation was also found in the study by Williams et al. [128], whose application of AR with BIM was threatened by a loss of data resulting from poor drifting capabilities between objects. Gheisari et al. [127] pointed out the use of AR to improve healthcare facilities management but showed limited discussions regarding maintenance-related information. Similarly, studies by Ammari and Hammad [129] further supported the remote interaction elements of AR in FM. Yet, the approach they considered was criticised for being too physically demanding, requiring additional training due to its specialised skillsets as well as other critical adaptability challenges.

5.2.2. Open Standards and Semantic Web

Other efforts aimed at improving the quality and accuracy of data handling approaches were explored by many studies, including [43,130,131,132]. Recently, Moretti et al. [131] and Patacas et al. [43] focused on open standards with BIM and built a framework for data integration. Though it was described as flexible and easy-to-use, the framework was not validated and was restricted by its requirements for inputs based on specific data structure formats. Other researchers [133,134] have suggested that future research directions should focus on using a semantic web to support the integration of BIM with external data sources. Kim et al. [133] used the semantic web approach to improve work order processing through the integration of IFC objects and FM information. In their work, it was revealed that there is a potential to further enhance current practices by including LFF concepts as well as embedding other functions of FM. In another study, Niknam et al. [134] used a semantic web to integrate BIM with manufactured data.

5.2.3. Cloud BIM and Digital Innovations

A comprehensive description of the required standards, classifications, related vocabularies and object-oriented links for BIM in AM was discussed by Farghaly et al. [9]. However, the methodology was limited due to the absence of the required sensors and databases to retrieve relevant information. In addition, the framework could benefit from further validations with more case studies so as to enhance the understanding of its proficiency. One unique contribution was by Chew et al. [135], who applied the 5G network for smart building and smart facilities management (SFM) in Singapore and proposed a training framework that allowed higher density of internet of things (IoT) device connections, as in [136]. Other integration efforts were considered by Alwan [137], who focused on the refurbishment of housing stock, while Xing et al. [138,139] highlighted the interesting integration of Cloud-BIM enabled cyber-physical data and COBie for component reuse. However, to evolve the model platforms from prototype to practice, both strategies still need to further refine their technological solutions by enabling regulatory frameworks and feasible financial measures in the building industry.
Furthermore, Golabchi et al. [140] proposed automated approaches for FDD for HVAC systems to improve maintenance-related features. However, the proposed model is linear, which may not adequately represent real-life scenarios that are often associated with nonlinearities and dynamism. Marzouk and Ahmed [141] improved maintenance scheduling and planning for water treatment plants through laser scanning. Hu et al. [142] enhanced the repair management of MEP systems through a five-step approach: managing back-ups, reporting defects, assigning repair work, updating the knowledge library and logging the repairs. However, one drawback is the manual input of data, which is time-consuming and heightens the possibilities of human errors. An interesting study by Marmo et al. [143] improved maintenance management and building performance assessment by key performance indicators (KPIs) using IFC schema. However, these KPIs were not specifically designed to reflect and/or measure maintenance performance in terms of specific maintenance activities but were rather a general/ unified set of FM tasks. The study also presents clear tracking and monitoring strategies that are designed to keep track of corrective maintenance activities, planned maintenance activities, maintenance monitoring activities, performance assessment results through KPIs and all the actors involved within these processes.
Other efforts include the application of seamless data integrations and improved collaboration as well as visualisation in smart cities frameworks [144,145], natural language processing [146], big data [67], graph theory [147], digital innovations and mixed reality techniques [72,148,149,150,151,152]. This review shows that there is a lack of standardised processes and procedures for seamless information exchange between BIM and O&M systems. The majority of issues lie in the interoperability between different software that require different data structures and formats. When the integration takes place, data are either lost, inconsistent or duplicated.

5.3. Maintenance Management

5.3.1. Maintenance Types and Strategies

The review revealed that 25 articles were in the maintenance management category and these are summarized in Table A3 in Appendix A. Among them, four articles focused on proposing contributions towards the improvement of maintenance management with respect to optimising the different types of existing strategies. Cheng et al. [153] developed a data-driven predictive maintenance planning framework that was based on BIM and IoT to overcome the limitations of reactive and preventive maintenance of MEP components. The framework consists of an information layer and an application layer. Although the algorithm allows better failure prediction and more efficient resource management, the algorithm is dependent on user experience and requires training and repeated testing. Piaia et al. [154] introduced a software solution to improve the maintenance inspections of historical buildings. Dias and Ergan [70] proposed approaches for eliminating system redundancy and unnecessary data by identifying missing IFC attributes and using an efficient level of details for preventive maintenance, condition monitoring and asset management of HVAC systems. This study is considered one of the few that focused closely on optimising specific information requirements for maintenance types. One of the first studies to apply advanced innovative maintenance strategies was conducted by Ma et al. [10], who proposed a data-driven decision-making approach for equipment maintenance, based on reliability-centred maintenance (RCM). However, some data requirements are unachievable in practice, such as the approximate maintenance material cost. Nevertheless, only two studies (published in 2020) addressed the term “reliability” and the concepts of reliability engineering and asset management amongst the 196 articles selected for this study. It is worth noting that, since this review focuses closely on the O&M phase, more advanced maintenance approaches are expected to emerge. This review shows that studies that clearly contribute to specific maintenance approaches are underrepresented. These benefits are either generally discussed, or rarely reported. In addition, the means and methods of reaching them remain unclear and are rarely reported in the literature.

5.3.2. Maintenance Planning, Scheduling and Visualization

Improving maintenance scheduling through optimised planning is another emerging research area within the domain of BIM–O&M integrations. Fargnoli et al. [53] showed how BIM and product service system (PSS) models can be merged to enhance the maintenance operations of building components by better scheduling maintenance interventions. Valdepeñas et al. [155] focused on improving maintenance planning and scheduling of breakwater items in port infrastructures through a comprehensive crack failure analysis. Chen et al. [156] automated maintenance work orders scheduling through simple coding to calculate the optimum maintenance time and distance. However, their work was criticized for being limited to a single maintenance team. Hence, further validation is needed to account for scenarios that involve several maintenance teams working in parallel, especially during major overhauls, outages or shutdowns (MoOSTs) [157,158]. McArthur et al. [159] proposed a machine-learning algorithm to visualise, predict and classify maintenance work orders. Lavy et al. [160] investigated the effects of using BIM and COBie data for facility management (FM) to improve the efficiency of work orders processing. Another interesting study among the few who reported the practical benefits of BIM–O&M integration was the study by Chao and Tang [161], who proposed a BIM–IFC computer system through a radio frequency identification system (RFID) to improve maintenance performance. The study findings depicted a 72% improvement in time efficiency as well as a 50% maintenance cost reduction. However, the algorithm was judged to be too complex due to its heavy programming requirements, thereby necessitating extensive training for potential users as well as the risk of compromising privacy.

5.3.3. Maintenance Budgeting

Chao and Tang [162] proposed a BIM-based integrated management workflow design for the scheduling, costs and planning of building fabric maintenance. Their study focused only on fabric maintenance, namely, curtain walls. Maltese et al. [163] on the other hand introduced a set of data, procedures and tools to allow the quantification and planning of maintenance to generate a more refined budget through the introduction of an IFC-based appraisal. The inefficient maintenance planning results from ineffective methods and techniques for predicting the uncertainties in maintenance scheduling and costs during the O&M stage. This further emphasises the importance of BIM in O&M and its potential to offer significant maintenance cost savings through better planning [163].

5.3.4. Maintenance Information Management Systems

The review also revealed three studies that focused on aspects of maintenance information management. These can be seen in the study by Ismail [51], who studied eight cases for conventional methods of precast concretes in Malaysia, where they identified key problems with existing maintenance management systems and proposed some tailored solutions. However, one shortcoming of the study is that it did not demonstrate clear benefits or justifications for how this integration can exactly adopt BIM. Another study by Moretti et al. [164] focused on smart buildings and optimised maintenance services through ultrasonic sensors and introduced a smart automated maintenance system that is triggered by pre-defined frequencies within the maintenance plan and real space usage. The limitations of this study [155] include its lack of a clear demonstration of the practical benefits in O&M, lack of clearly outlined input data to be extracted from the maintenance plans and poor accuracy levels. Wanigarathna et al. [80] proposed a framework to support healthcare maintenance engagement through more rigorous assessment of the physical condition of built assets/built asset performance data, maintenance resource data and organisational performance data. However, the framework was only validated by the built asset management (BAM) team and further involvement and perspectives of other hospital departments (especially the clinical team) are needed for the validation of the prototype. This would highlight the critical interdepartmental details of the O&M issues and would further decrease the gap between the teams, allowing for more effective maintenance planning.

5.3.5. Asset Management

Although not particularly surprising, this contents analysis further confirmed that research related to BIM and asset management integration is still in its infancy. Some of the notable studies include that by Cecconi et al. [165], which demonstrated the feasibility of transferring existing asset management procedures and tools into a BIM environment through an office building case study in Italy. The transformation helped to address qualitative asset conditions. However, further guidelines and tools are required to fully integrate BIM with computer-aided facilities management (CAFM) systems and to overcome the challenge of interoperability and the poor quality of the data. Brunet et al. [85] explored the importance of using pilot projects with feedback loops in BIM and sharing experience to support continuous improvements in AM. Munir et al. [83] focused on the business value of BIM and identified six dimensions of value that BIM contributes to AM, including management, commerce, efficiency, industry, user and technology values. Guillen et al. [166] claimed that BIM benefits within AM are not well categorised, and in turn explored how BIM can be conceived as an AM tool.

5.3.6. Other Aspects of Maintenance: Safety, Quality, Accessibility and FDD

Other essential aspects, including maintenance safety inspection, have been addressed by Wetzel and Thabet [167], who looked at delivering asset-specific safety information to FM staff prior to initiating an FM task. However, their framework was considered laborious and extremely time-consuming due to the enormous steps involved. Additionally, the FM teams were not aware of the data requirements, due to the knowledge gap between the design, O&M and FM teams. Similarly, Kim and Kim [168] studied safety inspections with BIM for bridge structures and provided an improved list of requirements for BIM-based inspections to acquire efficient statistical data. Other research efforts involving FDD can be found in [86], which supported maintenance decision making through case-based reasoning, with a focus on 21 predefined knowledge attributes. The proposed system consists of two modules: a BIM module to capture relevant information and a case-based reasoning (CBR) module to capture the operational knowledge of maintenance activities. Similarly, Motamedi et al. [169] focused on integrating BIM with a computerised maintenance management system (CMMS) to improve decision making through root cause failure analysis. However, the obvious limitations of this approach include the absence of an in-depth analysis of the assets’ deterioration rates, a limited scope of failure classes covered and a lack of demonstration of how maintenance can respond to the discussed failures.
Furthermore, “design for maintenance” was first and only seen in the study by Liu and Issa [48], who focused on maintenance accessibility with BIM for an MEP component. This highlights the fact that there is a further need for more studies to focus on maintenance accessibility and maintainability with BIM in O&M. Another aspect is related to improving maintenance quality aspects in post-construction phases as in [170], in which five significant areas were identified to improve the quality and performance of FM, namely: centralised system, visualisation, simplification, modifiable system and smart emergency escape. However, no clear demonstration of maintenance-related tasks was noted in the study.

5.4. Indoor Management

Another important aspect of BIM in O&M is indoor management. This review shows that BIM applications in this domain are scarce. Only eight publications focused on indoor management, as seen in Table A4 in Appendix A. These articles addressed different contributions which are classified under thermal comfort, visual monitoring and locating buildings’ components.

5.4.1. Thermal Comfort

Some studies focused on occupants and their satisfaction through enhancing thermal comfort for users. Some of the prominent studies within this domain include those by Carbonari et al. [171], who proposed a framework that combines the cyber-physical systems’ (CPS) technology, the holonic approach, and overall throughput effectiveness (OTE) metrics to efficiently diagnose the causes of buildings’ shortcomings in terms of indoor climate comfort, after which adequate refurbishment or maintenance plans are implemented. Similarly, Valinejadshoubi. et al. [172] focused on the virtual visualisation of buildings’ thermal conditions by integrating sensor-based alert systems with BIM, which provide real time data for thermal comfort monitoring. However, the proposed approach was limited to the capabilities and quantities of the sensors deployed.

5.4.2. Visual Monitoring

Alavi et al. [59] looked at how risk assessment models can improve the visualisation of occupants’ feedback and support decision diagnosis for heating, ventilation and air conditioning (HVAC) systems. Antonin et al. [173] showed how the visual monitoring of building occupancy through image recognition sensors can improve planned cost savings in FM by 40%. However, neither Alavi et al. [59], Valinejadshoubi [172] nor Antonino et al. [173] considered the clear benefits and relationships of the proposed methods on the building’s O&M phase. Recently, Ergen et al. [61] formalized a strategy to integrate occupants’ feedback with BIM for FM in office buildings via semantic data models. Similar efforts for real-time thermal monitoring were seen in [174,175].

5.4.3. Location of Buildings’ Components

Another fundamental area in the domain of indoor management relates to the location of buildings’ components as discussed by [176], who proposed a framework for integrating passive radio frequency identification (RFID) with BIM to assist indoor localisation for preventive maintenance. Yet, the study did not show precisely how the preventive maintenance activities were improved, thereby implying that the suggested framework required further validations, especially with regards to the demonstration of quantifiable benefits within the O&M stage.

5.5. Performance Assessment Management

Building performance assessments depict the ability of buildings to carry out their functions and objectives. Few research efforts have highlighted building performance assessments from various angles [177], as shown in Table A5 in Appendix A.

5.5.1. BIM Competency

Giel and Issa [14] proposed a framework to evaluate BIM competencies for facility owners. They proposed an assessment tool based on 12 specifically tailored competency categories, covering 66 critical factors used for BIM maturity assessment and highlighting that 47%, 29% and 24% were operational, strategic and administrative competencies, respectively.

5.5.2. Energy Performance

Another study for energy performance assessment discussed by [15] shows a framework for utilising feedback loops from building energy consumption to improving design and facility management, thereby narrowing the knowledge gap between the design and maintenance phases with respect to energy prediction and consumption, since it allows for a quicker design and performance review to highlight abnormal consumption trends that may require further investigation. Nevertheless, the limitations of the study include: (1) the rigour associated with structuring building management system (BMS) data prior to loading into the prototype, and (2) the data provided do not show any justifications regarding consumption levels and trends.

5.5.3. Building Deterioration

A recent study by Wu and Lepech [178] introduced a framework that integrates BIM with building durability and deterioration assessment models that are based on simulated trends. However, the assumptions of the model could benefit from further validations through multi-scenario sensitivity or parametric analyses. Following the same vein, [13] assessed residential buildings’ performance through sensors and [75] focused on assessing green buildings through asset information modelling. Another area of performance assessment is information quality assessment for asset owners. Zadeh et al. [49] proposed a framework for creating and performing BIM-IQA tests for asset and space management purposes. However, the IQA dimensions are limited to the definitions of the study, thereby necessitating the need for more case examples to expand as well as validate the quality aspects.
In general, this SLR shows that the majority of performance assessment studies do not address their impacts on O&M or focus on the performance of the O&M phase itself. This implies that there is still a lack of studies addressing the critical O&M activities that are crucial to building performance. Additionally, there is a need for studies that address the questions of: what performance standards are considered acceptable for these activities and how can certain O&M performance data be operationalised to conform to a given BIM–O&M system?

5.6. Visualization Management

5.6.1. Disaster Management

Table A6 in Appendix A summarizes the studies focusing on visualisation management. Jung et al. [179] discussed fire safety and disaster management and proposed a building fire information management system that is based on management, object, information and report modules. The framework was constructed around these four modules to enhance decision making and improve the accuracy and speed of fire rescue activities. However, one of the shortcomings identified is its lack of automation, especially for fire information sensors (e.g., fire, smoke and flame). Additionally, the model can be described as still in the conceptual stage and would need to be validated by testing its robustness experimentally or using the data acquired under real-life scenarios.

5.6.2. Infrastructure Visualization

Vilventhan et al. [180] studied BIM 4D application in infrastructure relocation management, but the practical benefits of the built 4D model for underground maintenance were not explained. The bridge reliability assessment was also studied by Chan et al. [181], who proved that advanced imaging techniques can create a consistent approach to inspecting a structure and assessing for visual signs of deterioration, determining the quantities for a given maintenance work order and documenting the maintenance history. While the former research explored the visualisation of data and application navigations, Neuville et al. [47] focused on visual counting tasks. They proposed an experiment-based algorithm with the best 3D viewpoint within the BIM model for a given MEP system.

5.6.3. Failure Localization

Other integration techniques involved BIM-GIS, as in the work of Mirarichi et al. [182], which had a framework that could overcome failure localisation issues of old barcode systems that was discussed based on three premises—damage reporting, fault message forwarding and work order closing. However, the model was criticized for its user-dependence and perceived inaccuracies, which may prompt the need for further evaluations with multiple cases. Yalcinkaya and Singh [55] proposed a user interface for a visual COBie search with BIM to overcome the usability challenges commonly encountered with COBie, but did not explore the O&M phase.

5.7. Lean Management

Lean management is a new as well as interesting area of focus with regards to BIM–O&M adoption. However, only three publications were found in this domain between 2018 and 2020, as shown in Table A7 in Appendix A. Nascimento et al. [56] applied lean principles to improve FM through a conceptual framework that relates the PDCA (Plan-Do-Check-Act) cycle in the real-world application of a shale process plant. However, the study lacks an explanation of benefits adopted from the BIM-Lean approach. McArthur and Bortoluzzi [76] proposed a lean-agile FM–BIM approach to prioritize operational physical data to support asset management and maintenance activities. However, some of the challenges associated with the approach include the limited number of implemented BIM uses in the project. Shou et al. [50] have recently discussed a framework for the lean production theory to improve project management performance in turnaround maintenance projects in the oil and gas industry through a single representative case study.

6. Drivers and Barriers to BIM Adoption in O&M

Although owners perceive the promising potentials and benefits of utilising BIM in the O&M stages, many still feel uncertain about where to begin. Establishing a baseline that informs where the organisation should stand prior to the integration of BIM in O&M is one of the most critical success factors for this integration. These pre-defined drivers can support business owners in expanding their technical knowledge, refining detailed information requirements during the O&M phase and subsequently enhancing the efficiency and sustainability of the integration. This review further explores the various drivers to support and facilitate BIM–O&M integrations as summarized in Table 6. These drivers are classified into three categories, namely: technical, organisational, and legal and contractual drivers.
Table 6. Drivers to BIM–O&M integration.

6.1. Drivers

6.1.1. Technical Drivers

One of the most important drivers for this integration is the need to digitise the predominant manual data input processes during project handover. BIM is expected to result in cost savings and a reduction in the man-hours that most FM teams will spend during the recreation of data files in their systems. This further facilitates data handling and improves the efficiency of accessing, tracking and modification through reductions in duplications and downtime [109,181]. Another motivation is the great potentials BIM can offer in terms of improving and updating preventive maintenance plans and schedules. In fact, improving the visualisation and tracking of data can enhance failure detections and reporting [183]. BIM can also be used as a tool to manage feasibility studies and propose rehabilitation models that support representative decision making to asset managers. Furthermore, within the rapid developments in technology, several methods have been proven to facilitate and ease BIM adoption in O&M through improved streamlining, such as mixed reality (MR), augmented reality (AR), artificial intelligence (AI), internet of things (IoT), virtual reality (VR), etc. [135].

6.1.2. Organisational Drivers

Once clients are aware of the potential enhancements of BIM in O&M, industry experts and facility managers then strive to reach competence and excellence in the integration process. According to Giel and Issa [14], these competencies in adopting BIM in O&M can be classified into: operational, administrative and strategic factors. Additionally, it is important to note that management involvement is vital to the success of this adoption as this pushes and motivates a collaborative platform among the different parties and stakeholders within BIM–O&M [85]. Additionally, owing to the ease of sharing and extracting data via BIM, the communication between the involved departments is improved which further accelerates this integration.

6.1.3. Legal and Contractual Drivers

The governmental guidelines and legislations push facility owners to integrate BIM in O&M to comply with legal requirements [15,183]. One of the top leading guidelines is the UK construction strategy of 2016 that mandates the use of BIM for all construction projects [25].

6.2. Barriers

In an ideal situation, BIM models should be easily linked with FM software packages and maintenance systems. However, these integrations may not always be easy or practical due to many challenges and limitations. This review classifies these barriers to BIM adoption in O&M into three categories, namely, technical, organisational and legal/contractual barriers, which are summarized in Table 7 [32,186].

6.2.1. Technical Barriers

The technical barriers include two sub-sections: method-related and data-related barriers. FM teams are not always aware of the information requirements that support BIM in O&M or the potential contributions BIM can provide [143]. This results in an unclear BIM–O&M workflow and the absence of clear guidance to enable such adoptions in the O&M environment. Another limitation is the undefined business values that BIM–O&M harmonisations can offer [8,183]. Studies show that identifying the potential return on investment (ROI) associated with BIM in this stage remains a challenge due to the absence of practical and quantifiable evidence. This hinders the integration between BIM and O&M and sometimes demotivates facility and asset owners [183]. Additionally, the design and construction phases of projects are synonymous with creating numerous files with different formats. These files become incompatible at a later phase, especially when using BIM and require modifications and re-processing which requires effort and time, and most importantly, raises the issue of interoperability [8,9,60]. This forms another issue of losing data throughout the format exchanging process. Previous studies have showed that establishing standardised libraries and BIM protocols, such as the NBS National BIM library, standardised data models, such as Construction Operations Building Information Exchange (COBie) and BIM level 2 protocols, and advanced digital programming techniques, such as customised APIs, add-ons or extensions to BIM authoring or facility management software help to minimize this gap. In addition, several studies supported the use of industry foundation classes (IFC) as a neutral data format extension which enables inter-data exchange in an information model without a loss or distortion of data [99,107,112,118,133]. However, it is important to note that these protocols do not identify the type of information that needs to be provided, when and by whom. Furthermore, BIM needs to be continuously updated, and when data are entered manually, the long process may cause inaccuracies in updating BIM models due to data duplications or unavailability [187]. Therefore, during handover, the poor quality of information (either due to the loss or absence of data) creates a knowledge gap between FM and O&M [9]. An additional drawback is the current number of software operating under the same system. FM personnel use different platforms and systems continuously, including CMMS, CAFM and Revit [67]. The selection of each system depends on various factors, such as the objectives, scope and complexity of the project. Additionally, the geographic dimensions play a major role in adapting these systems, if such integrations are to be effectively managed on a global scale. This compromises legacy systems, increases the complexity of the process, especially among stakeholders, and deaccelerates the pace of these integrations.

6.2.2. Organisational Barriers

Organisational barriers are categorised into people, culture and costs. Currently there is a lack of case studies that show real evidence of the economic benefits of integrating BIM into O&M. Therefore, clients fail to demand such integrations due to a lack of awareness of its potentials. As discussed previously, the technical challenges raise many other organisational barriers, including communication and collaboration between stakeholders and asset owners, leading to a reluctance to change, whereby teams refuse to share information with one another [16,183]. Additionally, the absence of clear guidelines for integration leads to the absence of clearly defined roles and responsibilities for both facets (i.e., BIM and O&M) [8]. Another important challenge is unclear management support and the gap between high-level business objectives and BIM models. Therefore, an effective integration between BIM and AM within the O&M life cycle phase would require inputs and support from top management to facilitate the directions for such adoptions. Aside from the initial investment costs, integrating BIM into O&M requires skills and time, thereby necessitating the provision of additional training that correspondingly heightens human resource costs [16,155,183]. Furthermore, overcoming the technical issues related to files and systems, the organisation would need to invest in information management solutions. Thus, investing a sufficient amount of funds in the pre-construction phase may be a strategic step towards successful BIM adoption.

6.2.3. Legal and Contractual Barriers

Since BIM–O&M integration requires different systems to operate, the allocation of data ownership becomes extremely complex. In addition, requirements, such as insurance and licensing, are mostly issued for limited reuse, which makes it more challenging for project stakeholders to understand the copyright restrictions associated with different classes of data [16,187]. To ensure a seamless integration, data ownership needs to be agreed on from the early stages of the project, but the authenticity and reliability of these models can be threatened by cyber security breaches. Therefore, for the cyber and electronic systems to be used for routine deployment as well as operating BIM within O&M, they must be fortified in order for such systems to appeal to organisations [173]. Table 7 depicts some of the barriers to BIM-O&M integra-tion as reported within the articles included in this SLR.
Table 7. Barriers to BIM–O&M adoption.

7. Discussion of Research Gaps

7.1. Research Gaps in BIM–O&M Integrations

This holistic review identified gaps in the body of knowledge in the area of BIM–O&M integrations. These gaps are mapped into the project life cycle of the Project Management Institute (PMI). Al Naggar and Pitt introduced a conceptual framework to manage BIM/COBie asset data using a standard project management methodology [113]. However, this study adopts the phases of a project life cycle in order to systemize the flow of knowledge gaps for all project stakeholders [193]. This can further help academics and industry professionals develop robust frameworks for BIM adoption in the O&M phase. The five phases of project life cycle as per PMI are: initiation, planning, execution, monitoring and controlling, and handover/closeout phases. Figure 11 below demonstrates how research gaps fall within these phases.

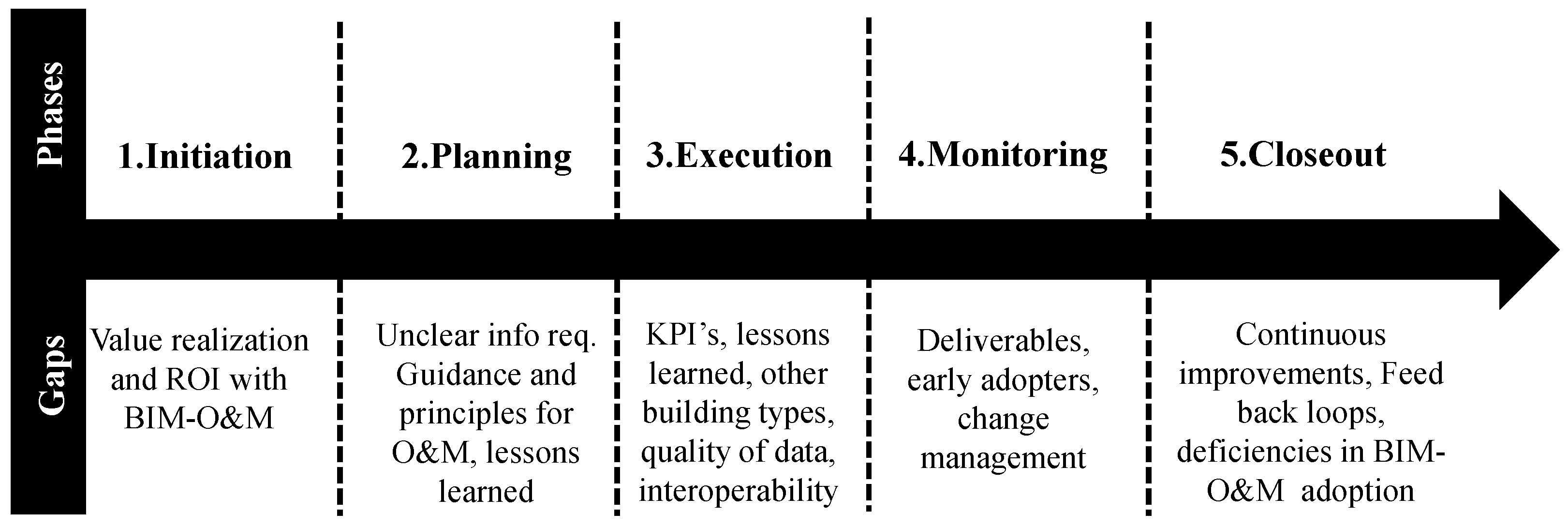

Figure 11. Research gaps mapped against the phases of the construction project life cycle.

7.2. Identification of Research Gaps

7.2.1. Value Realization and ROI with BIM in O&M at the Initiation Stage

The purpose of the initiation stage is to make sure that the scope of the BIM–O&M integration project is properly defined. This stage includes all the information required for strategic planning and investment justifications along with the value propositions for BIM in O&M. However, the ROI analysis required at the initiation stage remains a challenge. There is a gap in identifying the positive impacts of BIM in O&M. Although there are some studies reporting the general benefits of BIM in FM, very few case studies have provided proof of practical benefits in terms of cost [126,163]. The reason for this is the lack of means to quantify the benefits resulting from adopting BIM in the O&M phase of the life cycle. While the design and construction phase accounts for about 2 to 5 years of typical life cycles, the O&M phase on the other hand often accounts for approximately 20 years of the life cycle, making it more challenging to adequately assess the positive impacts of BIM. Therefore, one of the biggest challenges is to justify the ROI with BIM in O&M against the investment costs. Although few studies reported benefits in time and cost, none have clearly justified or validated how BIM in O&M can result in a positive ROI, neither theoretically nor with real case examples. Future recommendations include: studying the associated costs related to the O&M phase and the potential savings/benefits to help in realizing the positive value of BIM within the building life cycle.

7.2.2. Guidance and Principles for the Integration of BIM in the O&M Phase at the Planning Stage

After the scope of the project has been defined, the construction supply chain will plan to deliver this scope. When integrating BIM with O&M, the plan should be as detailed as possible since it is the most critical stage for setting out the foundation of the whole integration. The plan should include all the required information for specific roles and responsibilities for all stakeholders, the schedule and clear deliverables. However, facility managers and business owners do not fully understand or realize the information requirements for integrating BIM with the O&M environment [82,183]. The review shows that there are a lack of best practice and case studies addressing such integrations. Even though each organisation is different and diverse with regards to the nature of their business, there is still a research gap related to the generalisation of the requirements and information needed in the O&M scope. Further efforts are still required to explore the fundamental O&M information needs, classify these needs and identify specific deliverables, as well as the tools and methods for presenting the findings, so as to better support the integration of BIM in O&M. This review shows that the scope of O&M with BIM, the critical activities, subsystems and the required information for individual maintenance tasks within different facility types are yet to gain the desired attention. Future recommendations include answering questions such as: What type of data is required for O&M? Who should provide these data? What are the means of collecting and collating them? When should these data be integrated or collected, and how exactly should this integration fit into wider asset management strategies?

7.2.3. Interoperability and Information Logistics in the Execution Stage

In this stage, the construction supply chain and all the project stakeholders collaborate for the actual implementation of the integration of BIM in O&M. This requires data processing and transfers through the concurrent application of different software packages and programmes, which in turn raises the issue of interoperability. Interoperability remains a challenge for adopting BIM in O&M [8,9,60]. The compatibility between BIM and the different applications used during the life cycle (e.g., CMMS, CAFM and BAS) is still limited. This often entails laborious manual interventions, which are time-consuming and detrimental to the adoption process. Although a lot of studies have proposed systems architectures, frameworks and solutions to reduce this knowledge gap, the lessons learned and early adopter examples are yet to be investigated. In addition, Construction Operations Building Information Exchange (COBie) being the primary language exchange with BIM still has many limitations and is not widely adopted by the industry. Case studies prove that manual data entry in COBie and the required format structures delay the integration process [8,9,60]. This is perhaps why several studies [14,81] have advocated that some of the pressing future research areas should encompass mapping a seamless process for data exchange for BIM and O&M.
Another vital challenge in the integration is the information quality. Many software and applications are applied across the different life cycle stages of a typical building. When BIM models are integrated, the data needed from these systems lack unified structures and require individualised formats prior to data entry [187]. The literature [182] indicates that a major part of the problem is the process of updating, modifying and transferring data, which immensely contributes to the loss of information, unnecessary duplications data and quality issues. Therefore, when the integration process takes place, most data in BIM models are either inaccurate, lost or unnecessary [9]. In an attempt to alleviate this challenge, Cavka et al. [49] explored how to enhance information quality assessments with BIM for general FM requirements. However, as valuable as the findings from their study [48] are, the case examples applied were limited in complexity and dynamism, which may undermine the like-for-like transfer of knowledge gained to real-life scenarios. Therefore, future research endeavours should include identifying quality evaluation processes for a wider range of scenarios, so as to ensure information quality through the integration.

7.2.4. Performance Assessment with BIM in O&M in the Monitoring Stage

Once the integration has taken place, the project’s performance is measured to ensure its compliance with schedules and budget. It is vital to identify the key metrics that actually assess the integration. To accomplish this, it is imperative to initially identify the most critical activities in the O&M phase with regards to BIM, and this is an underrepresented area within the existing body of knowledge. Many researchers have reported methodologies for assessing as well as monitoring building performance [13,14,15]. However, none have identified key performance indicators (KPI) for BIM in the O&M phase, although a few authors, such as Eadie et al. [16], investigated general KPIs for BIM, but were not focused on the O&M stage. Assessing maintenance performance with BIM is less explored and demonstrated and future endeavours should encompass methodologies for identifying the most critical maintenance systems for the success of BIM integration, after which they can be monitored through dedicated O&M KPIs.

7.2.5. Lessons Learned, Early Adopters and Change Management in the Closeout Stage

In this stage, the project stakeholders collaborate to perform a final quality check to ensure that the integration of BIM in O&M meets the initially stipulated requirements. Once approved, it is important to address and document all the lessons learned for continuous improvement. This review shows a lack of studies that clearly address possible inefficiencies, drawbacks and limitations that BIM–O&M integrations can encounter, which would impede the ability of asset owners to learn from previous experiences. Furthermore, managing the lessons learned from these aspects is rarely reported. Moreover, adopting BIM in O&M is expected to inform several organisational changes within the managerial and technical realms. Therefore, future emphasis should be made on incorporating learning from failure and success frameworks, so that the feedback loops address questions such as: What are the effective and ineffective O&M requirements with BIM? What are the critical O&M inefficiencies best suited to be improved by BIM–O&M integrations? What were the encountered challenges and how were they solved? What is the level of expectations of BIM–O&M and how can it be defined?
In addition, this SLR exposes the lack of case studies and expert engagements that focus on O&M for different facility types. For example, Becerik-Gerber et al. [8] conducted a comprehensive survey to identify the application areas and data requirements for BIM in FM. Their study only considered general data needs for all facility types. Nevertheless, different types of facilities have different O&M needs. Therefore, future endeavours should include conducting more focused surveys on specific building types with O&M activities at their core. This SLR also highlights that the least investigated buildings types within the existing literature are residential, industrial and commercial buildings.

8. Conclusions

Although research and practice have somewhat highlighted the potentials for BIM to support the O&M phase of a building’s life cycle, studies that adequately explore how to enhance BIM-enabled facility operations and maintenance are still underrepresented. While a few review articles have attempted to harmonise the limited research outputs within this field, none of these reviews are systematic, making it difficult to ascertain the justifications for the selected articles and timeline covered. Against this backdrop, the current study contributes to the existing body of knowledge by logically evaluating, analysing and summarising the current literature surrounding BIM–O&M integrations, including identifying research trends that would eventually support the planning of future research endeavours. The well-established PRISM-P approach to systematic literature review (SLR) was used to generate, classify and justify a total of 196 retained articles. According to the scope of the study within prominent databases, such as Scopus, WoS and Engineering village, publications related to BIM integrations within the O&M phase only commenced in 2010 with a clear growing interest within the last three years. Additionally, the UK, USA and China are the top ranked countries in the discussed field. Furthermore, content analysis revealed seven thematic functions of BIM–O&M adoption, namely: information management (IM), advanced technology management (ATM), maintenance management (MAM), indoor management (InM), performance assessment management (PAM), visualisation management (VM) and lean management (LM). Most of the current research around BIM in O&M has focused on information management and advanced technologies, such as the internet of things (IoT), augmented reality (AR) and software developments. Further investigation of research trends depicts that there is a continuously growing interest in BIM–O&M studies; nevertheless, very few have actually focused on specific maintenance features and activities. A comprehensive analysis of BIM–O&M integrations focusing on specific maintenance functions is yet to be fully explored. The majority of studies focused on institutional and infrastructure facility types, but residential, industrial and commercial buildings are underrepresented, despite their disproportionate physical dominance within most societies. The study also presents an overview of the drivers and barriers hindering BIM integrations within O&M. The results of the content analyses were also mapped against the construction project life cycle, which would enable academics and industry professionals to identify and systemise research gaps and possible future directions. More studies are needed to justify the ROI for BIM within O&M, including focused surveys to identify O&M information requirements tailored to different building types as well as address the lessons learned by early adopters. Additionally, a starting point for O&M monitoring with BIM would include prioritising specific O&M data needs and defining critical indicators to measure and monitor the performance. The scope of this study was limited to the O&M phase. Therefore, other review studies should extend the scope in addressing the effects of BIM–O&M on other life cycle stages. This study can provide BIM practitioners with valuable insights regarding similar studies in the field by giving them the means and blueprints for guidance to integrate BIM within O&M. Additionally, the discussed drivers and barriers allow BIM professionals to speed up the integration process. Furthermore, the study enable decision makers to justify the specific needs to integrate BIM with O&M as well as determine the expected deliverables.

Funding

This research received no external funding.

Institutional Review Board Statement

The study did not require ethical approval.

Acknowledgments

The authors acknowledge King Abdul-Aziz University for the research scholarship to undertake the Ph.D. programme and their support for this work.

Conflicts of Interest

The authors declare no conflict of interest.

Appendix A

Table A1. Summary of studies on BIM–O&M in information management.
Table A2. Summary of studies on BIM–O&M in advanced technologies.
Table A3. Summary of studies on BIM–O&M in maintenance and asset management.
Table A4. Summary of studies on BIM–O&M in Indoor management.
Table A5. Summary of studies on BIM–O&M in performance assessment management.
Table A6. Summary of studies on BIM–O&M in visualization management.
Table A7. Summary of studies in BIM–O&M in lean management.

References

  1. Suprun, E.; Mostafa, S.; Stewart, R.A.; Villamor, H.; Sturm, K.; Mijares, A. Digitisation of Existing Water Facilities: A Framework for Realising the Value of Scan-to-BIM. Sustainability 2022, 14, 6142. [Google Scholar] [CrossRef] [Scilit]
  2. Kensek, K. BIM Guidelines Inform Facilities Management Databases: A Case Study over Time. Buildings 2015, 5, 899–916. [Google Scholar] [CrossRef] [Scilit]
  3. Akcamete, A.; Akinci, B.; Garrett, J.H. Potential utilization of building information models for planning maintenance activities. In Proceedings of the 17th International Workshop on Intelligent Computing in Engineering, Leuven, Belgium, 30 June–3 July 2019; pp. 151–157. [Google Scholar]
  4. Gallaher, M.P.; O’Connor, A.C.; Dettbarn, J.L., Jr.; Gilday, L.T. Cost Analysis of Inadequate Interoperability in the U.S. Capital Facilities Industry; NIST: Gaithersburg, MD, USA, 2004; pp. 1–210.
  5. Dong, B.; O’Neill, Z.; Li, Z. A BIM-enabled information infrastructure for building energy Fault Detection and Diagnostics. Autom. Constr. 2014, 44, 197–211. [Google Scholar] [CrossRef] [Scilit]
  6. Teicholz, P.M. BIM for Facility Managers; Teicholz, P., Ed.; John Wiley & Sons, Inc.: Hoboken, NJ, USA, 2013; ISBN 9781119572633. [Google Scholar]
  7. Wang, X. BIM Handbook: A guide to Building Information Modeling for owners, managers, designers, engineers and contractors. Constr. Econ. Build. 2012, 12, 101–102. [Google Scholar] [CrossRef] [Scilit]
  8. Becerik-Gerber, B.; Jazizadeh, F.; Li, N.; Calis, G. Application areas and data requirements for BIM-enabled facilities management. J. Constr. Eng. Manag. 2012, 138, 431–442. [Google Scholar] [CrossRef] [Scilit]
  9. Farghaly, K.; Abanda, F.H.; Vidalakis, C.; Wood, G. BIM-linked data integration for asset management. Built Environ. Proj. Asset Manag. 2019, 9, 489–502. [Google Scholar] [CrossRef] [Scilit]
  10. Ma, Z.; Ren, Y.; Xiang, X.; Turk, Z. Data-driven decision-making for equipment maintenance. Autom. Constr. 2020, 112, 103103. [Google Scholar] [CrossRef] [Scilit]
  11. Edirisinghe, R.; London, K.A.; Kalutara, P.; Aranda-Mena, G. Building information modelling for facility management: Are we there yet? Eng. Constr. Archit. Manag. 2017, 24, 1119–1154. [Google Scholar] [CrossRef] [Scilit]
  12. Bosch, A.; Volker, L.; Koutamanis, A. BIM in the operations stage: Bottlenecks and implications for owners. Built Environ. Proj. Asset Manag. 2015, 5, 331–343. [Google Scholar] [CrossRef] [Scilit]
  13. Rogage, K.; Clear, A.; Alwan, Z.; Lawrence, T.; Kelly, G. Assessing building performance in residential buildings using BIM and sensor data. Int. J. Build. Pathol. Adapt. 2019, 38, 176–191. [Google Scholar] [CrossRef] [Scilit]
  14. Giel, B.; Issa, R.R.A. Framework for Evaluating the BIM Competencies of Facility Owners. J. Manag. Eng. 2016, 32, 04015024. [Google Scholar] [CrossRef] [Scilit]
  15. Oti, A.H.; Kurul, E.; Cheung, F.; Tah, J.H.M. A framework for the utilization of Building Management System data in building information models for building design and operation. Autom. Constr. 2016, 72, 195–210. [Google Scholar] [CrossRef] [Scilit]
  16. Eadie, R.; Browne, M.; Odeyinka, H.; McKeown, C.; McNiff, S. BIM implementation throughout the UK construction project lifecycle: An analysis. Autom. Constr. 2013, 36, 145–151. [Google Scholar] [CrossRef] [Scilit]
  17. Petrosino, A.; Lavenberg, J. Systematic reviews and meta-analyses: Best evidence on “what works” for criminal justice decision makers. West. Crim. Rev. 2007, 8, 1–15. [Google Scholar]
  18. Moher, D.; Shamseer, L.; Clarke, M.; Ghersi, D.; Liberati, A.; Petticrew, M.; Shekelle, P.; Stewart, L.A. Preferred reporting items for systematic review and meta-analysis protocols (PRISMA-P) 2015 statement. Syst. Rev. 2015, 4, 1. [Google Scholar] [CrossRef]
  19. Okoli, C. A guide to conducting a standalone systematic literature review. Commun. Assoc. Inf. Syst. 2015, 37, 879–910. [Google Scholar] [CrossRef] [Scilit]
  20. Qiao, Q.; Yunusa-Kaltungo, A.; Edwards, R.E. Towards developing a systematic knowledge trend for building energy consumption prediction. J. Build. Eng. 2021, 35, 101967. [Google Scholar] [CrossRef] [Scilit]
  21. Iheukwumere-Esotu, L.; Yunusa-Kaltungo, A. A Systematic Analysis of Research Based Evidences of Major Overhauls, Outages, Shutdowns, Turnarounds (MoOSTs) Management. In Proceedings of the International Conference on Maintenance Engineering; Springer: Cham, Switherland, 2020; pp. 627–635. [Google Scholar]
  22. Bronson, D.E.; Davis, T.S.; Bronson, D.E.; Davis, T.S. Assessing the Quality of Systematic Reviews. In Finding and Evaluating Evidence: Systematic Reviews and Evidence-Based Practice; Oxford University Press: Oxford, UK, 2012; pp. 77–85. [Google Scholar]
  23. Matarneh, S.T.; Danso-Amoako, M.; Al-Bizri, S.; Gaterell, M.; Matarneh, R. Building information modeling for facilities management: A literature review and future research directions. J. Build. Eng. 2019, 24. [Google Scholar] [CrossRef] [Scilit]
  24. Xinghua, G.; Pishdad-Bozorgi, P. BIM-enabled facilities operation and maintenance: A review. Adv. Eng. Inform. 2019, 39, 227–247. [Google Scholar] [CrossRef] [Scilit]
  25. Government Construction Strategy. UK. 2016. Available online: https://assets.publishing.service.gov.uk/ (accessed on 24 May 2022).
  26. Hilal, M.; Maqsood, T.; Abdekhodaee, A. A scientometric analysis of BIM studies in facilities management. Int. J. Build. Pathol. Adapt. 2019, 37, 122–139. [Google Scholar] [CrossRef] [Scilit]
  27. Jang, R.; Collinge, W. Improving BIM asset and facilities management processes: A Mechanical and Electrical (M&E) contractor perspective. J. Build. Eng. 2020, 32, 101540. [Google Scholar]
  28. Lu, Q.; Lee, S. Image-Based Technologies for Constructing As-Is Building Information Models for Existing Buildings. J. Comput. Civ. Eng. 2017, 31, 04017005. [Google Scholar] [CrossRef] [Scilit]
  29. Ram, J.; Afridi, N.K.; Khan, K.A. Adoption of Big Data analytics in construction: Development of a conceptual model. Built Environ. Proj. Asset Manag. 2019, 9, 564–579. [Google Scholar] [CrossRef] [Scilit]
  30. Kumar, V.; Teo, E.A.L. Perceived benefits and issues associated with COBie datasheet handling in the construction industry. Facilities 2020, 39, 321–349. [Google Scholar] [CrossRef] [Scilit]
  31. Wetzel, E.M.; Thabet, W.Y. The use of a BIM-based framework to support safe facility management processes. Autom. Constr. 2015, 60, 12–24. [Google Scholar] [CrossRef] [Scilit]
  32. Dixit, M.K.; Venkatraj, V.; Ostadalimakhmalbaf, M.; Pariafsai, F.; Lavy, S. Integration of facility management and building information modeling (BIM). Facilities 2019, 37, 455–483. [Google Scholar] [CrossRef] [Scilit]
  33. Yalcinkaya, M.; Singh, V. Building Information Modeling (BIM) for Facilities Management—Literature Review and Future Needs. In IFIP Advances in Information and Communication Technology; Springer: Berlin, Germany, 2014; Volume 442, pp. 1–10. [Google Scholar]
  34. Naghshbandi, S.N. BIM for Facility Management: Challenges and Research Gaps. Civ. Eng. J. 2016, 2, 679–684. [Google Scholar] [CrossRef] [Scilit]
  35. Hossam, T.A.M.; Eid, A.F.; Khodeir, L. Identifying the Impact of Integrating Building Information Modeling with Maintenance Management a Literature Review. J. Al-Azhar Univ. Eng. Sect. 2019, 14, 627–641. [Google Scholar] [CrossRef] [Scilit]
  36. Pärn, E.A.; Edwards, D.J.; Sing, M.C.P. The building information modelling trajectory in facilities management: A review. Autom. Constr. 2017, 75, 45–55. [Google Scholar] [CrossRef] [Scilit]
  37. Marmo, R.; Nicolella, M.; Polverino, F.; Tibaut, A. A Methodology for a Performance Information Model to Support Facility Management. Sustainability 2019, 11, 7007. [Google Scholar] [CrossRef] [Scilit]
  38. Asare, K.A.B.; Liu, R.; Anumba, C.J. Building information modeling to support facilities management of large capital projects: A critical review. Facilities 2022, 40, 176–197. [Google Scholar] [CrossRef] [Scilit]
  39. Wang, T.; Ali, A.S.; Au-Yong, C.P. Exploring a body of knowledge for promoting the building information model for facility management. Ain Shams Eng. J. 2022, 13, 101717. [Google Scholar] [CrossRef] [Scilit]
  40. Hauashdh, A.; Jailani, J.; Rahman, I.A.; AL-fadhali, N. Strategic approaches towards achieving sustainable and effective building maintenance practices in maintenance-managed buildings: A combination of expert interviews and a literature review. J. Build. Eng. 2022, 45, 103490. [Google Scholar] [CrossRef] [Scilit]
  41. Marocco, M.; Garofolo, I. Integrating disruptive technologies with facilities management: A literature review and future research directions. Autom. Constr. 2021, 131, 103917. [Google Scholar] [CrossRef] [Scilit]
  42. Godager, B.; Onstein, E.; Huang, L. The Concept of Enterprise BIM: Current Research Practice and Future Trends. IEEE Access 2021, 9, 42265–42290. [Google Scholar] [CrossRef] [Scilit]
  43. Patacas, J.; Dawood, N.; Kassem, M. BIM for facilities management: A framework and a common data environment using open standards. Autom. Constr. 2020, 120, 103366. [Google Scholar] [CrossRef] [Scilit]
  44. Lin, Y.-C.; Chen, Y.-P.; Huang, W.-T.; Hong, C.-C. Development of BIM Execution Plan for BIM Model Management during the Pre-Operation Phase: A Case Study. Buildings 2016, 6, 8. [Google Scholar] [CrossRef] [Scilit]
  45. Lu, Q.; Chen, L.; Lee, S.; Zhao, X. Activity theory-based analysis of BIM implementation in building O&M and first response. Autom. Constr. 2018, 85, 317–332. [Google Scholar]
  46. Cavka, H.B.; Staub-French, S.; Poirier, E.A. Developing owner information requirements for BIM-enabled project delivery and asset management. Autom. Constr. 2017, 83, 169–183. [Google Scholar] [CrossRef] [Scilit]
  47. Neuville, R.; Pouliot, J.; Billen, R. Identification of the Best 3D Viewpoint within the BIM Model: Application to Visual Tasks Related to Facility Management. Buildings 2019, 9, 167. [Google Scholar] [CrossRef] [Scilit]
  48. Liu, R.; Issa, R.R. Design for maintenance accessibility using BIM tools. Facilities 2014, 32, 153–159. [Google Scholar] [CrossRef] [Scilit]
  49. Zadeh, P.A.; Wang, G.; Cavka, H.B.; Staub-French, S.; Pottinger, R. Information Quality Assessment for Facility Management. Adv. Eng. Inform. 2017, 33, 181–205. [Google Scholar] [CrossRef] [Scilit]
  50. Shou, W.; Wang, J.; Wu, P.; Wang, X. Lean management framework for improving maintenance operation: Development and application in the oil and gas industry. Prod. Plan. Control 2020, 32, 585–602. [Google Scholar] [CrossRef] [Scilit]
  51. Ismail, Z.-A. Improving conventional method on precast concrete building maintenance Towards BIM implementation. Ind. Manag. Data Syst. 2017, 117, 1485–1502. [Google Scholar] [CrossRef] [Scilit]
  52. Cavka, H.B.; Staub-French, S.; Poirier, E.A. Levels of BIM compliance for model handover. J. Inf. Technol. Constr. 2018, 23, 243–258. [Google Scholar]
  53. Fargnoli, M.; Lleshaj, A.; Lombardi, M.; Sciarretta, N.; Di Gravio, G. A BIM-based PSS Approach for the Management of Maintenance Operations of Building Equipment. Buildings 2019, 9, 139. [Google Scholar] [CrossRef] [Scilit]
  54. Heaton, J.; Parlikad, A.K.; Schooling, J. A Building Information Modelling approach to the alignment of organisational objectives to Asset Information Requirements. Autom. Constr. 2019, 104, 14–26. [Google Scholar] [CrossRef] [Scilit]
  55. Yalcinkaya, M.; Singh, V. VisualCOBie for facilities management A BIM integrated, visual search and information management platform for COBie extension. Facilities 2019, 37, 502–524. [Google Scholar] [CrossRef] [Scilit]
  56. Nascimento, D.L. de M.; Quelhas, O.L.G.; Meiriño, M.J.; Caiado, R.G.G.; Barbosa, S.D.J.; Ivson, P. Facility management using digital obeya room by integrating bim-lean approaches—An empirical study. J. Civ. Eng. Manag. 2018, 24, 581–591. [Google Scholar] [CrossRef] [Scilit]
  57. Kasprzak, C.; Dubler, C. Aligning BIM with FM: Streamlining the process for future projects. Constr. Econ. Build. 2015, 12, 68–77. [Google Scholar] [CrossRef] [Scilit]
  58. Pärn, E.A.; Edwards, D.J. Conceptualising the FinDD API plug-in: A study of BIM-FM integration. Autom. Constr. 2017, 80, 11–21. [Google Scholar] [CrossRef] [Scilit]
  59. Alavi, H.; Forcada, N.; Bortolini, R.; Edwards, D.J. Enhancing occupants’ comfort through BIM-based probabilistic approach. Autom. Constr. 2021, 123, 103528. [Google Scholar] [CrossRef] [Scilit]
  60. Liu, Q.; Gao, T. The Information Requirements for Transportation Industry’s Facilities Management Based on BIM. Open Constr. Build. Technol. J. 2017, 11, 136–141. [Google Scholar] [CrossRef] [Scilit]
  61. Ergen, E.; Kula, B.; Guven, G.; Artan, D. Formalization of Occupant Feedback and Integration with BIM in Office Buildings. J. Comput. Civ. Eng. 2021, 35, 04020055. [Google Scholar] [CrossRef] [Scilit]
  62. Munir, M.; Kiviniemi, A.; Jones, S.W.; Finnegan, S. The business value of BIM for asset owners: A cross-case analysis. J. Facil. Manag. 2020, 18, 469–486. [Google Scholar] [CrossRef] [Scilit]
  63. Mayo, G.; Issa, R.R.A. Nongeometric Building Information Needs Assessment for Facilities Management. J. Manag. Eng. 2016, 32, 04015054. [Google Scholar] [CrossRef] [Scilit]
  64. Ashworth, S.; Tucker, M.; Druhmann, C.K. Critical success factors for facility management employer’s information requirements (EIR) for BIM. Facilities 2019, 37, 103–118. [Google Scholar] [CrossRef] [Scilit]
  65. Hosseini, M.R.; Roelvink, R.; Papadonikolaki, E.; Edwards, D.J.; Pärn, E. Integrating BIM into facility management. Int. J. Build. Pathol. Adapt. 2018, 36, 2–14. [Google Scholar] [CrossRef] [Scilit]
  66. Cavka, H.; Staub-French, S.; Pottinger, R. Evaluating the Alignment of Organizational and Project Contexts for BIM Adoption: A Case Study of a Large Owner Organization. Buildings 2015, 5, 1265–1300. [Google Scholar] [CrossRef] [Scilit]
  67. Aziz, Z.; Riaz, Z.; Arslan, M. Leveraging BIM and Big Data to deliver well maintained highways. Facilities 2017, 35, 818–832. [Google Scholar] [CrossRef] [Scilit]
  68. Liu, R.; Issa, R.R.A. Survey: Common Knowledge in BIM for Facility Maintenance. J. Perform. Constr. Facil. 2016, 30, 04015033. [Google Scholar] [CrossRef] [Scilit]
  69. Gheisari, M.; Irizarry, J. Investigating human and technological requirements for successful implementation of a BIM-based mobile augmented reality environment in facility management practices. Facilities 2016, 34, 69–84. [Google Scholar] [CrossRef] [Scilit]
  70. Dias, P.D.R.; Ergan, S. Owner requirements in as-built BIM deliverables and a system architecture for FM-specific BIM representation. Can. J. Civ. Eng. 2020, 47, 215–227. [Google Scholar] [CrossRef] [Scilit]
  71. Carbonari, G.; Stravoravdis, S.; Gausden, C. Improving FM task efficiency through BIM: A proposal for BIM implementation. J. Corp. Real Estate 2018, 20, 4–15. [Google Scholar] [CrossRef] [Scilit]
  72. Halmetoja, E. The conditions data model supporting building information models in facility management. Facilities 2019, 37, 484–501. [Google Scholar] [CrossRef] [Scilit]
  73. Koch, C.; Hansen, G.K.; Jacobsen, K. Missed opportunities: Two case studies of digitalization of FM in hospitals. Facilities 2019, 37, 381–394. [Google Scholar] [CrossRef] [Scilit]
  74. Miettinen, R.; Kerosuo, H.; Metsälä, T.; Paavola, S. Bridging the life cycle: A case study on facility management infrastructures and uses of BIM. J. Facil. Manag. 2018, 16, 2–16. [Google Scholar] [CrossRef] [Scilit]
  75. Alwan, Z.; Gledson, B.J. Towards green building performance evaluation using asset information modelling. Built Environ. Proj. Asset Manag. 2015, 5, 290–303. [Google Scholar] [CrossRef] [Scilit]
  76. McArthur, J.J.; Bortoluzzi, B. Lean-Agile FM-BIM: A demonstrated approach. Facilities 2018, 36, 676–695. [Google Scholar] [CrossRef] [Scilit]
  77. Pishdad-Bozorgi, P.; Gao, X.; Eastman, C.; Self, A.P. Planning and developing facility management-enabled building information model (FM-enabled BIM). Autom. Constr. 2018, 87, 22–38. [Google Scholar] [CrossRef] [Scilit]
  78. Korpela, J.; Miettinen, R.; Salmikivi, T.; Ihalainen, J. The challenges and potentials of utilizing building information modelling in facility management: The case of the Center for Properties and Facilities of the University of Helsinki. Constr. Manag. Econ. 2015, 33, 3–17. [Google Scholar] [CrossRef] [Scilit]
  79. Ismail, Z.-A. An Integrated Computerised Maintenance Management System (I-CMMS) for IBS building maintenance. Int. J. Build. Pathol. Adapt. 2019, 37, 326–343. [Google Scholar] [CrossRef] [Scilit]
  80. Wanigarathna, N.; Jones, K.; Bell, A.; Kapogiannis, G. Building information modelling to support maintenance management of healthcare built assets. Facilities 2019, 37, 415–434. [Google Scholar] [CrossRef] [Scilit]
  81. Munir, M.; Kiviniemi, A.; Jones, S.; Finnegan, S. BIM business value for asset owners: Key issues and challenges. Int. J. Build. Pathol. Adapt. 2020, 39, 135–151. [Google Scholar] [CrossRef] [Scilit]
  82. Alnaggar, A.; Pitt, M. Lifecycle Exchange for Asset Data (LEAD). J. Facil. Manag. 2019, 17, 385–411. [Google Scholar] [CrossRef] [Scilit]
  83. Munir, M.; Kiviniemi, A.; Finnegan, S.; Jones, S.W. BIM business value for asset owners through effective asset information management. Facilities 2019, 38, 181–200. [Google Scholar] [CrossRef] [Scilit]
  84. Farghaly, K.; Abanda, F.H.; Vidalakis, C.; Wood, G. Taxonomy for BIM and Asset Management Semantic Interoperability. J. Manag. Eng. 2018, 34, 04018012. [Google Scholar] [CrossRef] [Scilit]
  85. Brunet, M.; Motamedi, A.; Guénette, L.-M.; Forgues, D. Analysis of BIM use for asset management in three public organizations in Québec, Canada. Built Environ. Proj. Asset Manag. 2019, 9, 153–167. [Google Scholar] [CrossRef] [Scilit]
  86. Motawa, I.; Almarshad, A. Case-based reasoning and BIM systems for asset management. Built Environ. Proj. Asset Manag. 2015, 5, 233–247. [Google Scholar] [CrossRef] [Scilit]
  87. Tucker, M.; Masuri, M.R.A. The development of facilities management-development process (FM-DP) integration framework. J. Build. Eng. 2018, 18, 377–385. [Google Scholar] [CrossRef] [Scilit]
  88. Matarneh, S.; Danso-Amoako, M.; Al-Bizri, S.; Gaterell, M.; Matarneh, R. BIM-based facilities information: Streamlining the information exchange process. J. Eng. Des. Technol. 2019, 17, 1304–1322. [Google Scholar] [CrossRef] [Scilit]
  89. Ismail, Z.-A.; Mutalib, A.A.; Hamzah, N. Case study to analyse problems and issues in IBS building maintenance. Int. J. Appl. Eng. Res. 2016, 11, 226–232. [Google Scholar]
  90. Nguyen, P.T.; Nguyen, T.A.; Ha, N.T.H.; Nguyen, T.N. Facilities management in high rise buildings using building information modeling. Int. J. Adv. Appl. Sci. 2017, 4, 1–9. [Google Scholar] [CrossRef] [Scilit]
  91. Yusoff, S.N.S.; Brahim, J. Implementation of building information modeling (Bim) for social heritage buildings in kuala lumpur. Int. J. Sustain. Constr. Eng. Technol. 2021, 12, 88–99. [Google Scholar] [CrossRef] [Scilit]
  92. Eskandari, N.; Noorzai, E. Offering a preventive solution to defects in commercial building facility system using BIM. Facilities 2021, 39, 859–887. [Google Scholar] [CrossRef] [Scilit]
  93. Ali, A.S.; Zakaria, N.; Zolkafli@Zulkifly, U.K. Building Operation and Maintenance: A Framework for Simplified Building Information Modeling (BIM) Digital Mobile Application. Int. J. Interact. Mob. Technol. 2021, 15, 146–160. [Google Scholar] [CrossRef] [Scilit]
  94. Akinradewo, O.; Aigbavboa, C.; Oke, A.; Edwards, D.; Kasongo, N. Key requirements for effective implementation of building information modelling for maintenance management. Int. J. Constr. Manag. 2022, 1–9. [Google Scholar] [CrossRef] [Scilit]
  95. Kula, B.; Ergen, E. Implementation of a BIM-FM Platform at an International Airport Project: Case Study. J. Constr. Eng. Manag. 2021, 147, 05021002. [Google Scholar] [CrossRef] [Scilit]
  96. Ismail, Z.-A. Implementation of BIM technology for knowledge transfer in IBS building maintenance projects. Int. J. Build. Pathol. Adapt. 2021, 39, 115–134. [Google Scholar] [CrossRef] [Scilit]
  97. Thabet, W.; Lucas, J. Asset Data Handover for a Large Educational Institution: Case-Study Approach. J. Constr. Eng. Manag. 2017, 143, 05017017. [Google Scholar] [CrossRef] [Scilit]
  98. Sadeghi, M.; Elliott, J.W.; Porro, N.; Strong, K. Developing building information models (BIM) for building handover, operation and maintenance. J. Facil. Manag. 2019, 17, 301–316. [Google Scholar] [CrossRef] [Scilit]
  99. William East, E.; Nisbet, N.; Liebich, T. Facility Management Handover Model View. J. Comput. Civ. Eng. 2013, 27, 61–67. [Google Scholar] [CrossRef] [Scilit]
  100. Munir, M.; Kiviniemi, A.; Jones, S.; Finnegan, S. BIM-based operational information requirements for asset owners. Archit. Eng. Des. Manag. 2020, 16, 100–114. [Google Scholar] [CrossRef] [Scilit]
  101. Pavón, R.M.; Alvarez, A.A.A.; Alberti, M.G. BIM-Based Educational and Facility Management of Large University Venues. Appl. Sci. 2020, 10, 7976. [Google Scholar] [CrossRef] [Scilit]
  102. Hull, J.; Ewart, I.J. Conservation data parameters for BIM-enabled heritage asset management. Autom. Constr. 2020, 119, 103333. [Google Scholar] [CrossRef] [Scilit]
  103. Love, P.E.D.; Zhou, J.; Matthews, J.; Sing, C.-P.; Carey, B. A systems information model for managing electrical, control, and instrumentation assets. Built Environ. Proj. Asset Manag. 2015, 5, 278–289. [Google Scholar] [CrossRef] [Scilit]
  104. Patacas, J.; Dawood, N.; Vukovic, V.; Kassem, M. BIM for facilities management: Evaluating bim standards in asset register creation and service life planning. J. Inf. Technol. Constr. 2015, 20, 313–331. [Google Scholar]
  105. Al-Kasasbeh, M.; Abudayyeh, O.; Liu, H. An integrated decision support system for building asset management based on BIM and Work Breakdown Structure. J. Build. Eng. 2021, 34, 101959. [Google Scholar] [CrossRef] [Scilit]
  106. Thabet, W.; Lucas, J.D. A 6-step systematic process for model-based facility data delivery. J. Inf. Technol. Constr. 2017, 22, 104–131. [Google Scholar]
  107. Heaton, J.; Parlikad, A.K.; Schooling, J. Design and development of BIM models to support operations and maintenance. Comput. Ind. 2019, 111, 172–186. [Google Scholar] [CrossRef] [Scilit]
  108. Saptari, A.Y.; Hendriatiningsih, S.; Bagaskara, D.; Apriani, L. Implementation of government asset management using terrestrial laser scanner (tls) as part of building information modelling (BIM). IIUM Eng. J. 2019, 20, 49–69. [Google Scholar] [CrossRef] [Scilit]
  109. Moreno Bazán, Á.; Alberti, M.G.; Arcos Álvarez, A.; Trigueros, J.A. New Perspectives for BIM Usage in Transportation Infrastructure Projects. Appl. Sci. 2020, 10, 7072. [Google Scholar] [CrossRef] [Scilit]
  110. Lee, P.-C.; Wang, Y.; Lo, T.-P.; Long, D. An integrated system framework of building information modelling and geographical information system for utility tunnel maintenance management. Tunn. Undergr. Sp. Technol. 2018, 79, 263–273. [Google Scholar] [CrossRef] [Scilit]
  111. Lucas, J.; Bulbul, T.; Thabet, W. A pilot model for a proof of concept healthcare facility information management prototype. J. Inf. Technol. Constr. 2013, 18, 76–98. [Google Scholar]
  112. Lucas, J.; Bulbul, T.; Thabet, W. An object-oriented model to support healthcare facility information management. Autom. Constr. 2013, 31, 281–291. [Google Scholar] [CrossRef] [Scilit]
  113. Alnaggar, A.; Pitt, M. Towards a conceptual framework to manage BIM/COBie asset data using a standard project management methodology. J. Facil. Manag. 2019, 17, 175–187. [Google Scholar] [CrossRef] [Scilit]
  114. Cheung, C.M.; Yunusa-Kaltungo, A.; Ejohwomu, O.; Zhang, R.P. Learning from failures (LFF). In Construction Health and Safety in Developing Countries, 1st ed.; Routledge: Abingdon, UK, 2019; pp. 205–217. [Google Scholar]
  115. Ayu, K.; Yunusa-Kaltungo, A. A Holistic Framework for Supporting Maintenance and Asset Management Life Cycle Decisions for Power Systems. Energies 2020, 13, 1937. [Google Scholar] [CrossRef] [Scilit]
  116. Yunusa-Kaltungo, A.; Kermani, M.M.; Labib, A. Investigation of critical failures using root cause analysis methods: Case study of ASH cement PLC. Eng. Fail. Anal. 2017, 73, 25–45. [Google Scholar] [CrossRef] [Scilit]
  117. Ismail, Z.-A. A case study of maintenance management systems in Malaysian complex and high-rise IBS buildings. J. Steel Struct. Constr. 2017, 03, 28–35. [Google Scholar] [CrossRef]
  118. Shalabi, F.; Turkan, Y. IFC BIM-Based Facility Management Approach to Optimize Data Collection for Corrective Maintenance. J. Perform. Constr. Facil. 2017, 31, 04016081. [Google Scholar] [CrossRef] [Scilit]
  119. Zhan, J.; Ge, X.J.; Huang, S.; Zhao, L.; Wong, J.K.W.; He, S.X. Improvement of the inspection-repair process with building information modelling and image classification. Facilities 2019, 37, 395–414. [Google Scholar] [CrossRef] [Scilit]
  120. Yoon, J.H.; Cha, H.S.; Kim, J. Three-Dimensional Location-Based O&M Data Management System for Large Commercial Office Buildings. J. Perform. Constr. Facil. 2019, 33, 04019010. [Google Scholar]
  121. Kim, E.; Park, S. Three-dimensional visualized space and asset management system for large-scale airports: The case of Incheon International Airport. Int. J. Archit. Comput. 2016, 14, 233–246. [Google Scholar] [CrossRef] [Scilit]
  122. Hoeft, M.; Trask, C. Safety Built Right in: Exploring the Occupational Health and Safety Potential of BIM-Based Platforms throughout the Building Lifecycle. Sustainability 2022, 14, 6104. [Google Scholar] [CrossRef] [Scilit]
  123. Villa, V.; Lauria, A.; Caldera, C. BIM-Based H&S Management for Facilities. Operations & Maintenance of Logistic Plants. Bo-Ricerche E Progett. Per Territ. La Citta E L Archit. 2018, 9, 158–165. [Google Scholar]
  124. Parn, E.A.; Edwards, D.; Riaz, Z.; Mehmood, F.; Lai, J. Engineering-out hazards: Digitising the management working safety in confined spaces. Facilities 2019, 37, 196–215. [Google Scholar] [CrossRef] [Scilit]
  125. Chen, L.; Shi, P.; Tang, Q.; Liu, W.; Wu, Q. Development and application of a specification-compliant highway tunnel facility management system based on BIM. Tunn. Undergr. Sp. Technol. 2020, 97, 103262. [Google Scholar] [CrossRef] [Scilit]
  126. Lee, S.; Akin, Ö. Augmented reality-based computational fieldwork support for equipment operations and maintenance. Autom. Constr. 2011, 20, 338–352. [Google Scholar] [CrossRef] [Scilit]
  127. Chen, K.; Chen, W.; Li, C.T.; Cheng, J.C.P. A BIM-based location aware ar collaborative framework for facility maintenance management. J. Inf. Technol. Constr. 2019, 24, 360–380. [Google Scholar]
  128. Williams, G.; Gheisari, M.; Chen, P.-J.; Irizarry, J. BIM2MAR: An Efficient BIM Translation to Mobile Augmented Reality Applications. J. Manag. Eng. 2015, 31, A4014009. [Google Scholar] [CrossRef] [Scilit]
  129. El Ammari, K.; Hammad, A. Remote interactive collaboration in facilities management using BIM-based mixed reality. Autom. Constr. 2019, 107, 102940. [Google Scholar] [CrossRef] [Scilit]
  130. Peng, Y.; Lin, J.-R.; Zhang, J.-P.; Hu, Z.-Z. A hybrid data mining approach on BIM-based building operation and maintenance. Build. Environ. 2017, 126, 483–495. [Google Scholar] [CrossRef] [Scilit]
  131. Moretti, N.; Xie, X.; Merino, J.; Brazauskas, J.; Parlikad, A.K. An openBIM Approach to IoT Integration with Incomplete As-Built Data. Appl. Sci. 2020, 10, 8287. [Google Scholar] [CrossRef] [Scilit]
  132. Ciccone, A.; Di Stasio, S.; Asprone, D.; Salzano, A.; Nicolella, M. Application of openBIM for the Management of Existing Railway Infrastructure: Case Study of the Cancello–Benevento Railway Line. Sustainability 2022, 14, 2283. [Google Scholar] [CrossRef] [Scilit]
  133. Kim, K.; Kim, H.; Kim, W.; Kim, C.; Kim, J.; Yu, J. Integration of ifc objects and facility management work information using Semantic Web. Autom. Constr. 2018, 87, 173–187. [Google Scholar] [CrossRef] [Scilit]
  134. Niknam, M.; Jalaei, F.; Karshenas, S. Integrating bim and product manufacturer data using the semantic web technologies. J. Inf. Technol. Constr. 2019, 24, 424–439. [Google Scholar]
  135. Chew, M.Y.L.; Teo, E.A.L.; Shah, K.W.; Kumar, V.; Hussein, G.F. Evaluating the Roadmap of 5G Technology Implementation for Smart Building and Facilities Management in Singapore. Sustainability 2020, 12, 10259. [Google Scholar] [CrossRef] [Scilit]
  136. Villa, V.; Bruno, G.; Aliev, K.; Piantanida, P.; Corneli, A.; Antonelli, D. Machine Learning Framework for the Sustainable Maintenance of Building Facilities. Sustainability 2022, 14, 681. [Google Scholar] [CrossRef] [Scilit]
  137. Alwan, Z. BIM performance framework for the maintenance and refurbishment of housing stock. Struct. Surv. 2016, 34, 242–255. [Google Scholar] [CrossRef] [Scilit]
  138. Xing, K.; Kim, K.P.; Ness, D. Cloud-BIM Enabled Cyber-Physical Data and Service Platforms for Building Component Reuse. Sustainability 2020, 12, 10329. [Google Scholar] [CrossRef] [Scilit]
  139. Hsieh, C.-C.; Liu, C.-Y.; Wu, P.-Y.; Jeng, A.-P.; Wang, R.-G.; Chou, C.-C. Building information modeling services reuse for facility management for semiconductor fabrication plants. Autom. Constr. 2019, 102, 270–287. [Google Scholar] [CrossRef] [Scilit]
  140. Golabchi, A.; Akula, M.; Kamat, V. Automated building information modeling for fault detection and diagnostics in commercial HVAC systems. Facilities 2016, 34, 233–246. [Google Scholar] [CrossRef] [Scilit]
  141. Marzouk, M.; Ahmed, R. BIM-Based Facility management for water treatment plants using laser scanning. Water Pract. Technol. 2019, 14, 325–330. [Google Scholar] [CrossRef] [Scilit]
  142. Hu, Z.-Z.; Tian, P.-L.; Li, S.-W.; Zhang, J.-P. BIM-based integrated delivery technologies for intelligent MEP management in the operation and maintenance phase. Adv. Eng. Softw. 2018, 115, 1–16. [Google Scholar] [CrossRef] [Scilit]
  143. Marmo, R.; Polverino, F.; Nicolella, M.; Tibaut, A. Building performance and maintenance information model based on IFC schema. Autom. Constr. 2020, 118, 103275. [Google Scholar] [CrossRef] [Scilit]
  144. Heaton, J.; Parlikad, A.K. A conceptual framework for the alignment of infrastructure assets to citizen requirements within a Smart Cities framework. Cities 2019, 90, 32–41. [Google Scholar] [CrossRef] [Scilit]
  145. Karthikeyan, R.R.; Raghu, D.B. Design of Smart Facility Management System. Int. J. Eng. Trends Technol. 2020, 68, 167–175. [Google Scholar] [CrossRef] [Scilit]
  146. Xie, Q.; Zhou, X.; Wang, J.; Gao, X.; Chen, X.; Liu, C. Matching Real-World Facilities to Building Information Modeling Data Using Natural Language Processing. IEEE Access 2019, 7, 119465–119475. [Google Scholar] [CrossRef] [Scilit]
  147. Skandhakumar, N.; Salim, F.; Reid, J.; Drogemuller, R.; Dawson, E. Graph theory based representation of building information models for access control applications. Autom. Constr. 2016, 68, 44–51. [Google Scholar] [CrossRef] [Scilit]
  148. Naticchia, B.; Corneli, A.; Carbonari, A. Framework based on building information modeling, mixed reality, and a cloud platform to support information flow in facility management. Front. Eng. Manag. 2020, 7, 131–141. [Google Scholar] [CrossRef] [Scilit]
  149. Ermolli, S.R. Digital flows of information for the operational phase: The Facility Management of Apple Developer Academy. Techne-J. Technol. Archit. Environ. 2019, 18, 235–245. [Google Scholar]
  150. Bortoluzzi, B.; Efremov, I.; Medina, C.; Sobieraj, D.; McArthur, J.J. Automating the creation of building information models for existing buildings. Autom. Constr. 2019, 105, 102838. [Google Scholar] [CrossRef] [Scilit]
  151. Zou, Z.; Arruda, L.; Ergan, S. Characteristics of models that impact transformation of bims to virtual environments to support facility management operations. J. Civ. Eng. Manag. 2018, 24, 481–498. [Google Scholar] [CrossRef] [Scilit]
  152. Lee, W.-L.; Tsai, M.-H.; Yang, C.-H.; Juang, J.-R.; Su, J.-Y. V3DM+: BIM interactive collaboration system for facility management. Vis. Eng. 2016, 4, 5. [Google Scholar] [CrossRef] [Scilit]
  153. Cheng, J.C.P.; Chen, W.; Chen, K.; Wang, Q. Data-driven predictive maintenance planning framework for MEP components based on BIM and IoT using machine learning algorithms. Autom. Constr. 2020, 112, 103087. [Google Scholar] [CrossRef] [Scilit]
  154. Piaia, E.; Maietti, F.; Di Giulio, R.; Schippers-Trifan, O.; Van Delft, A.; Bruinenberg, S.; Olivadese, R. BIM-based Cultural Heritage Asset Management Tool. Innovative Solution to Orient the Preservation and Valorization of Historic Buildings. Int. J. Archit. Herit. 2021, 15, 897–920. [Google Scholar] [CrossRef] [Scilit]
  155. Valdepeñas, P.; Esteban Pérez, M.D.; Henche, C.; Rodríguez-Escribano, R.; Fernández, G.; López-Gutiérrez, J.-S. Application of the BIM Method in the Management of the Maintenance in Port Infrastructures. J. Mar. Sci. Eng. 2020, 8, 981. [Google Scholar] [CrossRef] [Scilit]
  156. Chen, W.; Chen, K.; Cheng, J.C.P.; Wang, Q.; Gan, V.J.L. BIM-based framework for automatic scheduling of facility maintenance work orders. Autom. Constr. 2018, 91, 15–30. [Google Scholar] [CrossRef] [Scilit]
  157. Iheukwumere-Esotu, L.; Yunusa-Kaltungo, A. Assessment of barriers to knowledge and experience transfer in major maintenance activities. Energies 2020, 13, 1721. [Google Scholar] [CrossRef] [Scilit]
  158. Iheukwumere-Esotu, L.; Yunusa-Kaltungo, A. Knowledge Criticality Assessment and Codification Framework for Major Maintenance Activities: A Case Study of Cement Rotary Kiln Plant. Sustainability 2021, 13, 4619. [Google Scholar] [CrossRef] [Scilit]
  159. McArthur, J.J.; Shahbazi, N.; Fok, R.; Raghubar, C.; Bortoluzzi, B.; An, A. Machine learning and BIM visualization for maintenance issue classification and enhanced data collection. Adv. Eng. Inform. 2018, 38, 101–112. [Google Scholar] [CrossRef] [Scilit]
  160. Lavy, S.; Saxena, N.; Dixit, M. Effects of BIM and COBie Database Facility Management on Work Order Processing Times: Case Study. J. Perform. Constr. Facil. 2019, 33, 04019069. [Google Scholar] [CrossRef] [Scilit]
  161. Kameli, M.; Hosseinalipour, M.; Majrouhi Sardroud, J.; Ahmed, S.M.; Behruyan, M. Improving maintenance performance by developing an IFC BIM/RFID-based computer system. J. Ambient Intell. Humaniz. Comput. 2021, 12, 3055–3074. [Google Scholar] [CrossRef] [Scilit]
  162. Chao, C.; Tang, L. BIM-based integrated management workflow design for schedule and cost planning of building fabric maintenance. Autom. Constr. 2019, 107, 102944. [Google Scholar]
  163. Maltese, S.; Branca, G.; Cecconi, F.R.; Moretti, N. Ifc-based Maintenance Budget Allocation. Bo-Ricerche E Progett. Per Territ. La Citta E L Archit. 2018, 9, 44–51. [Google Scholar]
  164. Moretti, N.; Blanco Cadena, J.D.; Mannino, A.; Poli, T.; Re Cecconi, F. Maintenance service optimization in smart buildings through ultrasonic sensors network. Intell. Build. Int. 2021, 13, 4–16. [Google Scholar] [CrossRef] [Scilit]
  165. Re Cecconi, F.; Maltese, S.; Dejaco, M.C. Leveraging BIM for digital built environment asset management. Innov. Infrastruct. Solut. 2017, 2, 14. [Google Scholar] [CrossRef] [Scilit]
  166. Guillen, A.J.; Crespo, A.; Gómez, J.; González-Prida, V.; Kobbacy, K.; Shariff, S. Building Information Modeling as Assest Management Tool. IFAC-PapersOnLine 2016, 49, 191–196. [Google Scholar] [CrossRef] [Scilit]
  167. Wetzel, E.M.; Thabet, W.Y. A case study towards transferring relevant safety information for facilities maintenance using BIM. J. Inf. Technol. Constr. 2018, 23, 53–74. [Google Scholar]
  168. Kim, T.H.; Kim, S.J. A study on BIM application for the efficient maintenance management of bridge structures. Information 2017, 20, 3691–3698. [Google Scholar]
  169. Motamedi, A.; Hammad, A.; Asen, Y. Knowledge-assisted BIM-based visual analytics for failure root cause detection in facilities management. Autom. Constr. 2014, 43, 73–83. [Google Scholar] [CrossRef] [Scilit]
  170. Chong, H.-Y.; Wang, J.; Shou, W.; Wang, X.; Guo, J. Improving quality and performance of facility management using building information modelling. In International Conference on Cooperative Design, Visualization and Engineering, CDVE 2014: Cooperative Design, Visualization, and Engineering; Springer: Berlin, Germany, 2014; Volume 8683, pp. 44–50. [Google Scholar]
  171. Carbonari, A.; Messi, L.; Naticchia, B.; Vaccarini, M.; Pirani, M. Development of a BIM-based holonic system for real-time monitoring of building operational efficiency. Front. Eng. Manag. 2020, 7, 89–103. [Google Scholar] [CrossRef] [Scilit]
  172. Valinejadshoubi, M.; Moselhi, O.; Bagchi, A.; Salem, A. Development of an IoT and BIM-based automated alert system for thermal comfort monitoring in buildings. Sustain. Cities Soc. 2021, 66, 102602. [Google Scholar] [CrossRef] [Scilit]
  173. Mannino, A.; Moretti, N.; Dejaco, C.M.; Baresi, L.; Ceccon, R. iFulvio Office building occupancy monitoring through image recognition sensors. Int. J. Saf. Secur. Eng. 2019, 9, 371–380. [Google Scholar]
  174. Kazado, D.; Kavgic, M.; Eskicioglu, R. Integrating building information modeling (BIM) and sensor technology for facility management. J. Inf. Technol. Constr. 2019, 24, 440–458. [Google Scholar]
  175. Marzouk, M.; Abdelaty, A. Monitoring thermal comfort in subways using building information modeling. Energy Build. 2014, 84, 252–257. [Google Scholar] [CrossRef] [Scilit]
  176. Costin, A.M.; Teizer, J. Fusing passive RFID and BIM for increased accuracy in indoor localization. Vis. Eng. 2015, 3, 17. [Google Scholar] [CrossRef] [Scilit]
  177. Bahadori-Jahromi, A.; Teixeira Batista, L.; Ricardo, J.; Franco, Q.; Fakury, R.H.; Porto, M.F.; Polito Braga, C.M. Methodology for Determining Sustainable Water Consumption Indicators for Buildings. Sustainability 2022, 14, 5695. [Google Scholar]
  178. Wu, J.; Lepech, M.D. Incorporating multi-physics deterioration analysis in building information modeling for life-cycle management of durability performance. Autom. Constr. 2020, 110, 103004. [Google Scholar] [CrossRef] [Scilit]
  179. Jung; Cha; Jiang Developing a Building Fire Information Management System Based on 3D Object Visualization. Appl. Sci. 2020, 10, 772. [CrossRef] [Scilit]
  180. Vilventhan, A.; Razin, S.; Rajadurai, R. 4D BIM models for smart utility relocation management in urban infrastructure projects. Facilities 2020, 39, 50–63. [Google Scholar] [CrossRef] [Scilit]
  181. Chan, B.; Guan, H.; Hou, L.; Jo, J.; Blumenstein, M.; Wang, J. Defining a conceptual framework for the integration of modelling and advanced imaging for improving the reliability and efficiency of bridge assessments. J. Civ. Struct. Health Monit. 2016, 6, 703–714. [Google Scholar] [CrossRef] [Scilit]
  182. Mirarchi, C.; Pavan, A.; De Marco, F.; Wang, X.; Song, Y. Supporting Facility Management Processes through End-Users’ Integration and Coordinated BIM-GIS Technologies. ISPRS Int. J. Geo-Inf. 2018, 7, 191. [Google Scholar] [CrossRef] [Scilit]
  183. Kassem, M.; Kelly, G.; Dawood, N.; Serginson, M.; Lockley, S. BIM in facilities management applications: A case study of a large university complex. Built Environ. Proj. Asset Manag. 2015, 5, 261–277. [Google Scholar] [CrossRef] [Scilit]
  184. Codinhoto, R.; Kiviniemi, A. BIM for FM: A Case Support for Business Life Cycle. In IFIP Advances in Information and Communication Technology; School of the Built Environment, The University of Salford: Salford, UK, 2014; Volume 442, pp. 63–74. [Google Scholar]
  185. Hilal, M.; Maqsood, T.; Abdekhodaee, A. A hybrid conceptual model for BIM in FM. Constr. Innov. 2019, 19, 531–549. [Google Scholar] [CrossRef] [Scilit]
  186. Abideen, D.; Kutlango, A.; Cheung, C.; Manu, P. Digitalization of Construction Life Cycle; A Systematic Review of Building and Reliability Information modelling (BRIM). AIP Conf. Proc. 2021, 2428, 020001. [Google Scholar]
  187. Irizarry, J.; Gheisari, M.; Williams, G.; Roper, K. Ambient intelligence environments for accessing building information. Facilities 2014, 32, 120–138. [Google Scholar] [CrossRef] [Scilit]
  188. Alvarez, A.P.; Ordieres-Mere, J.; Loreiro, A.P.; de Marcos, L. Opportunities in airport pavement management: Integration of BIM, the IoT and DLT. J. Air Transp. Manag. 2021, 90, 101941. [Google Scholar] [CrossRef] [Scilit]
  189. Nicał, A.K.; Wodyński, W. Enhancing Facility Management through BIM 6D. Procedia Eng. 2016, 164, 299–306. [Google Scholar] [CrossRef] [Scilit]
  190. Wetzel, E.M.; Thabet, W.Y.; Jang, R.; Collinge, W.; Munoz Pavon, R.; Arcos Alvarez, A.A.; Alberti, M.G.; Chen, L.; Shi, P.; Tang, Q.; et al. Knowledge-assisted BIM-based visual analytics for failure root cause detection in facilities management. Autom. Constr. 2019, 37, 233–246. [Google Scholar]
  191. Durdyev, S.; Ashour, M.; Connelly, S.; Mahdiyar, A. Barriers to the implementation of Building Information Modelling (BIM) for facility management. J. Build. Eng. 2022, 46, 103736. [Google Scholar] [CrossRef] [Scilit]
  192. Hu, Z.-Z.; Zhang, J.-P.; Yu, F.-Q.; Tian, P.-L.; Xiang, X.-S. Construction and facility management of large MEP projects using a multi-Scale building information model. Adv. Eng. Softw. 2016, 100, 215–230. [Google Scholar] [CrossRef] [Scilit]
  193. Project Management Institute. A Guide to the Project Management Body of Knowledge: (PMBOK® Guide); Project Management Institute: Newtown Square, PA, USA, 2018. [Google Scholar]
  194. Yin, X.; Liu, H.; Chen, Y.; Wang, Y.; Al-Hussein, M. A BIM-based framework for operation and maintenance of utility tunnels. Tunn. Undergr. Sp. Technol. 2020, 97, 103252. [Google Scholar] [CrossRef] [Scilit]
  195. Matarneh, S.T.; Danso-Amoako, M.; Al-Bizri, S.; Gaterell, M.; Matarneh, R.T. BIM for FM Developing information requirements to support facilities management systems. Facilities 2019, 38, 378–394. [Google Scholar] [CrossRef] [Scilit]
  196. Baiardi, L.; Paoletti, I.; Puglisi, V.; Converso, S. Digital control room for the project and management of complex buildings. Techne-J. Technol. Archit. Environ. 2019, 18, 263–271. [Google Scholar]
  197. Su, L. Digitalization and Application Research of BIM-Based Power Plants Lifecycle Information. In Smart Innovation, Systems and Technologies; CRRC Information Technology Co., Ltd.: Beijing, China, 2017; Volume 62, pp. 218–224. [Google Scholar]
  198. Yang, X.; Ergan, S. Leveraging BIM to Provide Automated Support for Efficient Troubleshooting of HVAC-Related Problems. J. Comput. Civ. Eng. 2016, 30, 04015023. [Google Scholar] [CrossRef] [Scilit]
  199. Bin Ismail, Z.A. Towards a BIM-based approach for improving maintenance performance in IBS building projects. Eng. Constr. Archit. Manag. 2021, 28, 1468–1490. [Google Scholar] [CrossRef] [Scilit]
  200. Uhm, M.; Lee, G. Information Requirements for Managing Higher Education Facilities Using Building Information Modeling: Triangular Study of US and Korean Cases. J. Comput. Civ. Eng. 2021, 35, 04021025. [Google Scholar] [CrossRef] [Scilit]
  201. Fang, Z.; Liu, Y.; Lu, Q.; Pitt, M.; Hanna, S.; Tian, Z. BIM-integrated portfolio-based strategic asset data quality management. Autom. Constr. 2022, 134, 104070. [Google Scholar] [CrossRef] [Scilit]
  202. Kamal, Z.; Taghaddos, H.; Karimi, H. BIM-Based Maintenance Management System for Healthcare Facilities. J. Perform. Constr. Facil. 2021, 35, 04021036. [Google Scholar] [CrossRef] [Scilit]
  203. Wen, Y.; Tang, L.C.M.; Ho, D.C.W. A BIM-based space-oriented solution for hospital facilities management. Facilities 2021, 39, 689–702. [Google Scholar] [CrossRef] [Scilit]
  204. Zadeh, P.A.; Wei, L.; Dee, A.; Pottinger, R.; Staub-French, S. BIM-citygml data integration for modern urban challenges. J. Inf. Technol. Constr. 2019, 24, 318–340. [Google Scholar]
  205. Bosurgi, G.; Pellegrino, O.; Sollazzo, G. Pavement condition information modelling in an I-BIM environment. Int. J. Pavement Eng. 2021, 1–16. [Google Scholar] [CrossRef] [Scilit]
  206. Alavi, H.; Bortolini, R.; Forcada, N. BIM-based decision support for building condition assessment. Autom. Constr. 2022, 135, 104117. [Google Scholar] [CrossRef] [Scilit]
  207. Park, S.; Ju, S.; Yoon, S.; Nguyen, M.H.; Heo, J. An efficient data structure approach for BIM-to-point-cloud change detection using modifiable nested octree. Autom. Constr. 2021, 132, 103922. [Google Scholar] [CrossRef] [Scilit]
  208. Balakrishnan Selvakumaran, S.; Hall, D.M. From crowd to cloud: Simplified automatic reconstruction of digital building assets for facility management. J. Facil. Manag. 2022, 20, 401–436. [Google Scholar] [CrossRef] [Scilit]
  209. Zhao, J.; Feng, H.; Chen, Q.; Garcia de Soto, B. Developing a conceptual framework for the application of digital twin technologies to revamp building operation and maintenance processes. J. Build. Eng. 2022, 49, 104028. [Google Scholar] [CrossRef] [Scilit]
  210. Fang, T.C.; Zhao, Y.M.; Gong, J.; Wang, F.L.; Yang, J. Investigation on Maintenance Technology of Large-Scale Public Venues Based on BIM Technology. Sustainability 2021, 13, 18. [Google Scholar] [CrossRef] [Scilit]
  211. Matos, R.; Rodrigues, F.; Rodrigues, H.; Costa, A. Building condition assessment supported by Building Information Modelling. J. Build. Eng. 2021, 38, 102186. [Google Scholar] [CrossRef] [Scilit]
  212. Wang, L.; Li, W.; Feng, W.; Yang, R. Fire risk assessment for building operation and maintenance based on BIM technology. Build. Environ. 2021, 205, 108188. [Google Scholar] [CrossRef] [Scilit]
  213. Fialho, B.C.; Codinhoto, R.; Fabricio, M.M.; Estrella, J.C.; Neves Ribeiro, C.M.; Dos Santos Bueno, J.M.; Doimo Torrezan, J.P. Development of a BIM and IoT-Based Smart Lighting Maintenance System Prototype for Universities’ FM Sector. Buildings 2022, 12, 99. [Google Scholar] [CrossRef] [Scilit]
  214. Ensafi, M.; Harode, A.; Thabet, W. Developing systems-centric as-built BIMs to support facility emergency management: A case study approach. Autom. Constr. 2022, 133, 104003. [Google Scholar] [CrossRef] [Scilit]
  215. Samsami, R.; Mukherjee, A.; Brooks, C.N. Mapping Unmanned Aerial System Data onto Building Information Modeling Parameters for Highway Construction Progress Monitoring. Transp. Res. Rec. 2022, 2676, 669–682. [Google Scholar] [CrossRef] [Scilit]
  216. Edirisinghe, R.; Pablo, Z.; Anumba, C.; Tereno, S. An Actor-Network Approach to Developing a Life Cycle BIM Maturity Model (LCBMM). Sustainability 2021, 13, 25. [Google Scholar] [CrossRef] [Scilit]
  217. Moretti, N.; Ellul, C.; Re Cecconi, F.; Papapesios, N.; Dejaco, M.C.M.C. GeoBIM for built environment condition assessment supporting asset management decision making. Autom. Constr. 2021, 130, 103859. [Google Scholar] [CrossRef] [Scilit]
  218. Ma, J.W.; Czerniawski, T.; Leite, F. An application of metadata-based image retrieval system for facility management. Adv. Eng. Inform. 2021, 50, 101417. [Google Scholar] [CrossRef] [Scilit]
  219. Su, G.; Kensek, K. Fault-detection through integrating real-time sensor data into BIM. Inf. Constr. 2021, 73, 8. [Google Scholar]
  220. Jofrebriceno, C.; Rivera, F.M.-L.; Atencio, E.; Herrera, R.F. Implementation of facility management for port infrastructure through the use of UAVs, photogrammetry and BIM. Sensors 2021, 21, 6686. [Google Scholar] [CrossRef] [Scilit]
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Article Metrics

Citations

Article Access Statistics

Multiple requests from the same IP address are counted as one view.
