Development of the RACI Model for Processes of the Closure Phase in Construction Programs
Abstract
:1. Introduction
2. Literature Review
2.1. Construction Program

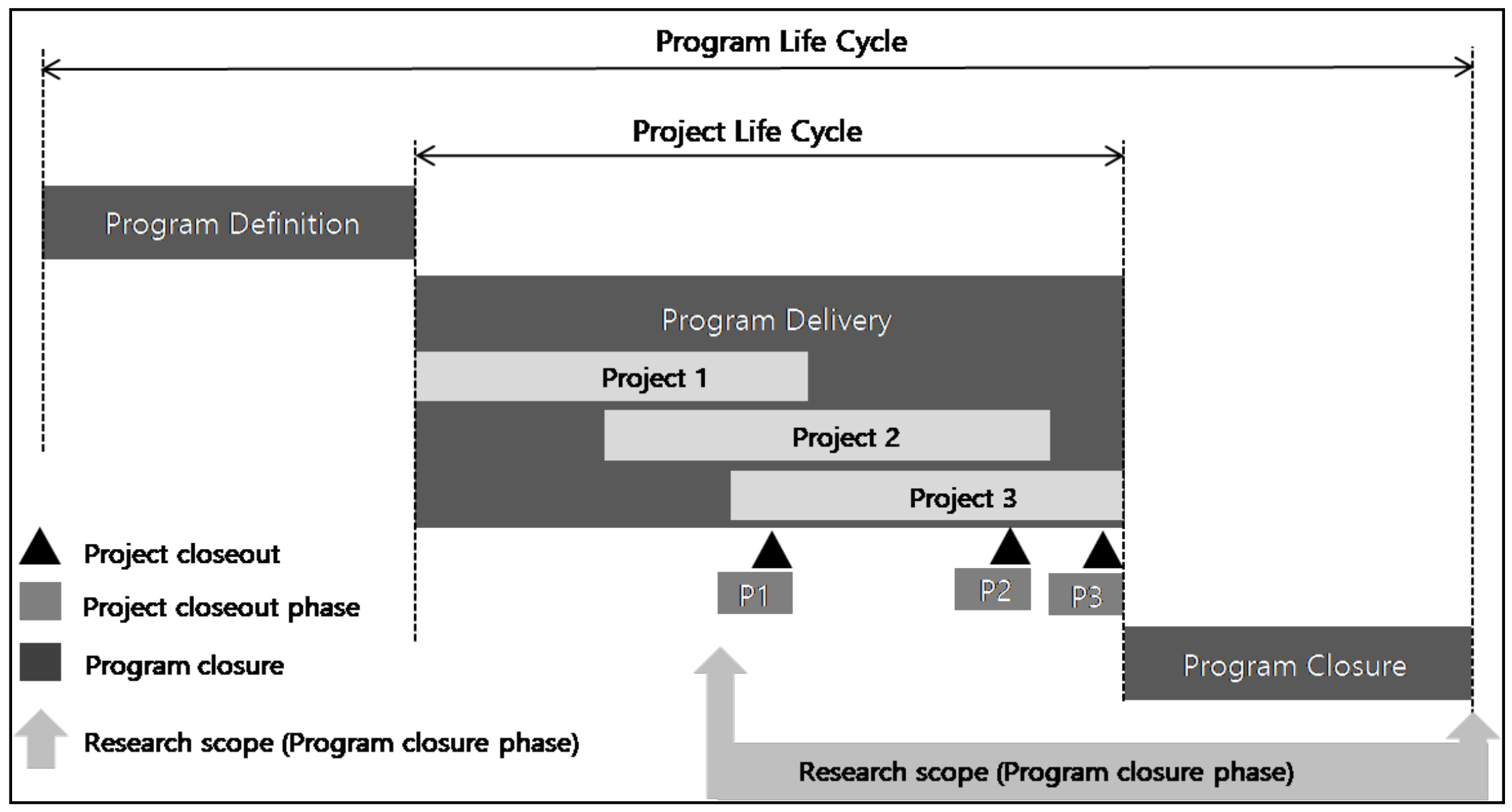

2.2. Program Life Cycle and Closure Phase
2.2.1. Project Life Cycle and Closeout Phase
2.2.2. Program Life Cycle and Closure Phase
2.2.3. Difference between Project and Program Closure Phases
2.3. Responsibility Assignment Matrix Analysis Techniques
3. Research Framework
3.1. Research Targets and Methods

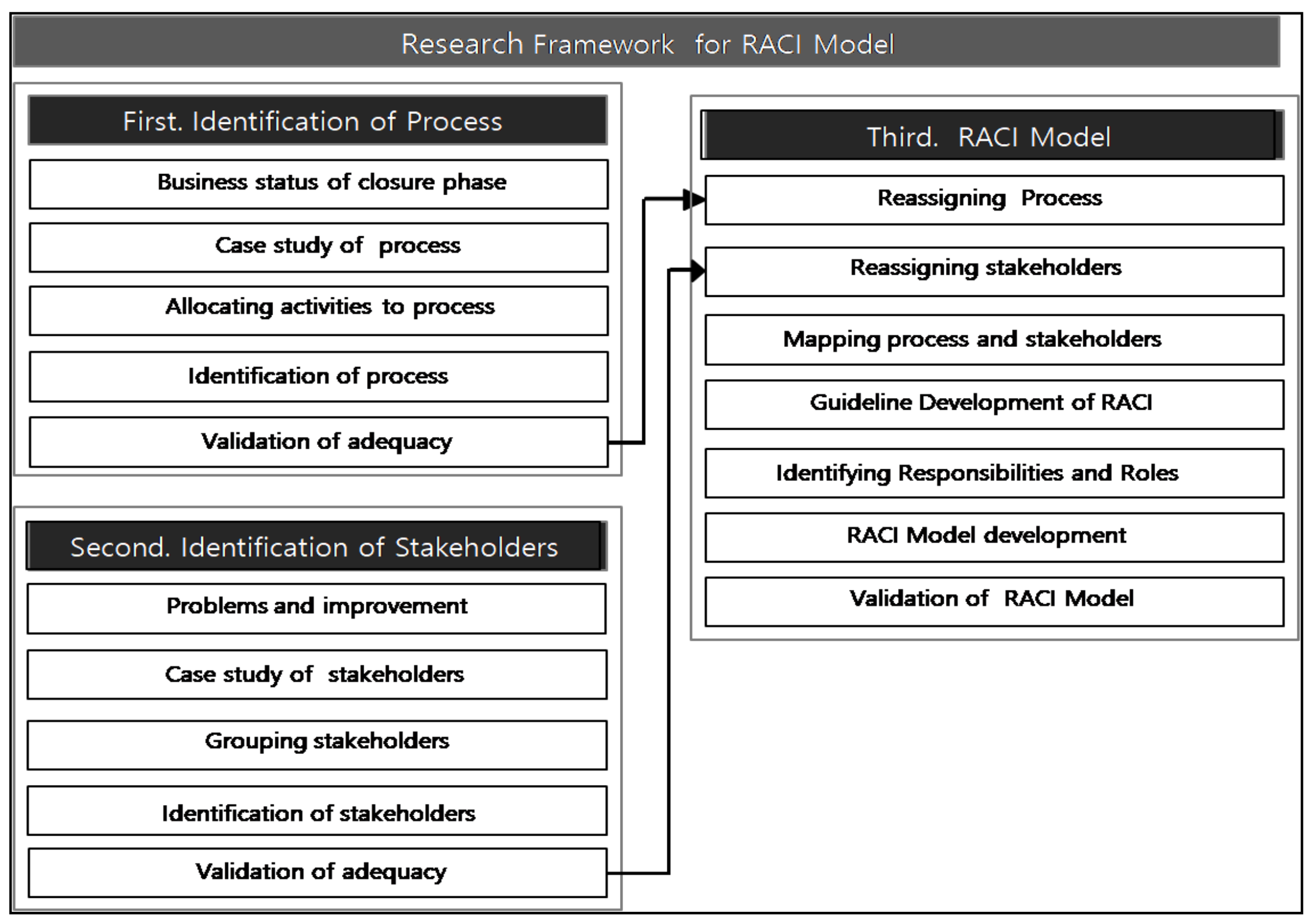

3.2. Research Framework
4. Process Identification of Closure Phase
4.1. Case Studies of Work Processes at the Closure Phase
4.2. Identification of Closure Phase Activities
4.3. Reorganization of Closure Phase Processes
4.4. Categorization of Activities for Each Process
4.5. Expert Validation

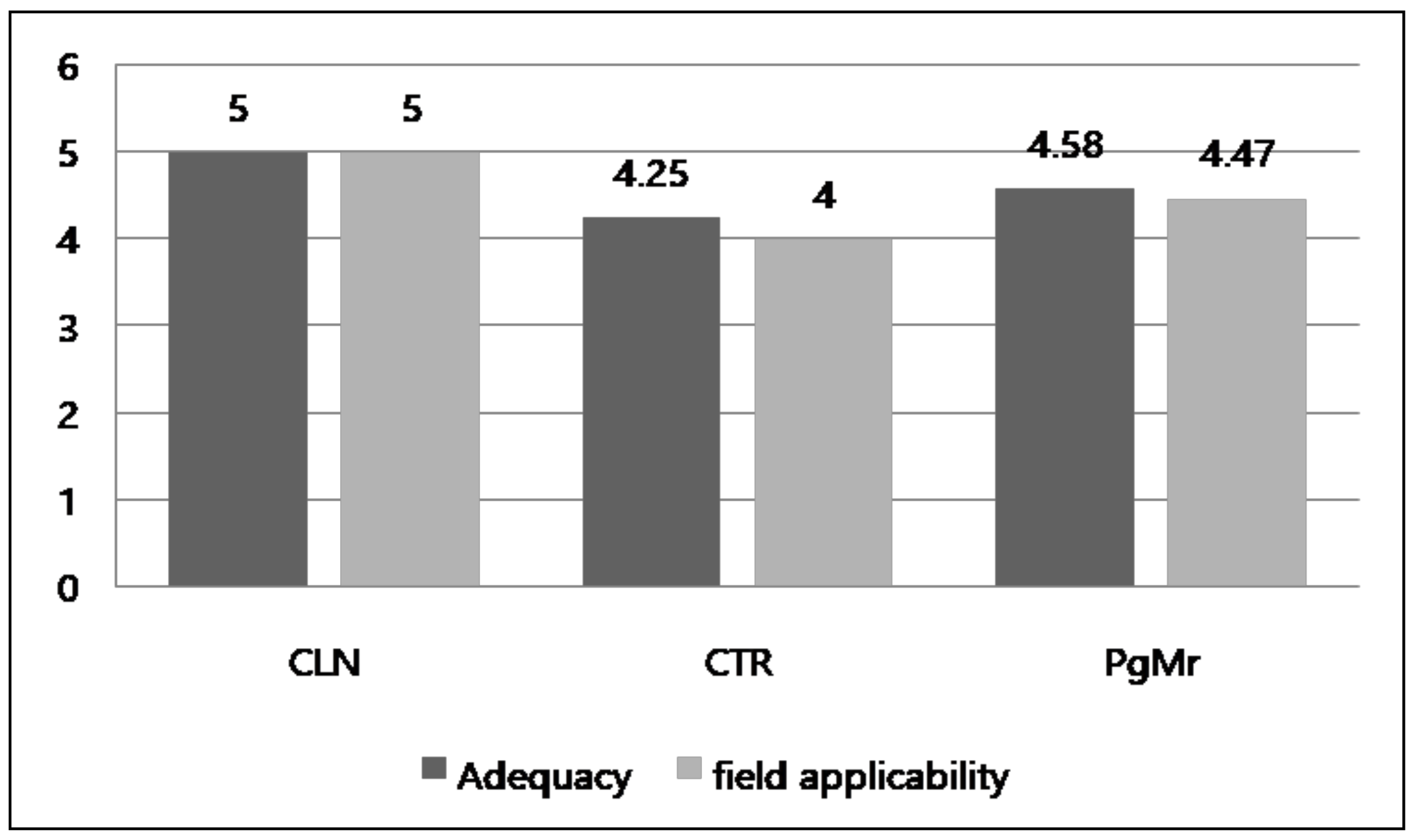

4.5.1. Adequacy and Field Applicability
4.5.2. Interviews on the Results
4.6. Subconclusion
5. Stakeholder Identification at Closure Phase
5.1. Definition of Stakeholder’s Responsibilities and Roles
5.2. Case Studies of Stakeholders at Closure Phase

5.3. Stakeholder Importance
6. RACI Model for Process
6.1. Establishment of Criteria for Stakeholders’ Responsibilities and Roles for Each Process
6.1.1. RACI Table of the MSP Program Closure Phase
6.1.2. USFK Base Relocation Program’s Closure Phase RACI Matrix
6.1.3. Establishment of Criteria for Roles and Responsibilities
6.2. Expert Interviews on Responsibilities and Roles of Stakeholders
6.3. RACI Models Proposed for Each Process
6.4. Validation of RACI Model
6.4.1. Validation of Correlation between Stakeholder Importance and the Responsibilities and Roles
6.4.2. Additional Opinions Regarding Research Results
7. Conclusions
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
Abbreviations
APM | Association for Project Management |
CIOB | Chartered Institute of Building |
CLN, CN | Client |
CM | Construction Management |
CMAA | Construction Management Association of America |
CMAK | Construction Management Association of Korea |
CTR, CT | Contractor |
DoD | Department of Defense |
DOE | Department of Energy |
DPW | Directorate of Public Works |
FAR | Federal Acquisition Regulation |
FED | Far East District |
FF&E | Furniture, Fixtures, and Equipment |
FMI | Fails Management Institute |
IPD | Integrated Project Delivery |
ISO | International Organization for Standardization |
LEED | Leadership in Energy and Environmental Design |
LH | Korea Land and Housing Corporation |
MND | Ministry of National Defense |
MOLIT | Ministry of Land, Infrastructure, and Transport |
MSP | Managing Successful Programmes |
MURO | MND USFK Relocation Office |
PMI | Project Management Institute |
PMC | Program Management Consortium |
PRINCE2 | PRojects IN Controlled Environments |
PgMr, PM | Program Manager |
PMBOK | Project Management Body of Knowledge |
PMO | Program Management Office |
PPP | Public-Private Partnership |
PVT | Performance Verification Test |
O&M | Operation and Maintenance |
RACI | Responsible, Accountable, Consulted, and Informed |
RAM | Responsibility Assignment Matrix |
RIBA | Royal Institute of British Architects |
TAB | Testing Adjusting Balancing |
USACE | US Army Corps of Engineers |
USFK | United States Forces Korea |
US | User |
YRP | Yongsan Relocation Program |
References
- Thomsen, C.; Sanders, S. Program Management 2.0: Concepts and Strategies for Managing Building Programs; Construction Management Association of America: McLean, VA, USA, 2011; pp. 49–69. [Google Scholar]
- PMI. The Standard for Program Management, 4th ed.; PMI: Newtown Square, PA, USA, 2017; pp. 3–14. Available online: http://dl.icdst.org/pdfs/files3/27b0e80bdf3bd39a8d8e69c08b5352da.pdf (accessed on 5 February 2021).
- The Standish Group. The Standish Group Report: Chaos; The Standish Group: Boston, MA, USA, 2015; Available online: https://www.projectsmart.co.uk/white-papers/chaos-report.pdf (accessed on 5 February 2021).
- United States Congress House. Committee on Oversight and Reform. Program Management Improvement Accountability Act, 114th Congress, 2nd Session. 2016. Available online: https://www.congress.gov/bill/114th-congress/senate-bill/1550 (accessed on 5 February 2021).
- Spragins, B.; Dwyer, B.; Lee, E. What to Do When Projects Go Bad, Part 2; FMI Insights: Raleigh, NC, USA, 2017; p. 10. Available online: https://www.fminet.com/wp-content/uploads/2017/06/WhatToDoWhenProjectsGoBad_Part2_FIN.pdf (accessed on 5 February 2021).
- Lee, W.Y.; Lee, S.H.; Cha, Y.H.; Hyun, C.T. A Suggestion of Process in the Construction Program Closure Phase. In Proceedings of the 2019 KICEM Conference; Korea Institute of Construction Engineering and Management: Seoul, Korea, 2019. [Google Scholar]
- Lee, W.Y.; Lee, S.H.; Cha, Y.H.; Hyun, C.T. Identification of Business Process in the Closure Phase of Construction Programs. Korean J. Constr. Eng. Manag. 2020, 21. [Google Scholar] [CrossRef]
- De Furia, G.L. Project Management Recipes for Success, 1st ed.; Auerbach Publications: Boca Raton, FL, USA, 2008; pp. 223–242. [Google Scholar]
- Korea Agency for Infrastructure Technology Advancement. General Report on Technical Level Analysis of Land, Infrastructure and Transport; Korea Agency for Infrastructure Technology Advancement: Anyang-si, Korea, 2015. [Google Scholar]
- Kim, J.H.; Lee, H.S.; Park, M.; Jeong, M.; Lee, I. Effect of Pre-Construction on Construction Schedule and Client Loyalty. Int. J. Civ. Eng. 2016, 10, 845–848. [Google Scholar]
- Bridgers, M. Owner Innovate Capital Programs through Program Management; Quarterly Issue 3; FMI: Denver, CO, USA, 2007. [Google Scholar]
- CMAA. Construction Management Standards of Practice; CMAA Publications: McLean, VA, USA, 2015; pp. 115–117. [Google Scholar]
- CMAA. Program Management Procedure; CMAA Publications: McLean, VA, USA, 2003. [Google Scholar]
- Gunduz, M.; Almuajebh, M. Critical Success Factors for Sustainable Construction Project Management. Sustainability 2020, 12, 1990. [Google Scholar] [CrossRef] [Green Version]
- Maghsoodi, A.I.; Khalilzadeh, M. Identification and Evaluation of Construction Projects’ Critical Success Factors Employing Fuzzy-TOPSIS Approach. KSCE J. Civ. Eng. 2018, 22, 1593–1605. [Google Scholar] [CrossRef]
- Chan, A.P.C.; Scott, D.; Chan, A.P.L. Factors affecting the success of a construction project. ASCE J. Constr. Eng. Manag. 2004, 130, 153–155. [Google Scholar] [CrossRef] [Green Version]
- Yang, J.; Shen, G.Q.; Drew, D.S.; Ho, M. Critical success factors for stakeholder management: Construction practitioners’ perspectives. ASCE J. Constr. Eng. Manag. 2010, 136, 778–786. [Google Scholar] [CrossRef]
- Sanvido, V.; Parfitt, K.; Guveris, M.; Coyle, M. Critical success factors for construction projects. ASCE J. Constr. Eng. Manag. 1992, 118, 94–111. [Google Scholar] [CrossRef]
- PMI. A Guide to the Project Management Body of Knowledge, 6th ed.; Project Management Institute: Newtown Square, PA, USA, 2017; pp. 354, 547–554. [Google Scholar]
- AXELOS. Managing Successful Projects with PRINCE2, 6th ed.; The Stationery Office (TSO): London, UK, 2017. [Google Scholar]
- ISO. ISO 21500, Guidance on Project Management; ISO: Geneva, Switzerland, 2012. [Google Scholar]
- RIBA. RIBA Plan of Work; RIBA: London, UK, 2020. [Google Scholar]
- CIOB. Code of Practice for Project Management for Construction and Development, 5th ed.; Wiley-Blackwell: Oxford, UK, 2014. [Google Scholar]
- Association for Project Management (APM). APM Body of Knowledge, 6th ed.; Association for Project Management: London, UK, 2012. [Google Scholar]
- CMAA. Project Closeout Guideline; CMAA Publications: McLean, VA, USA, 2020. [Google Scholar]
- Ministry of Land, Infrastructure and Transport. Construction Technology Promotion Act; Ministry of Land, Infrastructure and Transport: Sejong, Korea, 2020.
- ISO. ISO 21503, Project, Programme and Portfolio Management—Guidance on Programme Management; ISO: Geneva, Switzerland, 2017; pp. 13–14. [Google Scholar]
- Thiry, M. Program Management; Gower Publishing Company: Aldershot, UK, 2015; pp. 253–261. [Google Scholar]
- Lock, D.; Wagner, R. Gower Handbook of Programme Management; Gower Publishing, Ltd.: Aldershot, UK, 2016. [Google Scholar]
- Anthony, O. APM Research Fund Series: How Can We Hand over Projects Better. 2017. Available online: https://www.apm.org.uk/media/6153/handoverreport_2017_final.pdf (accessed on 21 June 2020).
- Thirion, C. Effective Handover of Projects to Operations Teams. 2018. Available online: https://www.ownerteamconsult.com/effective-handover-of-projects-to-operations-teams/ (accessed on 21 June 2020).
- Office of Government Commerce(OGC). Managing Successful Programmes; The Stationery Office: London, UK, 2011; pp. 177, 227–230. [Google Scholar]
- Karna, S. Analysing customer satisfaction and quality in construction—The case of public and private customers. Nord. J. Surv. R. Estate. Res. 2004, 2, 76–78. [Google Scholar]
- Chanter, B.; Swallow, P. Building Maintenance Management, 2nd ed.; Wiley-Blackwell: Hoboken, NJ, USA, 2007; p. 120. [Google Scholar]
- Smith, M.L.; Erwin, J. Role and Responsibility Charting (RACI); Project Management Forum (PMForum): Dubai, UAE, 2005; p. 5. [Google Scholar]
- Project Management Association of Japan (PMAJ). P2M: A Guidebook of Project & Program Management for Enterprise Innovation, Project Management Association of Japan; Project Management Association of Japan: Tokyo, Japan, 2017; p. 29. [Google Scholar]
- Korea CM Association. 2019 Construction Management Capability Assessment and Disclosure Data Collection; Korea CM Association: Seoul, Korea, 2019. [Google Scholar]
- LH. Construction Management Guideline for Yongsan Relocation Program; Korea Land and Housing Corporation: Jinju, Korea, 2012. [Google Scholar]
- Korea Land and Housing Corporation (LH). Experience and Knowledge of the Yongsan Relocation Plan; Korea Land and Housing Corporation: Jinju, Korea, 2018. [Google Scholar]
- Ministry of National Defense (MND). Program Management for USFK Base Relocation Project; Ministry of National Defense: Seoul, Korea, 2020.
- U.S. Army Corps of Engineers. MILCON Project Closeout, The Red Zone Meeting; U.S. Army Corps of Engineers: Washington, DC, USA, 2004. [Google Scholar]
- U.S. Department of Energy. Administrative Change to DOE G 413.3-16A, Project Completion/Closeout Guide; U.S. Department of Energy: Washington, DC, USA, 2015.
- Delaney, J. Construction Program Management; CRC Press: Boca Raton, FL, USA, 2014; pp. 161–166. [Google Scholar]
- Ministry of National Defense (MND). Program Management Work Guidebook for YRP Construction Management; MURO: Seoul, Korea, 2014. [Google Scholar]
- Cha, Y.W.; Kim, J.H.; Hyun, C.T.; Han, S.W. Development of a Program Definition Rating Index for the Performance Prediction of Construction Programs. Sustainability 2018, 10, 2747. [Google Scholar] [CrossRef] [Green Version]
- Young, T. Successful Project Management, 5th ed.; Koggan Page: London, UK, 2016; pp. 98–99. [Google Scholar]
PMI [19] | Initiating | Planning | Executing | Monitoring and Controlling | Closing |
PRINCE 2 [20] | Preproject Initiation | Subsequent Delivery | Final Delivery | ||
ISO21500 [21] | Initiating | Planning | Implementing | Controlling | Closing |
RIBA [22] | Strategic definition | Preparationandbriefing Concept design | Spatial coordination Technical design Construction | Handover | Use |
CIOB [23] | Inception | Feasibility Strategy | Preconstruction Construction | Testing and commissioning Completion, handover, and operation | Postcompletion review and in use |
APM [24] | Concept | Definition | Development | Handover and closure | Benefit realization Operation Termination |
CMAA [25] | Predesign | Design Procurement | Construction | Closeout | |
Korea law [26] | Predesign | Design Procurement | Construction | Postconstruction |
PMI [2] | Definition | Delivery | Closure |
Thiry [28] | Definition | Deployment | Closure |
Gower [29] | Initiate | Delivery | Close |
MSP [30] | Identifying a program Defining a program | Manage traches (Deliver the capability, Realise the benefits) | Close a program |
CMAA [12] | Program development | Design Procurement Construction | Postconstruction |
This research | Definition | Delivery | Closure |
No. | Activities | Cases | |||||
---|---|---|---|---|---|---|---|
A | B | C | D | E | F | ||
1 | Closeout Meeting | ● | ● | ● | |||
2 | Contractor Punch List Inspection | ● | ● | ● | ● | ||
3 | Warranty Management | ● | ● | ● | ● | ● | ● |
4 | Prefinal/Final Inspection | ● | ● | ● | ● | ● | ● |
5 | O&M Manuals and Training | ● | ● | ● | ● | ● | ● |
6 | Confirm User Requirement | ● | ● | ● | |||
7 | Coordination of Communication Requirements | ● | ● | ● | |||
8 | Handover of Keys and Spare Parts | ● | ● | ● | ● | ||
9 | Furniture Installation | ● | ● | ● | |||
10 | Testing, Adjusting, and Balancing, PVT | ● | ● | ● | |||
11 | Commissioning | ● | ● | ● | ● | ● | ● |
12 | Closeout Submittals | ● | ● | ● | |||
13 | Complete Contract Document | ● | ● | ||||
14 | Personnel Reassignment | ● | ● | ● | |||
15 | Test Results Submission | ● | ● | ● | |||
16 | As-built Drawings (Final) | ● | ● | ● | ● | ||
17 | Permit and Completion Submission | ● | ● | ● | |||
18 | Lessons Learned and Risk Transition | ● | ● | ||||
19 | Action Plan for Remaining Open Items | ● | ● | ● | |||
20 | Celebration of Success | ● | |||||
21 | Coordinates Training with End-User | ● | ● | ● | |||
22 | Completion Payment/Final Payroll | ● | ● | ● | |||
23 | Program Completion | ● | ● | ● | |||
24 | Program Projects Interface | ● | ● | ● | |||
25 | Maintenance Management | ● | ● | ● | |||
26 | Program Activation or Startup | ● | ● | ||||
27 | Contractual/Financial Closure | ● | ● | ● | ● | ||
28 | Program Evaluation | ● | ● | ● | |||
29 | Achieve Customer Objectives | ● | ● | ● | |||
30 | Handover Document Signature | ● | ● | ● | ● | ● | ● |
Classification | A: CLN | B: CTR | C: PgMr | |
---|---|---|---|---|
Total respondents (49 persons) | 22 | 8 | 19 | |
Working experience | 1~10 years | 5 | 2 | - |
11~20 years | 9 | 3 | 7 | |
More than 20 years | 8 | 3 | 12 |
Code | Activities | 1st Identified | 2nd Adjusted |
---|---|---|---|
CP 1 | Closeout Meeting | ○ | ★ |
CP 2 | Contractor Punchlist Inspection | ○ | ★ |
CP 3 | Warranty Management | ○ | ★ |
CP 4 | Prefinal/Final Inspection | ○ | ★ |
CP 5 | O&M Manuals and Training | ○ | ★ |
CP 6 | Confirm User Requirement | ○ | ★ |
CP 7 | Coordination of Communication Requirements | ○ | ▲(31) |
CP 8 | Handover of Keys and Spare Parts | ○ | ★ |
CP 9 | Furniture Installation | ○ | ★ |
CP 10 | Testing, Adjusting and Balancing, PVT | ○ | ★ |
CP 11 | Commissioning | ○ | ★ |
CP 12 | Closeout Submittals | ○ | ▲(15) |
CP 13 | Complete Contract Document | ○ | ▲(27) |
CP 14 | Personnel Reassignment | ○ | ★ |
CP 15 | Test Results Submission | ○ | ★ |
CP 16 | As-built Drawing (Final) | ○ | ★ |
CP 17 | Permit & Completion Submission | ○ | ★ |
CP 18 | Lessons Learned and Risk Transition | ○ | ★ |
CP 19 | Action Plan for Remaining Open Items | ○ | ★ |
CP 20 | Celebration of success | ○ | √ |
CP 21 | Coordinates Training with End-User | ○ | ▲(5) |
CP 22 | Completion Payment/Final Payroll | ○ | ▲(27) |
CP 23 | Program Completion | ○ | ▲(27) |
CP 24 | Program Project Interface | ○ | ▲(31) |
CP 25 | Maintenance Management | ○ | ★ |
CP 26 | Program Activation or Startup | ○ | ★ |
CP 27 | Contractual/Financial Closure | ○ | ★ |
CP 28 | Program Evaluation | ○ | ★ |
CP 29 | Achieve Customer Objectives | ○ | ▲(40) |
CP 30 | Handover Document Signature | ○ | ▲(8) |
CP 31 | Interface of Stakeholders | ★ (◎) | |
CP 32 | Closeout Checklist | ★ (◎) | |
CP 33 | Punchlist Completion | ★ (◎) | |
CP 34 | Real Property | ★ (◎) | |
CP 35 | User Move-in Coordination | ★ (◎) | |
CP 36 | Energization | ★ (◎) | |
CP 37 | Operational Trial | ★ (◎) | |
CP 38 | Transition and Relocation | ★ (◎) | |
CP 39 | Communication of Timeline Impact | ★ (◎) | |
CP 40 | Satisfaction Assessment | ★ (◎) |
CMAA (2015) | Delaney (2014) | YRP PgM (2014) | Restructured |
---|---|---|---|
7 Processes | 9 Processes | 8 Processes | 9 Processes |
• Program Completion (i) | • Startup and Testing (c) | • Red Zone Meeting (A) | A. Closeout Meeting |
• Program Projects • Interface (g) | • Owner Training (e) | • O&M Plan, Manual, Training (e) | B. Substantial Completion |
• Maintenance Management (E) | • Beneficial Occupancy (g) | • Testing, Adjusting and Balancing (c) | C. Commissioning |
• Activation (G) | • Substantial Completion (B) | • Commissioning (C) | D. Final Inspection |
• Facility Management (e) | • Punchlist (d) | • Substantial Completion (B) | E. Maintenance Management |
• Administrative Closeout (i) | • Final Inspection (D) | • Final Inspection (D) | F. Handover |
• Program Evaluation (H) | • Final Documentation (d) | • Turnover (F) | G. Activation |
• Final Acceptance (f) | • Contract Closure (i) | H. Program Evaluation | |
• Release of Retention (i) | I. Program Closure |
Process | Activities | |
---|---|---|
A. Closeout Meeting | a1 Closeout Meeting a3 Interface of Stakeholders | a2 User Requirement a4 Closeout Checklist |
B. Substantial Completion | b1 Completion of Contract Document | b2 Contract’s Punchlist Inspection |
C. Commissioning | c1 Commissioning and Startup c3 TAB, PVT, CCTV, LAN | c2 Energization (Elect. Testing) |
D. Final Inspection | d1 Pre and Final Inspection (Plan and Submittal) | d2 Punchlist Completion |
E. Maintenance Management | e1 O&M (Plan and Manual) e3 Warranty Management (Plan and Review) | e2 Training |
F. Handover | f1 Handover (Plan) f3 Keys and Spare Parts f5 Permit Submission | f2 As-Built Drawings f4 Test, Inspection Report f6 Real Property |
G. Activation | g1 FF&E g3 Transition and Relocation | g2 Trial Operational g4 Coordination and Control |
H. Program Evaluation | h1 Satisfaction Assessment | h2 Program Evaluation |
I. Program Closure | i1 Contractual Closure i3 Lessons Learned/Transition | i2 Personnel Reassignment i4 Finalization of Claim |
Cases | Stakeholders | |||
---|---|---|---|---|
CLN | PgMr | CTR | User | |
Incheon International Airport construction | Incheon International Airport Corporation | P company | S company H company K company | Incheon International Airport Corporation |
Gyeongbu High-Speed Railway construction | Korea Rail Network Authority | B company | S company H company D company | Korea Railroad Corporation |
Multi-functional Administrative City construction | National Agency for Administrative City Construction | H company | D company H company L company | Sejong Special Self-Governing City |
Stakeholders | Aver. | Power (P) | ||||
Very High (5) | High (4) | Med. (3) | Low (2) | Very Low (1) | ||
CLN (Pe) | 4.93 | 14 | 1 | - | - | - |
PgMr (Pp) | 4 | 2 | 7 | 2 | - | - |
CTR (Pc) | 3.08 | - | 4 | 5 | 3 | - |
User (Pu) | 4.08 | 4 | 6 | 3 | - | - |
Stakeholders | Aver. | Interest (I) | ||||
Very High (5) | High (4) | Med. (3) | Low (2) | Very Low (1) | ||
CLN (Ie) | 4.87 | 13 | 2 | - | - | - |
PgMr (Ip) | 4.18 | 3 | 7 | 1 | - | - |
CTR (Ic) | 3.67 | 1 | 6 | 5 | - | - |
User (Iu) | 4.38 | 6 | 6 | 1 | - | - |
Stakeholders | Power (A) | Interest (B) | (A×B) | SI (%) | Weight |
---|---|---|---|---|---|
CLN | 4.93 | 4.87 | 24.0 | 34.3 | 0.343 |
PgMr | 4 | 4.18 | 16.7 | 23.9 | 0.239 |
CTR | 3.08 | 3.67 | 11.3 | 16.2 | 0.162 |
User | 4.08 | 4.38 | 17.9 | 25.6 | 0.256 |
Sum (Aver.) | 16.09 (4.0) | 17.1 (4.3) | 69.9 (17.5) | 100 (25) | 1.00 |
Flow Steps | Stakeholders | |||
---|---|---|---|---|
SRO | PgMr | BCMs | Program Office | |
Confirm on-going support is in place | A | R | C | C |
Confirm program closure | A | C | C | I |
Notify program is about to close | A | R | C | I |
Review program | A | C | R | I |
Update and finalize program information | A | R | C | C |
Provide feedback to corporate governance | A | R | C | I |
Disband program organization and supporting functions | A | R | I | I |
Activities | Stakeholders | |||
---|---|---|---|---|
CLN | PMC | CTR | User | |
Red Zone meeting | C | R | C | C |
Contractor’s Completion Inspection | C | A | R | I |
Commissioning | C | A | R | I |
TAB | C | A | R | I |
PVT | C | A | R | I |
Prefinal Inspection | A | R | I | C |
Final Inspection | C | A | R | I |
Q&M Training Plan | C | A | R | I |
Q&M Manual | C | A | R | I |
O&M Training | C | A | R | C |
Closeout Submittals | C | A | R | I |
Warranty Implementation | A | I | R | C |
As-Built Drawings | C | A | R | C |
Keys & Spare Parts | C | A | R | I |
Lessons Learned | C | A | R | I |
Contractual Closure | A | R | C | I |
Warranty Inspection | A | I | R | C |
Stakeholders | Role | Responsibility |
---|---|---|
CLN | • Ensure successful completion of the project in accordance with the contract documents. | • Participate in prefinal inspection and final inspection to confirm construction completion. |
PgMr |
|
|
CTR | • Manage the work so that it is acceptable and completed on time. |
|
User |
|
|
Div. | Description | Point |
---|---|---|
R | Prepare for work activities with responsibility for the performance of the activity | 4 |
A | Approve or sign that activity is acceptable | 3 |
C | Have the information and the ability to complete the task (Supports) | 2 |
I | Notify results, provide information; no consulting required | 1 |
PROCESS Activities | Stakeholders Group (56 People) | |||||||||||||||
---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
CLN (0.343) | PgMr (0.239) | CTR (0.162) | User (0.256) | |||||||||||||
CL | PM | CT | US | CL | PM | CT | US | CL | PM | CT | US | CL | PM | CT | US | |
A. Closeout Meeting | ||||||||||||||||
a1 | 3.12 | 3.85 | 1.83 | 1.16 | 2.86 | 3.88 | 1.83 | 1.33 | 2.85 | 3.85 | 1.85 | 1.28 | 1.32 | 3.5 | 1.84 | 2.5 |
a2 | 2.61 | 1.83 | 1.16 | 3.67 | 2.72 | 1.22 | 1.78 | 3.56 | 2.88 | 1.66 | 1.22 | 3.44 | 2.83 | 1.56 | 1.27 | 3.66 |
a3 | 3.07 | 3.84 | 1.62 | 1.31 | 3.15 | 3.76 | 1.69 | 1.31 | 3.06 | 3.84 | 1.65 | 1.38 | 1.38 | 3.84 | 1.62 | 3.15 |
a4 | 3.15 | 3.84 | 1.69 | 1.38 | 3.07 | 3.92 | 1.62 | 1.31 | 3.07 | 3.92 | 1.69 | 1.37 | 3.08 | 3.93 | 1.38 | 1.62 |
B. Substantial Completion | ||||||||||||||||
b1 | 1.75 | 3.12 | 3.85 | 1.25 | 1.75 | 3 | 3.87 | 1.37 | 1.71 | 3.86 | 3 | 1.42 | 1.38 | 3 | 3.87 | 1.75 |
b2 | 1.87 | 3.87 | 3 | 1.12 | 1.86 | 3.85 | 3.12 | 1.12 | 3.87 | 3.12 | 2 | 1.12 | 1.25 | 3.87 | 3.12 | 1.75 |
C. Commissioning | ||||||||||||||||
c1 | 1.87 | 3.37 | 3.65 | 1.25 | 1.75 | 3.37 | 3.75 | 1.37 | 1.87 | 3.37 | 3.65 | 1.37 | 1.12 | 3.25 | 3.75 | 1.87 |
c2 | 1.87 | 3.12 | 3.87 | 1.12 | 1.87 | 3.25 | 3.75 | 1.25 | 1.65 | 3.25 | 3.75 | 1.37 | 1.87 | 3.25 | 3.75 | 1.37 |
c3 | 2 | 3.25 | 3.75 | 1.25 | 1.87 | 3.25 | 3.75 | 1.12 | 1.65 | 3.25 | 3.75 | 1.25 | 1.25 | 3.25 | 3.75 | 1.12 |
D. Final Inspection | ||||||||||||||||
d1 | 3.5 | 1.5 | 3.87 | 1.12 | 3.25 | 1.65 | 3.65 | 1.25 | 1.65 | 3.25 | 3.75 | 1.12 | 1.37 | 2 | 3.87 | 3.25 |
d2 | 1.65 | 3.25 | 3.87 | 1.25 | 2 | 3.25 | 3.87 | 1.36 | 1.75 | 3.25 | 3.75 | 1.12 | 1.12 | 3.12 | 3.87 | 1.65 |
E. Maintenance Management | ||||||||||||||||
e1 | 1.85 | 3.25 | 3.87 | 1.25 | 1.65 | 3.37 | 3.65 | 1.12 | 2 | 3.25 | 3.87 | 1.35 | 1.12 | 3.12 | 3.75 | 1.75 |
e2 | 1.65 | 1.25 | 3.62 | 3.25 | 1.12 | 1.75 | 3.75 | 3.25 | 3.25 | 1.25 | 3.87 | 1.87 | 1.75 | 1.25 | 3.75 | 3.25 |
e3 | 3.25 | 1.35 | 3.87 | 2 | 3.12 | 1.12 | 3.87 | 1.65 | 3.12 | 1.65 | 3.75 | 1.25 | 3.25 | 1.12 | 3.87 | 1.65 |
F. Handover | ||||||||||||||||
f1 | 2 | 3 | 3.75 | 1 | 1.5 | 3.25 | 3.75 | 1.12 | 1.5 | 3.12 | 3.87 | 1.12 | 1.12 | 3.25 | 3.75 | 1.65 |
f2 | 1.75 | 3.12 | 3.75 | 1.12 | 1.25 | 3.12 | 3.75 | 1.65 | 1.75 | 3.25 | 3.75 | 1.25 | 1.25 | 3.25 | 3.87 | 1.87 |
f3 | 1.75 | 3.25 | 3.75 | 1.12 | 1.12 | 3.15 | 3.87 | 1.65 | 1.25 | 3 | 3.87 | 1.65 | 1.12 | 3.65 | 3.75 | 1.65 |
f4 | 1.75 | 3 | 3.75 | 1 | 1.25 | 3.25 | 3.87 | 1.87 | 1.12 | 3.25 | 3.87 | 1.65 | 1.25 | 3.25 | 3.87 | 1.87 |
f5 | 1.65 | 3.12 | 3.87 | 1.12 | 1 | 3.25 | 3.75 | 1.65 | 1.12 | 3.37 | 3.65 | 1.65 | 1.12 | 3 | 3.87 | 1.75 |
f6 | 1.75 | 3 | 3.87 | 1 | 1.12 | 1.65 | 3.87 | 3 | 3 | 1.75 | 3.87 | 1.12 | 1.25 | 1.75 | 3.75 | 3.25 |
G. Activation | ||||||||||||||||
g1 | 1.75 | 1.12 | 3.87 | 3 | 1.65 | 1.12 | 3.87 | 3 | 1.75 | 1.12 | 3.12 | 3.75 | 1.65 | 1.12 | 3.87 | 3.12 |
g2 | 1.25 | 1.87 | 3.25 | 3.87 | 1.12 | 1.75 | 3.75 | 3.25 | 1 | 3.12 | 1.65 | 3.87 | 1.12 | 1.65 | 3.75 | 3.25 |
g3 | 3 | 1.75 | 1 | 3.75 | 1.65 | 3.25 | 1.25 | 3.75 | 2 | 3.25 | 1.37 | 3.87 | 1.75 | 3 | 1.12 | 3.87 |
g4 | 1.65 | 3.87 | 1 | 3.12 | 1.65 | 3.87 | 1.25 | 3 | 1.75 | 3.87 | 1.25 | 3 | 1.5 | 3.87 | 1 | 3.12 |
H. Program Evaluation | ||||||||||||||||
h1 | 3.12 | 1.75 | 1 | 3.87 | 3.87 | 3.12 | 1 | 1.75 | 3.87 | 1.65 | 1 | 3.12 | 3 | 1.65 | 1.25 | 3.87 |
h2 | 4 | 1.5 | 1 | 3 | 3.87 | 1.5 | 1 | 3.12 | 3.75 | 1 | 1.65 | 3.25 | 3.75 | 3.25 | 1.65 | 1 |
I. Program Closure | ||||||||||||||||
i1 | 1.65 | 3.87 | 3.12 | 1.25 | 3.25 | 3.75 | 1.65 | 1.25 | 1.65 | 3.25 | 3.75 | 1.25 | 3.12 | 3.87 | 1.12 | 1.75 |
i2 | 1.75 | 3.75 | 3.25 | 1.12 | 3.12 | 3.87 | 1.5 | 1.35 | 1.65 | 3.25 | 3.75 | 1.25 | 3.25 | 3.75 | 1.12 | 1.75 |
i3 | 1.65 | 3.85 | 3.12 | 1.25 | 3.12 | 3.87 | 1.75 | 1.12 | 3.25 | 3.75 | 1.5 | 1.37 | 3.12 | 3.87 | 1.25 | 1.65 |
i4 | 1.75 | 3.87 | 3.12 | 1.12 | 1.5 | 3.25 | 3.75 | 1.35 | 1.65 | 3.12 | 3.85 | 1.25 | 1.65 | 3.25 | 3.75 | 1.25 |
Process | Activities | Stakeholders | |||
---|---|---|---|---|---|
CLN | PgMr | CTR | User | ||
A. Closeout Meeting | a1 Closeout Meeting | A(2.55) | R(3.77) | C(1.84) | I(1.56) |
a2 User Requirement | A(2.74) | I(1.59) | I(1.35) | R(3.6) | |
a3 Interface of stakeholders | A(2.65) | R(3.82) | I(1.64) | C(1.79) | |
a4 Closeout Checklist | A(3.1) | R(3.9) | I(1.59) | I(1.42) | |
B. Substantial Completion | b1 Complete Contract Document | I(1.65) | A(3.18) | R(3.72) | I(1.43) |
b2 Contract’s Punch list Inspection | C(2.03) | R(3.74) | A(2.9) | I(1.28) | |
C. Commissioning | c1 Commissioning and Startup | I(1.65) | A(3.34) | R(3.7) | I(1.46) |
c2 Energization (Elect. Testing) | C(1.83) | A(3.21) | R(3.79) | I(1.26) | |
c3 TAB, PVT, CCTV, LAN | I(1.72) | A(3.25) | R(3.75) | I(1.19) | |
D. Final Inspection | d1 Pre and Final Inspection | A(2.6) | C(1.95) | R(3.8) | I(1.7) |
d2 Punch list Completion | I(1.61) | A(3.22) | R(3.85) | I(1.36) | |
E. Maintenance Management | e1 O&M(Plan and Manual) | I(1.64) | A(3.25) | R(3.79) | I(1.36) |
e2 Training | C(1.81) | I(1.37) | R(3.72) | A(3.03) | |
e3 Warranty Management | A(3.2) | I(1.28) | R(3.85) | I(1.71) | |
F. Handover | f1 Handover (Plan) | I(1.57) | A(3.14) | R(3.77) | I(1.21) |
f2 As-built Drawings | I(1.5) | A(3.17) | R(3.78) | I(1.46) | |
f3 Key and Spare Parts | I(1.36) | A(3.29) | R(3.8) | I(1.47) | |
f4 Test, Inspection Report | I(1.4) | A(3.16) | R(3.83) | I(1.54) | |
f5 Permit Submission | I(1.27) | A(3.16) | R(3.81) | I(1.49) | |
f6 Real Property | I(1.67) | C(2.15) | R(3.84) | C(2.07) | |
G. Activation | g1 FF&E (Furniture Installation) | I(1.7) | I(1.12) | R(3.75) | A(3.15) |
g2 Trial Operation | I(1.15) | C(1.99) | A(3.24) | R(3.56) | |
g3 Transition and Relocation | C(2.2) | A(2.67) | I(1.15) | R(3.8) | |
g4 Coordination and Control | I(1.63) | R(3.87) | I(1.1) | A(3.07) | |
H. Program Evaluation | h1 Satisfaction Assessment | R(3.39) | C(2.04) | I(1.06) | A(3.24) |
h2 Program Evaluation | R(3.86) | C(1.87) | I(1.27) | A(2.56) | |
I. Program Closure | i1 Contractual Closure | C(2.41) | R(3.74) | C(2.36) | I(1.38) |
i2 Personnel Reassignment | C(2.45) | R(3.7) | C(2.37) | I(1.36) | |
i3 Lessons Learned/Transition | A(2.64) | R(3.84) | C(2.05) | I(1.34) | |
i4 Finalization of Claim | I(1.65) | A(3.44) | R(3.55) | I(1.23) | |
SUM | 62.63 | 87.21 | 88.01 | 58.08 | |
Relative ratio | 21.2% | 29.5% | 29.7% | 19.6% |
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations. |
© 2021 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (http://creativecommons.org/licenses/by/4.0/).
Share and Cite
Lee, W.-y.; Lee, S.-h.; Jin, C.; Hyun, C.-t. Development of the RACI Model for Processes of the Closure Phase in Construction Programs. Sustainability 2021, 13, 1806. https://doi.org/10.3390/su13041806
Lee W-y, Lee S-h, Jin C, Hyun C-t. Development of the RACI Model for Processes of the Closure Phase in Construction Programs. Sustainability. 2021; 13(4):1806. https://doi.org/10.3390/su13041806
Chicago/Turabian StyleLee, Woo-yeon, Seung-hoon Lee, Chengquan Jin, and Chang-taek Hyun. 2021. "Development of the RACI Model for Processes of the Closure Phase in Construction Programs" Sustainability 13, no. 4: 1806. https://doi.org/10.3390/su13041806
APA StyleLee, W.-y., Lee, S.-h., Jin, C., & Hyun, C.-t. (2021). Development of the RACI Model for Processes of the Closure Phase in Construction Programs. Sustainability, 13(4), 1806. https://doi.org/10.3390/su13041806
