BIM-Based Human Machine Interface (HMI) Framework for Energy Management

Korea Institute of Civil Engineering and Building Technology, Goyang-si 10223, Korea
This article belongs to the Special Issue Sustainable Zero Energy Buildings

Abstract

This study proposes a Building Information Modeling (BIM)-based Human Machine Interface (HMI) framework for intuitive space-based energy management. The BIM-based HMI supports building managers with a method of linking data between BIM and Building Energy Management System (BEMS), which are heterogeneous systems, and provides space-based real-time energy monitoring. This study also proposes a BIM and BEMS data linking framework for systematic BIM-based HMI development. Towards this end, the BIM-based HMI framework was defined after deriving the considerations and requirements necessary for linking the energy control point and BIM through a questionnaire designed by practitioners. Through case analysis, the authors implemented BIM-based HMI and analyzed its effects. The results of the analysis confirmed the positive effects (3.9/5.0) on the connectivity of BIM-based HMI, the benefits (4.3/5.0) for real-time data monitoring, the system function expandability, and the BIM-based spatial intuitiveness.
Keywords:
BIM; HMI; energy; management; BEMS

1. Introduction

In 2020, zero-energy construction became mandatory in South Korea, especially in the public sector. As part of the move, the installation of the Building Energy Management System (BEMS) also became mandatory, along with the beginning of the work to establish the Korea Standard (KS). From 2020, the Ministry of Commerce, Industry and Energy of Korea will mandate BEMS for new buildings with a size of 1000 square meters or more. In addition, the Seoul Metropolitan Government has mandated the construction of BEMS on buildings.
If the Building Information Modeling (BIM) data, which are mandatory for construction projects of national public institutions, are well-utilized, synergy effects would be obtained by linking them with BEMS for energy monitoring.
BIM has a wealth of spatial and attribute information about buildings, whereas BEMS has the data needed for energy management. If the two can be connected to develop a BIM-based Human Machine Interface (HMI) that supports energy data monitoring, an effective energy management system can be developed.
However, BIM is not easy to handle. For example, in order to use the information required by BEMS, the relevant content must be defined in advance and this process may sometimes involve specialized programming. In the process, user requirements may be omitted or changed. Sometimes, the professional BEMS development process makes it difficult to predict which system users will use.
HMI is defined as the means of communication for human–machine interaction. It is widely used for equipment data monitoring. In particular, Supervisory Control and Data Acquisition (SCADA) is used as a core element of the system. HMI encapsulates technical complexity and focuses on how to interface between the user and the technology. This gives intuitiveness to system development and usage from the user view. This study intends to apply the HMI concept from the perspective of BIM-BEMS.
This study proposes a BIM-based HMI framework to support effective energy data monitoring. The framework includes BIM and BEMS data linkage and utilization methods. In addition, this study defines the requirements and utilization procedures necessary for linking energy Monitoring and Control (M&C) points with BIM. Through this concept definition process, a BIM-based HMI is defined for intuitive building energy management, and a BIM-based energy management method using the proposed authoring tool is described. The research plans to develop the proposed BIM-based HMI through case analysis, and to analyze the effect through a questionnaire for practitioners.
To proceed with this research, the researchers will also investigate the related technology trends and derive BIM-based HMI framework requirements with the use of case research. Based on the requirements, the role of each component of the framework and related data items will be defined. In addition, a method of interfacing BIM and BEMS from the perspective of HMI shall be designed. To derive the effects of the designed BIM-based HMI framework, a questionnaire for working-level workers will be conducted and the results will be analyzed.

3. BIM-Based HMI Framework Design

3.1. Overview

To apply BIM-based HMI to energy management, a standardized method of outputting energy management data to the HMI by linking it to the BIM model is required. To this end, the energy data monitoring system construction process was investigated, through which the requirements for frame design were derived. Based on the derived requirements, the framework components were derived, and the roles of each component were defined.
Each component has data needed for linking BIM-BEMS and HMI. In particular, it is necessary to designate a BIM space to be controlled and to connect it to the M&C point in order to use BIM, which involves heterogeneous data, from the viewpoint of energy management. The M&C point must be connected to the sensors installed in the space and facility. These connection data are the configuration information of the concept of metadata, and must be managed in the framework component.
In general, BEMS development follows a waterfall development process. This process verifies step-by-step results each time the design, installation, and operation phases are completed, and proceeds to the next step only if there are no problems. It is inefficient to redevelop the system according to the project requirements. Therefore, the results of BIM-based HMI development should be written data, not a programming code. The framework was designed in consideration of this.

3.2. Process Analysis

The energy management system construction process was investigated through expert advice to define the BIM-based HMI framework. The main steps in developing a general BEMS are as follows.
  • S1. Energy management system establishment requirements and stakeholder definition;
  • S2. System utilization scenario and process definition;
  • S3. Energy M&C point and data item definition;
  • S4. Energy M&C device and sensor definition;
  • S5. Energy management system architecture decision and development;
  • S6. Energy management development, installation, and testing.
The following points should be considered in steps S1 to S6.
  • R1. Classification of responsibility
The energy management system includes software and hardware development. The design, installation, and operation phases must be developed with detailed planning so that the energy management system can be applied to the building in operation. The installation phase includes installation of monitoring devices such as sensors and networks in the field. System development owners may wonder if this phase can be short and handled reliably. For this reason, the roles of system design, equipment installation, and operation should be separated from each other.
  • R2. Application-oriented customization and variability
The system architecture depends on the user requirements, and the implemented system is also developed differently depending on the situation. For example, S3′s M&C points and data items are developed according to the purpose of use. BIM-based HMI needs to consider the variability according to the purpose of its application to enable utilization of the architecture in various situations. Instead of redeveloping the sensors and control points, the BIM-based HMI uses an authoring tool to import the from the library and to define the control points. Through this, it is possible to develop a system that can be customized.
  • R3. Reusability
Functions such as M&C device information and M&C points that change only the data content and not the data processing method increase reusability through configuration information definition and library management. Through this, corresponding parts are not redeveloped, but functions can be implemented through item selection in the authoring tool.
Figure 1 shows a conceptual diagram of how to map the energy management system development process to the BIM-based HMI development process.
Figure 1. Building Information Modeling (BIM)-based Human Machine Interface (HMI) development process mapping concept.
The existing energy management system development process can be mapped to the BIM-based HMI development process as follows.
{S_(1..4)}→{H_(1..4)}, {S_6,7}→{H_5,6}
BIM-based HMI provides a method of creating a project (H1) and authoring, not a method of redeveloping a system. The BIM data that the project wants to use for energy management are defined using the Model View Definition (MVD) Interface (I/F) (H2). M&C devices are selected through a predefined library (H3 and H4). After setting information for energy data monitoring, the operation must be tested and distributed to the HMI server (H5). Then BIM-based HMI must be operated on the deployed server (H6). Here, the BIM server refers to a database system compatible with IFC. The BEMS server provides energy monitoring data.

3.3. Framework Design

To confirm the requirements of the BIM-based HMI framework component, the authors investigated the expected effects of, and the obstacles in, the BIM-based energy management system. Interview items were defined through related technical surveys and expert advice, and a five-point Likert scale was used to develop the questionnaire.
There were 53 interviewers. The interviewees’ work experience fields were architecture and urban (88.7%) and facility (11.3%). The most experienced process fields were design (49.1%), construction (17.0%), construction management and supervision (13.2%) and planning (5.7%). BIM practical experience is less than 2 years (37.7%), 5–10 years (20.8%), 2–5 years (20.8%), 10–15 years (18.9%) and 15 years or more (1.9%). The interviewers knew energy management and some had practical experience.
The expected effects of BIM-BEMS linkage were high in the order of spatial intuitive personality (Q1-2.4.2), BIM information recycling, and information search time reduction (Q1-3.4.0) when monitoring BEMS data, which suggests that many respondents expected that the data search function using spatial information included in the BIM would be helpful in effective energy management in Figure 2.

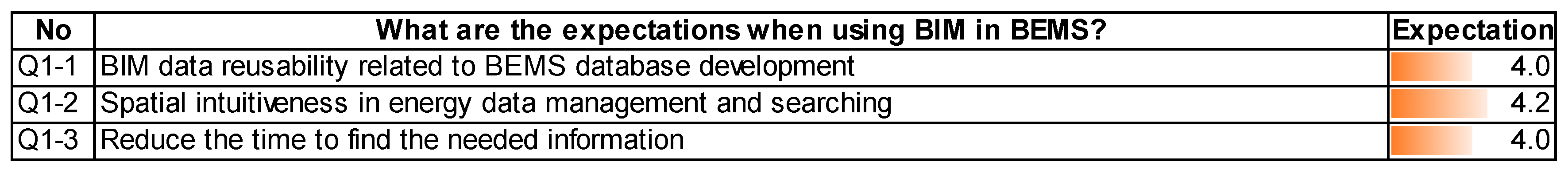

Figure 2. Expected effects of BIM utilization in the energy management system.
On the other hand, obstacles to the use of BIM for energy management include: the burden of time and costs for changing the working method of practitioners (Q2-8.4.1); compatibility with existing systems (Q2-10.4.1); poor environment for BIM system introduction (Q2-1.4.0); insufficient field data and reliability issues (Q2-3.4.0); poor environment for BEMS system introduction (Q2-2.3.9); and excessive data input and construction cost (Q2-11.3.9). The problems are pointed out in order in the figure below.
Among the obstacles listed in Figure 3, those related to BIM-based HMI requirements are Q2-3, Q2-4, Q2-5, Q2-10, and Q2-11, not the institutional and environmental aspects. The priorities are Q2-10, Q2-3, Q2-11, and Q2-5, which point to compatibility issues, excessive data input, and insufficient data reliability issues. For reference, Q2-1, Q2-2, and Q2-8 correspond to the user environment; Q2-6, to the system provider problem; and Q2-7 and Q2-9, to government roles.
Figure 3. Obstacles to utilizing the energy management system and BIM.

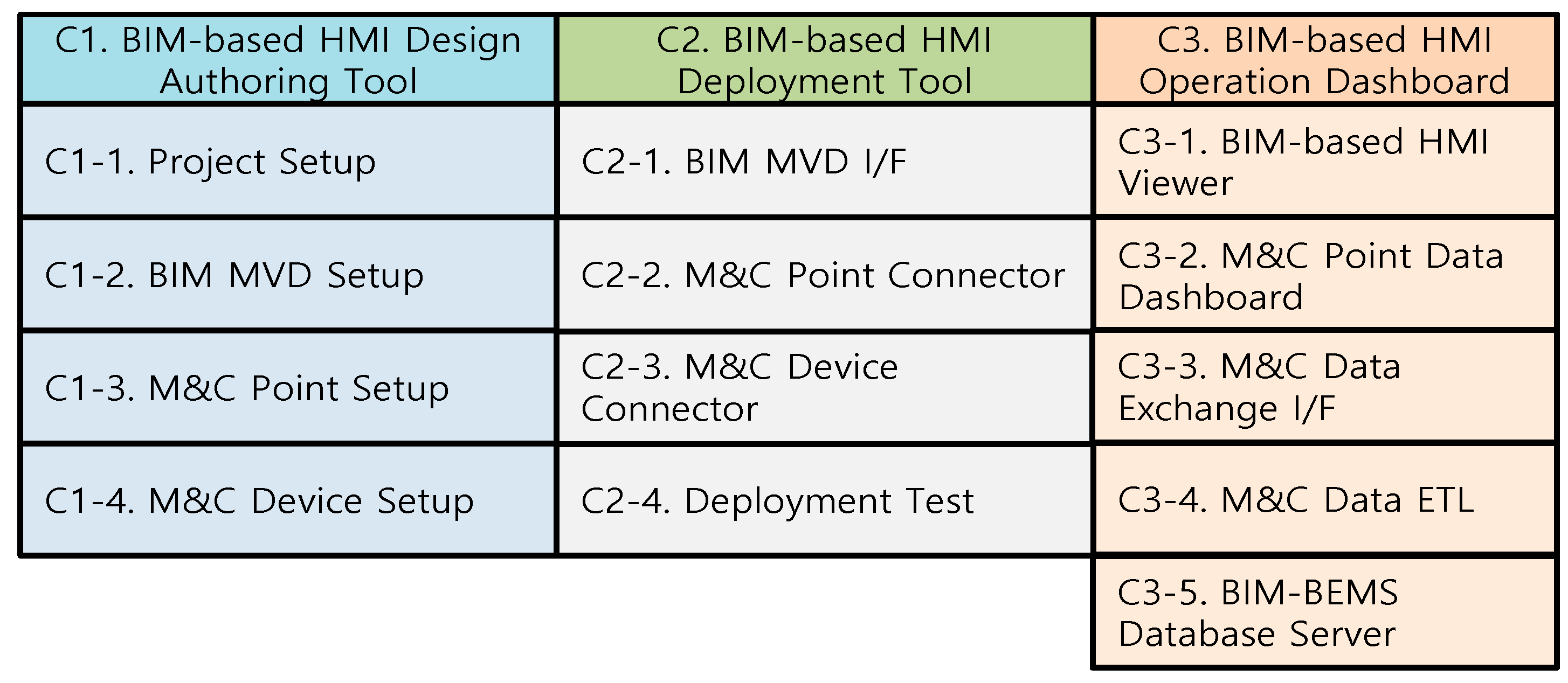

The BIM-based HMI framework is defined as shown in Figure 4, which considers the obstacles found in the investigation.
Figure 4. BIM-based HMI framework.
Each component of the framework is defined in Table 2 by reflecting the previously described BIM-based HMI requirements, development process, and investigated obstacles.
Table 2. BIM-based HMI framework component definition (* = multiple).
The devices described in Table 1 are all needed for energy management and monitoring. Examples of such devices are smart meters, current sensors, voltage sensors, temperature and humidity sensors, and environmental sensors. In general, the communication protocol can be TCP/IP-based MODBUS, MQTT, RESTful API, and others. The M&C Data Exchange I/F (C3-3) must be able to support communication protocols.
The data acquisition cycle and method must be set in the device with sensors to monitor the data set in the M&C points. The data acquired from the set data acquisition cycle are stored in the server before being outputted to the HMI dashboard.
The M&C Data ETL (C3-4) may have the logic for sensing data. The method of acquiring and converting data using the previously designated sensors and setting values may differ depending on the purpose of the data use.

3.4. Considerations for BIM Database Development

The following points must be considered before providing the BIM data needed for energy management.
In general, when BIM is used for heterogeneous systems, the modeled BIM data are converted into an IFC file, which is a standard format. However, it is difficult to use the modeled BIM data structure if it does not fit into the energy management system. Table 3 shows the requirements for developing a BIM database when using BIM data in the proposed BIM-based HMI.
Table 3. Requirements for BIM database development for energy management.

3.5. Sensing Database Design

The data acquired from the sensor device are stored in the Sensing DB Server (D7) as a database with a structure that can be linked to BIM. Figure 5 shows the essential data structure UML (Unified Modeling Language) that considers interrelationships.

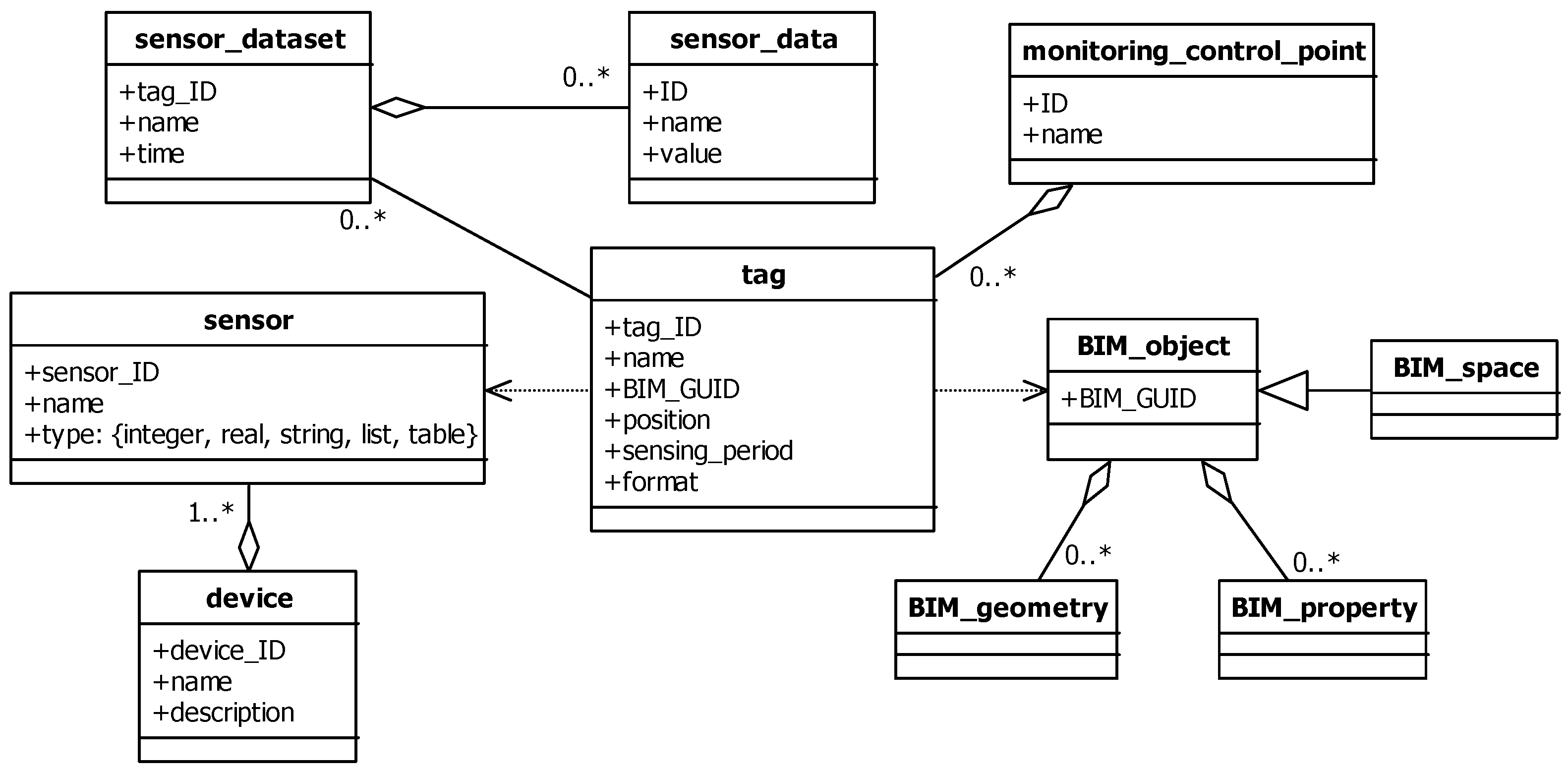

Figure 5. Sensing database structure (Unified Modeling Language (UML)).
Table 4. describes Figure 5 in detail.
Table 4. Sensing database structure.

4. Case Study and Benefits Analysis

4.1. Case Study

In order to test the BIM-based HMI proposed in this study and analyze its effects, a test case was constructed as follows. Based on this case, the researchers operated the BIM-based HMI with the help of practitioners, and analyzed its effects by receiving feedback.
  • T1. Building K BIM data development.
  • T2. Installation of systems and devices for acquiring energy management data in K buildings.
  • T3. BIM-based HMI development and demonstration.
The building modeled in relation to T1 has a building area of 1398.83 m2, 5th floor above the ground and 1 underground. BIM modeling was performed using Autodesk Revit, as shown in Figure 6. The modeling took about one month. It was performed after selecting a space for energy monitoring. Existing drawings were used; and in the case of spaces without drawings, the dimensions of the space were measured through a survey.

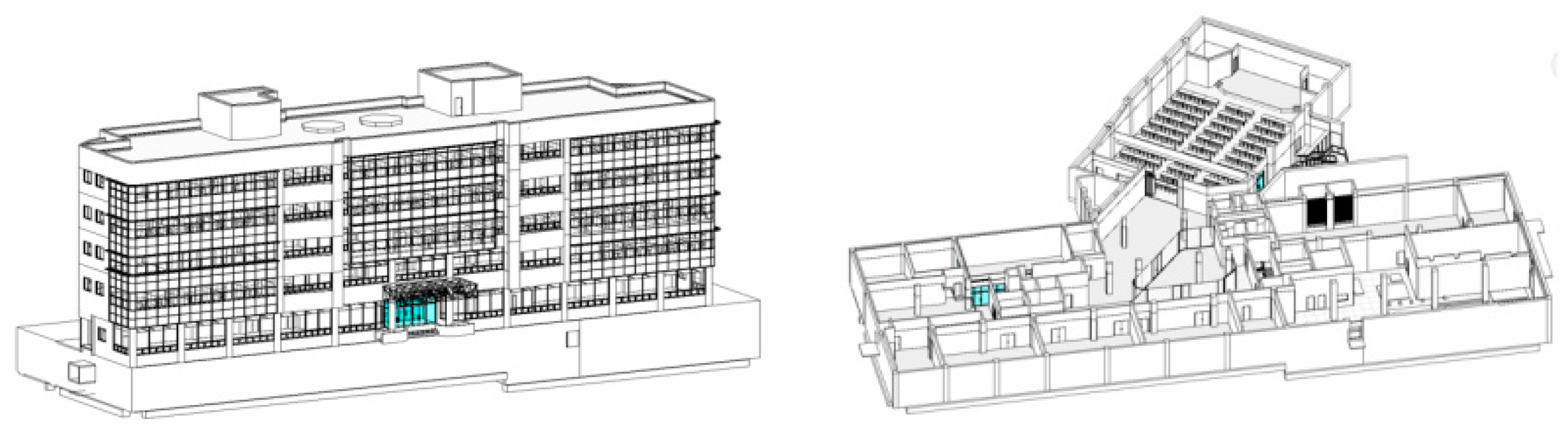

Figure 6. BIM data model.
The BIM model was developed by referring to Table 3 so that it can be used for energy management. The modeled data were converted to the IFC 2 × 3 version and uploaded to the BIM DB server.
Regarding T2, a clip-type meter for measuring power consumption was installed at each control point. The installed information was saved in the Sensing DB.
Regarding T3, a BIM-based HMI framework was implemented using the development tools shown in Table 5. In fact, the part into which a lot of development efforts were put is the component part related to the initial HMI design.
Table 5. BIM-based HMI framework component development method.
The implemented BIM-based HMI log-in account was divided into three phases: design, installation, and operation. The design phase was executed following the steps listed below, using the BIM-based HMI Design Authoring Tool. (The design stage can be performed at high speed because there is no need for a development process such as programming. The process uses only drag and drop and setting. In addition, in similar projects, related setting information is easy to recycle).
  • Create a new BIM-based HMI project.
  • Select and load the BIM and BIM MVD file.
    • The modeled BIM data are filtered by MVD to reduce complexity, because the space and objects required for energy monitoring are part of it. Thereafter, the lightweight BIM data are stored in the BIM server.
  • Select the M&C device from the Device Library.
    • The M&C devices are already registered in the library. The sensor information that can be used for each device is predefined. In this step, only selection of the devices required for monitoring is performed.
  • Create the M&C point.
  • Allocate the M&C device’s sensor to the M&C point as a tag.
    • The sensor of the created M&C device is assigned to the M&C point.
  • Allocate the M&C point to the BIM space or element object.7. Deploy the BIM-based HMI project to the HMI server
    • Since the information required for control is set, the created project is distributed to the HMI server.
When the installation process is completed, the perspective of the HMI UI changes according to the account type after log-in to the BIM-based HMI (Figure 7). The control screen displayed after the log-in (U1) is largely divided into three types (U2). The menus and components that can be used are changed according to the perspective of the HMI UI. On the left side of the screen, the space included in the BIM and the BIM object tree (U3), including the elements, are displayed. Clicking on the control space displays the BIM Viewer for controlling the energy data in the middle of the screen (U4). When a node is selected in the BIM object tree (U5), the control points are listed at the top (U6), and a dashboard (U8) is displayed in the lower part for each tag (U7) set at the control points.

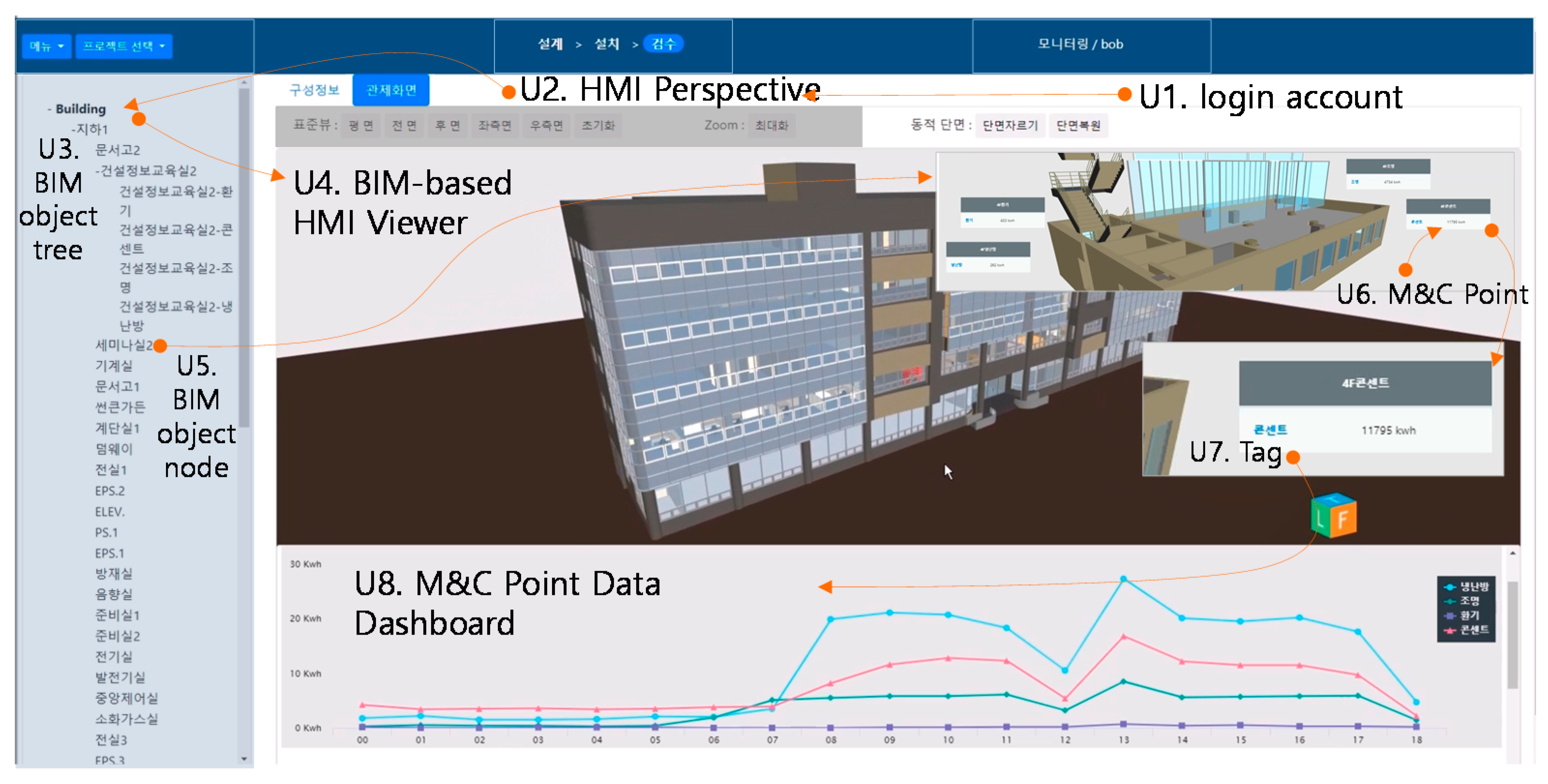

Figure 7. BIM-based HMI UI (user interface).
The BIM Viewer (U4) displays the space being monitored for energy, and allows checking of the location by setting the camera at various viewpoints. If the web-based operation is connected to the Internet, the energy monitoring information can be checked in real time at any time. In addition, by supporting mobile devices such as smartphones, related locations or data can immediately be checked on the site (Figure 8).
Figure 8. BIM-based HMI M&C point and mobile use in the field.
The data obtained for each tag specified in the control point are outputted in the format specified during the design. The sensor name, ID, and data are outputted on the dashboard and can be monitored in various graph formats. If a tag is attached to the BIM element object, it can be clicked to check the related sensor data (Figure 9). In this case, the object is highlighted, and the sensor data are displayed on the right.

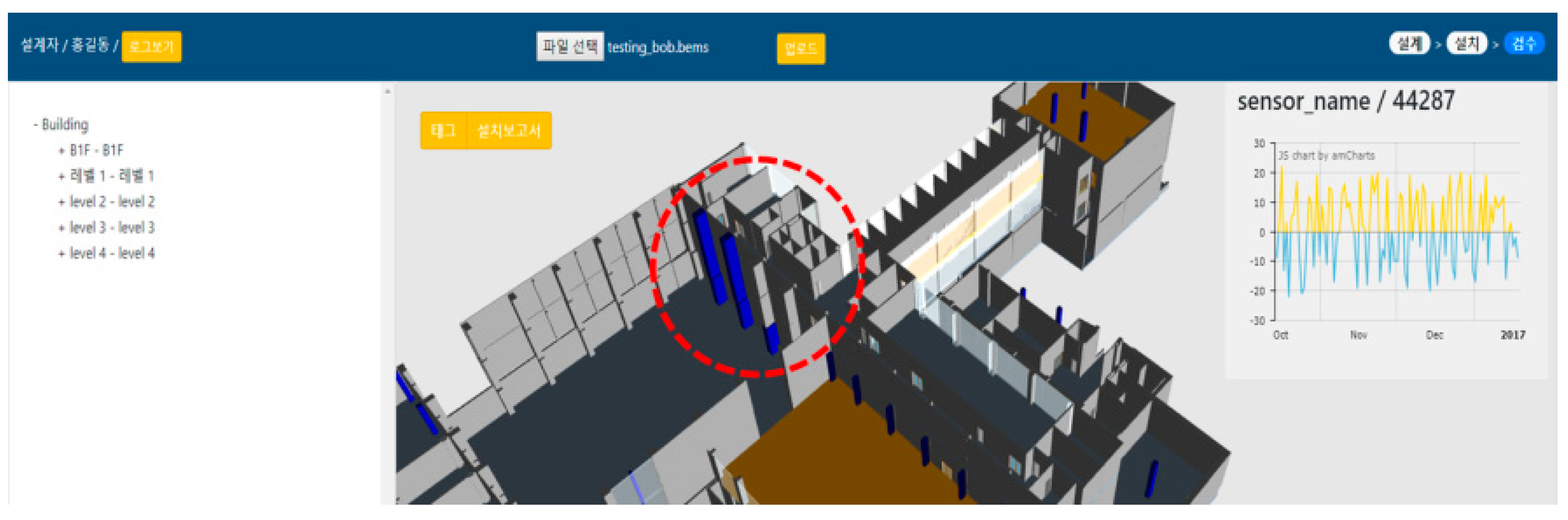

Figure 9. BIM-based HMI.

4.2. Analysis of the Interview Design and Benefits

To analyze the effects of the BIM-based HMI, the researchers conducted interviews with practitioners using a questionnaire after they were asked to use the software. The interviews were held for a month, from 1 October 2019. There were 32 interviewers. The main questions are as follows.
Q3. What do you think is the benefit of BIM-based HMI?
  • Prompt information verification—prompt acquisition and verification of necessary information.
  • Helps save energy—savings through energy monitoring.
  • Intuitive use of spatial information—management is possible in connection with spatial information such as BIM.
  • Scalability—services can be flexibly customized or developed as needed.
  • Real-time service—internet can be accessed anywhere and at any time.
  • Connectivity—internet-based systems and connected services, e.g., sending a text message when an incident occurs.
  • Proactive response—predicting and responding to future management information through data learning
The interviews were conducted with practitioners who have experience in both energy management and BIM. To check the distribution of the respondents, inquiries were made by classifying them into their work field, experienced process stage, working experience, and research experience. The respondents’ fields of work were architecture (40.6%), environment (34.4%), and energy (25.0%). Most of them had practical experience that spanned five to 10 years (37.5%), and the rest, two to five years (18.8%), less than two years (18.8%), 10 to 15 years (15.6%), and 15 years (9.4%) in Figure 10.

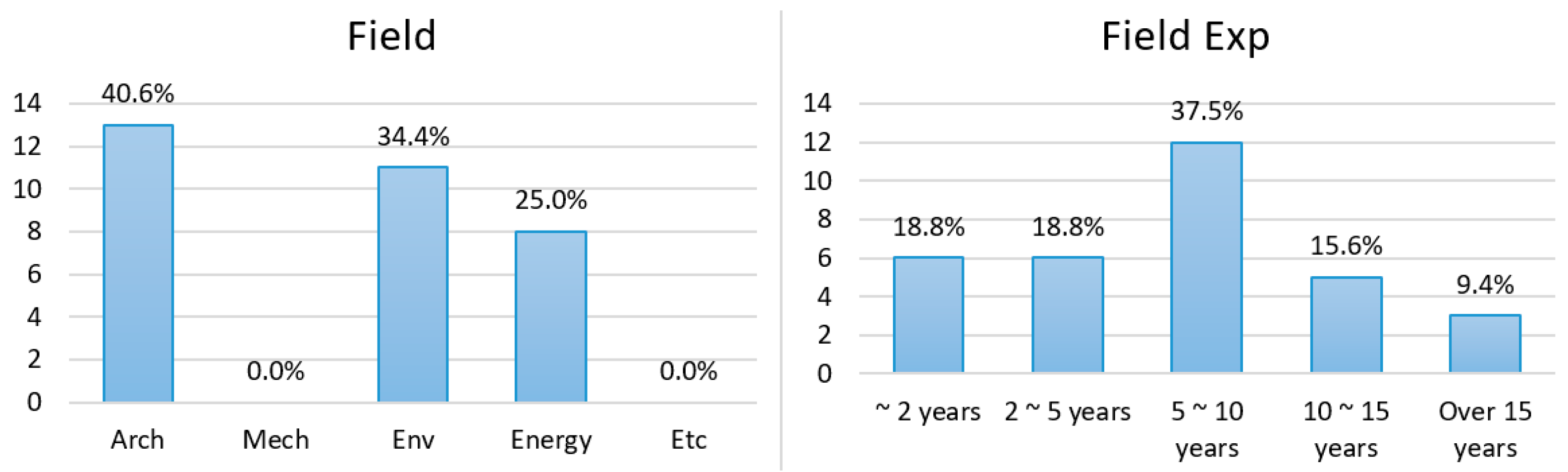

Figure 10. Distribution of the survey targets.
The identified effects of using BIM-based HMI are connectivity (Q3-6, 4.3), real-time service (Q3-5, 4.3), quick information check (Q3-1, 4.2), intuitive use of spatial information (Q3-3, 3.9), scalability (Q3-4, 3.9), and energy-saving help (Q3-7, 3.8) (average: 4.0) in Figure 11. The Cronbach-Alpha value of the survey results was 0.85, indicating good consistency.
Figure 11. Analysis of the benefits of the BIM-based HMI data support.
The interview results showed that the problems that were investigated as requirements when designing the BIM-based HMI framework (Figure 3) are being solved to some extent.
{Q2-10} → {Q3-6, Q3-5}, {Q2-5, Q2-11} → {Q3-1, Q3-3}, {Q2-8} → {Q3-4}
The profit distribution of the BIM-based HMI was relatively examined (Figure 12). It was seen that the respondents perceived that Q5-5 and Q5-6 are relatively more profitable than Q5-2 and Q5-3. As a result, the advantage of BIM-based HMI is recognized as its linkage of the BIM, the sensor device, and the energy management system, and its real-time data monitoring function. However, the survey results showed that the respondents were not clearly aware of the savings effect of energy monitoring. This can be observed only after one has been operating the system for a long time. It seems that the survey questionnaire failed to capture this information.
Figure 12. Analysis of the benefits of the BIM-based HMI data support.

5. Conclusions

This study proposed a BIM-based HMI framework for effective energy data monitoring. To support the proposal, related technology trends were investigated, and the requirements for the BIM-based HMI framework were derived through case investigations. Based on the requirements, the role of each component of the framework and related data items were defined. Through this process, the authors designed a method of interfacing BIM-BEMS from an HMI perspective. As part of the move, 13 components, up to C1-3, were derived. Through case analysis, the proposed BIM-based HMI was developed, and its effects were analyzed through a questionnaire survey of working-level practitioners. The results of the analysis showed that BIM-based HMI had benefits in real-time data monitoring (4.3/5.0), and positive effects in system function expandability and BIM-based spatial intuitiveness (3.9/5.0).
However, this study had limitations. It failed to investigate the energy saving effects after long-term system operation. In a future study, the researchers plan to acquire long-term data from the energy data monitoring device installed in the building to be tested, and to analyze the quantitative effects of the system built with the proposed framework. In addition, the researchers plan to check the effectiveness of the proposed technology for more diverse buildings.

Funding

This research received no external funding.

Acknowledgments

This research was supported by KAIA (Korea Agency for Infrastructure Technology Advancement (KAIA) grant number [20AUDP-B127891-04] and KICT (Korea Institute of Civil Engineering and Building Technology) grant number [KICT 2020-0559].

Conflicts of Interest

The authors declare no conflict of interest.
