2.1. Definitions
The methodology comprises a hybrid Economic Multi-Criteria Decision-Making framework using a Neural Network that merges BIM with the Analytic Hierarchy Process (AHP). BIM serves as a Common Data Environment (CDE) that transcends 3D modelling. Specifically, BIM provides the semantic spatial data (geospatial orientation, building energy demands, and topographical constraints) required to create a Digital Twin of the energy community. This allows for precise simulation of renewable resource potential (like solar incident radiation on specific geometries) and the optimization of energy distribution networks within a smart grid context. BIM simulations visualize energy flows and spatial constraints, while AHP introduces a structured evaluation of alternatives based on defined criteria such as cost, efficiency, environmental impact, and social acceptance. These criteria are weighted through pairwise comparisons, embedding community values into the decision model. This integrated model enables a robust assessment of renewable energy solutions, producing a ranked list supported by consistency ratios and key performance indicator (KPI) analyses. The optimal solution selected is not only technically thorough but also socially endorsed and economically justified. Following the selection, the implementation phase uses BIM visualization tools to communicate the strategy. Renewable technologies are deployed, and BIM-integrated monitoring systems track performance, maintenance, and energy savings in real time, ensuring adaptability to changing conditions. The BIM integration in our study is intended to be dynamic and parametric due to (i) dynamic linking, because parametric models ensure any change to any one part of the system (e.g., penstock geometry or building orientation) automatically updates all related elements; (ii) real-time potential, where the framework supports interoperability for dynamic performance simulations, suggesting the framework is designed for active management rather than just post-construction visualization. The final phase involves reflection and projection, evaluating the effectiveness of the integration and exploring opportunities for scaling or replication (
Figure 1).
Throughout, environmental data from sources like ArcGIS and sustainability criteria are referenced to maintain alignment with broader goals. In the context of hydropower projects, this methodology demonstrates a sophisticated application of BIM [

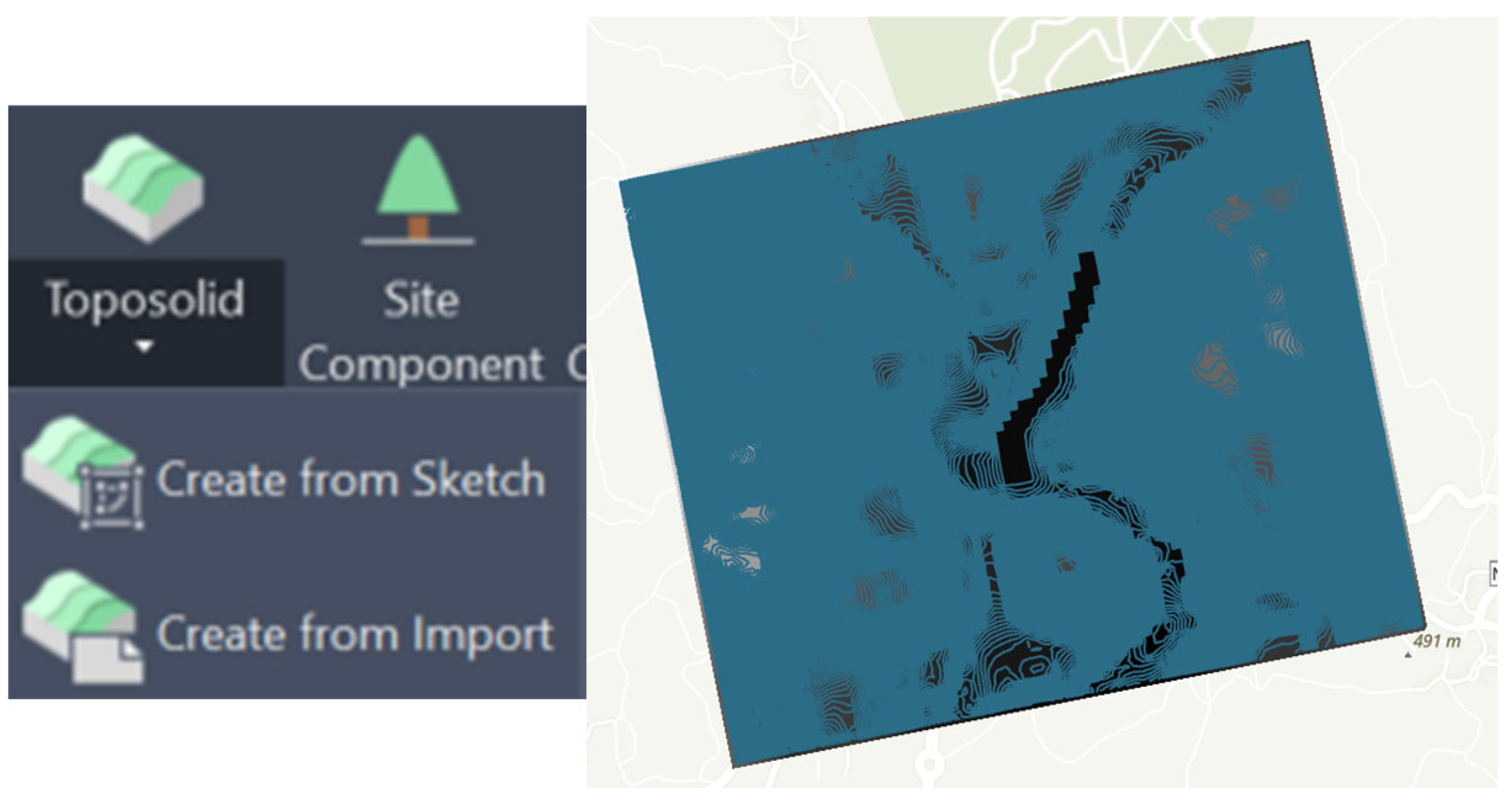

16]. Topographic data sourced from 1.8ArcGIS Pro is processed in AutoCAD 25.1 to generate contour lines and elevation profiles, which are then imported into Revit. Using tools like “Toposolid” and “Toposurface,” a three-dimensional terrain model is constructed, accurately reflecting elevation changes and natural landforms. The model is further enriched with environmental and structural features, such as access roads, vegetation zones, water channels, and nearby buildings, modelled with simplified geometry to preserve spatial relationships and support environmental assessments and stakeholder presentations [
17]. Hydrological data—including river flow paths, reservoir boundaries, and flood zones—is integrated using ARGIS overlays, enabling dynamic analysis of water behaviour in relation to infrastructure [
18]. The model supports interoperability with other BIM tools, facilitating clash detection, construction sequencing, and performance simulations.
Additional topographic corrections refine terrain discontinuities, especially at lateral boundaries, improving slope analysis and runoff simulations. Vegetation modelling, based on satellite imagery and GIS data, enhances visual realism and supports microclimate studies and environmental impact assessments.
In the planning and evaluation of hybrid renewable energy systems, the integration of the Analytic Hierarchy Process (AHP) and Economic Multi-Criteria Decision-Making (EMCDM) provides a comprehensive framework capable of addressing the complexity and multidimensionality of infrastructure decisions. Hybrid systems—often combining solar, wind, hydro, and energy storage—present a unique challenge, as they must be assessed not only on technical performance and economic feasibility [
19,
20]. Traditional financial metrics, such as Net Present Value or Internal Rate of Return, while useful, are insufficient to capture the full spectrum of considerations required for sustainable infrastructure planning. AHP offers a structured approach to decision-making by decomposing the problem into a hierarchy of goals, criteria, and alternatives. This method allows stakeholders to participate actively by assigning relative weights to each criterion through pairwise comparisons, which are then used to calculate priority scores for each alternative. For instance, in a community-driven energy project, stakeholders may prioritize environmental sustainability over initial cost, and AHP can reflect this preference in the final ranking of system configurations. Complemented by AHP, EMCDM introduces a rigorous economic lens to the decision-making process. It integrates financial indicators with different metrics, enabling planners to simulate trade-offs and assess long-term viability under various scenarios. EMCDM can account for externalities such as carbon pricing, maintenance risks, and policy incentives, offering a more nuanced understanding of economic performance [
21]. This methodology supports scenario analysis, allowing decision-makers to explore how fluctuations in energy solutions, technology costs, or regulatory frameworks might influence the feasibility of different hybrid configurations. Together, BIM, AHP, and EMCDM form a synergistic decision-making engine that is both stakeholder-driven and economically grounded. BIM visualises the solution, and AHP captures the values and priorities of the community, while EMCDM ensures that these priorities are evaluated against a robust financial and technical backdrop. This dual approach is particularly effective in hybrid renewable energy planning, where the optimal solution must balance competing interests and adapt to dynamic conditions. BIM tools (Revit and ArcGIS) provide topographic and geometric parameters (e.g., elevation, terrain, building shadows). These parameters are used in simulation software (like PVsyst and HOMER) to generate “Total Renewable” production time-series data, which directly serves as the Exogenous (u) input for the NARX Neural Network. AHP weights to EMCDM: Stakeholder preferences are processed through AHP pairwise comparisons to derive specific priority weights (e.g., for Power Security or Long-Term Profit). These weights are then applied to the normalized performance indicators within the EMCDM matrix, transforming raw simulation outputs into a final ranked score for each energy scenario.
Ultimately, this methodology highlights the synergistic relationship between the three main pillars (BIM, AHP, and EMCDM):
Step 1: Data Generation (BIM and Simulation): BIM-derived spatial and topographic data (from ArcGIS and Revit) drive the technical simulations. These simulations generate the raw Technical Indicators that serve as inputs for the decision matrix.
Step 2: Valuation (AHP): Simultaneously, the AHP process captures subjective stakeholder priorities (e.g., municipal autonomy vs. private profit) through pairwise comparisons. This step produces the Weights for each criterion.
Step 3: Synthesis (EMCDM): The EMCDM framework (using the Multi-Index Methodology) then acts as the integration layer. It takes the weighted values from AHP and applies them to the technical and economic indicators.

Step 4: Decision Output: This interaction transforms raw performance data into a normalized, ranked list of energy configurations (IDs 1–5), ensuring the final choice is “not only technically thorough but also socially endorsed and economically justified”.
So, the integration of these methodologies fosters inclusive, transparent, and adaptive planning. It empowers communities and planners to move beyond one-size-fits-all models and make informed decisions that are technically and economically viable, and socially endorsed. This approach is especially valuable in decentralized energy systems, smart grid development, and climate-resilient infrastructure, where complexity is the norm, and alignment is essential for long-term success.
2.2. BIM Methodology of the Baseline System

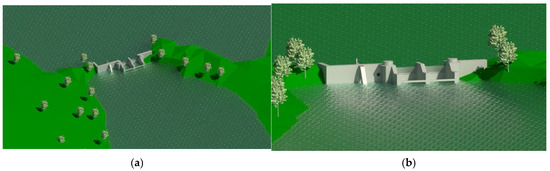

To initiate the study of the turbine solution for the case study hydropower plant, a 3D AutoCAD representation served as the foundational reference. Upon converting this representation into Revit format, it became possible to model the existing infrastructure. Based on the available information regarding the existing structure and the AutoCAD model, it is evident that the adopted solution underwent modifications concerning the type of turbine to be installed. During the integration of the AutoCAD document into the BIM environment, it was observed that the model was defined using a rectangular coordinate system. This system was retained in Revit to ensure accurate positioning of the modelled elements. Consequently, a coordinate correction was necessary, which was achieved by referencing a specific point within the solution representation. To facilitate the modelling process, various elevation levels were defined. Their definition was based on data extracted from the 3D AutoCAD model. Using the imported lines from the AutoCAD document and the previously established levels, the modelling process started. The objective was to achieve a representation that closely mirrored the original reference. Given the uniqueness of the components involved, the modelling was executed using wall elements with variable thicknesses and customized profiles. For specialized geometries, voids were employed. To streamline the analysis of the BIM representation, two key colours were selected: grey for reinforced concrete structures and orange for steel structures corresponding to the sluice gates.
Finally, to complete the modelling of the existing structure, the material characteristics were defined. In the absence of specific data regarding these elements, materials deemed appropriate for the context of the study were assumed (
Table 1).
2.3. Hydropower Plant

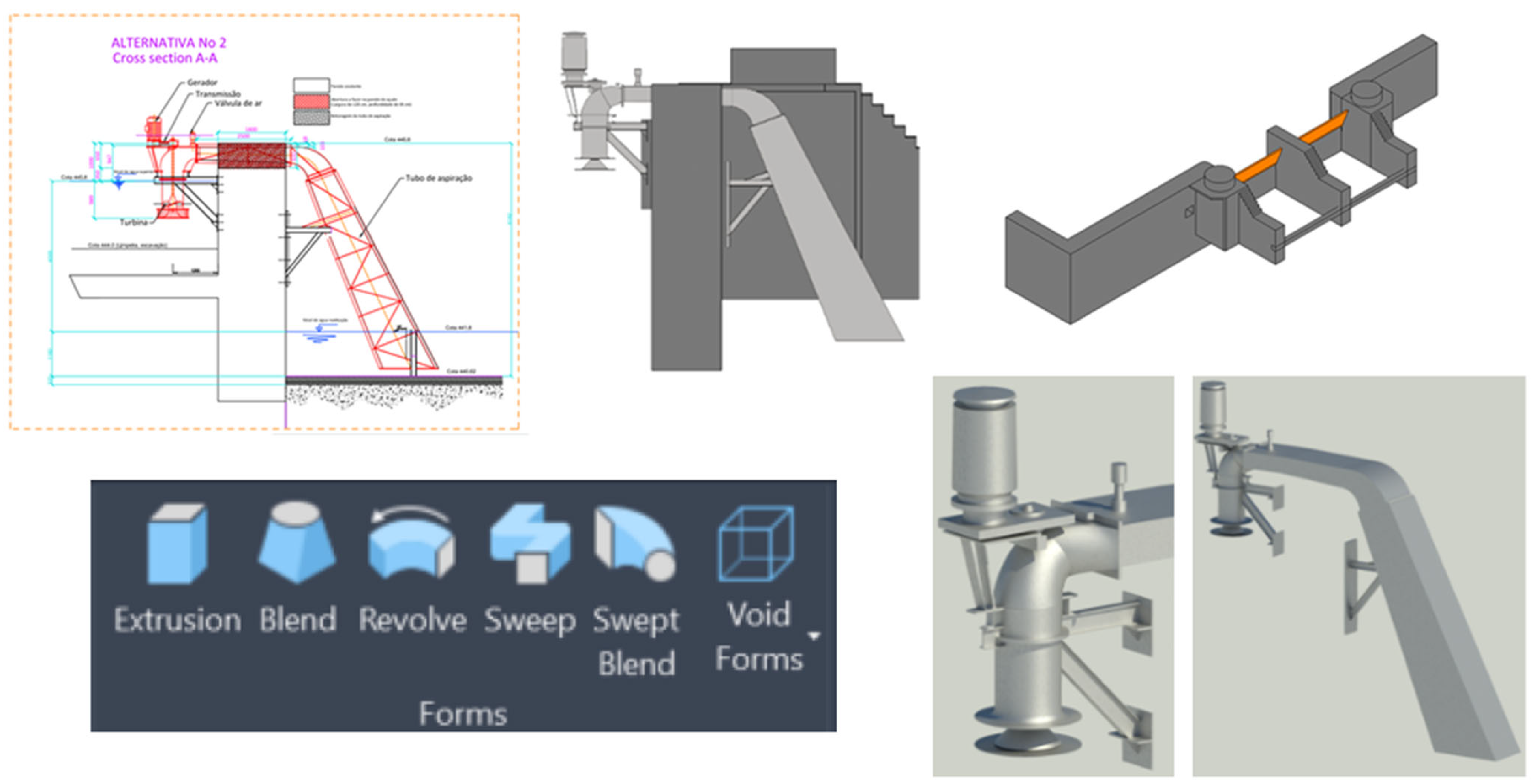

The turbine selected for this study is a siphon-type turbine manufactured by Mavel (Benesov, Czech Republic), model “Turbine TM5”, over the dam, to avoid civil works reconstruction. For the case under analysis, technical drawings were available: a representation of the turbine installed on the dam under study, including the downstream discharge pipes (
Figure 2). For the modelling process, the drawing depicting the turbine already integrated into the dam was used as the primary reference. To model the turbine, a custom family was created in Revit. The AutoCAD representation of the solution was imported, with appropriate scaling applied. The turbine components were modelled using the following Revit functions:
Revolve for cylindrical and straight-axis modules;
Swept Blend for curved segments with varying cross-sections;
Extrusion for straight segments with constant cross-sections.
To enhance realism, the internal geometry of the turbine was also modelled. This was achieved by duplicating the previously created solid components, placing them in the same location, reducing their cross-sections to a thickness of 10 mm for the conduits, and converting these new elements into voids. The Cut function was then applied to subtract the voids from the solids, thereby creating internal cavities. For the modelling of the turbine supports, Extrusion was used for the metal plates and Sweep for the steel profiles shaped like “‡.” These modelling functions are illustrated in

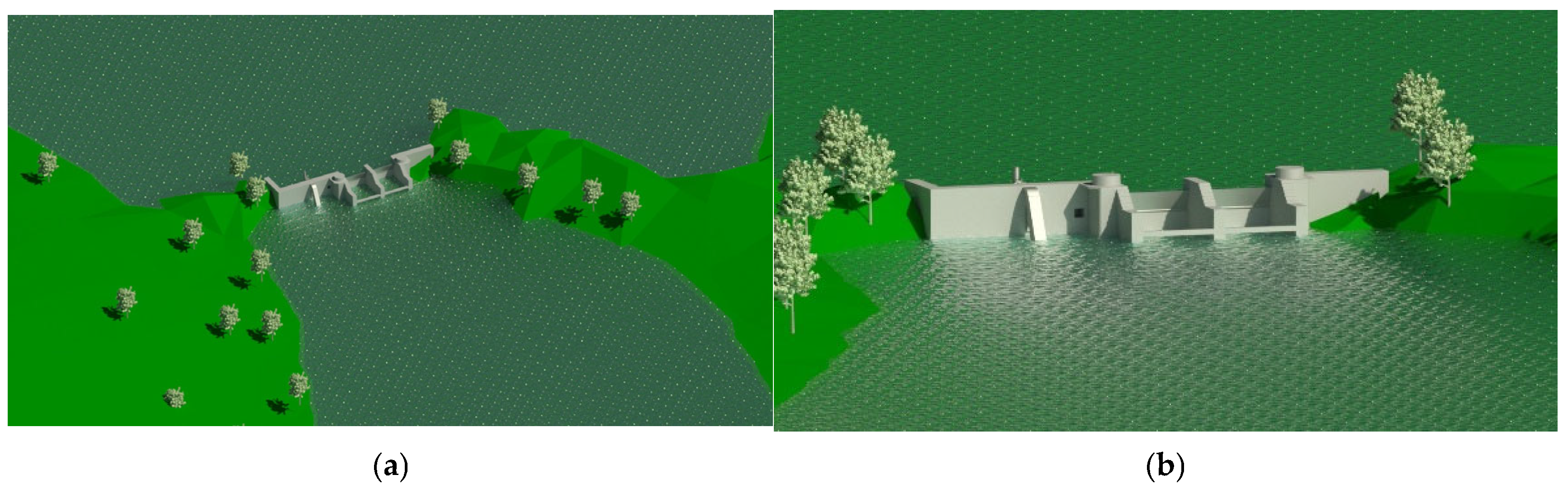

Figure 2. To facilitate understanding of the turbine model, several visual representations were extracted, presenting a general side view of the turbine, including the draft tube and its supports. The turbine itself is shown with a half-axis cut to reveal its interior. Additionally, two renderings were produced to improve the visual clarity of the model. Upon completion of the turbine model, the finalized family is imported into the Revit project and positioned at the designated location.
2.4. Economic Multi-Criteria Decision-Making (EMCDM)
Multi-Index Methodology (MIM) [
12] is applied in this study for the economic evaluation of the hybrid renewable energy system. MIM represents an extended and more comprehensive alternative to the Classical Methodologies of Investment Analysis (CMIA), which primarily rely on a narrow set of financial indicators such as Net Present Value (NPV) and Internal Rate of Return (IRR) (
Table 2). While CMIA can be effective for projects with stable financial conditions, it often lacks the depth required to assess capital-intensive and volatile projects, such as hybrid renewable systems. To address these limitations, MIM introduces a broader framework that evaluates both returns and risks across multiple dimensions. This allows for a more nuanced and reliable assessment of economic viability, especially in scenarios where uncertainty, variability, and long-term investment are involved.
According to [
12,
13], the use of MIM enhances decision-making by improving the visibility of both profitability and risk factors, making it particularly relevant for renewable energy investments. In this research, MIM is employed to evaluate the Hybrid Energy System under realistic financial conditions, enabling a more informed judgment on its economic feasibility.
Self-Sufficiency (SS) represents the proportion of the community’s electricity demand that is met by the hybrid energy system. It indicates how much of the total electricity consumption is supplied directly by the Hybrid Energy System, rather than relying on external sources such as the grid. This KPI is crucial as it reflects the system’s ability to independently satisfy the load demand, which is a key goal in enhancing energy autonomy and resilience. A higher SS value signifies greater reliance on local renewable generation. It is expressed as a percentage and calculated using the following formula:
Loss of Power Supply Probability (LPSP) is a key reliability indicator that quantifies the proportion of time during which the hybrid energy system is unable to meet the electricity demand of the community. It is extensively used in the assessment of hybrid renewable energy systems as a measure of system adequacy and performance:
where U(t) is binary indicator of unmet demand at time step t, E
gen is electricity generation from Hybrid Energy System, and E
load is Electricity demand from the community at the specific hour (h).
where T is the total number of time steps (e.g., 8760 for one year of hourly data). The result is a value between 0% and 100%. LPSP = 0%, perfect system reliability (demand always met). LPSP = 100%, system never meets the load completely.
Power curtailment refers to the unused portion of electricity generated by the hybrid system when production exceeds demand and available storage capacity. This typically occurs during periods of high renewable output, such as midday for solar PV. In this study, curtailed energy is assumed to be exported to the public grid, but at a significantly lower tariff of about 67% less than the purchase price due to model default export assumptions. While curtailment reduces energy waste, elevated levels may indicate oversizing of generation assets and can negatively impact economic efficiency.
This formula is valid in case of no energy exported to the public grid and no storage used. The Levelized Cost of Energy (LCOE) quantifies the average cost of generating one kilowatt-hour of electricity over an energy system’s lifetime, accounting for both capital (CAPEX) and operational (OPEX) expenses. While infrastructure aging can increase maintenance costs, a constant value to maintain model stability across the 25-year projection was used. Future iterations of the framework could incorporate a non-linear degradation factor for maintenance costs. As a standardized metric, it enables cost-effectiveness comparisons across technologies and scales. In this study, LCOE is used to evaluate the economic viability of hybrid configurations by relating total system costs to total energy output.
2.5. Neural Network Structure

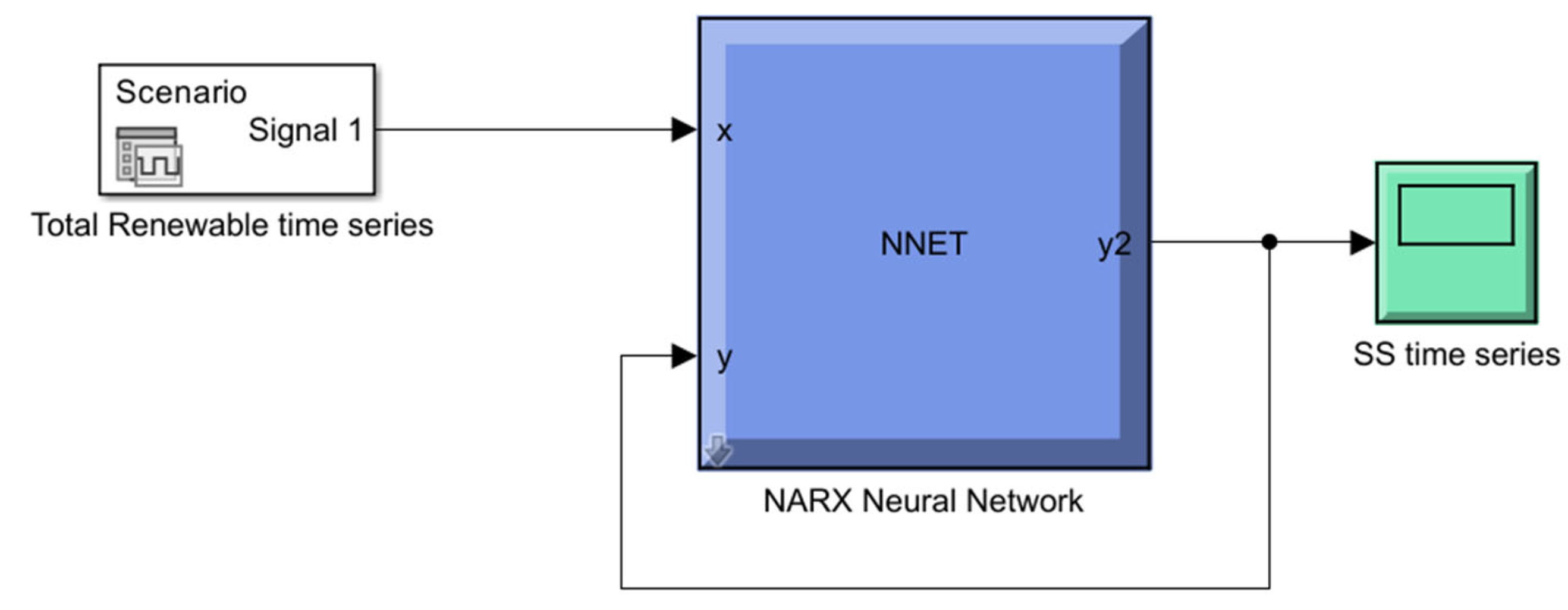

In this research, a nonlinear auto-regressive network with exogenous inputs (NARX) was used to consider the total renewable as input (
) and the output SS% (
) [
22,
23,
24]. The selection of NARX is accomplished by highlighting its specific strengths for renewable energy (RE) time-series: (i) suitability—NARX is a dynamic recurrent network that excels at modelling nonlinear systems with memory. Its ability to capture the influence of both historical outputs (autoregressive) and external weather-dependent inputs (exogenous) makes it highly effective for RE data, which is governed by temporal patterns and meteorological variables; (ii) comparison to LSTM/GRU: while LSTM and GRU are powerful for very long-range dependencies in massive datasets, NARX often provides a more efficient and interpretable surrogate model for engineering applications where the feedback loop between input and output is direct and the dataset size is moderate. It offers high accuracy with faster training cycles for community-scale simulations.
The formula employed is presented as follows:
where
represents the time.

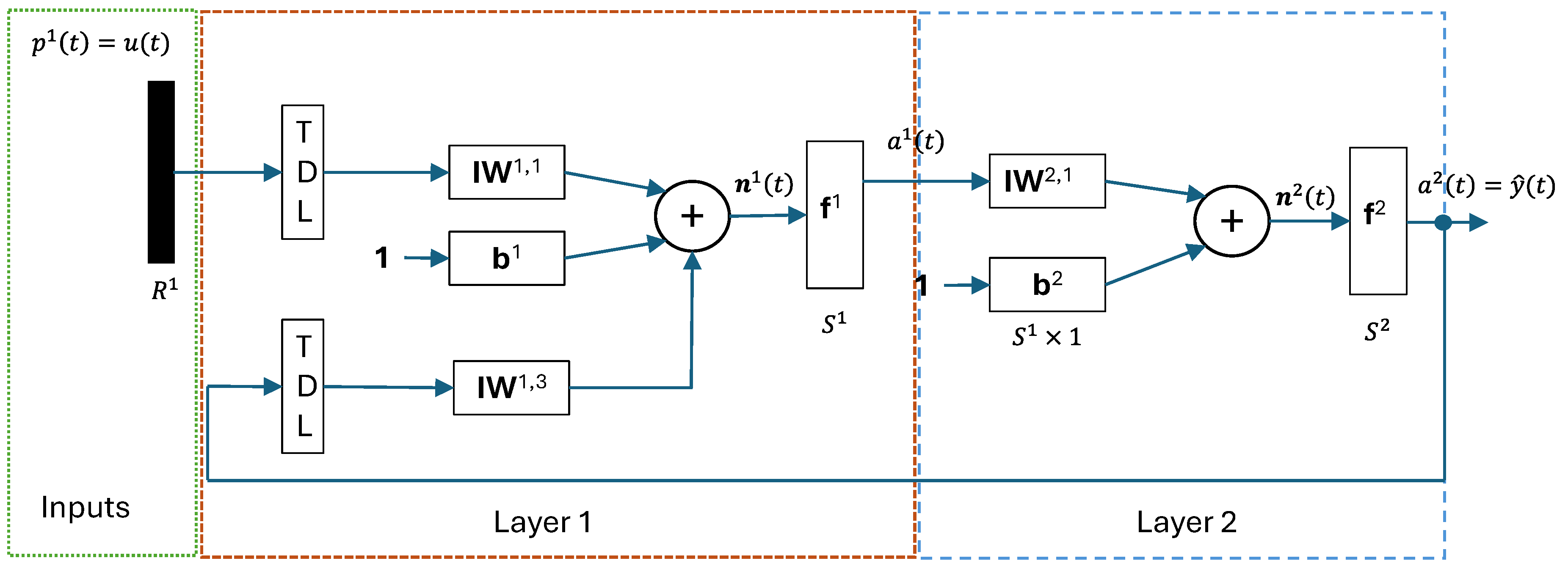

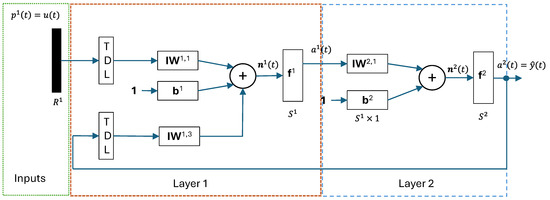

Figure 3 illustrates the structure of a two-layer feedforward network for function approximation, which can be employed in a vector ARX model where both inputs and outputs may be multidimensional. A tapped delay line (TDL) is used to fully exploit the linear component of the network, forming an N-dimensional vector of the input signal. In the analysis, the influence of each neuron is represented through the weight (IW), while the bias (b) term is incorporated into the activation function. A time delay of two months was applied in the neural network, with a hidden layer comprising ten neurons.

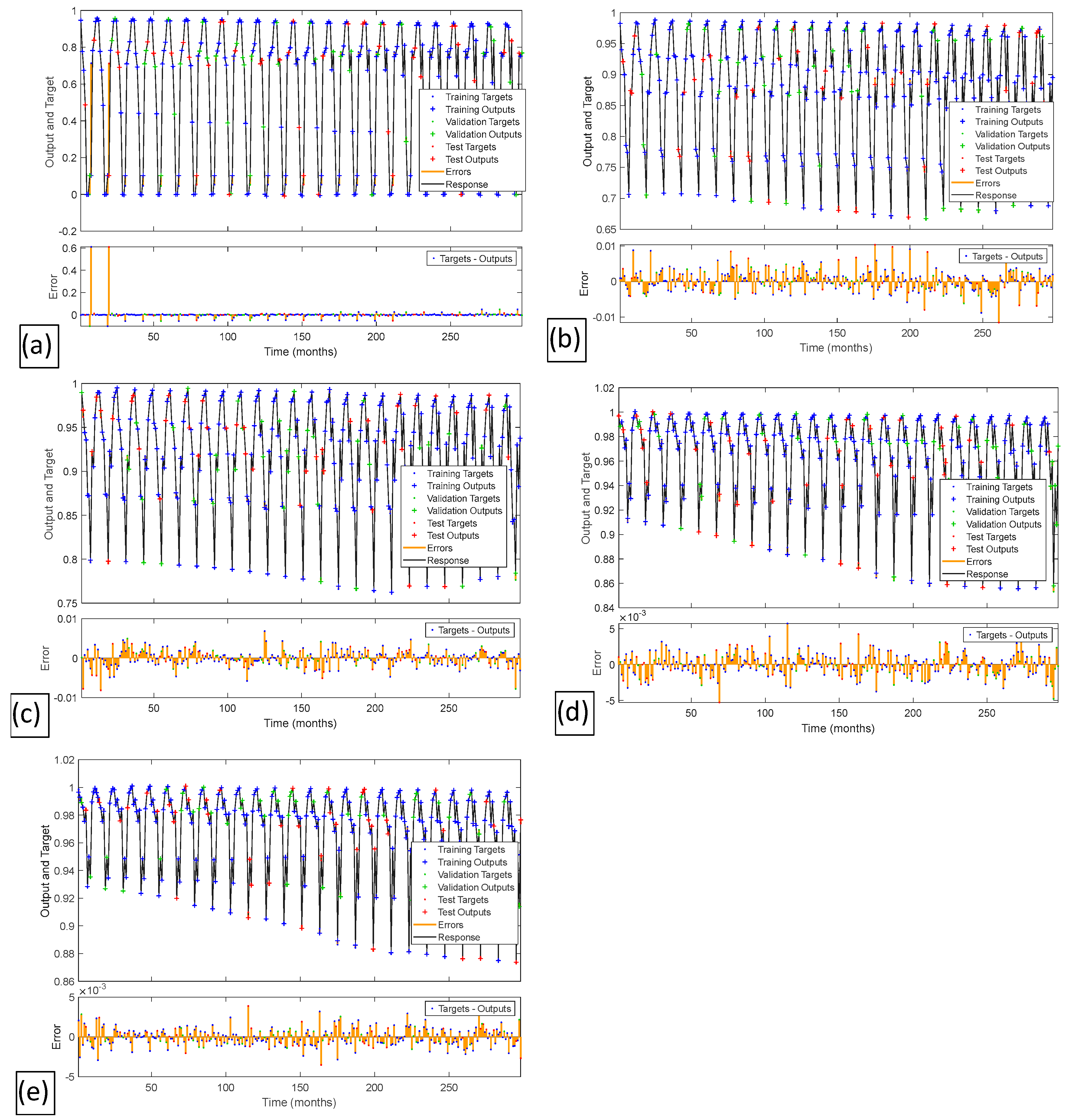

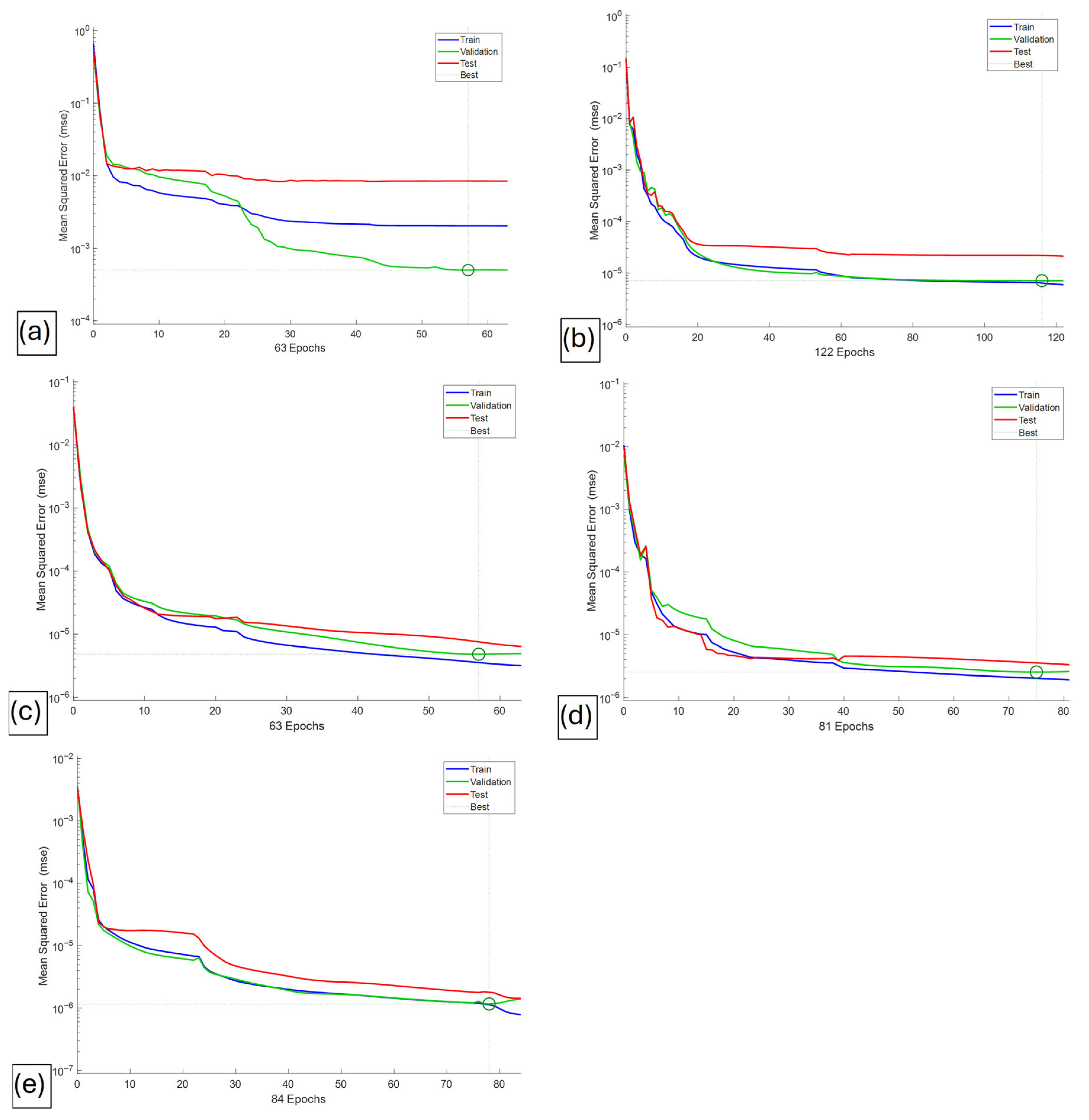

The Levenberg–Marquardt algorithm was used to train the model with 70% of the available dataset. Consequently, 15% of the time series was employed for validation and the remaining 15% for testing. In this case, the Jacobian matrix has dimensions of Q × n, where Q is the number of training samples, and n is the number of weights and biases. The Jacobian matrix can be used to approximate the Hessian matrix as follows:
The implementation of this procedure involves the analysis of five scenarios, each considering different values of Total Renewable and SS, comprising a total of 3020 values.
The mean square error was used as the statistical measure, defined as follows:
where
is the total number of observations of the time series,
is the vector of observed SS values, and
is the vector of predicted SS% values by the neural network.
For the NARX series, the correlation coefficient (R) is computed as follows:
where
corresponds to the average of the observed SS values, and
refers to the average of predicted values.
