Next Article in Journal
A Dual-Stream Network with Dynamic Graph Convolution and Attention-Based BiGRU for IGBT Open-Circuit Fault Diagnosis in T-NPC Three-Level Inverters
Previous Article in Journal
Hybrid and All-Electric Civil and Military Ships: From Maritime Decarbonisation Drivers to Integrated Energy System Architectures

Font Type:
Arial Georgia Verdana
Font Size:
Aa Aa Aa
Line Spacing:
Column Width:
Background:
Article

Nuclear Energy Development and Energy Security in Slovakia: Current Status and Conditional Prospects up to 2050

by
Jacek Dworzecki
1,2,* and
Izabela Nowicka
2
1
Department of Social Sciences and Engineering, University College of Professional Education, Powstańców Śląskich Square 1, 53-329 Wrocław, Poland
2
Faculty of Security Studies, General Tadeusz Kościuszko Military University of Land Forces, Czajkowskiego 109, 51-147 Wrocław, Poland
*
Author to whom correspondence should be addressed.
Energies 2026, 19(17), 4225; https://doi.org/10.3390/en19174225
Submission received: 2 July 2026 / Revised: 10 August 2026 / Accepted: 1 September 2026 / Published: 7 September 2026
(This article belongs to the Section B4: Nuclear Energy)

Abstract

This article evaluates how nuclear energy development may affect energy security and nuclear energy security in Slovakia up to 2050. It applies a qualitative-dominant mixed-method design combining critical source-position appraisal, a claim-evidence matrix, quantitative reconstruction of the 2021–2024 electricity balance, comparison of three official 2040 adequacy scenarios, stress tests for a 1200 MW large reactor and a 300 MW small modular reactor (SMR), and negative-case analysis. The results show that Slovakia entered 2024 as a net electricity exporter after Mochovce Unit 3 increased nuclear generation, while electricity consumption remained 3.1 TWh below 2021. The decline from 2021 to 2022 reflected a combination of the energy-price shock, industrial demand curtailment, lower fossil generation and hydrological variability rather than a single structural factor. Official 2040 scenarios project gross generation of 43.9–48.5 TWh, of which nuclear contributes 24.2–26.7 TWh, approximately 55%. Adding a 1200 MW unit would generate about 8.4–10.0 TWh annually at capacity factors of 80–95%, creating a material need for demand growth, exports, storage, nuclear heat, hydrogen or load-following operation. The analysis therefore does not treat the Bohunice project or SMRs as inevitable. Their contribution to energy security is conditional on financing, licensing, fuel diversification, grid flexibility, heat off-takers, climate-resilient cooling, radioactive-waste governance, workforce continuity and transparent public governance. A diversified pathway combining safe long-term operation of existing units, renewables, wind development, storage, demand response and selective nuclear investment is more robust than a single-project strategy.

1. Introduction

Slovakia is entering a new phase of nuclear energy development in which energy security, nuclear energy security and decarbonisation are increasingly inseparable. The policy portfolio now includes the commissioning of Mochovce Unit 4 [1], long-term operation and possible uprating of the existing VVER-440 fleet [2], diversification of nuclear-fuel supply [3], preparation of a new state-owned large reactor at Jaslovske Bohunice [4], and feasibility work on small modular reactors (SMRs) for electricity, heat, hydrogen and industrial applications [3,5]. These measures are not merely technology choices. They affect the resilience, affordability, sovereignty and environmental performance of the Slovak energy system over several decades.
In this article, energy security is understood more broadly than the reduction in fossil-fuel imports. It comprises the reliable availability of energy services, affordability for households and industry, environmental sustainability, resilience to technical and geopolitical shocks, adequate infrastructure and institutional capacity, and the fair allocation of costs and risks [6,7]. Nuclear energy security is used as a related but more specific concept: the ability of nuclear assets and their fuel cycle to provide dependable low-carbon electricity and heat while maintaining independently verified nuclear safety, protection against malicious acts, fuel and service diversification, regulatory competence, workforce continuity, climate resilience, credible radioactive-waste management and economically sustainable system integration. Nuclear safety concerns protection against accidental events, whereas nuclear security concerns prevention and response to theft, sabotage and other malicious acts; both are necessary conditions for nuclear energy security [8,9].
The phase-out of Slovak coal-fired generation must therefore be distinguished from the maintenance of domestic low-carbon generation. Coal is neither treated nor described here as a low-carbon source. Mining at Novaky ended in 2023, the Novaky power plant closed in December 2023, and coal firing at Vojany ended in March 2024 [2,10]. The policy question is how the removed dispatchable coal capacity is replaced by a portfolio of nuclear power, hydropower, solar photovoltaics, wind, storage, demand response, interconnection and, where justified, flexible gas or combined heat and power during the transition. The phrase “maintenance of domestic low-carbon generation” refers specifically to nuclear, hydro and renewable output, not to the preservation of coal.
Slovakia has one of Europe’s most nuclear-intensive electricity systems, but its position is not unique. International Atomic Energy Agency (IAEA) Power Reactor Information System (PRIS) data show that France had a higher nuclear share in 2025, while Czechia, Finland and Belgium also relied substantially on nuclear generation [11]. This comparison strengthens rather than weakens the relevance of the Slovak case: small and medium-sized interconnected systems must manage both the benefits of low-carbon firm generation and the concentration risk created by a limited number of large units. The French fleet in 2022 illustrates correlated outage risk: average availability fell to 54%, and nearly 65% of capacity was offline at the annual low because of maintenance and stress-corrosion inspections [12]. The nine-day outage of the 1450 MW Oskarshamn 3 unit in Sweden in December 2022 likewise demonstrated how one large unit can matter when regional margins are tight [13]. These examples do not imply that similar events will occur in Slovakia; they show why nuclear energy security requires outage-resilient planning, reserves, interconnection and diversified flexibility.
Construction of Mochovce Units 3 and 4 was interrupted for many years and later resumed under changed ownership, regulatory and design requirements. The Slovak Supreme Audit Office reported completion costs approaching EUR 6 billion and identified weaknesses in project management and state oversight [14], while WNISR records approximately 38 years from the start of construction to the grid connection of Unit 3 [15]. This experience shows that political approval and international cooperation do not substitute for a final investment decision, a licensed design, a financeable contract, a mature supply chain or a credible schedule for the proposed Bohunice unit.
The electricity balance changed sharply between 2021 and 2024. In 2021 Slovakia produced 30.093 TWh and consumed 30.867 TWh, resulting in a 0.774 TWh import balance [16]. Production and consumption both declined in 2022, to 26.916 TWh and 28.328 TWh respectively [2]. After Mochovce Unit 3 entered operation, production recovered to 30.082 TWh in 2023 and 30.702 TWh in 2024, while consumption remained lower, at 26.660 TWh and 27.757 TWh [5]. Slovakia therefore recorded export balances of 3.422 TWh in 2023 and 2.945 TWh in 2024 [5]. These figures create two questions that a descriptive account cannot answer adequately: why consumption fell, and whether the resulting export position is durable under future electrification and industrial demand.
The proposed new large source magnifies these questions. Five operating reactors represented approximately 2306 MW of net nuclear capacity in mid-2026, while the six-unit fleet after Mochovce Unit 4 is expected to approach 2945 MW gross under the National Energy and Climate Plan (NECP) [2,11]. At capacity factors of 80–95%, a 1200 MW reactor would generate approximately 8.4–10.0 TWh per year. Its contribution must therefore be assessed against demand growth, exports, outage reserves, storage, non-electric uses and possible load-following operation.
This article examines which elements of Slovakia’s nuclear pathway are supported by robust evidence, which remain conditional policy intentions, and which system requirements must be fulfilled for nuclear development to strengthen rather than weaken energy security. The central research question is: under what technical, economic, institutional and system-integration conditions can existing and prospective nuclear capacity contribute to Slovak energy security and nuclear energy security up to 2050? Four subsidiary questions follow. First, what explains the 2021–2024 change in electricity generation, consumption and trade balance? Second, what do official 2040 scenarios imply for total generation and the nuclear share? Third, how would a 1200 MW unit and possible SMRs affect flexibility, non-electric uses and workforce requirements? Fourth, what alternative pathways remain credible if large nuclear projects are delayed, reduced or not realised?
The analytical contribution is threefold. First, the article appraises official, operator, industry, independent and scholarly sources according to their institutional position and evidentiary status. Second, it reconstructs the 2021–2024 electricity balance and reproduces the 2040 scenario outputs from the national resource-adequacy assessment. Third, transparent stress tests evaluate additional nuclear capacity and negative cases involving delay, high demand and stronger renewable development. Together, these elements provide an integrated assessment of energy-security trade-offs.
Section 2 presents the method and evidence hierarchy. Section 3 analyses Slovakia’s energy and electricity profiles and the 2021–2024 balance. Section 4 evaluates the operating fleet, nuclear energy security functions and non-electric uses. Section 5 quantifies the 2040 scenarios, additional-capacity stress tests, load-following economics and alternative pathways. Section 6 examines implementation constraints. Section 7 discusses robust and conditional findings and the study limitations. Section 8 presents policy recommendations, and Section 9 concludes.

2. Materials and Methods

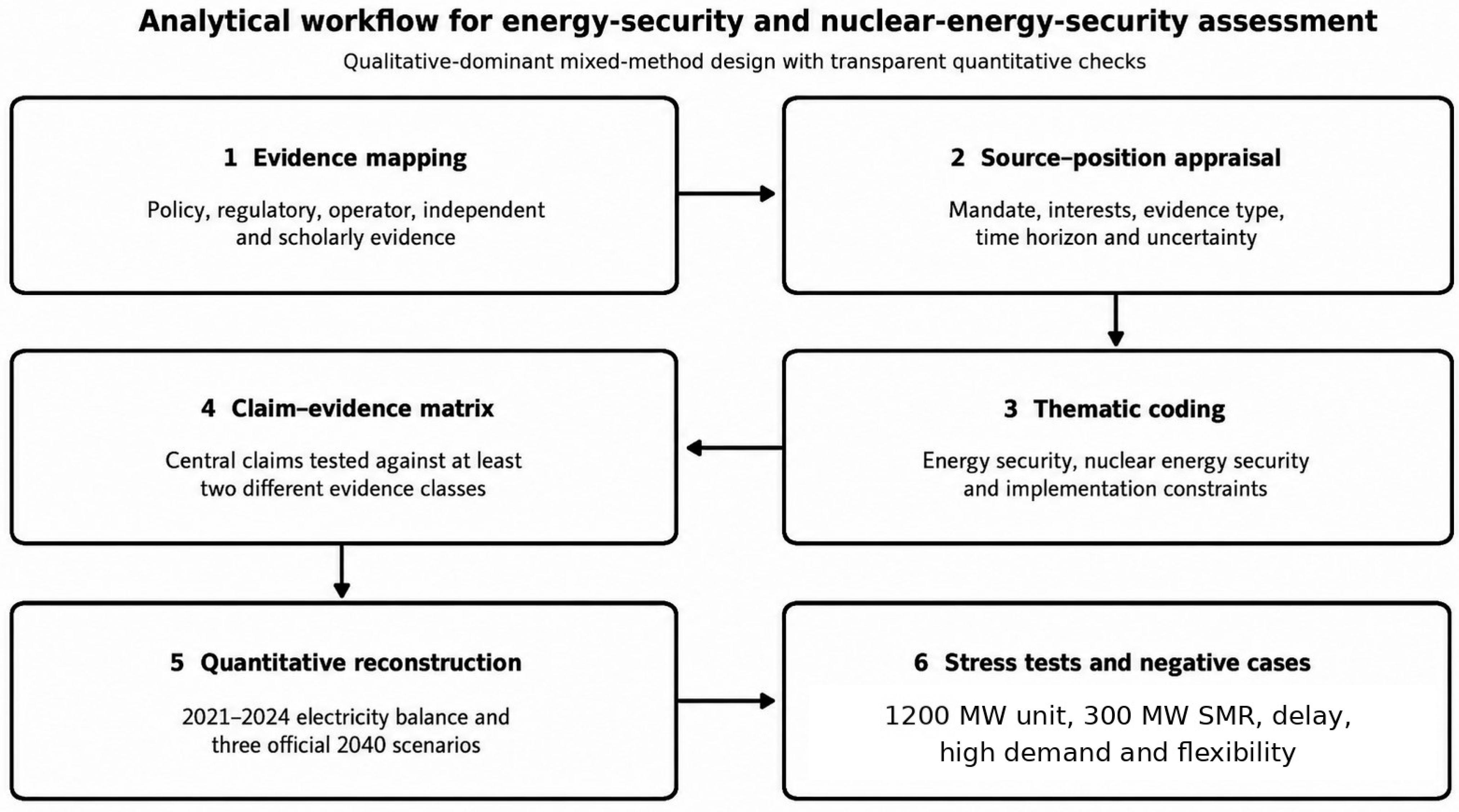

2.1. Research Design and Analytical Contribution

The study uses a qualitative-dominant mixed-method policy and system-security design, combining critical document analysis, source-position appraisal, comparative policy analysis, quantitative reconstruction, scenario comparison, transparent stress tests and negative-case analysis. The unit of analysis is the national policy portfolio rather than a single reactor project, encompassing the interactions of nuclear energy with electricity adequacy, fuel security, industrial demand, affordability, heat, hydrogen, flexibility, workforce and radioactive-waste governance. No commercial software, laboratory instruments, chemicals, reagents, cell lines, samples or proprietary materials were used in this document-based study.
Originality is generated through the integration and interrogation of evidence rather than through the reproduction of government targets. Every central claim was classified as one of four types: observed outcome, modelled scenario, institutional intention or author inference. Observed outcomes include historical generation and consumption. Modelled scenarios include the 2040 results of the resource-adequacy assessment. Institutional intentions include proposed commissioning dates, capacity envelopes and cooperation agreements. Author inferences include the calculated output of a 1200 MW unit under alternative capacity factors. This classification prevents a political announcement from being presented as an operational forecast.

2.2. Evidence Corpus and Source-Position Appraisal

The evidence corpus contains five source classes: (i) Slovak statutory and strategic documents; (ii) transmission-system, regulator and operator data; (iii) international intergovernmental databases and technical reports; (iv) industry and government stakeholder statements; and (v) independent and peer-reviewed scholarship. The core Slovak sources are the March 2025 NECP update [2], the 2024 resource-adequacy assessment published in 2025 [5], the 2021 electricity-supply security report [16], energy-security and emergency-planning documents [17,18,19,20,21,22], and the Ministry of Economy annual report [3]. Current reactor status was checked against IAEA PRIS and Slovenske elektrarne information up to 20 July 2026 [1,11,23].
Source-position appraisal was applied to each item using five questions: What is the source’s legal or institutional mandate? Does it have a promotional, regulatory, commercial or independent role? Is the claim based on observed data, modelling, a political commitment or advocacy? What time horizon and uncertainty apply? Is the claim corroborated by a second evidence class? The World Nuclear Association profile [24] is treated as a useful industry synthesis, while WNISR [15] provides an independent counterpoint on construction performance and SMR maturity. U.S. Department of Energy and Slovak Ministry statements [4,25,26,27,28] are treated as evidence of governmental direction and cooperation, not as proof of final vendor selection, financing closure or on-time delivery. The source classes and their analytical treatment are summarised in Table 1.

2.3. Coding, Triangulation and Negative-Case Analysis

The documentary material was coded under ten themes: energy security; nuclear energy security; electricity demand and adequacy; affordability and financing; nuclear safety and nuclear security; fuel and supply-chain diversification; flexibility and load following; non-electric uses; workforce and institutional capacity; and waste, decommissioning and climate resilience. A claim-evidence matrix linked each substantive conclusion to at least two evidence classes wherever the evidence permitted. For example, the proposition that the 2024 export balance was driven by both higher nuclear output and lower consumption is supported by national balance data [5], the commissioning of Mochovce Unit 3 [2], and industrial-demand evidence from Slovalco [35]. The complete coding and evidence-threshold framework is provided in Appendix A.
Negative-case analysis tests outcomes in which announced nuclear projects are delayed, cancelled or accompanied by different demand and renewable-development trajectories. Four pathway conditions were examined: (A) timely delivery of the new Bohunice unit; (B) delayed or cancelled large new build; (C) high electrification and industrial demand; and (D) stronger renewables, wind, storage and demand response. The analysis asks whether energy-security outcomes remain acceptable under each condition. It also distinguishes an enabling agreement from an investment decision, a feasibility study from a licensed project, and installed capacity from electricity actually generated and absorbed.

2.4. Quantitative Reconstruction and Stress Tests

The quantitative component has three steps. First, annual electricity production, consumption and net balance were reconstructed for 2021–2024 from the 2021 monitoring report, NECP data and the 2024 resource-adequacy assessment [2,5,16]. Second, the exact 2040 balances for Scenario A, Scenario B and the Ministry of Economy scenario were transcribed from Table 4.12 of the national assessment [5]. Third, additional nuclear output was calculated using the transparent identity annual generation = capacity × 8760 h × capacity factor. No proprietary dispatch model is claimed.
For the proposed 1200 MW unit, annual output is tested at capacity factors of 80%, 90% and 95%, producing 8.410, 9.461 and 9.986 TWh respectively. A 300 MW SMR at a 90% capacity factor would produce 2.365 TWh. These figures are not forecasts. They are scale tests used to compare prospective output with official 2040 consumption, export/import balances, electrolyser demand and flexibility needs. The tests assume no transmission constraint and no curtailment; therefore, they deliberately show the upper-bound energy volume that would have to be sold, shifted, stored or converted.

2.5. Methodological Boundaries

The study does not rank reactor vendors, calculate a full levelized cost of electricity, optimise hourly dispatch or claim to prove project bankability. Publicly available data do not include final financing terms, vendor bids, site-specific cooling-water projections, heat-network investment plans, confidential outage probabilities or full hourly demand profiles. The method is therefore suitable for a transparent policy and energy-security assessment, but not a substitute for an investment-grade feasibility study. The implications of these boundaries are discussed in Section 7. The analytical workflow is summarised in Figure 1.

3. Energy-System Baseline and the 2021–2024 Electricity Balance

3.1. Energy and Electricity Profiles

In 2022, Slovakia’s total energy mix comprised approximately 24% nuclear energy, 24% oil, 23% natural gas, 14% coal, and 15% renewable sources and waste [2]. Nuclear power supplied 61.0% of domestic electricity generation in 2023 and 59.9% in 2024 [5]. A low-carbon electricity sector can therefore coexist with substantial oil and gas dependence across transport, heat and industry.
Electrification of transport, heating and industry can reduce imported fossil-fuel demand, but the security effect depends on electricity volume, peak capacity, network constraints, heat demand, industrial contracts and the timing of electrification.

3.2. Explaining the 2021–2022 Decline

From 2021 to 2022, Slovak electricity production decreased by 3.177 TWh, or 10.6%, while consumption decreased by 2.539 TWh, or 8.2% [2,16]. The evidence does not support a single-cause explanation. On the supply side, fossil generation fell by about 2.5 TWh and hydropower by about 0.6 TWh, while nuclear output increased slightly. On the demand side, the European energy-price shock affected industrial operation and encouraged conservation. Slovalco had already curtailed production in late 2021 and early 2022 because of very high electricity prices, and it ended primary aluminium production by September 2022 after reporting adverse framework conditions and the absence of a viable long-term power arrangement [35,36].
The simultaneous decrease in generation and consumption was therefore a combination of lower dispatch from fossil plants, hydrological variability, industrial curtailment, high prices and broader economic adjustment. It should not be interpreted as evidence that Slovakia no longer requires additional electricity in the long term. Industrial demand is price-sensitive and can return when competitive electricity contracts and policy conditions change. Hydro announced in July 2026 a conditional restart of 75,000 tonnes of Slovalco capacity in the fourth quarter of 2026, supported by a long-term power-purchase agreement and subject to European Commission approval of the revised indirect-carbon-cost scheme [37]. This prospective restart illustrates why the 2022 demand decline cannot simply be extrapolated to 2040.

3.3. The 2024 Balance: Similar Generation, Lower Consumption

In 2024, total generation of 30.702 TWh was close to the 30.093 TWh produced in 2021, but consumption was 27.757 TWh, 3.110 TWh below the 2021 level [5,16]. The new balance resulted from both sides of the system. Mochovce Unit 3 increased nuclear generation; hydropower and photovoltaics contributed more than in 2022; coal generation had ended; and electricity demand had not returned to its pre-crisis level. The resulting 2.945 TWh export balance was therefore not created by nuclear output alone, nor does it prove a permanent structural surplus.
Several consumption trends must be considered. First, energy-intensive industrial demand was lower after the Slovalco shutdown. Second, efficiency, price response and post-crisis conservation reduced grid demand. Third, distributed photovoltaic generation increasingly serves consumption behind the metre; the 2024 assessment includes estimated unmetered photovoltaic output, which complicates comparison between metered demand and total electricity service [5]. Fourth, future electrification of vehicle production, batteries, steelmaking and heating is expected to raise consumption, but the timing is uncertain. The correct energy-security interpretation is that Slovakia had a favourable annual energy balance in 2024 while still facing uncertainty about hourly flexibility, future demand and the economic value of exports. The reconstructed annual electricity balance is presented in Table 2.

3.4. Coal Phase-Out, Low-Carbon Generation and Back-End Responsibilities

The closure of Novaky and Vojany removed high-emission coal generation and supported decarbonisation, but it also removed dispatchable capacity and regional employment [2,10]. Maintaining domestic low-carbon generation means preserving safe nuclear and hydro output while expanding renewables and flexibility. It does not mean maintaining coal. The replacement portfolio must supply energy, reserves and local transition functions that coal plants previously provided. Former thermal sites may be useful for grid connections, storage, renewable projects or, only if justified, future SMRs, but each option requires a separate economic and environmental case. The relationship between annual generation, consumption and net balance is shown in Figure 2.
A nuclear-dominated low-carbon electricity mix also creates back-end obligations. Spent fuel, radioactive waste and decommissioning are part of nuclear energy security because long-lived liabilities affect public trust, financing and institutional continuity. Slovakia has operational experience in interim storage and decommissioning, but no operating deep geological repository. Repository siting, licensing, public consent, financing and interim-storage capacity must therefore be integrated into any capacity-expansion decision rather than treated as a later technical appendix [3].
The baseline analysis leads to a cautious conclusion. Slovakia currently possesses a strong annual low-carbon electricity position, but broader energy security remains exposed to imported fuels, industrial-demand uncertainty, large-unit outages, fuel-cycle dependence and insufficient flexibility. Nuclear energy security is strongest when nuclear generation is embedded in a diversified system rather than used as a substitute for system planning.

4. Nuclear Fleet, Policy and Nuclear Energy Security

4.1. Existing Fleet, Mochovce Completion and Delivery History

As of 20 July 2026, IAEA PRIS listed five operating reactors in Slovakia and Mochovce Unit 4 as under construction or commissioning [11]. The operating units were Bohunice V2 Units 3 and 4, Mochovce Units 1 and 2, and Mochovce Unit 3. They all belong to the VVER pressurised-water reactor family. Standardisation provides accumulated operating experience, common training and established maintenance capabilities, but it also concentrates fuel-design, component and licensing dependencies. Nuclear energy security therefore depends on preserving the benefits of standardisation while reducing single-supplier and common-mode risks.
The two Bohunice V2 units entered service in 1984 and 1985 and have been uprated to approximately 500 MWe gross each. They also supply heat to Jaslovske Bohunice and nearby urban areas, including Trnava, Leopoldov and Hlohovec [2]. Mochovce Units 1 and 2 entered operation in 1998 and 2000 and were uprated to approximately 501.44 MWe gross each [2]. Mochovce Unit 3 was synchronised with the grid on 31 January 2023 and materially increased annual nuclear generation [2,5]. These units form the current operational foundation of Slovak energy security, but lifetime extension beyond original design assumptions remains conditional on ten-year safety reviews, ageing management, investment and regulatory approval.
Mochovce Unit 4 (EMO4) is the decisive near-term addition. Fuel loading began on 29 June 2026, moving the 471 MW unit into active commissioning under the supervision of the Nuclear Regulatory Authority [1,28]. Once in stable commercial operation, the six-unit fleet is expected to reach approximately 2944.88 MW on the gross-capacity basis reported in the NECP [2]. Operator statements that EMO4 could cover approximately 13% of Slovak consumption are useful for scale, but the realised contribution will depend on commissioning performance, outages, demand and the definition of consumption used [1].
The project’s history is an energy-security warning as well as an engineering achievement. Units 3 and 4 were initiated in the 1980s, construction was suspended, and completion proceeded only after long delays, design changes and major financing commitments. The Supreme Audit Office found serious weaknesses in project control and reported a cost close to EUR 6 billion [14]. WNISR records the unusually long construction duration of Unit 3 [15]. Continued reliance on Russian-origin technology, documentation, services and fuel during the completion period also demonstrates that physical location inside Slovakia does not automatically equal technological sovereignty. The lesson for the new Bohunice project is that nuclear energy security must include delivery capability, transparent cost control and diversified life-cycle support. The status and energy-security functions of current and prospective nuclear assets are summarised in Table 3.

4.2. Nuclear Power as an Energy-Security Asset and a Concentrated Risk

Official Slovak policy treats nuclear power as a core component of energy security, low-carbon generation and industrial policy [2]. The analytical conclusion is narrower: nuclear power is a strong energy-security asset when its high availability, low operational carbon emissions, fuel storability and domestic generation reduce exposure to volatile gas and coal markets. It becomes an energy-security vulnerability when common-mode outages, fuel dependence, project debt, insufficient flexibility, weak waste governance or regulatory overload are ignored. The relevant question is therefore not whether nuclear energy is intrinsically secure, but under which governance and system conditions it contributes to nuclear energy security.
The coal phase-out increases the value of dependable low-carbon output, especially during winter periods of low solar production. Nuclear generation also reduces the need for gas-fired baseload electricity in a country that imports more than 98% of its gas consumption [22]. Nevertheless, gas may continue to provide industrial feedstock, district heat and flexible generation. Energy security is strengthened most when nuclear power reduces fossil demand without creating a rigid system that depends on low-value exports or frequent curtailment.
A high share of generation from six large units also concentrates operational risk. A prolonged outage of one 500 MW unit equals approximately 17% of the expected six-unit gross nuclear fleet and a much larger share of winter reserve margin. Common design features can create correlated inspection or maintenance requirements. The experiences of France and Oskarshamn described in Section 1 demonstrate why energy security requires spare capacity, demand response, hydro, storage, interconnection, diversified maintenance capability and realistic outage assumptions [12,13]. Annual nuclear shares alone do not measure this resilience.

4.3. Fuel Diversification and the Broader Meaning of Supply Security

Nuclear-fuel diversification is the most immediate nuclear energy security task. Slovak VVER-440 reactors historically relied on Russian TVEL fuel, and the risk-preparedness plan noted that alternative fuel must undergo complete plant-specific licensing [2,18]. Slovenske elektrarne has pursued parallel paths with Westinghouse and Framatome; the Ministry annual report records agreements with both, and the NECP expects first Framatome deliveries from 2027 [2,3]. Diversification is therefore progressing from political intent toward contractual and technical qualification, but it is not complete until fuel is licensed, fabricated, transported, stored, loaded and operated safely.
Two alternative fuel suppliers do not exhaust the energy-security choices. At the fuel-cycle level, Westinghouse and Framatome are parallel supplier paths. At the whole-system level, a third diversification path is to reduce the amount of nuclear output that must be secured at any single moment by expanding wind, solar, hydro, storage, demand response, efficiency and cross-border capacity. This does not replace the need for alternative VVER fuel; it reduces concentration risk. A robust strategy therefore combines supplier diversification inside nuclear energy with technology diversification across the electricity system.
Fuel security also extends beyond assemblies. Transport routes, export controls, sanctions, spare parts, digital systems, maintenance documentation, specialist services and reserve inventories are part of nuclear energy security [40,41]. A change in fuel vendor can introduce new licensing and operational requirements, while a new Western large reactor can create a different long-term dependency on the selected vendor and state partner. Sovereignty should therefore be measured by the ability to switch, stock, regulate and maintain critical inputs, not by the nationality of one supplier alone.

4.4. Nuclear Heat, Hydrogen and the Conditions for Non-Electric Use

Non-electric applications may improve the utilisation of nuclear assets, but they require more precise treatment than a general reference to “heat and hydrogen.” Existing Bohunice heat supply demonstrates that steam extraction and district-heating integration are technically possible [2]. Conventional second- and third-generation district-heating networks commonly require supply temperatures above 80–100 degrees Celsius, while published nuclear district-heating studies report indicative supply ranges of about 80–130 degrees Celsius and return temperatures of about 45–70 degrees Celsius [42,43]. Actual temperatures vary by season and network design. Lower-temperature modern networks may reduce heat losses but can require building and network adaptation.
The public Slovak documents reviewed do not provide an investment-grade estimate of annual heat demand, peak load, pipeline distance, heat-exchanger configuration, network temperature, backup capacity, off-taker creditworthiness or delivered heat cost for an expanded Mochovce corridor or an SMR site. This is a material evidence gap. Before nuclear heat is counted as an energy-security benefit, a project must identify a geographically concentrated and durable heat demand, a technically and economically viable transmission corridor, municipal agreements, backup arrangements and a risk allocation between the nuclear operator and heat utility. Siting an SMR close enough to a city or industrial user to sell heat must also remain compatible with nuclear-safety, emergency-planning, water and land-use requirements.
Hydrogen production is similarly conditional. Electrolysers can absorb low-price electricity and provide a flexible load, and the 2040 official scenarios include 0.813–1.122 TWh of electrolyser consumption [5]. Nuclear electricity could contribute to this supply, especially when co-located with industrial demand, but conversion losses, electrolyser utilisation, hydrogen transport, market demand and competition from renewable electricity determine economics. Hydrogen should therefore be treated as a possible flexibility and industrial-decarbonisation service, not as an automatic sink for surplus nuclear generation.

4.5. Financing, Affordability and Industrial Competitiveness

The phrase “acceptable prices” requires an explicit answer to the question of who bears project risk. The proposed Bohunice unit is described as state owned, and the Ministry launched a competition in June 2025 for a financial adviser with an estimated contract value of EUR 15 million [26]. This confirms that the financing model was still under development. Possible structures include direct public equity, state guarantees, regulated asset-base mechanisms, contracts for difference, long-term power-purchase agreements or combinations of these instruments. Each shifts construction, market and financing risk differently among taxpayers, electricity consumers, industrial off-takers, the project company and suppliers.
Nuclear power does not automatically make industry competitive. Industrial competitiveness depends on the delivered electricity price, reliability, carbon intensity, contract duration, grid charges, flexibility costs, financing burden and access to risk-sharing mechanisms. Existing depreciated nuclear units may provide economically valuable low-carbon output, while a new capital-intensive unit may require public support or long-term revenue stabilisation. The analytical claim is therefore that nuclear power can support industrial competitiveness when it delivers predictable low-carbon electricity under disciplined financing and transparent contracts; it is not that higher nuclear capacity necessarily lowers market prices.
The state-ownership rationale may be justified by strategic control and long-term energy security, but public ownership increases the obligation to disclose assumptions, contingent liabilities and milestone performance. A credible nuclear energy-security framework should publish the reference financing model, expected weighted cost of capital, construction-risk allocation, consumer impacts, state-aid strategy and exit criteria before the project becomes irreversible. Without that information, the 2040 date remains a policy objective rather than a bankable schedule.

5. The 2040 Electricity Balance, Additional Nuclear Capacity and Alternative Pathways

5.1. What the Official 2040 Scenarios Actually Show

The 2024 national resource-adequacy assessment provides three 2040 cases: Scenario A, Scenario B and the Ministry of Economy scenario (MH SR) [5]. Scenario A represents a lower-demand development path; Scenario B assumes strong electrification and new large consumers; the Ministry scenario includes stronger wind development and a 300 MW SMR. The scenarios are not forecasts with assigned probabilities. They are internally consistent tests of different demand and supply assumptions.
Gross electricity generation in 2040 ranges from 43.901 TWh in Scenario A to 48.500 TWh in the Ministry scenario. Nuclear generation ranges from 24.222 TWh to 26.651 TWh. The nuclear share of gross generation is remarkably stable at approximately 55.0–55.2% across all three cases. Thus, official modelling does not imply that nuclear power must supply an ever-rising percentage of electricity by 2040. It implies that nuclear output grows in absolute terms while renewables, storage, demand-side response and consumption also expand. The official 2040 balances and calculated nuclear shares are presented in Table 4.
Scenario B is the most important negative case. Gross consumption reaches 52.796 TWh, the system imports 8.517 TWh, expected unserved energy reaches 38 GWh and loss of load expectation (LOLE) rises to 42 h per year [5]. This high-demand case shows that completion of Mochovce Unit 4 and renewable expansion do not eliminate adequacy risk if electrification and industrial loads grow faster than firm and flexible capacity.
The Ministry scenario produces 48.500 TWh and remains a net exporter while including 3.203 TWh of wind generation and a 300 MW SMR [5]. The difference from Scenarios A and B is analytically important. Wind is not absent because Slovakia has no wind resource; it is low in some assumptions because planning, permitting, social acceptance and project pipelines remain limited. The Ministry of Environment issued a methodology for identifying wind-development areas in 2025 [44]. Stronger wind deployment is therefore a plausible energy-security pathway that should be evaluated alongside, not after, nuclear new build.

5.2. Stress Test for a 1200 MW Unit and a 300 MW SMR

A 1200 MW unit would be a large addition relative to the Slovak system. At an 80% capacity factor it would generate 8.410 TWh annually; at 90%, 9.461 TWh; and at 95%, 9.986 TWh. For comparison, the entire 2024 export balance was 2.945 TWh [5]. The new unit’s annual output would therefore equal roughly three times the 2024 export surplus and between 18% and 23% of gross generation in the official 2040 cases before the unit is added. This scale requires an explicit utilisation strategy. The scale implications of prospective additional nuclear capacity are shown in Table 5.
The first use for additional capacity is electricity demand from electrification and industry. The adequacy assessment includes the Volvo plant, battery manufacturing, heat pumps and possible electrification of U. S. Steel Kosice [5]. The second use is export, but exports cannot be assumed to remain available or profitable during regional renewable surpluses. The third is storage and flexible demand, including pumped hydro, batteries, industrial load management and electrolysers. The fourth is non-electric use through district heat or industrial steam. Each use has different infrastructure, revenue and timing requirements.
SMRs should be accommodated only after the role of the large unit and existing fleet is clear. The official 300 MW SMR assumption adds 2.365 TWh at a 90% capacity factor, while multiple SMRs could add much more. An SMR at Vojany or an industrial site may provide regional grid support, heat or direct industrial supply; an SMR at Bohunice or Mochovce may benefit from nuclear infrastructure but could intensify local generation concentration. Portfolio planning should therefore set a system-level capacity envelope and require each SMR proposal to demonstrate an identified off-taker, grid need, fuel route, waste plan, emergency-planning case and financing model.
SMR maturity also requires caution. The OECD Nuclear Energy Agency (NEA) tracks 129 designs, of which 79 are included in its digital dashboard; other concepts are inactive, paused, cancelled or under-resourced [38]. Seven designs were operating or under construction in the 2025 dashboard, but no standardised commercial European SMR fleet is in serial deployment, and first-of-a-kind projects still face licensing, siting, financing, supply-chain and fuel uncertainty [38,39]. Slovak SMRs should therefore be treated as conditional options rather than guaranteed 2035 capacity.

5.3. Load Following and the Economic Competitiveness of a High-Nuclear System

As nuclear and variable renewable generation increase, Slovak reactors may face more frequent load-following operation. Existing pressurised-water reactors can provide some flexible operation within technical and licensing limits, and the IAEA has documented non-baseload operating practices [45]. Technical capability, however, does not eliminate economic consequences.
The OECD NEA concludes that baseload operation is generally the simplest and most economical mode for nuclear plants because fixed capital and staffing costs are spread over more megawatt-hours [46]. Reducing output lowers the capacity factor and revenue while most fixed costs remain. Frequent manoeuvring may also affect fuel management, maintenance planning and component wear, although impacts are plant-specific. A state-owned new unit with guaranteed revenue could transfer these costs to consumers or taxpayers rather than make them disappear.
The economic response should prioritise system flexibility before routine nuclear curtailment. Pumped storage, batteries, demand response, heat storage, electrolysers, industrial contracts and cross-border trade can shift or absorb surplus. The adequacy assessment identifies additional non-fossil flexibility needs in 2030 of 711 MW in Scenario A and 467 MW in the Ministry scenario [5]. When surplus persists despite these measures, limited nuclear load following may be rational, but its lost output and revenue must be incorporated into project appraisal. A new reactor should not be financed on a 90–95% capacity-factor assumption if the system plan expects regular operation below that range.
Market design is equally important. Contracts for difference, regulated remuneration or long-term industrial contracts can stabilise revenues, but they can also weaken incentives to respond efficiently to negative prices if poorly designed. The policy objective should be to reward availability and low-carbon value without socialising unlimited construction and utilisation risk. Energy security, nuclear energy security and affordability must be assessed together rather than sequentially.

5.4. Plausible Pathways Beyond a Single Nuclear-Focused Scenario

The evidence supports several plausible pathways rather than one inevitable trajectory. A large nuclear pathway may maintain a high firm low-carbon share if the new Bohunice unit is delivered, financed and absorbed. A delayed new-build pathway relies more heavily on lifetime extension, renewables, storage, demand response and imports. A high-electrification pathway requires additional firm and flexible capacity regardless of technology. A diversified-renewables pathway accelerates wind, solar, storage, network investment and flexible demand while retaining the existing nuclear fleet and postponing some new nuclear decisions. The four conditional pathways are compared in Table 6.
The diversified portfolio is the most robust under uncertainty because it preserves options. It does not assume that renewables can replace every firm-capacity function, nor that nuclear construction will occur on schedule. Instead, it sequences decisions: commission EMO4, qualify alternative fuel, modernise flexibility, unlock wind and storage, verify demand, complete the Bohunice finance and licensing case, and deploy SMRs only where a specific service is demonstrated. This sequence aligns investment with evidence and protects energy security against both underbuilding and overbuilding.

6. Implementation Constraints for Energy Security and Nuclear Energy Security

6.1. Project Delivery, Financing and Geopolitical Dependence

The most consequential uncertainty is project delivery. The May 2024 announcement referred to a state-owned unit of up to 1200 MW [25], while the June 2025 financial-adviser competition described a planning envelope of up to 1700 MW and a minimum 60-year life [26]. The January 2026 U.S.-Slovak intergovernmental agreement referred to a state-owned American 1200 MWe unit [4], and an implementation steering committee subsequently began work [27]. These developments demonstrate political momentum and a framework for cooperation. They do not yet demonstrate a final investment decision (FID), a completed engineering, procurement and construction (EPC) contract, a closed financing package, a final licensed design or an achievable commercial-operation date.
Recent European construction experience requires schedule humility. Mochovce, Olkiluoto, Flamanville and Hinkley Point C show that project preparation, licensing, supply-chain readiness and construction can take substantially longer and cost more than early political schedules suggest [14,15]. Poland’s nuclear programme also illustrates the distance between national commitment and first commercial operation [47]. Accordingly, the article does not assume that a new Slovak unit will operate by 2040 or even by 2050. It treats operation around 2040 as a policy target and tests a delayed or non-delivery case.
Geopolitical cooperation creates both diversification and dependence. A U.S. framework can reduce reliance on Russian technology and fuel, but future administrations, export-control policy, trade disputes, sanctions, financing priorities and vendor capacity may change over a multi-decade project. The same applies to any foreign technology partner. Nuclear energy security requires contractual continuity, European regulatory compatibility, alternative suppliers for critical components and an explicit response to political change; alliance language alone is not a risk-allocation mechanism.
Financing is inseparable from energy security because high capital costs can affect public budgets and electricity bills for decades. Before construction, the state should publish a reference case and sensitivities for capital cost, construction duration, interest during construction, capacity factor, load following, decommissioning, spent fuel, cooling adaptation and delay. A project that improves physical supply but creates unmanageable fiscal or consumer exposure would not satisfy the broader definition of energy security used in this article.

6.2. Large-Unit Concentration, Flexibility and Operational Resilience

A 1200 MW unit would be the single largest generating asset in Slovakia. Its unplanned loss would require reserves, imports, demand response or rapid replacement from other resources. Grid connection studies must therefore test the largest-infeed loss, reserve procurement, transmission reinforcement, black-start arrangements and simultaneous outages of existing units. Regional interconnection reduces risk but cannot guarantee imports during a common cold-weather or regional scarcity event.
Operational resilience also depends on maintaining diversified ancillary services as synchronous fossil plants retire. Nuclear units contribute inertia and voltage support, but not every plant is optimised to provide all balancing services. Hydropower, pumped storage, batteries, flexible industrial loads and aggregators should be developed in advance of additional inflexible output. Flexibility is not an optional environmental add-on; it is part of energy security and nuclear energy security because it determines whether low-carbon generation can be used reliably and economically.
The load-following issue should be included in procurement and financing. Vendor guarantees should specify manoeuvring ranges, ramp rates, minimum stable output, fuel-cycle impacts and maintenance implications. The project financial model should include lower-capacity-factor sensitivities rather than assuming that every produced megawatt-hour will have equal value. This requirement is particularly important if wind reaches or exceeds the 3.203 TWh level in the Ministry scenario and photovoltaic capacity continues to grow [5].

6.3. Workforce Continuity Beyond the Construction Peak

The proposed large programme creates a two-sided workforce problem: shortages before and during construction, followed by a possible employment cliff after completion. A single 1200 MW reactor can support thousands of temporary construction jobs but cannot automatically provide permanent work for all specialist trades after commissioning. Nuclear energy security planning must therefore distinguish construction craft, commissioning staff, licensed operators, maintenance personnel, regulators, researchers and decommissioning specialists.
Continuity can be improved through a sequenced national programme. Qualified welders and non-destructive-testing specialists can move from new-build construction to lifetime-extension outages, major component replacement, fuel-diversification modifications, maintenance, decommissioning of Bohunice V1, radioactive-waste facilities and, if justified, later SMR projects. Engineers can support operation, digital modernisation, safety review, the regulator, research and regional supply chains. However, these transitions require retraining and work-pipeline coordination; they should not be assumed merely because all activities are “nuclear.”
A national workforce plan should map annual occupational demand from project preparation through at least ten years after commissioning. It should include vocational education and training, university places, operator apprenticeships, regulator staffing, scholarships linked to service commitments, international placements and certification portability. Procurement should also require suppliers to present localisation and knowledge-transfer plans. The objective is not to maximise domestic content at any cost, but to retain the capabilities needed for safe operation and nuclear energy security after foreign contractors leave.

6.4. Spent Fuel, Radioactive Waste and Decommissioning

The back end of the fuel cycle is a binding governance condition. Each additional reactor increases spent-fuel inventories, interim-storage requirements, decommissioning liabilities and the financial contribution required for long-term management. Slovakia has decommissioning and waste-management experience [3], but the absence of an operating deep geological repository means that long-term disposal remains unresolved.
New-build approval should therefore require a quantified spent-fuel and waste plan covering expected inventories, interim-storage capacity, transport, repository milestones, funding adequacy and responsibilities if schedules change. SMRs and advanced reactors should not be exempted on the assumption that smaller size or different fuel automatically simplifies disposal. The OECD NEA is examining how waste characteristics, storage, transport and disposal differ across advanced reactor designs, which confirms that back-end integration must begin at technology selection rather than after operation [38].
Repository governance is also a public-acceptance issue. Communities and neighbouring states may reasonably distinguish between reliable reactor operation today and confidence in institutions that must manage waste for generations. Transparent inventory reporting, independent oversight, participation and realistic milestones are therefore energy-security instruments. Delaying the repository discussion may preserve short-term political convenience but weakens long-term nuclear energy security.

6.5. Climate Change, Cooling Water and Site Resilience

Climate change is a material implementation risk for the Slovak electricity system. Nuclear plants can be affected by higher cooling-water temperatures, drought, low river flow, flooding, storms and extreme heat. The OECD NEA notes that such events have already affected nuclear operation and that warmer cooling water can reduce thermal efficiency and available output [48]. Hydropower, which is an important Slovak balancing resource, is also climate-sensitive; correlated low water availability could therefore affect both firm generation and flexibility.
The public documents reviewed do not provide a site-specific probabilistic assessment of future low-flow conditions, water temperature, heat rejection or climate adaptation for the new Bohunice unit or potential SMR sites. This absence should not be interpreted as evidence that cooling constraints are negligible. Environmental assessment and licensing should use updated climate projections, compound-event analysis and stress tests for simultaneous heat waves, drought, high demand and reduced imports. Technology selection should compare cooling-system options, water use, efficiency penalties and ecological limits.
Climate resilience also affects nuclear heat. A district-heating system may improve overall thermal utilisation in winter, but heat demand is seasonal and generally lower during summer periods when cooling constraints may be strongest. Heat sales therefore cannot be assumed to solve all surplus-output or cooling problems. A credible nuclear energy security case must test seasonal electricity, heat and water balances together.

6.6. Permitting, Cross-Border Acceptance, Nuclear Safety and Nuclear Security

Nuclear project preparation requires an environmental impact assessment, site approval, design licensing, construction authorisation and public participation. Early publication of environmental, seismic, hydrological and emergency-planning evidence can reduce procedural conflict, although it cannot guarantee agreement.
The regulator must simultaneously oversee EMO4 commissioning, existing-unit lifetime extension, alternative VVER fuel, the new large source and possible SMRs. Regulatory competence is therefore a scarce energy-security resource. Funding, staffing and training for the Nuclear Regulatory Authority should grow before the project pipeline expands. International peer review can support domestic capacity but cannot replace an independent national regulator.
Physical protection and cyber resilience must evolve with emerging threats. The national risk-preparedness plan includes cyberattack, loss of information and communication technology, extreme weather and industrial or nuclear accidents [18]. Nuclear security measures should integrate cyber-physical exercises, insider-risk management, continuity of communications and coordination with police, military and emergency services. Details that would compromise protection should remain restricted, but governance responsibilities and preparedness standards should be publicly accountable.
Public communication should avoid both technological triumphalism and reflexive secrecy. Nuclear safety, nuclear security, costs, waste, cooling, emergency preparedness and project delays should be discussed as normal components of governance. Research on Slovak and Czech media discourse shows that nuclear energy can be framed as a reliable response to external insecurity, but credibility depends on transparent treatment of trade-offs [31]. Energy-security rhetoric should not be used to prevent scrutiny; scrutiny is part of nuclear energy security. The principal implementation risks and required responses are summarised in Table 7.

7. Discussion

7.1. Robust Findings and Conditional Findings

The analysis separates robust findings from conditional findings. Four conclusions are robust. First, nuclear power is the principal source of Slovak electricity and a major contributor to current energy security. Second, the coal phase-out concerns high-carbon generation, whereas the policy objective of maintaining domestic low-carbon generation concerns nuclear, hydro and renewables. Third, the 2023–2024 export position resulted from both increased generation and reduced demand. Fourth, nuclear energy security depends on the entire system of fuel, regulation, workforce, waste, flexibility, financing, climate adaptation and protection, not only reactor availability.
Other conclusions are conditional. EMO4 is in commissioning, but its full annual contribution is not yet observed. The new Bohunice unit has political and intergovernmental support, but project delivery, cost and operation around 2040 remain unproven. SMRs are under feasibility assessment, not commercial deployment in Slovakia. Nuclear heat and hydrogen may add system value, but no bankable Slovak off-take and infrastructure case is presently demonstrated in the reviewed public evidence. These distinctions prevent planned policy from being presented as a deterministic forecast.
The official 2040 scenarios provide the strongest quantitative insight. They indicate total gross generation of 43.9–48.5 TWh and a nuclear share of about 55%, not an unlimited rise in nuclear dominance. Scenario B demonstrates that high electrification can create an 8.5 TWh import balance and a reliability problem even with strong nuclear output [5]. The Ministry scenario demonstrates that additional wind and a 300 MW SMR can coexist, but it does not establish that either will be built. The system problem is therefore a portfolio and timing problem rather than a binary choice between nuclear and renewables.

7.2. Added Analytical Value

The article’s analytical contribution comprises four elements. The first is causal qualification of the 2021–2024 balance: the demand decline is linked to the price shock and industrial curtailment, while the generation recovery is linked to Mochovce Unit 3 and changes in the supply mix. The second is scale: a 1200 MW unit would add 8.4–10.0 TWh per year, which is too large to discuss without a utilisation and flexibility strategy. The third is uncertainty: large new build, SMRs, nuclear heat and hydrogen are treated as contingent options. The fourth is resilience: energy security and nuclear energy security are evaluated under outage, delay, high-demand, climate and financing stress rather than only under the preferred policy case.
This perspective also clarifies industrial competitiveness. Reliable low-carbon electricity can support automotive, battery, metallurgical and manufacturing investment, but competitiveness is not reducible to wholesale price or nuclear share. Slovalco demonstrates that electricity contracts, carbon-cost compensation and policy stability can determine whether an efficient industrial facility operates [35,37]. A new nuclear project may support long-term contracts, but its financing and system costs must be allocated transparently. Nuclear capacity is therefore an input to competitiveness, not a sufficient explanation of it.
The broader regional literature supports a diversified reading of Slovak energy security. Research on the 2009 gas crisis and Visegrad energy-security cooperation shows that infrastructure, interconnection and institutions often advance after shocks [49,50,51,52]. Post-2022 Slovak policy has combined persistence with stronger security framing [33]. EnergyPLAN research for Slovakia also shows that climate neutrality and security require interactions among nuclear, renewables, efficiency and flexibility [30]. The present analysis extends this literature by quantifying the capacity-integration problem and by defining nuclear energy security as a multi-dimensional governance outcome.

7.3. Study Limitations

The study has important limitations. First, it does not include direct confidential interviews with the operator, transmission-system operator, industrial off-takers, financiers, energy economists, public-policy experts and environmental organisations. Consequently, the study cannot establish stakeholder consensus.
Second, the quantitative analysis is annual rather than hourly. Annual balances cannot reveal ramping, minimum-load, reserve, congestion, price and curtailment patterns. The additional-capacity calculations are transparent scale tests, not dispatch optimisation. Third, public data do not provide final cost, financing, vendor, cooling, heat-demand or project-contract information. Fourth, several projects are evolving rapidly; the evidence cut-off is 20 July 2026. Fifth, source-position appraisal reduces but cannot eliminate institutional bias, especially where government and industry announcements are the only current evidence.
These limitations mean that the article cannot prove that the proposed nuclear pathway is feasible in an investment or construction sense. It can identify conditions under which the pathway is technically conceivable and potentially supportive of energy security. Future research should use hourly system modelling, confidential stakeholder interviews, industrial-demand scenarios, distributional cost analysis, site-specific cooling studies, heat-network feasibility and probabilistic project-schedule assessment. These limitations define the scope of the conclusions.

8. Policy Recommendations

  • Complete EMO4 under independent regulatory oversight and publish commissioning milestones, outage performance and system effects before using the unit as proof that later projects will follow the same schedule.
  • Treat nuclear-fuel diversification as an operational programme: complete plant-specific qualification, secure transport and inventory, maintain parallel suppliers and coordinate with Euratom and regional VVER operators.
  • Make the Bohunice FID conditional on a public reference case covering financing, state-aid compliance, cost and delay sensitivity, lower capacity factors, largest-infeed security, cooling, waste, workforce and identified electricity or heat off-takers.
  • Establish a system-level capacity envelope before committing to SMRs. Each SMR proposal should demonstrate a specific regional, industrial, heat or replacement function and should not be added merely because a site or technology is politically attractive.
  • Accelerate wind permitting, storage, pumped-hydro modernisation, demand response, aggregation, heat storage and grid reinforcement. These resources are complements to nuclear energy security and contingency options if new nuclear delivery is delayed.
  • Require explicit load-following and surplus-management assumptions in new-build contracts and financing. Expected capacity factors should be consistent with renewable growth, annual demand and hourly market conditions.
  • Create a 25-year nuclear-workforce plan that covers preparation, construction, operation, lifetime extension, fuel qualification, regulation, decommissioning and waste. The plan should provide post-construction pathways for specialist trades instead of relying on a single-project cycle.
  • Integrate repository milestones, interim-storage capacity and decommissioning finance into every expansion decision, and use transparent participatory governance to maintain long-term nuclear energy security.
  • Require site-specific climate and cooling-water stress tests based on future, not historical, hydrology and temperature, including compound events affecting nuclear, hydro, demand and imports simultaneously.
  • Report energy-security outcomes annually using a balanced dashboard: reliability, affordability, emissions, import exposure, nuclear-fuel diversity, flexibility, outage concentration, waste milestones, regulator staffing and distribution of public financial risk.

9. Conclusions

Slovakia’s nuclear sector is central to its electricity system and to its present energy security. The country phased out coal-fired generation while maintaining domestic low-carbon generation from nuclear, hydro and renewables. Mochovce Unit 3 helped move the annual balance from import dependence in 2021–2022 to net exports in 2023–2024. Yet the lower 2024 consumption level was partly shaped by the energy-price shock and industrial curtailment, and it should not be treated as a permanent surplus.
Official 2040 scenarios project 43.9–48.5 TWh of gross generation and 24.2–26.7 TWh of nuclear generation, approximately 55% of the total. A 1200 MW unit would add roughly 8.4–10.0 TWh per year at capacity factors of 80–95%. This is a system-transforming quantity. Its energy-security value depends on industrial and electrification demand, exports, storage, demand response, heat, hydrogen, reserve requirements and economically credible load following. Additional SMRs can be accommodated only where they solve a defined system or off-taker problem.
Nuclear energy security is broader than reactor construction. It includes nuclear safety, nuclear security, diversified fuel and services, regulator capacity, climate-resilient cooling, workforce renewal, project delivery, affordability, radioactive-waste governance and public trust. A failure in any of these areas can reduce the security value of additional capacity. Conversely, a diversified portfolio of safe existing nuclear operation, renewables, wind, hydro, storage, flexible demand and selective new nuclear investment can reduce exposure to both fossil imports and single-technology risk.
The proposed Bohunice project is politically supported and technically conceivable, but its implementation feasibility is not yet demonstrated. The public evidence does not establish a final investment decision, closed financing, final vendor contract, licensed design or proven 2040 delivery schedule. Recent European experience and the Mochovce history justify explicit delay and non-delivery contingencies. SMRs and nuclear heat should likewise be treated as conditional options rather than inevitable components of the 2050 system.
The principal policy implication is the sequencing of decisions and investments. Slovakia should first convert EMO4, fuel-diversification contracts, wind planning and flexibility measures into verified operational capability. It should then decide on the scale and timing of large new nuclear projects and SMRs using updated demand, system and financing evidence. This adaptive approach protects energy security against both an adequacy deficit and an inflexible overcapacity problem.
The final conclusion is therefore conditional rather than deterministic. Slovakia can preserve a nuclear-intensive, low-carbon electricity system and strengthen energy security up to 2050, but only if nuclear development is governed as part of a diversified and climate-resilient energy system. Political momentum is a starting condition, not proof of delivery. Implementation quality, cost discipline, regulatory independence, flexibility and credible back-end governance will determine whether prospective nuclear capacity becomes an energy-security asset or a long-term liability.

Author Contributions

Conceptualization, J.D. and I.N.; methodology, J.D.; quantitative reconstruction and stress tests, J.D.; formal analysis, J.D. and I.N.; investigation, I.N.; resources, J.D. and I.N.; data curation, J.D.; writing—original draft preparation, J.D. and I.N.; writing—review and editing, J.D. and I.N.; supervision, I.N. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Institutional Review Board Statement

Not applicable. The study did not involve human participants.

Informed Consent Statement

Not applicable. The study did not involve human participants or interviews.

Data Availability Statement

All quantitative source data are publicly available in the reports and databases listed in the References. The 1200 MW and 300 MW calculations are fully described in Section 2.4 and Table 5.

Conflicts of Interest

The authors declare no conflicts of interest.

Appendix A. Coding and Evidence-Threshold Framework

Table A1. Coding framework used in the analysis.
Table A1. Coding framework used in the analysis.
CodeOperational QuestionEvidence Threshold for a Central Claim
ES-REL: Energy-security reliabilityCan demand be met under normal, outage and high-demand conditions?Observed data or official adequacy model plus an independent or comparative check.
ES-AFF: AffordabilityWho bears capital, market, balancing and delay risk?Published financing mechanism or explicit statement that the mechanism remains unresolved.
NES-FUEL: Nuclear-fuel securityAre fuel, transport, licensing and inventories diversified?Contract evidence plus licensing/operational status; announcements alone are insufficient.
NES-SAFE/SEC: Nuclear safety and securityAre accidental and malicious risks governed by competent institutions?Regulatory or risk-preparedness evidence; sensitive operational details excluded.
SYS-FLEX: System flexibilityCan surplus and variability be managed without excessive curtailment or fossil backup?Adequacy model, storage and demand-response assumptions, and load-following sensitivity.
IMP-DEL: Implementation deliveryIs the project announced, licensed, financed, contracted, under construction or operating?Stage must be stated explicitly; no conversion of a political target into an operational forecast.
SOC-WASTE: Waste and social legitimacyAre spent fuel, repository, decommissioning and participation integrated?Published inventories, funding or milestones; otherwise classified as an unresolved condition.
CLIM-WAT: Climate and water resilienceAre future heat, drought, flood and cooling conditions assessed?Site-specific forward-looking analysis; historical operation alone is insufficient.

References

  1. Slovenske Elektrarne. Nuclear Fuel Loading at Mochovce 4: Slovakia Strengthens Its Position Among Europe’s Nuclear Leaders. 2026. Available online: https://www.seas.sk/en/press-releases/mochovce-4-first-fuel-loading/ (accessed on 20 July 2026).
  2. Ministry of Economy of the Slovak Republic. Aktualizacia Integrovaneho Narodneho Energetickeho a Klimatickeho Planu na Roky 2021–2030; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2025.
  3. Ministry of Economy of the Slovak Republic. Vyrocna Sprava Ministerstva Hospodarstva 2024; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2025.
  4. U.S. Department of Energy. U.S. Energy Secretary and Slovakia’s Prime Minister Sign Agreement to Advance U.S.-Slovakia Civil Nuclear Program. 2026. Available online: https://www.energy.gov/articles/us-energy-secretary-and-slovakias-prime-minister-sign-agreement-advance-us-slovakia-civil (accessed on 20 July 2026).
  5. Ministry of Economy of the Slovak Republic. Posudenie Primeranosti Zdrojov ES SR za Rok 2024; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2025.
  6. Cherp, A.; Jewell, J. The Concept of Energy Security: Beyond the Four As. Energy Policy 2014, 75, 415–421. [Google Scholar] [CrossRef] [Scilit]
  7. Sovacool, B.K.; Mukherjee, I. Conceptualizing and Measuring Energy Security: A Synthesized Approach. Energy 2011, 36, 5343–5355. [Google Scholar] [CrossRef] [Scilit]
  8. International Atomic Energy Agency. IAEA Safety Glossary: Terminology Used in Nuclear Safety and Radiation Protection, 2022 Edition; IAEA: Vienna, Austria, 2022. [Google Scholar]
  9. International Atomic Energy Agency. Objective and Essential Elements of a State’s Nuclear Security Regime; IAEA Nuclear Security Series No. 20; IAEA: Vienna, Austria, 2013. [Google Scholar]
  10. Slovenske Elektrarne. Thermal Power Plants. Available online: https://www.seas.sk/en/about-us/our-power-plants/thermal-power-plants/ (accessed on 20 July 2026).
  11. International Atomic Energy Agency. Power Reactor Information System (PRIS): Slovak Republic Country Details and Nuclear Share Statistics. Available online: https://pris-stats.iaea.org/country-statistics/SK (accessed on 20 July 2026).
  12. RTE. French Annual Electricity Review 2022: Key Findings. Available online: https://analysesetdonnees.rte-france.com/en/electricity-review-keyfindings (accessed on 20 July 2026).
  13. Uniper. Elforsorjningen Kanslig for Enskilda Storningar: Planned Nine-Day Outage of Oskarshamn 3. 2022. Available online: https://www.uniper.energy/sverige/nyheter/elfoersoerjningen-kaenslig-foer-enskilda-stoerningar/ (accessed on 20 July 2026).
  14. Supreme Audit Office of the Slovak Republic. The State Failed in the Management but Also in the Control of the Mochovce Nuclear Power Plant Completion. 2020. Available online: https://www.nku.gov.sk/web/nku-en/news/-/asset_publisher/v7bHjTqXv5Qa/content/the-state-failed-in-the-management-but-also-in-the-control-of-the-mochovce-nuclear-power-plant-completion (accessed on 20 July 2026).
  15. Schneider, M.; Hazemann, J.; Dvorak, P.; Godoy, E.; Gorchakov, D.; Gürbüz, Ö.; Hrdy, B.; Jobin, P.; Judson, T.; Kobayashi, Y.; et al. The World Nuclear Industry Status Report 2025; World Nuclear Industry Status Report: Paris, France, 2025; Available online: https://www.worldnuclearreport.org/IMG/pdf/wnisr2025-v2.pdf (accessed on 20 July 2026).
  16. Ministry of Economy of the Slovak Republic. Sprava o Vysledkoch Monitorovania Bezpecnosti Dodavok Elektriny za 2021; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2022.
  17. Ministry of Economy of the Slovak Republic. Nudzovy Plan; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2023.
  18. Ministry of Economy of the Slovak Republic. Plan Pripravenosti Slovenskej Republiky na Rizika v Sektore Elektrickej Energie; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2023.
  19. Ministry of Economy of the Slovak Republic. Preventivny Akcny Plan; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2023.
  20. Ministry of Economy of the Slovak Republic. Priloha V: Energeticka Bezpecnost; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2023.
  21. Ministry of Economy of the Slovak Republic. Sprava o Stave Vykonavania Integrovaneho Narodneho Energetickeho a Klimatickeho Planu na Roky 2021–2023; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2023.
  22. Ministry of Economy of the Slovak Republic. Sprava o Vysledkoch Monitorovania Bezpecnosti Dodavok Plynu; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2025.
  23. Slovenske Elektrarne. Mochovce 3&4 Construction. Available online: https://www.seas.sk/en/about-us/mochovce-34-construction/ (accessed on 20 July 2026).
  24. World Nuclear Association. Nuclear Power in Slovakia. Available online: https://world-nuclear.org/information-library/country-profiles/countries-o-s/slovakia (accessed on 20 July 2026).
  25. Ministry of Economy of the Slovak Republic. A Working Meeting Held Between R. Fico and D. Sakova: We Plan to Build a New Nuclear Reactor under State Ownership; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2024. Available online: https://www.economy.gov.sk/en/press/a-working-meeting-held-between-r-fico-and-d-sakova-we-plan-to-build-a-new-nuclear-reactor-under-the-state-ownership (accessed on 20 July 2026).
  26. Ministry of Economy of the Slovak Republic. The Competition for a Financial Advisor for the Construction of a New Nuclear Power Source Has Begun; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2025. Available online: https://www.economy.gov.sk/en/press/the-competition-for-a-financial-advisor-for-the-construction-of-a-new-nuclear-power-source-has-begun (accessed on 20 July 2026).
  27. Ministry of Economy of the Slovak Republic. Slovakia and the USA Launch the Implementation Phase of the Strategic Agreement in Civil Nuclear Energy; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2026. Available online: https://www.economy.gov.sk/press/slovensko-a-usa-spustaju-implementacnu-fazu-strategickej-dohody-v-oblasti-civilnej-jadrovej-energetiky (accessed on 20 July 2026).
  28. Ministry of Economy of the Slovak Republic. D. Sakova: The Mochovce Nuclear Power Plant Is Entering a Decisive Phase; the Loading of Fuel into Unit 4 Is a Historic Milestone; Ministry of Economy of the Slovak Republic: Bratislava, Slovakia, 2026. Available online: https://www.economy.gov.sk/en/press/d-sakova-the-mochovce-nuclear-power-plant-is-entering-a-decisive-phase-the-loading-of-fuel-into-unit-4-is-a-historic-milestone (accessed on 20 July 2026).
  29. Hebda, W.; Misik, M. In Search of Energy Security: Nuclear Energy Development in the Visegrad Group Countries. Energies 2024, 17, 5390. [Google Scholar] [CrossRef] [Scilit]
  30. Karatayev, M.; Gadus, J.; Lisiakiewicz, R. Creating Pathways toward Secure and Climate Neutral Energy System through EnergyPLAN Scenario Model: The Case of Slovak Republic. Energy Rep. 2023, 10, 2525–2536. [Google Scholar] [CrossRef] [Scilit]
  31. Kratochvil, P.; Misik, M. Bad External Actors and Good Nuclear Energy: Media Discourse on Energy Supplies in the Czech Republic and Slovakia. Energy Policy 2020, 136, 111058. [Google Scholar] [CrossRef] [Scilit]
  32. Mihok, P. Understanding Political Institutional Support for Completing the Mochovce Nuclear Power Plant. Prog. Nucl. Energy 2020, 120, 103192. [Google Scholar] [CrossRef] [Scilit]
  33. Misik, M.; Oravcova, V. Policy Persistence vis-a-vis a Crisis: The Curious Case of Slovak Energy Policy after the Russian Invasion of Ukraine. Energy Effic. 2024, 17, 33. [Google Scholar] [CrossRef] [Scilit]
  34. Vrban, B.; Necas, V.; Cerba, S.; Luley, J.; Filova, V. Perspectives on the Future of Nuclear Energy in Slovakia. Energy Syst. 2023. [Google Scholar] [CrossRef] [Scilit]
  35. Hydro. Slovalco Will Stop Primary Aluminium Production. 2022. Available online: https://www.hydro.com/en/global/media/news/2022/slovalco-will-stop-primary-aluminium-production/ (accessed on 20 July 2026).
  36. Hydro. Further Curtailment of Production at Slovalco. 2021. Available online: https://www.hydro.com/en/global/media/news/2021/further-curtailment-of-production-at-slovalco/ (accessed on 20 July 2026).
  37. Hydro. Slovalco to Restart 75,000 Tonnes of Curtailed Aluminium Capacity, Supplying a Critical Raw Material for Europe. 2026. Available online: https://www.hydro.com/en/global/media/news/2026/slovalco-to-restart-75000-tonnes-of-curtailed-aluminium-capacity-supplying-a-critical-raw-material-for-europe/ (accessed on 20 July 2026).
  38. OECD Nuclear Energy Agency. NEA Small Modular Reactor Digital Dashboard, Edition 3.2. Available online: https://www.oecd-nea.org/smr-digital-dashboard (accessed on 20 July 2026).
  39. International Atomic Energy Agency. Advances in Small Modular Reactor Technology Developments: A Supplement to the IAEA Advanced Reactors Information System, 2024 Edition; IAEA: Vienna, Austria, 2024. [Google Scholar]
  40. Pan, Y. Managing the Atomic Divorce: The Challenges of East Central Europe’s Nuclear Energy Decoupling from Russia. Electr. J. 2023, 36, 107241. [Google Scholar] [CrossRef] [Scilit]
  41. Vlcek, T. Critical Assessment of Diversification of Nuclear Fuel for the Operating VVER Reactors in the EU. Energy Strategy Rev. 2016, 13–14, 77–85. [Google Scholar] [CrossRef] [Scilit]
  42. Lipka, M.; Rajewski, A. Regress in Nuclear District Heating: Why the Opportunity Was Missed? Prog. Nucl. Energy 2020, 130, 103518. [Google Scholar] [CrossRef] [Scilit]
  43. Guelpa, E.; Capone, M.; Sciacovelli, A.; Vasset, N.; Baviere, R.; Verda, V. Reduction of Supply Temperature in Existing District Heating: A Review of Strategies and Implementations. Energy 2023, 262, 125363. [Google Scholar] [CrossRef] [Scilit]
  44. Ministry of Environment of the Slovak Republic. Methodology for the Development of Wind Energy Acceleration Areas in the Slovak Republic; Ministry of Environment of the Slovak Republic: Bratislava, Slovakia, 2025. [Google Scholar]
  45. International Atomic Energy Agency. Non-Baseload Operation in Nuclear Power Plants: Load Following and Frequency Control Modes of Flexible Operation; IAEA Nuclear Energy Series No. NP-T-3.23; IAEA: Vienna, Austria, 2018. [Google Scholar]
  46. OECD Nuclear Energy Agency. Technical and Economic Aspects of Load Following with Nuclear Power Plants; OECD Publishing: Paris, France, 2021. [Google Scholar] [CrossRef] [Scilit]
  47. Gierszewski, J.; Mlynarkiewicz, L.; Nowacki, T.R.; Dworzecki, J. Nuclear Power in Poland’s Energy Transition. Energies 2021, 14, 3626. [Google Scholar] [CrossRef] [Scilit]
  48. OECD Nuclear Energy Agency. Climate Change: Assessment of the Vulnerability of Nuclear Power Plants and Approaches for Their Adaptation; OECD Publishing: Paris, France, 2021. [Google Scholar] [CrossRef] [Scilit]
  49. Duleba, A. Poucenia z Plynovej Krizy v Januari 2009: Analyza Pricin Vzniku, Pravdepodobnosti Opakovania a Navrhy Opatreni na Zvysenie Energetickej Bezpecnosti SR v Oblasti Dodavok Zemneho Plynu; Slovak Foreign Policy Association: Bratislava, Slovakia, 2009; pp. 1–42. [Google Scholar]
  50. Misik, M. Crisis as Remedy? The 2009 Gas Crisis and Its Influence on the Increase of Energy Security within Visegrad Group Countries. Int. Issues Slovak Foreign Policy Aff. 2012, 21, 56–72. [Google Scholar]
  51. Misik, M. On the Way towards the Energy Union: Position of Austria, the Czech Republic and Slovakia towards External Energy Security Integration. Energy 2016, 111, 68–81. [Google Scholar] [CrossRef] [Scilit]
  52. Misik, M.; Nosko, A. The Eastring Gas Pipeline in the Context of the Central and Eastern European Gas Supply Challenge. Nat. Energy 2017, 2, 844–848. [Google Scholar] [CrossRef] [Scilit]
Figure 1. Research design. Central claims are separated into observed outcomes, modelled scenarios, institutional intentions and author stress-test inferences.
Figure 1. Research design. Central claims are separated into observed outcomes, modelled scenarios, institutional intentions and author stress-test inferences.
Energies 19 04225 g001
Figure 2. Electricity generation and consumption in Slovakia, 2021–2024. Grey bars on the right axis show the annual net balance: imports (negative) or exports (positive). Annual export does not eliminate hourly adequacy or flexibility risks. Sources: [2,5,16].
Figure 2. Electricity generation and consumption in Slovakia, 2021–2024. Grey bars on the right axis show the annual net balance: imports (negative) or exports (positive). Annual export does not eliminate hourly adequacy or flexibility risks. Sources: [2,5,16].
Energies 19 04225 g002
Table 1. Evidence classes, source positions and analytical use.
Table 1. Evidence classes, source positions and analytical use.
Evidence ClassExamplesPrimary UseCritical Treatment
Statutory and strategic documentsNECP, adequacy report, risk-preparedness and gas-security plans [2,5,16,17,18,19,20,21,22]Policy objectives, official assumptions and modelled balancesTargets and scenarios are not treated as guaranteed outcomes.
Regulator, TSO and operator evidenceIAEA PRIS, Slovenske elektrarne, Ministry annual report [1,3,10,11,23]Reactor status, commissioning milestones and operational dataOperator claims are checked against regulator or system documents where possible.
Government and industry announcementsSlovak Ministry, U.S. DOE, WNA [4,24,25,26,27,28]Political direction, project framework and stakeholder expectationsPotential promotional bias; no equivalence with FID, EPC contract or licence.
Independent and scholarly sourcesWNISR, peer-reviewed energy-security and Slovak studies [6,7,15,29,30,31,32,33,34]Counter-evidence, conceptual framing and comparative interpretationMethods, date and normative assumptions are recorded.
Table 2. Slovak electricity production, consumption, balance and nuclear generation, 2021–2024.
Table 2. Slovak electricity production, consumption, balance and nuclear generation, 2021–2024.
Indicator2021202220232024Interpretation
Total production (GWh)30,09326,91630,08230,702Recovery after 2022; Mochovce 3 materially changed the supply mix.
Total consumption (GWh)30,86728,32826,66027,757Demand remained below 2021 because of industrial curtailment, price response and efficiency.
Net balance (GWh)−774−1412+3422+2945Negative denotes net import; positive denotes net export.
Nuclear generation (GWh)15,73015,92018,34418,387Increase in 2023 reflects Mochovce 3; nuclear share remained close to 60%.
Nuclear share of production52.3%59.1%61.0%59.9%Annual share does not describe hourly flexibility or outage concentration.
Sources: [2,5,16]. The 2021 nuclear value is taken from the 2021 electricity-supply security report. Percentages are calculated from annual generation and rounded to one decimal place.
Table 3. Current and prospective Slovak nuclear assets: status, function and evidence confidence.
Table 3. Current and prospective Slovak nuclear assets: status, function and evidence confidence.
AssetCapacity/TimingEnergy-Security FunctionStatus and Confidence
Bohunice V2 Units 3–4About 2 × 500 MWe gross; operation since 1984–1985Firm electricity, district heat, operating knowledgeOperating. Long-term continuation is conditional on periodic safety review and ageing management [2,11].
Mochovce Units 1–2About 2 × 501.44 MWe gross; operation since 1998–2000Firm low-carbon electricity and system inertiaOperating. Further uprating is possible only within demonstrated safety margins [2,11].
Mochovce Unit 3About 471 MWe gross; grid connection in 2023Changed annual balance from import pressure to export capabilityOperating; effect observed in 2023–2024 system data [2,5].
Mochovce Unit 4471 MW; fuel loading from 29 June 2026Near-term increase in firm low-carbon outputActive commissioning. Commercial performance is not yet an observed annual outcome [1,28].
New Bohunice large unitPublic framework: 1200 MWe; later planning envelope up to 1700 MW; target around 2040Potential replacement, electrification support and strategic state controlPolitical and intergovernmental preparation. No final investment decision, closed financing model, EPC contract or operating licence is evidenced [4,25,26,27].
SMRsOfficial adequacy case includes 300 MW in 2040; feasibility work considers several sitesPossible regional power, heat, industrial supply and modular replacementPre-investment option. Technology, site, off-taker, financing, fuel and licence remain unresolved [2,3,5,38,39].
Table 4. Official 2040 electricity-system balances and calculated nuclear shares.
Table 4. Official 2040 electricity-system balances and calculated nuclear shares.
Indicator (GWh Unless Stated)Scenario AScenario BMH SR Scenario
Fossil generation392841433907
Nuclear generation24,22224,39726,651
Photovoltaic generation373737373737
Wind generation103110313203
Other renewable generation329232923292
Hydropower generation588759065899
Battery discharge177217191779
Gross generation43,90144,27948,500
Gross consumption42,87652,79646,120
Electrolyser consumption10408131122
Cross-border balance (+export/−import)+1025−8517+2378
Unserved energy1382
Calculated nuclear share of gross generation55.17%55.10%54.95%
Source: exact values transcribed from Table 4.12 of the national resource-adequacy assessment [5]. Nuclear shares are author calculations. The scenarios are model outputs, not commitments.
Table 5. Transparent scale test for prospective additional nuclear capacity.
Table 5. Transparent scale test for prospective additional nuclear capacity.
CaseAnnual OutputComparison with Official 2040 SystemIndicative System Requirement
1200 MW at 80% capacity factor8.410 TWhRaises nuclear share to about 61.6–62.4% if all output is incrementalMajor demand growth, exports, storage, heat/hydrogen or lower output during surplus periods.
1200 MW at 90% capacity factor9.461 TWhRaises nuclear share to about 62.3–63.1% if all output is incrementalStronger flexibility and firm off-take; otherwise price cannibalisation or curtailment risk.
1200 MW at 95% capacity factor9.986 TWhRaises nuclear share to about 62.6–63.5% if all output is incrementalVery high utilisation requires large new loads or sustained exports.
300 MW SMR at 90% capacity factor2.365 TWhClose to the 2.378 TWh export balance in the MH SR scenarioSite-specific industrial/heat demand or replacement of other generation; cannot be added automatically.
Author calculations: annual generation = capacity × 8760 h × capacity factor. Shares assume the added generation is fully absorbed and does not displace existing output; they are upper-bound arithmetic, not dispatch forecasts.
Table 6. Conditional pathways for Slovak energy security to 2050.
Table 6. Conditional pathways for Slovak energy security to 2050.
PathwayCore AssumptionsEnergy-Security StrengthsPrincipal Risks/Decision Triggers
P1: Large unit delivered around 2040EMO4 stable; existing units extended; 1200 MW unit completed; moderate renewablesHigh firm low-carbon output; reduced fossil exposure; potential industrial contractsCost and delay; surplus hours; load following; public liability; workforce peak. Proceed only after FID, finance and grid/off-take tests.
P2: Large unit delayed or cancelledExisting fleet retained where safe; stronger wind, solar, storage, demand response and importsAvoids premature megaproject exposure; modular investment; preserves optionalityAdequacy after 2035 under high demand; import dependence; need for rapid permitting and networks.
P3: High electrification and industrial growthDemand approaches Scenario B; large new loads and heat pumpsSupports decarbonisation and industrial expansion8.5 TWh import gap in official high-demand case; requires firm capacity, flexibility and contracts.
P4: Diversified nuclear-renewable portfolioSafe lifetime extension, selective new nuclear/SMRs, 3.2 TWh or more wind, storage, heat and DSRReduces technology and supplier concentration; adaptable to demandCoordination complexity; simultaneous permitting, skills and finance demands.
Table 7. Principal implementation risks and required responses.
Table 7. Principal implementation risks and required responses.
RiskWhy It MattersRequired Response Before Irreversible Commitment
Construction cost and delayCan shift large liabilities to taxpayers or consumers and create a capacity gapIndependent reference estimate; staged FID; transparent contingency; schedule and cost sensitivity.
Large-unit outage and surplusOne unit is systemically large; high output may depress prices or require curtailmentLargest-infeed study; reserves; storage; demand response; credible off-take and lower-capacity-factor case.
Fuel and geopolitical dependenceAlternative fuel and foreign technology require licensing, transport and long-term servicesParallel qualified suppliers; strategic inventories; export-control and political-change clauses.
Workforce discontinuityShortages can delay projects; post-construction employment can collapseOccupation-by-year plan; training, certification, lifetime-extension, decommissioning and selective follow-on work.
Waste and repositoryExpansion increases inventories and intergenerational liabilitiesQuantified back-end plan, funded milestones, interim-storage margin and participatory repository governance.
Cooling and climateHeat, drought, flood and water temperature can reduce output or constrain sitesSite-specific climate stress test, cooling alternatives and compound-event licensing analysis.
Permitting and cross-border acceptanceLong procedures and legal challenge can undermine scheduleEarly EIA, transparent evidence, cross-border consultation and regulator capacity.
Physical and cyber protectionCyberattack and insider risk can affect critical infrastructureIntegrated nuclear-security doctrine, exercises and protected but accountable governance.
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Dworzecki, J.; Nowicka, I. Nuclear Energy Development and Energy Security in Slovakia: Current Status and Conditional Prospects up to 2050. Energies 2026, 19, 4225. https://doi.org/10.3390/en19174225

AMA Style

Dworzecki J, Nowicka I. Nuclear Energy Development and Energy Security in Slovakia: Current Status and Conditional Prospects up to 2050. Energies. 2026; 19(17):4225. https://doi.org/10.3390/en19174225

Chicago/Turabian Style

Dworzecki, Jacek, and Izabela Nowicka. 2026. "Nuclear Energy Development and Energy Security in Slovakia: Current Status and Conditional Prospects up to 2050" Energies 19, no. 17: 4225. https://doi.org/10.3390/en19174225

APA Style

Dworzecki, J., & Nowicka, I. (2026). Nuclear Energy Development and Energy Security in Slovakia: Current Status and Conditional Prospects up to 2050. Energies, 19(17), 4225. https://doi.org/10.3390/en19174225

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
