Article

Strategies to Mitigate Risks in Building Information Modelling Implementation: A Techno-Organizational Perspective

Lincoln School of Design and Architecture, Brayford Pool Campus, University of Lincoln, Lincoln LN6 7TS, UK
*
Author to whom correspondence should be addressed.
Intell. Infrastruct. Constr. 2025, 1(2), 5; https://doi.org/10.3390/iic1020005
Submission received: 14 April 2025 / Revised: 28 May 2025 / Accepted: 11 July 2025 / Published: 17 July 2025

Abstract

The construction industry is moving towards the era of industry 4.0; 5.0 with Building Information Modelling (BIM) as the tool gaining significant traction owing to its inherent advantages such as enhancing construction design, process and data management. However, the integration of BIM presents risks that are often overlooked in project implementation. This study aims to develop a novel amalgamated dimensional factor (Techno-organizational Aspect) that is set out to identify and align appropriate management strategies to these risks. Firstly, it encompasses an in-depth analysis of BIM and risk management, through an integrative review approach. The study utilizes an exploratory-based review centered around journal articles and conference papers sourced from Scopus and Google Scholar. Then processed using NVivo 12 Pro software to categorise risks through thematic analysis, resulting in a comprehensive Risk Breakdown Structure (RBS). Then qualitative content analysis was employed to identify and develop management strategies. Further data collection via online survey was crucial for closing the research gap identified. The analysis by mixed method research enabled to determine the risk severity via the quantitative approach using SPSS (version 29), while the qualitative approach linked management strategies to the risk factors. The findings accentuate the crucial linkages of key strategies such as version control system that controls BIM data repository transactions to mitigate challenges controlling transactions in multi-model collaborative environment. The study extends into underexplored amalgamated domains (techno-organisational spectrum). Therefore, a significant contribution to bridging the existing research gap in understanding the intricate relationship between BIM implementation risks and effective management strategies.

1. Introduction

The construction industry is considered a major growth industry globally and construction projects are s by interdisciplinary and multistep processes with excessive portion of global energy consumption and carbon emissions [1,2,3]. According to [4], we live in an era of change, not measured in years, but days or even hours, due to digital revolution pushing towards all aspects of our life at a faster pace and advancing the industry towards a more innovative, collaborative, and technological approach is essential [5]. The adoption of new digital technologies for advanced information and communication allows capturing, displaying, processing, collaborating and storing information [4]. An example of such modern digital technology is Building Information Modelling (BIM). Currently, BIM technology is widely used and is becoming increasingly prevalent in the Architecture, Engineering and Construction (AEC) industry [6,7]. It is the process of creating and managing information using an intelligent model and a cloud platform, integrating multidisciplinary data for built asset throughout its lifecycle [8]. However, there is considerable literature that is focused on BIM benefits with less consideration of the problematic implementation process across the construction industry. Additionally, what is lacking are management strategies to mitigate these risks. For example, ref. [9] study on cloud-based BIM governance solutions to facilitate team collaboration in construction projects identified some socio-organizational barriers to BIM adoption, which suggest there is a significant knowledge gap in the literature with non from a techno-organizational perspective. Ref. [10] developed a tailored RBS and [8] discussed risk classification such as environmental, economic and social risks from a single dimensional perspective. However, failed to extend the scope to the amalgamated dimensional aspect. Elshabshiri et al. [11] discussed challenges and barriers in advancing BIM and DT technology and suggest establishing universal standards for data interoperability and security is crucial to overcome this barrier. These scholars have highlighted the problematic implementation of the technology and inherent risk in the construction industry even though a much higher dimension and levels within BIM have been reached. However, no research was conducted on management strategies to mitigate these risks. Recognizing this knowledge gab, this study undertakes a critical literature review and presenting the analysis relating to BIM implementation from a multi-dimensional perspective but limiting the scope to the intersection of the technical and organizational dimension. The goal is to address the problem using an integrative review method to identify and assess the magnitude of the risk factors and then align appropriate management strategies.

1.1. Literature Review

BIM is a process and modelling technology for creating, communicating, analyzing digital information models during the life cycle of a construction project [12]. BIM application extends three dimensional (3D) geometric data into a multi-dimensional information model to achieve specific functions [6]. Such as a central information repository to provide comprehensive, reliable, and easily accessible information to stakeholders, and information integration platform for managing building operation and maintenance [6,7,13]. The widespread application of BIM technology yielded several benefits in the construction industry [14], such as improving reliability, enhancing data availability as a potential solution for reducing time in carbon emission assessments [6]. Including quality control, cost management, scheduling, clash detection, and simulations through 3D data models enhancing efficiency and transparency [8,15]. The extraordinary scalability of BIM integrated with advanced multiple technologies plays a pivotal role throughout the planning, design, construction, operation and maintenance of a project’s entire lifecycle [7]. For example, [7] merge BIM with generative AI technologies for intelligent structural design pipeline. BIM integrated with Internet of Things and cloud computing to develop BIM-based Digital Twin to overpass BIM implementation barriers [13,14]. Within that context there are various associated risks implementing BIM due to increasing complexity of the construction industry and the advances in computer technology [12]. Such important implementation barriers and challenges are initial investment in hardware and software, stakeholder coordination issues, initial BIM and programming skills or low data interoperability [11,13]; changes in traditional working methods with more capital investment at the early stages hinders BIM application in property management [14]; Applying theoretical knowledge to practical real-life scenarios is challenging and adapting legal frameworks to accommodate new technologies and the management of intellectual property rights within these digital environment still remain a significant obstacle. Additionally, the necessity for systemic cultural change and workforce upskilling adapting to new technological demands further complicates the implementation process [11]. In addition to that the construction industry is still ranked amongst the highest in terms of risk exposure [16,17,18], because risk is present ubiquitously in every aspect of our everyday life. Hence an inherent element in every aspect of the construction industry that is hard to avoid [19], and building safety has always been one of the most important pillars of building construction processes [20]. However, incorporating the implications of these uncertainties and risks is a key feature of management for construction companies in the industry. In other words, an effective risk management is understood to be valuable in managing construction projects more accurately with consistency to achieve optimum project performance [17,21].
Risk is defined as an event with known uncertainty, usually measured in terms of likelihood and severity. It has the potential to significantly affect project outcomes such as time, cost and quality, with both negative and positive impacts on project objectives [8,22]. Moreover, risk management refers to a series of actions taken to mitigate the risk [23]. It is essential for decision-making and integrated into the structure, program, operations, and strategic activities of an organization project levels. By virtue, risk vary in nature depending on the project type, as a result numerous studies meticulously defined risk management, as a process of planning, identifying, analyzing, treatment, monitoring project risks and review [8,22,24,25]. Nevertheless, risk identification is the first stage in the process [22], and risk categorization which structures the diverse nature of risks, has been widely accepted as an integral part of risk identification [25]. Various scholars have adopted various risks identification techniques such as expert interview, document review, fault tree analysis, risk map and risk breakdown structure (RBS) etc. [10,26]. However, the scope of this study is limited to BIM and RBS to develop a risk database, because RBS is highly ranked in the representation of risk factors in events and projects. It is an easily updatable framework that is open and flexible, which can offer a global view of risk exposure [10]. Researchers categorize risks as internal and external risk, social risks covering community engagement, environmental risks involve climate conditions, financial risks inaccuracies in cost and technical risks such as design flaws etc. from a single dimensional perspective [8]. Hence, the scope of this study extends to the amalgamated dimensional perspective specifically the techno-organizational aspect. For example, ref. [27] suggested that various project practitioners practice formal critical path scheduling techniques for estimating project duration. Conversely, they structure cost estimates into cost categories using work breakdown structures relating to the physical project work. However, in BIM practical settings the approach by technology-pull implementation perspectives that is focused on aligning existing BIM based tools with the current work practices in organizations might balance the prevailing technology-push implementation perspectives (such as UK government BIM mandate) within the construction industry. This suggests that aligning an organization with technology depends on understanding the project management methods that guide the operation of a project team and aligning the existing functionality of BIM-based tools with these methods [27]. Considering that the construction industry is fragmented, likewise introducing innovative technology such as BIM is fragmented [28]. As a consequence, ref. [29] suggest the successful implementation of BIM involves moving away from fragmented roles. Contrarily, these risks will keep evolving as Hooper and Ekholm [30] suggest BIM project delivery remains both a practical and a theoretical problem due to new design processes and procedures emerging. This is because, as technology advances with new models, new issues will inevitably arise. It is not just about switching tools but also about adapting to new work processes [31,32,33,34]. Moreover, BIM should not be understood merely as a digital tool; it encompasses vast amounts of data and information, which also introduce risks associated with the misinterpretation of BIM among AEC professionals. Hence, ref. [35] suggests the fragmentation of BIM data, which is problematic can be resolved by providing a transparent BIM coordination framework that represents the fragmented BIM data as a single distributed data model. Additionally, ref. [36] recommend that functional coupling of the fragmented construction organizations into an integrated project delivery team(s) can be a solution for the lack of data integration between stakeholders. The COBie standard enables stakeholders to systematically organize maintenance information in BIM addressing information losses [14]. BIM protocols alignment with ISO standards is one of the best ways to achieve and provide a structured well-defined guidance that clarifies, simplifies, and organizes each process throughout the project lifecycle [8]. Notably, mitigating strategies were limited with regard to the identified risk factors in this category due to lack of reference materials indicating a knowledge gap in this domain. Thus, a comprehensive study of BIM’s practical applications in construction is necessary to fully explore risk factors and management strategies.
Therefore, for a successful BIM implementation, identifying risks early will enable industry professionals to plan and better respond to these potential risk factors via RBS [37], and effective risk management is vital to mitigate these risks [8]. Therefore, the following objectives seeks to implement the risk management process by: firstly, identify and categorize the risk factors using risk breakdown structure followed by analysis; Secondly, risk evaluation by assessing the severity of the risk factors; Thirdly, risk response and treatment by linking management strategies to the identified risk factors; finally, assess and interpret the evidence, drawing on the views and experience of these professionals.
This paper is structured as follows: It presents a comprehensive integrative review encompassing key domains of BIM and other Information Technology (IT)-related studies intertwined with BIM. This review scrutinizes evolving risk factors inherent in the technology’s implementation. Then critically examines the existing body of BIM literature and its intersection with risk management, rationalizing the research problem that serves as the focal point of this study. Additionally, encompassing the theoretical framework that will guide the study. Moving forward, Section 2 outlines the methodology, reporting on the paper retrieval process, detailing the research design, and categorizing risks systematically from a techno-organizational perspective, and discussing the online survey strategy. Section 3 provides a meticulous account of the study’s results, and a comprehensive analysis of these findings. In Section 4, the paper discusses the practical implications, and conscientiously delineates its limitations. The concluding section synthesizes the research study, drawing attention to its broader impact and applicability. It culminates with well-founded recommendations that not only encapsulate the direction for future studies but also emphasize the significance of the research’s contributions to the field.

1.2. Theoretical Framework

BIM implementation is a combination of information technology (IT) in a social environment that requires an organization culture change. Therefore, its success in organizations depends not only on technical issues but also on social issues [38]. Hence, to examine this integration from a techno-organizational perspective requires a theoretical framework and means of evaluation for a successful BIM implementation by AEC professionals. Theories act as a bridge between variables, while a theoretical lens guides a study [39,40]. There are various theoretical models and frameworks for the design and analysis of BIM studies from a techno-organizational perspective. For example, Technology Organization Environment Theory, Delone and McLean IS Success Model [41] and Leavitt Socio-technical Model (LSTM) etc. [42]. The Leavitt’s model comprises of four components tightly connected to each other (i.e., technology, actors, task, and structure). Mat Ya’acob et al. [43] applied the model to investigate collaboration in BIM-based construction networks (BbCNs) (i.e., BbCNs is a BIM system that connects technology, actors, task, and structure in BIM-enabled projects). They extended the model by including new components that act in synergy to achieve a balance in socio-technical systems. Therefore, the proposed theoretical framework for this particular paper was developed by [44] perceived as the “blueprint” of this research enquiry serving as a guide. It is the structure that summarizes concepts and theories, and supports them within a research study [45,46]. The blueprint is suitable for this study because it encompasses the extended version of the sociotechnical theory known as the Leavitt Socio-technical Model (LSTM) developed by [42]. In [47], the study utilizes the model to examine the BIM implementation process within an organization in relation to the sociotechnical framework. Their findings suggest that a complex and interrelated set of incidents, events, and gaps emerged, threatening the stability of organizational norms and work processes. This indicates extending the model to include additional components in developing a framework to examine all the aspects is beneficial. Hence, the Leavitt sociotechnical model is a suitable theoretical lens for this study, as its underlying principles closely reflect the working nature of BIM systems and are capable of explaining the challenges of modern sociotechnical systems (STSs). Its explanatory power expands to include new components, producing a modified model that better reflects BIM-related systems [44,47,48]. Therefore, an extended version of the Leavitt sociotechnical model, incorporating components of BIM-RBS risk factors and BIM-RBS-MS management strategies (i.e., socio-organizational, technical, legal-contract, eco-financial aspects etc. see Figure 1) developed by [44], will provide the theoretical basis for examining all categories while limiting the scope to the techno-organizational dimension. This is because the fundamental principle enacted with the model states that all the components are highly interrelated, and the system is in a state of equilibrium. Any event that causes a change in the system is an incident (i.e., risk factor). These incidents shift the system into a state of disequilibrium and is determined by the boundaries of the deep structure representing the risk magnitude. Therefore, an intervention is required (i.e., management strategy) to move the system back to a new equilibrium state [43,44,48]. Figure 1 displays the developed theoretical framework by [44] and its application to this study shown in green color.

2. Methodology

This section outlines the materials and methods used to assess BIM implementation risks and establish management strategies. It covers the research design, inquiry procedures, and data collection methods (i.e., primary and secondary data) suitable for analysis and interpretation to achieve the study’s objectives.
Bibliometric analysis identifies key trends, collaborations, and research patterns, offering an overview of the body of knowledge. Meanwhile, an integrative review—a flexible and holistic approach distinct from a systematic review—examines a broad range of sources, including various study designs, methodologies, and literature types [49]. A systematic literature review, on the other hand, delves deeper into challenges, gaps, and opportunities in the field [11,26,50].
To analyze the intersection of the technical and organizational aspects, this study adopts an integrative review approach following a systematic process. This method enables the synthesis and structuring of knowledge, facilitating its application in practice by AEC professionals—particularly in risk evaluation, management strategies, and identifying key considerations for BIM implementation. The research design is presented next.

2.1. Research Design

In this study, the research design aligns with the risk management process as illustrated in Figure 2. It shows the strategic plan conducting the research by outlining the methods and procedure for data collection and analysis in relation to the objectives set out [51].

2.2. Paper Retrieval Process (Step 1–3)

The database used in collecting Journal articles and conference papers were retrieved from Scopus and Google Scholar as they provide extensive coverage of multidisciplinary scientific literature [48,52]. The search strategy in Scopus involved three sets of keyword combinations used for risk identification by triangulating “Building information modelling” and “risk” and “management”. For management strategies the terms “Risk management” and “management strategies” and “BIM” or “Building Information Modelling” were applied. On Google scholar the full research topic was entered into the search engine. Adequately, the search covered publications from 2000 to 2025. For article selection criteria, a total of 326 English language publications were initially downloaded. After screening for relevance—excluding non-English papers and those unrelated to the research focus—94 articles were selected for risk identification and 30 for risk management strategies totaling 124 relevant articles for this study. These relevant articles were saved in RefWorks, a reference management program enabling the convenient elimination of duplicates. Then downloaded into NVivo 12 Pro software which enabled risk identification and analysis for categories via coding because a similar approach was successfully conducted and validated by [53] and [54].
Thematic analysis was used to extract risk factors from these relevant papers, recognizing that different fields describe risks using various terms such as “threat,” “hazard,” “uncertainty,” “challenge,” and “barriers” [52]. An open coding process facilitated categorization, a well-established qualitative analysis method that emphasizes comparison, similarity, and contrast against existing models to frame interpretations. The identified risks were classified based on prior scholars’ categorization techniques but were modified using a risk breakdown structure (RBS) from a theoretical perspective (Figure 1). This approach contributed to developing “BIM-RBS” to achieve the study’s first objective [44,55,56]. Then content analysis was used to extract and analyze management strategies linked to identified risk factors, focusing on key areas such as previous experience, knowledge reuse, techniques, methods, and procedures [57,58,59]. This enabled the development of BIM-RBS (risk factors) and BIM-RBS-MS (management strategies) representing variables used in analyzing the online survey.

2.3. Online Survey (Step 4)

A survey was conducted to achieve the second objective—establishing the statistical relationship between BIM-RBS and BIM-RBS-MS, determining the magnitude of risk factors, and ensuring high representativeness for precise results. Sampling and questionnaire design are key aspects of this survey. The criteria for the questionnaire development were designed based on gaps in management strategies within the techno-organizational spectrum, identified through the literature review. The measurement scale used was the 5-point Likert scale to determine the magnitude of risk factors aligning with the equilibrium and disequilibrium state principles of the Levitt socio-technical model. For data sampling, defining a specific sample frame was challenging due to geographic restrictions, which could limit valuable insights. To enhance generalizability, AEC professionals were targeted through BIM groups on LinkedIn, where they were invited to participate. This was achieved using Microsoft Forms which is an online tool for creating and distributing surveys. 60 participants responded between 2024–2025 which is one of the limitations discussed later in Section 4. The results were downloaded into Microsoft spreadsheet and then uploaded into Statistical Package for Social Sciences (SPSS) software (version 29). for numerical data analysis and the techniques for the quantitative analysis are detailed below.
  • Variables and Scales: Nominal (N) Gender and Age; Ordinal (O) Level of BIM experience, BIM-RBS as the outcome variable and shares the same properties as the dependent variables; String (S) BIM-RBS-MS as the intervening variable that transmit the effect of an independent variable on a dependent variable.
  • Cronbach’s Alpha (α) test (CA): was employed to measure internal consistency/reliability of the survey scale. It assessed the reliability of multiple Likert-scale questions determining the magnitude of risk factors (BIM-RBS). Various thresholds were applied and the test procedure involved [Click Analyze > Scale > Reliability Analysis > select the variables > ensuring the model says ‘Alpha’ > then click OK]. The results are shown in Section 3.2.
  • Simple linear regression (SLR): attempts to predict the outcome variable (BIM-RBS) using the predictor variable (Level of BIM experience). The test procedure involved [Click Analyze > Regression > Linear > select outcome variable and move to the ‘Dependent’ box > select predictor variable and move to the ‘Block 1 of 1’ box > Select Statistics > click Estimates, Confidence Intervals, Model Fit, R Squared Change, and Descriptives]. See results in Section 3.2.

2.4. Mix-Method Analysis (Step 5)

This approach involved manually sifting through and analyzing both qualitative data (i.e., literature review) and quantitative data (i.e., online survey), enabling different perspectives and paradigms to frame the Nexus BIM-RBS and BIM-RBS-MS matrix and develop the database. This approach helps gain a holistic understanding of risk factors, their magnitude, and management strategies for implementing BIM by comparing data and producing more robust and compelling results with global relevance.

3. Results

The research gap identified in this study is predominantly associated with two interrelated domains, as revealed through a critical analysis of the literature review. Scholars have mainly focused on a single-dimensional aspect. The technical aspect relates to the physical characteristics of the technology, such as tools (i.e., software and hardware), while the organizational aspect concerns the structure (i.e., inter- or intra-organizational links between departments and disciplines). The analysis of the results is based on the equilibrium and disequilibrium principles of the Leavitt socio-technical model as illustrated in Section 1.2, Figure 1. Therefore, the aspects and capabilities of BIM are examined by narrowing the research scope to the intersection of these two knowledge domains, referred to as the techno-organizational spectrum presented below.

3.1. Secondary Data Analysis (Literature Review)

BIM-RBS: The analysis indicates [32] suggest that BIM holds promise for addressing AEC industry challenges, but the analysis reveals practical difficulties in BIM implementation due to the construction industry’s fragmented structure, inherently affecting BIM [28]. Notably, there’s a lack of strategies to integrate and exchange information among fragmented BIM components and roles [29], highlighting the need for research to evaluate and address this risk. Practitioners must recognize that immediate solutions for these challenges are elusive, given the constant evolution of BIM technology with new components, processes, and methods [30,34]. Furthermore, the technical challenges of integrating BIM models with other systems such as facilities management, project management and quantity surveying systems etc. indicate time constraint for organizations to properly internalize BIM tools into their work processes and practices. Nevertheless, the boundaries of the two-knowledge domain lack comprehensive research, leading to a shortage of reference materials for certain strategies. Further research was crucial to comprehend and tackle challenges within this category to avoid a shift of BIM systems into a disequilibrium state.
BIM-RBS-MS: Analyzing for strategies to manage data integration gaps among stakeholders, integrating fragmented organizations into an integrated project delivery team can be effective [36]. Implementing a version control system controls BIM data repository transactions in a collaborative environment, addressing organizational and legal-contractual challenges [60]. Utilizing Application Programming Interface (API) mitigates technological interface challenges, advancing BIM systems toward equilibrium [61]. (See Figure 11 displaying the findings) Further research was necessary to determine the risk magnitude and establish equilibrium-seeking strategies by employing the online survey to address the risk factors.

3.2. Primary Data Analysis (Online Survey)

The results (see Figure 3) reveal the 16-item questionnaire measured Evaluation Ability across all BIM-RBS dimensions, yielding a Cronbach’s Alpha value of α = 0.947, indicating “Very High Reliability” ([62], p. 744 therein).
For the Simple linear regression (SLR), the analysis presents the model summary and the Figure 4 below shows a selection of descriptive statistics about the model/regression overall: the R-value (R), the R-Squared Statistic (R Square), the F statistic measuring change (F Change) and the p-value associated with the F stat change (Sig. F Change).
ANOVA: The Figure 5 below shows a further selection of descriptive statistics about the model/regression overall: two different Degrees of Freedom (df), the F statistic measuring change (F Change) and the p-value associated with the F stat change (Sig. F Change).
Coefficients: The Figure 6 below shows the exact values of the constant and of our predictors, it also shows if the variables are significant (Sig.) and the 95% Confidence intervals (95.0% Confidence Interval for B).
A simple linear regression was used to predict the magnitude of the risk factors in BIM-RBS Techno-organizational Aspect (TOA) based on the level of BIM experience. The results showed that experience is a significantly influence on the TOA, however it only accounted for less than 1% of the variance seen in TOA. F = 0.085, p ≤ 0.001, R square = 0.001, R square adjusted = −0.016. The regression coefficient (B = −0.053, 95% CI (−0.309, 0.414) indicated that an increase in one point level of BIM experience score, would correspond, on average, to a decrease in BIM-RBS (TOA) score by −0.053 points.
  • Analyzing for risk magnitude (BIM-RBS) and management strategies (BIM-RBS-MS)
A-(Risk Magnitude): The analysis with regards to the difficulty to implement BIM due to the fragmented structure of the construction industry, as BIM is also fragmented indicate the level of the risk factor by participants. 30% selected very effective; 40% somewhat effective; 21% neither effective nor ineffective; 4% somewhat ineffective; 4% very ineffective. A shift to disequilibrium state of BbCNs by 70%. (See Figure 7).
A-(BIM-RBS-MS) Strategies for Achieving Equilibrium in BIM Implementation: Achieving equilibrium requires industry standards, collaboration, capacity building, and technological advancements. Organizations and industry bodies have established standards and guidelines to promote consistency and interoperability in BIM processes, aligning data formats and information exchange among stakeholders. Collaborative project delivery methods, such as Integrated Project Delivery (IPD) and Building-SMART’s Open-BIM, encourage early stakeholder involvement, fostering integration and cooperation while reducing fragmentation and improving project outcomes. Capacity-building initiatives, including training programs, certifications, and education, aim to bridge the BIM proficiency gap and promote standardized practices across the industry. Additionally, advancements in BIM software and technology are addressing interoperability challenges, with Open-BIM principles supporting non-proprietary data formats to enhance data exchange and collaboration across platforms. While these strategies help move BIM systems toward equilibrium by enhancing productivity and streamlining processes, challenges remain due to the fragmented nature of the construction industry. Since BIM implementation also faces fragmentation, ongoing collaboration, industry-wide cooperation, and a commitment to standardization are essential to mitigating risks and ensuring long-term success.
B-(Risk Magnitude): The analysis on the risk due to lack of strategies for integration and exchanging information among BIM components between organizations working on a project. The magnitude of the risk factor indicates 39% of participants selected very effective; 24% somewhat effective; 16% neither effective nor ineffective; 6% somewhat ineffective; 14% very ineffective. A shift on BIM systems to disequilibrium status by 63%. (See Figure 8).
B-(BIM-RBS-MS) Strategies for Achieving Equilibrium status in BIM systems: Analyzing for equilibrium status to achieve a coordinated and integrated approach, enabling smooth collaboration and avoiding delays or discrepancies in the exchange of critical project information involves; conducting collaboration planning sessions early in the project to identify the BIM components involved and establish strategies for their integration. This includes defining information exchange requirements, data formats, and protocols to ensure compatibility and seamless communication between organizations. Utilize data sharing platforms such as Common Data Environments (CDEs) or cloud-based collaboration tools, to facilitate efficient information exchange. These platforms provide a centralized repository for storing and sharing BIM components, enabling real-time access and collaboration among organizations. Establish standardized information exchange protocols that outline the requirements for sharing BIM components. These protocols specify the format, level of detail, and naming conventions to ensure consistency and compatibility across organizations. Utilize BIM software and file formats that supports interoperability, allowing seamless integration of BIM components between organizations. Open-BIM principles and Industry Foundation Classes (IFC) can be utilized to enable the exchange of information across different software platforms. Regular coordination meetings with representatives from each organization involved in the project. These meetings will provide opportunities to discuss integration challenges, exchange information, and address any issues or conflicts that may arise during the process.
C-(Risk Magnitude): The analysis due to lack of alignment between the IT strategy and organizational strategy in BIM-enabled projects. In assessing the severity of the risk factor 33% of participant selected very effective; 29% somewhat effective; 23% neither effective nor ineffective; 8% somewhat ineffective; 6% very ineffective. Indicating a shift to disequilibrium status of BbCNs by 62%. (See Figure 9).
C-(BIM-RBS-MS) Strategies for Attaining Equilibrium Status Implementing BIM: To achieve equilibrium status involves strategic planning where organizations should ensure that the IT strategy and organizational strategy are developed in tandem. This involves aligning the objectives, goals, and priorities of the IT strategy with the overall organizational strategy. Clear communication and collaboration between IT and organizational leadership are essential to achieving this alignment. Engaging key stakeholders from different departments and levels of the organization is crucial to understand their requirements and expectations regarding BIM implementation. This input should be considered in the development of the IT strategy, ensuring that it supports and enables the broader organizational objectives. Encouraging cross-functional collaboration and communication between IT teams and other departments is essential for aligning strategies. Regular meetings, workshops, and forums can facilitate knowledge sharing and ensure that the IT strategy is closely linked to the needs of various business units. Effective change management practices should be implemented to support the alignment process. This involves communicating the strategic direction, addressing any resistance or concerns, and providing training and support to ensure smooth adoption of BIM technologies and practices across the organization. Continuous evaluation and adjustment by regular monitoring and evaluation of the alignment between the IT strategy and organizational strategy should be conducted. This allows organizations to identify any gaps or emerging issues and make necessary adjustments to ensure ongoing alignment. Organizations that prioritize alignment and actively work towards bridging the gap are more likely to achieve better integration of BIM technologies, improved organizational performance, and enhanced project outcomes.
D-(Risk Magnitude): The analysis regarding issues with privacy constraints associated with external storage when organizations work together. The assessment indicates 45% of participant selected very effective; 27% somewhat effective; 14% neither effective nor ineffective; 7% somewhat ineffective; 7% very ineffective. A shift on BIM systems to disequilibrium state by 72%. (See Figure 10).
D-(BIM-RBS-MS) Strategies to Achieve Equilibrium Status in BIM implementation: To effectively manage the risk severity and shift BIM systems towards equilibrium status involves data classification and access control. As organizations should implement a data classification framework that categorizes information based on its sensitivity and importance. Access control should be established to restrict access to sensitive data, ensuring that only authorized individuals can view and modify it. When sharing BIM data externally, secure data transfer protocols should be employed to protect data in transit. Encryption, secure file transfer protocols, and virtual private networks (VPNs) can be used to establish secure channels for data exchange. Organizations should implement non-disclosure agreements (NDAs) with external parties involved in the project. These agreements establish legal obligations for maintaining the confidentiality of shared information and help protect against unauthorized disclosure. Clear policies should be established regarding data ownership and retention. This ensures that organizations retain control over their data and can specify how long it will be stored and when it should be securely disposed of after the project’s completion. Organizations should adhere to relevant privacy regulations, such as the General Data Protection Regulation (GDPR) or local data protection laws. Ensuring compliance with these regulations includes obtaining necessary consent for data processing, providing transparency to data subjects about the collection and use of their data, and implementing appropriate safeguards for data protection. These measures align towards best practices for data privacy and security, ensuring that sensitive information is adequately protected throughout the project lifecycle.

3.3. Findings

The findings from the analysis shows the aspects and capabilities of BIM-RBS and BIM-RBS-MS providing an up to date understanding of risk factors and management strategy in the techno-organizational spectrum “BIM-RBS Matrix and BIM-RBS-MS Nexus” (See Figure 11 and Table 1).

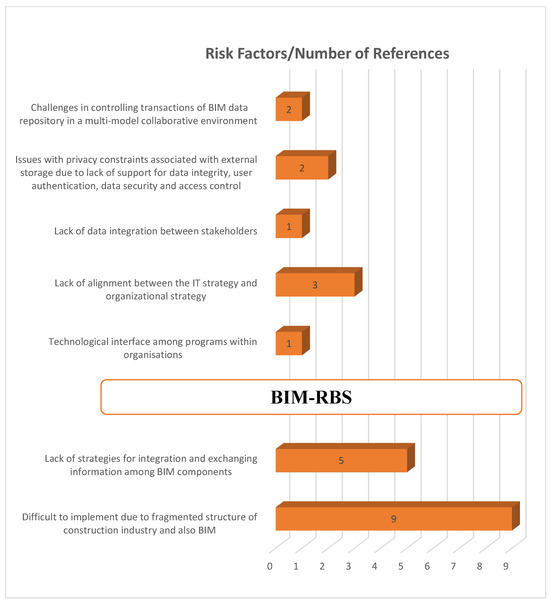

The findings presented in Table 1 and Figure 11 indicate the average magnitude of the risk factors in this spectrum is 66.75% shift to disequilibrium status. The dominant risk factor in this category is associated with the difficulty to implement BIM due to the fragmented structure of the construction industry, as BIM is also fragmented. The risk magnitude shows a 70% shift to disequilibrium state and is still a challenge because it is routed beyond, and reaching over to the real estate development dynamics, therefore utilizing industry standards and guidelines with IPD methods can minimize the risk. Then the lack of strategies for integration and exchanging information among BIM components between organizations working on a project has a 63% shift to disequilibrium state, and is associated with lack of computing power. It can be mitigated using CDE with collaboration planning sessions. The lack of alignment between the IT strategy and organizational strategy in BIM-enabled projects has a 62% shift to disequilibrium status that can result in suboptimal utilization of BIM technologies, disjointed workflows, and missed opportunities for process improvements. This can be minimized by change management practice and strategic planning with regular meetings, workshops, and forums to facilitate knowledge sharing. The issues with privacy constraints associated with external storage when organizations work together has a 72% shift to disequilibrium state. It is due to data security and access control; user authentication and data integrity; challenges controlling transactions in multi-model collaborative environment on a BIM project. This can be managed with data classification and assess control with non-disclosure agreements (NDAs).

4. Discussions

The body of literature examining BIM and risk management, as assessed by various scholars [8,16,28,44,55,63,64,65,66,67,68] has significantly advanced our understanding in key BIM-related domains. This includes diverse insights into BIM definitions presented by experts such as [2,3,10,18,24,36,69]. It also explores the integration of BIM with other components, processes, and methodologies, advancing the technology into the Construction 4.0; 5.0 era [24,67,70,71,72,73]. The critical analysis of these findings highlights key areas within BIM studies, unveiling previously unexplored facets and identifying notable research gaps such as the techno-organizational spectrum. The varying definitions of BIM, reflecting its multifaceted applications across disciplines, contribute to a comprehensive understanding of the term and also exacerbate further risks. Furthermore, the examination reveals that the integration of BIM maturity advances with various components, methods, and processes, as discussed in the existing literature, heightens the risk factors associated with BIM implementation. Responding to these challenges, scholars [8,18,28,55,63,64,65,66,74] have independently proposed some strategies and delineated singular dimensions of risk factors, culminating in the emergence of the concept of BIM-RBS, a term embraced and expanded upon in this study. The scope of the risk management process employed by these scholars in their studies was limited to the third stage of the risk management process. However, this study extends the process one step further to the fourth stage, risk response and treatment culminating in the identification of management strategies to develop BIM-RBS-MS in alignment with BIM-RBS as strategies to mitigate the risk factors that extends to the amalgamated dimensional aspects specifically the techno-organizational spectrum.
To achieve this, an integrative approach was employed, facilitating the processing of retrieved papers on BIM and risk management. Furthermore, the purpose of the analysis, conducted through coding using NVivo 12 Pro software, not only established BIM-RBS through thematic analysis from a single dimensional perspective but also unveiled BIM-RBS-MS through content analysis from both single and double dimensional perspective of the techno-organizational spectrum. This extends to the analysis conducted through statistics using SPSS software to further discover management strategies for the identified risk factors and determine its magnitude, guided by the established theoretical framework developed by [44]. These methods include the Cronbach’s Alpha (α) test for reliability and ‘Simple’ Linear Regression to predict the outcome variable (BIM-RBS) using the predictor variable (Level of BIM experience). This allowed for the interpretation of the techno-organizational aspect of risk factors and management strategies, generating the terminology that had not been previously explored in scholarly works. Thus, contributes to a deeper understanding of BIM-related risk severity and provides valuable insights into the development of effective management strategies. This approach completely neutralizes the issue put forward by [28] that the construction industry is fragmented, likewise introducing innovative technology such as BIM is also fragmented. As [29] suggest the successful implementation of BIM involves moving away from fragmented roles, and the findings in this study is a course of action. Because it is a solution which will aid in mitigating these risks that will keep evolving based on [30] suggestion that BIM project delivery remains both a practical and a theoretical problem due to new design processes and procedures emerging. In essence, this study not only enriches the existing knowledge base but also equips AEC professionals with a data that transcends traditional disciplinary boundaries, fostering a more integrated and informed approach to BIM implementation. Moreover, the qualitative methodology, leveraging NVivo 12 Pro software for coding, demonstrated its efficacy. The quantitative methodology via the statistical approach determined the severity of the risk factors. Both approaches (i.e., mixed method) facilitated the establishment of “BIM-RBS Matrix and BIM-RBS-MS Nexus.” Notably, this database systematically categorizes risks inherent across disparate construction stages and proffers targeted management strategies aimed at mitigating their impact.
The theoretical framework developed by [44] was employed to examine the interrelation between the variables. Even though Technology Organization Environment Theory and DeLone and McLean IS Success Model [41] are interchangeable options within the system, it is limited to only the technical and techno-organizational spectrum. LSTM was the preferred theoretical lens in guiding this study. Because not only is it suitable to examine all spectrum but also enabled in measuring the magnitude of the risk factors and to analyze the interrelations of BIM-RBS and BIM-RBS-MS based on its principles (i.e., Equilibrium and Disequilibrium state).
Despite the invaluable insights offered by this study, it is imperative to acknowledge certain inherent limitations. Notably, the absence of data validation through case study approach via interviews and observations involving real-world cases stands out as a constraint. This limitation implies that the robustness of the findings may be subject to the absence of direct engagement with practitioners and stakeholders in real construction scenarios. The reliance on academic publications and the online survey conducted while informative, introduces another potential limitation, as it may not fully capture the complex and dynamic challenges present in actual construction projects. The impact on the validity of the appropriate strategies is an aspect that warrants consideration. Another potential limitation is the small sample size of 60 survey responses, including response bias. Given the differences in life experience between different age groups, as well as people’s changing behavior as they get older. As younger respondents have a higher tendency to leave surveys incomplete due to less experience, while older respondents have a higher interaction while doing the survey. To address these limitations future research endeavors should prioritize larger sample size and validation through case studies via implementation in real-world construction projects. This pragmatic approach not only ensures a more comprehensive understanding but also serves to bridge existing gaps between theoretical propositions and practical applications in the dynamic field of BIM and risk management.
The practical implications of this study are profound. The developed “BIM-RBS Matrix and BIM-RBS-MS Nexus” provides a valuable repository of strategies to assist industry professionals in effectively mitigating associated risks. This repository can serve as a knowledge base and a “check and balance mechanism,” guiding AEC professionals towards a more efficient BIM implementation process from a techno-organizational perspective. Furthermore, as BIM integration continues to evolve, organizations must embrace the flexibility of the BIM-RBS and BIM-RBS-MS Nexus to continually update new strategies, post-implementation ensuring long-term performance monitoring. The potential for generalization and application of the BIM-RBS and BIM-RBS-MS nexus is substantial because its adaptability emphasizes its value for various disciplines involved in BIM-enabled projects—architects during design, contractors throughout construction, and facilities managers during maintenance. For project managers overseeing all stages providing indispensable guidance. Academically, this study expands the research domain by delving into two key knowledge domains such as the techno-organizational aspect which can influence government regulations and guidelines concerning BIM and risk management, shaping their development and implementation. The novel BIM-RBS Matrix and BIM-RBS-MS Nexus composes an exceptional knowledge contribution to the field addressing an important gap, providing new insight, and demonstrating its potential for global impact and applicability via the breakthrough techno-organizational aspect.

4.1. Conclusions

This study of BIM and risk management presented in this paper provided an up to date understanding of challenges and risks involved in BIM-enabled projects due to limited research. Numerous studies were conducted on the single dimensional aspects such as technical, social and organizational aspect etc. however, this research have shown that there is an evident knowledge gap on the two-dimensional aspect such as the techno-organizational spectrum. The integrative review of previous studies undertaken established challenges, barriers and highlight the risk factors implementing the technology. BIM maturity levels leading to the fourth and fifth industrial revolutions represent the era of digitization (i.e., industry 4.0; 5.0). It is upon the AEC industry to transform through these processes (i.e., Construction 5.0 enhancing collaboration between humans and machines) to advance the industry. Making the construction industry more sustainable and improving the working experience. Hence, BIM, Digital twin and AI technologies are at the center to become the key factors. For the transformation of the construction industry to move towards this era it is essential to resolve the risk factors (BIM-RBS) identified in this study related to the techno-organizational spectrum. The integrative approach undertaken enabled the discovery of appropriate management strategies used such as Application Programming Interface (API) to eradicate issues with technological interface among various programs. The critical analysis of the results via the mixed method approach guided by the theoretical framework enabled the establishment of a novel robust BIM-RBS Matrix establishing the risk magnitude and BIM-RBS-MS Nexus to mitigate the risks as a contribution to knowledge that can be used globally by AEC and academic professionals.

4.2. Recommendations

This study highlights a significant gap in existing research, particularly at the intersection of two knowledge domains—BIM-RBS and BIM-RBS-MS. Further exploration in this area is essential, prompting the need to address these issues from a:
  • Socio-organizational Aspect
  • Eco-financial perspective
  • Legal-contractual perspective

Author Contributions

Conceptualization, I.D. and A.E.; methodology, I.D.; software, I.D.; validation, I.D. and A.E.; formal analysis, I.D.; investigation, I.D.; resources, I.D.; data curation, I.D.; writing—original draft preparation, I.D.; writing—review and editing, I.D.; visualization, I.D.; supervision, A.E.; project administration, A.E.; funding acquisition, A.E. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Institutional Review Board Statement

This study was conducted in accordance with the guidelines of the Declaration of Helsinki and was approved by the University of Lincoln Ethics Committee. The research project titled “A Framework for Identifying the Link between BIM-RBS Management Strategies and BIM-RBS Risk Factors” (Review ref. 2021_7067) received a favorable ethical opinion on 17 September 2021.

Data Availability Statement

The authors confirm that the data supporting the findings of this study are available on demand, within the article.

Acknowledgments

This article and the research behind were possible due to the exceptional support of my supervisors. Their enthusiasm, knowledge and exacting attention to detail have been an inspiration and also looked over my transcripts. I am grateful for the perceptive comments they offered. Their expertise has improved this study in innumerable ways.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Duran, Ö.; Elnokly, A. Collaborative Approach to Design: Case-study of Future-Proofing A Paragraph 80 House. In Proceedings of the 18th IBPSA Conference, Shanghai, China, 4–6 September 2023; pp. 1497–1504. [Google Scholar]
  2. Kadume, N.H.; Naji, H.I. Building Schedule Risks Simulation by Using BIM with Monte Carlo Technique. IOP Conf. Ser. Earth Environ. Sci. 2021, 856, 012059. [Google Scholar] [CrossRef]
  3. Khoshfetrat, R.; Sarvari, H.; Chan, D.W.; Rakhshanifar, M. Critical risk factors for implementing building information modelling (BIM): A Delphi-based survey. Int. J. Constr. Manag. 2022, 22, 2375–2384. [Google Scholar] [CrossRef]
  4. Kozlovska, M.; Klosova, D.; Strukova, Z. Impact of Industry 4.0 Platform on the Formation of Construction 4.0 Concept: A Literature Review. Sustainability 2021, 13, 2683. [Google Scholar] [CrossRef]
  5. Zairul, M.; Zaremohzzabieh, Z. Thematic Trends in Industry 4.0 Revolution Potential towards Sustainability in the Construction Industry. Sustainability 2023, 15, 7720. [Google Scholar] [CrossRef]
  6. Li, X.; Jiang, M.; Lin, C.; Chen, R.; Weng, M.; Jim, C.Y. Integrated BIM-IoT platform for carbon emission assessment and tracking in prefabricated building materialization. Resour. Conserv. Recycl. 2025, 215, 108122. [Google Scholar] [CrossRef]
  7. Liu, Z.; Li, M.; Ji, W. Development and application of a digital twin model for Net zero energy building operation and maintenance utilizing BIM-IoT integration. Energy Build. 2025, 328, 115170. [Google Scholar] [CrossRef]
  8. Ahmad, D.M.; Gáspár, L.; Maya, R.A. Optimizing Sustainability in Bridge Projects: A Framework Integrating Risk Analysis and BIM with LCSA According to ISO Standards. Appl. Sci. 2025, 15, 383. [Google Scholar] [CrossRef]
  9. Alreshidi, E.; Mourshed, M.; Rezgui, Y. Requirements for cloud-based BIM governance solutions to facilitate team collaboration in construction projects. Requir. Eng. 2018, 23, 1–31. [Google Scholar] [CrossRef]
  10. Zou, Y.; Kiviniemi, A.; Jones, S.W. Developing a tailored RBS linking to BIM for risk management of bridge projects. Eng. Constr. Archit. Manag. 2016, 23, 727–750. [Google Scholar] [CrossRef]
  11. Elshabshiri, A.; Ghanim, A.; Hussien, A.; Maksoud, A.; Mushtaha, E. Integration of Building Information Modelling and Digital Twins in the Operation and Maintenance of a Building Lifecycle: A Bibliometric Analysis Review. J. Build. Eng. 2025, 99, 111541. [Google Scholar] [CrossRef]
  12. Ismail, N.H.; Kamal, E.M.; Fizal, M.F. A Systematic Literature Review: Implementing Building Information Modelling (BIM) for TVET Educators in Malaysia. J. Adv. Res. Appl. Sci. Eng. Technol. 2025, 49, 194–210. [Google Scholar] [CrossRef]
  13. Pavón, R.M.; Alberti, M.G.; Álvarez, A.A.A.; Cepa, J.J. Bim-based Digital Twin development for university Campus management. Case study ETSICCP. Expert Syst. Appl. 2025, 262, 125696. [Google Scholar] [CrossRef]
  14. Huan, X.; Kang, B.G.; Xie, J.; Hancock, C. Building Information Modelling (BIM)-enabled Facility Management (FM) of Nursing Homes in China: A Systematic Review. J. Build. Eng. 2025, 99, 111580. [Google Scholar] [CrossRef]
  15. He, Z.; Wang, Y.H.; Zhang, J. Generative AIBIM: An automatic and intelligent structural design pipeline integrating BIM and generative AI. Inf. Fusion 2025, 114, 102654. [Google Scholar] [CrossRef]
  16. Okika, M.C.; Vermeulen, A.; Pretorius, J.H.C. A Systematic Approach to Identify and Manage Interface Risks between Project Stakeholders in Construction Projects. CivilEng 2024, 5, 89–118. [Google Scholar] [CrossRef]
  17. Ranjbar, A.A.; Ansari, R.; Taherkhani, R.; Hosseini, M.R. Developing a novel cash flow risk analysis framework for construction projects based on 5D BIM. J. Build. Eng. 2021, 44, 103341. [Google Scholar] [CrossRef]
  18. Yasser, M.; Rashid, I.A.; Nagy, A.M.; Elbehairy, H.S. Integrated model for BIM and risk data in construction projects. Eng. Res. Express 2022, 4, 045044. [Google Scholar] [CrossRef]
  19. Szymański, P. Risk management in construction projects. Procedia Eng. 2017, 208, 174–182. [Google Scholar] [CrossRef]
  20. Mirzaei-Zohan, S.A.; Gheibi, M.; Chahkandi, B.; Mousavi, S.; Khaksar, R.Y.; Behzadian, K. A new integrated agent-based framework for designing building emergency evacuation: A BIM approach. Int. J. Disaster Risk Reduct. 2023, 93, 103753. [Google Scholar] [CrossRef]
  21. Chenya, L.; Aminudin, E.; Mohd, S.; Yap, L.S. Intelligent risk management in construction projects: Systematic Literature Review. IEEE Access 2022, 10, 72936–72954. [Google Scholar] [CrossRef]
  22. Mat Ya’acob, I.A.; Mohd Rahim, F.A.; Zainon, N. Risk in Implementing Building Information Modelling (BIM) in Malaysia Construction Industry: A Review. E3S Web Conf. 2018, 65, 03002. [Google Scholar] [CrossRef]
  23. Górecki, J. Big Data as a Project Risk Management Tool. In Risk Management Treatise for Engineering Practitioners; IntechOpen: London, UK, 2018; pp. 26–49. [Google Scholar]
  24. Lee, P.C.; Wei, J.; Ting, H.I.; Lo, T.P.; Long, D.; Chang, L.M. Dynamic Analysis of Construction Safety Risk and Visual Tracking of Key Factors based on Behaviour-based Safety and Building Information Modelling. KSCE J. Civ. Eng. 2019, 23, 4155–4167. [Google Scholar] [CrossRef]
  25. Zou, Y.; Kiviniemi, A.; Jones, S.W. A review of risk management through BIM and BIM-related technologies. Saf. Sci. 2017, 97, 88–98. [Google Scholar] [CrossRef]
  26. Ganbat, T.; Chong, H.; Liao, P.; Wu, Y. A Bibliometric Review on Risk Management and Building Information Modelling for International Construction. Adv. Civ. Eng. 2018, 2018, 8351679. [Google Scholar] [CrossRef]
  27. Hartmann, T.; van Meerveld, H.; Vossebeld, N.; Adriaanse, A. Aligning building information model tools and construction management methods. Autom. Constr. 2012, 22, 605–613. [Google Scholar] [CrossRef]
  28. Zhao, X.; Wu, P.; Wang, X. Risk paths in BIM adoption: Empirical study of China. Eng. Constr. Archit. Manag. 2018, 25, 1170–1187. [Google Scholar] [CrossRef]
  29. Matthews, J.; Love, P.E.D.; Mewburn, J.; Stobaus, C.; Ramanayaka, C. Building information modelling in construction: Insights from collaboration and change management perspectives. Prod. Plan. Control 2018, 29, 202–216. [Google Scholar] [CrossRef]
  30. Hooper, M.; Ekholm, A. A BIM-Info delivery protocol. Australas. J. Constr. Econ. Build. 2012, 12, 39–52. [Google Scholar] [CrossRef]
  31. Azhar, S. Building Information Modelling (BIM): Trends, Benefits, Risks, and Challenges for the AEC Industry. Leadersh. Manag. Eng. 2011, 11, 241–252. [Google Scholar] [CrossRef]
  32. Dossick, C.S.; Neff, G. Organizational Divisions in BIM-Enabled Commercial Construction. J. Constr. Eng. Manag. 2010, 136, 459–467. [Google Scholar] [CrossRef]
  33. Ku DDES, K.; Taiebat, M. BIM Experiences and Expectations: The Constructors’ Perspective. J. Constr. Educ. Res. 2011, 7, 175–197. [Google Scholar]
  34. Tomek, A.; Matejka, P. The impact of BIM on risk management as an argument for its implementation in a construction company. Procedia Eng. 2014, 85, 501–509. [Google Scholar] [CrossRef]
  35. Beach, T.; Petri, I.; Rezgui, Y.; Rana, O. Management of Collaborative BIM Data by Federating Distributed BIM Models. J. Comput. Civ. Eng. 2017, 31, 04017009. [Google Scholar] [CrossRef]
  36. Mahamadu, A.-M.; Mahdjoubi, L.; Booth, C.; Manu, P.; Manu, E. Building information modelling (BIM) capability and delivery success on construction projects. Constr. Innov. 2019, 19, 170–192. [Google Scholar] [CrossRef]
  37. Yanda, G.; Amin, M.; Soehari, T.D. Investment, Returns, and Risk of Building Information Modelling (BIM) Implementation in Indonesia’s Construction Project. Int. J. Eng. Adv. Technol. 2019, 9, 5159–5166. [Google Scholar] [CrossRef]
  38. Maskil-Leitan, R.; Gurevich, U.; Reychav, I. BIM management measure for an effective green building project. Buildings 2020, 10, 147. [Google Scholar] [CrossRef]
  39. Creswell, W.J. Research Design: Qualitative, Quantitative and Mixed Methods Approaches, 2nd ed.; Sage: Thousand Oaks, CA, USA, 2003. [Google Scholar]
  40. Khosrowshahi, F.; Arayici, Y. Roadmap for implementation of BIM in the UK construction industry. Eng. Constr. Archit. Manag. 2012, 19, 610–635. [Google Scholar] [CrossRef]
  41. DeLone, W.H.; McLean, E.R. The DeLone and McLean Model of Information Systems Success: A Ten-Year Update. J. Manag. Inf. Syst. 2003, 19, 9–30. [Google Scholar]
  42. Leavitt, H.J. Applied organization change in industry: Structural, technical and human approaches. In New Perspectives in Organizational Research; Cooper, W.W., Leavitt, H.J., Shelly, M.W., Eds.; John Wiley: New York, NY, USA, 1964; pp. 55–71. [Google Scholar]
  43. Merschbrock, C.; Hosseini, M.; Martek, I.; Arashpour, M.; Mignone, G. Collaborative Role of Sociotechnical Components in BIM-Based Construction Networks in Two Hospitals. Am. Soc. Civ. Eng. 2018, 34, 05018006. [Google Scholar] [CrossRef]
  44. Elnokaly, A.; Dogonyaro, I. Framework to assess connection of risk factors and management strategies in Building Information Modelling. Acad. Eng. 2024, 1, 1–20. [Google Scholar] [CrossRef]
  45. Grant, C.; Osanloo, A. Understanding, selecting, and integrating a theoretical framework in dissertation research: Creating the blueprint for your “House”. Adm. Issues J. 2014, 4, 12–26. [Google Scholar] [CrossRef]
  46. Kivunja, C. Distinguishing between Theory, Theoretical Framework, and Conceptual Framework: A Systematic Review of Lessons from the Field. Int. J. High. Educ. 2018, 7, 44–53. [Google Scholar] [CrossRef]
  47. Sackey, E.; Tuuli, M.; Dainty, A. Sociotechnical systems approach to BIM implementation in a multidisciplinary construction context. J. Manag. Eng. 2015, 31, A4014005. [Google Scholar] [CrossRef]
  48. Oraee, M.; Hosseini, M.R.; Papadonikolaki, E.; Palliyaguru, R.; Arashpour, M. Collaboration in BIM-based construction networks: A bibliometric-qualitative literature review. Int. J. Proj. Manag. 2017, 35, 1288–1301. [Google Scholar] [CrossRef]
  49. Klein, G.; Müller, R. Literature Review Expectations of Project Management Journal®. Proj. Manag. J. 2020, 51, 239–241. [Google Scholar] [CrossRef]
  50. Succar, B.; Sher, W.; Williams, A. Measuring BIM performance: Five metrics. Archit. Eng. Des. Manag. 2012, 8, 120–142. [Google Scholar] [CrossRef]
  51. Akhtar, D.M.I. Research design. In Research in Social Science: Interdisciplinary Perspectives; Social Research Foundation: Kanpur, India, 2016; pp. 68–84. [Google Scholar]
  52. Zhao, X.; Feng, Y.; Pienaar, J.; O’Brien, D. Modelling paths of risks associated with BIM implementation in architectural, engineering and construction projects. Archit. Sci. Rev. 2017, 60, 472–482. [Google Scholar] [CrossRef]
  53. Aksenova, G.; Kiviniemi, A.; Kocaturk, T.; Lejeune, A. From Finnish AEC knowledge ecosystem to business ecosystem: Lessons learned from the national deployment of BIM. Constr. Manag. Econ. 2019, 37, 317–335. [Google Scholar] [CrossRef]
  54. Dhakal, K. NVivo. J. Med. Libr. Assoc. 2022, 110, 270–272. [Google Scholar] [CrossRef] [PubMed]
  55. Blay, K.B.; Tuuli, M.M.; France-Mensah, J. Managing change in BIM-Level 2 projects: Benefits, challenges, and opportunities. Built Environ. Proj. Asset Manag. 2019, 9, 581–596. [Google Scholar] [CrossRef]
  56. Poirier, A.; Forgues, D.; Staub-French, S. Understanding the impact of BIM on collaboration: A Canadian case study. Build. Res. Inf. 2017, 45, 681–695. [Google Scholar] [CrossRef]
  57. Ding, L.; Zhong, B.; Wu, S.; Luo, H. Construction risk knowledge management in BIM using ontology and semantic web technology. Saf. Sci. 2016, 87, 202–213. [Google Scholar] [CrossRef]
  58. Imoudu Enegbuma, W.; Godwin Aliagha, U.; Nita Ali, K. Preliminary building information modelling adoption model in Malaysia: A strategic information technology perspective. Constr. Innov. 2014, 14, 408–432. [Google Scholar] [CrossRef]
  59. Oyedele, L.O.; Regan, M.; von Meding, J.; Ahmed, A.; Ebohon, O.J.; Elnokaly, A. Reducing waste to landfill in the UK: Identifying impediments and critical solutions. World J. Sci. Technol. Sustain. Dev. 2013, 10, 131–142. [Google Scholar] [CrossRef]
  60. Feist, S.; Ferreira, B.; Leitão, A. Collaborative algorithmic-based building information modelling. Protocols, Flows and Glitches. In Proceedings of the 22nd International Conference of the Association for Computer-Aided Architectural Design Research in Asia (CAADRIA), Suzhou, China, 5–8 April 2017; pp. 613–623. [Google Scholar]
  61. Chien, K.-F.; Wu, Z.-H.; Huang, S.-C. Identifying and assessing critical risk factors for BIM projects: Empirical study. Autom. Constr. 2014, 45, 1–15. [Google Scholar] [CrossRef]
  62. Cohen, L.; Manion, L.; Morrison, K. Research Methods in Education; Routledge: London, UK, 2018. [Google Scholar]
  63. Ali, K.N.; Alhajlah, H.H.; Kassem, M.A. Collaboration and risk in building information modelling (BIM): A systematic literature review. Buildings 2022, 12, 571. [Google Scholar] [CrossRef]
  64. Ganbat, T.; Chong, H.-Y.; Liao, P.-C.; Lee, C.-Y. A Cross-Systematic Review of Addressing Risks in Building Information Modelling-Enabled International Construction Projects. Arch. Comput. Methods Eng. 2019, 26, 899–931. [Google Scholar] [CrossRef]
  65. Georgiadou, M. An overview of benefits and challenges of building information modelling (BIM) adoption in UK residential projects. Constr. Innov. 2019, 19, 298–320. [Google Scholar] [CrossRef]
  66. Pu, L.; Wang, Y. The combination of BIM technology with the whole life cycle of green building. World J. Eng. Technol. 2021, 9, 604–613. [Google Scholar] [CrossRef]
  67. Waqar, A.; Qureshi, A.H.; Alaloul, W.S. Barriers to building information modelling (BIM) deployment in small construction projects: Malaysian construction industry. Sustainability 2023, 15, 2477. [Google Scholar] [CrossRef]
  68. Zou, Y.; Kiviniemi, A.; Jones, S.; Walsh, J. Risk Information Management for Bridges by Integrating Risk Breakdown Structure into 3D/4D BIM. KSCE J. Civ. Eng. 2019, 23, 467–480. [Google Scholar] [CrossRef]
  69. Ahmad, D.M.; Gáspár, L.; Bencze, Z.; Maya, R.A. The Role of BIM in Managing Risks in Sustainability of Bridge Projects: A Systematic Review with Meta-Analysis. Sustainability 2024, 16, 1242. [Google Scholar] [CrossRef]
  70. Sani, M.J.; Abdul Rahman, A. GIS and BIM integration at data level: A review. Int. Arch. Photogramm. Remote Sens. Spat. Inf. Sci. 2018, 42, 299–306. [Google Scholar] [CrossRef]
  71. Tabejamaat, S.; Ahmadi, H.; Barmayehvar, B. Boosting large-scale construction project risk management: Application of the impact of building information modelling, knowledge management, and sustainable practices for optimal productivity. Energy Sci. Eng. 2024, 12, 2284–2296. [Google Scholar] [CrossRef]
  72. Wang, G.; Song, J. The relation of perceived benefits and organizational supports to user satisfaction with building information model (BIM). Comput. Hum. Behav. 2017, 68, 493–500. [Google Scholar] [CrossRef]
  73. Yitmen, I.; Almusaed, A.; Alizadehsalehi, S. Facilitating Construction 5.0 for smart, sustainable and resilient buildings: Opportunities and challenges for implementation. Smart Sustain. Built Environ. 2024. Available online: https://www.emerald.com/insight/2046-6099.htm (accessed on 20 February 2025). [CrossRef]
  74. Bensalah, M.; Elouadi, A.; Mharzi, H. Overview: The opportunity of BIM in railway. Smart Sustain. Built Environ. 2019, 8, 103–116. [Google Scholar] [CrossRef]

Figure 1. The Blueprint: Research methods and theoretical perspective [44].
Figure 1. The Blueprint: Research methods and theoretical perspective [44].
Iic 01 00005 g001

Figure 2. Research Design (Author’s own).
Figure 2. Research Design (Author’s own).
Iic 01 00005 g002

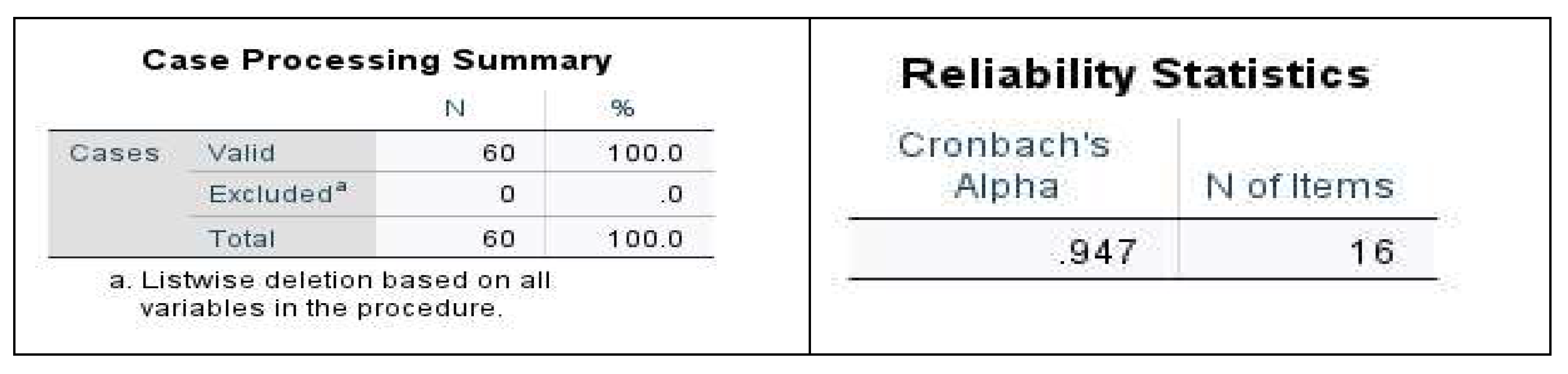

Figure 3. The Cronbach’s Alpha test results [62].
Figure 3. The Cronbach’s Alpha test results [62].
Iic 01 00005 g003

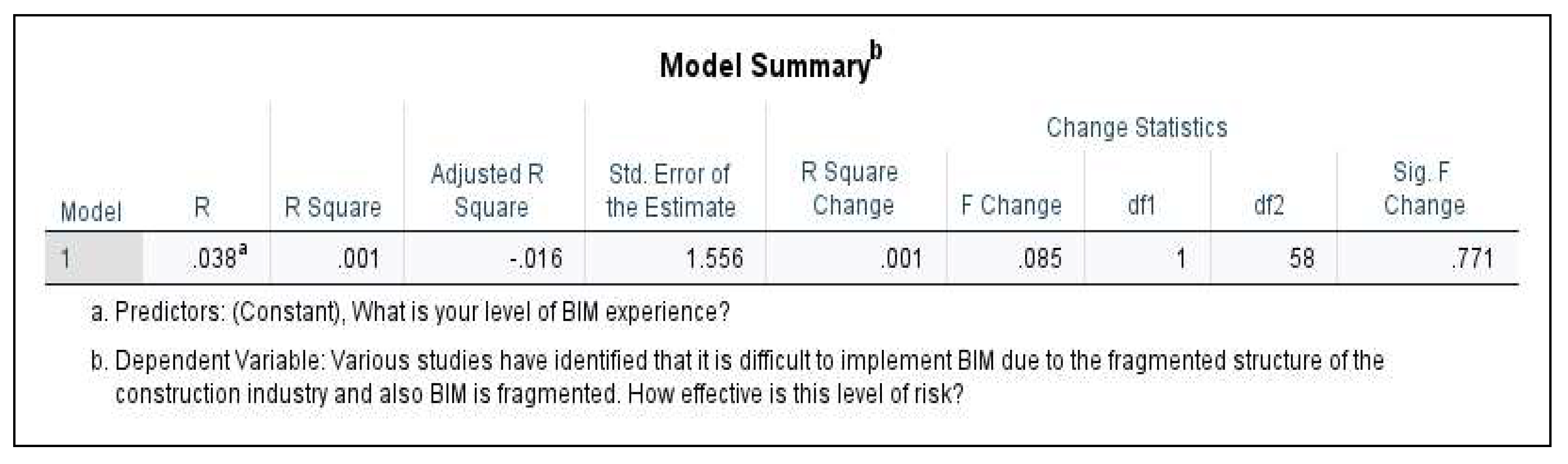

Figure 4. The Model Summary results (SPSS).
Figure 4. The Model Summary results (SPSS).
Iic 01 00005 g004

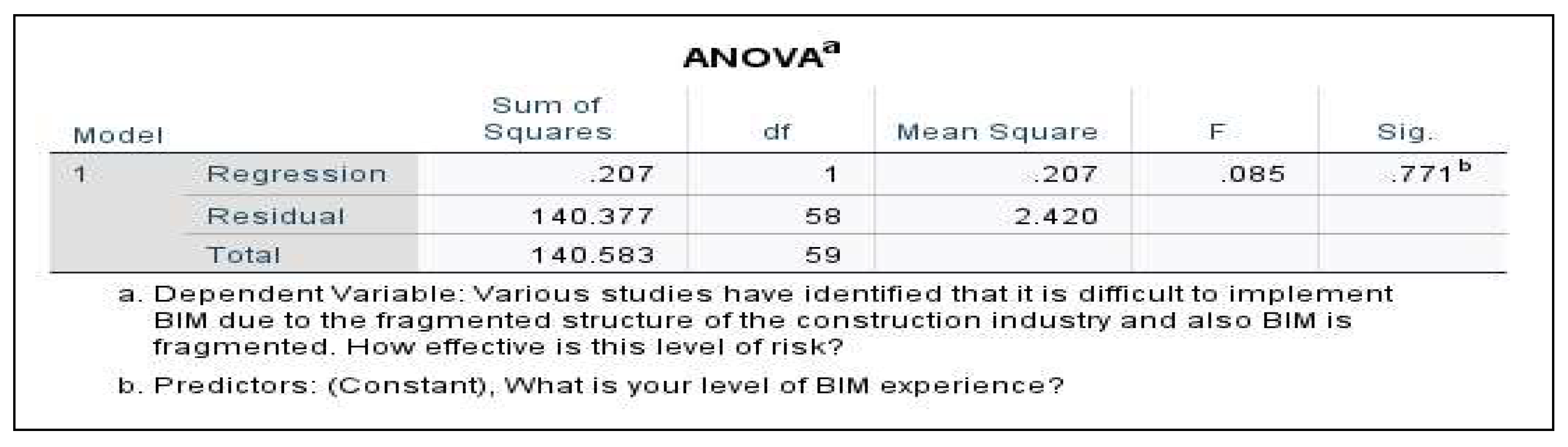

Figure 5. The Anova results (SPSS).
Figure 5. The Anova results (SPSS).
Iic 01 00005 g005

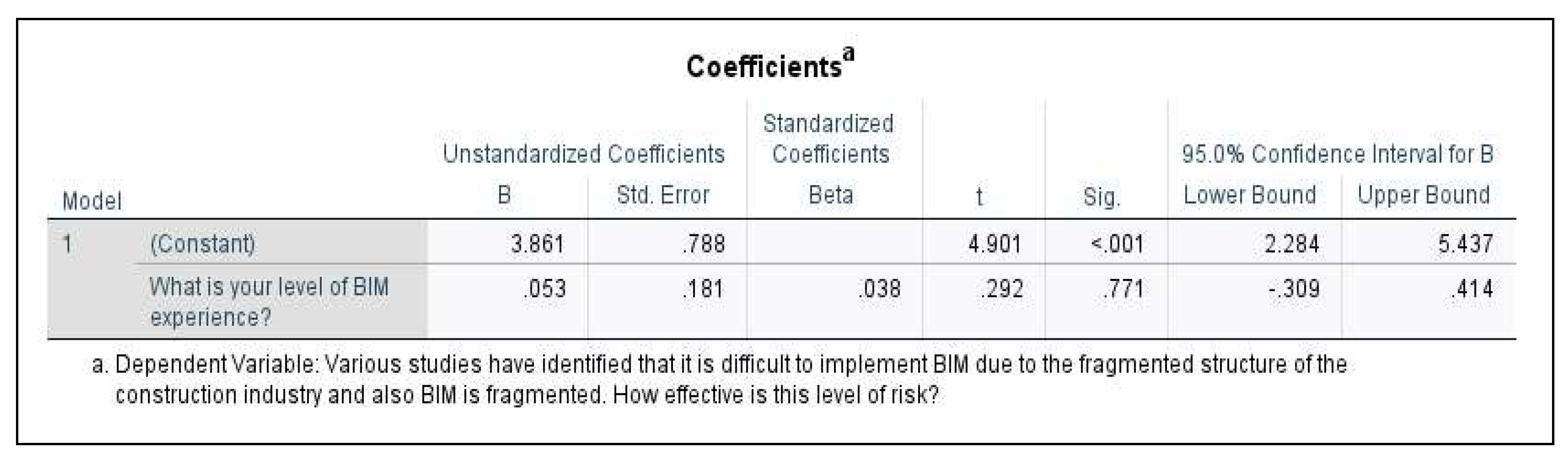

Figure 6. The Coefficients results (SPSS).
Figure 6. The Coefficients results (SPSS).
Iic 01 00005 g006

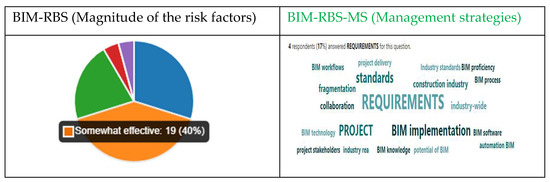

Figure 7. BIM and construction industry fragmentation risk magnitude and strategies.
Figure 7. BIM and construction industry fragmentation risk magnitude and strategies.
Iic 01 00005 g007

Figure 8. Magnitude of risk integrating BIM components and strategies.
Figure 8. Magnitude of risk integrating BIM components and strategies.
Iic 01 00005 g008

Figure 9. Risk magnitude of misalignment between IT and organizational strategies.
Figure 9. Risk magnitude of misalignment between IT and organizational strategies.
Iic 01 00005 g009

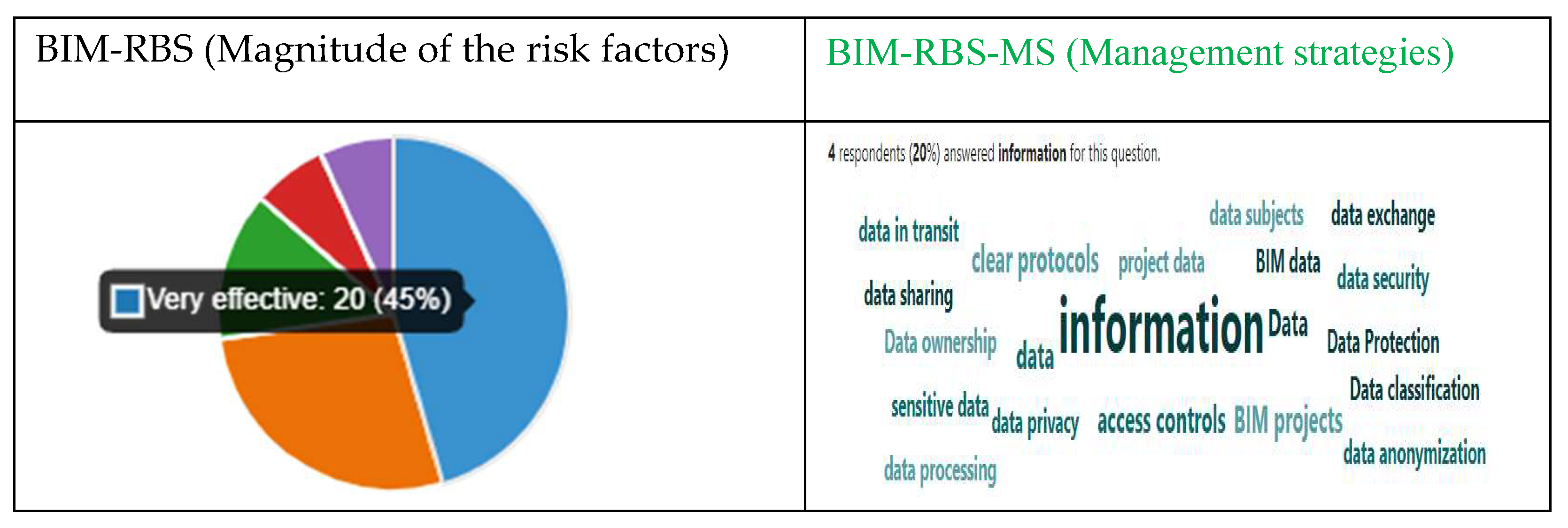

Figure 10. Risk magnitude of external storage data security and strategies.
Figure 10. Risk magnitude of external storage data security and strategies.
Iic 01 00005 g010

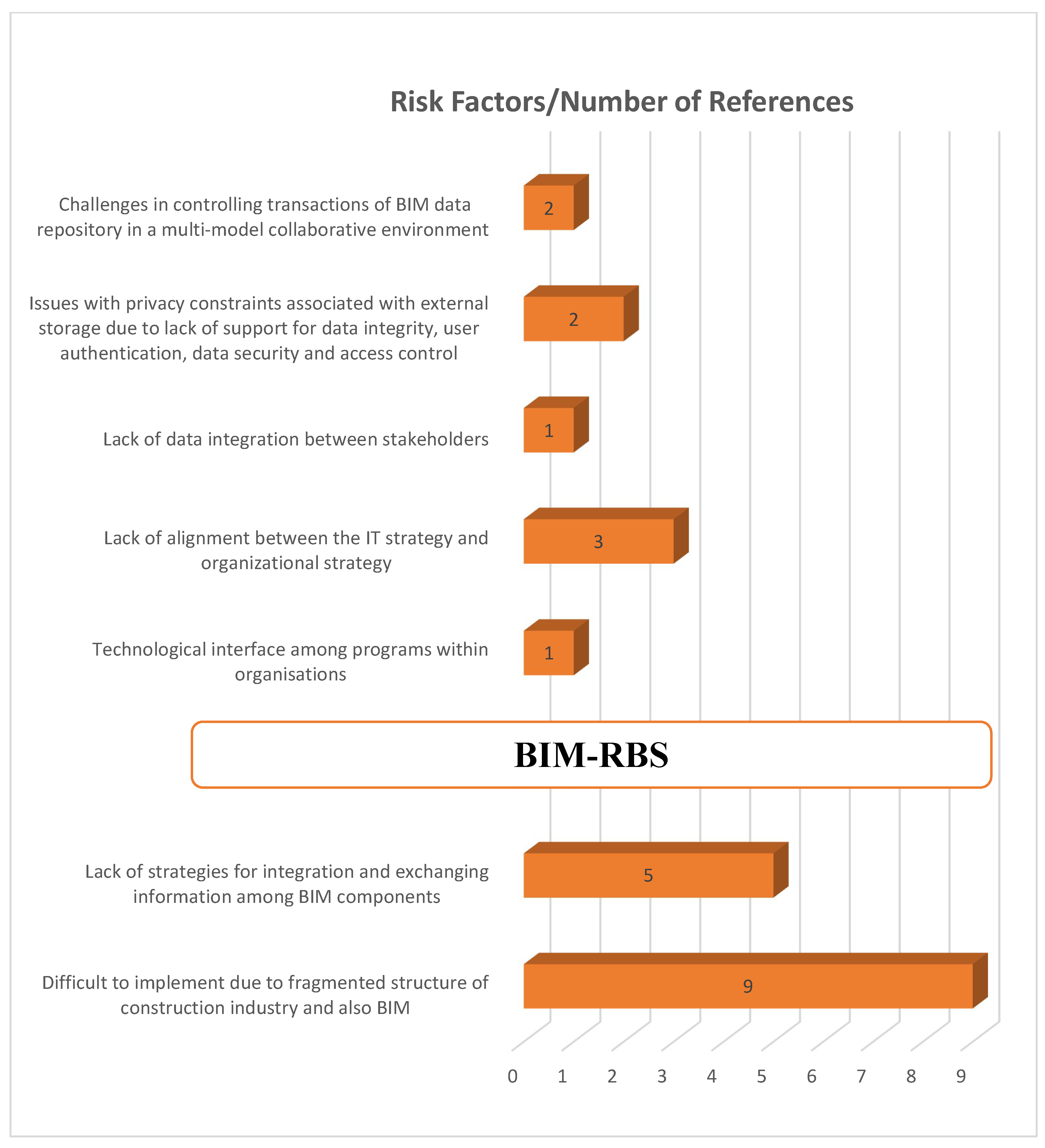

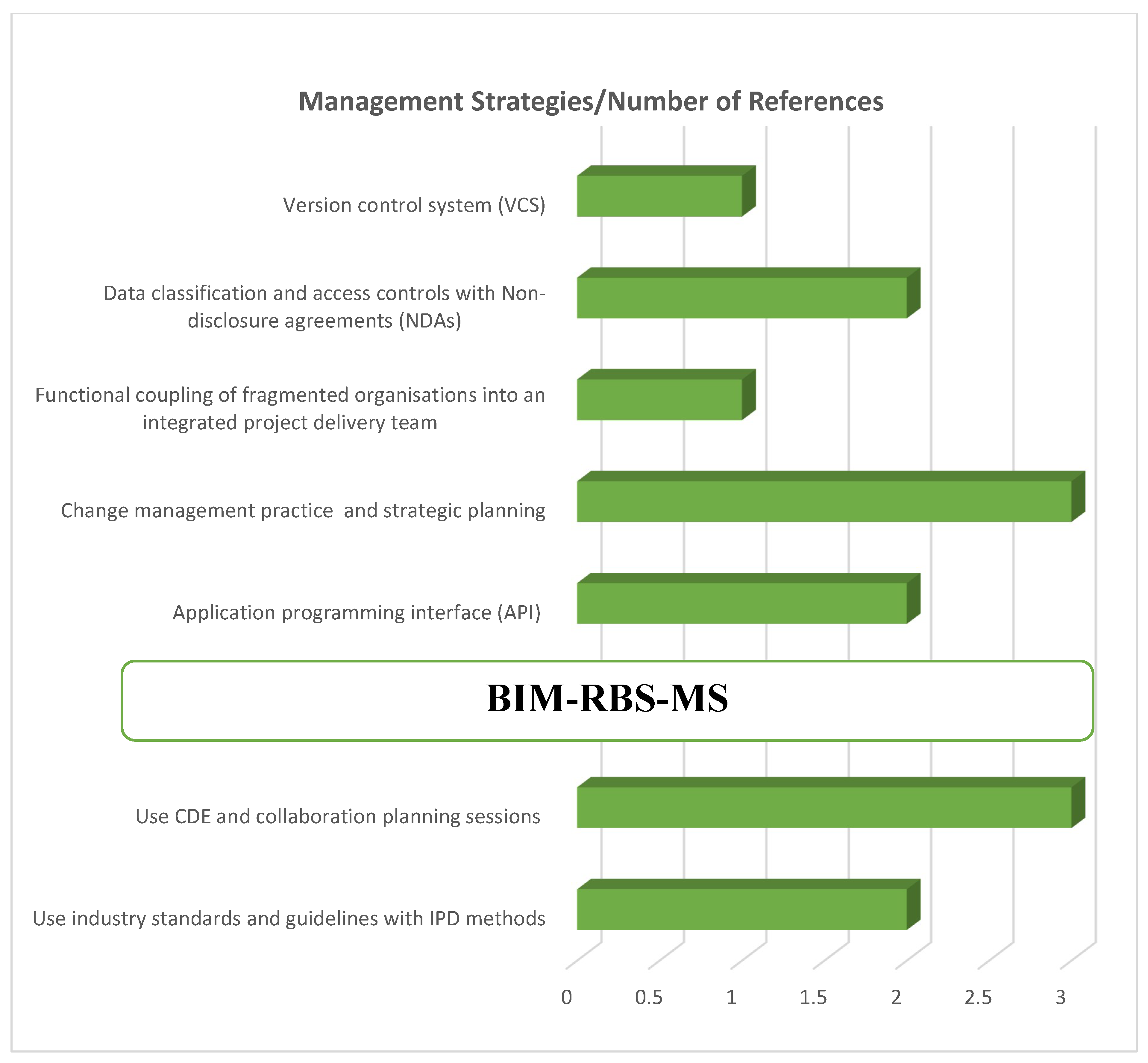

Figure 11. Techno-organizational Aspect BIM-RBS and BIM-RBS-MS Nexus 2000–2025 (Author’s own).
Figure 11. Techno-organizational Aspect BIM-RBS and BIM-RBS-MS Nexus 2000–2025 (Author’s own).
Iic 01 00005 g011aIic 01 00005 g011b
Table 1. Techno-organizational Aspect BIM-RBS Matrix.
Table 1. Techno-organizational Aspect BIM-RBS Matrix.
Techno-Organisational AspectMagnitude of Risk Factors
Severity→Very Low RiskLow RiskMedium RiskHigh RiskVery High Risk
Difficult to implement due to fragmented structure of construction industry and also BIM44214030
Lack of strategies for integration and exchanging information among BIM components146162439
Lack of alignment between the IT strategy and organizational strategy68232933
Privacy constraints associated with external storage77142745
Average (%)7.756.2518.53036.75
LSTMEquilibrium state<<<<<<<<
>>>>>>>>
Disequilibrium state
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Dogonyaro, I.; Elnokaly, A. Strategies to Mitigate Risks in Building Information Modelling Implementation: A Techno-Organizational Perspective. Intell. Infrastruct. Constr. 2025, 1, 5. https://doi.org/10.3390/iic1020005

AMA Style

Dogonyaro I, Elnokaly A. Strategies to Mitigate Risks in Building Information Modelling Implementation: A Techno-Organizational Perspective. Intelligent Infrastructure and Construction. 2025; 1(2):5. https://doi.org/10.3390/iic1020005

Chicago/Turabian Style

Dogonyaro, Ibrahim, and Amira Elnokaly. 2025. "Strategies to Mitigate Risks in Building Information Modelling Implementation: A Techno-Organizational Perspective" Intelligent Infrastructure and Construction 1, no. 2: 5. https://doi.org/10.3390/iic1020005

APA Style

Dogonyaro, I., & Elnokaly, A. (2025). Strategies to Mitigate Risks in Building Information Modelling Implementation: A Techno-Organizational Perspective. Intelligent Infrastructure and Construction, 1(2), 5. https://doi.org/10.3390/iic1020005

Article Metrics

Back to TopTop
