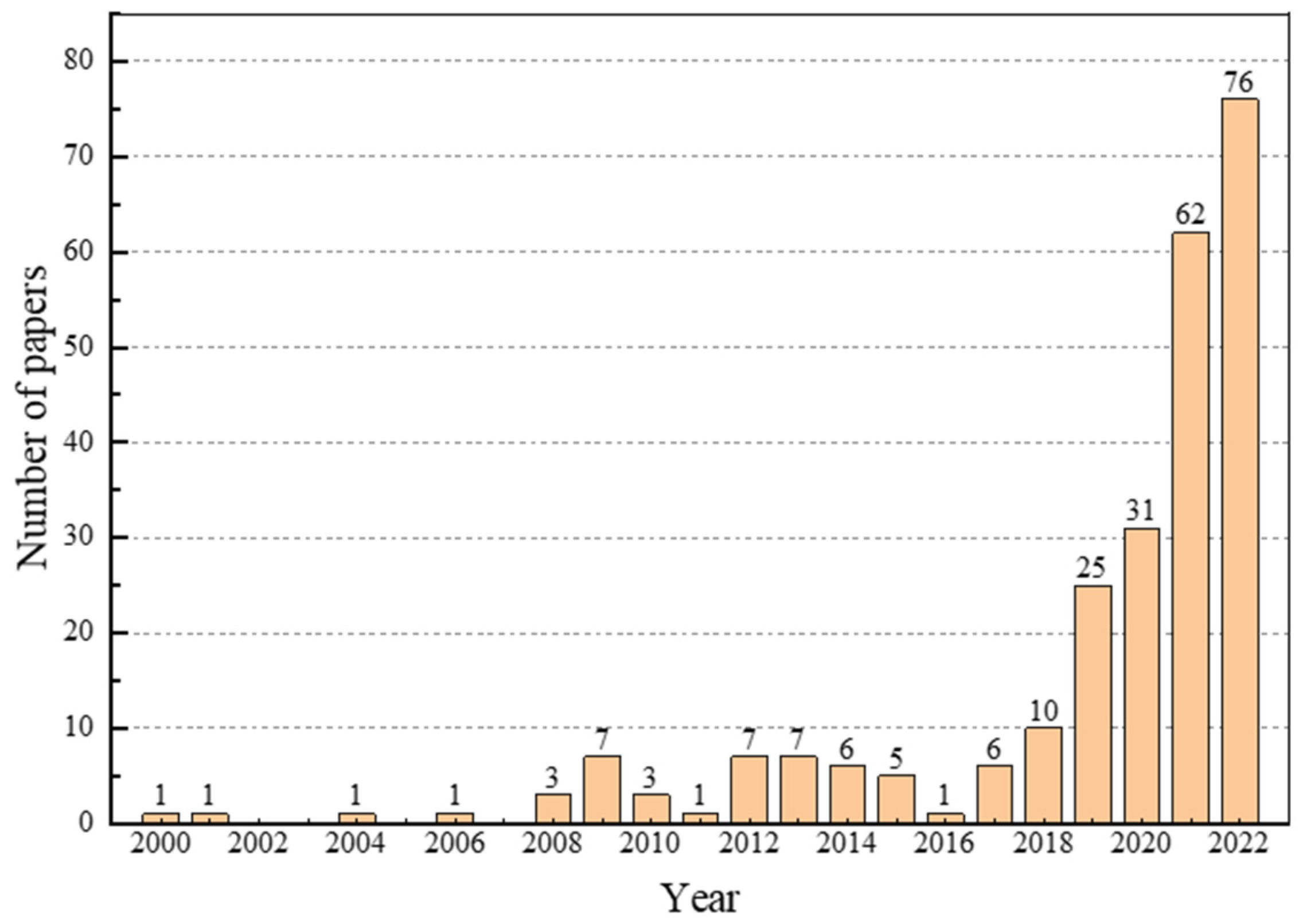

Applications of Machine Learning in Mechanised Tunnel Construction: A Systematic Review
Abstract
:1. Introduction

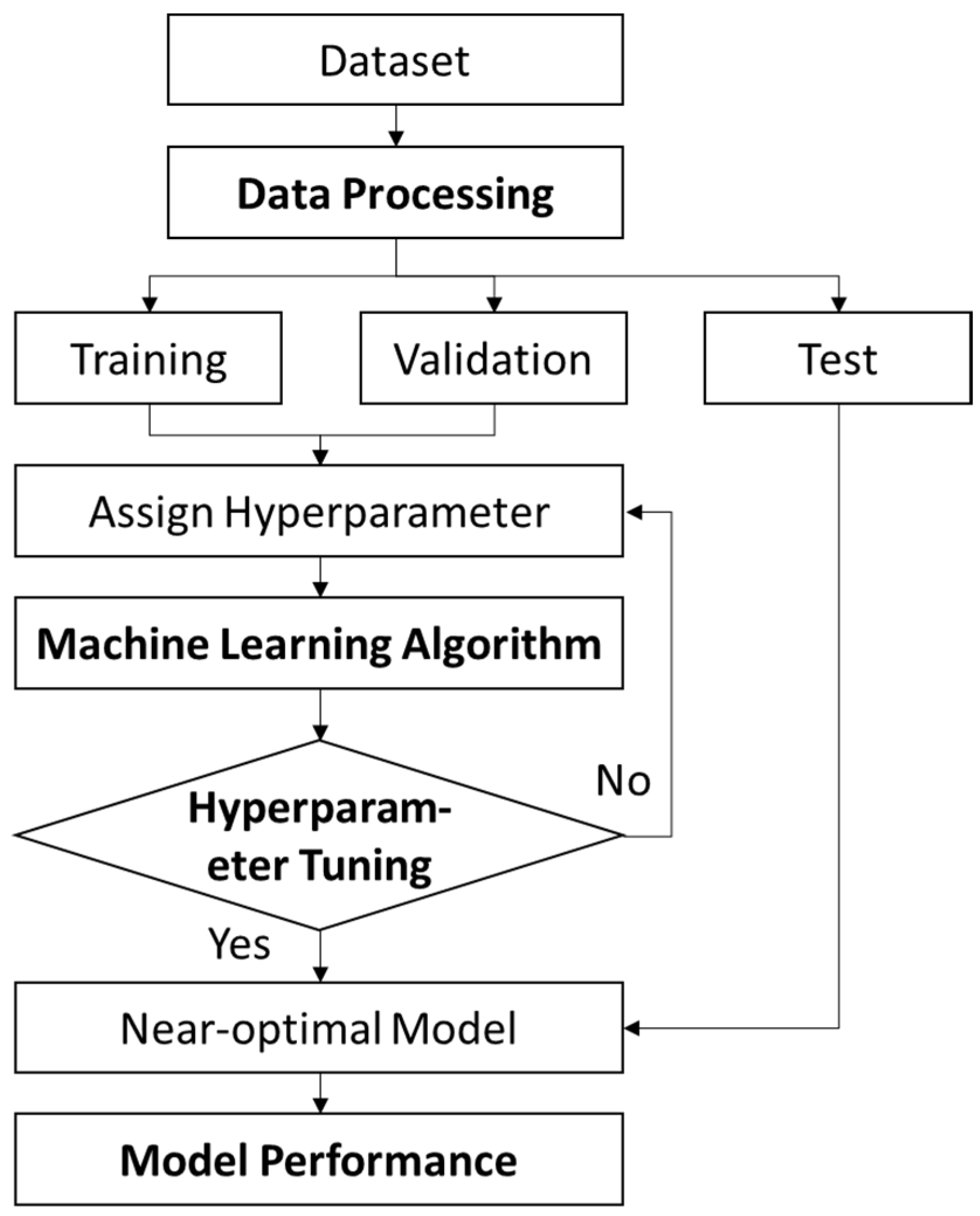

2. Machine Learning Modelling
2.1. Data Processing
2.2. Machine Learning Algorithms
2.3. Hyperparameter Tuning
2.4. Evaluation Metrics

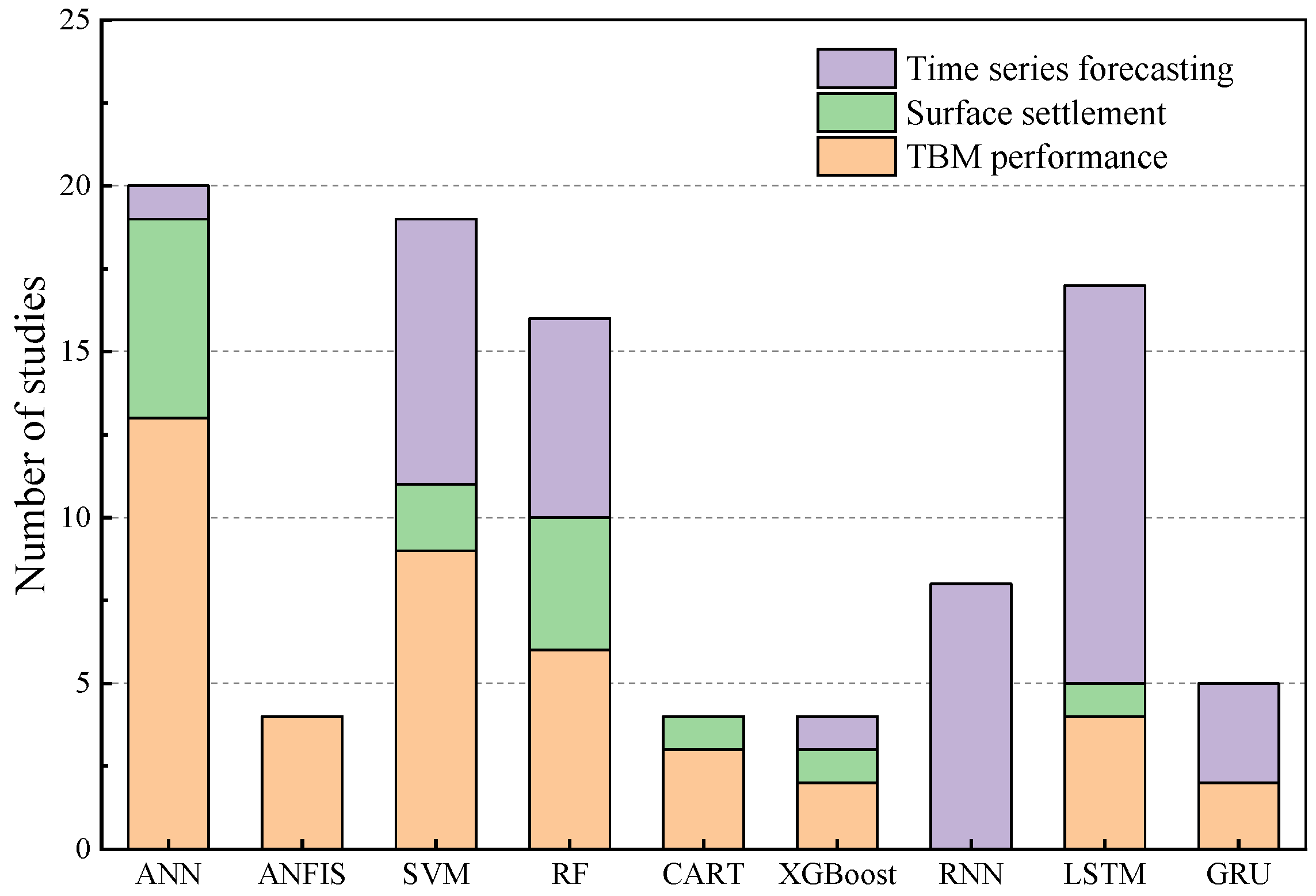

3. Application in TBM Tunnelling
3.1. TBM Performance
3.2. Surface Settlement
3.3. Time Series Forecasting
4. Summary and Perspectives
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
Abbreviations
TBM | Tunnel boring machine |
ML | Machine learning |
PR | Penetration rate |
AR | Advance rate |
FPI | Field penetration index |
TH | Thrust force |
TO | Cutterhead torque |
Smax | Maximum surface settlement |
PCA | Principal component analysis |
PCC | Pearson correlation coefficient |
ANN | Artificial neural network |
CNN | Convolutional neural network |
RNN | Recurrent neural network |
LSTM | Long short-term memory |
GRU | Gated recurrent unit |
FL | Fuzzy logic |
ANIFS | Adaptive neuro-fuzzy inference system |
SVM | Support vector machine |
DT | Decision tree |
RF | Random forest |
CART | Classification and regression tree |
XGBoost | Extreme gradient boosting |
PSO | Particle swarm optimisation |
BO | Bayesian optimisation |
ICA | Imperialism competitive algorithm |
References
- Adoko, A.C.; Gokceoglu, C.; Yagiz, S. Bayesian prediction of TBM penetration rate in rock mass. Eng. Geol. 2017, 226, 245–256. [Google Scholar] [CrossRef]
- Li, J.; Li, P.; Guo, D.; Li, X.; Chen, Z. Advanced prediction of tunnel boring machine performance based on big data. Geosci. Front. 2021, 12, 331–338. [Google Scholar] [CrossRef]
- Yang, H.; Wang, Z.; Song, K. A new hybrid grey wolf optimizer-feature weighted-multiple kernel-support vector regression technique to predict TBM performance. Eng. Comput. 2022, 38, 2469–2485. [Google Scholar] [CrossRef]
- Ozdemir, L. Development of Theoretical Equations for Predicting Tunnel Boreability; Colorado School of Mines: Golden, CO, USA, 1977. [Google Scholar]
- Rostami, J. Development of a Force Estimation Model for Rock Fragmentation with Disc Cutters through Theoretical Modeling and Physical Measurement of Crushed Zone Pressure; Colorado School of Mines: Golden, CO, USA, 1997. [Google Scholar]
- Barton, N.R. TBM Tunnelling in Jointed and Faulted Rock; Crc Press: Boca Raton, FL, USA, 2000. [Google Scholar]
- Bruland, A. Hard Rock Tunnel Boring. Ph.D. Thesis, Norwegian University of Science and Technology, Trondheim, Norway, 1998. [Google Scholar]
- Yagiz, S. Utilizing rock mass properties for predicting TBM performance in hard rock condition. Tunn. Undergr. Space Technol. 2008, 23, 326–339. [Google Scholar] [CrossRef]
- Shreyas, S.; Dey, A. Application of soft computing techniques in tunnelling and underground excavations: State of the art and future prospects. Innov. Infrastruct. Solut. 2019, 4, 46. [Google Scholar] [CrossRef]
- Shahrour, I.; Zhang, W. Use of soft computing techniques for tunneling optimization of tunnel boring machines. Undergr. Space 2021, 6, 233–239. [Google Scholar] [CrossRef]
- Sheil, B.B.; Suryasentana, S.K.; Mooney, M.A.; Zhu, H. Machine learning to inform tunnelling operations: Recent advances and future trends. Proc. Inst. Civ. Eng. -Smart Infrastruct. Constr. 2020, 173, 74–95. [Google Scholar]
- Li, J.-B.; Chen, Z.-Y.; Li, X.; Jing, L.-J.; Zhangf, Y.-P.; Xiao, H.-H.; Wang, S.-J.; Yang, W.-K.; Wu, L.-J.; Li, P.-Y. Feedback on a shared big dataset for intelligent TBM Part I: Feature extraction and machine learning methods. Undergr. Space 2023, 11, 1–25. [Google Scholar] [CrossRef]
- Feng, S.; Chen, Z.; Luo, H.; Wang, S.; Zhao, Y.; Liu, L.; Ling, D.; Jing, L. Tunnel boring machines (TBM) performance prediction: A case study using big data and deep learning. Tunn. Undergr. Space Technol. 2021, 110, 103636. [Google Scholar] [CrossRef]
- Xu, C.; Liu, X.; Wang, E.; Wang, S. Prediction of tunnel boring machine operating parameters using various machine learning algorithms. Tunn. Undergr. Space Technol. 2021, 109, 103699. [Google Scholar] [CrossRef]
- Hou, S.; Liu, Y.; Yang, Q. Real-time prediction of rock mass classification based on TBM operation big data and stacking technique of ensemble learning. J. Rock Mech. Geotech. Eng. 2022, 14, 123–143. [Google Scholar] [CrossRef]
- Wu, Z.; Wei, R.; Chu, Z.; Liu, Q. Real-time rock mass condition prediction with TBM tunneling big data using a novel rock–machine mutual feedback perception method. J. Rock Mech. Geotech. Eng. 2021, 13, 1311–1325. [Google Scholar] [CrossRef]
- Shen, S.-L.; Elbaz, K.; Shaban, W.M.; Zhou, A. Real-time prediction of shield moving trajectory during tunnelling. Acta Geotech. 2022, 17, 1533–1549. [Google Scholar] [CrossRef]
- Sun, W.; Shi, M.; Zhang, C.; Zhao, J.; Song, X. Dynamic load prediction of tunnel boring machine (TBM) based on heterogeneous in-situ data. Autom. Constr. 2018, 92, 23–34. [Google Scholar] [CrossRef]
- Shan, F.; He, X.; Armaghani, D.J.; Zhang, P.; Sheng, D. Success and challenges in predicting TBM penetration rate using recurrent neural networks. Tunn. Undergr. Space Technol. 2022, 130, 104728. [Google Scholar] [CrossRef]
- Guo, J.; Ding, L.; Luo, H.; Zhou, C.; Ma, L. Wavelet prediction method for ground deformation induced by tunneling. Tunn. Undergr. Space Technol. 2014, 41, 137–151. [Google Scholar] [CrossRef]
- Wang, R.; Li, D.; Chen, E.J.; Liu, Y. Dynamic prediction of mechanized shield tunneling performance. Autom. Constr. 2021, 132, 103958. [Google Scholar] [CrossRef]
- Zhang, P.; Wu, H.; Chen, R.; Dai, T.; Meng, F.; Wang, H. A critical evaluation of machine learning and deep learning in shield-ground interaction prediction. Tunn. Undergr. Space Technol. 2020, 106, 103593. [Google Scholar] [CrossRef]
- Zhou, C.; Xu, H.; Ding, L.; Wei, L.; Zhou, Y. Dynamic prediction for attitude and position in shield tunneling: A deep learning method. Autom. Constr. 2019, 105, 102840. [Google Scholar] [CrossRef]
- Chen, R.-P.; Zhang, P.; Kang, X.; Zhong, Z.-Q.; Liu, Y.; Wu, H.-N. Prediction of maximum surface settlement caused by earth pressure balance (EPB) shield tunneling with ANN methods. Soils Found. 2019, 59, 284–295. [Google Scholar] [CrossRef]
- Lin, S.; Zhang, N.; Zhou, A.; Shen, S. Time-series prediction of shield movement performance during tunneling based on hybrid model. Tunn. Undergr. Space Technol. 2022, 119, 104245. [Google Scholar] [CrossRef]
- Grima, M.A.; Bruines, P.; Verhoef, P. Modeling tunnel boring machine performance by neuro-fuzzy methods. Tunn. Undergr. Space Technol. 2000, 15, 259–269. [Google Scholar] [CrossRef]
- Salimi, A.; Rostami, J.; Moormann, C.; Delisio, A. Application of non-linear regression analysis and artificial intelligence algorithms for performance prediction of hard rock TBMs. Tunn. Undergr. Space Technol. 2016, 58, 236–246. [Google Scholar] [CrossRef]
- Tiryaki, B. Application of artificial neural networks for predicting the cuttability of rocks by drag tools. Tunn. Undergr. Space Technol. 2008, 23, 273–280. [Google Scholar] [CrossRef]
- Zhang, N.; Zhang, N.; Zheng, Q.; Xu, Y.-S. Real-time prediction of shield moving trajectory during tunnelling using GRU deep neural network. Acta Geotech. 2022, 17, 1167–1182. [Google Scholar] [CrossRef]
- Armaghani, D.J.; Mohamad, E.T.; Narayanasamy, M.S.; Narita, N.; Yagiz, S. Development of hybrid intelligent models for predicting TBM penetration rate in hard rock condition. Tunn. Undergr. Space Technol. 2017, 63, 29–43. [Google Scholar] [CrossRef]
- Benardos, A.; Kaliampakos, D. Modelling TBM performance with artificial neural networks. Tunn. Undergr. Space Technol. 2004, 19, 597–605. [Google Scholar] [CrossRef]
- Suwansawat, S.; Einstein, H.H. Artificial neural networks for predicting the maximum surface settlement caused by EPB shield tunneling. Tunn. Undergr. Space Technol. 2006, 21, 133–150. [Google Scholar] [CrossRef]
- Pourtaghi, A.; Lotfollahi-Yaghin, M. Wavenet ability assessment in comparison to ANN for predicting the maximum surface settlement caused by tunneling. Tunn. Undergr. Space Technol. 2012, 28, 257–271. [Google Scholar] [CrossRef]
- Zhang, P.; Wu, H.-N.; Chen, R.-P.; Chan, T.H. Hybrid meta-heuristic and machine learning algorithms for tunneling-induced settlement prediction: A comparative study. Tunn. Undergr. Space Technol. 2020, 99, 103383. [Google Scholar] [CrossRef]
- Zeng, J.; Roy, B.; Kumar, D.; Mohammed, A.S.; Armaghani, D.J.; Zhou, J.; Mohamad, E.T. Proposing several hybrid PSO-extreme learning machine techniques to predict TBM performance. Eng. Comput. 2021, 38, 3811–3827. [Google Scholar] [CrossRef]
- Qin, C.; Shi, G.; Tao, J.; Yu, H.; Jin, Y.; Lei, J.; Liu, C. Precise cutterhead torque prediction for shield tunneling machines using a novel hybrid deep neural network. Mech. Syst. Signal Process. 2021, 151, 107386. [Google Scholar] [CrossRef]
- Gao, X.; Shi, M.; Song, X.; Zhang, C.; Zhang, H. Recurrent neural networks for real-time prediction of TBM operating parameters. Autom. Constr. 2019, 98, 225–235. [Google Scholar] [CrossRef]
- Jin, Y.; Qin, C.; Tao, J.; Liu, C. An accurate and adaptative cutterhead torque prediction method for shield tunneling machines via adaptative residual long-short term memory network. Mech. Syst. Signal Process. 2022, 165, 108312. [Google Scholar] [CrossRef]
- Shi, G.; Qin, C.; Tao, J.; Liu, C. A VMD-EWT-LSTM-based multi-step prediction approach for shield tunneling machine cutterhead torque. Knowl.-Based Syst. 2021, 228, 107213. [Google Scholar] [CrossRef]
- Acaroglu, O.; Ozdemir, L.; Asbury, B. A fuzzy logic model to predict specific energy requirement for TBM performance prediction. Tunn. Undergr. Space Technol. 2008, 23, 600–608. [Google Scholar] [CrossRef]
- Mikaeil, R.; Naghadehi, M.Z.; Sereshki, F. Multifactorial fuzzy approach to the penetrability classification of TBM in hard rock conditions. Tunn. Undergr. Space Technol. 2009, 24, 500–505. [Google Scholar] [CrossRef]
- Parsajoo, M.; Mohammed, A.S.; Yagiz, S.; Armaghani, D.J.; Khandelwal, M. An evolutionary adaptive neuro-fuzzy inference system for estimating field penetration index of tunnel boring machine in rock mass. J. Rock Mech. Geotech. Eng. 2021, 13, 1290–1299. [Google Scholar] [CrossRef]
- Mahdevari, S.; Shahriar, K.; Yagiz, S.; Shirazi, M.A. A support vector regression model for predicting tunnel boring machine penetration rates. Int. J. Rock Mech. Min. Sci. 2014, 72, 214–229. [Google Scholar] [CrossRef]
- Mokhtari, S.; Mooney, M.A. Predicting EPBM advance rate performance using support vector regression modeling. Tunn. Undergr. Space Technol. 2020, 104, 103520. [Google Scholar] [CrossRef]
- Bai, X.-D.; Cheng, W.-C.; Li, G. A comparative study of different machine learning algorithms in predicting EPB shield behaviour: A case study at the Xi’an metro, China. Acta Geotech. 2021, 16, 4061–4080. [Google Scholar] [CrossRef]
- Kannangara, K.P.M.; Zhou, W.; Ding, Z.; Hong, Z. Investigation of feature contribution to shield tunneling-induced settlement using Shapley additive explanations method. J. Rock Mech. Geotech. Eng. 2022, 14, 1052–1063. [Google Scholar] [CrossRef]
- Zhang, P.; Chen, R.; Wu, H. Real-time analysis and regulation of EPB shield steering using Random Forest. Autom. Constr. 2019, 106, 102860. [Google Scholar] [CrossRef]
- Salimi, A.; Rostami, J.; Moormann, C. Application of rock mass classification systems for performance estimation of rock TBMs using regression tree and artificial intelligence algorithms. Tunn. Undergr. Space Technol. 2019, 92, 103046. [Google Scholar] [CrossRef]
- Zhang, Q.; Hu, W.; Liu, Z.; Tan, J. TBM performance prediction with Bayesian optimization and automated machine learning. Tunn. Undergr. Space Technol. 2020, 103, 103493. [Google Scholar] [CrossRef]
- Zhou, J.; Qiu, Y.; Armaghani, D.J.; Zhang, W.; Li, C.; Zhu, S.; Tarinejad, R. Predicting TBM penetration rate in hard rock condition: A comparative study among six XGB-based metaheuristic techniques. Geosci. Front. 2021, 12, 101091. [Google Scholar] [CrossRef]
- Yagiz, S.; Karahan, H. Prediction of hard rock TBM penetration rate using particle swarm optimization. Int. J. Rock Mech. Min. Sci. 2011, 48, 427–433. [Google Scholar] [CrossRef]
- Yagiz, S.; Karahan, H. Application of various optimization techniques and comparison of their performances for predicting TBM penetration rate in rock mass. Int. J. Rock Mech. Min. Sci. 2015, 80, 308–315. [Google Scholar] [CrossRef]
- Huang, X.; Zhang, Q.; Liu, Q.; Liu, X.; Liu, B.; Wang, J.; Yin, X. A real-time prediction method for tunnel boring machine cutter-head torque using bidirectional long short-term memory networks optimized by multi-algorithm. J. Rock Mech. Geotech. Eng. 2022, 14, 798–812. [Google Scholar] [CrossRef]
- Zhou, J.; Qiu, Y.; Zhu, S.; Armaghani, D.J.; Khandelwal, M.; Mohamad, E.T. Estimation of the TBM advance rate under hard rock conditions using XGBoost and Bayesian optimization. Undergr. Space 2021, 6, 506–515. [Google Scholar] [CrossRef]
- Armaghani, D.J.; Koopialipoor, M.; Marto, A.; Yagiz, S. Application of several optimization techniques for estimating TBM advance rate in granitic rocks. J. Rock Mech. Geotech. Eng. 2019, 11, 779–789. [Google Scholar] [CrossRef]
- Harandizadeh, H.; Armaghani, D.J.; Asteris, P.G.; Gandomi, A.H. TBM performance prediction developing a hybrid ANFIS-PNN predictive model optimized by imperialism competitive algorithm. Neural Comput. Appl. 2021, 33, 16149–16179. [Google Scholar] [CrossRef]
- Chen, Z.; Zhang, Y.; Li, J.; Li, X.; Jing, L. Diagnosing tunnel collapse sections based on TBM tunneling big data and deep learning: A case study on the Yinsong Project, China. Tunn. Undergr. Space Technol. 2021, 108, 103700. [Google Scholar] [CrossRef]
- Liu, B.; Wang, R.; Zhao, G.; Guo, X.; Wang, Y.; Li, J.; Wang, S. Prediction of rock mass parameters in the TBM tunnel based on BP neural network integrated simulated annealing algorithm. Tunn. Undergr. Space Technol. 2020, 95, 103103. [Google Scholar] [CrossRef]
- Yagiz, S. Assessment of brittleness using rock strength and density with punch penetration test. Tunn. Undergr. Space Technol. 2009, 24, 66–74. [Google Scholar] [CrossRef]
- Javad, G.; Narges, T. Application of artificial neural networks to the prediction of tunnel boring machine penetration rate. Min. Sci. Technol. 2010, 20, 727–733. [Google Scholar] [CrossRef]
- Armaghani, D.J.; Faradonbeh, R.S.; Momeni, E.; Fahimifar, A.; Tahir, M. Performance prediction of tunnel boring machine through developing a gene expression programming equation. Eng. Comput. 2018, 34, 129–141. [Google Scholar] [CrossRef]
- Koopialipoor, M.; Tootoonchi, H.; Jahed Armaghani, D.; Tonnizam Mohamad, E.; Hedayat, A. Application of deep neural networks in predicting the penetration rate of tunnel boring machines. Bull. Eng. Geol. Environ. 2019, 78, 6347–6360. [Google Scholar] [CrossRef]
- Koopialipoor, M.; Fahimifar, A.; Ghaleini, E.N.; Momenzadeh, M.; Armaghani, D.J. Development of a new hybrid ANN for solving a geotechnical problem related to tunnel boring machine performance. Eng. Comput. 2020, 36, 345–357. [Google Scholar] [CrossRef]
- Wang, Q.; Xie, X.; Shahrour, I. Deep learning model for shield tunneling advance rate prediction in mixed ground condition considering past operations. IEEE Access 2020, 8, 215310–215326. [Google Scholar] [CrossRef]
- Zhou, J.; Yazdani Bejarbaneh, B.; Jahed Armaghani, D.; Tahir, M. Forecasting of TBM advance rate in hard rock condition based on artificial neural network and genetic programming techniques. Bull. Eng. Geol. Environ. 2020, 79, 2069–2084. [Google Scholar] [CrossRef]
- Bardhan, A.; Kardani, N.; GuhaRay, A.; Burman, A.; Samui, P.; Zhang, Y. Hybrid ensemble soft computing approach for predicting penetration rate of tunnel boring machine in a rock environment. J. Rock Mech. Geotech. Eng. 2021, 13, 1398–1412. [Google Scholar] [CrossRef]
- Lin, S.; Shen, S.; Zhang, N.; Zhou, A. Modelling the performance of EPB shield tunnelling using machine and deep learning algorithms. Geosci. Front. 2021, 12, 101177. [Google Scholar] [CrossRef]
- Lin, S.-S.; Shen, S.-L.; Zhou, A. Real-time analysis and prediction of shield cutterhead torque using optimized gated recurrent unit neural network. J. Rock Mech. Geotech. Eng. 2022, 14, 1232–1240. [Google Scholar] [CrossRef]
- Salimi, A.; Rostami, J.; Moormann, C.; Hassanpour, J. Introducing Tree-Based-Regression Models for Prediction of Hard Rock TBM Performance with Consideration of Rock Type. Rock Mech. Rock Eng. 2022, 55, 4869–4891. [Google Scholar] [CrossRef]
- Yang, J.; Yagiz, S.; Liu, Y.-J.; Laouafa, F. Comprehensive evaluation of machine learning algorithms applied to TBM performance prediction. Undergr. Space 2022, 7, 37–49. [Google Scholar] [CrossRef]
- Zhang, W.; Li, H.; Li, Y.; Liu, H.; Chen, Y.; Ding, X. Application of deep learning algorithms in geotechnical engineering: A short critical review. Artif. Intell. Rev. 2021, 54, 5633–5673. [Google Scholar] [CrossRef]
- Ahangari, K.; Moeinossadat, S.R.; Behnia, D. Estimation of tunnelling-induced settlement by modern intelligent methods. Soils Found. 2015, 55, 737–748. [Google Scholar] [CrossRef]
- Neaupane, K.M.; Adhikari, N. Prediction of tunneling-induced ground movement with the multi-layer perceptron. Tunn. Undergr. Space Technol. 2006, 21, 151–159. [Google Scholar] [CrossRef]
- Santos, O.J., Jr.; Celestino, T.B. Artificial neural networks analysis of Sao Paulo subway tunnel settlement data. Tunn. Undergr. Space Technol. 2008, 23, 481–491. [Google Scholar] [CrossRef]
- Boubou, R.; Emeriault, F.; Kastner, R. Artificial neural network application for the prediction of ground surface movements induced by shield tunnelling. Can. Geotech. J. 2010, 47, 1214–1233. [Google Scholar] [CrossRef]
- Dindarloo, S.R.; Siami-Irdemoosa, E. Maximum surface settlement based classification of shallow tunnels in soft ground. Tunn. Undergr. Space Technol. 2015, 49, 320–327. [Google Scholar] [CrossRef]
- Goh, A.T.C.; Zhang, W.; Zhang, Y.; Xiao, Y.; Xiang, Y. Determination of earth pressure balance tunnel-related maximum surface settlement: A multivariate adaptive regression splines approach. Bull. Eng. Geol. Environ. 2018, 77, 489–500. [Google Scholar] [CrossRef]
- Zhang, W.; Li, H.; Wu, C.; Li, Y.; Liu, Z.; Liu, H. Soft computing approach for prediction of surface settlement induced by earth pressure balance shield tunneling. Undergr. Space 2021, 6, 353–363. [Google Scholar] [CrossRef]
- Zhang, L.; Wu, X.; Ji, W.; AbouRizk, S.M. Intelligent approach to estimation of tunnel-induced ground settlement using wavelet packet and support vector machines. J. Comput. Civ. Eng. 2017, 31, 04016053. [Google Scholar] [CrossRef]
- Gao, M.-Y.; Zhang, N.; Shen, S.-L.; Zhou, A. Real-time dynamic earth-pressure regulation model for shield tunneling by integrating GRU deep learning method with GA optimization. IEEE Access 2020, 8, 64310–64323. [Google Scholar] [CrossRef]
- Erharter, G.H.; Marcher, T. On the pointlessness of machine learning based time delayed prediction of TBM operational data. Autom. Constr. 2021, 121, 103443. [Google Scholar] [CrossRef]
- Gao, B.; Wang, R.; Lin, C.; Guo, X.; Liu, B.; Zhang, W. TBM penetration rate prediction based on the long short-term memory neural network. Undergr. Space 2021, 6, 718–731. [Google Scholar] [CrossRef]
- Zhang, P.; Chen, R.; Dai, T.; Wang, Z.; Wu, K. An AIoT-based system for real-time monitoring of tunnel construction. Tunn. Undergr. Space Technol. 2021, 109, 103766. [Google Scholar] [CrossRef]
- Qin, C.; Shi, G.; Tao, J.; Yu, H.; Jin, Y.; Xiao, D.; Zhang, Z.; Liu, C. An adaptive hierarchical decomposition-based method for multi-step cutterhead torque forecast of shield machine. Mech. Syst. Signal Process. 2022, 175, 109148. [Google Scholar] [CrossRef]
- Shan, F.; He, X.; Armaghani, D.J.; Zhang, P.; Sheng, D. Response to Discussion on “Success and challenges in predicting TBM penetration rate using recurrent neural networks” by Georg H. Erharter, Thomas Marcher. Tunn. Undergr. Space Technol. 2023, 105064. [Google Scholar] [CrossRef]
Literature | Data Processing a | Algorithms b | Hyperparameter Tuning c | Targets d | Data Size and Data Set |
---|---|---|---|---|---|

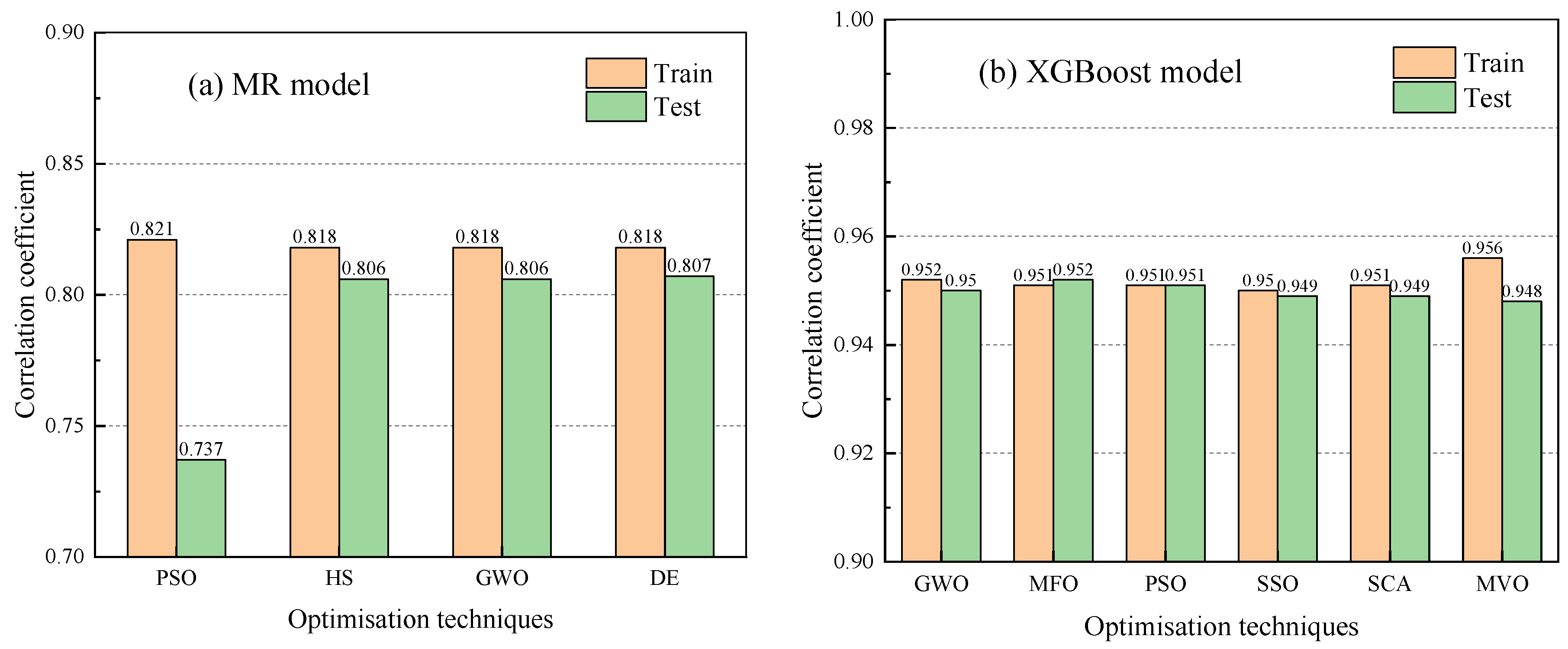

Grima et al. [26] | PCA | MR, ANN, ANFIS | - | PR, AR | 640 tunnel project |
Benardos and Kaliampakos [31] | - | ANN | - | AR | 11-Athens metro |
Tiryaki [28] | PCA | MR, ANN | - | specific energy | 44-Three tunnel projects |
Mikaeil et al. [41] | - | FL | - | Penetrability | 151-Queens water tunnel |
Yagiz [59] | PCC | MR, ANN | - | PR | 151-Queens water tunnel |
Javad and Narges [60] | - | ANN | - | PR | 185-Three tunnel projects |
Mahdevari et al. [43] | - | MR, SVM | - | PR | 151-Queens water tunnel |
Salimi et al. [27] | PCA | MR, SVM, ANFIS | - | FPI | 75-Zagros lot 1B and 2 |
Armaghani et al. [30] | - | ANN | PSO, ICA | PR | 1286-Pahang-Selangor raw water transfer |
Armaghani et al. [61] | - | MR, GEP | - | PR | 1286-Pahang-Selangor raw water transfer |
Sun et al. [18] | Kriging interpolation, rate of change | RF | - | TH, TO, PR | 88-Shenzhen metro |
Armaghani et al. [55] | - | ANN | PSO, ICA | AR | 1286-Pahang-Selangor raw water transfer |
Koopialipoor et al. [62] | - | ANN, DNN | - | PR | 1286-Pahang-Selangor raw water transfer |
Salimi et al. [48] | PCA | MR, CART, GP | - | FPI | 580-Seven tunnel projects |
Zhang et al. [47] | PCC | RF | PSO | TO, TH, PR, FP | 294-Changsha metro line 4 |
Koopialipoor et al. [63] | - | ANN | firefly algorithm | PR | 1200-Pahang-Selangor raw water transfer |
Mokhtari and Mooney [44] | PCC, Relief | SVM | BO | PR | Northgate Link tunnel |
Wang et al. [64] | - | ANN, LSTM, RF, SVM | - | AR | 806-Nanning metro line 1 |
Zhang et al. [49] | - | SVM, CART, RF, bagging, Ada boosting | BO | PR | 151-Queens water tunnel |
Zhang et al. [22] | WT, MD, GRG | LSTM, RF | PSO | TH, TO, PR, RPM, CP | 3549-Changsha metro line 4 and Zhengzhou metro line 2 |
Zhou et al. [65] | - | ANN, GP | - | AR | 1286-Pahang-Selangor raw water transfer |
Bai et al. [45] | PCC, Seasonal-trend decomposition | MR, SVM, DT, GBoost | - | TO, TH, FP | 450-Xi’an metro |
Bardhan et al. [66] | - | hybrid ensemble model | - | PR | 185-Three tunnel project |
Harandizadeh et al. [56] | - | ANFIS-PNN | ICA | PR | 209-Pahang-Selangor raw water transfer |
Lin et al. [67] | - | MR, ANN, SVM, LSTM, GRU, EML | PR | 1000-Shenzhen railway | |
Parsajoo et al. [42] | - | ANFIS | artificial bee colony | FPI | 150-Queens water tunnel |
Zeng et al. [35] | - | EML | PSO | AR | 1286-Pahang-Selangor raw water transfer |
Zhou et al. [54] | - | XGBoost | BO | AR | 1286-Pahang-Selangor raw water transfer |
Zhou et al. [50] | - | ANN, RF, XGBoost, SVM | GWO, PSO, SCA, SSO, MVO, MFO | PR | 1286-Pahang-Selangor raw water transfer |
Lin et al. [25] | - | LSTM | PSO | TH | 1500-Shenzhen railway |
Lin et al. [68] | - | GRU | PSO | TO | 1500-Shenzhen railway |
Salimi et al. [69] | - | MR, CART | - | FPI | 666-Eight tunnel projects |
Yang et al. [3] | - | SVM | GWO, biogeography-based optimisation | PR | 503-Shenzhen metro line |
Model Type | Dataset | Data Size | Parameters | Open Access | Limitations |
---|---|---|---|---|---|
Model A | 640 tunnel projects | - | Geological conditions, Operational parameters, TBM type and size | No | hard to access |
Model B | Queen water tunnel | 151 | Geological conditions | Yes | overfitting or lack of generalisability |
Model C | Pahang-Selangor raw water transfer | 1286 | Geological conditions, Operational parameters | Yes | hard to apply in practice |
Literature | Data Processing | Algorithms a | Hyperparameter Tuning | Targets | Data Size and Data Set |
---|---|---|---|---|---|
Suwansawat and Einstein [32] | - | ANN | - | Smax | 49-Bangkok subway project |
Boubou et al. [75] | - | ANN | - | S(X) | 432-Toulouse subway line B |
Pourtaghi and Lotfollahi-Yaghin [33] | - | Wavelet-ANN | - | Smax | 49-Bangkok subway project |
Dindarloo and Siami-Irdemoosa [76] | PCC | CART | - | Smax | 34-Various tunnel projects |
Goh et al. [77] | - | MARS | - | Smax | 148-Three Singapore MRT projects |
Chen et al. [24] | PCC | ANN, RBF, GRNN | - | Smax | 200-Changsha metro line 4 |
Zhang et al. [47] | PCC | RF | PSO | Smax | 294-Changsha metro line 4 |
Zhang et al. [34] | PCC | ANN, SVM, RF, EML, GRNN | PSO | Smax | 294-Changsha metro line 4 |
Zhang et al. [22] | WT, MD, GRG | LSTM, RF | PSO | Smax | 423-Changsha metro line 4 |
Zhang et al. [78] | PCC | XGBoost, ANN, SVM, MARS | - | Smax | 148-Three Singapore MRT projects |
Kannangara et al. [46] | PCC, sequential feature selection, Boruta algorithm | RF | - | Smax | 264-Hangzhou metro line 2 and line 6 |
Literature | Data Processing a | Algorithms b | Hyperparameter Tuning | Targets c | Data Size and Data Set |
---|---|---|---|---|---|
Guo et al. [20] | WT | Elman RNN | PSO | longitudinal settlement | Jiangji subway tunnel |
Zhang et al. [79] | WT | ANN, SVM | - | daily settlement | 60-Wuhan metro line 2 |
Gao et al. [37] | - | RNN, LSTM, GRU, SVM. RF, Lasso | - | TO, TH, AR, CP | 3000-Shenzhen metro |
Zhou et al. [23] | WT | ARIMA, LSTM, CNN-LSTM | - | HDSH, HDST, VDSH, VDST, roll, pitch | 5005-Sanyang Road Tunnel |
Gao et al. [80] | 3-sigma rule, MA, GRG | GRU | genetic algorithm | earth pressure | 1538-Luoyang metro line 2 |
Erharter and Marcher [81] | PCC | LSTM, RF, SVM | - | TO | 200,000-Brenner base tunnel |
Feng et al. [13] | 3-sigma rule, WT | DBN | - | FPI | 8915-Yingsong water diversion project |
Gao et al. [82] | - | ARIMA, RNN, LSTM | - | PR | Hangzhou second water source project |
Li et al. [2] | PCC | LSTM | - | TO, TH | 4650-Yingsong water diversion project |
Qin et al. [36] | cosine similarity | CNN-LSTM, XGBoost, RF, SVM, LSTM, RNN, CNN | - | TO | 150,000-Singapore metro T225 project |
Shi et al. [39] | WT, variational mode decomposition | LSTM, CNN, RNN, SVM, RF | - | TO | 60,000-Singapore metro T225 project |
Wang et al. [21] | WT, light gradient boosting machine | LSTM | - | PR, TO | 25,543-Sutong gas transmission line |
Xu et al. [14] | 3-sigma rule, MA, PCC | SVM, RF, CNN, LSTM, GBoost, KNN, Bayesian ridge regression | - | PR, TO, TH, RPM | 7000-Yingsong water diversion project |
Zhang et al. [83] | - | RF | - | Smax | 386-Changsha Metro Line 4 |
Huang et al. [53] | SelectKBest | LSTM | BO | TO | Yingsong water diversion project |
Shan et al. [19] | MA | RNN, LSTM | - | PR | 463-Changsha metro line 4 and Zhengzhou metro line 2 |
Shen et al. [17] | WT, Kriging interpolation | LSTM, SVM, RNN | - | HDSH, HDST, VDSH, VDST, roll, pitch | 1200-Shenzhen intercity railway |
Zhang et al. [29] | PCA, PCC | GRU, RNN, SVM | - | HDSH, HDST, VDSH, VDST, | 22,010-Guang-Fo intercity railway |
Literature | Category | Historical Data | Forecast Horizon | ||
---|---|---|---|---|---|
Step behind | Distance behind | Step ahead | Distance ahead | ||
Gao et al. [37] | high-frequency | 5 steps | 1.25 mm a | 1 step | 0.25 mm a |
Qin et al. [36] | 10 steps | - | 1 step | - | |
Huang et al. [53] | 6 steps | 22.4 mm a | 1 step | 3.73 mm a | |
Erharter and Marcher [81] | 50 steps | 2.75 m | 1 or 100 steps | 0.055 or 5.5 m | |
Shi et al. [39] | 10 steps | - | 1–5 steps | - | |
Gao et al. [80] | low-frequency | 5 steps | 7.5 m | 1 step | 1.5 m |
Feng et al. [13] | 7 steps | 7 m | 1 step | 1 m | |
Shan et al. [19] | 5 steps | 7.5 m | 1–5 steps | 1.5–7.5 m |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2023 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Shan, F.; He, X.; Xu, H.; Armaghani, D.J.; Sheng, D. Applications of Machine Learning in Mechanised Tunnel Construction: A Systematic Review. Eng 2023, 4, 1516-1535. https://doi.org/10.3390/eng4020087
Shan F, He X, Xu H, Armaghani DJ, Sheng D. Applications of Machine Learning in Mechanised Tunnel Construction: A Systematic Review. Eng. 2023; 4(2):1516-1535. https://doi.org/10.3390/eng4020087
Chicago/Turabian StyleShan, Feng, Xuzhen He, Haoding Xu, Danial Jahed Armaghani, and Daichao Sheng. 2023. "Applications of Machine Learning in Mechanised Tunnel Construction: A Systematic Review" Eng 4, no. 2: 1516-1535. https://doi.org/10.3390/eng4020087
APA StyleShan, F., He, X., Xu, H., Armaghani, D. J., & Sheng, D. (2023). Applications of Machine Learning in Mechanised Tunnel Construction: A Systematic Review. Eng, 4(2), 1516-1535. https://doi.org/10.3390/eng4020087
