A Review on Significant Factors Causing Delays in Saudi Arabia Construction Projects
Abstract
:1. Introduction
2. Construction Companies and Its Types
- Residential Building;
- Institutional and Commercial Building;
- Specialized Industrial Construction;
- Infrastructure and Heavy Construction.
2.1. Civil Engineering Companies
2.2. Construction Contracting Company
2.3. Heavy Engineering and Construction
2.4. Industrial Infrastructure Company
2.5. EPC—Engineering, Procurement and Construction Company
2.6. PMC—Project Management Consultant
2.7. Real Estate Companies
2.8. MEP—Mechanical, Electrical, and Plumbing Contractors
2.9. Small Renovation Contractors
3. Construction Companies of Saudi Arabia
4. Delays in Construction Companies
4.1. Delays in Construction Companies across the World
4.2. Delays in Construction Companies of Saudi Arabia
5. Critical Analysis of Literature Review for the Identification of Causes and Effects of Delays
6. Causes and Effects of Delays Identified Based on the Literature Review

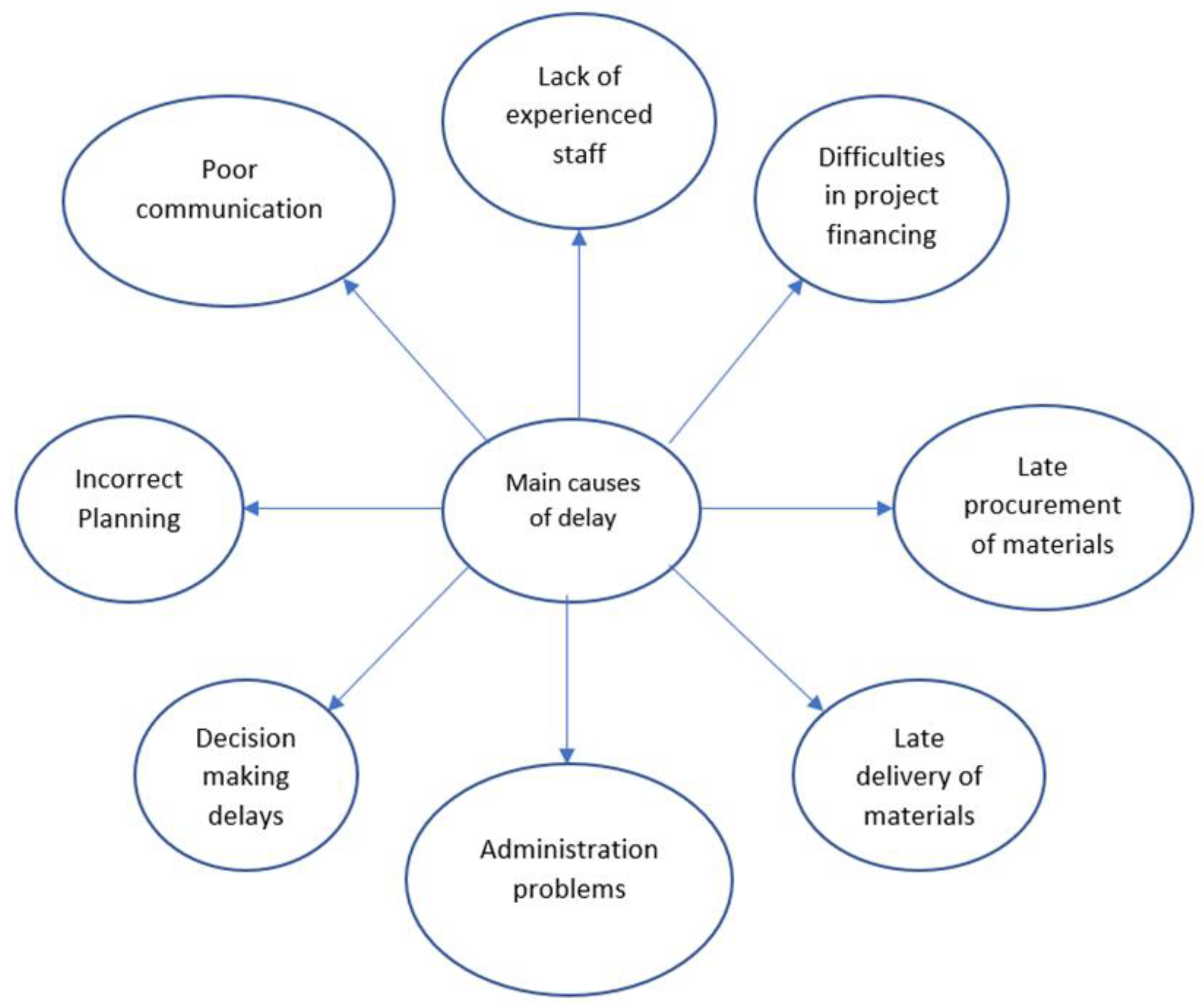

6.1. Causes of Delays
6.2. Effects of Delays
7. Conclusions
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Acknowledgments
Conflicts of Interest
References
- Sanni-Anibire, M.O.; Zin, R.M.; Olatunji, S.O. Causes of delay in the global construction industry: A meta analytical review. Int. J. Constr. Manag. 2022, 22, 1395–1407. [Google Scholar] [CrossRef]
- Tariq, J.; Gardezi, S.S.S. Study the delays and conflicts for construction projects and their mutual relationship: A review. Ain Shams Eng. J. 2022, 14, 101815. [Google Scholar] [CrossRef]
- Fashina, A.A.; Omar, M.A.; Sheikh, A.A.; Fakunle, F.F. Exploring the significant factors that influence delays in construction projects in Hargeisa. Heliyon 2021, 7, 4. [Google Scholar] [CrossRef] [PubMed]
- Sha, M.K.; Shahi, P.B.; Pandit, R.; Pandey, A. Causes and Effects of Delays in Constrution Projets. IOSR J. Mech. Civ. Eng. 2017, 14, 52–58. [Google Scholar] [CrossRef]
- Sweis, G.; Sweis, R.; Hammad, A.A.; Shboul, A. Delays in construction projects: The case of Jordan. Int. J. Proj. Manag. 2008, 26, 665–674. [Google Scholar] [CrossRef]
- Zavadskas, E.K.; Antucheviciene, J.; Vilutiene, T.; Adeli, H. Sustainable decision-making in civil engineering, construction and building technology. Sustainability 2018, 10, 14. [Google Scholar] [CrossRef] [Green Version]
- Nurdiana, A.; Susanti, R. Assessing Risk on the Engineering Procurement Construction (EPC) Project from the Perspective of the Owner: A Case Study. IOP Conf. Ser. Earth Environ. Sci. 2020, 506, 012040. [Google Scholar] [CrossRef]
- Tongkong, S. Key factors influencing capital structure decision and its speed of adjustment of Thai listed real estate companies. Procedia-Soc. Behav. Sci. 2012, 40, 716–720. [Google Scholar] [CrossRef] [Green Version]
- G. of S. Arabia. “Sustanable Development Goals,” Saudi Arabia. 2021. Available online: https://sdgs.un.org/goals (accessed on 3 April 2022).
- Rachid, Z.; Toufik, B.; Mohammed, B. Causes of schedule delays in construction projects in Algeria. Int. J. Constr. Manag. 2019, 19, 371–381. [Google Scholar] [CrossRef]
- Asif, M. Growth and sustainability trends in the buildings sector in the GCC region with particular reference to the KSA and UAE. Renew. Sustain. Energy Rev. 2016, 55, 1267–1273. [Google Scholar] [CrossRef]
- Jamal, E.; Albattah, M. Evaluating the Factors That Cause Cost and Time Overrun in the Residential Construction Projects in the UAE: Project Manager Perspective. In Proceedings of the 8th Zero Energy Mass Custom Home International Conference, Dubai, United Arab Emirates, 26 October 2021. [Google Scholar]
- Enshassi, A.; al Najjar, J.; Kumaraswamy, M. Delays and cost overruns in the construction projects in the Gaza Strip. J. Financ. Manag. Prop. Constr. 2009, 14, 126–151. [Google Scholar] [CrossRef]
- Durdyev, S.; Hosseini, M.R. Causes of delays on construction projects: A comprehensive list. Int. J. Manag. Proj. Bus. 2020, 13, 20–46. [Google Scholar] [CrossRef]
- Kumaraswamy, M.M.; Chan, D.W.M. Contributors to construction delays. Constr. Manag. Econ. 1998, 16, 17–29. [Google Scholar] [CrossRef]
- Chan, D.W.M.; Kumaraswamy, M.M. A comparative study of causes of time overruns in Hong Kong construction projects. Int. J. Proj. Manag. 1997, 15, 55–63. [Google Scholar] [CrossRef]
- Venkatesh, P.K.; Venkatesan, V. Delays in construction projects: A review of causes, need and scope for further research. Malaysian Constr. Res. J. 2017, 23, 89–113. [Google Scholar]
- Odeyinka, H.A.; Yusif, A. The Causes and Effects of Construction Delays on Completion Cost of Housing Projects in Nigeria. J. Financ. Manag. Prop. Constr. 1997, 2, 31–44. [Google Scholar]
- Mansfield, N.; Ugwu, O.; Doran, T. Causes of delay and cost overruns in Nigerian construction projects. Int. J. Proj. Manag. 1994, 12, 254–260. [Google Scholar] [CrossRef]
- Doloi, H.; Sawhney, A.; Iyer, K.C.; Rentala, S. Analysing factors affecting delays in Indian construction projects. Int. J. Proj. Manag. 2012, 30, 479–489. [Google Scholar] [CrossRef]
- Assaf, S.A.; Al-Hejji, S. Causes of delay in large construction projects. Int. J. Proj. Manag. 2006, 24, 349–357. [Google Scholar] [CrossRef]
- Kaliba, C.; Muya, M.; Mumba, K. Cost escalation and schedule delays in road construction projects in Zambia. Int. J. Proj. Manag. 2009, 27, 522–531. [Google Scholar] [CrossRef]
- Yap, J.B.H.; Goay, P.L.; Woon, Y.B.; Skitmore, M. Revisiting critical delay factors for construction: Analysing projects in Malaysia. Alex. Eng. J. 2021, 60, 1717–1729. [Google Scholar] [CrossRef]
- Chapman, R.J. The role of system dynamics in understanding the impact of changes to key project personnel on design production within construction projects. Int. J. Proj. Manag. 1998, 16, 235–247. [Google Scholar] [CrossRef]
- Faridi, A.S.; El-Sayegh, S.M. Significant factors causing delay in the UAE construction industry. Constr. Manag. Econ. 2006, 24, 1167–1176. [Google Scholar] [CrossRef]
- Gardezi, S.S.S.; Manarvi, I.A.; Gardezi, S.J.S. Time extension factors in construction industry of Pakistan. Procedia Eng. 2014, 77, 196–204. [Google Scholar] [CrossRef] [Green Version]
- Prasad, K.V.; Vasugi, V.; Venkatesan, R.; Bhat, N.S. Critical causes of time overrun in Indian construction projects and mitigation measures. Int. J. Constr. Educ. Res. 2019, 15, 216–238. [Google Scholar] [CrossRef]
- Yap, J.B.H.; Chow, I.N.; Shavarebi, K. Criticality of Construction Industry Problems in Developing Countries: Analyzing Malaysian Projects. J. Manag. Eng. 2019, 35, 04019020. [Google Scholar] [CrossRef]
- Almahmoud, E.; Doloi, H.K. Identifying the key factors in construction projects that affect neighbourhood social sustainability. Facilities 2020, 38, 765–782. [Google Scholar] [CrossRef]
- Rashid, Y. Analysis of delay factors and their effects on construction projects. Manag. Sci. Lett. 2020, 10, 1197–1204. [Google Scholar] [CrossRef]
- Elhusseiny, H.O.; Nosair, I.; Ezeldin, A.S. Systematic processing framework for analyzing the factors of construction projects’ delays in Egypt. Ain Shams Eng. J. 2021, 12, 1501–1511. [Google Scholar] [CrossRef]
- Viswanathan, S.K.; Jha, K.N. Critical risk factors in international construction projects: An Indian perspective. Eng. Constr. Archit. Manag. 2020, 27, 1169–1190. [Google Scholar] [CrossRef]
- Kim, S.; Chang, S.; Castro-Lacouture, D. Dynamic Modeling for Analyzing Impacts of Skilled Labor Shortage on Construction Project Management. J. Manag. Eng. 2020, 36, 04019035. [Google Scholar] [CrossRef]
- Bajjou, M.S.; Chafi, A. Empirical study of schedule delay in Moroccan construction projects. Int. J. Constr. Manag. 2020, 20, 783–800. [Google Scholar] [CrossRef]
- Gondia, A.; Siam, A.; El-Dakhakhni, W.; Nassar, A.H. Machine Learning Algorithms for Construction Projects Delay Risk Prediction. J. Constr. Eng. Manag. 2020, 146, 04019085. [Google Scholar] [CrossRef]
- Heravi, G.; Mohammadian, M. Investigating cost overruns and delay in urban construction projects in Iran. Int. J. Constr. Manag. 2021, 21, 958–968. [Google Scholar] [CrossRef]
- Yap, J.B.H.; Tan, S.M. Investigating Rework: Insights from the Malaysian Construction Industry. ASM Sci. J. 2021, 14, 1–9. [Google Scholar] [CrossRef]
- Issa, U.H.; Marouf, K.G.; Faheem, H. Analysis of risk factors affecting the main execution activities of roadways construction projects. J. King Saud Univ.-Eng. Sci. 2021, (in press). [Google Scholar] [CrossRef]
- Al Amri, T.; Marey-Pérez, M. Towards a sustainable construction industry: Delays and cost overrun causes in construction projects of Oman. J. Proj. Manag. 2020, 5, 87–102. [Google Scholar] [CrossRef]
- Kermanshachi, S.; Rouhanizadeh, B.; Govan, P. Developing management policies and analyzing impact of change orders on labor productivity in construction projects. J. Eng. Des. Technol. 2021, 20, 1257–1279. [Google Scholar] [CrossRef]
- Arantes, A.; Ferreira, L.M.D.F. A methodology for the development of delay mitigation measures in construction projects. Prod. Plan. Control 2021, 32, 228–241. [Google Scholar] [CrossRef]
- Ammar, T.; Abdel-Monem, M.; El-Dash, K. Risk factors causing cost overruns in road networks. Ain Shams Eng. J. 2022, 13, 101720. [Google Scholar] [CrossRef]
- Fitzsimmons, J.P.; Lu, R.; Hong, Y.; Brilakis, I. Construction Schedule Risk Analysis—A Hybrid Machine Learning Approach. J. Inf. Technol. Constr. 2022, 27, 70–93. [Google Scholar] [CrossRef]
- Kazaz, A.; Ulubeyli, S.; Tuncbilekli, N.A. Causes of Delays in Construction Projects in Turkey. Vilnius Gedim. Tech. Univ. 2012, 18, 426–435. [Google Scholar] [CrossRef]
- Chan, D.W.M.; Kumaraswamy, M.M. A study of the factors affecting construction durations in Hong Kong. Constr. Manag. Econ. 1995, 13, 319–333. [Google Scholar] [CrossRef]
- Koushki, P.A.; Al-Rashid, K.; Kartman, N. Delays and cost increases in the construction of private residential projects in Kuwait. Taylor Fr. 2005, 23, 285–294. [Google Scholar] [CrossRef]
- Sambasivan, M.; Soon, Y.W. Causes and effects of delays in Malaysian construction industry. Int. J. Proj. Manag. 2007, 25, 517–526. Available online: https://www.sciencedirect.com/science/article/pii/S0263786306001700?casa_token=PW3MgjQbmE4AAAAA:OglspcH21ZQ1_rLxQO363RyOZjVJpcPuxFe7A_dwZXfuiuzioseZOg6mWgQ_aENxZM3nDRNVAvet (accessed on 5 July 2022). [CrossRef]
- Semple, C.; Hartman, F.T.; Jergeas, G. Construction Claims and Disputes: Causes and Cost/Time Overruns. J. Constr. Eng. Manag. 1994, 120, 785–795. [Google Scholar] [CrossRef]
- Flyvbjerg, B.; Ansar, A.; Budzier, A.; Buhl, S.; Cantarelli, C.; Garbuio, M.; Glenting, C.; Holm, M.S.; Lovallo, D.; Lunn, D.; et al. Five things you should know about cost overrun. Transp. Res. Part A Policy Pract. 2018, 118, 174–190. Available online: https://www.sciencedirect.com/science/article/pii/S0965856418309157?casa_token=jJqDlcbyRrcAAAAA:cp-5Fuz67PQyZLjdMkjP9ak03mJp1vL9LODpq6upL2aNgGpYpx7pqnk9JtccA5biUi4EfNGBtpO4 (accessed on 5 July 2022).
- Alsuliman, J.A. Causes of delay in Saudi public construction projects. Alex. Eng. J. 2019, 58, 801–808. [Google Scholar] [CrossRef]
- Al-Kharashi, A.; Skitmore, M. Causes of delays in Saudi Arabian public sector construction projects. Constr. Manag. Econ. 2009, 27, 3–23. [Google Scholar] [CrossRef] [Green Version]
- Alshakhrit, A.K.S.; Alshakhrit, A.K.S.; Supeni, E.E.; Zahari, N.I. Causes and Effects of Delays in Saudi Arabian Construction Projects. J. Glob. Econ. Manag. Bus. Res. 2019, 11, 165–174. Available online: https://archives.biciconference.co.in/index.php/JGEMBR/article/view/4721 (accessed on 14 May 2022).
- Assaf, S.A.; Al-Khalil, M.; Al-Hazmi, M. Causes of Delay in Large Building Construction Projects. J. Manag. Eng. 1995, 11, 45–50. [Google Scholar] [CrossRef]
- Abduljawwad, T.M.; Almaktoom, A.; Abduljawwad, T.M.; Preparation, S. Factors behind construction delays in Saudi Arabia. PalArchs J. Archaeol. Egypt Egyptol. 2021, 18, 184–194. [Google Scholar]
- Alenazi, E.; Adamu, Z.; Al-otaibi, A. Exploring the Nature and Impact of Client-Related Delays on Contemporary Saudi Construction Projects. Buildings 2022, 12, 880. [Google Scholar] [CrossRef]
- Mbala, M.; Aigbavboa, C.; Aliu, J. Causes of Delay in Various Construction Projects: A Literature Review. Adv. Intell. Syst. Comput. 2019, 788, 489–495. [Google Scholar] [CrossRef]
- Mahamid, I. Factors contributing to poor performance in construction projects. Stud. Saudi Arabia 2016, 12, 27–38. [Google Scholar] [CrossRef]
- Al Khatib, B.; Poh, Y.S.; El-Shafie, A. Delay factors in reconstruction projects: A case study of Mataf Expansion Project. Sustainability 2018, 10, 4772. [Google Scholar] [CrossRef] [Green Version]
- Al Hammadi, S.; Nawab, M.S. Study of Delay Factors in Construction Projects. Iarjset 2016, 3, 87–93. [Google Scholar] [CrossRef]
- Albogamy, A.; Scott, D.; Dawood, N. Dilemma of Saudi Arabian Construction Industry. J. Constr. Eng. Proj. Manag. 2013, 3, 35–40. [Google Scholar] [CrossRef] [Green Version]
- Afshari, H.; Khosravi, S.; Ghorbanali, A.; Borzabadi, M.; Valipour, M. Identification of Causes of Non-excusable Delays of Construction Projects. Management 2011, 3, 42–46. [Google Scholar]
- Ikediashi, D.I.; Ogunlana, S.O.; Alotaibi, A. Analysis of Project Failure Factors for Infrastructure Projects in Saudi Arabia: Approach. J. Constr. Dev. Ctries. 2014, 19, 35–52. [Google Scholar]
- Al-emad, N.; Nagapan, S. Identification of Delay Factors from Mecca’s Construction Experts Perspective. Int. J. Sustain. Constr. Eng. Technol. 2015, 6, 16–25. [Google Scholar]
- Arain, F.M.; Pheng, L.S.; Assaf, S.A. Contractors’ Views of the Potential Causes of Inconsistencies between Design and Construction in Saudi Arabia. J. Perform. Constr. Facil. 2006, 20, 74–83. [Google Scholar] [CrossRef] [Green Version]
- Rahman, I.A.; Al-Emad, N.; Nagapan, S. Projects Delay Factors of Saudi Arabia Construction Industry Using PLS-SEM Path Modelling Approach. MATEC Web Conf. 2016, 81, 07001. [Google Scholar] [CrossRef] [Green Version]
- Al-Emad, N.; Rahman, I.A.; Nagapan, S.; Gamil, Y. Ranking of Delay Factors for Makkah’s Construction Industry. MATEC Web Conf. 2017, 103, 03001. [Google Scholar] [CrossRef] [Green Version]
- Alzara, M.; Kashiwagi, J.; Kashiwagi, D.; Al-Tassan, A. Important Causes of Delayed Projects in Saudi Arabia vs. PIPS: A University Campus Case Study. J. Adv. Perform. Inf. Value 2016, 8, 7–19. [Google Scholar] [CrossRef]
- Ahmad, S.; Emam, H.; Farrell, P. Barriers to BIM/4D implementation in Qatar. Proceedings of The First International Conference of the CIB Middle East & North Africa Research Network CIB-MENA, Abu Dhabi, United Arab Emirates, 14–16 December 2014; pp. 533–547. [Google Scholar]
- Ammar, T.; Alghonamy, A. Cost Overrun in Construction Projects in Saudi Arabia: Contractors’ Perspective. Int. J. Eng. Technol. 2015, 15, 35–42. [Google Scholar]
- Al-Khalil, M.I.; AL-Ghafly, M.A. Delay in public utility projects in Saudi Arabia. Int. J. Proj. Manag. 1999, 17, 101–106. [Google Scholar] [CrossRef]
- Albogamy, A.; Scott, D.; Dawood, N. Addressing construction delays in the Kingdom of Saudi Arabia. Int. Proc. Econ. Dev. Res. 2012, 45, 148–153. [Google Scholar]
- Alhomidan, A. Factors Affecting Cost Overrun in Road Construction Projects in Saudi Arabia. Int. J. Civ. Environ. Eng. 2013, 13, 1–4. [Google Scholar]
- Elawi, G.S.A.; Algahtany, M.; Kashiwagi, D. Owners’ Perspective of Factors Contributing to Project Delay: Case Studies of Road and Bridge Projects in Saudi Arabia. Procedia Eng. 2016, 145, 1402–1409. [Google Scholar] [CrossRef] [Green Version]
- Mahamid, I. Schedule Delay in Saudi Arabia Road Construction Projects: Size, Estimate, Determinants and Effects. Int. J. Archit. Eng. Constr. 2017, 6, 51–58. [Google Scholar] [CrossRef]
- Mahamid, I. Contributors to Schedule Delays in Public Construction Projects in Saudi Arabia: Owners’ Perspective. J. Constr. Proj. Manag. Innov. 2013, 3, 608–619. [Google Scholar]
- Elawi, G.S.A.; Algahtany, M.; Kashiwagi, D.; Sullivan, K. Major Factors Causing Construction Delays in Mecca. J. Adv. Perform. Inf. Value 2015, 7, 75. [Google Scholar] [CrossRef]
- Mahamid, I. Micro and macro level of dispute causes in residential building projects: Studies of Saudi Arabia. J. King Saud Univ.-Eng. Sci. 2016, 28, 12–20. [Google Scholar] [CrossRef] [Green Version]
- Gopang, R.K.M.; Imran, Q.B.A.; Nagapan, S. Assessment of delay factors in Saudi Arabia railway/metro construction projects. Int. J. Sustain. Constr. Eng. Technol. 2020, 11, 225–233. [Google Scholar] [CrossRef]
- Baghdadi, A.; Kishk, M. Saudi Arabian Aviation Construction Projects: Identification of Risks and Their Consequences. Procedia Eng. 2015, 123, 32–40. [Google Scholar] [CrossRef]
GCC Countries | Construction Projects (%) |
---|---|
Saudi Arabia | 43 |
United Arab Emirates | 29 |
Qatar | 11 |
Kuwait | 8 |
Oman | 6 |
Bahrain | 3 |
Reference | Country | Type of Project | Finding in the Study |
---|---|---|---|

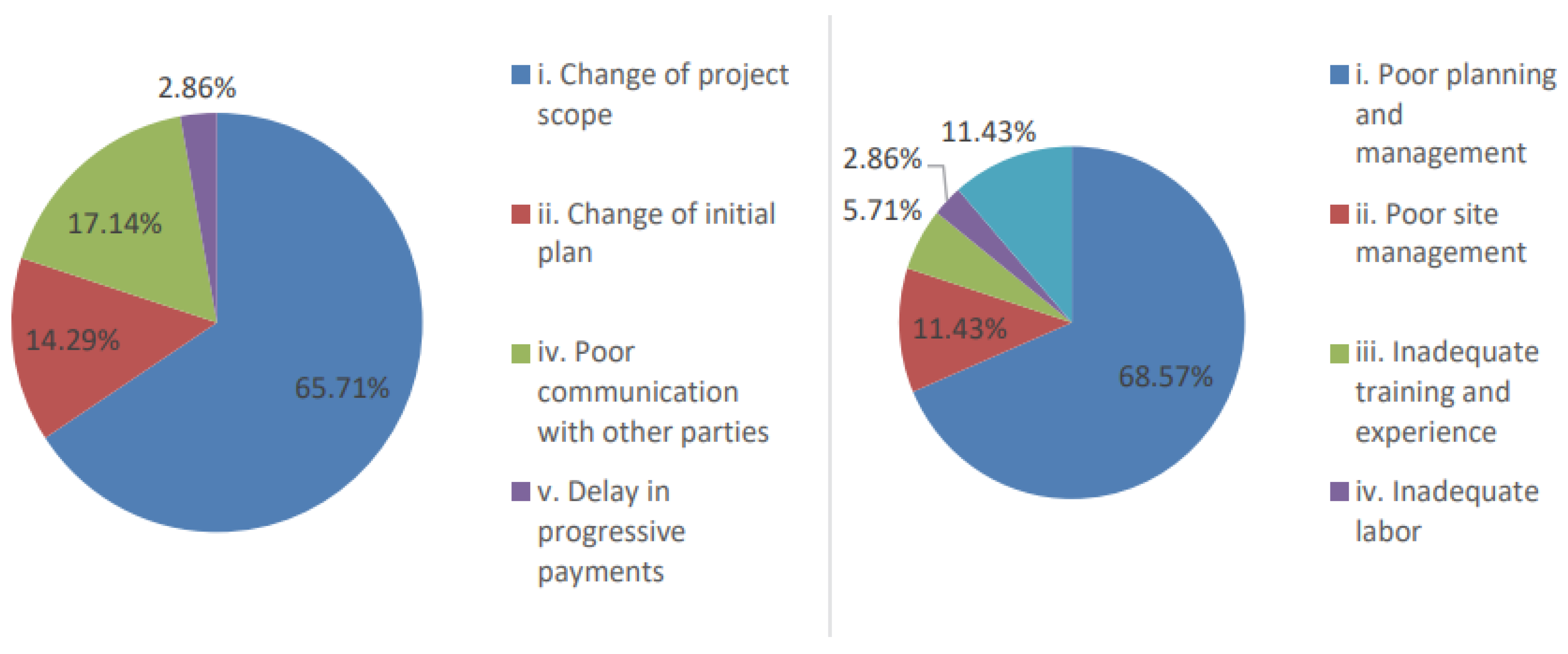

[43] | Turkey | Utility projects | A total of 34.6% delay in contractor’s projects, 43.6% delay in projects executed by public agencies. |
[44] | Hong Kong | Building and Civil | The average time overrun is more than 20% and only 40% Govt. buildings, 25% private buildings, and 35% civil engineering works completed within schedule. |
[45] | UAE | Residential Buildings | Out of 450 buildings, 56% of projects experienced time (2005) overruns, 54% of the projects were delayed by four months or more, and 33% of the projects were delayed by more than six months. |
[46] | Malaysia | Government Projects | A total of 17.3% of the projects were delayed by more than three months, abandoned, or otherwise deemed unhealthy. |
[47] | Canada | Generic | In some instances, delays went over the initial (1994) contract duration by more than 100%. |
[48] | Many Countries | Mixed | The average schedule overrun was 42.7%. |

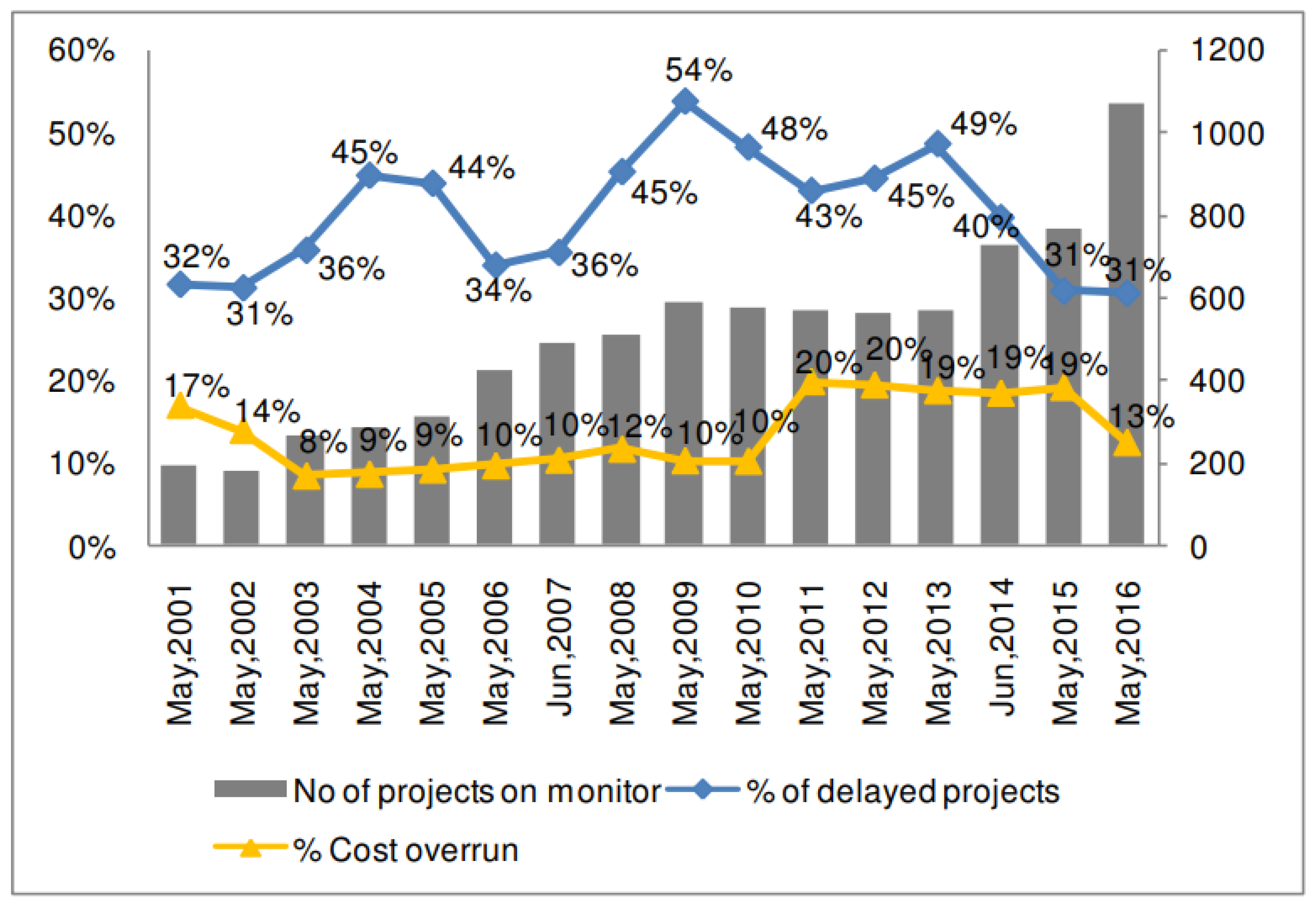

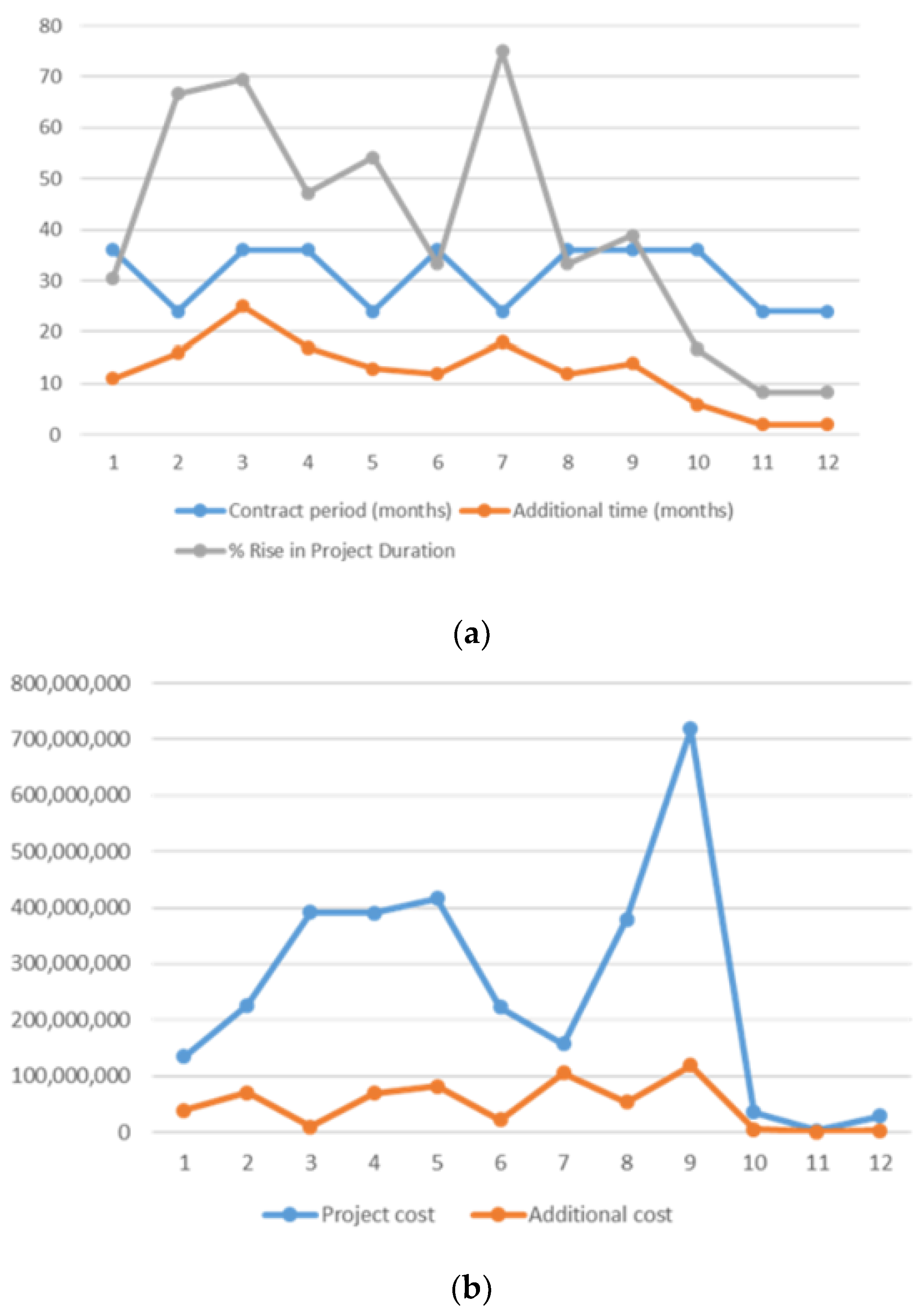

[49] | KSA | Construction mixed | The average project was delayed by 40%. |
Type of Project | Methodology | Causes of Delays Identified | Reference |
---|---|---|---|
Industrial/Manufacturing developments | Literature review and discussions with Saudi Arabian industry professionals | Difficulties in project financing, late procurement of materials, late delivery of materials, delay in progress payments, and delay in approving design documents. | [70] |
Public construction project | Literature review and questionnaires | Contractor and owner/client-related factors. | [71] |

Saudi Arabian road construction projects | A risk map comprising 41 factors was analyzed in a survey | Internal administrative problems, payment delays, poor communication between construction partners, and decision-making delays. | [72] |
Infrastructure projects | Quantitative evaluation of data from the questionnaire | The land acquisition component was discovered to be the most significant cause of delay. | [73] |
Road construction projects | A questionnaire survey | Incorrect planning, low labour productivity, additional work, lack of contractor experience, and rework. | [74] |
Public construction projects | A structured questionnaire survey | Bid award for lowest price, poor site management, poor communication and coordination between construction parties, rework, delays, and low labor productivity. | [75] |
Infrastructure projects | An objective examination of data from the questionnaire | Land acquisition component. | [76] |
Saudi Arabian residential construction projects | A questionnaire | Delay in progress payment by the owner, unrealistic contract terms, change orders, poor quality of finished works, and labor inefficiencies. Inadequate contractor expertise, lack of communication between construction parties, bad project planning and scheduling by contractors, poor estimation practices, and cash problems during construction. | [77] |
Railway construction | Thorough literature analysis and questionnaire | The client decision-making process and changes in control procedures, design errors (including ambiguities and discrepancies of details/specifications), labor skills level, client, or consultant design changes, and finally, issues regarding permissions/approvals from other stakeholders. | [78] |
Airport projects | Critical literature assessments | A total of 54 new hazards were discovered and divided into three categories: internal, external, and force majeure. | [79] |
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations. |
© 2022 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Alajmi, A.M.; Ahmed Memon, Z. A Review on Significant Factors Causing Delays in Saudi Arabia Construction Projects. Smart Cities 2022, 5, 1465-1487. https://doi.org/10.3390/smartcities5040075
Alajmi AM, Ahmed Memon Z. A Review on Significant Factors Causing Delays in Saudi Arabia Construction Projects. Smart Cities. 2022; 5(4):1465-1487. https://doi.org/10.3390/smartcities5040075
Chicago/Turabian StyleAlajmi, Abdulali Mohammed, and Zubair Ahmed Memon. 2022. "A Review on Significant Factors Causing Delays in Saudi Arabia Construction Projects" Smart Cities 5, no. 4: 1465-1487. https://doi.org/10.3390/smartcities5040075
APA StyleAlajmi, A. M., & Ahmed Memon, Z. (2022). A Review on Significant Factors Causing Delays in Saudi Arabia Construction Projects. Smart Cities, 5(4), 1465-1487. https://doi.org/10.3390/smartcities5040075
