1. Introduction
Lean manufacturing concepts are becoming rapidly popular in global production industries subjected to growing market competitions and increased manufacturing costs. Initiated by Toyota’s engineer Taiichi Ohno, credited with developing the principles of lean production after World War II; eliminating unwanted activities, empowering workforce, cut down inventories, and improving productivity are the focused themes of lean philosophy. Unlike Henry Ford, who maintained resources in expectation of what might be required for future manufacturing, the management team at Toyota built partnership with suppliers and consequently became made-to-order. Thus, they can easily handle quick changes, and opposite to what their competitors could, they became able to respond quicker to market demands.
Highly inflexible and having high volume/low variety products of automatic machinery are the constraints in the textile industries. Due to this nature of textile industry, implementation of lean manufacturing is a challenge in this industry. Therefore, value stream mapping, kaizen, 5S, kanban, poka-yoke, and visual controls are practiced in combination with each other to improve the textile manufacturing process [
1]. Most of the textile manufacturing processes include more than one production stages, and among all other concerns, optimum work in process inventory levels and scrap control are the premier ones. Thus, managers are interested in working out ways to minimize total system costs through optimal lot sizing in the production system. This builds importance of economic production quantity model in this sector to escape high inventory levels and cut down production costs.
Figure 1 shows a general multi-stage production flow of an apparel manufacturing industry.
Since Harris [
2] and Taft [
3] provided Economic Order Quantity (EOQ) and Economic Production Quantity (EPQ) formulas, respectively, economic lot size models are broadly developed by the researchers. Due to their simplicity, these inventory models are used in many applied situations. In the inventory management research, Lee [
4], Gupta and Chakraborty [
5], and Tayi and Ballou [
6] studied reprocessing of imperfect items, in which shortages due to reworking were not taken into account by the last two. Lee et al. [
7] and Glock and Jaber [
8] provided production models for imperfect production systems without considering rework opportunity. C.S Lin [
9] studied the production process for its out-of-control state along with raw material resource constraints. Salameh and Jaber [
10] provided an inventory model for imperfect quality items where these items are withdrawn from stock resulting in lower holding cost per unit time. Their model was extended by Khan et al. [
11], and Jaber et al. [
12] considers strategies for handling these imperfect quality items. Ouyang et al. [
13] and Cárdenas-Barrón [
14] formulated inventory models in which backordering is allowed and Eroglu and Ozdemir [
15] considered shortages in their studies. Jaber and Guiffrida [
16] studied Wright’s learning curve along with preventive maintenance, and Daya [
17] likewise extended the inventory model with planned maintenance schedules.
Most of the researchers developed inventory models for single-stage imperfect production systems, where numerous of them focused on analysis of the defective rates. Reworking in single-stage inventory models with constant defective rates has been established by Jamal et al. [
18], Biswas and Sarker [
19], Chung [
20], and Taleizadeh et al. [
21], in which the latter two included backordering in their models. Cárdenas-Barrón [
22] extended the inventory model provided by Jamal et al. [
18] with the addition of the algebraic solution approach. Ma et al. [
23] analyzed imperfect production system without providing reworking alternatives in their model, and Barzoki et al. [
24] presented discounted sales of non-reworkable items. Other researchers modified inventory model with random-defective rate in single-stage manufacturing system, where the reworking option was assumed by Chiu et al. [
25], Chiu et al. [
26], Noorollahi et al. [
27], Haider et al. [
28], and Chiu et al. [
29] using the renewal reward theorem. Taleizadeh et al. [
30] allowed a backordering alternative along with the rework prospect in their inventory model, whereas Chiu et al. [
31] and Taleizadeh et al. [
32] developed inventory models, ignoring the reworking facility. Random defect-rate contemplation was further established by Sana [
33], Sarkar and Moon [
34], Yoo et al. [
35], Chakraborty and Giri [
36], Wee et al. [
37], Chiu et al. [
38], and Sarkar et al. [
39] using a number of other shop-floor conditions.
In real situations, determining the precise value of product demand is very difficult. To deal with such conditions, managers need to gather demand data from the experts. If, according to the experts, demand about some randomly chosen quantity is fixed; their opinion is imprecise and then the expected annual demand is vaguely expressed. This explanation of demand is through a fuzzy number. As defined by Dang and Hong [
40], fuzziness is some parametric property of the demand captured when its sharp boundaries cannot be determined by the decision makers. Zadeh [
41] introduced fuzzy terminologies in 1978. After him, several researches including Petrovic and Sweeney [
42], Roy and Maiti [
43], Yao and Su [
44], Chang and Ouyang [
45], Mahata and Goswami [
46], and De and Goswami [
47] formulated inventory models considering parameters like demand, total average cost, storage space, and holding cost as fuzzy numbers. Numerous other researches solved inventory models considering fuzzy demand. Chang and Yeh [
48], Sadeghu and Niaki [
49], Lin et al. [
50], Cosgun et al. [
51], and Sadeghi et al. [
52] treated demand as a trapezoidal fuzzy number in their inventory models. Some other researchers including Rong and Maiti [
53], Zhang et al. [
54], Moghaddam [
55], and Huang et al. [
56] considered demand as a Triangular Fuzzy Number (TFN). In addition, Taleizadeh et al. [
57] presented a multi-constraint EOQ model with incremental discounts and uncertain item cost under fuzzy environment, and Jana et al. [
58] considered storage space and available budget as fuzzy variables. Das et al. [
59] assumed credit period in a supply chain as a fuzzy number, and Kumar and Goswami [
60] developed a production inventory model under fuzzy shifting time to out-of-control state and fuzzy defective proportion.
In fact, in real situations, production processes are imperfect, thus producing defective items at a certain rate. That is why many researchers and practitioners have formulated inventory models expressing different real world circumstances [
21,
22,
23,
24]. In addition, parametric information of the real world production systems is not always known with precision [
48]. This imprecise data can be random or uncertain in nature. Probability theory can handle the situations with random information, whereas the computational methods provided by the fuzzy theory are required to tackle the uncertain conditions. Several approaches including the signed distance method, min-max approximation, weighted average method, the center of gravity approach (centroid method), and center of the largest area are available in the uncertainty control literature to model the uncertain environment. This research work has used the center of gravity approach to grasp the uncertainty in demand information because of its simplicity and ease of use.
Vast research has been done on single-stage production system, in which machine breakdowns and defective proportion are considered as constant, random, and occasionally fuzzy in nature [
22,
34,
60]. Regarding multistage production systems, only a few economic batch quantity models are available with limited real world production scenarios to provide succor in decision making for the managers dealing with multi-stage production systems [
61,
62]. This paper attempts to add in the literature by formulating an economic lot size model for multi-stage production facility with setup time requirement, uncertain annual demand rate, and imperfection constraints. The aim of this research work is to initiate a multi-stage production model by considering a real world shop-floor situation of defective production and uncertain market conditions regarding demand information.
Literature analysis indicates that no such model exists in the current research stream of the inventory and production management. This fact provides motivation for the development of multi-stage production model with the aforementioned attributes. Thus, the novelty of this study is the introduction of imperfect production proportion at each stage of the multi-stage production system and imprecise product demand. The objective of the research is to minimize the total cost of the imperfect multi-stage production system by determining optimal lot size under uncertain environments. Fuzzy theory is applied to grasp the uncertainty in demand information and analytical optimization technique is applied to obtain global optimum results of the model. The model is analyzed through sensitivity analysis and significant conclusions are obtained that verifies the substantial contribution of the proposed model in the inventory research literature.
Framework of the paper is as follows: The mathematical model is developed in
Section 2.
Section 3 provides experimental study and optimal results.
Section 4 presents discussion and analysis of the proposed production model. Finally, in
Section 5, concluding remarks and future research directions of this paper are discussed.
2. Materials and Methods
This research work studies an
-stage imperfect production system where defective items are produced along with the perfect quality items. These defective items are reworked at an additional processing cost, and product demand is fulfilled at the
production stage.
Figure 2 and
Figure 3 show inventory behavior of production stage-
k and production stage-
n, respectively. The objective of the model is to minimize the total system cost by determining optimal lot size.
2.1. Assumptions
Following assumptions are considered in the development of multi-stage production model.
A single type of item is produced in an n-stage production system.
Production runs are fairly consistent, i.e., system is assumed to be a lean manufacturing system where inventory behavior follows a similar trend in repetitive production cycles.
Uncertain product demand is measured as a Triangular Fuzzy Number (TFN).
Inline inspections provides effective results, determines the defective items immediately, and helps the managers to make immediate decisions over it. This model assumes that defective items are detected during the hundred percent inline inspection.
In textile industries, defective items are generally reworked. This model assumes reworking of defective items at each production stage. The reworking process is considered as perfect and no item is scrapped.
Defective rate is constant at each production stage, but it may vary from stage to stage.
Setup time of each production stage is percent of the total time of that production stage.
Transportation time and cost among the production stages is assumed to be negligible.
2.2. Model Formulation

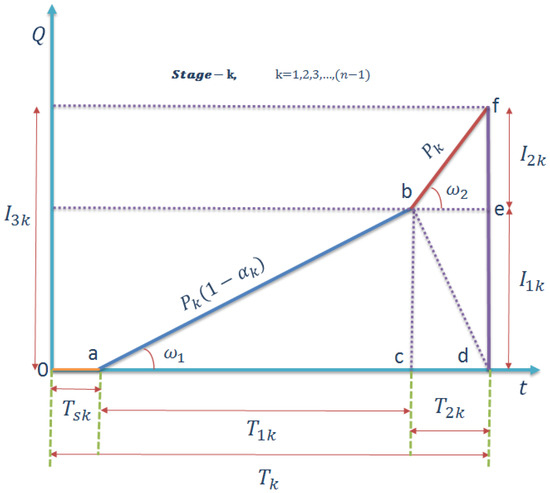

Keeping in view the above-mentioned assumptions, a mathematical model is formulated.

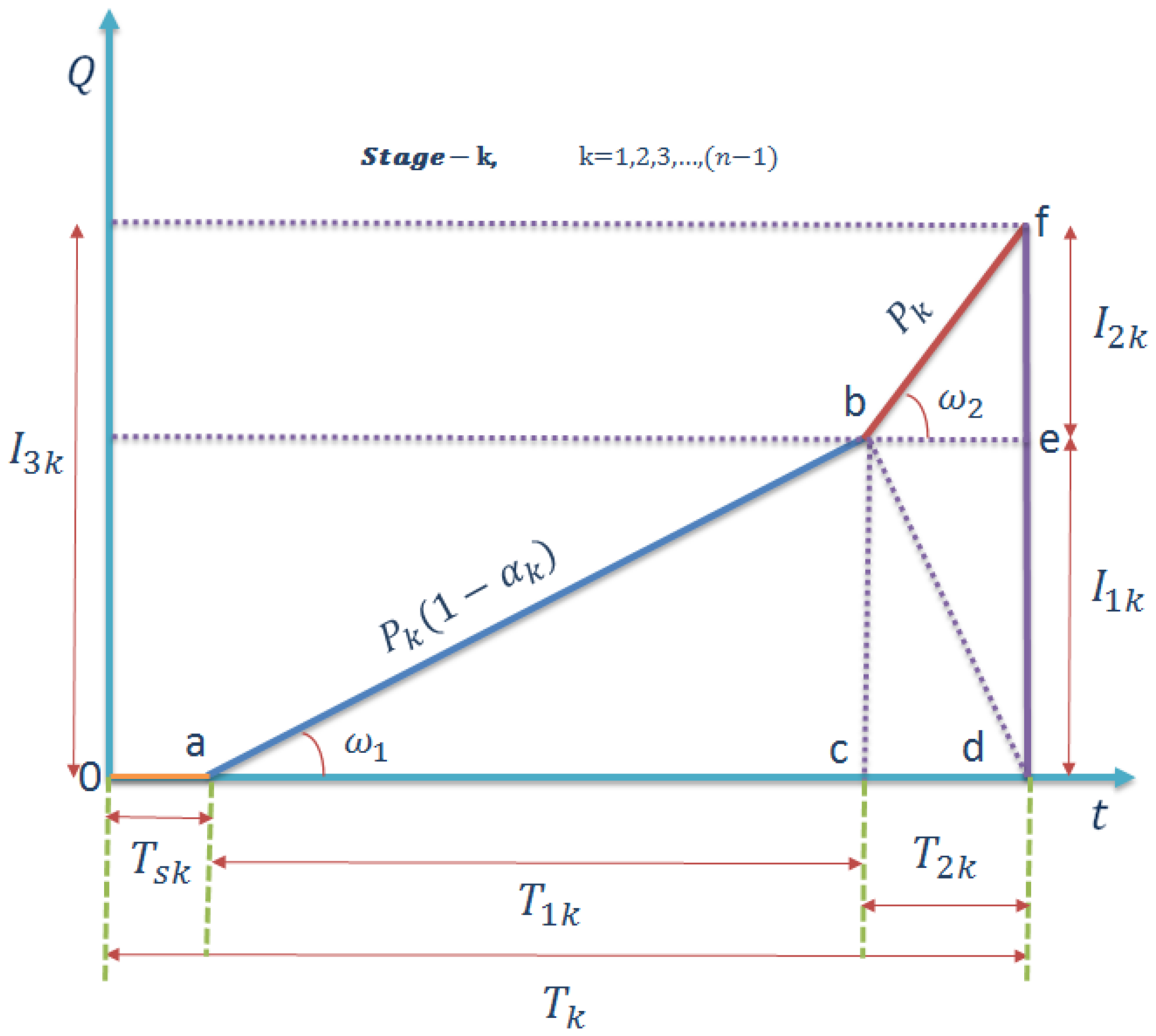

Figure 2 shows the inventory behavior of
production stage. Maximum inventory level (
) of the
production stage (
) is computed as
, where
is the inventory level after production phase and
is the inventory level after reworking phase.
Production time of stage-
k is
, and its reworking time is
. It is obvious from triangle
abc in
Figure 2, that
, which gives
. Similarly, from triangle
bef, one can observe that
, which provides
. From above the maximum inventory level of
production stage is obtained as
.
Total inventory of
production stage is the sum of the triangular areas
abc,
bcd, and
bdf (
Figure 2). One can simply compute these areas and the total inventory of
production stage is now formulated as:
Total production time of stage-
can be obtained by the sum
, where the setup time of stage-
,
. Total time of stage-
(
) is obtained as:

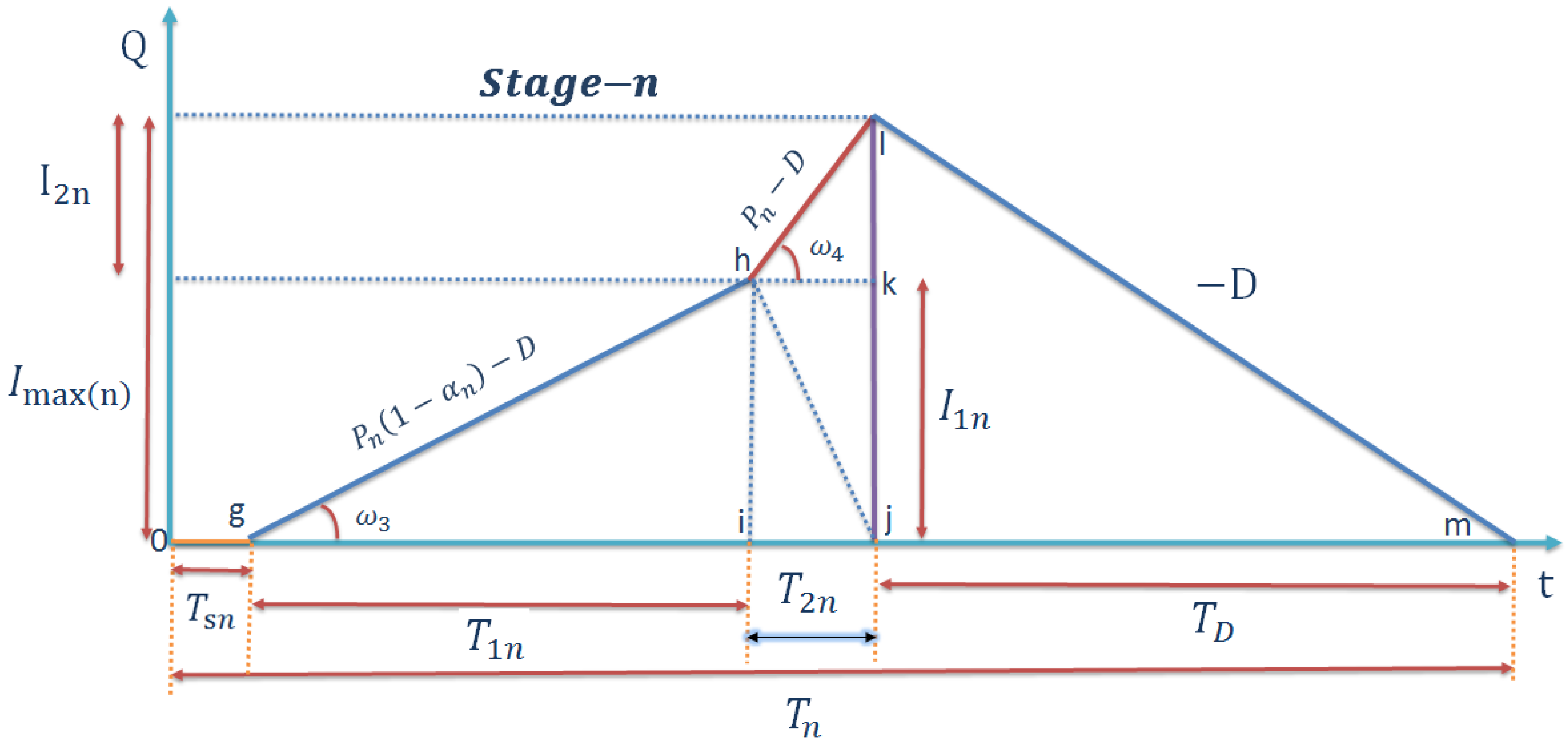

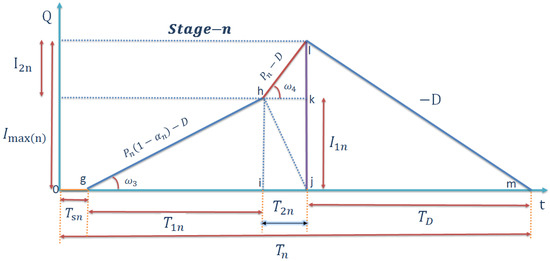

Applying similar method for production stage-
(
Figure 3), one can simply obtain production time
, reworking time
, pure consumption time
, inventory level after production phase
, and inventory level after reworking phase as
for production stage-
n. Finally, maximum inventory level of stage-
n is computed as
.
Proceeding towards determination of total inventory level of finished items (
), we have
Total time of production stage-
is obtained as
Total time of the complete production system can be determined by the sum
, and is given by
Average inventory level of the finished items (
) in the system is calculated as
, which provides
Total cost of the system by considering setup cost, order processing cost, inspection cost, and inventory holding cost is formulated as follows:
Setup cost () ($K/lot/stage)
Setup cost is a major part of the total cost in a production system. It is required to be incurred prior to the production of every lot. For an
n-stage production system, the total setup cost is
Order processing cost () ($C/item/stage)
Order processing cost and reworking cost are considered as the same in this model. The total order processing cost is the sum of processing cost of good items as well as the reworking cost of defective items:
Inspection cost () ($J/item/stage)
Inspection cost is incurred on both good quality items as well as on reworked items and is assumed to be the same. Total inspection cost:
Inventory holding cost () ($H/item/year)
Under linear assumptions, total inventory holding cost is proportional to the holding cost of average inventory of finished items in the cycle as
Total system cost function by considering aforementioned cost components is given by
and after some simplifications
Cárdenas-Barrón [
14] viewed annual demand as a constant parameter. However, in several real world scenarios, some uncertainties may alter annual demand slightly. Thus, annual demand may be considered as a fuzzy number. To replace the annual demand
D by a fuzzy number
, consider the fuzzy number
as a TFN
, where
and

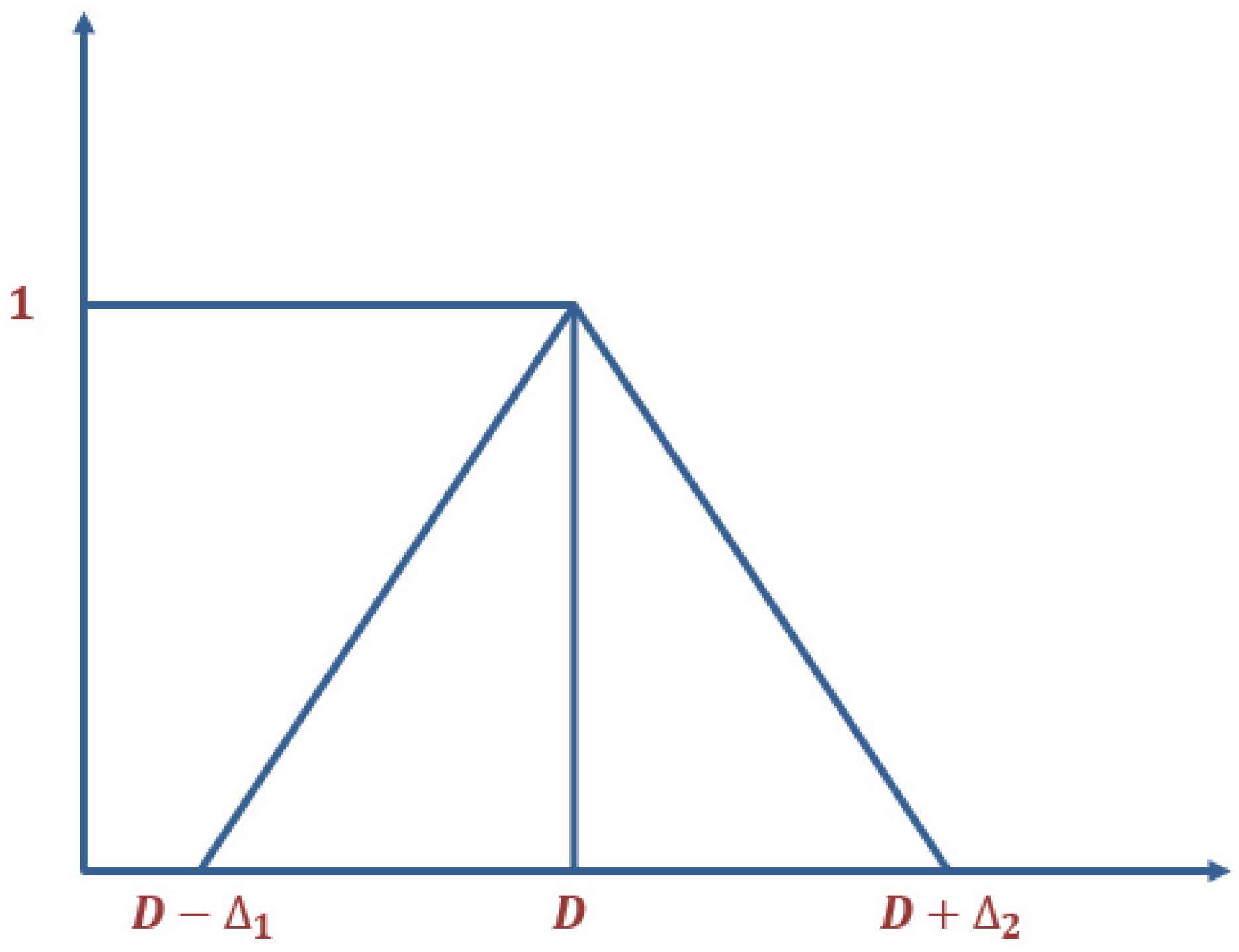

as shown in
Figure 4. The Fuzzy Membership Function (FMF) of
is formulated as
The centroid of
is given by
. This result is considered to obtain the annual demand in fuzzy sense. For any
, let
Using the extension principle of Kaufmann and Gupta [
63] and Zimmermann [
64], the membership function of the fuzzy cost
is formulated as
From
and the system cost function, we obtain
For simplification purpose, let us assume
,
,
,
,
,
and
.
From the standard triangular FMF and values of
and
, the FMF of
is given by

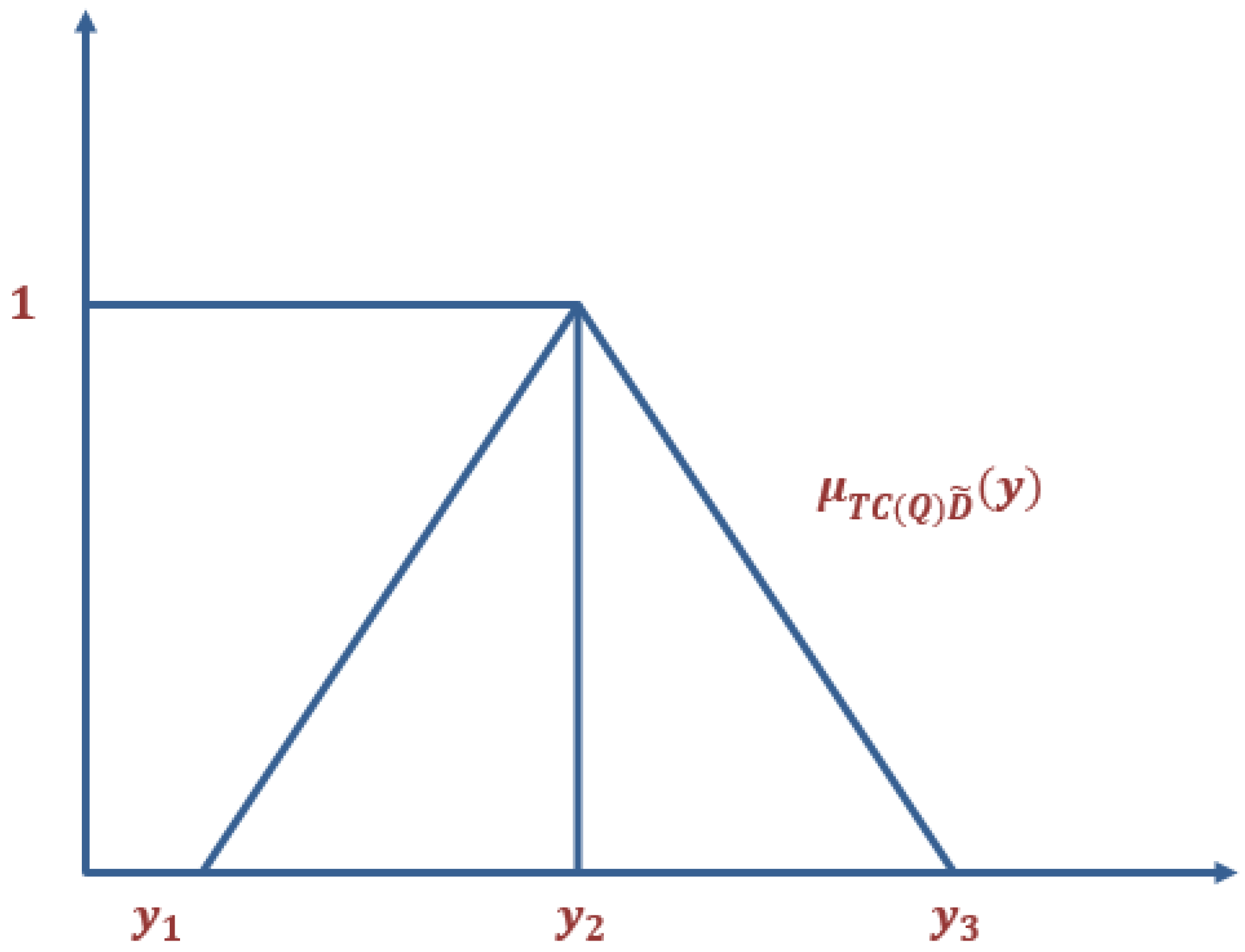

Figure 5 represents the FMF of
.
Now centroid of
is formulated as
After defuzzification, crisp total cost function becomes
As lot size
is a decision variable, we differentiate the cost function (17) with respect to
Q. Thus, from the necessary conditions, we have
After some simplification, Equation (18) can be written in standard quadratic form as
Quadratic equation (19) provide two roots, one is negative and the other is positive. It is a well-known fact that quadratic equation has only one positive root. Thus, the two solutions for the optimal lot size are obtained as below
Negative root seems quite impossible candidate solution for optimal lot size problem, and is thus discarded. The positive root is taken as the optimal lot size
,
To satisfy sufficient conditions,
As the solution to the above expression is positive, the sufficient condition is also satisfied. Thus the system cost attains minimum value in the interval (0, T) for Q*.
5. Conclusions
Agreeing to lean philosophy, high inventory levels are considered as one of the major non-value added aspect of the production system. For true implementation of lean culture, inventory as a form of non-value added activity should be reduced to its minimum. Therefore, there must be a defined optimal lot size in accordance with the input requirements of each production stage at minimum system cost. Cárdenas-Barrón [
14] provided interpretation of considering defective rate in his inventory model to achieve optimal cost at the single-stage production facility. This inference is carried forward in this paper for its implication on a multi-stage production system.
This study is made-up to support production and planning managers, especially in the textile production sector where defective production and uncertain product demand are faced. It introduces an imperfect multi-stage production model with the consideration of defective proportion in the production process and uncertain product demand. Thus, the novelty of this study is the introduction of imperfect production proportion at each stage of the multi-stage production system and imprecise product demand. Fuzzy theory is applied to handle the uncertainty in demand information and center of gravity approach is utilized to defuzzify the objective function. This defuzzified cost objective is solved through the analytical optimization technique and closed form solution of the optimal lot size is obtained.

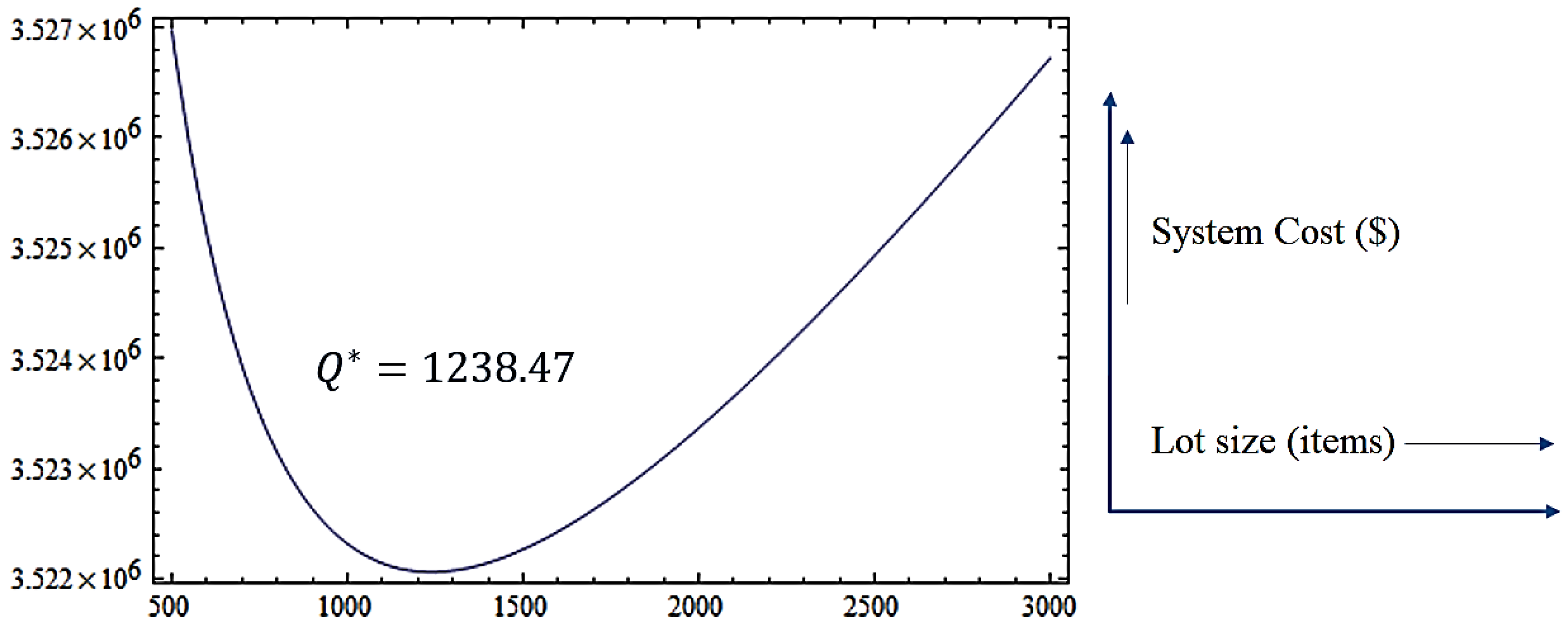

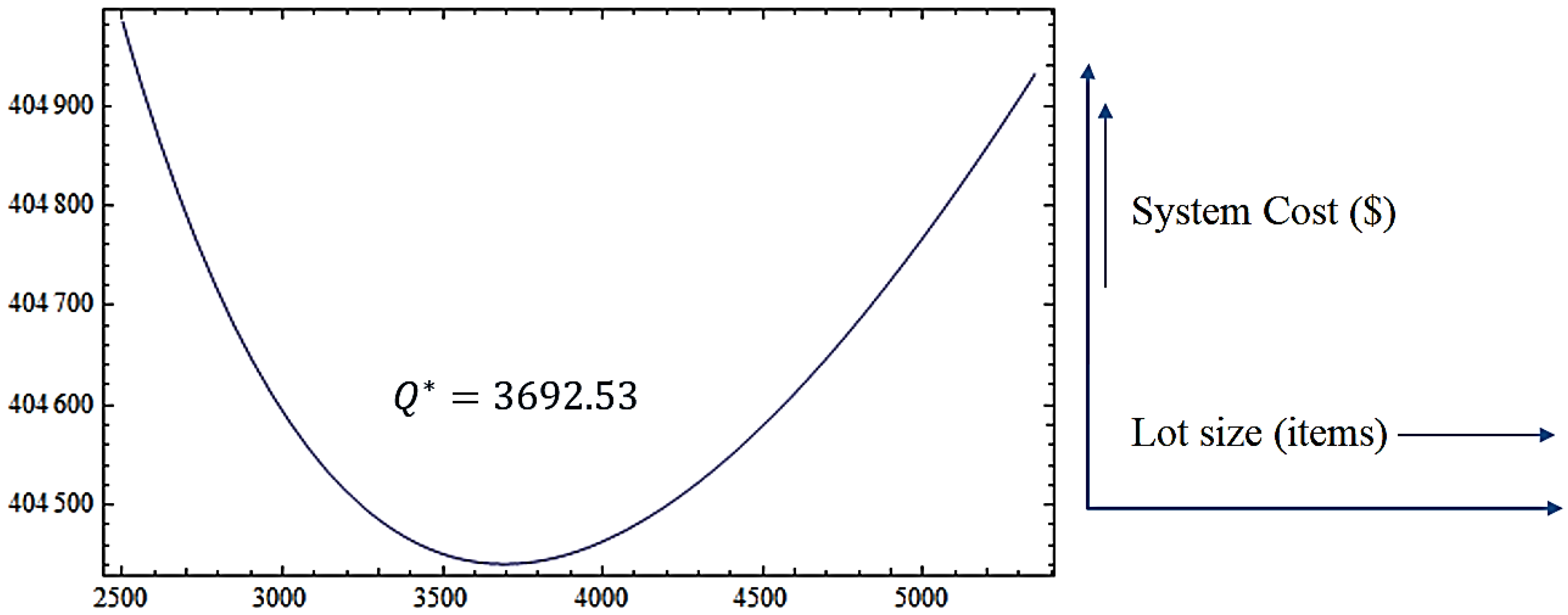

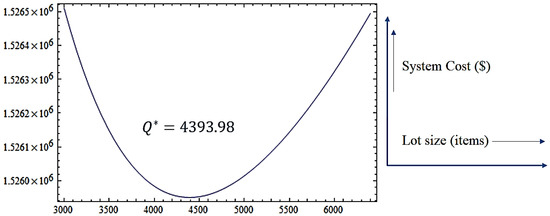

Numerical experiment comprising of three examples is conducted and optimal results are analyzed through sensitivity analysis. Optimal results indicate that as the number of stages increase, lots of larger sizes are cost effective. Sensitivity analysis indicates that the order processing cost bears the highest effect on the system cost and its effect increases slightly as the system moves towards higher number of stages. Creditably, this study can work as an elementary support in implementing lean culture in the production system. Analysis of the model illustrates the major advantage of this study by highlighting the importance of lean activities to reduce the system cost, as the results suggest application of SMED for setup cost reduction in the multi-stage production system prior to making efforts for inventory holding cost reduction.
Despite various benefits, this study has some limitations. It has considered constant defective proportion in the production system, whereas defective rate becomes imprecise in long run production processes. Secondly, the proposed model has incorporated a perfect reworking opportunity that is very rare in the real life production systems, as defective products are also produced during reworking. The analysis of the results state that the effect of order processing cost on the total system cost is highest among all other system parameters. However, this study has not provided order processing cost reduction policy to minimize system cost for future runs. Further, the model can be extended with several ideas including consideration of shortages backordered [
39,
65,
66], variable production rate [
67,
68,
69], trade credit policies [
70,
71], allocation problem [
72,
73], and different rework options [
19]. The immediate possible extension to this paper can be the incorporation of uncertain defective rate [
61,
62].
