1. Introduction
Ultrasonic phased array (UPA) systems with a large number of elements can achieve multigroup scanning, increase the scanning flexibility, and enhance the resolution and contrast of the resulting images. Hierarchical signal processing flow that accounts for the constraints of a directed acyclic graph (DAG) can be realized by adding a bus and an arbitrator to the hardware architecture. In a distributed software environment, multigroup UPA scans can use different scanning modes in different groupings; thus, several different signal processing methods can be implemented. These processes must also be hierarchically processed using the heterogenous shared resources according to the priority constraints. The priority constraints between the tasks in each group are represented using the DAG diagrams, and each shared resource can only perform the specified signal processing tasks because of functional constraints. Further, the priority constraints related to the multigroup tasks combine with the functional constraints on shared resources to form a hierarchical heterogeneous multi-DAG workflow problem (HHMDP). To address this problem, a scheduling algorithm is required to coordinate task processing with the heterogeneous shared resources so that the various signal processing steps involved in the distributed UPA instruments can be executed in an orderly manner.
With the rapid development of information technology and the increasing complexity of the associated problems, distributed computing resources with high performance are required to complete the computing tasks subject to the deadline constraints. Further, distributed resource scheduling for DAG tasks has been the subject of several previous researches and has developed into a mature method. More than 100 scheduling algorithms have been developed based on the homogeneous or heterogeneous distributed environments, the structural differences of the scheduling tasks, and the different optimization objectives [
1]. Among these algorithms, the DAG scheduling model and the heterogeneous earliest finish time (HEFT) algorithm proposed by Topcuoglu [
2] in 2002 have been extensively adopted. These are the models and methods that have been recently employed in distributed systems for performing tasks such as grid and cloud computing.
An existing study has denoted that the DAG scheduling problem is a nondeterministic polynomial complete problem [
3]. Further, popular task scheduling algorithms used to obtain the makespan can be classified into the following two categories: static scheduling and dynamic scheduling algorithms [
4]. Among the static scheduling algorithms, the list scheduling algorithms that employ heuristic techniques have been proved to produce the most efficient scheduling, and their complexities, associated with the number of involved tasks involved, are generally quadratic [
5]. In addition, the list scheduling algorithm is fast, easy to implement, and has wider applicability than that of other scheduling algorithms. Some of the most famous list scheduling algorithms are HEFT [
2], predicted earliest finish time (PEFT) [
3], heterogeneous critical parent tree (HCPT) [
6], high-performance task scheduling (HPS) [
7], and performance effective task scheduling (PETS) [
8]. HEFT is known to produce a scheduling length that can be compared with that produced by other scheduling algorithms exhibiting a lower time complexity. Further, the HEFT algorithm can be enhanced by either introducing a new mechanism for calculating the task priority or adding a new mechanism (such as prior attributes) to improve the processor selection [
9].
The idle time slot of a single DAG task is large, and its resource utilization is low owing to the data transmission delay between the tasks and the imbalanced DAG structure. To effectively improve these shortcomings, Honig [
10] and H. Zhao [
11] initially proposed a scheduling algorithm in 2006 for multi-DAGs sharing a set of distributed resources. A DAG task can use idle slots generated by other DAG tasks scheduled on the same distributed resource group. Further, strategies to minimize makespan and scheduling fairness were also proposed. Although Yu et al. [
12] made some improvements in this regard, the multi-DAG scheduling algorithm proposed in their study did not consider the deadline constraints. By considering the earliest deadline first (EDF) [
13] algorithm—an application of the sequential scheduling algorithm based on the deadline—Stavrinides [
14] proposed the usage of the deadline of each DAG for determining the priority of the multi-DAG task scheduling and the usage of the time slots for accurate calculation of the DAG tasks. This approach is suitable for DAGs with similar DAG structures and sizes. However, the deadline is insufficient to respond to the emergency of DAG because the number of DAG tasks is different. Furthermore, the relative strictness of Multi-DAGs with deadlines (MDRS) [
15] scheduling strategy improves the fairness of scheduling according to the relative strictness of each DAG. However, before the scheduling tasks are selected, the HEFT algorithm is used to preschedule the remaining tasks for each DAG after which the relative duration of each DAG is calculated, and the most urgent task in the DAG is scheduled for execution. Therefore, each DAG can decentralize hybrid scheduling before the deadline, thereby improving resource utilization. However, some DAGs would be discarded when resource shortage is observed. Tian et al. [
16] improved the existing fair scheduling algorithm by solving the fairness problem that is encountered while scheduling multiple DAG workflows that have the same priority but are submitted at different times. In addition, Xu et al. [
17] proposed a cooperative scheduling algorithm to further improve the utilization of the computing resources for the workflow in a distributed heterogeneous environment exhibiting better performance in terms of throughput, time slot wastage, fairness, and time complexity when compared with those exhibited by MDRS, EDF, and fairness algorithms.
For ultrasonic phased array and DAG workflow scheduling, Tang et al. [
17] studied ultrasonic bus transmission scheduling using the MFBSS algorithm to schedule between FIFOs, so that the utilization rate of transmission channels was not less than 92%. Li et al. [
18], based on time division multiplexing, proposed an IBF algorithm for focus and delay module scheduling, which increased the maximum completion time by 8.76 to 21.48%, reduced resource consumption by 30 to 40%. Li et al. [
19] also proposed SSPA algorithm for heterogeneous signal processing. Compared with the FCFS algorithm and SPT algorithm, the SSPA algorithm improves bandwidth utilization by 9.72% and reduces maximum completion time by 11%. Anwar and Deng [
20] proposed a novel Hybrid Bio-inspired Metaheuristic for Multiobjective Optimization (HBMMO) algorithm based on a nondominant sorting strategy for the workflow scheduling problem, which decrease makespan, execution cost, and inefficient utilization of the virtual machines (VMs). Miao et al. [
21] investigates H
∞ consensus problem of heterogeneous multiagent systems under Markov switching topologies; consensus algorithms with communication time delay via output were also proposed. By applying stochastic stability analysis, model transformation techniques and graph theory, sufficient conditions of mean square consensus and H
∞ consensus are obtained, respectively. Drozdov [
22] address image processing workflow scheduling problems on a multicore digital signal processor cluster. They proposed Pessimistic Heterogeneous Earliest Finish Time scheduling algorithm for Ligo and Montage applications and presented its better performance than others. Feng et al. [
23] studied gene function prediction, which includes the hierarchical multilabel classification (HMC) task, and proposed an algorithm for solving this problem based on the Gene Ontology (GO), the hierarchy of which is a directed acyclic graph (DAG). The algorithm has better performance compared with true path rule and CLUS-HMC algorithm on eight yeast data sets annotated by the GO.
However, these scheduling algorithms do not consider the challenge in performing heterogeneous resource processing tasks at different layers using different resources, i.e., some processors can only handle specific tasks, and these tasks or transactions can be sequentially executed if a single DAG can be approximated as a distributed permutation flow shop scheduling problem in a distributed environment and if the processor selection phase can be considered to be hierarchical. Thus, in general, there exists little research and few achievements related to the multi-DAG hierarchical scheduling problem and its application in the signal processing scheduling of ultrasonic systems even though many related problems require urgent attention. This study uses the critical path method by considering the hierarchical and specified function constraints of the shared resources to propose an improved method for HEFT that incorporates predecessor pointer adjustment (PPA), which can be referred to as the heterogeneous predecessor earliest finish time (HPEFT). This method can coordinate the different signal processing steps to satisfy the priority constraints represented by the multi-DAG model under the multigroup scanning architecture of a UPA system with multiple layers and shared resources for performing the specified functions. This coordination reduces the maximum completion time (makespan) and improves the utilization rate of the shared resources, improving the real-time frame rate and reducing the energy consumption.
The remainder of the manuscript is organized as follows.
Section 2 discusses the hierarchical heterogeneous multi-DAG workflow scheduling problem and presents both the previous and proposed algorithms along with some basic examples;
Section 3 discusses the experimental settings, problem generators, parameters, the experiments performed herein, and the results;
Section 4 presents the signal processing scheduling optimization strategies for a multigroup scan UPA system; and
Section 5 summarizes this study and discusses future work.
2. A Hierarchical Heterogeneous Multi-DAG Workflow Problem (HHMDP) and HPEFT Algorithm
2.1. Problem Description
Suppose there are multiple workflows that can be modeled as DAG {
Gk,
k ∈ 1, 2…K}. Each DAG node,
ki, represents a task,
Tki, and each edge represents the sequential relation between two different nodes. Thus, it can be said that
ki exhibits a hierarchical structure. The nodes belonging to the first layer have no predecessor nodes, and they have start time
STki. The tasks in the first layer must wait until the specified
STki before they can be executed by the processor. Further, the tasks in the final layer have no successor nodes. All the nodes must be dispatched to a collection of heterogeneous shared resources M = {{
Mjl,
j = 1, 2…
Ql},
l = 1, 2, 3…L}; the set of shared resources for each layer of
Mjl contains several shared resources that can execute the corresponding layer nodes. The shared resources in a layer can only perform tasks corresponding to the nodes in the same layer, and the nodes in the same layer to be executed by the shared resource must belong to the same layer. Further, the nodes in the same DAG have a sequential relation. With the exception of the first and the final layer nodes, the remaining nodes in a DAG must have predecessor and successor nodes and cannot be isolated from other nodes. A node can have multiple predecessor and successor nodes, and its predecessor nodes can only be in the upper layer, whereas its successor nodes can only be in the subsequent layer. However, a node cannot be both the predecessor and successor node of another node simultaneously. All the tasks must be sequentially processed according to the DAG graph, and the computing tasks of the upper node must be processed before the current node can be processed. For any given node, the processing time
Pki for the computing tasks is determined by the data length
Dki in the node, as follows
The difference in Dki and the shared resource speed, SDj, can change the execution time of a given node Pki,j. Cj is the delay that is required for the current processor to run. The delay is considered to be generally small. The system used in the present research was interconnected by buses with the following conditions. The tasks of the same node cannot be executed twice on the same shared resource, and the predecessor or successor nodes of any given node cannot be executed on the same shared resource because the hierarchical structure is in different sets of shared resources. Therefore, in the problem that is considered herein, the delay is not equivalent to the communication time, as observed in the case of a classical HEFT algorithm. Hence, we propose a strategy, which ensures that each node produces Cj in any processor, with the communication time for shared resource switching observed to be zero.
Each shared resource in the system can be simultaneously executed and communicated. The scheduling problem is to minimize the makespan. Furthermore, the DAG actual finish time (DAFT) after the scheduling of the algorithm represents the makespan after all the nodes in a DAG are executed.
The maximum number of layers of tasks (node) from the top to the bottom of the DAG and the number of layers of shared resources is equal to L. Further, the longest path from the top to the bottom denotes the critical path of the DAG.
ki at the earliest start time (EST) of the shared resource
Mj is given as follows
Tavailable (
Mj) is the time when the shared resource
Mj is ready for performing new tasks. For the top (first) level nodes, all the processors have not yet performed node tasks, and there are no previous nodes; however, the processors have the EST,
STki, for node tasks. In such a situation, EST becomes equal to
STki. The earliest finish time (EFT) is the earliest time when task
ki can be processed using an assigned shared resource.
The actual start time (AST) refers to the real time when a given node task begins executing after a DAG task is scheduled. In this algorithm, AST is considered to be equal to EST. The actual finish time (AFT) refers to the actual completion time of a node after task scheduling.
Table 1 presents the symbols used in this study.
2.2. HPEFT Algorithm
A previous study [
2] demonstrated that HEFT can be used to obtain the critical path of scheduling and generate upward rank (Rank
u) with respect to the critical path. However, the problems presented in this study are different from the ones available in the literature on HEFT using PEFT, given as follows [
4]; (1) multi-DAG scheduling; (2) each DAG has a different start time
STki; (3) the communication consumption between the shared resources
Mj is 0; however, considering the different latency of each processor, the shared resources can be classified as
Pki; and (4) the shared resources and DAG are hierarchical.
When compared with the HEFT algorithm, the proposed algorithm can satisfy the requirements of hierarchical scheduling. In addition, hierarchical scheduling, where any two layers are connected by edges, contains a prioritized set of nodes. The current node is scheduled to execute after the execution of all the predecessor nodes, thereby making the scheduling compact. As depicted in

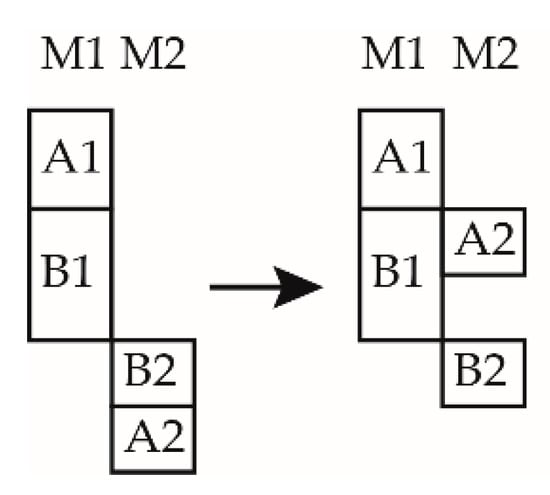

Figure 1, the tasks in any two DAGs are assumed to be tasks A1 and A2; here, they are the tasks of DAG A, and the tasks of B1 and B2 are the tasks of DAG B. If A1 and B1 belong to the same layer and are scheduled on the same processor, B1 and B2 are the tasks of DAG B. A2 and B2 belong to the same layer and are scheduled on the same processor. A1 is scheduled on the shared resource M1 before B1. In the shared resource M2, the task A2 is scheduled first and is followed by B2. The completion time is observed to be short. The higher the ratio of processors to tasks in a given layer, the shorter will be the maximum completion time in the layer. The highest execution efficiency can be achieved when the number of processors and tasks in a given layer is the same.
The proposed algorithm can be given as follows:
In stage 1, the upward weights are calculated as
Communication delay, i.e., the average of the execution time of in all the machines at the same layer of ki, has been incorporated into Pki,j. ks denotes the direct successor of ki. Pki,j denotes the processing time of ki in the shared resource Mj; Rankp denotes the upward rank. If the node is at the final level, , NumMac (ki) denotes the shared resource in the same layer as node ki. The average execution time of all the previous tasks is related to the shared resource NumMac (ki) at that layer.
Stage 2 involves the selection of tasks with the highest Rankp in the list. According to the maximum completion time of all the scheduled predecessor tasks, the available slots are searched, and the location of the shared resource Mj with the earliest time slots is allocated to the available (Mj) task nodes.
In stage 3, after completing all the scheduled tasks in stage 1 and 2, the time slots among the scheduled resources are researched according to each shared resource, as denoted in Equation (6).
If a shared resource
Mj_
PPA has a time slot in the scheduled task, we can find the maximum actual completion time of their predecessor tasks (PAFT) for tasks arranged by the previous DAG, as denoted in Equation (7); next, we calculate the PPA table and reschedule
Mj_PPA accordingly.
2.3. Example Demonstration

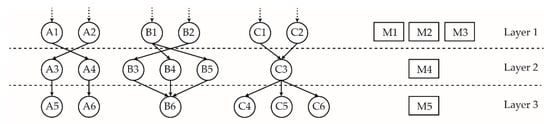

The three DAGs and their node constraints are depicted in
Figure 2; the dashed arrow denotes the start time of the tasks. A1–A6 belong to G1 (DAG A), B1–B6 belong to G2 (DAG B), C1–C6 belong to G3 (DAG C), and M1–M5 denote a set of shared resources. The hierarchy of the shared resources and task nodes can also be observed. The priority constraints between the tasks in each DAG are represented by the solid arrowhead lines. For example, the successor tasks of A1 are A4, and the successor tasks of C3 are C4. The specific functional constraints (layering) and the task layering of all the shared resources are also depicted in
Figure 2, i.e., A1, A2, B1, B2, and C1. C1 can be executed by the shared resources M1, M2, and M3, which belong to Layer 1, or by other layers.
Table 2 is a hierarchical table of shared resources presenting the serial number of shared resources and their corresponding layers.
Table 3 presents the data length of each task node, which can be calculated using Equation (1) to obtain the execution time
Pki,j.
Table 4 presents
SDj and
Cj of the shared resources.
Table 5 denotes the
STki values. For a start node
kistart = {
ki, Pred(
ki) = ∅} without predecessor tasks, there exists a corresponding start time.
Table 6,
Table 7 and
Table 8 denote that after calculating the processing time (
Pki,j), all the corresponding “-” lines indicate that node
ki cannot be executed on the shared resource
Mj. Therefore, the specific functional constraints (hierarchical relations) can also be observed from these tables.

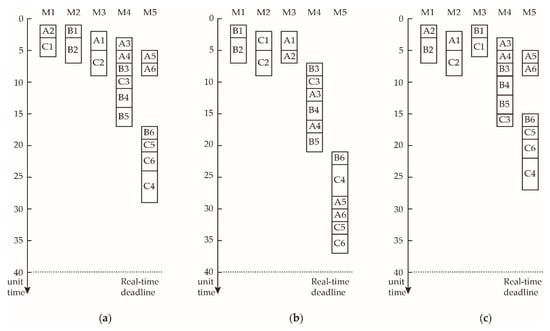

Figure 3a–c denotes the schematics of three scheduling algorithms: shortest processing time (SPT), round-robin (R-R), and HEFT. No constraint connection is depicted on the graph for clarity. The constraint relation between the tasks is shown on the edges of
Figure 2.

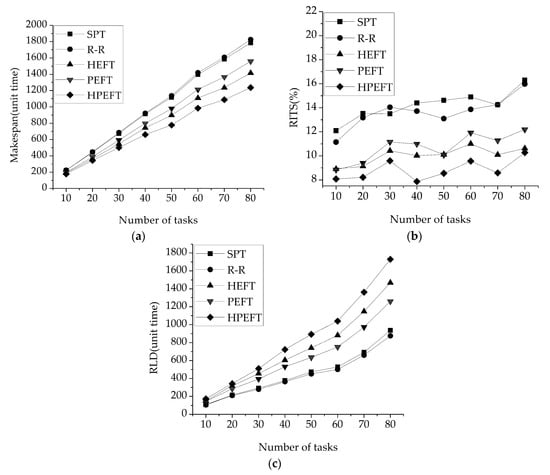

The SPT algorithm sorts all the DAG tasks on the layer from small to large according to the processing time; further, the algorithm schedules the tasks according to the earliest time slot of the shared resources that they possess until all the task nodes in all the layers complete task scheduling.
The R-R algorithm can be used to schedule the tasks in the DAG according to the serial number of the DAG and to allocate tasks to the earliest time slot of shared resources in the corresponding layer.
The associated communication time
Cks,ki = 0. In addition, for the end node, Rank
p can be calculated using Equation (8), whereas, for other nodes, Rank
p can be calculated using Equation (5).

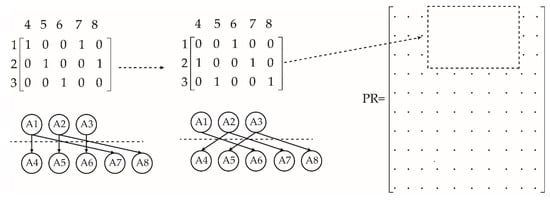

Here, NumMac (Mj) denotes the number of matching shared resources, i.e., Layer (j) = Layer (ki).
Table 9 presents the PPA table, and

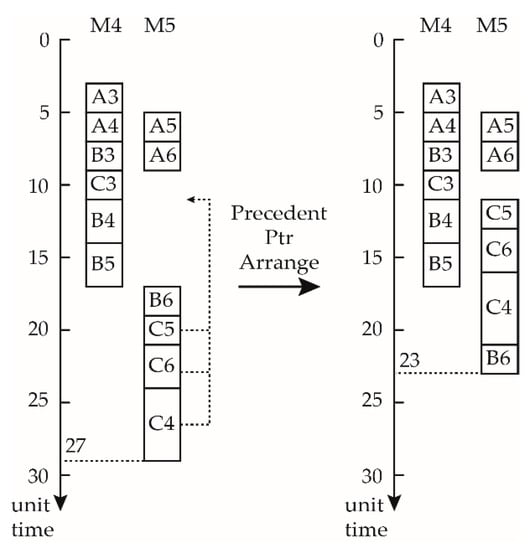

Figure 4 depicts the adjustment method using a PPA table diagram. The graph shown herein reveals that the HPEFT algorithm is arranged according to Rank
p (
ki); B5 is scheduled next to B6, subsequently followed by C5, C6, and C4. However, this approach is not optimal. According to the algorithm proposed in the previous section, C5, C6, and C4 are not directly connected with C3 scheduling. Hence, there is a time slot between A6 and B6. Therefore, according to Equation (6), all node tasks in the shared resource M5 can evaluate their PPA table according to the tasks that were scheduled in M5 in the previous stage with respect to the PPA table presented in
Table 9.
As depicted in
Figure 4, the first step is to arrange A5 and A6 at time 5 and 7; schedule C5, C6, and C4 at time 11; and finally schedule B6 to C4, which can reduce the makespan from 27 to 23.
2.4. Description of the HPEFT Algorithm
Algorithm 1 HPEFT |
Input: DAG group , resource group , processing time matrix of tasks in a shared resource set , DAG deadline, constraint matrix , and start time matrix Output: Scheduling List HPEFT () 1. Unscheduled DAG list unscheTasks←Tki (k = 1,2…K, i = 1, 2…Nk) 2. Calculate Rankp of each Tki in unscheTasks, and arrange them in the ascending order 3. Using Equation (1), the data length Di, shared resource speed SDj, and delay Cj are substituted, and the processing time matrix P is obtained. 4. For l = 1, 2…L 5. Find whether all the tasks performed at this unscheLayerTasks←{Tki, Layer(ki) ∈ l} in unschTasks. 6. WHILE (unscheLayerTasks ≠ ∅) 7. Sort all the tasks Tki in unscheLayerTasks according to Rankp (Tki), and find the current minimum Tki as Tki_urgent. 8. Using Equation (3), find an EST (Tki,Mj) suitable for scheduling. 9. Assign Tki_urgent to the Scheduling List HPEFT (). 10. Delete the Tki_urgent Task from unscheLayerTasks. 11. END WHILE 12. END FOR 13. Find the idle time slot in the Mj Gantt chart using Equation (6). 14. If Mj has an idle time slot, all the tasks scheduled to Mj should be returned to rearrange(j)←{Tki, Tki ∈ Shed (Mj)}; then, clear the Mj scheduling table, i.e., the scheduling list. 15. According to their predecessor AFT, calculate the corresponding PAFT(ki) in the ascending order for the PPA table. 16. WHILE (rearrange(j) ≠ ∅) 17. Schedule the minimum PAFT(ki) of task, Tki_rearrange_urgent, in the PPA table to Mj ∈ Tavailable(Mj) in the scheduling list; if overlay exists, postpone the other tasks for Tki_rearrange_urgent. 18. Delete Tki_rearrange_urgent. 19. END WHILE 20. Makespan is calculated using Equation (2), RITS is calculated using Equation (9), and RLBD is calculated using Equation (10). 21. Return the scheduling list End Procedure |

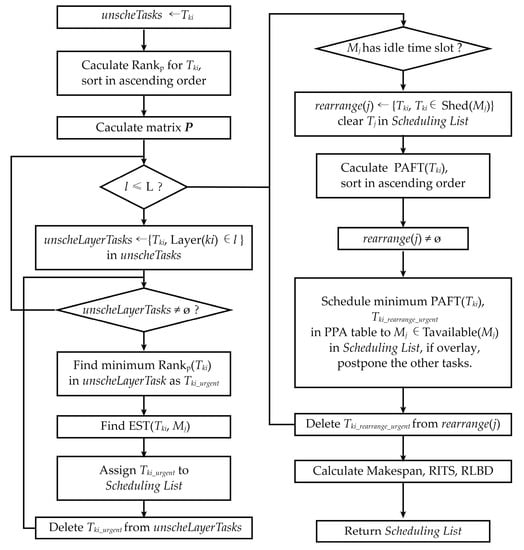

The HPEFT flowchart is depicted in
Figure 5.
2.5. Time Complexity

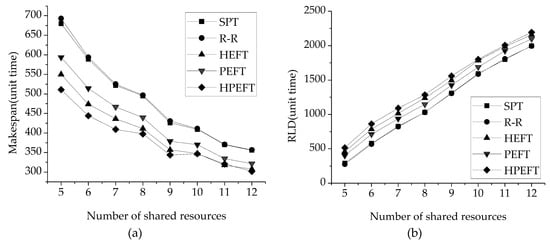

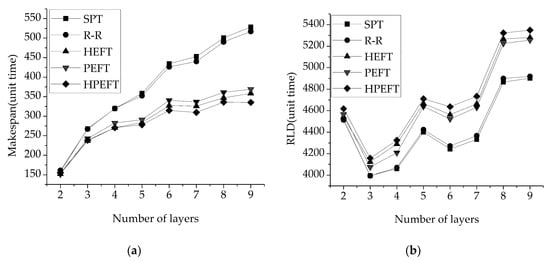

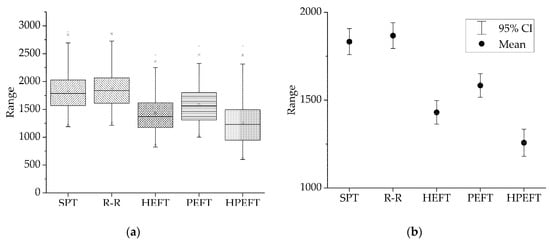

Assuming that each DAG has N nodes and that the number of computing resources is Q, the worst-case time complexity of the HEFT algorithm is computed to be O(N
2Q) [
2]. If there are K such DAGs that need to be simultaneously scheduled, the time complexity of HPEFT becomes O(K
2N
2Q). HPEFT needs to adjust the order of scheduling in shared resource with time slots and obey the compact scheduling rule because it can find all the time slots and sort PPA table in stage 3. The order of time complexity increases the algorithm’s complexity; therefore, the complexity of the algorithm is O(K
2N
2Q
2).
4. Optimization of the Signal Processing Scheduling Process for a Multigroup Scan UPA System Based on HPEFT

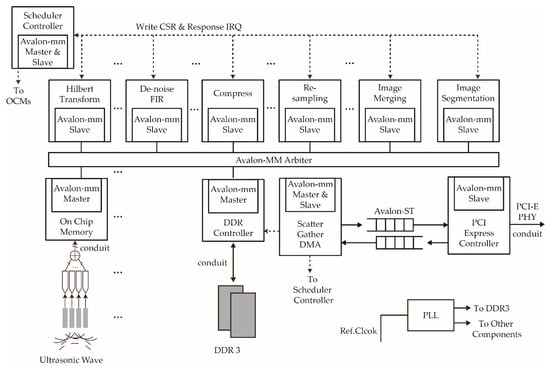

Figure 12 depicts the architecture of a multigroup scan UPA system using the TFM method [
24]. After the acquisition, multigroup scan ultrasound signals are sent to the on-chip memories (OCMs) of the FPGA chip. The shared signal processing modules, such as Hilbert transform and FIR noise reduction, are connected to the Avalon-MM bus of the system. The scheduling control module reads the signals by writing the OCMs in the control and status register and interrupt request (IRQ) control chips, and the signals are sent to the corresponding signal processing module with respect to the DAG tasks. After completing DAG processing, the signal is sent to the DDR3 buffer controlled by the DDR controller from which signals are sent directly to a PCI-E bus controller using the Scatter–Gather DMA through the Avalon-ST bus. The PCI-E controller receives the signal of the Scatter–Gather DMA. After all DAG tasks are processed, all signals are sent to the PC through the PCI-E PHY physical terminal.

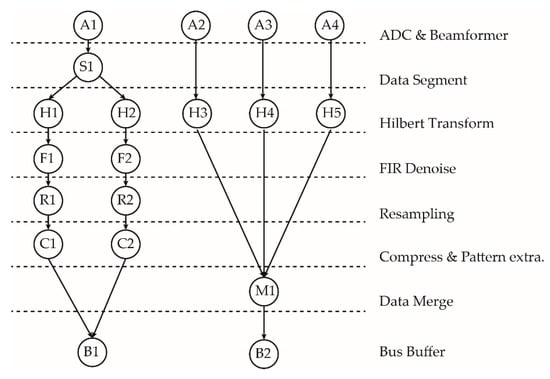

A virtual example of multiple DAG scheduling for a multigroup-scan UPA system is depicted in
Figure 13.
The first DAG is the graph formed after a set of piezoelectric chips acquires the segment data and then applies the focusing delays, the Hilbert transform, FIR denoising, resampling, compression & pattern extraction and data merge. Further, the data is sent to the bus buffer. The second DAG expresses the functions obtained when the signals collected by the three sets of piezoelectric wafers are subjected to focusing delays; only then is the Hilbert transform performed along with data merging, and the data are finally sent to the bus buffer.
To simplify the experiment, the process modules in a single layer (performing the same special function) are considered to be homogeneous, and the ADC and beam-forming steps are considered to be the start time of DAG.
Table 14 denotes the processing time of the signal processing modules,
Table 15 presents the number of signal processing modules used to facilitate the calculation in the FPGA by considering k = 1024. The time unit is a single clock cycle in the FPGA and is 10 ns (100 MHz) in these experiments.

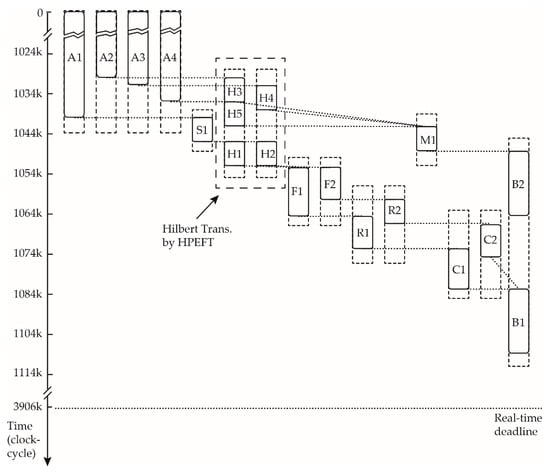

Figure 14 provides a Gantt chart of the whole system as scheduled by HPEFT. In this figure, we can observe the effect of hierarchical scheduling to address the functional constraints.
To clearly denote the effect of scheduling, we selected the Hilbert transform as part of the overall system scheduling to verify the results of the algorithm after the simulation of the FPGA scheduler. We used Hilbert transform tasks H1–H5 to illustrate the scheduling situation and generate the simulation results from Modelsim 10.2 SE (Mentor Co., Ltd., Wilsonville, OR, USA). In this case, two DAGs arrive at the Hilbert transform tasks H1–H5 after handling tasks A1, A2, A3, A4, and S1. Tasks H1–H5 are ranked as in
Table 16 by the HEFT algorithm; therefore, the scheduling order of the HEFT algorithm is H1, H2, H3, H4, H5, and the simulation results are presented in

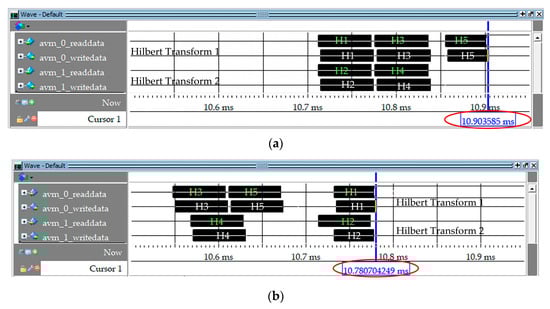

Figure 15a. The PPA table obtained by the HPEFT algorithm is depicted in
Table 17. The scheduling orders are H3, H5, H1 in Hilbert Transform module 1 and H4, H2 in Hilbert Transform module 2. The simulation results are denoted in
Figure 15b.
The experimental parameters are set as follows: the processing times of all the tasks (H1-H5)
Pki,j are 6k clock cycles, and the Hilbert transform shared resources number is two. There are four scanning groups; each group has 32 elements with 16k sample depth; therefore, all the ADC & beam-forming times are 1024k clock cycles [
25]. As depicted in

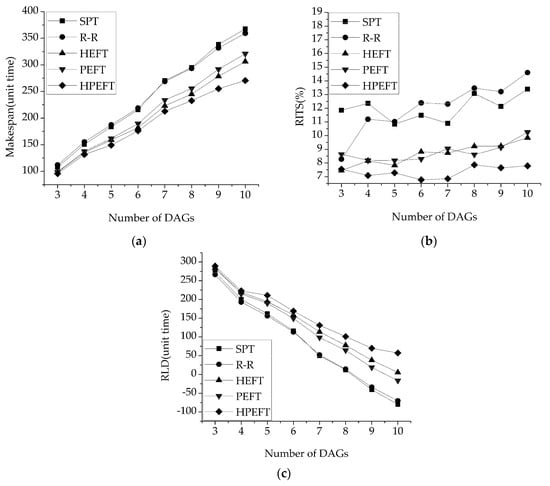

Figure 15a,b, the completion time of all the schedules using HPEFT is approximately 10.78 ms, whereas that of the schedules employing HEFT is 10.90 ms. If 1 ms is given to the remaining signal processing modules, the frame periods, as shown in
Figure 15a,b, will be 11.90 ms and 11.78 ms, respectively. Therefore, using the HPEFT algorithm, the frame period was increased by 1% in this experiment. If ADC and beam-forming require less time, the increase in frame period will be made obvious by scheduling.
In our experiment verification environment,

Figure 16 shows the experiment circuit board and Signaltap II (Intel Corporation, Santa Clara, CA., USA) diagram with the small-scale local experiment.
5. Conclusions
Based on the existing multi-DAG resource scheduling algorithms, this study proposes a deadline, constraint, multi-DAG, sharing-limited HHDMP scheduling problem and proposes an HPEFT algorithm for solving it. This algorithm inherits the advantages of both the HEFT algorithms for calculating the upward rank for critical paths, and it is improved for performing hierarchical tasks and for obtaining shared resources. Based on the characteristics of the hierarchical resources, wherein the DAG predecessors and successors must be compact, a stage 3 PPA algorithm was proposed. After stage 1 and 2 scheduling, PPA can find a large time slot to make the same DAG task of the same shared resource schedule compact, shortening the time of the multi-layer resource scheduling problem. This study also adopted two indicators with respect to the hierarchical scheduling problem: RITS and RLD. When compared with several classical algorithms, such as SPT, R-R, HEFT, and PEFT, the experimental results denote that the makespan of the proposed algorithm was reduced by 5 to 16%, RITS was reduced by 0 to 6.53%, RLD was increased by 2.27 to 8.58%, and MDR was decreased by 13 to 58%. Even so, the algorithm still exhibits some limitations. First, when the number of shared resources and layers increases, the RITS index of the HPEFT algorithm shows no clear advantage over that of HEFT. Second, the time complexity is increased, and the computing time increases by approximately 50%. Third, in the experiments that were not presented above, the PPA method can significantly increase the scheduling imbalance between DAGs. An example of a multigroup scanning UPA system based on the Altera Qsys architecture was also presented, and the HPEFT algorithm scheduling was verified in this architecture by scheduling the Hilbert transform tasks in two DAGs.
In future works, we intend to focus on selecting the initial resources for the algorithm with respect to different types of ultrasound scanning; the relation between the shared resources in each layer and the successors, predecessors, and number of tasks in the layer, and studying the layer delay of shared resources. More complex and numerous signal processing modules based on FPGA will have to be tested in the future to verify the effectiveness of the scheduling algorithms discussed in this study.
