1. Introduction
Developing nations are disproportionately impacted by the rapid increase in population, widespread poverty, poorly executed development initiatives, and a limited capacity to adapt. Furthermore, ongoing armed conflict results in significant interruption, eviction, and loss of life. Armed conflict, however, in terms of impact, is a type of disaster markedly different from a natural disaster in that the results are felt in the breadth and depth of effective coping techniques, which vary exceedingly [
1]. Over the past 10 years, the world has witnessed significant hostilities in Afghanistan, Angola, Ethiopia, Nigeria, and most recently, Ukraine, Russia, Palestine, and Israel. For example, this dramatic rise in violence has triggered massive population displacement in the affected regions. The war in Ukraine has led to the destruction of several thousands of houses and other infrastructure. Meanwhile, there are approximately 600,000 internally displaced persons (IDP) living in Myanmar and several thousand in Indonesia and the Philippines. In 2021, the conflict in Ethiopia resulted in the loss of millions of dollars in property damage. Across the continent, the insurgence in the northern part of Nigeria has continuously increased the number of IDPs and damaged structures. The Kyiv School of Economics (KSE) estimated that 4413 houses and 189 healthcare institutions have been destroyed due to the war [
2], resulting in
$63 billion in damage to Ukraine’s infrastructure. Similarly, according to the report by [
3], the Ethiopia Ministry of Finance has projected that over
$20 billion would be required for the post-war reconstruction.
Ref. [
4] defines reconstruction as rebuilding what has been damaged or destroyed, which involves response and recovery. The response phase involves debris clearance and removal, establishing temporary buildings for displaced persons, securing damaged buildings, basic sanitation, and communication. Ref. [
5], defined recovery as a major part of the entire emergency management process. Sullivan further reiterated that the distressed nation needs to reach a point where they can support themselves with external help. In 2023, Mingarelli suggested that governance architecture, recovery plans, financing structures, and monitoring methods be set up to prevent the suffering of the Ukrainian people [
6]. In terms of recovery, ref. [
7] defined in line with the Ministry of Civil Defence and Emergency Management as coordinated efforts and processes to affect a community’s immediate medium and long-term holistic regeneration following a disaster, this phase includes several projects after the initial response to a conflict. The recovery components for the war-ravaged region include social, economic, natural, and construction environment. Reconstruction is a burdensome challenge that requires concerted input from all stakeholders. The schedule or programme needed to coordinate the reconstruction after a major disaster or conflict has not been properly delineated in policy and legislation worldwide [
8]. Some of the available policies and legislation were not adequately tailored to cope with the reconstruction of nations after armed conflict and disaster [
9]. They further suggested that the government can create an agreement or understanding that spelled out the modalities for exchanging resources and distributing aid. However, processing building consent during the initial reconstruction phase poses a considerable problem [
10].
Ref. [
7] studied the CI roles in disaster preparedness and recovery and discovered that improper information and knowledge dissemination are the main reasons for the below-par performance level of the recent disaster management process. Ref. [
11] assessed the effect of labour shortage on sustainable construction, while noting some of the causes of this shortage, namely migration out of the country because of war was not examined. The prospect of CI development in Ukraine was researched by [
12], considering the recent quarantine technique for tackling the COVID -19 pandemic as the main obstacle for construction firms. However, the recent war damages on the nation were not considered. Ref. [
13] studied the CI by examining marketing challenges, while highlighting that the construction sector’s marketing research and intelligence system is more extensive than in other sectors. Using the political, economic, social, technological, environmental, legal and security (PESTEL) analysis, Ref. [
14] examined the challenges of the construction sector in the adoption of Industry 4.0. Waste management policies such as the Construction Waste Disposal Charging Scheme (CWDCS), where polluters pay principle, were examined by [
15]. Though these policies have shown to be reasonably efficient, consideration was not given to war-ravaged regions. Ref. [
16] highlights the economic, social, and environmental issues that need to be addressed in order to achieve sustainable construction. The study examines stable national conditions and does not include nations under the distress of war. Other research in the CI includes challenges of sustainable construction from the stakeholders’ viewpoint, as well as quality and productivity challenges, [
17,
18]. Refs. [
18,
19] consider the challenges of performance, development, and growth using the CI in South Africa as a case study.
Despite the environmental and socio-economic challenges that hinder the growth of nations in war-ravaged regions, the CI in these regions must assist in the recovery of the nation’s economic and social problems, including societal-driven historical reconstruction [
20,
21]. Crucially, construction businesses and practitioners must be encouraged to continuously seek ways to minimize the harmful impact of building activity on the environment. Furthermore, openly discussing comprehensive case studies of successful techniques would be beneficial, as would exploring the possibility of creating effective practice guides that can be implemented in different situations. The CI, despite being complex, unique, and contributing environmental waste, has the potential to boost GDP through the creation of jobs, tax revenue, and other marketable goods and services. While previous studies have looked at sustainability, the industrial revolution, small and medium-scale construction, building information modelling (BIM), and intelligent construction as obstacles facing the industry, this study uses PLS-SEM to assess the challenging factors impacting the CI in conflict-affected regions. Through a detailed review of the literature and interviews with seasoned professionals in the CI, the challenging factors affecting the CI in these regions were identified, and EFA was used to group the identified factors. SEM was created to show the relationship between the factors and the components. This study will be of great importance to national governments, industry professionals, and stakeholders in the CI.
3. Methods

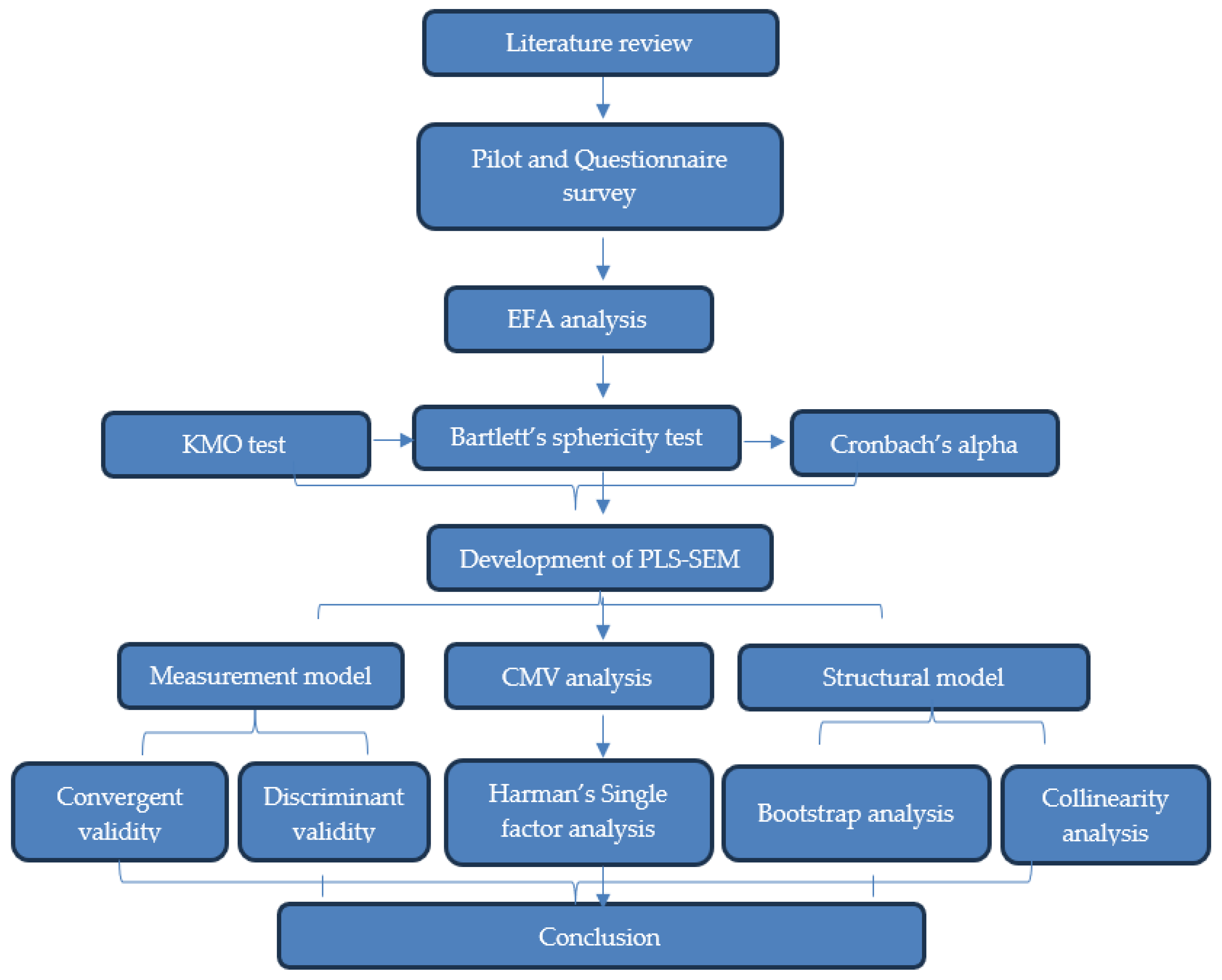

This research adopts a three staged approach to accomplish the research objectives as shown in
Figure 2. The stages include questionnaire design, data collection, and data analysis.
3.1. Questionnaire Design
The first phase of the methodology is a detailed review of research articles, books, and conference proceedings published from the year 2000–2024. 206 articles were searched in the collection of the challenging factors impacting the CI in the war-ravaged regions. 167 articles that are not directly related to the study were removed. Through a comprehensive and extensive reading of the remaining 39 relevant articles, a total of 98 challenges were identified. These were then consolidated using a semi-structured interview with industry experts, educationists, and government representatives based in Nigeria, Ethiopia, Yemen, Palestine, and Ukraine or who had previously worked in these nations. These nations are representations of the regions under consideration. The experts were selected based on their experience and knowledge of the CI, sustainability, reconstruction, and recovery. The interview sessions were conducted to acquire a holistic depth and notion of the experts in the current state of the CI within the conflict-affected regions. The pilot survey involves a 20-min interview with 10 professionals with an average of 10 years of work experience in the CI using various conference software tools. The interviews were conversational while addressing the most critical concepts and questions. Experts were asked for their observations and recommendations regarding the current state of the CI and to identify and categorize the challenging factors. Based on their recommendations, 21 factors were merged because of their similarity, while three additional factors were included. These additional factors are improper enforcement of safety regulations, high taxation on sustainable products, and limited funds for safety precautions, while others were eliminated. The data were used to re-organize and modify the questionnaire while ensuring that it reflected the topic’s concerns.
3.2. Data Collection
The modified number of challenges became 35 after the pilot survey, as shown in
Table 1. The second stage was composed of the questionnaire design and data collection. The questionnaire was designed to gather data on the relative levels of importance of the predetermined factors. In designing the questionnaire, there is no consensus on the sample size that should be used for SEM.
Ref. [
52] recommends aiming for a sample size beyond 100, ideally surpassing 200 participants. The data for the questionnaire were obtained through an online survey sent to a representative sample of CI professionals using snowball sampling, ref. [
53] which enabled the researcher to obtain a large number of completed questionnaires. The sample is identified by friends and through referral networks. This sampling strategy is chosen when it is challenging to obtain responses from randomly selected sample elements. The survey was distributed through friends to professionals who have worked or lived in Nigeria, Ethiopia, Yemen, Palestine, and Ukraine, representing regions affected by war. In this study, a total of 150 respondents completed the questionnaire, which is enough for developing the model.
Table 1.
Challenging factors affecting CI in war-ravaged regions.
Table 1.
Challenging factors affecting CI in war-ravaged regions.
Code | Challenging Factors | References |
---|
CF1 | Lack of modern curriculum (Lack of environmental education) | [54,55,56,57,58] |
CF2 | Poor construction demolition and waste management training | [15] |
CF3 | Limited allocation of funds for research and development | [18,39,55] |
CF4 | Poor disaster management training | [21,39,56] |
CF5 | Poor environmental legislation and policy on certification (LEED, BREEAM) | [17,40] |
CF6 | Professional institute’s involvement in environmental support | [55] |
CF7 | High taxation on sustainable products | [39] |
CF8 | Political instability | [39] |
CF9 | Bribery and corruption | [39] |
CF10 | Low government support for construction sector | [39] |
CF11 | Improper enforcement of safety regulations | [59] |
CF12 | Lack of supportive legislation (disaster management, post-conflict reconstruction, waste management) and programme | [8,9,15,16,57,60,61] |
CF13 | Low level of stakeholders and management commitment to health and safety | [49,50,62] |
CF14 | Inadequate Safety training | [49,50,62] |
CF15 | Low level of usage of technology for health safety and environment (e.g., BIM, sensor, and wearable devices) | [47,49] |
CF16 | Limited funds for safety precautions | [39] |
CF17 | High inflation rate | [38,39,41,63] |
CF18 | High interest rate | [19,39,63] |
CF19 | Direct foreign investment | [18,64] |
CF20 | Low credit facilities | [19,39] |
CF21 | Adjustment to new economic policies and globalization | [18,27,44,57] |
CF22 | Lack of support from the banking sector | [39,65] |
CF23 | Lack disaster-resistant buildings | [66] |
CF24 | Reluctant in using innovative building materials | [17,18,19,39] |
CF25 | Inadequate support from institutional organizations | [39,55,57,65] |
CF26 | Low level and scarcity of skilled workers | [11,17,18,39,41,57,58,60,67], |
CF27 | Lower supply of eco-friendly materials | [16,17,37,40,58] |
CF28 | Sustainable supply chain management | [16,68,69] |
CF29 | Low capital base of contractors | [38,65] |
CF30 | Poor contractual management | [1,19,39,56,65] |
CF31 | Implementation of Industrial Revolution (IR) 4.0 (e.g., BIM, 4D design, blockchain, smart building, virtual and augmented reality | [14,16,47,48,57,60,70,71] |
CF32 | Lack of knowledge of new technologies | [11,39] |
CF33 | Poor technological application and transfer | [39] |
CF34 | Value engineering | [16] |
CF35 | Lack of funding for implementation of new technologies | [47,48] |
The questionnaire was separated into two parts, namely “General information” and “challenging factors groups affecting the CI in the region under study”. The first section gathered data on the region of the respondents, years of experience, type of organization, types of projects under the construction sector, and their degree of understanding of challenges in the CI. The second section asked respondents to evaluate the levels of importance of the 35 identified factors. The survey was designed to identify and assess the challenging factors affecting the CI using the 5-point Likert-scale questions. represented by “strongly disagree”, “disagree”, “neutral”, “agree”, and “strongly agree”.
3.3. Data Analysis
3.3.1. Exploratory Factor Analysis (EFA)

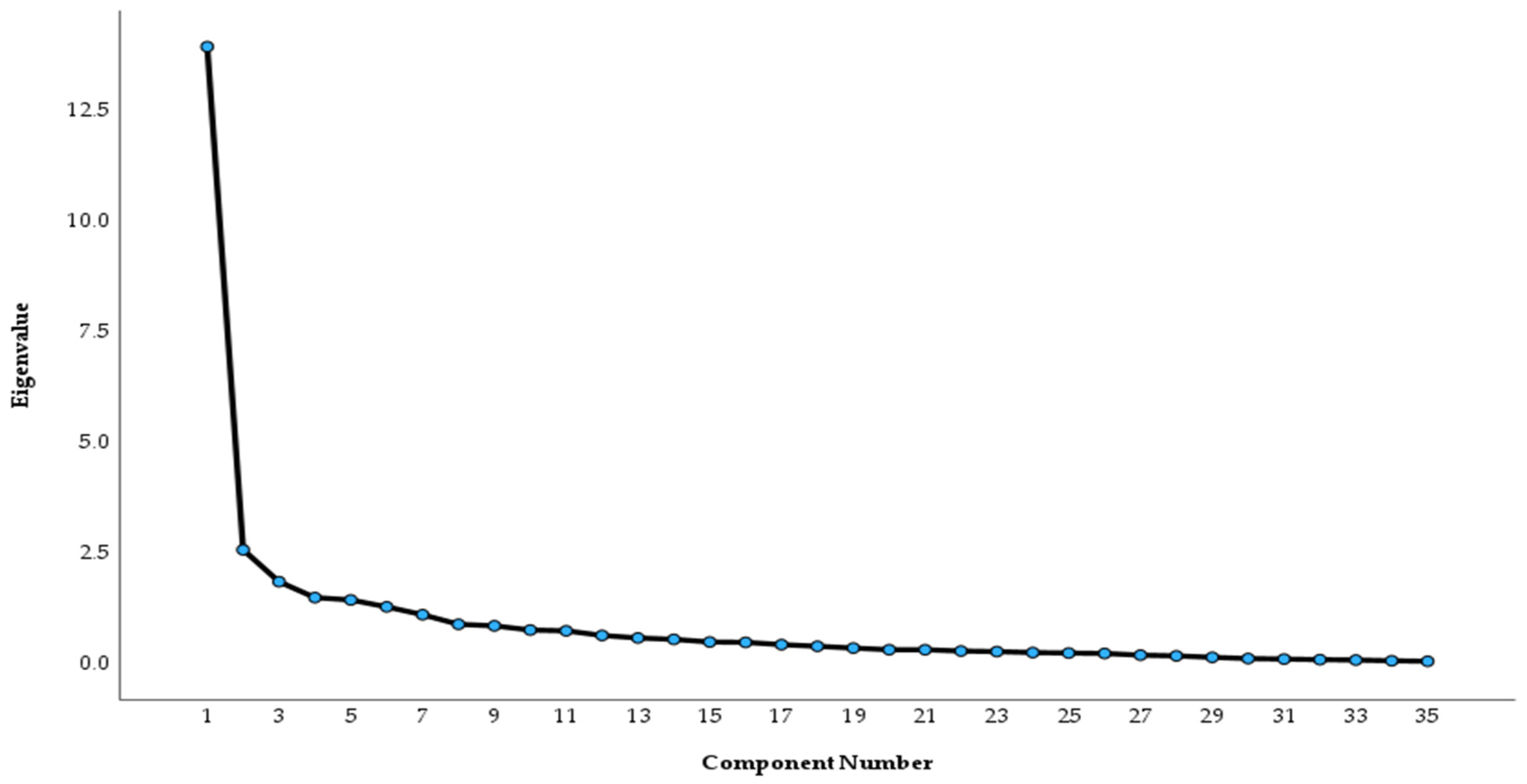

The goal of the EFA was to determine a limited number of factors that explain the variability of the observed factors. The EFA was used to determine the fundamental structure of the challenging factors to the CI in war-ravaged regions. Factor analysis was performed on the 150 completed questionnaires and the identified challenging factors. The reliability and correlation adequacy of the data were tested using Kaiser–Meyer–Olkin (KMO) and Bartlett’s Test of Sphericity. A principal component analysis (PCA) was conducted on the data, and an Eigenvalue criterion was used for component extraction by reducing the number of variables and establishing principal components. Factor rotation was conducted using the varimax rotation. This rotation method was selected over other factor rotation methods like promax because it simplifies the structure making the factors distinct for ease of interpretation of the inter-correlation between the constructs. Next, a factor retention decision was made by extracting factors that similarly increase the total variance of explanatory power through factor analysis. Finally, the elements were then evaluated based on the factor loadings, indicating the strength of the factors’ link with the variables. A factor loading value of ≥0.5 was selected. One of the primary benefits of the EFA in this research was that it streamlined the study’s variables, making it more straightforward to comprehend the correlations between the factors and to make conclusions from the findings [
72]. The findings of the EFA were used to identify the most challenging factors affecting the CI in the regions affected by wars. The findings of the EFA would confirm the reliability and validity of extracted components [
73,
74]. Comparing the results of the EFA to the qualitative data acquired via the semi-structured interviews ensured that the conclusions were in agreement with the opinion of CI experts.
3.3.2. Development of SEM
The SEM is a multivariate data analysis method that makes possible the simultaneous modelling and estimation of complex relationships among variables [
75]. SEM is used for a better understanding of the multiple observed variables (dependent and independent) in the area of CI research, as the use of a small number of variables for complex phenomena can be limited [
76]. The SEM takes measurement error into account while analyzing data and can statistically test theoretical and measurement assumptions against empirical data [
77]. There are two methods within the SEM: Covariance-based (CB-SEM) and Partial least square (PLS-SEM). The features of the data, model characteristics, model estimation, and model evaluation are described by [
78] as the critical and most relevant issues in PLS-SEM. Using the Smart PLS 4, a piece of software with highly distinctive functionalities was deemed appropriate for this study. The software uses the partial least squares methodology, a beneficial method in situations where the hypothesis analysis was not followed closely enough, the sample size is small, or the data does not meet the distributional assumptions [
78,
79]. Furthermore, the software offers a robust estimation and enables the evaluation of the suggested model with high precision. These are important criteria in assuring the accuracy and proper understanding of the research findings.
In this study, three major assessments were taken into consideration in the analysis of the PLS-SEM: the common method variance (CMV), the measurement model, and the structural model. According to [
80,
81], the common method bias (CMB) is an issue in research (e.g., one data source, self-reported data, leniency bias, and social desirability, etc.) that could lead to inaccuracy in results brought about by the fact that data collection could increase the trigger issues. Therefore, it is important to observe these difficulties and to determine whether the CMV is present or not. Harman’s analysis is recommended by [
82], a systematic, single-factor analysis used to examine the presence of CMV. This study examined the possible effect of CMV by utilizing online questionnaires, which prevent multiple respondents and the anonymity of the respondents, thereby preventing the effect of social desirability.

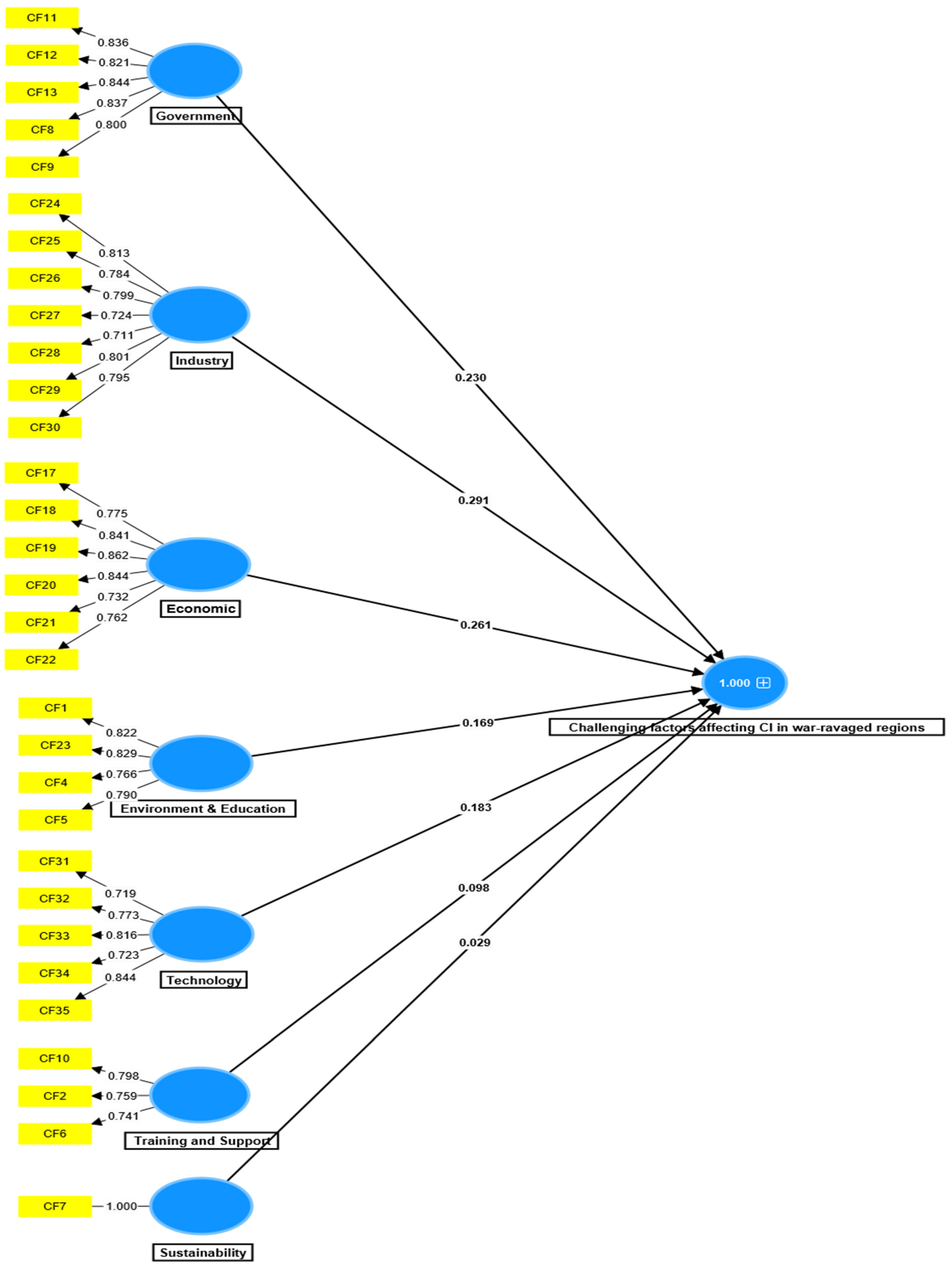

The measurement model can be tested through the analysis of internal consistency, indicator reliability, convergent validity, and discriminant validity. In PLS SEM, composite reliability (CR) is used for measuring internal consistency because indicators with different loadings are considered [
83]. According to [
84], an internal consistency of ≥0.7 is considered satisfactory, whereas, when the value is <0.6, this shows a lack of reliability measures. Indicator reliability is evaluated when a set of variables is consistent with what it tends to measure. Ref. [
77] suggested that the indicator loading should be ≥0.7 at the 0.05 significant level. Elimination of a factor is complete when the indicator’s reliability is low, and this increases the CR of the factor. Next is the evaluation of convergent and discriminant validity. The analysis of convergent validity is the degree to which all measurements agree with one another, which are assessed using the average variance extracted (AVE) [
85]. According to [
86], the convergent validity of the construct is achieved when the AVE is ≥0.50. On the other hand, discriminant validity is the measurement model that differentiates the measure of the construct from one another. This study evaluated the discriminant validity using the Heterotrait-Monotrait Ratio (HTMT). Ref. [
87] suggested that the values of the HTMT should be lesser than the required threshold of HTMT 0.85 or HTMT 0.90 as suggested by [
88].
The structural model can be analyzed after achieving the measurement model. Lateral collinearity, also known as predictor–criterion collinearity, occurs when two hypothesized variables are causally related and measure the same constructs. This can be assessed using the variance inflator factor (VIF). Ref. [
89] concluded that a VIF value of 3.3 or more shows a potential collinearity problem. The significance and validity of the structural model relationship was tested using bootstrapping. The bootstrapping was performed according to [
90,
91] to avoid the increase or decrease in the standard errors due to non-normality issues. In this research, 5000 subsamples were taken from the original sample to calculate the bootstrap standard errors, which will eventually show the approximate t-values for the significance testing of the structural path. Lastly, the path coefficient for this study was examined to show the hypothesized relationship that connect the constructs and the strength of the relationship between two latent variables. The level of significance of the path coefficient should be at least 0.05.
5. Discussion
The result from this study highlights the formative economic construct, which includes high inflation rates (CF17), high interest rates (CF18), and direct foreign investment (CF19) as leading factors. Nations recovering from war have general economic problems, with several sectors of their economy hemorrhaging, and the construction sector is no exception. Refs. [
39,
63] outlined the problem of inflation and high interest rates in a climate where credit facilities are scarcely available. Prior to the war in Ukraine, inflation in several countries had been on the rise. The war heightened inflationary pressure, causing disruptions to trade routes, transportation delays, and increased energy prices during times of hostility. According to the International Monetary Fund (IMF) [
92], the war in Ukraine, Russia, Israel, and Palestine has further resulted in high interest rates, which could make the global economy lose its momentum. Reduction in the prices of imported goods and in the demand for exported goods, heterogeneity of manufacturers and distribution networks, promotion of energy efficiency, and investment in a major and long-term construction project will add to the government’s effort. To increase the economic activities that could be enhanced through the CI by increasing the inflow of FDI and good interest rates, cooperation with financial institutions, and provision of capital cannot be ignored. The study from [
64] shows that the FDI has a major contribution to the GDP of the host nation.
The educational curriculum of several developing nations, such as Ukraine and Nigeria, needs to be revamped. This research identifies the lack of a modern curriculum (CF1) as a critical factor under the environment and education construct. A proper, adequate curriculum will boost the nation’s readiness for the development of disaster resistant buildings and post disaster management and training. Ref. [
17] further stressed the need for environmental education in the attainment of sustainable construction processes, while [
65] examines the impact of collaboration between construction education and humanitarian organizations in promoting positive changes in nations lacking sufficient resources. Currently, some professionals have been encouraging the need for certification of buildings using the leadership in energy and environmental design (LEED) or the building research establishment environmental assessment method (BREEAM). The incorporation of this certification into national policy would be a good step to follow for countries under reconstruction or recovering from war in order to harness the gains of implementing sustainability practices.
The CI has been considered as a major sector of a nation’s economy in terms of GDP. This sector of the economy is majorly affected whenever there is war or armed conflict due to widespread property and infrastructure destruction. This study identifies some factors under the industry construct: reluctancy in the use of sustainable material (CF24), inadequate support from institutions (CF25), scarcity and a low level of skilled workers (CF26), which have resulted from the emigration of citizens from the unsettled countries. Organizations within this sector face challenges of capital [
38] coupled with poor contractual management [
19], which both play a significant role in the commercial activities of the construction companies—hence the need to have a well-developed and improved construction sector for effective reconstruction and boosting of the economic activities.
Information technology is an important aspect of the nation’s economy; the Implementation of Industrial Revolution (IR) 4.0 (e.g., BIM, 4D design, blockchain, smart building, virtual, and augmented reality) is essential in the reconstruction of a nation’s recovery from war and post disaster reconstruction. This implementation, however, is hampered by several challenges such as funding and poor technological transfer, as highlighted in this study. This also aligned with the results from [
14,
16,
48], which consider technical and social factors in the implementation of IR 4.0. The utilization of sustainable products is vital in the rebuilding of countries recovering from wars. However, high taxation on these products has hampered the availability of these materials. According to [
18], this has been a major setback for the CI in Brazil despite the stakeholders’ efforts to incorporate sustainable products into the construction sector.
The role of government in the reconstruction of countries recovering from war cannot be overemphasized. This study identified the need to have a stable political terrain devoid of the bribery and corruption, which have plagued many developing nations. Some of these countries receive aid from various international organizations but lack adequate accountability in the management of these funds. The need for supportive legislation on safety, disaster management, post-conflict reconstruction, and waste management is essential to the total recovery of the nation. Some of the policies include subnational reconstruction funds, regional development and decentralization reforms, and resilient infrastructural development. This is in line with the work of [
15], which highlights some of the new policies in play by the government of Hong Kong with respect to construction waste management. On the other hand, Ref. [
9] found that procedural constraint such as issues of consent and logistics could hamper the quick reconstruction process of nations. Furthermore, when legislation is in place, proper enforcement of these policies and regulations should be maintained through proper training and support.
The training and support construct identify factors such as low governmental support (CF10), professional institutes’ involvement in the environmental support (CF6), and poor construction and demolition waste management training (CF2). These are major factors to be considered by a nation’s recovery from war to properly manage the waste generated from the destruction resulting from the armed conflicts. Adequate training of personnel and environmental sensitization have been identified by researchers as major contributors to the achievement of sustainable development. Ref. [
65] recommended that mandatory training programmes on market inflation and high cost of building materials be conducted for construction professionals.

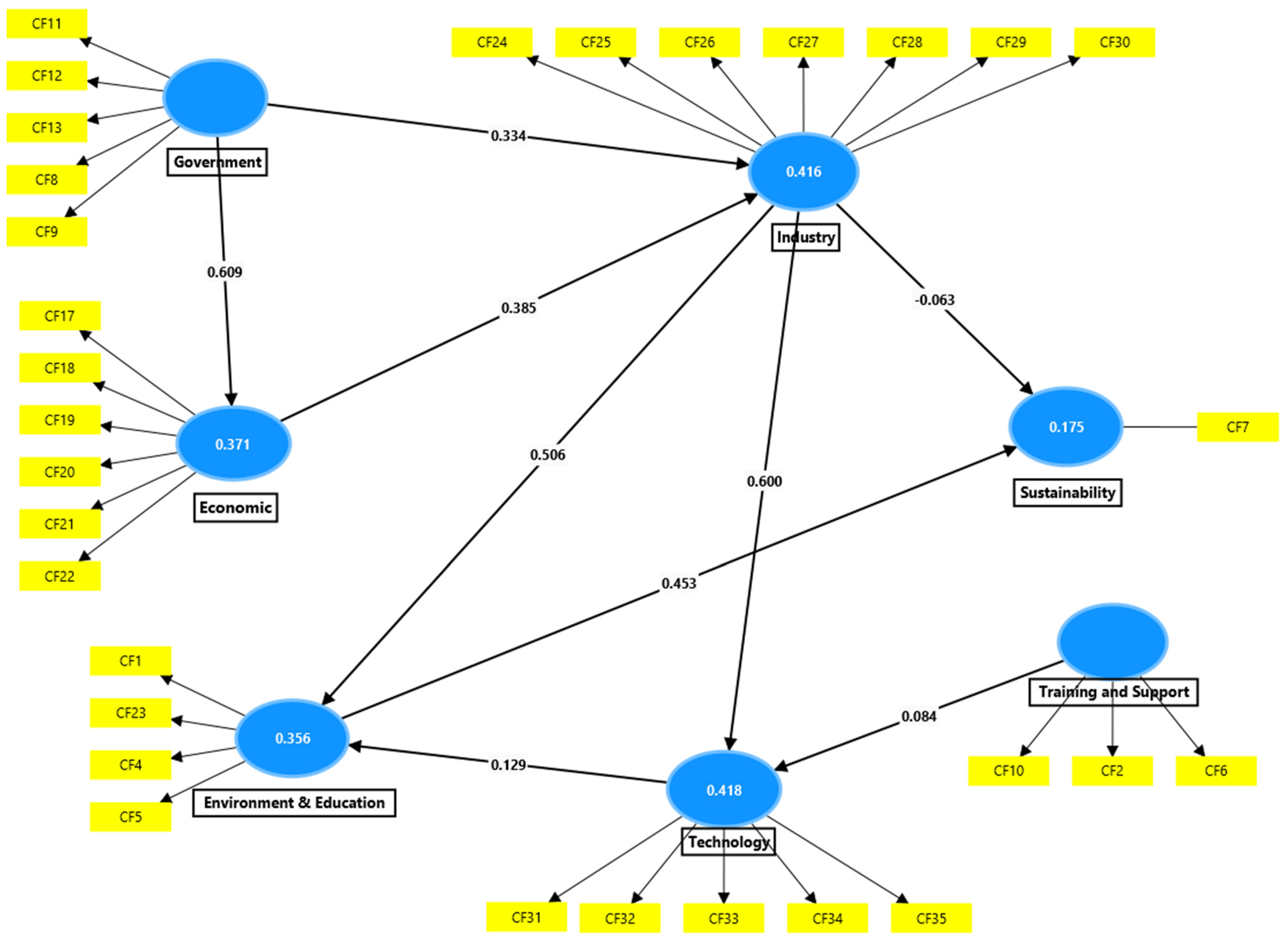

The relationship between the constructs indicates how factors from one construct can interact and significantly affect the other. Increased levels of FDI, reasonable interest rates, and good credit facilities will most likely trigger an improvement in the industry. The positive, significant effect of government on industry and economics could be a game changer in rebuilding and recovering the CI in nations affected by war. The role of government is further clarified by the established relationship with these constructs. The industry also has a positive effect on technology, making the CI position in adopting technological input a worthy investment.
6. Conclusions
The research delves into the current state of the CI in nations pronged by wars, conflicts, insurgence, or terrorist attacks by examining the relevant challenging factors. Using quantitative analysis, 35 factors were identified and examined using EFA. Of these factors 31 significantly affect the CI in nations affected by wars. Further analysis using SEM has produced seven constructs: economic, environment and education, government, industry, sustainability, technology, and training and support. The constructs were used to develop a model for the CI’s challenging factors in the regions affected by conflicts. The validity and the reliability of the model was tested and proved to be significant. The developed model also has acceptable convergent and discriminant validity.
The model generated in this study investigates the challenging factors in the CI in war regions. Several challenges affecting various segments of the CI have been studied by different researchers. However, this research modelled the critical issues that will be relevant in the construction sectors of nations recovering from wars. This work may serve as a basis for further research in countries ravaged by conflicts, insurgence, or war. The theoretical constructs from this research can be implemented in developing a mathematical model for determining the effective and appropriate solutions to the CI. This study provides the background for further research into reconstruction and recovery of the infrastructures and economies of these nations.
The reconstruction of nations affected by wars requires deliberate effort and guidance. Hence, the understanding of the various challenging factors affecting the CI in these nations is crucial. Stakeholders within the construction sector in these regions can better analyze and make informed decisions that will guide and improve the sector in the event of the rebuilding of nations. Secondly, industry professionals and researchers can better collaborate and improve the construction process, which will in turn yield a productive result in the transformation of the countries. Furthermore, governmental policies and platforms that will encourage FDI, and, in the long run, improve this sector of the economy, will be better analyzed.
This study has tremendous implications for the CI in war affected regions, though some limitations could be benefit from future research. The regions under consideration could affect the generalization of this work. Future study could focus on specific countries, as the challenging situations for the CI in various nations destroyed by wars differs. Apart from the PLS SEM used for this study, future research can hypothesize each component for better conclusions on how each component affects the others, for example, the effects of technology on overall governmental input. Lastly, a holistic approach on issues relating to reconstruction policies and their effects on the CI should be examined in war-ravaged regions.
