Article

An HACCP-Inspired Post-Evaluation Framework for Highway Preventive Maintenance: Methodology and Case Application

1
School of Civil Engineering, Tianjin Chengjian University, Tianjin 300384, China
2
Tianjin Key Laboratory of Civil and Structure Protection and Reinforcement, Tianjin 300384, China
3
Academy of Eco-Civilization Development for Jing-Jin-Ji Megalopolis, Tianjin Normal University, Tianjin 300387, China
4
State Key Laboratory of Water Cycle and Water Security, China Institute of Water Resources and Hydropower Research (IWHR), Beijing 100038, China
5
State Key Laboratory of Hydroscience and Engineering, Tsinghua University, Beijing 100084, China
*
Author to whom correspondence should be addressed.
Appl. Sci. 2025, 15(21), 11377; https://doi.org/10.3390/app152111377
Submission received: 11 June 2025 / Revised: 22 September 2025 / Accepted: 20 October 2025 / Published: 23 October 2025

Abstract

With the increasing age and traffic load of highway networks in China, preventive maintenance has become a critical strategy for extending pavement service life and improving infrastructure sustainability. However, the lack of standardized post-evaluation systems has hindered the scientific assessment of maintenance effectiveness. This study proposes a systematic post-evaluation framework for highway preventive maintenance projects based on the Hazard Analysis and Critical Control Points (HACCP)-Inspired methodology (Applying Principles of Hazard Analysis and CCP Identification). Adopting a full life-cycle perspective, the framework identifies critical control points (CCPs) across pre-, mid-, and post-implementation phases, targeting six key dimensions: ecological and environmental hazards, resource utilization hazard, engineering safety risks, engineering quality risks, socioeconomic benefit hazards, and social living environment hazards. A multi-level evaluation indicator system is constructed using hierarchical clustering and weighted through the Analytic Hierarchy Process (AHP). The framework is applied to a preventive maintenance project on the Jinghuan Expressway in Tianjin, China, demonstrating strong practical applicability. The final evaluation score of 84.1 out of 100 confirms the technical adequacy of the project while revealing areas for improvement in clean energy adoption and substructure monitoring. This framework provides a robust basis for standardizing post-evaluation practices and promoting sustainable highway maintenance management.

1. Introduction

Highways, as a fundamental component of urban infrastructure, are a key indicator of a city’s overall development capacity and modernization level. Since the initiation of China’s Reform and Opening-Up policy, the country’s highway construction has experienced rapid growth. By the end of 2023, the total operational length of highways in China had reached 5.355 million kilometers, including 177,000 km of expressways—ranking first in the world. However, with increasing service age and rising traffic volumes, many early-constructed high-grade highways and a vast number of secondary and tertiary roads have entered a peak period of maintenance and repair, resulting in an increasingly heavy burden on road maintenance tasks [1].
Construction and maintenance of highways are complementary processes; timely maintenance is crucial to extending pavement service life [2,3]. In this context, preventive maintenance is particularly important; it targets pavements that are structurally sound or exhibit only minor signs of distress, aiming to slow deterioration and prevent the development of more severe damages [4,5]. Compared with traditional reactive maintenance, preventive maintenance is a proactive strategy that extends the service life of roads in good condition without enhancing their structural capacity, improves system performance, and significantly reduces lifecycle maintenance costs [6,7]. Consequently, China’s road management philosophy has evolved from a “repair-first” approach to a balanced “repair and maintenance” model, and more recently, to a strategy that prioritizes preventive maintenance. According to national statistics, the cumulative implementation of preventive maintenance in China has now reached 1.356 million kilometers. This paradigm shift has raised the standards for both the execution and evaluation of highway maintenance practices.
Post-evaluation of preventive maintenance refers to the comprehensive assessment of engineering effectiveness, technical decision-making, economic efficiency, and environmental and social impacts. It is a critical tool for accelerating the maturity of preventive maintenance technologies [8]. In 2018, the Ministry of Transport of China issued the Administrative Measures for Highway Maintenance Projects, which formally incorporated post-evaluation as part of maintenance fund management, highlighting its increasing importance [9]. Conducting timely, accurate, and efficient post-evaluation is not only aligned with the current level of preventive maintenance practices in China but also serves as essential support for achieving national “dual carbon” goals. Moreover, it plays a vital role in ensuring the scientific and rapid development of preventive maintenance.
Unlike conventional post-evaluation approaches that center on project duration, cost, or quality endpoints, this study adapts Hazard Analysis and Critical Control Points (HACCP)-Inspired method, applying only HACCP Principles 1–2 (hazard analysis and critical control point (CCP) identification) to a retrospective, technical post-evaluation of asphalt-pavement preventive maintenance. The goal is to identify process hazards and the decision points most likely to influence outcomes. A bottom-up agglomerative hierarchical-clustering procedure groups related control items at each project stage and reveals their internal logical relationships, thereby sharpening indicator selection and structure. Rather than being treated as independent targets, indicators such as the Pavement Condition Index (PCI), Subgrade Condition Index (SCI), or cost are embedded within the risk-pathway framework as diagnostic evidence tied to specific CCPs. This shift from results-based appraisal to process-oriented, risk-informed post-evaluation is the primary conceptual contribution. By combining expert judgment with quantitative scoring and visual diagnostics (spider charts and dendrograms), the framework provides a transparent and replicable basis for auditing preventive-maintenance projects and extends the methodological toolbox for highway-maintenance management.

2. Literature Review

2.1. Current Research Status of Preventive Maintenance Technologies

Preventive maintenance practices were initiated earlier in developed countries, where extensive research has been conducted and technologies have been widely applied in real-world projects. Countries such as the United States and members of the European Union have developed highly mature preventive maintenance systems. In the early 1990s, the United States was among the first to propose the concept of preventive maintenance, marking a significant departure from traditional reactive road maintenance strategies. Commonly adopted techniques in the U.S. include chip sealing, cape sealing, fog sealing, and the ultra-thin wearing course technology [10,11,12,13,14]. In Australia, research has primarily focused on ultra-thin overlays. A widely adopted approach in Western Australian urban roads involves milling the surface layer, placing a stress-absorbing membrane interlayer, and applying a 3 cm ultra-thin overlay. This method offers effective repair outcomes with added benefits such as noise reduction and waterproofing, while maintaining relatively low maintenance costs. South Africa, characterized by low annual rainfall, has prioritized surface sealing technologies which not only extend pavement service life but also enhance skid resistance and reduce noise [15]. In France, the emphasis has been on thin and ultra-thin overlay techniques, targeting functional improvements such as skid resistance, noise reduction, and driving comfort, again with relatively low maintenance expenditures [16,17,18,19].
In contrast, China began exploring preventive maintenance later. However, significant progress has been made in recent years, both in terms of technical capabilities and implementation scale. Since the mid-to-late 1990s, increasing attention has been paid to preventive maintenance, with domestic efforts drawing on international experience while adapting to the specific conditions of Chinese road networks [20]. The release of the Technical Specifications for Highway Maintenance (JTJ 073-96 [21]) by the Ministry of Transport in 1996 explicitly mandated preventive maintenance for asphalt pavements. Since then, many provinces have actively advanced preventive maintenance initiatives. For instance, Shanghai has long been a leader in this field, introducing slurry seal and micro-surfacing technologies in the late 1990s. By 2005, its research outcomes in pavement preventive maintenance were internationally recognized [22]. In 2000, Shandong Province introduced chip sealing techniques along with corresponding asphalt distributors and pavers, promoting surface treatment methods on a large scale. Over the next five years, various techniques such as crack sealing, micro-surfacing, slurry seal, and thin overlays were extensively adopted. Similarly, Jiangsu Province has promoted slurry seal technology since 2002, with more than 300 km implemented annually across the province, achieving excellent results. In Shaanxi Province, pilot sections using thin overlays and chip seals were constructed starting in 2003. These experiences informed the subsequent province-wide promotion of preventive maintenance techniques. By 2005, micro-surfacing, emulsified asphalt slurry seals, and modified asphalt thin overlays were incorporated into expressway maintenance, supported by the issuance of the Technical Guidelines for Highway Maintenance in Shaanxi Province (DBJTJ/T-002-2005 [23]), which specified the applicable conditions, material requirements, and construction processes for these techniques [24,25]. In addition, several provinces have made notable advances in the development and application of innovative preventive maintenance technologies. Examples include low-noise micro-surfacing, ultra-thin wearing courses, and SMC warm-mix ultra-thin overlays, which have been successfully applied in engineering practice [26,27,28,29,30].

2.2. Current Research Progress on Post-Evaluation of Preventive Maintenance

The United States [31] was among the earliest countries to initiate post-evaluation practices. The first use of post-evaluation can be traced back to the New Deal programs of the 1930s. Later, during the “War on Poverty” initiative, large-scale investments in public welfare projects led to growing public and congressional concerns regarding capital utilization and economic efficiency. Consequently, post-evaluation approaches focusing on investment benefits were widely applied. The World Bank [32] formally established a dedicated post-evaluation agency in 1970 and developed a comprehensive post-evaluation procedure, which included self-evaluation, self-evaluation audit, synthesis, re-evaluation, and feedback. Both qualitative and quantitative evaluation methods were incorporated into this framework.
China began piloting post-evaluation in the 1980s [33], primarily to assess the use of construction funds, management effectiveness, and accumulated experience. Subsequent evaluation guidelines clearly defined the objectives, content, and methodologies of post-evaluation. In 1990, the Ministry of Transport [34] held a symposium on post-evaluation of highway construction projects in Beijing, initiating the first formal application of post-evaluation in the sector. Based on the evaluation of four selected expressway projects, the Ministry developed standard procedures for compiling post-evaluation reports, thereby ushering in a procedural era for the post-evaluation of highway and other infrastructure projects in China.
Wang et al. [35] provided an overview of China’s highway maintenance management, and conducted post-evaluation of decision-making in asphalt pavement maintenance, establishing a comprehensive evaluation framework. Ma et al. [36] employing a panoramic analysis approach from a three-dimensional perspective, they formulated an evaluation framework based on the “value–goal–indicator–standard” logic and proposed specific evaluation standards and methodologies. Wang et al. [37] considering the context of Beijing, analyzed the structure and connotation of highway maintenance performance and used methods such as membership function analysis, correlation analysis, and discrimination analysis to select performance indicators across quality, schedule, cost, and management dimensions, ultimately constructing a 15-indicator performance evaluation system for Beijing’s highway maintenance. Xu et al. [38], from an engineering and technical perspective, proposed a stage-based post-evaluation framework covering the pre-, mid-, and post-implementation phases, and developed corresponding technical evaluation indicators and composite indices.
Given the lack of established methods for post-evaluation of preventive maintenance, Hu et al. [8] highlighted its importance and proposed a framework based on project-level post-evaluation practices. They developed qualitative and quantitative indicators across five dimensions: engineering technology, management, economic benefits, environmental impact, and social impact. Wang et al. [39] classified evaluation indicators into two categories: pavement condition indicators (to determine appropriate intervention timing) and performance evaluation indicators (to assess effectiveness). Zhang et al. [40], adhering to principles of quantifiability, measurability, and variability, proposed pavement condition indices such as PCI (Pavement Condition Index) and RQI (Ride Quality Index), and performance evaluation indicators including △PCI, service life (N), and deferred major rehabilitation years (T). He developed an evaluation methodology for road service performance and economic benefits of preventive maintenance from a network-level perspective, offering a foundation for post-evaluation of provincial or similar preventive strategies. Tang et al. [41], through literature review and expert interviews, established a hierarchical indicator system for post-evaluation of expressway preventive maintenance, covering technical and economic aspects. Li et al. [42] conducted field investigations of pavement distress patterns and their causes on an expressway before and after preventive maintenance interventions. By comparing pre- and post-maintenance inspection data, they assessed project outcomes in terms of ride quality, rutting depth, and skid resistance. Wang et al. [43], integrating post-evaluation principles from highway construction projects with the characteristics of preventive maintenance, proposed a dedicated post-evaluation index system.
Based on the literature reviewed above, the methodological differences among representative studies in terms of indicator selection and weighting approaches were further summarized to clarify the innovation of the proposed framework. The comparative results are presented in Table 1.
Many post-evaluation studies emphasize project duration, cost, or quality endpoints and often rely on subjective surveys or expert judgment for indicator selection and weighting. In contrast, this study adopts an HACCP-Inspired method, applying only HACCP Principles 1–2, hazard analysis and critical control point (CCP) identification, to the post-evaluation of preventive maintenance for asphalt pavements. This yields a CCP-centered, process-oriented framework that clarifies risk nodes across pre-, mid-, and post-implementation phases and embeds diagnostic indicators (e.g., PCI, SCI, and cost) within specific hazard–CCP pathways rather than treating them as standalone targets. To derive quantitative weights, not specified by Principles 1–2, the Analytic Hierarchy Process (AHP) is integrated, and bottom-up agglomerative hierarchical clustering is applied to group related control items and reveal their internal relationships.

2.3. Framework Selection and HACCP-Inspired Indicator Development

2.3.1. Comparative Analysis of Multiple Evaluation Methods

Existing frameworks for infrastructure evaluation can be broadly grouped into four categories.
Architectural systems such as HQE (High Quality Environmental), GSAS (Global Sustainability Assessment System), ASGB (Assessment Standard for Green Building), and DGNB (German Sustainable Building Council) [44,45,46,47,48,49,50,51] emphasize ecological, economic, and social dimensions with life-cycle perspectives. While mature and widely applied, their building-specific orientation limits direct use in highway preventive maintenance, though concepts such as ecological quality and process rigor are instructive.
Management frameworks include ESG (Environment–Social–Governance), BSC (Balanced Scorecard), NESS (Necessity–Economy–Society–Service), and CIPP (Context–Input–Process–Product) [52,53,54,55]. These provide comprehensive strategic indicators and process-oriented evaluation, but they are designed for organizations rather than engineering systems, and thus lack specificity for technical post-evaluation.
Risk management methods such as FMEA (Failure Mode and Effects Analysis), RBS (Risk Breakdown Structure), and ISO 31000 [56] offer structured risk identification, classification, and governance. FMEA excels in early-stage defect analysis, RBS in hierarchical categorization, and ISO 31000 in organizational integration [57,58,59]. However, they generally neglect full-process, node-specific, and dynamically adjustable evaluation requirements needed in preventive maintenance.
Food safety systems provide closer analogies. The 4T model (Traceability, Transparency, Testability, Timeliness) improves information completeness and accountability, but its application to transport projects shows that traceability alone is insufficient for managing complex engineering risks. HACCP (Hazard Analysis and Critical Control Point), in contrast, is a process-oriented and proactive system that identifies hazards, defines CCPs (Critical Control Points), and establishes monitoring and corrective actions. Compared with FMEA, RBS, and ISO 31000, HACCP offers greater systematicity and responsiveness through node-based control and adaptive feedback [60,61,62].

2.3.2. Overview of the HACCP Method

HACCP was developed in the 1960s by Pillsbury with NASA and the U.S. Army for space-food safety and was standardized by the Codex Alimentarius (1997). Many countries subsequently mandated HACCP in food industries. Beyond food systems, HACCP has inspired risk-management practices in reclaimed-water reuse, flood-risk governance, and urban drainage, among others [63,64,65,66,67].
HACCP comprises seven principles: (1) hazard analysis; (2) identification of critical control points (CCPs); (3) critical limits; (4) monitoring; (5) corrective actions; (6) verification; and (7) documentation. Scope note: because the objective of this study is a retrospective post-evaluation, only Principles 1–2 (hazard analysis and CCP identification) are applied. Real-time control elements in Principles 3–7 are not implemented.
Typical hazards across pre-, mid-, and post-implementation stages (ecological/environmental, resource utilization, engineering safety, engineering quality, socioeconomic benefit, and social living environment) are identified, and a CCP decision tree is used to screen controllable nodes. These two steps yield a hazard–CCP map that structures subsequent indicator mapping and quantitative analysis for post-evaluation.
Construction of the post-evaluation indicator system (six steps).
(1) Stage division and hazard taxonomy. The project lifecycle is partitioned into pre-, mid-, and post-implementation stages, with six hazard types defined for each stage.
(2) Task objectives and hazard analysis. Through expert consultation and case analysis, 12 task objectives (5 pre-, 3 mid-, 4 post-) are identified, and task-specific hazards are enumerated.
(3) CCP determination and control measures. Using the HACCP-Inspired decision tree, each task is evaluated to determine whether its hazards can be mitigated by management or engineering measures; all 12 tasks are confirmed as CCPs, and associated measures are proposed (prospective recommendations in a post-evaluation setting).
(4) Extraction of key control items (KCIs). Procedural measures are refined into operable, quantifiable KCIs that serve as Level-3 indicators.
(5) Expert scoring for diagnostic profiling. Each KCI is assessed across six Level-1 dimensions using a six-level (0–5) scale (0 = no impact, 5 = significant impact).
(6) Agglomerative hierarchical clustering (AHC). Based on the score matrix, Euclidean distances are computed and Ward’s linkage is applied to group KCIs; results are visualized as a dendrogram. Clusters reveal key influencing factors, which are adopted as Level 2 indicators.
The Agglomerative Hierarchical Clustering (AHC) method was employed in this study and proceeds through the following steps [68,69]: a. Cluster Object Definition: Each Key Control Item corresponding to a CCP is treated as an independent initial sample for clustering; b. Score Matrix Construction: Expert evaluations are conducted to score each key control item across six dimensions (EEH, RUH, ESR, EQR, SBH, SLEH). These scores are standardized to form an evaluation matrix. c. Distance Calculation: Based on the score matrix, the Euclidean distance between any two key control items is computed to construct the distance matrix. d. Clustering Criterion Selection: The Ward’s method is adopted as the linkage criterion. In each iteration, the two clusters that result in the smallest increase in within-cluster variance are merged. e. Dendrogram Construction: The final clustering results are visualized using a dendrogram. In the diagram, the vertical lines represent the merging distances between different key control items. Shorter lines indicate higher similarity. The horizontal axis shows the dissimilarity values, with smaller values reflecting stronger similarity and larger values indicating greater differences between the merged clusters or items.
Through these steps, a multi-level indicator framework is established, ranging from tasks, control points, and control items to key influencing factors, providing a systematic and quantifiable basis for the post-evaluation of highway maintenance projects.

2.4. Scientometric Analysis of Related Literature

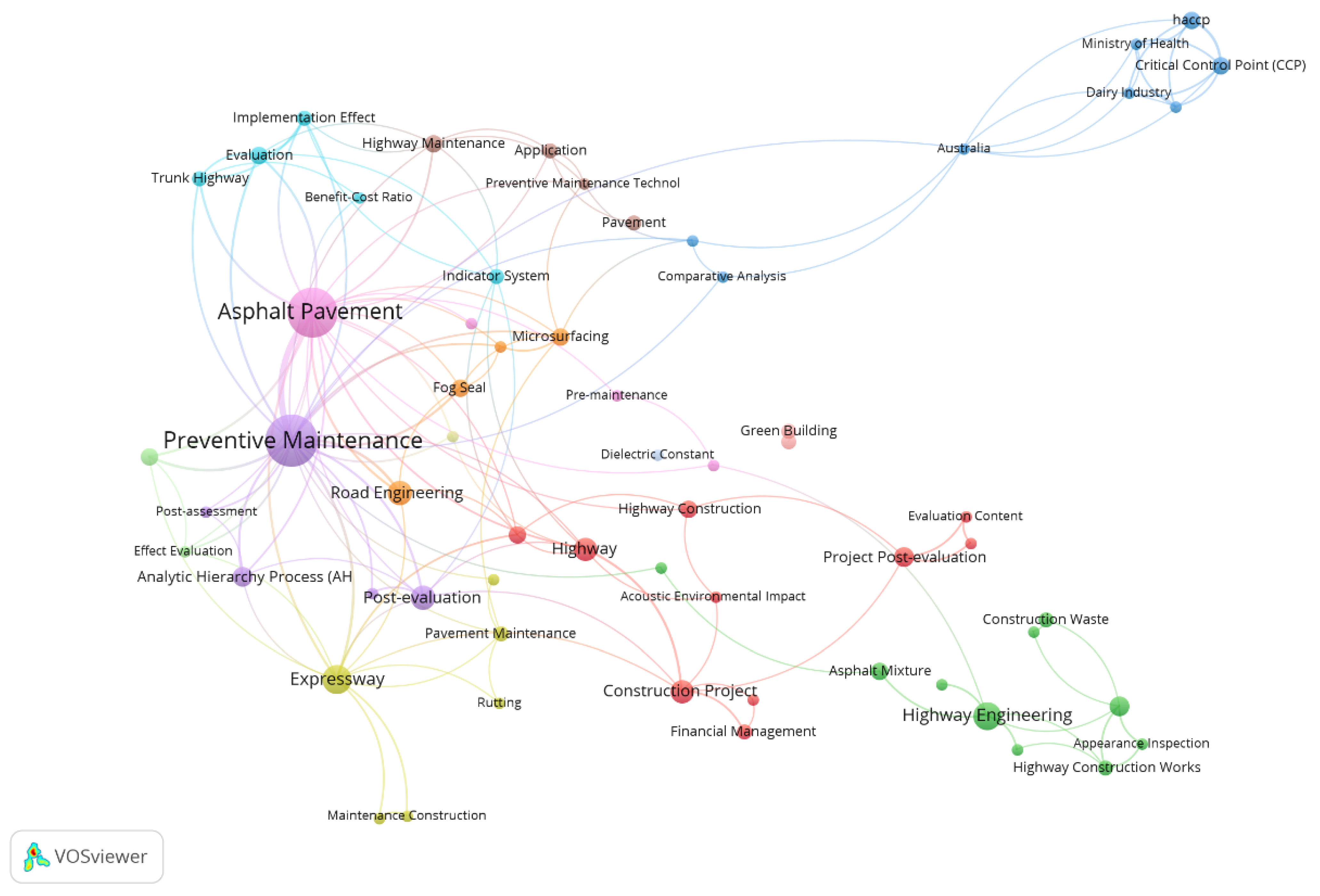

A scientometric analysis was conducted using VOSviewer 1.6.20, drawing on the body of literature reviewed in this study, which represents the core research on highway preventive maintenance and HACCP. Figure 1 presents the keyword co-occurrence network, which reveals several distinct clusters representing the research landscape of highway preventive maintenance.
The largest cluster centers on Preventive Maintenance and Asphalt Pavement, with high-frequency terms such as Road Engineering, Expressway, and Pavement Maintenance. This reflects the mainstream technical focus on asphalt-based materials, maintenance timing, microsurfacing, fog seal, and related engineering measures.
A second cluster emphasizes Highway Engineering and Construction Projects, linked with Highway Construction Works, Asphalt Mixture, Construction Waste, and Financial Management. This cluster highlights managerial and economic aspects, including quality inspection, construction technology, and safety management.
A third cluster captures methodological frameworks, where Post-evaluation, Analytic Hierarchy Process, Effect Evaluation, and Indicator System are strongly connected. These keywords underline the growing interest in quantitative evaluation and decision-support tools in highway maintenance research.
Of particular relevance is the HACCP-related cluster, including HACCP, Critical Control Point, Hazard Analysis, and links to the Dairy Industry and Ministry of Health. This cluster appears relatively isolated from the mainstream highway maintenance literature, reflecting HACCP’s origin in food safety and its limited adoption in transportation infrastructure. Its peripheral position in the network underscores both the novelty and the research gap that this study seeks to address by introducing an HACCP-inspired evaluation framework.
Overall, the mapping analysis demonstrates that while preventive maintenance and pavement engineering dominate the field, systematic post-evaluation frameworks—particularly those inspired by HACCP—remain underexplored. This finding reinforces the originality and significance of our proposed HACCP-inspired post-evaluation system for highway preventive maintenance.

2.5. Limitations of Current Post-Evaluation Systems for Highway Preventive Maintenance Projects

In recent years, the concept of “preventive maintenance as the primary strategy, with corrective maintenance as a supplement” has been widely accepted and promoted in China. Consequently, preventive maintenance projects have gained increasing attention in both theory and practice. A number of scholars have made valuable contributions to the development of post-evaluation frameworks for such projects, exploring various indicator systems and evaluation methods from technical, economic, and management perspectives.
However, despite this progress, several critical limitations remain in the existing body of work, particularly regarding the systematization, standardization, and feedback mechanisms of post-evaluation practices:
(1) Fragmented and inconsistent frameworks. While some post-evaluation frameworks have been proposed, they often rely heavily on subjective expert opinions and lack a unified theoretical basis. Many studies focus on static, post hoc evaluation without fully capturing the dynamic characteristics and phased nature of preventive maintenance activities.
(2) Lack of standardized and institutionalized procedures. Currently, there is no widely accepted or standardized methodological system for post-evaluation across regions and project types. Evaluation criteria, data sources, and methodological rigor vary significantly, making cross-project comparisons difficult and limiting the broader applicability of results.
(3) Insufficient integration of risk control and feedback logic. Most existing frameworks focus primarily on performance outcomes, while overlooking the potential value of embedding risk identification, process monitoring, and correction mechanisms into the evaluation structure. This results in limited support for continuous improvement and decision optimization in future projects.
Given these gaps, there is an urgent need to construct a more integrated, process-oriented, and adaptable post-evaluation system. Our study aims to address this need by introducing an HACCP-Inspired method with embedded control logic and dynamic feedback loops, supplemented by AHP-based weighting to enhance indicator robustness and objectivity.

3. Determination of Technical Evaluation Indicators for Highway Preventive Maintenance Projects

3.1. Hazard Analysis of Preventive Maintenance Implementation

In accordance with the principles of the HACCP-Inspired evaluation framework, this section conducts a comprehensive hazard identification and assessment of highway preventive maintenance projects. From the perspective of the full life cycle, the preventive maintenance process is divided into three phases: pre-implementation, mid-implementation, and post-implementation. Each phase is analyzed to identify potential hazards and assess their severity, providing a reliable foundation for the determination of critical control points. Based on the characteristics of preventive maintenance in each phase, this study identifies the following key hazard types across the process: Ecological and Environmental Hazards, Resource Utilization Hazard, Engineering Safety Risks, Engineering Quality Risks, Socioeconomic Benefit Hazards, and Social Living Environment Hazards.

3.1.1. Hazard Classification in Maintenance Projects

(1) Ecological and Environmental Hazards (EEH)
Throughout the life cycle of highway maintenance projects, ecological and environmental hazards may include: a. Noise pollution: The use of heavy equipment such as mixers, pavers, and pneumatic drills generates intermittent and high-decibel noise that contributes to environmental noise pollution; b. Impact on flora and fauna: Maintenance activities may cause direct or indirect harm to surrounding plant and animal species, affecting their populations, diversity, and activity ranges. In severe cases, species unable to adapt to the altered environment may perish; c. Air pollution: Diesel-powered machinery emits large volumes of exhaust gases. In addition, construction activities generate dust, and asphalt heating and mixing release hazardous compounds such as phenols, and total hydrocarbons, posing respiratory and environmental risks. Other potential environmental impacts include light pollution, water contamination, soil degradation, and improper disposal of solid waste.
(2) Resource Utilization Hazards (RUH)
Key resource-related hazards across the project lifecycle include: a. Labor inefficiency: Poor on-site coordination can lead to overcrowding, downtime, or idle labor, resulting in wasted human resources; b. Material waste: Ineffective maintenance plans may hinder the recycling or reuse of construction materials, leading to excessive consumption; c. Excessive energy use: Irrational energy use during construction not only strains national energy reserves but also increases carbon emissions, threatening both ecological sustainability and long-term economic growth.
(3) Engineering Safety Risks (ESR)
Safety risks arise when engineering practices lack standardization or enforcement. These may include: fragmented or ineffective safety management systems, insufficient safety protocols throughout the construction process, poor execution of safety plans, inadequate investment in safety measures, low worker competency, and limited awareness or adoption of modern safety technologies.
(4) Engineering Quality Risks (EQR)
Quality risks may result from unqualified contractors, insufficient construction experience, rushed project schedules, shallow planning, poor decision-making, lack of advanced construction materials or equipment, and outdated or poorly executed technical processes. These issues can lead to compromised engineering standards and long-term performance deficiencies.
(5) Socioeconomic Benefit Hazards (SBH)
Socioeconomic risks include: a. Limited participation of private capital, leading to inadequate project funding; b. Unfair bidding practices, such as local protectionism or collusion, which undermine market competitiveness; c. Design flaws and frequent design changes that increase workload and project costs; d. Inefficient technical measures during construction that inflate costs and reduce project quality and schedule adherence.
(6) Social Living Environment Hazards (SLEH)
Maintenance activities may negatively affect local residents’ living conditions in several ways: a. Construction noise may disturb daily routines and working environments; b. Emissions from asphalt fumes can degrade local air quality; c. After project completion, increased traffic volume and vehicle speed can raise ambient noise levels, disrupting surrounding communities.

3.1.2. Hazard Analysis in Maintenance Projects

(1) Pre-Implementation Phase Hazard Analysis
The pre-implementation phase consists of five core tasks based on the life cycle theory: maintenance plan formulation, material properties, equipment provision, personnel configuration, and technical preparedness.
Taking maintenance plan formulation as an example, potential hazards in this phase are analyzed as follows: Inaccurate maintenance timing may result in premature intervention, leading to unnecessary expenditure, or delayed maintenance, rendering the intervention ineffective and wasting both resources and funds. Inappropriate selection of maintenance strategies may also lead to risks. For instance, applying HAP fog seal technology to road sections requiring enhanced skid resistance may worsen the situation. Although the technique provides good waterproofing, it reduces skid resistance, ultimately failing to improve pavement performance, misusing funds, and even potentially damaging the local ecological environment. Insufficient consideration of local traffic needs, such as neglecting the travel demands of nearby residents, may exacerbate traffic congestion. Inefficient organizational planning may lead to cost overruns, failing to control overall maintenance expenditures.
Therefore, the main types of hazards associated with the maintenance plan formulation stage include: Ecological and Environmental Hazards, Resource Utilization Hazard, Engineering Safety Risks, Engineering Quality Risks, Socioeconomic Benefit Hazards, Social Living Environment Hazards. For each task, associated potential hazards are identified, as summarized in Table 2.
(2) Mid-Implementation Phase Hazard Analysis
The mid-implementation phase includes three main objectives: construction process control, quality control, and safety protection.
Taking safety protection as an example, several potential hazards may arise during this phase of highway maintenance projects. These include inadequate establishment of specialized safety protocols, insufficient safety training and awareness campaigns, and a lack of safety vigilance among workers, which may result in improper equipment operation, leading to machinery overturning or material ejection. Additionally, poor traffic control measures at the construction site and unclear division of responsibilities may expose personnel to serious safety risks. Furthermore, deficiencies in emergency response planning, such as incomplete emergency protocols and insufficient first-aid knowledge, can prevent timely and effective responses to on-site incidents.
Therefore, the main types of hazards associated with the safety protection stage include: Engineering Safety Risks, Engineering Quality Risks, and Socioeconomic Benefit Hazards. For each task, associated potential hazards are identified, as summarized in Table 3.
(3) Post-Implementation Phase Hazard Analysis
The post-implementation phase comprises four key objectives: technical performance indicators, financial management, resource utilization, and environmental protection.
Taking Environmental protection as an example, several potential hazards may arise during this stage of highway maintenance projects. These include the emission of greenhouse gases such as CO2 and NO2 during raw material processing, asphalt mixture preparation, and construction activities, which can pollute the atmosphere, harm workers’ health, and reduce the quality of life for nearby residents. Additionally, noise generated by construction machinery can cause noise pollution, disrupting residents’ daily lives. During nighttime operations, the lighting equipment used by construction machinery may lead to light pollution, negatively affecting the growth and survival of local flora and fauna.
Therefore, the main types of hazards associated with the environmental protection stage include: Ecological and Environmental Hazards, Resource Utilization Hazard, Socioeconomic Benefit Hazards, and Social Living Environment Hazards. For each task, associated potential hazards are identified, as summarized in Table 4.

3.2. Identification of Technical Critical Control Points in Preventive Maintenance Projects

Based on the hazard analysis conducted in the previous section, it is evident that various risks, ranging from ecological and environmental impacts, resource inefficiencies, engineering safety hazards, and quality defects to socioeconomic disruptions and deterioration of the living environment, may significantly affect the overall evaluation outcomes of preventive maintenance projects. Specifically, ecological and resource-related hazards can cause irreversible damage to local ecosystems; safety and quality hazards can threaten the well-being of workers and road users; and socioeconomic risks may disrupt market order and delay project schedules. Therefore, it is imperative to implement rigorous quality control and identify critical control points (CCPs) within the technical aspects of maintenance engineering.
A critical control point refers to a specific stage, step, or procedure in the maintenance process where effective preventive, eliminative, or mitigating measures can be applied to reduce the associated hazards to an acceptable level. The identification of these points is guided by a critical control point decision tree (Figure 2).

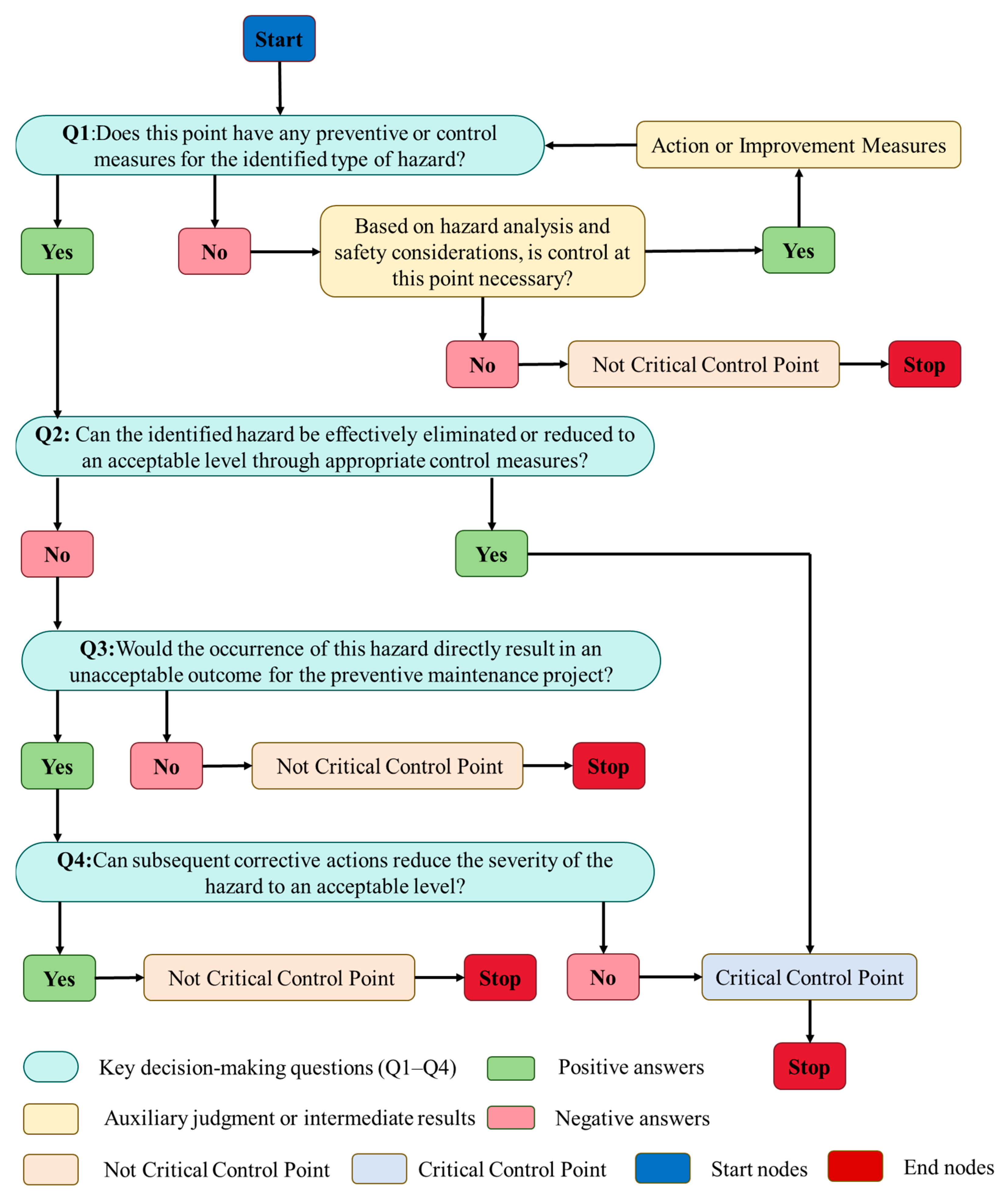

3.2.1. Critical Control Points in the Pre-Implementation Phase

To identify CCPs during the early implementation phase of highway maintenance engineering, a CCP decision tree was applied to systematically assess key steps, procedures, and activities. The evaluation process is summarized in Table 5.
Based on the CCP identification process, five CCPs were determined for the pre-implementation phase: Maintenance plan formulation; Material performance; Equipment provision; Personnel configuration; and Technical preparedness. By applying effective preventive or control measures to address the potential hazards associated with these CCPs, risks related to ecological environment, resource consumption, construction safety, and project quality can be significantly reduced or eliminated.
Taking the “Maintenance plan formulation” as an example, the process of determining its corresponding critical control measures is analyzed in detail. The critical control measures for this CCP refer to the set of preventive actions or control indicators established to reduce the likelihood of various risks during this phase, including engineering safety hazards, ecological and environmental impacts, inefficient resource utilization, construction quality issues, socioeconomic losses, and adverse effects on the living environment. In designing a maintenance plan, three key technical factors must be thoroughly considered: the predominant pavement distress type and its severity, road classification, and traffic volume. The design process should strictly adhere to relevant technical standards, such as the Highway Performance Assessment Standards (JTG 5210-2018) [79], Specifications for Maintenance Design of Highway Asphalt Pavement (JTG 5421-2018) [70], and Technical Specifications for Maintenance of Asphalt Pavement (JTG 5142-2019) [71]. Additionally, economic, construction-related, and environmental considerations must be incorporated into the planning process. Specifically, maintenance timing must be determined with precision to avoid resource waste caused by premature or delayed interventions. Pavement sections should be accurately clustered based on condition and functional needs to ensure targeted maintenance. The chosen treatment strategy must be tailored to the specific type of pavement distress to ensure that the implemented measures effectively eliminate defects and substantially improve pavement quality. Lastly, the overall organizational plan must be rationally structured, with accurate repair cost estimation to avoid budget overruns.
This study analyzes the five critical control points identified in the pre-implementation phase. Based on their associated hazard types, and in alignment with the principles of sustainable development, targeted mitigation measures are proposed with a focus on efficiency, energy conservation, safety, and environmental protection. These measures are then refined and consolidated into the key control strategies for the pre-implementation phase of highway maintenance projects, as summarized in Table 6.

3.2.2. Critical Control Points in the Mid-Implementation Phase

Using the CCP decision tree, each step, procedure, or task in the mid-implementation phase of highway maintenance was systematically evaluated to identify key CCPs. The determination process is presented in Table 7.
Based on the identification procedure, three CCPs were determined for the mid-implementation phase: Construction process control, Quality control, and Safety protection. Implementing effective preventive measures for these CCPs can significantly reduce or eliminate hazards related to the ecological environment, resource consumption, engineering safety, and construction quality.
Taking “Safety protection” as an example, the determination process for its critical control measures is elaborated below. These measures aim to mitigate engineering safety risks, quality defects, and socioeconomic losses during this stage. First, specialized safety protocols should be established, and training and awareness campaigns should be conducted to ensure safe practices on-site. In addition, construction site traffic management must be strengthened. Second, comprehensive emergency response plans must be formulated to ensure prompt and effective action in the event of safety incidents during construction.
This study further analyzes the three CCPs identified for the mid-implementation phase. In addition to meeting baseline requirements for construction quality and safety, targeted solutions are proposed with an emphasis on environmental protection, energy efficiency, the adoption of new materials and equipment, and innovations in management systems. These measures are refined into a set of key control strategies summarized in Table 8.

3.2.3. Critical Control Points in the Post-Implementation Phase

Using the CCP decision tree, each task, step, or procedure involved in the post-implementation phase of highway maintenance was assessed to identify its criticality. The identification process is presented in Table 9.
According to the results of the CCP identification process, all task objectives in the post-implementation phase qualify as critical control points. Therefore, four CCPs are confirmed for this phase: Technical indicators, Financial management, Resource utilization, and Environmental protection. Effective preventive and control measures targeting the potential hazards associated with these CCPs can significantly mitigate risks related to environmental degradation, inefficient resource use, construction safety, and quality assurance.
Taking Environmental protection as an example, the process of determining its critical control measures is elaborated as follows. These measures aim to reduce the likelihood of risks such as resource inefficiency, environmental degradation, negative socioeconomic impacts, and disturbances to the living environment. Specifically, construction wastewater should be treated in accordance with relevant regulations; waste materials must be collected and stored centrally; and noise and light pollution from machinery should be strictly managed. During the operation phase, no-honking zones should be designated, and vehicles failing emission standards must be prohibited from operating. Additionally, nighttime vehicle lighting should be strictly monitored and controlled.
This study further analyzes the four CCPs identified in the post-implementation phase. Based on the specific types of hazards associated with each CCP, a series of targeted measures emphasizing environmental protection and management innovation were proposed. These refined strategies are presented in Table 10.

3.3. Determination of Evaluation Indicators

3.3.1. Key Control Items in the Pre-Implementation Phase

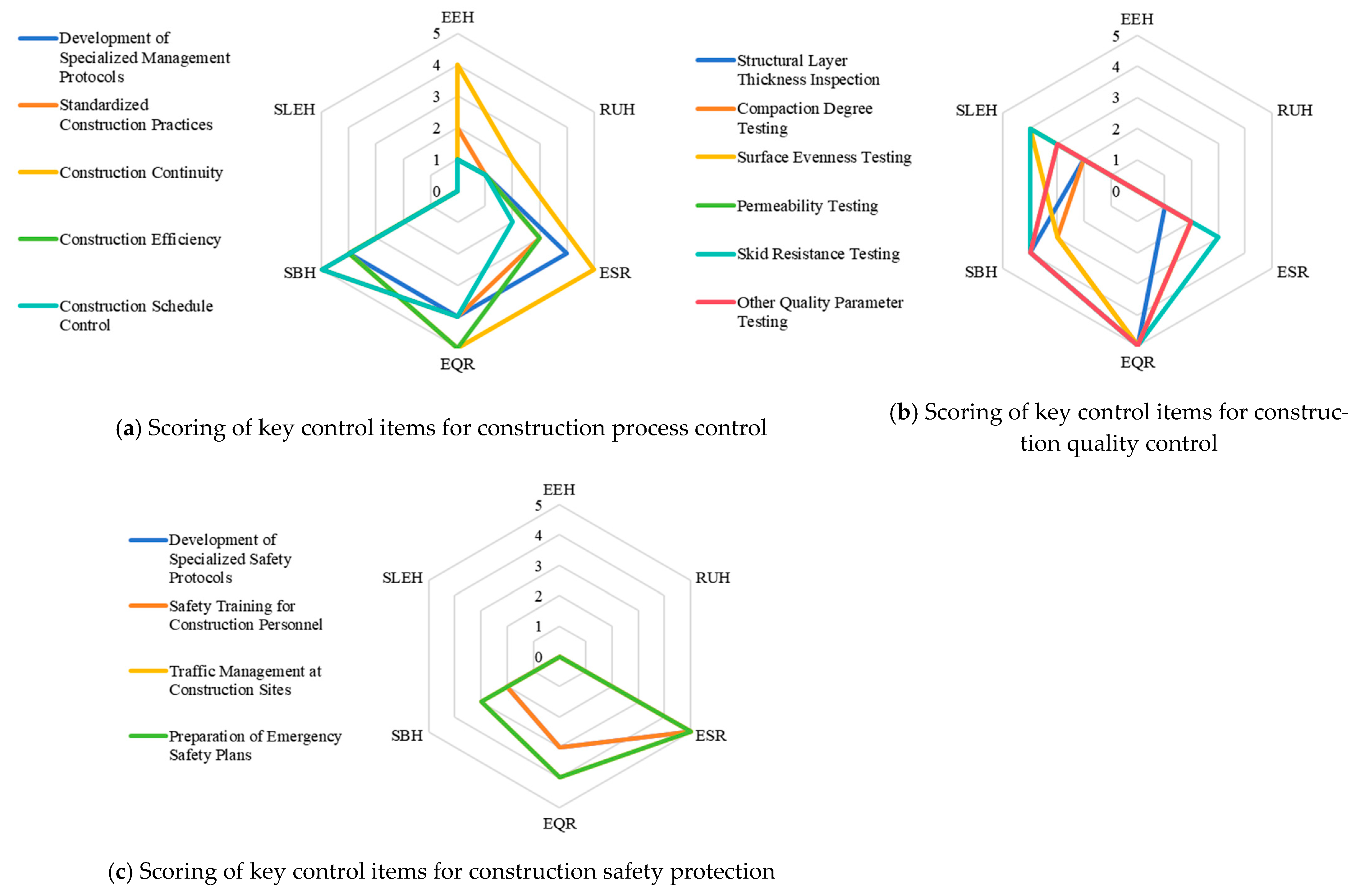

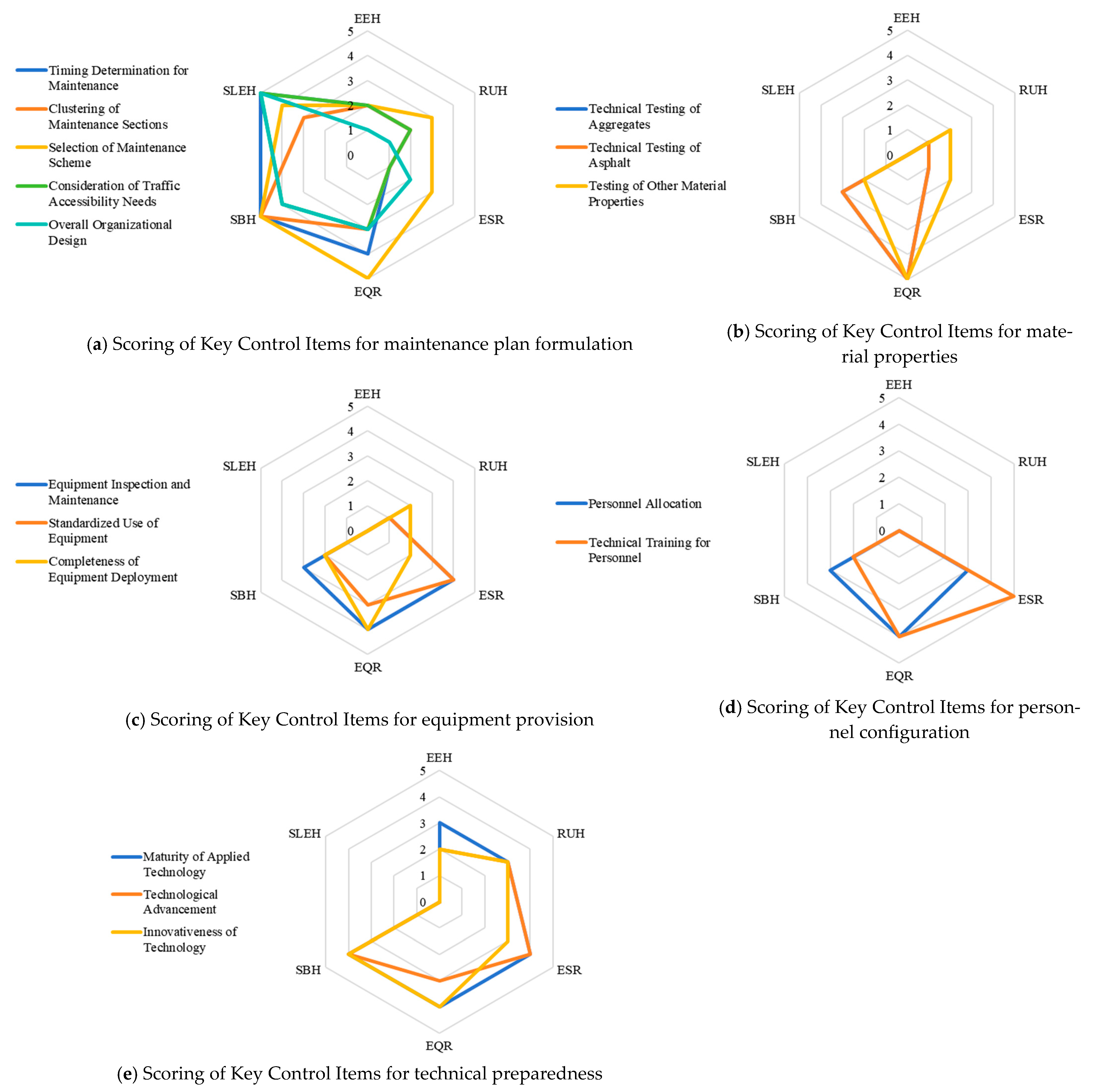

The five CCPs identified in the pre-implementation phase, maintenance plan formulation, material properties, equipment provision, personnel configuration, and technical preparedness, were analyzed and condensed under the principles of scientific rigor, simplicity, and optimization. The resulting key control items are presented in Table 11.
All control items were scored to evaluate their influence on construction-related indicators (Figure 3). Subsequently, hierarchical clustering analysis was performed in Python 3.11, and the corresponding dendrogram is presented in Figure 4.

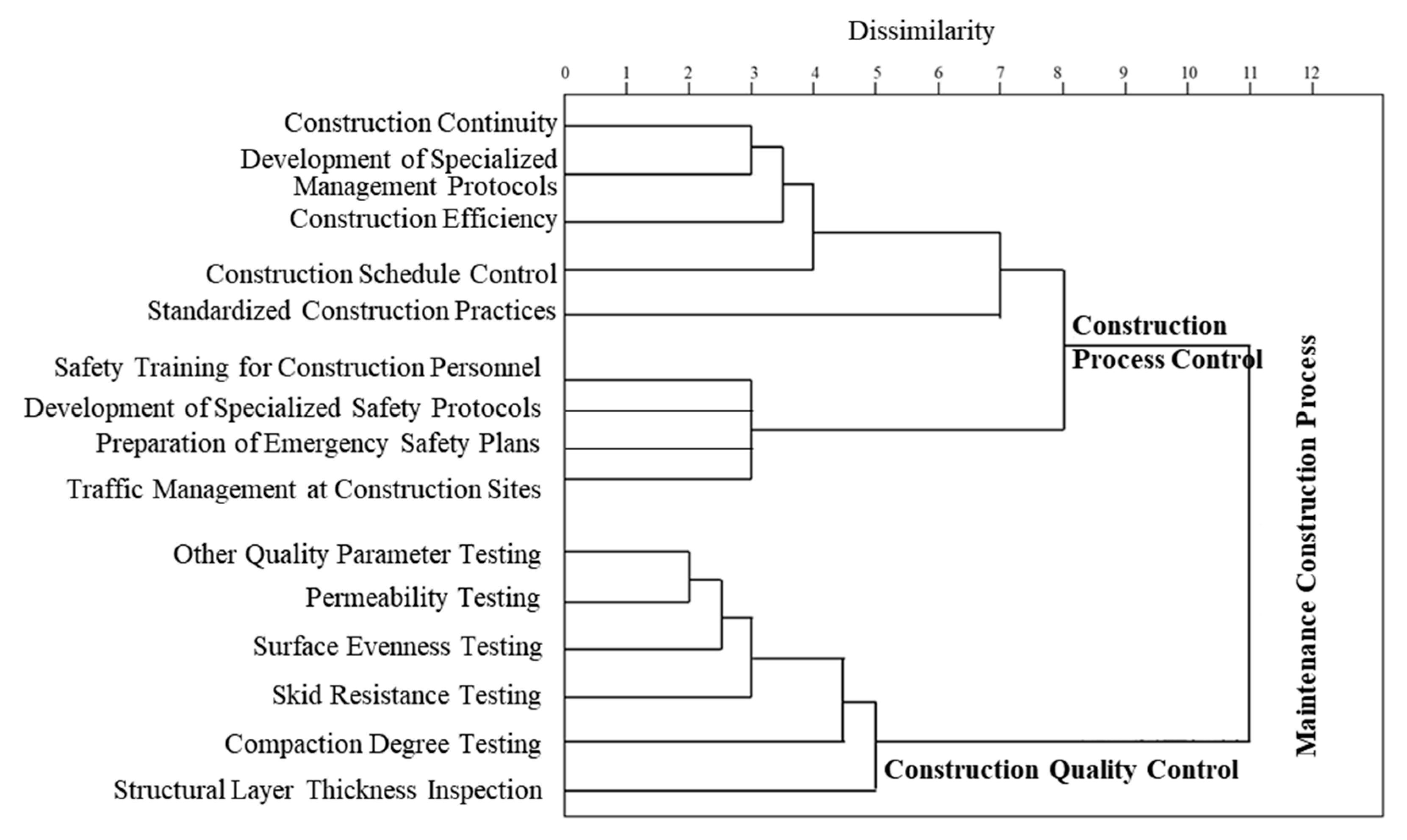

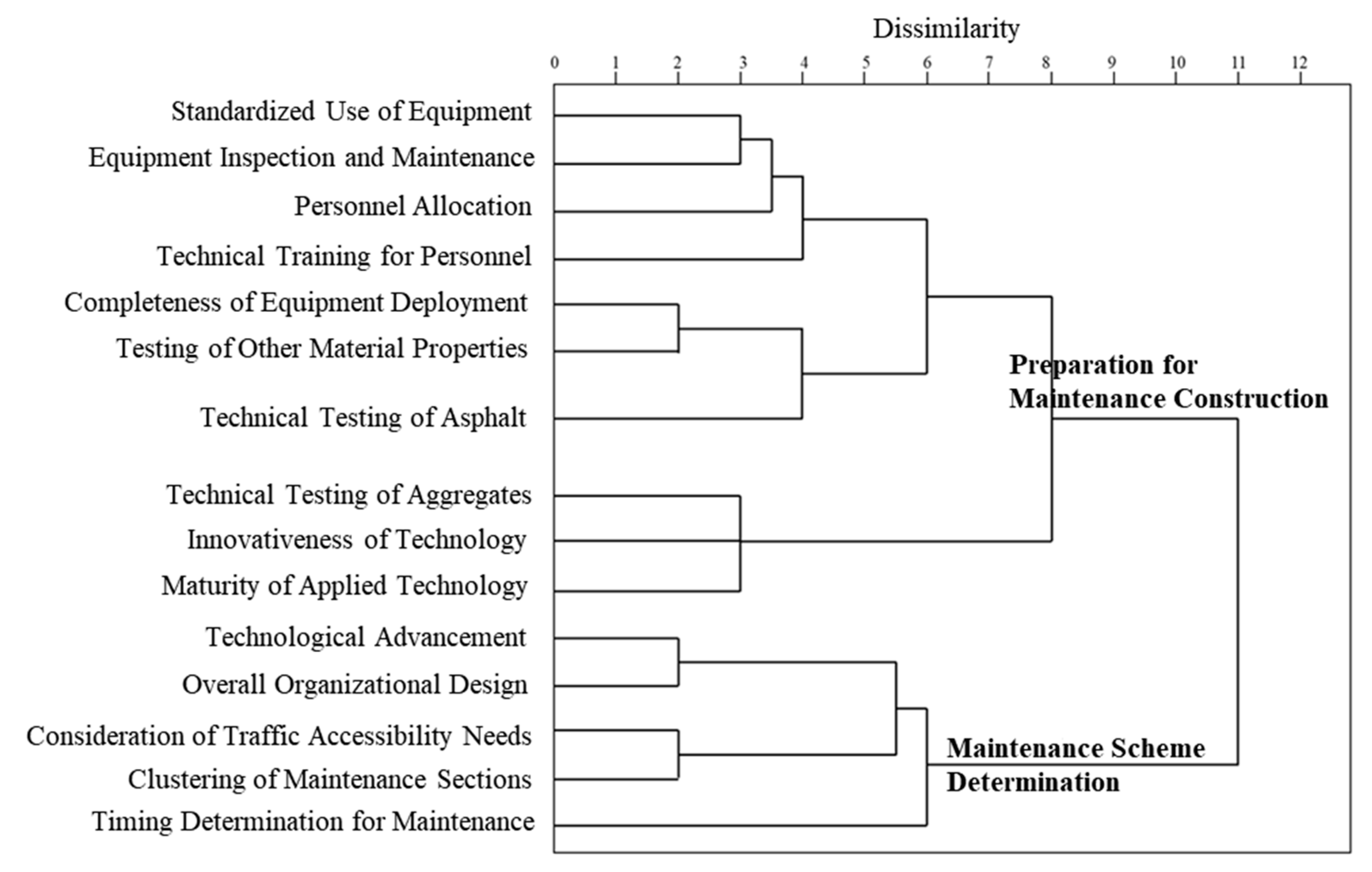

The clustering results grouped the Key Control Items into two major categories: (1) Key Control Items related to material, equipment, personnel, and technique were grouped under “Preparation for Maintenance Construction”. (2) Key Control Items related to plan timing, sectioning, and design were grouped under “Determination of Maintenance Strategy”. Thus, the key influencing factors for the pre-implementation phase were determined as: Preparation for Maintenance Construction and Maintenance Scheme Determination.

3.3.2. Key Control Items in the Mid-Implementation Phase

The mid-implementation phase includes three CCPs, process control, quality control, and safety protection. After consolidating the relevant technical measures, the key control items were extracted as summarized in Table 12.
All items were assigned scores and subjected to clustering analysis using Python, as illustrated in Figure 5 and Figure 6.

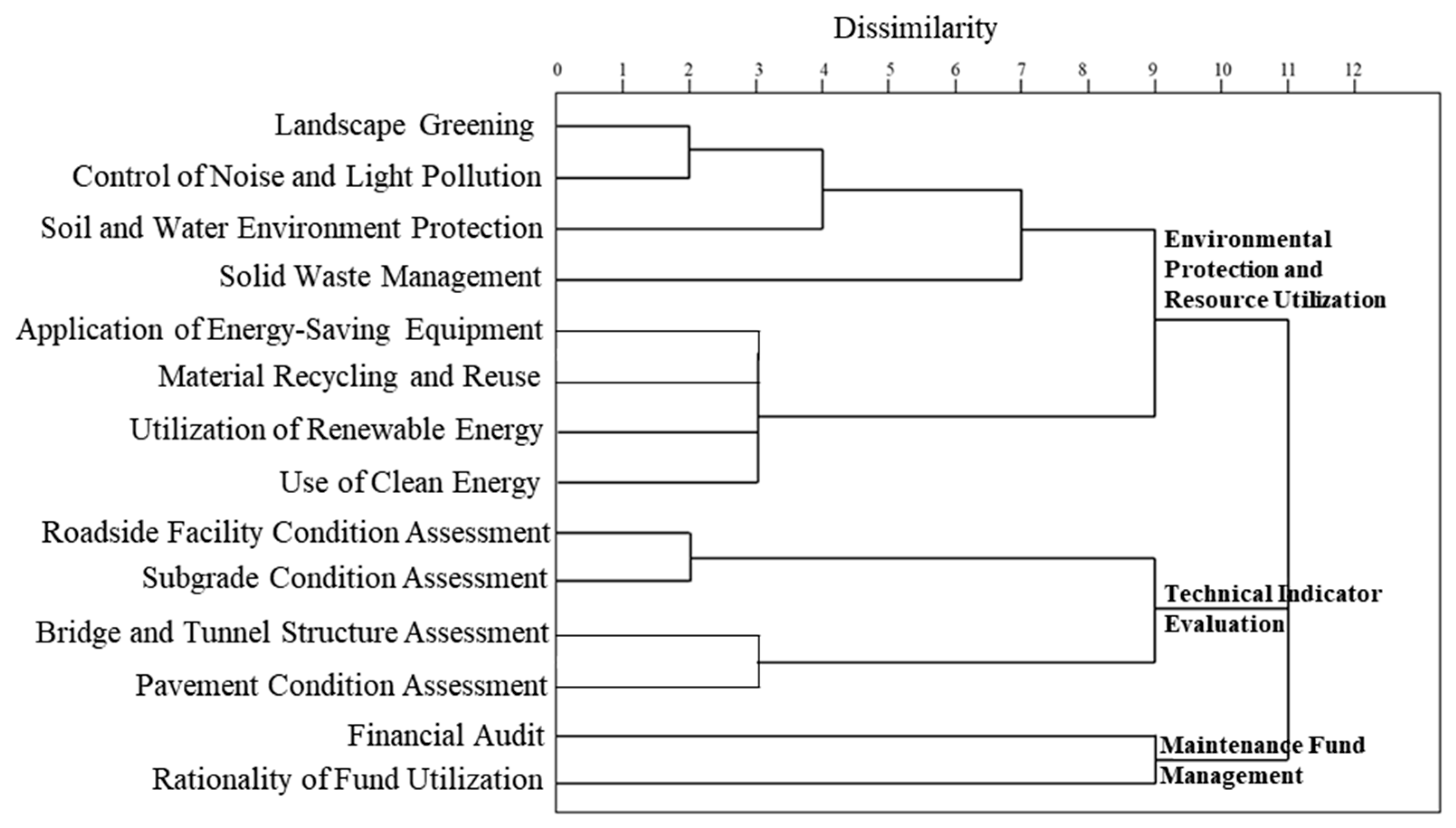

The clustering results grouped the Key Control Items for the mid-implementation phase into two major categories: (1) Key Control Items related to safety protection and process control were grouped under “Construction Process Control”; (2) Key Control Items related to construction quality supervision were grouped under “Construction Quality Control”. Considering their shared relevance to on-site implementation, both categories were integrated and generalized as “Maintenance Construction Process”. Thus, the key influencing factor for the mid-implementation phase was determined as: Maintenance Construction Process.

3.3.3. Key Control Items in the Post-Implementation Phase

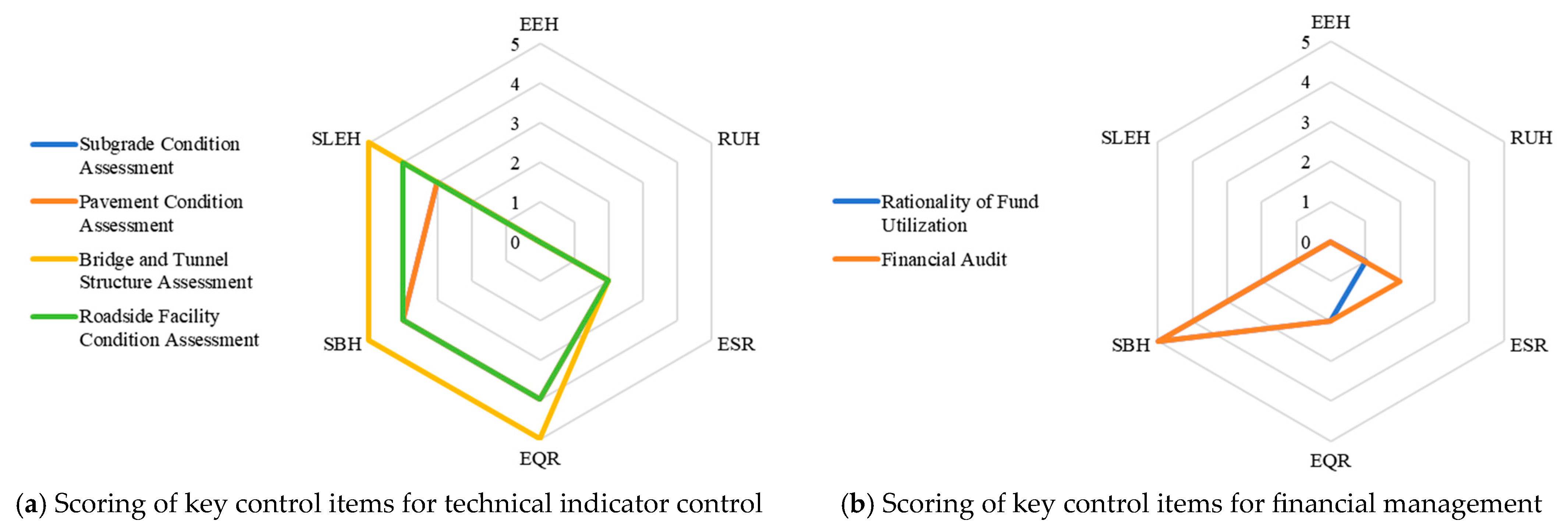

The four CCPs in the post-implementation phase, technical indicators, financial management, resource utilization, and environmental protection, were each analyzed, and their key control items were defined and consolidated as shown in Table 13.
All post-implementation key control items were scored and clustered using Python, with results presented in Figure 7 and Figure 8.
The analysis revealed three distinct clusters: (1) Indicators related to natural resource efficiency and environmental sustainability were grouped under “Environmental Protection and Resource Utilization”. (2) Quantitative technical indicators (Subgrade Condition Assessment, Pavement Condition Assessment, etc.) were grouped as “Technical Indicator Evaluation”. (3) Financial performance metrics were grouped as “Maintenance Fund Management”. Accordingly, the key influencing factors in the post-implementation phase were: Technical Indicator Evaluation, Maintenance Fund Management, and Environmental Protection and Resource Utilization.

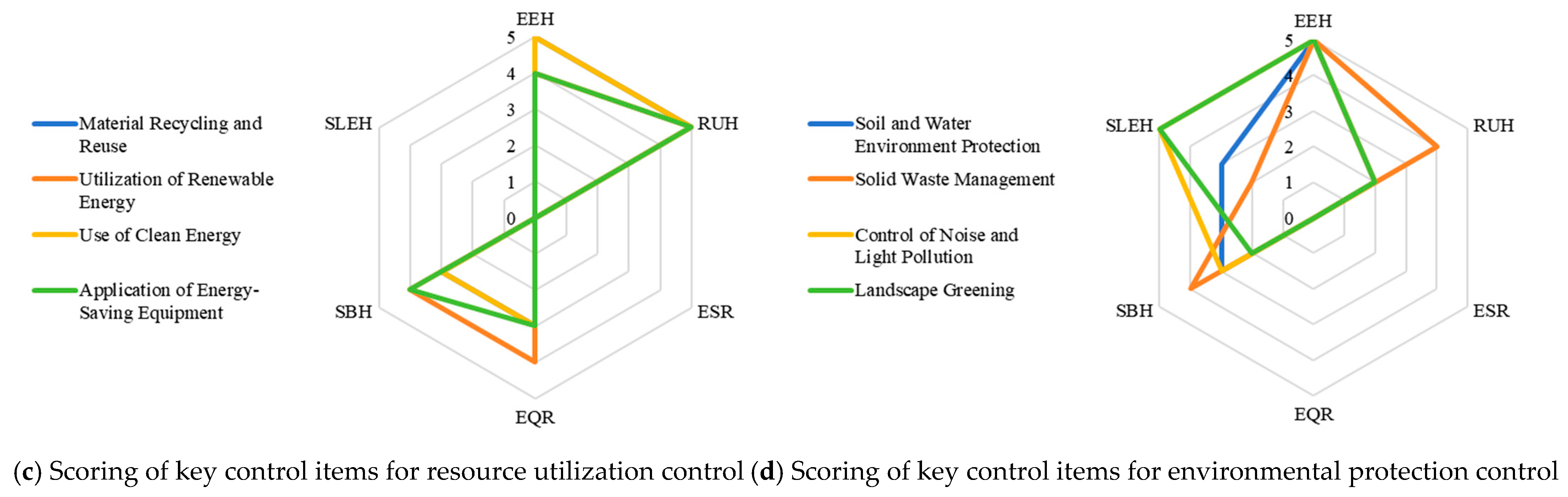

3.4. Establishment of the Evaluation System

Based on the identified key control items in the pre-implementation, mid-implementation, and post-implementation phases of preventive maintenance, a comprehensive post-evaluation system was constructed. The system was developed in accordance with the principles of comprehensiveness, operability, comparability, and sustainability, and adopts a life-cycle perspective covering the entire process of highway maintenance project execution.
The system aims to ensure construction quality and safety, maintain highway safety, comfort, and durability, and guarantee the normal operation and usage of roads. Additionally, it seeks to improve traffic efficiency, promote economic benefits, and safeguard the convenience and safety of public travel.

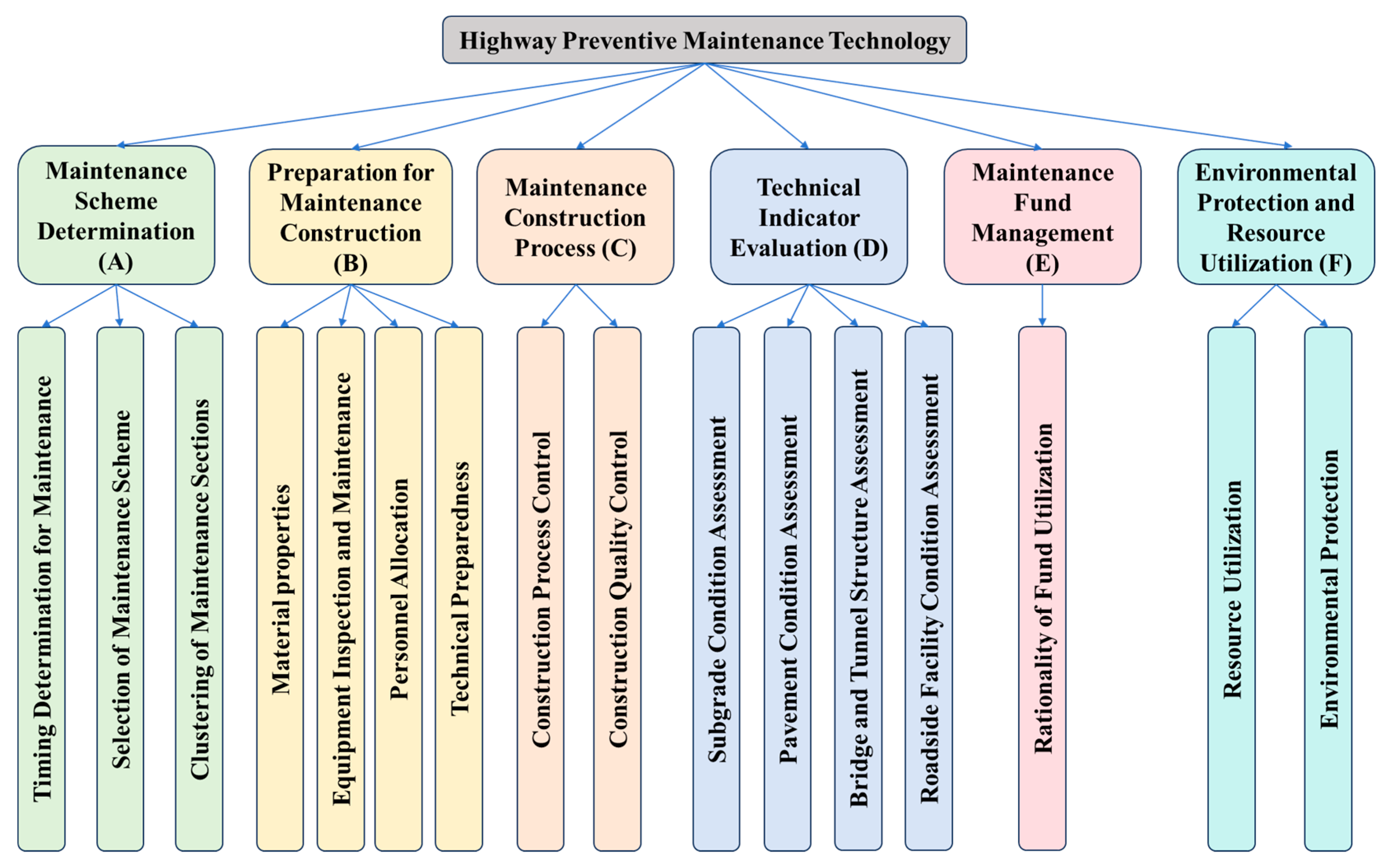

Accordingly, the evaluation framework includes six primary categories of indicators: Timing Determination and Scheme Selection for Maintenance, Preparation for Maintenance Construction, Maintenance Construction Process, Technical Indicator Evaluation, Maintenance Fund Management, and Environmental Protection and Resource Utilization. These six dimensions form the foundation of the Highway Preventive Maintenance Technical Post-Evaluation System, as summarized in Table 14.

4. Case Study: Engineering Application of the Evaluation System

4.1. Project Overview

The selected case for evaluation is the Tianjin section of the Jinghuan Expressway (G112), a key national trunk road running from Langfang City in Hebei Province in the west to the Tianjin–Tangshan border in the east, with a total length of 106.22 km. This segment serves as an important east–west freight corridor through the central part of Tianjin and carries substantial traffic volumes, particularly heavy and overloaded trucks. Except for a small portion in Ninghe District, the entire section is classified as a Class I Highway.
In recent years, the sharp increase in heavy-duty and oversized freight vehicles has led to significant pavement deterioration. The northbound carriageway of the segment from Kehuang Road to Jingbin Road underwent maintenance in 2021. In 2022, the southbound carriageway was selected for preventive maintenance. According to the official pavement condition assessment report, the Pavement Quality Index (PQI) for the segment is 88, the Pavement Condition Index (PCI) is 77 (classified as “Fair”), and the Pavement Structural Strength Index (PSSI) is 88 (classified as “Good”). Based on these ratings, a targeted rehabilitation strategy was implemented to restore road functionality and extend its service life. This study adopts this real-world project as a case application of the Technical Post-Evaluation System for Highway Preventive Maintenance, aiming to assess the performance and technical effectiveness of the engineering practices employed.

4.2. Indicator Scoring Framework

Based on the previously established Technical Post-Evaluation Index System and the corresponding indicator interpretation and scoring rules, this study constructs a scoring conversion framework, using a full score of 100 points as the evaluation benchmark.
To ensure practical applicability and operational efficiency in real-world project assessment, the scoring system follows a hierarchical aggregation method:
(1) The weights of the Level 3 indicators are shown in Table 15; the detailed weight calculation procedure is provided in Appendix A.2.
(2) Where a Level 3 indicator has Level 4 sub-indicators, its weight is equally apportioned among the Level 4 indicators.
(3) The weight of a Level 2 indicator equals the sum of the weights of its Level 3 indicators.
(4) The weight of a Level 1 indicator equals the sum of the weights of its Level 2 indicators.
(5) The weights are converted into percentage-based scores, and the final comprehensive evaluation score is obtained by aggregating all Level 1 scores.
In practical engineering evaluation, some indicators may be non-applicable. For example, in purely preventive pavement maintenance, indicators related to subgrade condition may not be relevant. In such cases, the final adjusted score is calculated using the following normalization formula:
Final   Score = S actual S applicable × 100
To standardize this process, the post-evaluation system adopts a percentage-based structure with 0.5-point granularity for fine adjustments. The resulting score allocation for each indicator is summarized in Table 15.
It should be noted that the scores presented in Table 15 are the theoretical maximum values assigned to each indicator based on the evaluation framework and weighting methods outlined in Appendix A.2. These reflect the ideal full scores under perfect implementation conditions. In contrast, Table 16, Table 17, Table 18, Table 19, Table 20 and Table 21 show the actual assessment results from the Jinghuan Expressway project. These were determined using real project data, inspection results, and implementation records, and were calculated according to the scoring criteria provided in Appendix A.1.

4.3. Case Evaluation and Discussion

Following the indicator system and scoring methodology outlined in Section 5.2, this section applies the technical post-evaluation framework to assess the performance of the preventive maintenance project on the Jinghuan Expressway (Tianjin section). Each Level 3 and Level 4 indicator was evaluated according to the established scoring standards, and detailed justifications were provided based on actual engineering records, inspection results, and design documentation. The evaluation results are summarized in Table 16, Table 17, Table 18, Table 19, Table 20 and Table 21.
In summary, Total Applicable Score is 78.5 points, Actual Score Achieved is 66.0 points, and the final evaluation score for this maintenance project is 84.1 out of 100, indicating a favorable technical outcome with effective project planning, material control, and performance improvement. However, the absence of innovation in clean energy adoption and incomplete subgrade/bridge-related assessments slightly limited the project’s overall technical coverage.
This case study demonstrates that the proposed evaluation system is applicable and practical in real-world preventive maintenance projects. The system allows for flexible exclusion of non-relevant indicators while maintaining comparability through score normalization. The detailed evaluation reveals several key insights: (1) Maintenance planning and scheme selection had the greatest impact on project effectiveness, reflecting the importance of timing and diagnostic accuracy; (2) Technical preparedness and material control remain critical, but variability in scoring suggests that many projects may overlook formal verification procedures; (3) The relatively low score in environmental and resource dimensions reveals a common gap in current engineering practice, where recycling is implemented, but renewable energy and emission reduction strategies are still underutilized. These findings reinforce the need to strengthen sustainability-oriented practices and promote standardized evaluation methods across similar national-level projects.

5. Discussion

5.1. Methodological Adaptability and Current Limitations

The post-evaluation framework for highway maintenance projects developed in this study, based on the HACCP-Inspired approach, represents a novel attempt both domestically and internationally. Given its exploratory and innovative nature, it is necessary to discuss the rationality of the methodological integration and clarify its applicable boundaries.
First, regarding the number of CCPs defined, this study identifies 12 CCPs corresponding to 12 task objectives, segmented across the three stages of the project lifecycle (pre-, mid-, and post-implementation). However, this number is neither fixed nor universally optimal. Variations in natural conditions, technical standards, regulatory systems, and data availability across different regions necessitate adaptive adjustment of CCP selection in practical applications. For instance, in ecologically sensitive areas, environmental monitoring CCPs should be emphasized [81], whereas in urban trunk roads, greater attention should be paid to noise control, construction safety, and financial efficiency [82]. In response, the need for CCP frameworks to remain adaptable and expandable, rather than rigidly applied, is highlighted.
Second, concerning the rationality of integrating the HACCP-Inspired and AHP methods, this study argues that the two are functionally complementary. HACCP-Inspired focuses on identifying potential risk nodes throughout the process and proposes systematic intervention strategies. However, it lacks a mechanism for prioritizing or weighting indicators. To enhance the quantifiability and operational feasibility of the evaluation results, the AHP is introduced to perform structured indicator weighting through hierarchical analysis. This integration effectively combines expert judgment with structured decision-making tools. Therefore, the proposed framework adopts an “HACCP-Inspired, AHP-assisted” structure that balances subjective and objective inputs, offering strong internal consistency in logic and methodology.
Nonetheless, the integrated methodology has some limitations. For instance, AHP may suffer from judgment bias when the expert sample size is small or when significant opinion divergence exists [83]. Meanwhile, HACCP-Inspired, though widely validated in the food sector, requires further empirical validation when applied across domains to engineering evaluation contexts [84]. Future research may explore incorporating additional weighting techniques such as fuzzy comprehensive evaluation or the entropy weight method to enhance the robustness and flexibility of the evaluation framework.
In summary, this study provides an exploratory attempt to apply an HACCP-Inspired method to the post-evaluation of highway preventive maintenance. While we recognize the importance of further supporting the stated limitations with broader references and comparing outcomes with alternative approaches, the present work is positioned as a methodological proposal and validation rather than a systematic review. The current discussion already highlights adaptability, methodological limitations (e.g., expert dependence in AHP and cross-domain applicability of HACCP), and future directions (e.g., fuzzy evaluation [85], entropy weighting [86], Bayesian networks [87]).

5.2. Future Research Directions

To further enhance the scientific rigor, intelligence level, and applicability of the evaluation system developed in this study, future research can explore the following four key directions:
(1) Empirical validation across multiple regions and project types, and expansion of the task objective framework. The current empirical study is based on a highway preventive maintenance project in Tianjin, demonstrating the feasibility of the proposed evaluation system. Future work should involve multi-center comparative studies across projects in diverse regions, selected for their representativeness in terms of climate conditions, road classification, and maintenance complexity. This would allow for testing of the system’s generalizability and scalability under different natural and socioeconomic contexts.
It is also worth noting that the present indicator system adopts a technology-oriented structure, focusing primarily on technical control nodes during the construction process. However, elements related to cost estimation, budget management, and contract preparation are not yet sufficiently covered [88]. Moreover, the system does not systematically consider task requirements under complex scenarios such as extreme weather or emergency events. Future studies could, therefore, refine the framework by identifying the common characteristics of task objectives across the pre-, mid-, and post-implementation stages based on multi-project evidence. A standardized task checklist that integrates both technical and managerial dimensions may then be established, leading to the development of a transplantable and modular indicator system with improved systematicity and applicability.
(2) Integration of dynamic feedback and intelligent control mechanisms. Although this study proposes a process-oriented static evaluation framework, it has not yet incorporated real-time feedback mechanisms. Future research could explore the integration of digital twin technologies by leveraging sensor data and construction monitoring information to build dynamic evaluation models [89,90]. This would enable real-time perception and automated control of key control point states, thereby enhancing the system’s responsiveness and level of intelligence.
(3) Expansion and refinement of green performance indicators. Under the context of China’s “dual carbon” strategy, there is an urgent need to incorporate more quantifiable metrics to evaluate the green performance of maintenance projects [91,92]. The current system adopts a relatively coarse approach to resource utilization and ecological protection [93]. In future iterations, more detailed indicators could be introduced, such as carbon footprint per unit maintenance length, proportion of green energy usage, and energy efficiency levels of construction equipment. This would strengthen the evaluation system’s policy relevance and its guidance for green transition in infrastructure maintenance.
(4) Enhancement of hazard identification methods and uncertainty management [94]. While this study has systematically identified six major hazard categories and their associated factors through literature review and case analysis, certain latent or emergent risks may still be overlooked due to limited case samples and data accessibility. For example, cascading effects triggered by extreme weather events or impacts of geological hazards on infrastructure stability are difficult to capture through conventional methods [95,96]. Future research may consider incorporating uncertainty modeling techniques such as fuzzy logic and Bayesian networks to expand risk identification dimensions and assess system vulnerabilities under compound hazard scenarios.

6. Conclusions

This study develops a comprehensive, lifecycle-based post-evaluation framework for highway preventive maintenance projects, with a specific focus on asphalt pavements. Grounded in the HACCP-Inspired methodology, the framework systematically identifies and analyzes potential hazards across the pre-, mid-, and post-implementation phases of maintenance. Through hierarchical clustering and indicator scoring, twelve critical control points were distilled and categorized into six key evaluation dimensions: Maintenance Scheme Determination, Preparation for Maintenance Construction, Maintenance Construction Process, Technical Indicator Evaluation, Maintenance Fund Management, and Environmental Protection and Resource Utilization.
Based on these dimensions, a multi-level post-evaluation system was constructed and empirically validated through a case study of the Jinghuan Expressway project in Tianjin. The evaluation results demonstrated that the proposed system is practical, scalable, and adaptable to real-world preventive maintenance scenarios. The project scored 84.1 out of 100, reflecting a technically effective outcome with well-executed maintenance planning, material control, and performance improvements. However, limitations such as insufficient integration of renewable energy practices and partial omission of substructure assessments indicate areas for further enhancement.
The findings underscore the critical role of timely scheme determination, rigorous construction control, and sustainability considerations in achieving high-quality maintenance outcomes. The evaluation system not only provides a scientific basis for assessing preventive maintenance performance but also supports more standardized, transparent, and sustainable management practices across China’s highway infrastructure sector. Future research should further integrate dynamic behavioral data, expand applicability across diverse road types, and explore coupling with digital twin technologies for real-time evaluation and feedback.

Author Contributions

Conceptualization, H.C.; Formal analysis, C.W.; Funding acquisition, H.C.; Methodology, N.F.; Supervision, N.F.; Writing—original draft, H.C. and N.F.; Writing—review and editing, H.C., C.W. and N.F. All authors have read and agreed to the published version of the manuscript.

Funding

This research was funded by the Jiangxi Provincial Department of Education Science and Technology Project (GJJ214605), the Tianjin Transportation Science and Technology Department Plan Project (2024-B02), the Tianjin Project to Promote the Transfer and Transformation of Scientific and Technological Achievements (25ZYCGCG00440), the Key Research and Development Program of Tianjin (No. 24YFXTHZ00230), the Open Research Fund of State Key Laboratory of Water Cycle and Water Security (IWHR) (Grant No.IWHR-SKL-KF202412), and the Open Research Fund Program of the State Key Laboratory of Hydroscience and Engineering (Grant No. sklhse-KF-2025-B-02).

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

The raw data supporting the conclusions of this article will be made available by the authors on request.

Acknowledgments

We are so grateful to the anonymous reviewers and editors for their suggestions.

Conflicts of Interest

The authors declare no conflicts of interest.

Appendix A

Appendix A.1. Evaluation Criteria for Key Control Items

Appendix A.1.1. Preventive Maintenance Scheme Determination

The maintenance scheme is determined based on field inspections, pavement condition surveys, and distress analysis. This stage is considered foundational to the entire maintenance process and thus requires careful evaluation. It includes three tertiary indicators: Timing Determination for Maintenance, Selection of Maintenance Scheme, and Clustering of Maintenance Sections. The evaluation criteria are shown in Table A1. The classification criteria for the evaluation indicators presented in Table A1, Table A2 and Table A3 are based on the Highway Performance Assessment Standards (JTG 5210-2018), issued by the Ministry of Transport of the People’s Republic of China.
Table A1. Evaluation Criteria for Maintenance Scheme Determination.
Table A1. Evaluation Criteria for Maintenance Scheme Determination.
Evaluation GradeExcellentGoodFairMarginalPoor
Score Range≥9080–8970–7960–69<60
Timing DeterminationReasonableRelatively ReasonableModerately ReasonablePartially UnreasonableUnreasonable
Selection of Maintenance SchemeReasonableRelatively ReasonableModerately ReasonablePartially UnreasonableUnreasonable
Clustering of Maintenance SectionsReasonableRelatively ReasonableModerately ReasonablePartially UnreasonableUnreasonable

Appendix A.1.2. Preparation for Maintenance Construction

The Preparation for Maintenance Construction includes four tertiary indicators: Material properties, Equipment Inspection and Maintenance, Personnel Allocation, and Technical Preparedness. The evaluation criteria are provided in Table A2.
Table A2. Evaluation Criteria for Preparation for Maintenance Execution.
Table A2. Evaluation Criteria for Preparation for Maintenance Execution.
Evaluation GradeExcellentGoodFairMarginalPoor
Score Range≥9080–8970–7960–69<60
Material properties
(Pass Rate)
≥90%80–89%70–79%60–69%<60%
Equipment Inspection and MaintenanceCompleteRelatively CompleteGenerally CompleteMissing Some EquipmentPoor
Personnel AllocationCompleteRelatively CompleteGenerally CompleteMissing Some StaffPoor
Technical PreparednessFully Innovative TechnologyDerived Innovative TechnologyImproved TechnologyMature TechnologyNon-Compliant Technology

Appendix A.1.3. Maintenance Execution Process

The execution process includes two tertiary indicators: Construction Process Control and Construction Quality Control. The former consists of two quaternary indicators: Development of Specialized Safety Protocols, and Construction Schedule Control. Detailed criteria are listed in Table A3.
Table A3. Evaluation Criteria for Maintenance Execution Process.
Table A3. Evaluation Criteria for Maintenance Execution Process.
Evaluation GradeExcellentGoodFairMarginalPoor
Score Range≥9080–8970–7960–69<60
Development of Specialized Safety ProtocolsCompleteRelatively CompleteModerately CompletePartially LackingPoor
Construction Schedule ControlExcellentGoodAverageBelow AveragePoor
Quality Control (Pass Rate)≥90%80–89%70–79%60–69%<60%
Appendix A.1.4. Technical Indicator Evaluation
The evaluation of technical indicators can be categorized into two main types: (1) short-term performance assessment, which measures the improvement in road performance resulting from maintenance interventions, and (2) service life assessment, which evaluates the long-term effectiveness of such interventions.
This study adopts four tertiary-level indicators for technical evaluation: subgrade condition assessment, pavement condition assessment, structural condition assessment of bridges and tunnels, and condition assessment of roadside facilities. Specifically, the pavement condition assessment includes eight quaternary-level indicators: Pavement Quality Index (PQI), Pavement Condition Index (PCI), Ride Quality Index (RQI), Rutting Depth Index (RDI), Bump Index (PBI), Pavement Wear Index (PWI), Skid Resistance Index (SRI), and Pavement Structural Strength Index (PSSI).
In Table A4, the short-term performance index is calculated as the ratio of the actual performance improvement to the expected improvement (default value: 100). The service life index is the ratio of actual to expected service life. Depending on the type of maintenance activity, specific performance indicators can be selected as control metrics. If these indicators fall below pre-maintenance standards or a defined threshold, the actual service life is considered reached.
Table A4. Basic Formulas for Technical Indicator Evaluation.
Table A4. Basic Formulas for Technical Indicator Evaluation.
Evaluation IndexWeight CoefficientCalculation Formula
Short-term Performance0.3(Actual Performance Gain/Expected Gain) × 100
Service Life Index0.7(Actual Service Life/Expected Service Life) × 100
(1) Subgrade Condition Assessment
Subgrade condition assessment is conducted by identifying and analyzing subgrade defects to evaluate its structural integrity and maintenance effectiveness. The Subgrade Condition Index (SCI) is employed as the key evaluation metric.
S C I = i = 1 i 0   w i 100 G D i S C I
where G D i S C I is the cumulative deduction value for the i-th type of subgrade damage (maximum score deduction is 100); w i is the weight assigned to the i-th type of damage; i represents the type of subgrade damage; i 0 is the total number of damage types, set to 7.
(2) Pavement Condition Assessment
Pavement condition assessment involves evaluating the extent to which pavement performance meets service requirements, based on collected condition data. This assessment provides insights into the overall service level of the road network, identifies sections requiring maintenance or rehabilitation, supports the selection of appropriate interventions, and assists in prioritizing projects. Moreover, it helps to analyze key factors affecting pavement performance and serves as a crucial component of pavement maintenance, economic analysis, and pavement management systems.
The assessment uses the Pavement Quality Index (PQI) as a composite measure, supported by the following sub-indices: Pavement Condition Index (PCI), Ride Quality Index (RQI), Rutting Depth Index (RDI), Bump Index (PBI), Pavement Wear Index (PWI), Skid Resistance Index (SRI), and Pavement Structural Strength Index (PSSI).
① Pavement Quality Index (PQI)
The PQI integrates evaluations of surface damage, roughness, rutting, bumping, surface wear, skid resistance, and structural strength:
P Q I = w P C I P C I + w R Q I R Q I + w R D I R D I + w P B I P B I + w P W I P W I + w S R I S R I + w P S S I P S S I
where w P C I , w R Q I , w R D I , w P B I , w P W I , w S R I , w P S S I are the corresponding weights for each sub-index.
② Pavement Condition Index (PCI)
The PCI evaluates pavement surface distress:
P C I = 100 a 0 D R a 1
D R = 100 × i = 1 i 0   w i A i A
where DR is Damage Ratio (%); a 0 = 15.00 (asphalt), 10.66 (concrete); a 1 = 0.412 (asphalt), 0.461 (concrete); A i is Area of the iii-th distress type (m2); A is Total surveyed area (m2); w i is Weight for distress type i; i 0 = 21 (asphalt), 20 (concrete).
③ Ride Quality Index (RQI)
RQI evaluates ride smoothness based on International Roughness Index (IRI):
R Q I = 100 1 + a 0 e a 1 I R I
where IRI is International Roughness Index (m/km); a 0 = 0.026, a 1 = 0.65 for expressways and class I roads; a 0 = 0.0185, a 1 = 0.58 for other road classes.
④ Rutting Depth Index (RDI)
RDI measures surface rutting severity:
R D I = 100 a 0 R D R D R D a 90 a 1 R D R a R D a < R D a R b 0 R D > R D b
where RD is Rut depth (mm); R D a = 10.0, R D b = 40.0; a 0 = 1.0, a 1 = 3.0.
⑤ Bump Index (PBI)
PBI assesses sudden vertical displacements caused by surface deformations:
P B I = 100 i = 1 i 0   a i P B i
where P B i is Count of bumps of severity level i; a i is Deduction value per bump for severity level i; i 0 = 3.
⑥ Pavement Wear Index (PWI)
PWI evaluates surface texture wear:
P W I = 100 a 0 W R a 1
W R = 100 × M P D C m i n M P D L , M P D R M P D C
where WR is Wear Ratio (%); a 0 = 1.696, a 1 = 0.785; MPDC is Center lane Mean Profile Depth (mm); MPDL, MPDR are Left and right wheel path MPD (mm).
⑦ Skid Resistance Index (SRI)
SRI quantifies pavement friction capability:
S R I = 100 S R I m i n 1 + a 0 e a 1 S F C + S R I m i n
where SFC is Side Force Coefficient; S R I m i n = 35.0; a 0 = 28.6, a 1 = −0.105.
⑧ Pavement Structural Strength Index (PSSI)
PSSI measures the structural integrity of pavement:
PSSI = 100 1 + a 0 e a 1 S S R
S S R = l R l 0
where SSR is Structural Strength Ratio; lR is Allowable deflection (mm); l 0 is Measured representative deflection (mm); a 0 = 15.71, a 1 = −5.19.
(3) Bridge and Tunnel Structure Assessment
The Bridge and Tunnel Structure Assessment involves comprehensive and detailed inspections of their operational state, defects, and damage. The goal is to evaluate their performance and the effectiveness of maintenance activities. The Bridge and Tunnel Condition Index (BCI) is used as the evaluation metric:
B C I = m i n 100 G D i B C I
where G D i B C I is Cumulative deduction score for the i-th type of structure, with a maximum deduction of 100; i is Type of structure (bridge, tunnel, culvert), totaling 3 types.
(4) Roadside Facility Condition Assessment
Roadside facilities are essential components of highways. They play a critical role in enhancing service levels, ensuring traffic safety, and maintaining road continuity. Therefore, a structured assessment of their condition is necessary. The Traffic Facility Condition Index (TCI) is employed for this purpose:
T C I = i = 1 i 0   w i 100 G D i T C I
where G D i T C I is Cumulative deduction score for the i-th type of facility damage, with a maximum deduction of 100; w i is Weight assigned to the i-th type of damage; i is Type of roadside facility damage; i 0 = 5, representing the total number of facility damage types.

Appendix A.1.5. Maintenance Fund Management

The assessment of maintenance fund management involves a comprehensive evaluation based on multiple factors, including the adequacy of budget allocation justifications, the standardization of the appropriation process, the rationality of funding standards, the legality and efficiency of fund utilization, budget overrun rates, and the proportion of funds involved in non-compliant activities. The corresponding rating criteria are presented in Table A5.
Table A5. Evaluation Criteria for Maintenance Fund Management.
Table A5. Evaluation Criteria for Maintenance Fund Management.
Evaluation GradeExcellentGoodFairMarginalPoor
Score Range≥9080–8970–7960–69<60
Rationality of Fund UtilizationExcellentGoodModerateGeneralPoor

Appendix A.1.6. Environmental Protection and Resource Utilization

This evaluation includes two tertiary indicators: Resource Utilization and Environmental Protection. The first indicator is further divided into two quaternary indicators: the Utilization of Renewable Energy and the Recycling of Old Pavement Materials (Table A6).
Table A6. Evaluation Criteria for Environmental Protection and Resource Utilization.
Table A6. Evaluation Criteria for Environmental Protection and Resource Utilization.
Evaluation GradeExcellentGoodFairMarginalPoor
Score Range≥9080–8970–7960–69<60
Utilization of Renewable EnergyHighRelatively HighModerateLowVery Low
Recycling of Old Pavement Materials≥90%≥80%, <90%≥70%, <80%≥60%, <70%<60%
Environmental ProtectionExcellentGoodModerateGeneralPoor

Appendix A.2. Determination of Indicator Weights for the Post-Evaluation of Highway Preventive Maintenance Technology Based on the AHP

The Analytic Hierarchy Process (AHP) has long been employed as a robust method for determining indicator weights within evaluation systems. By analyzing the logical structure and hierarchical relationships of evaluation objectives, AHP enables decision-makers to quantify subjective judgments using minimal data input. This approach is particularly suitable for complex indicator systems, where it helps derive consistent and reliable weights.
In this study, AHP is used to determine the weights of post-evaluation indicators for highway maintenance technology. The evaluation target is the overall technical performance of highway maintenance projects. The evaluation system is hierarchically decomposed into multiple layers—including goal, criteria, and sub-criteria layers. By solving eigenvectors of pairwise comparison matrices at each level, priority weights of elements are obtained and aggregated to form the final indicator weights.
To reduce subjectivity in the scoring process, a total of 20 experts were invited to participate in this study, including five representatives each from universities, transportation authorities, design institutes, and construction companies. These experts covered a wide range of professional fields such as maintenance design, construction management, road inspection, and evaluation.
The implementation of AHP involves the following key steps:
(1) Structuring the Decision Problem and Constructing the Judgment Matrix
The decision problem is first structured into a hierarchical model. For each layer, a pairwise comparison matrix A = a i j n × n is constructed based on the relative importance of elements. The value a i j represents the relative importance of indicator i compared to indicator j, using a standardized scale.
(2) Calculating Indicator Weights
Each row product of the judgment matrix is calculated, and the nth root is taken to derive the geometric mean vector. The normalized vector yields the weight vector w:
w i = j = 1 n a i j 1 n , i = 1,2 , , n
This vector w represents the priority weights of indicators at the current level.
(3) Consistency Check
To ensure the logical consistency of the pairwise comparisons, the Consistency Ratio (CR) is calculated as follows:
C I = λ max n n 1
λ max = 1 n i = 1 n A W i W i
C R = C I R I
The average Random Consistency Index (RI) is derived by repeatedly generating random pairwise comparison matrices and averaging their principal eigenvalues to obtain a statistical benchmark for consistency. The standard RI values for matrices of different sizes are shown in Table A7:
Table A7. Random Consistency Index (RI).
Table A7. Random Consistency Index (RI).
No.1234567891011
RI000.580.91.121.241.321.411.451.491.51
During the consistency test, if the Consistency Ratio (CR) is sufficiently small, the matrix is considered to meet consistency requirements and the weight calculation is deemed reliable. Otherwise, the result is considered unacceptable, and the matrix must be revised. Empirical studies have validated that a CR value less than 0.10 is generally acceptable.
(4) Synthesis of Weights Across Levels
To compute the global weights of each factor in the lowest layer (e.g., indicator level) with respect to the overall goal, a multiplicative synthesis approach is applied. Suppose the weights of n elements in the (k − 1)-th level with respect to the goal are:
W k 1 = w 1 k 1 , w 2 k 1 , , w n k 1 T
Taking the primary and secondary indicators of the post-evaluation system for highway maintenance engineering technology as an example, the Analytic Hierarchy Process (AHP) was applied to determine the corresponding indicator weights. Figure A1 illustrates the hierarchical structure of the post-evaluation system, in which the overall goal (Level 1) is the comprehensive post-evaluation of highway maintenance technology. The secondary indicators (criteria level) include six categories: Maintenance Scheme Determination (A), Preparation for Maintenance Construction (B), Maintenance Construction Process (C), Technical Indicator Evaluation (D), Maintenance Fund Management (E), and Environmental Protection and Resource Utilization (F). The tertiary indicators (sub-criteria level) represent the specific influencing factors under each secondary indicator and comprise 16 items in total, including Timing Determination for Maintenance, Maintenance Measures Selection, Maintenance Section Division, Material Inspection, Facility Deployment, Workforce Allocation, Technical Completeness, Construction Process Control, Construction Quality Control, Subgrade Condition Assessment, Pavement Condition Assessment, Structure Condition Assessment, Roadside Facility Assessment, Rationality of Fund Utilization, Resource Utilization, and Environmental Protection.
A pairwise comparison matrix for indicators A–F was constructed based on a detailed analysis of the post-evaluation framework and consultations with domain experts. The relative importance of each indicator was assessed through expert judgment, and a reciprocal matrix was developed accordingly (see Table A8).
Figure A1. Hierarchical structure of the post-evaluation system.
Figure A1. Hierarchical structure of the post-evaluation system.
Applsci 15 11377 g0a1
Table A8. Pairwise Comparison Matrix of Criteria Layer (A–F).
Table A8. Pairwise Comparison Matrix of Criteria Layer (A–F).
Criteria LevelABCDEF
Maintenance Scheme Determination (A)1630.528
Preparation for Maintenance Construction (B)0.16710.50.1250.252
Maintenance Construction Process (C)0.333210.1670.54
Technical Indicator Evaluation (D)286149
Maintenance Fund Management (E)0.5420.2516
Environmental Protection and Resource Utilization (F)0.1250.50.250.1110.1671
The maximum eigenvalue of the matrix was calculated as λmax = 6.1224. The consistency index (CI) was computed as: CI = (λmax − n)/(n − 1) = 0.0245; Given the random index (RI) for n = 6 is 1.24, the consistency ratio (CR) was: CR = CI/RI = 0.0197 < 0.1; Since CR < 0.10, the judgment matrix was considered to have acceptable consistency. The normalized eigenvector corresponding to λmax was derived as: WA = (0.251, 0.047, 0.088, 0.433, 0.151, 0.030) T.
This vector represents the weight distribution of the six secondary indicators in the post-evaluation system of highway maintenance technology. The weight calculations for the tertiary indicators under each secondary indicator were similarly conducted and are presented in Table A9, Table A10, Table A11, Table A12 and Table A13.
Table A9. Pairwise Comparison Matrix and Weight Calculation for Maintenance Scheme Determination (A).
Table A9. Pairwise Comparison Matrix and Weight Calculation for Maintenance Scheme Determination (A).
AA1A2A3Wi
A110.520.286
A22140.571
A30.50.2510.143
λmax = 3, CI = 0, RI = 0.58, CR = 0 < 0.10
Table A10. Pairwise Comparison Matrix and Weight Calculation for Preparation for Maintenance Construction (B).
Table A10. Pairwise Comparison Matrix and Weight Calculation for Preparation for Maintenance Construction (B).
BB1B2B3B4Wi
B114620.512
B20.25120.50.138
B30.1670.510.250.074
B40.52410.275
λmax = 4.0604, CI = 0, RI = 0.9, CR = 0.0224 < 0.10
Table A11. Pairwise Comparison Matrix and Weight Calculation for Maintenance Construction Process (C).
Table A11. Pairwise Comparison Matrix and Weight Calculation for Maintenance Construction Process (C).
CC1C2Wi
C1120.667
C20.510.333
λmax = 2, CI = 0, RI = 0, CR = 0 < 0.10
Table A12. Pairwise Comparison Matrix and Weight Calculation for Technical Indicator Evaluation (D).
Table A12. Pairwise Comparison Matrix and Weight Calculation for Technical Indicator Evaluation (D).
DD1D2D3D4Wi
D110.5240.275
D221460.512
D30.50.25120.138
D40.250.1670.510.074
λmax = 4.01, CI = 0.003, RI = 0.9, CR = 0.004 < 0.10
Table A13. P Pairwise Comparison Matrix and Weight Calculation for Environmental Protection and Resource Utilization (F).
Table A13. P Pairwise Comparison Matrix and Weight Calculation for Environmental Protection and Resource Utilization (F).
FF1F2Wi
F1120.667
F20.510.333
λmax = 2, CI = 0, RI = 0, CR ≤ 0.10
Using the AHP, the weights of all indicators within the post-evaluation system for highway maintenance engineering technology were systematically calculated and aggregated. Based on the multiplication principle, weights were synthesized from higher levels down to the lowest (factor) level. The final integrated results are summarized and presented in Table A14, which shows the computed weights for each indicator in the evaluation system.
Table A14. Pairwise Comparison Matrix of Criteria Level and Indicator Level (A–F).
Table A14. Pairwise Comparison Matrix of Criteria Level and Indicator Level (A–F).
Criteria LevelIndicator LevelABCDEFCombined Weight
0.2510.0470.0880.4330.1510.03
Maintenance
Scheme Determination
A
Timing Determination
for Maintenance
0.286 0.072
Selection of
Maintenance Scheme
0.571 0.144
Clustering of
Maintenance Sections
0.143 0.036
Preparation for
Maintenance Construction
B
Material properties 0.512 0.024
Equipment Inspection
and Maintenance
0.138 0.006
Personnel Allocation 0.074 0.003
Technical Preparedness 0.275 0.013
Maintenance
Construction Process
C
Construction Process
Control
0.667 0.058
Construction Quality
Control
0.333 0.029
Technical Indicator
Evaluation
D
Subgrade Condition
Assessment
0.275 0.119
Pavement Condition
Assessment
0.512 0.222
Bridge and Tunnel
Structure Assessment
0.138 0.06
Roadside Facility
Condition Assessment
0.074 0.032
Maintenance Fund
Management
E
Rationality of
Fund Utilization
1 0.151
Environmental Protection
and Resource Utilization
F
Resource Utilization 0.6670.02
Environmental
Protection
0.3330.01

References

  1. Ge, P. Research on Highway Asphalt Pavement Maintenance Technology. TranspoWorld 2019, 33, 24–25. [Google Scholar]
  2. Niu, F. Preliminary Discussion on Preventive Maintenance Technology of Asphalt Pavement. Priv. Sci. Technol. 2011, 12, 302. [Google Scholar]
  3. Lu, C. On the Relationship Between Highway Routine Maintenance and the Design and Construction of Highways. Guangdong Sci. Technol. 2014, 23, 132, 98. [Google Scholar]
  4. Zhang, L.; Wang, X.; Gao, T. Discussion of Contingency Maintenance for Asphalt Pavement. J. Munic. Technol. 2009, 27, 5–8. [Google Scholar]
  5. Liu, B.Z. Asphalt Pavement Preventive Maintenance Technology Overview. Appl. Mech. Mater. 2014, 638–640, 1135–1138. [Google Scholar] [CrossRef]
  6. Zhang, J. Evaluation Research on Preventive Maintenance Measures of Asphalt Pavement. J. Shandong Ind. Technol. 2017, 4, 261, 226. [Google Scholar]
  7. Xu, Y. The Optimal Timing of Preventive Maintenance of Highway Asphalt Pavements. Master’s Thesis, Chang’an University, Xi’an, China, 2009. [Google Scholar]
  8. Hu, G.; Li, J.; He, X. Post Evaluation Method for Preventive Maintenance Project of Expressway Asphalt Pavement. Road Mach. Constr. Mech. 2008, 7, 55–57. (In Chinese) [Google Scholar]
  9. Liu, Z. A Study on Post-Evaluation of Expressway PPP Projects Based on Analytic Hierarchy Process and Success Degree Method. Master’s Thesis, Lanzhou Jiaotong University, Lanzhou, China, 2023. [Google Scholar]
  10. Cuelho, E.; Mokwa, R.; Akin, M. Preventive Maintenance Treatment of Flexible Pavement: A Synthesis of Highway; The State of Montana Department of Transportation: Helena, MT, USA, 2006; pp. 11–20. [Google Scholar]
  11. Udelhofen, G. Scrub Cape Seal Provides Cost-Effective Solution. Asph. Contract. 2010, 24, 38, 40–42, 44. [Google Scholar]
  12. Wu, B. Brief Discussion on New Technology of Pavement Maintenance of American Highway. North. Commun. 2012, 11, 120–121. [Google Scholar]
  13. Zhang, H. Introduction to Preventive Maintenance Technology in the United States. Maint. Manag. 2017, 1, 46–49. [Google Scholar]
  14. Yang, R.; Zhang, C.; Zhou, Q.; Wei, Y. Study on Application of Novachip Ultra-Thin Layer. E3S Web Conf. 2021, 283, 01042. [Google Scholar] [CrossRef]
  15. Wu, Y. Comparative Analysis of Highway Maintenance Strategies at Home and Abroad. Maint. Manag. 2012, 5, 80–95. [Google Scholar]
  16. Highway Pavement and Bridge Maintenance Methods in France. J. China Foreign Highw. 1983, 2, 57–58.
  17. Li, F. Construction and Maintenance of French Expressways. Highw. Eng. 1989, 3, 21–24. [Google Scholar]
  18. Liu, J. Maintenance and Management of German and French Expressways. Shandong Commun. Sci. Technol. 1997, 1, 11–16. [Google Scholar]
  19. Wu, Y. Review on the Development of Pavement Maintenance Methods of French Expressways. Hunan Commun. Sci. Technol. 2001, 2, 56–58. [Google Scholar]
  20. Jiang, J. Research of Timing and Strategy of Asphalt Pavement Preventive Maintenance Based on Exponential Smoothing Method. Master’s Thesis, Hebei University of Technology, Tianjin, China, 2010. [Google Scholar]
  21. JTJ 073-96; Highway Maintenance Technical Specification. Ministry of Transport of the People’s Republic of China: Beijing, China, 1996.
  22. JTG/T 5142-01-2021; Technical Specifications for Preventive Maintenance of Highway Asphalt Pavement. Ministry of Transport of the People’s Republic of China: Beijing, China, 2021.
  23. DBJTJ/T-002-2005; Technical Guidelines for Highway Maintenance in Shaanxi Province. Shaanxi Provincial Department of Transportation: Xi’an, China, 2005.
  24. Fang, K. Study on Preventive Maintenance Decision and Post Evaluation of Asphalt Pavement. Master’s Thesis, Chang’an University, Xi’an, China, 2017. [Google Scholar]
  25. Yang, J. Evaluation on the Implementation Effect of Preventive Maintenance of Asphalt Pavement of Trunk Highways in Shaanxi Province. Master’s Thesis, Chang’an University, Xi’an, China, 2021. [Google Scholar]
  26. Henan Gaoyuan Highway Industry Co. Construction of Low-Noise Micro-Surfacing on Dedicated Lanes for Guangzhou Asian Games. TranspoWorld 2010, 11, 76–77. [Google Scholar]
  27. Li, X. Study on Application of Micro-Surfacing Technology of Asphalt Pavement with Low Noise. Master’s Thesis, Chang’an University, Xi’an, China, 2016. [Google Scholar]
  28. Wang, Z. Surface Function Analysis of Thus-12 Extremely Thin Overlay on Chengya Overpass in Sichuan. Sichuan Cem. 2020, 5, 160, 241. [Google Scholar]
  29. Li, J.; Liu, Z.; Zeng, G.; Li, H. Application of Extremely Thin Wearing Course in Preventive Maintenance Engineering of Guangming Expressway. Jiangxi Build. Mater. 2022, 6, 26–27, 31. [Google Scholar]
  30. Zhang, Y.; Song, X.; Wang, T.; Liu, Z.; Zhu, H. Application Technology of Warm-Mix Asphalt Ultra-Thin Overlay in Road Maintenance. Highway 2011, 1, 223–226. [Google Scholar]
  31. Yao, G. Study on the Mechanism of Post-Evaluation of Investment Projects; Economic Science Press: Beijing, China, 2002. [Google Scholar]
  32. The World Bank. Implementation Completion Report: Good Practices, Operational Policies of the World Bank Operational Manual; The World Bank: Washington, DC, USA; London, UK, 1994. [Google Scholar]
  33. Tang, X. Study on Theory and Application of Road-Bridge Investment Project Ex Post Evaluations. Ph.D. Thesis, Nanjing University of Aeronautics and Astronautics, Nanjing, China, 2005. [Google Scholar]
  34. Huang, S. Project Post-Evaluation Technical Research of Highway Construction. Master’s Thesis, Hebei University of Technology, Tianjin, China, 2008. [Google Scholar]
  35. Wang, W. Evaluation of Maintenance Management Decision-Making for Highway Asphalt Pavement. TranspoWorld 2011, 21, 106–107. [Google Scholar]
  36. Ma, S.; Wang, Y. Research on Evaluation System for Implementation Effect of Highway Maintenance Projects. J. China Foreign Highw. 2011, 31, 283–287. [Google Scholar]
  37. Wang, C. Discussion on the Construction of Performance Evaluation System for Highway Maintenance Management in Beijing. Highway 2007, 12, 123–128. [Google Scholar]
  38. Xu, J.; Wang, Z.; Yin, X. Study on the Post-Evaluation of Highway Asphalt Pavement Maintenance Engineering Technology. Highw. Traffic Technol. (Appl. Technol. Ed.) 2020, 16, 73–76. [Google Scholar]
  39. Wang, S. How to Evaluate the Effect of Preventive Maintenance Projects. Maint. Manag. 2016, 11, 30–36. [Google Scholar]
  40. Zhang, H. Research on Post-Evaluation Method for Asphalt Pavement Preventive Maintenance. Highw. Traffic Technol. (Appl. Technol. Ed.) 2019, 15, 178–180, 187. [Google Scholar]
  41. Tang, Y.; Zhou, D.; Zhao, T. Evaluation Model and Application on Preventive Maintenance Effect of Highway Based on SVM. Eng. Constr. 2020, 52, 72–77. [Google Scholar]
  42. Li, J.; Zheng, D.; Gao, M.; Zhao, Y. Evaluation and Analysis on the Application Effect of Preventive Maintenance Technology of Expressway. Shanxi Archit. 2020, 46, 136–138. [Google Scholar]
  43. Wang, Z. The Post-Evaluation System Study of Asphalt Pavement Preventive Maintenance. Transp. Energy Conserv. Environ. Prot. 2022, 18, 76–79. [Google Scholar]
  44. Ghalenoee, M. Environmental Assessment of Buildings through HQE® Method: Case Study of a Three-Story Residential Apartment in the 5th District of Isfahan. J. Environ. Stud. 2011, 37, 123–134. [Google Scholar]
  45. Guo, X. The Reference Study of French High Quality Environmental Evaluation System to the Development of Green Buildings in China. Master’s Thesis, South China University of Technology, Guangzhou, China, 2022. [Google Scholar]
  46. Liu, M.; Meng, C.; Zeng, L.; Hu, A.; Wang, X.; Deng, Y.; Dai, R. French High Quality Environment Assessment System and Application Research. Heat. Vent. Air Cond. 2023, 53, 22–27. [Google Scholar]
  47. Ding, Y.; Li, B. Study on GSAS Green Building Rating System in the Middle East Region. Urban. Archit. 2021, 18, 53–56, 59. [Google Scholar]
  48. Wang, Y. Green Building Assessment Research Based on Extenics Evaluation. Master’s Thesis, Dalian University of Technology, Dalian, China, 2016. [Google Scholar]
  49. Zhang, K. The Sustainable Building Assessment System: DGNB of Germany. Eco-City Green Build. 2015, 1, 42–45. [Google Scholar]
  50. Shang, Z. Introduction of LCA Method in DGNB and Case Study in China. Green Build. 2017, 9, 29–32. [Google Scholar]
  51. Orova, M.; Reith, A. Multiscalarity in International Sustainable Assessment Systems: A Qualitative Comparison of LEED, CASBEE, BREEAM, DGNB and ESTIDAMA on Building, Neighbourhood and City Scale. IOP Conf. Ser. Earth Environ. Sci. 2019, 290, 012056. [Google Scholar] [CrossRef]
  52. Zhang, S. Research on the Application of ESG System in China. Financ. Perspect. J. 2017, 11, 80–85. [Google Scholar]
  53. Huang, J.; Zhang, Y. How to Apply Balanced Scorecard. Logist. Technol. 2005, 12, 37–40. [Google Scholar]
  54. Liu, S.; Ding, Z.; Sun, Y.; Cui, M. Evaluation System for Modern Construction Industry Cluster Based on NESS Model. Sichuan Cem. 2022, 1, 64–65. [Google Scholar]
  55. Gao, Z. Review of CIPP Educational Evaluation Model. Teach. Adm. 1998, Z1, 57–59. [Google Scholar]
  56. ISO 31000:2018; Risk Management—Guidelines. International Organization for Standardization: Geneva, Switzerland, 2018.
  57. Sharma, K.D.; Srivastava, S. Failure mode and effect analysis (FMEA) implementation: A literature review. J. Adv. Res. Aeronaut. Space Sci. 2018, 5, 1–17. [Google Scholar]
  58. Rasool, M.; Franck, T.; Denys, B.; Halidou, N. Methodology and tools for risk evaluation in construction projects using Risk Breakdown Structure. Eur. J. Environ. Civ. Eng. 2012, 16 (Suppl. S1), s78–s98. [Google Scholar] [CrossRef]
  59. ISO. Risk Management—Principles and Guidelines; International Organization for Standardization: Geneva, Switzerland, 2009. [Google Scholar]
  60. Liu, W.; Ye, H. Construction of Food Safety Evaluation Index System Based on 4T. Saf. Environ. Eng. 2018, 25, 106–113. [Google Scholar]
  61. Zhang, Z.; Wang, M. Research and Application Progress of HACCP: A Review. Chin. J. Food Hyg. 1994, 3, 51–55, 62. [Google Scholar]
  62. Hall, D.C. Managing Fraud in Food Supply Chains: The Case of Honey Laundering. Sustainability 2023, 15, 14374. [Google Scholar] [CrossRef]
  63. Fan, Y.; Li, T.; Bao, D. Application and Management Status of HACCP at Home and Abroad: A Review. Chin. J. Food Hyg. 2001, 5, 38–42. [Google Scholar]
  64. Gao, P.; Ma, F.; Yan, Z. Research and Application of HACCP Management in China and Abroad. Chin. J. Public Health 2002, 10, 114–116. [Google Scholar]
  65. Salgot, M.; Priestley, G.K.; Folch, M. Golf Course Irrigation with Reclaimed Water in the Mediterranean: A Risk Management Matter. Water 2012, 4, 389–429. [Google Scholar] [CrossRef]
  66. Škerjanec, M.; Steinman, F.; Rak, G. Integrated Flood Management Based on Hazard Analysis Critical Control Point Approach. J. Flood Risk Manag. 2022, 15, e12769. [Google Scholar] [CrossRef]
  67. Möderl, M.; Sitzenfrei, R.; Lammel, J.; Apperl, M.; Kleidorfer, M.; Rauch, W. Development of an Urban Drainage Safety Plan Concept Based on Spatial Risk Assessment. Struct. Infrastruct. Eng. 2015, 11, 918–928. [Google Scholar] [CrossRef]
  68. El-Rawy, M.; Fathi, H.; Abdalla, F.; Alshehri, F.; Eldeeb, H. An Integrated Principal Component and Hierarchical Cluster Analysis Approach for Groundwater Quality Assessment in Jazan, Saudi Arabia. Water 2023, 15, 1466. [Google Scholar] [CrossRef]
  69. Doan, V.T.; Le, C.C.; Le, H.V.T.; Trieu, N.A.; Vo, P.L.; Tran, D.A.; Vu, T.T.H. Comprehensive Statistical Analysis for Characterizing Water Quality Assessment in the Mekong Delta: Trends, Variability, and Key Influencing Factors. Sustainability 2025, 17, 5375. [Google Scholar] [CrossRef]
  70. JTG 5421-2018; Code for Maintenance Design of Highway Asphalt Pavement. Ministry of Transport of the People’s Republic of China: Beijing, China, 2018.
  71. JTG 5142-2019; Technical Code for Maintenance of Highway Asphalt Pavement. Ministry of Transport of the People’s Republic of China: Beijing, China, 2019.
  72. JTG F40-2004; Technical Specifications for Construction of Highway Asphalt Pavement. Ministry of Transport of the People’s Republic of China: Beijing, China, 2004.
  73. JTG E20-2011; Test Specifications for Asphalt and Asphalt Mixtures in Highway Engineering. Ministry of Transport of the People’s Republic of China: Beijing, China, 2011.
  74. GB/T 23577-2009; State Administration for Market Regulation, Standardization Administration of the People’s Republic of China. Road Construction and Maintenance Machinery and Equipment—Basic Types, Identification and Description. State Administration for Market Regulation (SAMR): Beijing, China, 2009.
  75. JTG H30-2015; Code for Safety Operations in Highway Maintenance. Ministry of Transport of the People’s Republic of China: Beijing, China, 2015.
  76. JTG 5110-2023; Technical Standards for Highway Maintenance. Ministry of Transport of the People’s Republic of China: Beijing, China, 2023.
  77. T/THTS 001-2024; Technical Guide for Post-Evaluation of Highway Asphalt Pavement Maintenance Projects. Tianjin Highway Institute: Tianjin, China, 2024.
  78. JTG 5220-2020; Standards for Quality Inspection and Evaluation of Highway Maintenance Projects—Volume 1: Civil Engineering. Ministry of Transport of the People’s Republic of China: Beijing, China, 2020.
  79. JTG 5210-2018; Highway Performance Assessment Standards. Ministry of Transport of the People’s Republic of China: Beijing, China, 2018.
  80. JTG F71-2006; Technical Specification for Construction of Highway Safety Facilities. Ministry of Transport of the People’s Republic of China: Beijing, China, 2006.
  81. Wang, Y.L.; Zhang, L.; Zhou, Y.P.; Yin, L.; Wang, X.Y. Assessment of Ecological Environment Sensitivity in Chishui City Based on GIS Technology. Environ. Ecol. 2023, 5, 10–18. [Google Scholar]
  82. Yan, Z.B.; Li, C.X.; Zhou, M. Study on Quality Evaluation and Improvement Measures of Urban Road Construction. China Constr. 2025, 7, 83–85. [Google Scholar]
  83. Xu, X.; Wang, S.; Kang, F.; Li, S.; Li, Q.; Wu, T. Multi-Attribute Decision-Making Method in Preventive Maintenance of Asphalt Pavement Based on Optimized Triangular Fuzzy Number. Sustainability 2024, 16, 2787. [Google Scholar] [CrossRef]
  84. Ruggeri, M.; Zaki, M.G.; Vinci, G. Towards Social Life Cycle Assessment of Food Delivery: Findings from the Italian Case Study. Int. J. Life Cycle Assess. 2024, 29, 1007–1022. [Google Scholar] [CrossRef]
  85. Hu, G.; Shi, G.; Zhang, R.; Chen, J.; Wang, H.; Wang, J. Assessment of Intelligent Unmanned Maintenance Construction for Asphalt Pavement Based on Fuzzy Comprehensive Evaluation and Analytical Hierarchy Process. Buildings 2024, 14, 1112. [Google Scholar] [CrossRef]
  86. Li, H.L.; Si, J.Z.; Jia, W.D.; Fu, L.; Li, Q.; Yang, S.; Zhang, S. Multi-Objective Weighted Grey Target Decision-Making for Asphalt Pavement Preventive Maintenance Schemes Based on Three-Level Maintenance Standards. J. Beijing Univ. Technol. 2024, 50, 543–555. [Google Scholar] [CrossRef]
  87. Hao, J.; Sun, Z.; Xing, Z.; Pei, L.; Feng, X. Dual-Layer Fusion Model Using Bayesian Optimization for Asphalt Pavement Condition Index Prediction. Sensors 2025, 25, 2616. [Google Scholar] [CrossRef]
  88. Arun, V.; Suresha, S.N. Prediction of Pavement Maintenance Cost for Rural Roads at Network Level. J. Inst. Eng. India Ser. A 2025, 106, 489–509. [Google Scholar] [CrossRef]
  89. Lu, L.; D’Avigneau, A.M.; Pan, Y.; Sun, Z.; Luo, P.; Brilakis, I. Modeling Heterogeneous Spatiotemporal Pavement Data for Condition Prediction and Preventive Maintenance in Digital Twin-Enabled Highway Management. Autom. Constr. 2025, 174, 106134. [Google Scholar] [CrossRef]
  90. Zhao, K.; Xu, S.; Loney, J.; Visentin, A.; Li, Z. Road Pavement Health Monitoring System Using Smartphone Sensing with a Two-Stage Machine Learning Model. Autom. Constr. 2024, 167, 105664. [Google Scholar] [CrossRef]
  91. Jiang, D.; Cao, Z.; Gong, G.; Wang, C.; Gao, Y. VOCs Inhibited Asphalt Mixtures for Green Pavement: Emission Reduction Behavior, Environmental Health Impact and Road Performance. J. Clean. Prod. 2025, 489, 144671. [Google Scholar] [CrossRef]
  92. Huang, C. Advancements in Sustainable Pavement Materials: A Literature Review. Adv. Eng. Innov. 2025, 16, 175–192. [Google Scholar] [CrossRef]
  93. Li, P.; Ding, Z. Analysis of Environmental and Ecological Effects on New Techniques for Asphalt Pavement Materials. In Proceedings of the International Symposium on Water Resource and Environmental Protection (ISWREP), Xi’an, China, 20–22 May 2011; IEEE: Piscataway, NJ, USA, 2011; pp. 3532–3536. [Google Scholar] [CrossRef]
  94. Chen, G.; Zhao, S.; Li, P.; Wang, S.; Zhou, X.; Potekhin, V. The Improved Mountain Gazelle Optimizer for Spatiotemporal Support Vector Regression: A Novel Method for Railway Subgrade Settlement Prediction Integrating Multi-Source Information. Appl. Intell. 2025. Online ahead of print. [Google Scholar] [CrossRef]
  95. Yang, J. Stability Analysis of Embankment Slope Considering Water Absorption and Softening of Subgrade Expansive Soil. Water 2022, 14, 3528. [Google Scholar] [CrossRef]
  96. Qiong, X.; Shun, D.; Xu, W. A Study on Seepage Field in Subgrade Slope Subjected to Various Rainfall Patterns. J. Railw. Eng. Soc. 2014, 31, 35–39. [Google Scholar]
Figure 1. Keyword co-occurrence network of related literature.
Figure 1. Keyword co-occurrence network of related literature.
Applsci 15 11377 g001
Figure 2. Critical Control Point Decision Tree.
Figure 2. Critical Control Point Decision Tree.
Applsci 15 11377 g002
Figure 3. Scoring Results of Key Control Items in the Pre-Implementation Phase.
Figure 3. Scoring Results of Key Control Items in the Pre-Implementation Phase.
Applsci 15 11377 g003
Figure 4. Dendrogram of Key Control Items in the pre-implementation phase.
Figure 4. Dendrogram of Key Control Items in the pre-implementation phase.
Applsci 15 11377 g004
Figure 5. Scoring Results of Key Control Items in the mid-Implementation Phase.
Figure 5. Scoring Results of Key Control Items in the mid-Implementation Phase.
Applsci 15 11377 g005
Figure 6. Dendrogram of Key Control Items in the mid-implementation phase.
Figure 6. Dendrogram of Key Control Items in the mid-implementation phase.
Applsci 15 11377 g006
Figure 7. Scoring Results of All Key Control Items in the Post-Implementation Phase.
Figure 7. Scoring Results of All Key Control Items in the Post-Implementation Phase.
Applsci 15 11377 g007aApplsci 15 11377 g007b
Figure 8. Dendrogram of Key Control Items in the post-implementation phase.
Figure 8. Dendrogram of Key Control Items in the post-implementation phase.
Applsci 15 11377 g008
Table 1. Comparison of Indicator and Weight Determination Methods in Existing Post-Evaluation Frameworks.
Table 1. Comparison of Indicator and Weight Determination Methods in Existing Post-Evaluation Frameworks.
Evaluation TypeReferencesIndicator Determination MethodWeight Determination Method
Existing post-evaluation systemsMa et al. [36]Panorama analysis methodNot addressed
Wang et al. [37]Expert interviewsExpert judgment
Xu et al. [38]Expert interviewsExpert judgment
Existing preventive maintenance systemsHu et al. [8]Expert interviewsNot addressed
Wang et al. [39]Expert interviewsNot addressed
Zhang et al. [40]Economic-based indicatorsNot addressed
Tang et al. [41]Expert interviewsDecision function
Wang et al. [43]Expert interviewsNot addressed
This studyHACCP-InspiredAnalytic Hierarchy Process (AHP)
Table 2. Hazard Analysis for the Pre-Implementation Phase.
Table 2. Hazard Analysis for the Pre-Implementation Phase.
No.Task ObjectiveHazard TypesPotential Hazard FactorsRisk Identification Basis
1Maintenance plan formulationEEH, RUH, ESR, EQR, SBH, SLEHIncomplete analysis of historical pavement data; poor design safety/economy; inappropriate maintenance timing; poor sectioning; unreasonable measure selection; lack of local traffic demand consideration; disorganized planning leading to cost overruns.[22,70,71]
2Material
properties
RUH, ESR, EQR, SBHUse of unqualified materials; lack of standard inspection; long-distance material transportation.[72,73]
3Equipment
provision
RUH, ESR, EQR, SBHInadequate communication, power, lighting, and safety facilities; irregular maintenance of machinery; inefficient use; lack of pre-operation checks.[72,74]
4Personnel
configuration
ESR, EQR, SBHUnqualified technical staff; poor skill mastery; lack of motivation and discipline.[72,75]
5Technical
preparedness
EEH, RUH, ESR, EQR, SBHIncomplete technical preparation; insufficient staff training; increased risk of construction safety and quality issues.[72,76]
Table 3. Hazard Analysis for the Mid-Implementation Phase.
Table 3. Hazard Analysis for the Mid-Implementation Phase.
No.Task ObjectiveHazard TypesPotential Hazard FactorsRisk Identification Basis
1Construction process controlEEH, RUH, ESR, EQR, SBHImproper coordination of labor and equipment; poor organization; inadequate safety training; weak supervision; poor schedule and cost control; increased project costs and reduced social benefits.[72,76,77]
2Quality controlESR, EQR, SBH, SLEHInadequate inspection of contract compliance and material quality; failure in on-site verification and acceptance; surface defects such as unevenness and poor compaction; quality failures impacting public satisfaction; budget overruns.[72,76,78]
3Safety protectionESR, EQR, SBHIncomplete safety protocols; lack of emergency plans; traffic management failures; equipment misuse; storage safety issues; fire hazards due to poor prevention measures.[72,75,76]
Table 4. Hazard Analysis for the Post-Implementation Phase.
Table 4. Hazard Analysis for the Post-Implementation Phase.
No.Task ObjectiveHazard TypesPotential Hazard FactorsRisk Identification Basis
1Technical indicatorsESR, EQR, SBH, SLEHUntimely/inaccurate performance testing; poor road condition data; lack of load-bearing capacity monitoring causing structural damage and traffic interruption.[77,79]
2Financial managementESR, EQR, SBHPoor fund allocation and disbursement; lack of cost control; excessive overspending; salary arrears; inadequate cost awareness among staff; material waste and inefficient logistics.[22,70,71,77]
3Resource utilizationEEH, RUH, EQR, SBHLow adoption of energy-saving equipment; use of high-energy temporary facilities.[22,70,71,77]
4Environmental protectionEEH, RUH, SBH, SLEHEmissions from machinery (e.g., asphalt pavers, chip spreaders); GHG emissions from production; noise pollution; light pollution from nighttime construction; increased traffic emissions and noise affecting local residents’ well-being.[22,70,71,77]
Table 5. Identification of Critical Control Points in the Pre-Implementation Phase.
Table 5. Identification of Critical Control Points in the Pre-Implementation Phase.
No.Task ObjectiveQ1Q2Q3Q4Identified as CCP
1Maintenance plan formulationYesYesN/AN/AYes
2Material performanceYesYesN/AN/AYes
3Equipment provisionYesYesN/AN/AYes
4Personnel configurationYesYesN/AN/AYes
5Technical preparednessYesYesN/AN/AYes
Table 6. Critical Control Measures in the Pre-Implementation Phase.
Table 6. Critical Control Measures in the Pre-Implementation Phase.
No.Critical Control PointControl Measures
1Maintenance plan formulationPrecisely determine the timing of maintenance; accurately cluster maintenance sections to enable targeted interventions; select optimal maintenance measures to ensure defect resolution and quality improvement; fully consider local travel needs; ensure rational overall project design.
2Material performanceConduct standardized technical tests for all materials; select suppliers with reasonable transport distances to ensure logistics efficiency.
3Equipment provisionPerform routine checks according to technical specifications; operate machinery strictly as prescribed; conduct pre-operation adjustments and maintenance inspections.
4Personnel configurationPrepare construction personnel in line with technical requirements; enhance training on methods and procedures.
5Technical preparednessApply proven, innovative, or newly derived technical methods; provide comprehensive training to improve operational proficiency.
Table 7. Identification of Critical Control Points in the Mid-Implementation Phase.
Table 7. Identification of Critical Control Points in the Mid-Implementation Phase.
No.Task ObjectiveQ1Q2Q3Q4Identified as CCP
1Construction process controlYesYesN/AN/AYes
2Quality controlYesYesN/AN/AYes
3Safety protectionYesYesN/AN/AYes
Table 8. Critical Control Measures in the Mid-Implementation Phase.
Table 8. Critical Control Measures in the Mid-Implementation Phase.
No.Critical Control PointControl Measures
1Construction process controlEstablish special management protocols and training; define construction zones clearly; enhance workflow continuity; optimize work sequences to control project timelines; implement digital construction management to improve efficiency and equipment utilization.
2Quality controlStrictly verify construction parameters including layer thickness, smoothness, compaction, permeability, and skid resistance; adjust evaluation indicators as needed based on maintenance techniques; ensure compliance with applicable standards for new technologies.
3Safety protectionDevelop and enforce dedicated safety protocols; promote safety awareness and training; improve site safety measures and establish robust safety management mechanisms.
Table 9. Identification of Critical Control Points in the Post-Implementation Phase.
Table 9. Identification of Critical Control Points in the Post-Implementation Phase.
No.Task ObjectiveQ1Q2Q3Q4Identified as CCP
1Technical indicatorsYesYesN/AN/AYes
2Financial managementYesYesN/AN/AYes
3Resource utilizationYesYesN/AN/AYes
4Environmental protectionYesYesN/AN/AYes
Table 10. Critical Control Measures in the Post-Implementation Phase.
Table 10. Critical Control Measures in the Post-Implementation Phase.
No.Critical Control PointControl Measures
1Technical indicatorsContinuously monitor road performance to ensure alignment with design expectations. Key indicators include: Subgrade Condition Index (SCI), Pavement Quality Index (PQI), Pavement Condition Index (PCI), Ride Quality Index (RQI), Rut Depth Index (RDI), Bump Index (PBI), Pavement Wear Index (PWI), Skid Resistance Index (SRI), Pavement Structural Strength Index (PSSI), Bridge Condition Index (BCI), and Traffic Facility Index (TCI).
2Financial managementEstablish standardized funding management procedures; ensure reasonable allocation, disbursement, and supervision of funds; prevent cost overruns and project violations; enforce cost control mechanisms during construction preparation.
3Resource utilizationPromote renewable energy use and material recycling; increase the adoption of clean energy sources such as wind and solar; encourage hybrid renewable energy applications.
4Environmental protectionManage construction wastewater per regulations; centralize and dispose of solid waste promptly; use machinery compliant with emissions standards; implement noise and light pollution controls; enhance roadside greening efforts.
Table 11. Key Control Items in the Pre-Implementation Phase.
Table 11. Key Control Items in the Pre-Implementation Phase.
No.Critical Control PointKey Control Items
1Maintenance plan formulationTiming Determination for Maintenance
Clustering of Maintenance Sections
Selection of Maintenance Scheme
Consideration of Traffic Accessibility Needs
Overall Organizational Design
2Material propertiesTechnical Testing of Aggregates
Technical Testing of Asphalt
Testing of Other Material Properties
3Equipment provisionEquipment Inspection and Maintenance
Standardized Use of Equipment
Completeness of Equipment Deployment
4Personnel configurationPersonnel Allocation
Technical Training for Personnel
5Technical preparednessMaturity of Applied Technology
Technological Advancement
Innovativeness of Technology
Table 12. Key Control Items in the mid-Implementation Phase.
Table 12. Key Control Items in the mid-Implementation Phase.
No.Critical Control PointKey Control Items
1Construction process controlDevelopment of Specialized Management Protocols
Standardized Construction Practices
Construction Continuity
Construction Efficiency
Construction Schedule Control
2Quality controlStructural Layer Thickness Inspection
Compaction Degree Testing
Surface Evenness Testing
Permeability Testing
Skid Resistance Testing
Other Quality Parameter Testing
3Safety protectionDevelopment of Specialized Safety Protocols
Safety Training for Construction Personnel
Traffic Management at Construction Sites
Preparation of Emergency Safety Plans
Table 13. Key Control Items in the Post-Implementation Phase.
Table 13. Key Control Items in the Post-Implementation Phase.
No.Critical Control PointKey Control Items
1Technical indicatorsSubgrade Condition Assessment
Pavement Condition Assessment
Bridge and Tunnel Structure Assessment
Roadside Facility Condition Assessment
2Financial managementRationality of Fund Utilization
Financial Audit
3Resource utilizationMaterial Recycling and Reuse
Utilization of Renewable Energy
Use of Clean Energy
Application of Energy-Saving Equipment
4Environmental protectionSoil and Water Environment Protection
Solid Waste Management
Control of Noise and Light Pollution
Landscape Greening
Table 14. Technical Post-Evaluation Indicator System for Highway Preventive Maintenance Projects.
Table 14. Technical Post-Evaluation Indicator System for Highway Preventive Maintenance Projects.
Level 1 IndicatorLevel 2 IndicatorLevel 3 IndicatorLevel 4 Indicator
Highway
Preventive
Maintenance
Technology
Maintenance
Scheme
Determination
Timing Determination for Maintenance
Selection of Maintenance Scheme
Clustering of Maintenance Sections
Preparation for
Maintenance
Construction
Material propertiesTechnical Testing of Aggregates
Technical Testing of Asphalt
Testing of Other Material Properties
Equipment Inspection and Maintenance
Personnel Allocation
Technical Preparedness
Maintenance
Construction
Process
Construction Process ControlDevelopment of Specialized Safety Protocols
Construction Schedule Control
Construction Quality Control
Technical
Indicator
Evaluation
Subgrade Condition AssessmentSubgrade Condition Index (SCI)
Pavement Condition AssessmentPavement Quality Index (PQI)
Pavement Condition Index (PCI)
Ride Quality Index (RQI)
Rutting Depth Index (RDI)
Bump Index (PBI)
Pavement Wear Index (PWI)
Skid Resistance Index (SRI)
Pavement Structural Strength Index (PSSI)
Bridge and Tunnel Structure AssessmentBridge Condition Index (BCI)
Roadside Facility Condition AssessmentTraffic Facility Condition Index (TCI)
Maintenance
Fund
Management
Rationality of Fund Utilization
Environmental
Protection
and Resource
Utilization
Resource UtilizationUtilization of Renewable Energy
Recycling of Old Pavement Materials
Environmental Protection
Table 15. Weights and Scores of Technical Post-Evaluation Indicator System for Highway Preventive Maintenance Projects.
Table 15. Weights and Scores of Technical Post-Evaluation Indicator System for Highway Preventive Maintenance Projects.
Level 1 IndicatorLevel 2 IndicatorWeightScoreLevel 3 IndicatorWeightScoreLevel 4 IndicatorWeightScore
Highway Preventive Maintenance TechnologyMaintenance Scheme Determination0.25125Timing Determination for Maintenance0.0727
Selection of Maintenance Scheme0.14414.5
Clustering of Maintenance Sections0.0363.5
Preparation for Maintenance Construction0.0475Material properties0.0242.5Technical Testing of Aggregates0.0080.5
Technical Testing of Asphalt0.0080.5
Testing of Other Material Properties0.0081.5
Equipment Inspection and Maintenance0.0060.5
Personnel Allocation0.0030.5
Technical Preparedness0.0131.5
Maintenance Construction Process0.0889Construction Process Control0.0586Development of Specialized Safety Protocols0.0293
Construction Schedule Control0.0293
Construction Quality Control0.0293
Technical Indicator Evaluation0.43343Subgrade Condition Assessment0.11912Subgrade Condition Index (SCI)
Pavement Condition Assessment0.22222Pavement Quality Index (PQI)0.027753
Pavement Condition Index (PCI)0.027753
Ride Quality Index (RQI)0.027752.5
Rutting Depth Index (RDI)0.027753
Bump Index (PBI)0.027752.5
Pavement Wear Index (PWI)0.027752.5
Skid Resistance Index (SRI)0.027752.5
Pavement Structural Strength Index (PSSI)0.027753
Bridge and Tunnel Structure Assessment0.066Bridge Condition Index (BCI)
Roadside Facility Condition Assessment0.0323Traffic Facility Condition Index (TCI)
Maintenance Fund Management0.15115Rationality of Fund Utilization0.15115
Environmental Protection and Resource Utilization0.033Resource Utilization0.022Utilization of Renewable Energy0.011
Recycling of Old Pavement Materials0.011
Environmental Protection0.011
Table 16. Evaluation Score of Maintenance Scheme Determination.
Table 16. Evaluation Score of Maintenance Scheme Determination.
Level 2 IndicatorLevel 3 IndicatorMaintenance DescriptionScore
Maintenance Scheme Determination (25 pts)Timing Determination for Maintenance (7 pts)Pavement condition data show a PQI score of 88 and a PCI score of 77. The surface damage level is Fair. If maintenance is not conducted in time, further deterioration may occur, resulting in increased costs and significant impacts on road functionality. Based on standards, PQI = 88 meets the timing requirement; PCI = 77 is slightly below the requirement. Overall assessment: Good. Score: 7 × 85% = 6.6
Selection of Maintenance Scheme (14.5 pts)According to the Specifications for Maintenance Design of Highway Asphalt Pavement (JTG 5421-2018), functional maintenance is recommended for this project. In practice, milling and resurfacing was adopted for the surface layer, while patch repairs (either surface or base layer) were implemented at specific damaged locations. The overall strategy complies with the standard, though localized patching decisions were insufficiently justified. Overall assessment: Excellent. Score: 14.5 × 90% = 13.13
Clustering of Maintenance Sections (3.5 pts)According to the Specifications for Maintenance Design of Highway Asphalt Pavement (JTG 5421-2018), it suggests dividing road sections by kilometers, with finer segmentation for special sections. In this project, sections were generally divided by kilometers, meeting the requirement, but some special segments were not subdivided in detail. Overall assessment: Good. Score: 3.5 × 85% = 3.3
Table 17. Evaluation Score of Preparation for Maintenance Construction.
Table 17. Evaluation Score of Preparation for Maintenance Construction.
Level 2 IndicatorLevel 3 IndicatorMaintenance DescriptionScore
Preparation for Maintenance Construction
(5 pts)
Material properties (2.5 pts)The technical specifications of raw materials used in the pavement structure must comply with the Technical Specifications for Construction of Highway Asphalt Pavements (JTG F40-2004 [72]), and all materials delivered to the site must undergo quality testing. Approval based solely on supplier reports or inspection certificates is not permitted. This project met all requirements. Full score awarded.2.5
Equipment Inspection and Maintenance (0.5 pts)Adequate provision of water, electricity, construction equipment, materials, and essential living supplies must be ensured. This project met all relevant requirements. Full score awarded.0.5
Personnel Allocation (0.5 pts)This content was not included in the project documentation. No score assigned.
Technical Preparedness (1.5 pts)The project adopted mature and conventional technologies. According to the evaluation standard, this item is rated as “Fair.” Score: 1.5 × 65% = 1.1
Table 18. Evaluation Score of Maintenance Construction Process.
Table 18. Evaluation Score of Maintenance Construction Process.
Level 2 IndicatorLevel 3 IndicatorMaintenance DescriptionScore
Maintenance Construction Process (9 pts)Construction Process Control (6 pts)For construction safety, prior to commencement of the Jinghuan Expressway maintenance project, the supervising engineer, technical personnel, and project leader conducted technical briefings, quality briefings, and safety education for all workers. Personnel responsibilities were clearly defined. The entire construction process strictly followed relevant provisions in the Technical Specifications for Construction of Highway Safety Facilities (JTG F71-2006 [80]). The project was completed within the scheduled timeline. Full score awarded.6
Construction Quality Control
(3 pts)
The construction quality of this project was not adequately controlled, lacking temperature monitoring, asphalt content tests, and total gradation inspections of aggregates. According to the evaluation standard, this item is rated as “Fair.” Score: 3 × 65% = 2.2
Table 19. Evaluation Score of Technical Indicator Evaluation.
Table 19. Evaluation Score of Technical Indicator Evaluation.
Level 2 IndicatorLevel 3 IndicatorLevel 4 IndicatorScore DescriptionScore
Technical Indicator Evaluation (43 pts)Subgrade Condition
Assessment (12 pts)
Pavement Condition
Assessment (22 pts)
PQI (3 pts)Based on pavement condition survey, rated as “Fair”; score = 3 × 65% = 2.2
PCI (3 pts)Based on pavement condition survey, rated as “Fair”; score = 3 × 65% = 2.2
RQI (2.5 pts)Based on pavement condition survey, rated as “Fair”; score = 3 × 65% = 2.1
RDI (3 pts)Based on pavement condition survey, rated as “Fair”; score = 3 × 65% = 2.3
PBI (2.5 pts)Based on pavement condition survey, this item received full score.2.5
PWI (2.5 pts)Based on pavement condition survey, this item received full score.2.5
SRI (2.5 pts)Based on pavement condition survey, this item received full score.2
PSSI (3 pts)
Bridge and Tunnel Structure
Assessment (6 pts)
Roadside Facility
Condition
Assessment (3 pts)
Table 20. Maintenance Fund Management.
Table 20. Maintenance Fund Management.
Level 2 IndicatorLevel 3 IndicatorMaintenance DescriptionScore
Maintenance Fund Management (15 pts)Rationality of Fund Utilization (15 pts)The project complied with official fund allocation procedures. Detailed audit reports were provided. The project met all regulatory requirements. Therefore, this item received a full score.15
Table 21. Evaluation Score of Environmental Protection and Resource Utilization.
Table 21. Evaluation Score of Environmental Protection and Resource Utilization.
Level 2 IndicatorLevel 3 IndicatorLevel 4 IndicatorMaintenance DescriptionScore
Environmental Protection and Resource Utilization (3 pts)Resource Utilization (2 pts)Utilization of Renewable Energy (1 pt)No clean energy was used in this project. Therefore, this item received a score of 0.0
Recycling of Old Pavement Materials (1 pt)All milled old pavement materials were fully recovered, achieving a 100% recycling rate. This item received a full score.1
Environmental Protection (1 pt)Measures were implemented for noise control, air quality protection, water environment protection, solid waste management, and ecological conservation. The project complied with relevant regulations and thus received a full score.1
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Fang, N.; Wang, C.; Chang, H. An HACCP-Inspired Post-Evaluation Framework for Highway Preventive Maintenance: Methodology and Case Application. Appl. Sci. 2025, 15, 11377. https://doi.org/10.3390/app152111377

AMA Style

Fang N, Wang C, Chang H. An HACCP-Inspired Post-Evaluation Framework for Highway Preventive Maintenance: Methodology and Case Application. Applied Sciences. 2025; 15(21):11377. https://doi.org/10.3390/app152111377

Chicago/Turabian Style

Fang, Naren, Chen Wang, and Huanyu Chang. 2025. "An HACCP-Inspired Post-Evaluation Framework for Highway Preventive Maintenance: Methodology and Case Application" Applied Sciences 15, no. 21: 11377. https://doi.org/10.3390/app152111377

APA Style

Fang, N., Wang, C., & Chang, H. (2025). An HACCP-Inspired Post-Evaluation Framework for Highway Preventive Maintenance: Methodology and Case Application. Applied Sciences, 15(21), 11377. https://doi.org/10.3390/app152111377

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
