Next Article in Journal
Optimization of Sensor Positions and Orientations for Multiple Load Case Scenarios
Previous Article in Journal
Error-Function-Based Penalized Quantile Regression in the Linear Mixed Model

Font Type:
Arial Georgia Verdana
Font Size:
Aa Aa Aa
Line Spacing:
Column Width:
Background:
Article

Monte Carlo Simulation for Enhancing the Schedule Completion Forecast of Jakarta Central Railway Station Construction Project

1
Binus Management, BINUS Business School Undergraduate Program, Bina Nusantara University, Jakarta 10270, Indonesia
2
Civil Engineering Department, Faculty of Engineering, Universitas Indonesia, Depok 16424, Indonesia
*
Author to whom correspondence should be addressed.
Appl. Sci. 2025, 15(13), 7464; https://doi.org/10.3390/app15137464
Submission received: 29 May 2025 / Revised: 21 June 2025 / Accepted: 25 June 2025 / Published: 3 July 2025
(This article belongs to the Section Civil Engineering)

Abstract

Some construction projects in Indonesia have been experiencing frequent major delays, and there is an urgent need to perform a comprehensive schedule forecast to anticipate them. This study aims to enhance the forecast of the project-completion schedule of a major railway construction project in Indonesia, with considerations of the identified project risks. Using structured interviews of practitioners and experts, this study has identified key risks in the Phase II Construction project. The @RISK V8.5.1 software was used to run Monte Carlo Simulation to calculate the scheduling forecast more accurately with the PERT method. The results of the scheduling simulation on the inherent key risks that affect key activities in the critical path show that there are additional days due to pre-mitigation during the construction of the project, ranging from 130.81% to 136.25% of the initial contract completion duration to approximately 95.82% to 102.23% of the original contract completion duration. This research provides a way not only to identify and prioritize the risks but also to quantify them to estimate the project completion schedule more up to 95% accuracy using Monte Carlo Simulation, where the model can be used to plan and monitor the risks of future projects.

1. Introduction

The infrastructure development program is the main target of the Indonesia government, which aims to grow the economy and national connectivity. Limitations and delays in infrastructure development in Indonesia make it difficult for Indonesia’s economy to develop. Infrastructure investment in Cameroon heavily influences economic and private-sector growth [1]. Transportation infrastructure is important in supporting economic growth in the United Kingdom. Improving connectivity, and facilitating trade and investment are two of the goals of building a strong infrastructure supporting economic development in the United Kingdom [2]. By influencing production and consumption patterns and promoting sustainable economic development through higher tourism and private consumption, rail infrastructure impacts economic growth in China [3]. Transportation infrastructure, particularly railways, significantly affects economic growth by improving connectivity, reducing transportation costs, and facilitating trade. Investment in railway projects can increase efficiency in the movement of goods and people, stimulating the local economy and attracting investment [4]. According to [5], delays in railway projects significantly hamper economic growth, as timely implementation of transport networks is critical to development. In developing countries such as Vietnam, economic growth is one of the significant obstacles, one of which is the problem of postponing the railway project schedule [6]. Despite the performed studies in emerging markets, they lack evidence in the context of complex construction work, such as central station building, due to interdependencies with several factors, such technical, social, interface-management, and any other related factors.
One of the ways to support the government’s program in growing the economic sector in Indonesia is to revitalize the Jakarta Central.
Jakarta Central Railway Station Construction Project Phase II, one of the largest and busiest central stations in Indonesia, has a very complex location, and the implementation of the project has experienced a very significant delay. According to the initial contract, the construction of the Railway Station Phase II project began on 11 October 2019 and is planned to be completed on 30 September 2021.
Based on Figure 1, which was obtained from the author’s research results through project archive studies, the construction of Railway Station Phase II should have been completed on 30 September 2021; however, the actual progress achieved on that day was merely 42.08%, resulting in a delay deviation of −57.92% [7]. However, significant delays led to the project’s completion on 31 January 2024, a delay of approximately 2.5 years where the risks are identified and qualitatively assessed, as shown in Figure 1.
The delayed construction of the station has negatively impacted the project owner, causing increased operational challenges and financial losses. Furthermore, the commuters were disappointed, and it led to negative perceptions and complaints that spread across the train users. Project owners face reputational risks, while service providers struggle [8].
The delay problem occurs because, in managing the project and the estimated schedule and controlling the project schedule with ineffective risk management, minimal risk management will have an impact on risk. Risk analysis and probabilistic methods are used for scheduling simulations, ensuring timely completion and minimizing delays [9].
This research aims to identify the risks in the project causing the delay, assess them using quantitative risk analysis, and enhance the project completion forecast based on the prioritized risks with PERT and Monte Carlo Simulation. It examines several occurrences of delays in global railway projects, using the Jakarta Central Railway Station Phase II Construction in Indonesia as a case study. Furthermore, to mitigate the unpredictability of scheduling risk, the PERT analysis approach is employed to estimate the time of essential tasks via three-point estimation. This study uses the Monte Carlo Simulation probabilistic method to assess the influence of risk, estimate variations in activity length, and predict project completion time with greater precision.
This research is grounded in a case study of the Phase II Development of the Jakarta Central Railway Station, with a focus on three main problem formulations:
(a)
What are the indicators that cause the risk of delay in completing the construction project (RQ1)?
(b)
How can the risk-based simulation of the project implementation scheduling be established to optimize the project’s completion time (RQ2)?
(c)
What are the appropriate risk response strategies and recommendations to respond to the risks that have a major impact on the construction schedule to optimize the project completion time (RQ3)?
This study’s primary benefit is quantifying the risk of project delays, which can be used as lessons to prevent future occurrences, particularly in railway station construction projects.

2. Literature Review

A theory is defined as a collection of logically coherent statements regarding a phenomenon that effectively encapsulates current empirical understanding, systematically arranges this knowledge through precise relational statements among variables, offers an explanation for the phenomenon, and serves as a foundation for predicting behavior [10]. In risk management, theory provides the foundation for understanding, predicting, and managing risk based on basic principles and assumptions. Some of the key theories that are relevant to explaining the concept of risk and risk analysis include probability theory, rational model theory, utility theory, and prospect theory. Theory used in this study is utility theory. Utility theory is used in risk analysis to evaluate decision scenarios under uncertainty by selecting options that maximize expected utility. This theory is also applied in risk modeling and simulation to simulate decision-making behavior in complex systems and test various scenarios [11]. The use of utility theory on EMV (Expected Monetary Value) helps to measure not only the expected number of risky decisions but also to consider the expected satisfaction based on risk preferences. EMV is a risk analysis tool that measures the financial impact of potential events by multiplying their probabilities and impacts, helping project managers make data-driven decisions to choose the best risk mitigation strategies.

2.1. Program Evaluation and Review Technique (PERT)

From some of the literature reviews mentioned above, it can be concluded that the delay of railway projects is a serious problem in the world that needs to be solved, including in Indonesia. To address the issue above, one approach is to employ a Monte Carlo Simulation to incorporate uncertainty and generate a more precise range of scheduling solutions, enhancing the accuracy of the entire scheduling-estimation process. Simultaneously, the Program Evaluation and Review Technique (PERT) offers a probabilistic method for estimating activity durations through a three-point estimation methodology [12]. The framework will employ Monte Carlo Simulation to estimate fluctuations in activity duration and anticipate project completion time with greater accuracy. The simulation-based methodology enhances project schedule risk analysis by including novel equations for quantifying duration risk in PERT method analysis. This approach facilitates improved decision-making in ambiguous contexts [13]. Efficient scheduling is crucial for railway projects to minimize delays and ensure timely completion. PERT methodology and Monte Carlo Simulation assess project-completion probability and identify time-critical paths.
The Program Evaluation and Review Technique (PERT) method is a dependable analytical approach for managing delays in railway project scheduling. The PERT method facilitates time estimation and project monitoring through a systematic methodology [14,15,16]. PERT offers systematic scheduling and resource estimation methodology, aiding in managing identified risks among uncertainty. According to [17], the delineation of PERT constitutes a methodology for approximating project duration through a weighted mean of optimistic (O), pessimistic (P), and most likely (ML) to estimate activity durations in the presence of ambiguity regarding individual activity assessments. The PERT equation comprises three elements (O, P, and ML) that employ a weighted mean of the three approximated values, presupposing a beta probability distribution for the temporal estimations, as delineated by [16].
T e = O + 4 M L + P 6
where T e represents the expected time (in days); optimistic (O), in days, denotes the minimum duration required to accomplish the task; most likely (ML), in days, signifies the duration with the greatest likelihood of completion; and pessimistic (P), in days, shows the maximum duration necessary to finish the task. According to [18], the timely completion of a project by the planned likelihood is assessed with a normal distribution, utilizing the subsequent formula:
Z = D T e σ c p 2
where Z is the standard measurement of the deviation from the actual value to the mean value, σ c p 2 (in days) shows the variation in individual activities on the critical path, and D (in days) indicates the likelihood that the period will be fulfilled by the deadline.
The studies of [5] stated that the PERT method was used to analyze the delays in the scheduling of railway projects. Meanwhile, ref. [13,19] utilized a combination of AHP and PERT in optimizing the schedule-completion forecast in their study. Previous studies have been conducted using various techniques, which have resulted in differing risk variable assessments, as each project’s geographical conditions will vary according to its cultural context. According to a study by [20], focus-group discussions (FGDs) serve to accurately evaluate the risks and impacts of project activities, as respondents are selected among experts engaged in the relevant case studies. Subsequently, data analysis will employ critical path data and the Critical Path Method (CPM) on historical project scheduling data, along with PERT, to forecast duration uncertainty and mitigate project risks [13,21]. Meanwhile, ref. [22] used both PERT and M-PERT to compare the scheduling result for a construction project.
Furthermore, some studies employed the Monte Carlo technique with @Risk software as simulation method, which successfully analyzes the probability of project completion. Refs. [12,13,23], applied Earned Value Management, CPM, and PERT in estimating construction project duration and costs. A risk-based approach to estimate the duration of the project schedule will be used in performing the calculation using the probabilistic method PERT with help from Monte Carlo Simulation.

2.2. Monte Carlo Simulation (MCS)

Quantitative risk analysis is a mathematical method used to predict the likelihood and consequences of risks, identifying primary reasons for construction project delays by analyzing literature data and assessing their impact levels. According to [13,24], qualitative risk analysis evaluates potential project hazards through a systematic methodology employing numerical and static methodologies. This method aims to assess the potential impact of diverse risks to enhance decision-making and resource-allocation efficiency. According to Nguyen, qualitative analysis can integrate findings with quantitative methods such as Monte Carlo Simulation (MCS) to evaluate the overall risk value. The impact of risk and the development of effective risk management strategies can create a better understanding of risk [6]. We propose that employing a novel equation for total risk value alongside Monte Carlo Simulation enables the estimation of activity duration variability. This approach is very effective for assessing the likelihood of train delays. This strategy can enhance the accuracy of project completion time predictions by adhering to deadlines [13]. This is an illustration of a Monte Carlo probability distribution, as suggested by [25].
Figure 2 illustrates an example of Probability Density Distribution for Input and Cumulative Probability Distribution derived from the study of [25]. The procedure and process for Monte Carlo Simulation analysis is as follows: (1) Probability distribution of many random variables and stochastic experimental values is sampled. (2) Input sample data are processed to yield computed results inside a deterministic model. (3) The selected outcome values for this experiment, including the time and cost for completion, are recorded in a file. (4) To achieve a substantial quantity of experimental results and the desired precision, revert to step 1. (5) Preserving analytical outcomes. Repeated and uniform distribution sampling will yield an estimate of the expected time. If the value is mathematically proximate, then the outcomes of random sampling will be acquired:
V = X f x d x
where V is the expected value (in days), x represents the outcome value (in days), f(x) is the probability density function, and d x represents the infinitesimal elements of random variables x (in days). The straightforward yet sophisticated simulation process conducts integration on our behalf. The integration of X(fx) is highly significant in most pertinent assessment issues. According to [26], the following formula determines the number of iterations:
σ = i = 1 k ( x i x ¯ ) 2 k 1
ε = x ¯ 1 R E
n = 3 σ ε 2
where σ (in days) is the standard deviation, xi (in days) is the data value of each population member, x ¯ (in days) is the overall data mean, k is the number of data, ε (in days) is the absolute standard error, RE is the maximum error value, and n is the number of iterations.
This study applies the PERT technique to refine the schedule completion forecast using the Monte Carlo Simulation, with estimated duration based on the identified risks using the structured risk from previous study. Confidence levels of 80%, 90%, and 95% were chosen to increase the likelihood and enhance the schedule completion forecast based on the calculated duration estimates. The refinement of the risk-based calculation method shall be the major contribution of this study.

3. Research Methodology

According to [27], there are three conditions that determine the research strategy: the form of the research question (RQ), control over the events being researched, and focus on contemporary events (Contemporary/historical events). A research strategy was established for each research question in this study. For the RQ1 research process, the methodology is based on a literature review, archival analysis, and historical data from case studies. Subsequently, expert validation is performed by qualitative analysis utilizing the Delphi method and focus-group discussions (FGDs). This research method is to identify the indicators associated with the reasons for delays in the completion of the Railway Station Phase II Construction Projects. Meanwhile, to answer RQ2, a literature review, archival analysis, and historical data examination were conducted. Additionally, qualitative analysis encompassing the pre-risk mitigation phase was performed throughout the focus group-discussion phase. Finally, to answer RQ3, PERT techniques and Monte Carlo Simulation with @Risk Software from Lumivero for quantitative analysis were established to create a simulation for scheduling the implementation of Phase II of the Railway Station Development Project, encompassing both post-risk mitigation phases.
The Critical Path Method (CPM) quantitative analysis regarding essential scheduling activities for RQ2 and RQ3 was conducted utilizing archive data from a case study involving MS Project V2016 software. The calculated values from RQ2 and RQ3 will be treated as inputs to estimate the total duration, which is calculated using MS Project by entering the calculated PERT values, theoretical values, and simulated values. Those three types of values are compared, and deviations with the initial baseline based on the contract are also calculated. The calculation is performed based on 22 of the initial 51 risk factors for railway project delays, derived from various literature surveys and research findings from the previous research results [7]. The qualitative analysis is employed to validate the data of 51 variables related to railway project delay risk, where 22 risks were validated, while the rest were eliminated due to insignificance of the delay, as per the findings of that study. Furthermore, confidence levels (α) of 80%, 90%, and 95% are suggested according to various previous studies, delineating the confidence level (α) value and the number of iterations from various literature reviews on railway project delays [6,13,28,29]. This study differentiated the confidence level (α) according to theoretical and simulated values. This study also suggested 10000 iterations in order to have much better results.
The criteria for survey respondent profiles are essential for guaranteeing the reliability and validity of survey outcomes. These criteria include several elements, such as demographic attributes, recruitment techniques, and response behaviors, which collectively influence the quality of the obtained data. The respondent experts consist of five individuals who are both physically and mentally healthy; possess at least a bachelor’s degree in civil engineering; and have academic or practical experience in railways and the construction of buildings, bridges, or railway operations facilities, with a minimum of ten years of relevant work experience. Five respondents were selected: four of them are from contractors, and one of them is an academic, with experience ranging from 18 to 37 years.

4. Discussion

4.1. Data Collection for, and Analysis and Discussion of Research Question 1 (RQ 1)

The initial step of RQ1 data collecting is derived from the findings with additional data based on the research conducted by [7]. The data collection process at this stage begins with the gathering of both primary and secondary data from the case studies, and this process involves locating various literature articles concerning railway project delays globally and compiling historical and archival data from these case studies.
The qualitative analysis was performed to identify the most significant risk in each critical scheduling action. A focus-group discussion with five railway specialists was performed to identify the primary variables influencing the completion time of a project work activity. This study employed focus-group discussions (FGDs) to identify the primary risk indicators influencing scheduling, following these steps: (1) Experts were briefed on the overarching objectives, background, and research subjects, and allowed a question-and-answer session to synchronize research perspectives. (2) Experts were allotted time to review and complete the distributed questionnaire. (3) Discussions ensued regarding the responses from all experts. (4) Each expert elucidated their questionnaire responses and engaged with feedback from fellow experts. (5) All experts concurred on the outcomes regarding the predominant hazards associated with each essential activity of the railway station project phase II. Table 1 shows the 22 validated risks from the previous study.
According to the expert validation results in Table 1, there are eight risk category groupings derived from 22 validated risk variables about delays in the Jakarta Central Railway Station Project Phase II ([7] and author’s Research), specifically (I) technical risk, (II) project owner risk, (III) construction risk, (IV) project design and methods risk, (V) contract risk, (VI) financial risk, (VII) external risks, and (VIII) HSE and environmental risks. Two risk category groupings emerged from the expert validation results, characterized by the highest number of risk indicator variables: project owner risk, which has five risk indicators: (R5) the project owner’s time-consuming decision-making process, (R6) delay in issuing work permits, (R7) changes in scope of work, (R8) inaccuracy in predicting the budget, and (R9) project delay by the owner. A primary factor contributing to project delays is the deficiency in owner competencies and strategies for managing mega projects [30]. The owner’s contribution is the primary cause of the project delay [33]. Each cause attributed to the owner significantly impacts project delays, either moderately or severely [35]. There are five risk indicators in the Design and Methods Risk Project: (R12) many changes to the design of drawings, specifications, and scope-of-work packages during the project by the project owner/external; (R13) incomplete design from the planner; (R14) request for changes in work method/design from clients/external parties during the construction period; (R15) design inconsistencies and ambiguity; and (R16) project complexity (design). As stated by [39], design risk is significantly affected by the designer’s critical role in comprehending and fulfilling the project owner’s wishes and needs. Risks during this phase are governmental bureaucracy, design inaccuracies, and modifications initiated for clients and contractors. Additionally, the final improper work method can cause project delays, as stated by [5].

4.2. Data Collection for, and Analysis and Discussion of Research Question 2 (RQ 2)

The preliminary phase of data collection is based on the results of the study conducted by [7] and other author’s research. The data collecting process at this stage initiates with the gathering of information about research question 1 (RQ1), specifically focusing on 22 indicators of delay risk that may influence the delay of the Jakarta Central Railway project phase II. Utilizing historical and archival data from the case-study project schedule, each essential activity that may impact project delays is identified by the essential Path Method (CPM) in the MS Project. The case-study scheduling identifies nine essential tasks, as detailed in Table 2: Demolition Zone 1, Building Work Zone 1, Demolition Zone 2, Track Work Zone 2, Demolition Zone 3, Track Work Zone 3, Demolition Zone 4-Sub A, Building Work Zone 4-Sub A, and Safety Assessment.
Qualitative analysis is essential for identifying the most significant risk in each critical scheduling action. A focus-group discussion with five railway specialists was performed to identify the primary variables influencing the completion time of a project work activity. This study employed focus-group discussions (FGDs) to identify the primary risk indicators influencing scheduling, following these steps: (1) Experts were briefed on the overarching objectives, background, and research subjects, and allowed a question-and-answer session to synchronize research perspectives. (2) Experts were allotted time to review and complete the distributed questionnaire. (3) Discussions ensued regarding the responses from all experts. (4) Each expert elucidated their questionnaire responses and engaged with feedback from fellow experts. (5) All experts concurred on the outcomes regarding the predominant hazards associated with each essential activity of the Jakarta Central Railway Project Phase II. Furthermore, the experts were asked to identify the critical work activities, and those were paired with identified risks; hence, they were categorized as dominant risks, as shown in Table 2.
According to Table 2, the predominant risk in each important work activity of the case study (Jakarta Central Railway Station Phase II) indicates, based on the FGD results, that there are six primary risk indicators in each critical schedule activity, with the most significant risk being R10. In (R1), there is one critical activity: Demolition Zone 1. In (R6), there are three critical activities: Building Work Zone 1, Demolition Zone 3, and Demolition Zone 4-Sub A. In (R20), there is one critical activity: Demolition Zone 2. In (R22), there are two critical activities: Track Work Zone 2 and Track Work Zone 3. In (R5), there is one critical activity: Building Work Zone 4-Sub A. In (R19), there is one critical activity: Safety Assessment.
Following the study in Table 2, a subsequent FGD was performed with experts to ascertain the additional days required due to the predominant risk associated with each activity, utilizing quantitative PERT analysis. Each expert delivered an evaluation and elucidation of the delay in project completion (in days) attributable to the predominant risk, utilizing the PERT distribution approach across the pessimistic (P), most-likely (ML), and optimistic (O) categories. All experts concurred with the definitive conclusion, including the inclusion of days attributable to inherent risk (pre-risk mitigation).
Adjusting the estimated results from PERT requires a conversion of the confidence level (α). The estimated value at each confidence level varies according to its corresponding time value. Furthermore, the theoretical value is derived from the PERT number formula, whereas the simulation value is determined by the number of iterations conducted in the model.
The simulation results are chosen and presented for the activity that had a substantial increase in duration. Utilizing Risk software for nine activities, A to I, as per Table 2, the Monte Carlo Simulation was performed, and the comprehensive simulation results are presented in detail in Table 3.
Following the implementation of various distribution models based on data collected in stage 2, modeling was performed according to the number of iterations and confidence levels utilized in this study. Subsequently, the scheduling model was constructed using the Gantt chart approach in the MS Project scheduling case study. Multiple schedule estimates were conducted, using the number of additional days attributable to inherent risk (pre-risk mitigation), alongside the project’s initial length and simulation findings, to derive an estimate for the completion time of the Jakarta Central Railway Station Phase II, as presented in Table 4.
Table 4 shows the duration and project completion time comparison of the Station Phase II Project Implementation Schedule Model under inherent risk conditions (pre-risk mitigation). First of all, it indicates that the initial completion length is 674.00 days. Under PERT conditions, the value includes an additional period of 1555.66 days or 130.815% of the original schedule duration.
Under theoretical value conditions (confidence level 80%), there is an additional length of 1575.70 days or 133.78% of the initial timeframe. Under theoretical value conditions (confidence level 90%), there is an additional length of 1584.78 days or 135.13% of the starting period. Under theoretical value conditions (confidence level 95%), there is an additional length of 1592.33 days, equating to 136,25% of the initial period. In the simulation value condition (confidence level 80%), there is an additional length of 1575.70 days, representing 136.25% of the initial timeframe.
In the simulation value condition (confidence level 90%), there is an additional period of 1584.78 days or 135.13% of the initial timeframe. In the simulation value condition (confidence level 95%), there is an additional duration of 1592.33 days or 136.25% of the initial timeframe. The findings of the additional time from all scheduling models under the inherent risk condition (pre-risk mitigation) range from 130.81% to 136.25%.

4.3. Data Collection for, and Analysis and Discussion of Research Question 3 (RQ 3)

In the third step of data collection, the preliminary phase is informed by the findings of the RQ 2 study conducted by [7] and the author’s research, specifically identifying the most prevalent risk in every critical activity. The literature study, archival data, and historical data in case studies are employed to conduct a cause-and-effect analysis of the dominant risk in each activity. A focus-group discussion (FGD) was performed to ascertain the causal relationships associated with each dominant risk in the activities examined in the case study. FGD was undertaken to ascertain the suitable risk response approach by identifying preventative and corrective actions for each dominant risk associated with critical activities. The same approach was used, where confidence levels (α) of 80%, 90%, and 95%, and 10000 iterations were selected as a basis for the simulation. The comprehensive simulation results are presented in detail in Table 5.
The simulation results were collected and put into MS Project, and scheduling calculations were performed. Again, multiple schedule estimates were conducted, using the number of additional days attributable to residual risk (post-risk mitigation), alongside the project’s initial length and simulation findings, to derive an estimate for the completion time of the Railway Station Phase II, as presented in Table 6.
The inherent risks are further discussed and analyzed with respective respondents (experts). Using cause–effect analysis and further preventive, as well as corrective, measures, the following risk response strategies are proposed as shown in Table 6. Referring to Table 6, showing a duration and project completion time comparison based on the Station Phase II Project Implementation Schedule Model under residual risk conditions (post-risk mitigation), the initial completion length is 674.00 days.
Using PERT conditions, the value includes an additional period of 1319.82 days or 95.82% of the original timeframe. Under theoretical value conditions (confidence level 80%), there is an additional length of 1342.26 days or 99.15% of the initial timeframe. Under theoretical value conditions (confidence level 90%), there is an additional length of 1345.10 days or 99.57% of the starting period. Under theoretical value conditions (confidence level 95%), there is an additional length of 1363.02 days, equating to 102.23% of the initial period. In the simulation value condition (confidence level 80%), there is an additional length of 1342.26 days, representing 99.15% of the initial timeframe. In the simulation value condition (confidence level 90%), there is an additional period of 1345.10 days or 135.13% of the initial timeframe. In the simulation value condition (confidence level 95%), there is an additional duration of 1592.33 days or 99.57% of the initial timeframe. The findings of additional time from all scheduling models under the residual risk condition (post-risk mitigation) range from 95.82% to 102.23%.
The risk responses are suggested and validated by the experts in the form of preventive and corrective actions. Table 7 shows how the respective risks are responded using risk response strategies as defined by the [17].

5. Conclusions

After performing data analysis, this research has revealed the answers to the proposed research questions. The construction project risks were validated, and the results showed that 22 out of 51 risk indicators related to the Jakarta Central Railway Station project phase II were selected as major inherent (pre-mitigated) risks, with 29 remaining rejected items [7]. The next finding is that there were nine critical activities (identified as activities A to I in this study) in the project that are significant to the project schedule, where they are correlated with six most dominant risks in each critical activity from the qualitative analysis of the FGD. The results of the simulation and calculated values on inherent risk showed additional days due to residual risk ranging from 130.81% to 136.25% of the initial contract completion duration. The risks were further analyzed, discussed, and validated with designated risk response strategies using preventive actions. After the implementation of preventive and corrective measures, and risk response strategies via focus-group discussions, the scheduling simulation indicated that residual risk under post-risk mitigation conditions resulted in an extension of approximately 95.82% to 102.23% of the original contract completion duration. The R10 is the biggest contribution of the extended duration to the project. This is because of the complexity of the operational activities (life train operations) that have to be taken into account during the project’s construction. Priority to the train operations is given as priority to construction activities. The impact was calculated as being bigger, as sometimes there were clashes of train traffic peak with the construction activities that were within the critical path.
This research shows that by using proper project risks management process and Monte Carlo, Analysis using a rich-featured software, as well project management software, a reduction in project durations can be calculated. By knowing this, project organizations (hereinafter, the project managers and project sponsors) can adjust their expectations and make further strategic decisions that might lead to major changes in the projects. This is much better than a normative and subjective decision that might further cause a much bigger impact on the project cost as in implication to the deviation of the schedules.
This study has provided further enhancement to the project risk management studies, especially in railway construction. The results prove the utility and prospect theories that the risk impact to the schedule can be quantified and somehow can be accepted due to the respective risk attitudes and their thresholds. The research result also has enriched the development of the current risk studies, especially where the risks of a complex railway project can be managed using proper processes, tools, and inputs to the project risks, especially in quantifying the deviation of schedule as a form of risk impact. Furthermore, this study has also provided insight that better risk response strategies can be proposed if the risk impacts are quantified.
From a practical point of view, this research has provided insightful results, where identified risks, processes, and tools will be treated as a significant information of lessons learned repository for future projects. The information will be used in estimating a more realistic project schedule. The identified and analyzed risks are also considered as significant inputs not only in schedule, but also to other project areas, such as project cost, project contract, resources estimates, and any other related aspects of the railway construction projects. The most important aspect that is taken into consideration by the construction project practitioners, especially of railways, is that project risk quantification requires powerful project management tools (risk management and project management software). The findings could also be considered a construction policy for the railway regulator and/or can be applied to the contract clauses; meanwhile, the result can also be considered as project management governance for the civil contractors.
The authors are aware that there are limitations to this study. Despite conducting a deep and comprehensive analysis of the railway construction using Monte Carlo analysis, this study refers only to the railway station construction project in Indonesia. Furthermore, the limited number of five panel reviewers could also potentially lead to biases in the justification and assessment of the risks. The uniqueness of the project could limit the generalization of the result and its applicability to other construction projects. Some aspects, such as project governance, organization capabilities (that might relate to project management maturity), and social environment, could also deviate the result of this study from its applicability.
This study also employed several data-gathering strategies in qualitative risk analysis to ascertain the impact of these methods on qualitative risk outcomes. In addition to PERT, various other distribution models can be employed to discern the distinctions among other distribution models not utilized in this study.
Furthermore, this research also employs various ways to collect data on risk responses, enabling the assessment of their impact on the development of a strategy model. Further study can be conducted by analyzing the time–cost trade-off. This study also proposed additional research advancement, where the risk indicators for the railway construction project could be expanded to include a wider range of factors and use different case-study projects.

Author Contributions

Conceptualization, M.I. and W.I.; methodology, M.I.; software, S.K.; validation, M.I., W.I. and S.K.; formal analysis, S.K.; investigation, S.K.; resources, S.K.; data curation, S.K.; writing—original draft preparation, S.K.; writing—review and editing, M.I. and W.I.; visualization, S.K.; supervision, M.I. and W.I. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

The raw data supporting the conclusions of this article is available in this link https://binusianorg-my.sharepoint.com/personal/mohammad_ichsan_binus_ac_id/_layouts/15/guestaccess.aspx?share=EocZD3fbbAtCsKRdyL6QY_wBYpzh_zpuqHM5C3xOyDPYew&e=B3Caal (accessed on 24 June 2025).

Acknowledgments

The authors would like to thank the supporting individuals and organizations who have been involved in this research.

Conflicts of Interest

The authors declare no conflicts of interest.

References

  1. Meka’a, C.B.; Fotso, S.R.; Guemdjo Kamdem, B.R. Investments in Basic Public Infrastructure and Their Effects on Economic Growth in a Developing Country: The Case of Cameroon. Heliyon 2024, 10, e26504. [Google Scholar] [CrossRef] [PubMed]
  2. Zhang, Y.; Cheng, L. The Role of Transport Infrastructure in Economic Growth: Empirical Evidence in the UK. Transp. Policy 2023, 133, 223–233. [Google Scholar] [CrossRef]
  3. Wu, C.; Zhang, N.; Xu, L. Travelers on the Railway: An Economic Growth Model of the Effects of Railway Transportation Infrastructure on Consumption and Sustainable Economic Growth. Sustainability 2021, 13, 6863. [Google Scholar] [CrossRef]
  4. Acheampong, A.O.; Dzator, J.; Dzator, M.; Salim, R. Unveiling the Effect of Transport Infrastructure and Technological Innovation on Economic Growth, Energy Consumption and CO2 Emissions. Technol. Forecast. Soc. Change 2022, 182, 121843. [Google Scholar] [CrossRef]
  5. Tavassolirizi, M.; Sarvari, H.; Chan, D.W.M.; Olawumi, T.O. Factors Affecting Delays in Rail Transportation Projects Using Analytic Network Process: The Case of Iran. Int. J. Constr. Manag. 2022, 22, 2712–2723. [Google Scholar] [CrossRef]
  6. Nguyen, T.; Chileshe, N.; Ho, D.T.; Nguyen, V.T.; Tran, Q.P. Significant Risks That Trigger Cost Overruns and Delays in Urban Rail Projects: A Typical Case Study of Vietnam. Built Environ. Proj. Asset Manag. 2024, 14, 278–295. [Google Scholar] [CrossRef]
  7. Karim, S.; Isvara, W.; Ichsan, M. Factors Affecting Delayed Implementation of Railway Station Projects: Case Studies in Indonesia. Glob. Bus. Financ. Rev. 2024, 29, 46–60. [Google Scholar] [CrossRef]
  8. Oktaria, D.S.; Guilin, X.; Jiao, D.; Wang, Y. Juridical Review of Minimum Service Standards at Manggarai Station. Rechtsnormen J. Law 2023, 1, 85–94. [Google Scholar] [CrossRef]
  9. Khadilkar, H. Data-Enabled Stochastic Modeling for Evaluating Schedule Robustness of Railway Networks. Transp. Sci. 2017, 51, 1161–1176. [Google Scholar] [CrossRef]
  10. Goodwin, K.A.; Goodwin, C.J. Research in Psychology: Methods and Design, 8th ed.; John Wiley & Sons, Inc.: Hoboken, NJ, USA, 2017. [Google Scholar]
  11. Hartono, B.; Ichsan, M.; Arini, H.M. Manajemen Risiko Pada Proyek Dan Bisnis Di Era Disrupsi: Konsep Kontemporer Dan Implementasi, 1st ed.; Gadjah Mada University Press: Yogyakarta, Indonesia, 2024. [Google Scholar]
  12. Jie, D.; Wei, J. Estimating Construction Project Duration and Costs upon Completion Using Monte Carlo Simulations and Improved Earned Value Management. Buildings 2022, 12, 2173. [Google Scholar] [CrossRef]
  13. Koulinas, G.K.; Xanthopoulos, A.S.; Sidas, K.A.; Koulouriotis, D.E. Risks Ranking in a Desalination Plant Construction Project with a Hybrid AHP, Risk Matrix, and Simulation-Based Approach. Water Resour. Manag. 2021, 35, 3221–3233. [Google Scholar] [CrossRef]
  14. Hu, Z.G. A New Progress in the Theory of PERT. In Proceedings of the 2011 IEEE 18th International Conference on Industrial Engineering and Engineering Management, Changchun, China, 3–5 September 2011; pp. 15–20. [Google Scholar] [CrossRef]
  15. US Department of the Navy. Summary Report: Program Evaluation Research Task; US Department of the Navy: Washington, DC, USA, 1958.
  16. Project Management Institute. Practice Standard for Scheduling; Project Management Institute, Inc.: Newtown Square, PA, USA, 2019. [Google Scholar]
  17. Project Management Institute. A Guide to Project Management Body of Knowledge, 6th ed.; Project Management Institute, Inc.: Newtown Square, PA, USA, 2017. [Google Scholar]
  18. Bagshaw, K.B. NEW PERT and CPM in Project Management with Practical Examples. Am. J. Oper. Res. 2021, 11, 215–226. [Google Scholar] [CrossRef]
  19. Riantini, L.S.; Ichsan, M.; Trigunarsyah, B.; Rarasati, A.D.; Handika, N.; Lolo, C.A. Optimization of Completion Schedule Forecasting in Case Study of Double-Double Track Development Project (Package A) Using the Probabilistic Pert Method. J. Infrastruct. Policy Dev. 2024, 8, 7798. [Google Scholar] [CrossRef]
  20. Ichsan, M.; Isvara, W.; Handibyanto, J.N.; Muhammad, F.A. Development of a Risk-Based Strategy Implementation of a Full Pre-Financed Contractor Scheme (CPF) in Toll Road Projects to Improve Time Performance. Cogent Eng. 2024, 11, 2307212. [Google Scholar] [CrossRef]
  21. Sackey, S.; Kim, B.S. Schedule Risk Analysis Using a Proposed Modified Variance and Mean of the Original Program Evaluation and Review Technique Model. KSCE J. Civ. Eng. 2019, 23, 1484–1492. [Google Scholar] [CrossRef]
  22. Handoko, J.R.; Gondokusumo, O. Comparison of PERT and M-PERT Scheduling for a Construction Project in Malang, Indonesia. IOP Conf. Ser. Mater. Sci. Eng. 2019, 508, 012034. [Google Scholar] [CrossRef]
  23. Zhang, S.; Jin, L. Research on Software Project Schedule Management Method Based on Monte Carlo Simulation. In Proceedings of the 2020 IEEE 5th Information Technology and Mechatronics Engineering Conference (ITOEC), Chongqing, China, 12–14 June 2020; pp. 1605–1608. [Google Scholar] [CrossRef]
  24. Andrić, J.M.; Wang, J.; Zhong, R. Identifying the Critical Risks in Railway Projects Based on Fuzzy and Sensitivity Analysis: A Case Study of Belt and Road Projects. Sustainability 2019, 11, 1302. [Google Scholar] [CrossRef]
  25. Abbasi, O.; Noorzai, E.; Gharouni Jafari, K.; Golabchi, M. Exploring the Causes of Delays in Construction Industry Using a Cause-and-Effect Diagram: Case Study for Iran. J. Archit. Eng. 2020, 26, 05020008. [Google Scholar] [CrossRef]
  26. Djohim, M.F.N.; Nugroho, A.S.B.; Handayani, T.N. Risk Analysis of Modest Housing Projects Scheduling Using Monte Carlo Simulation. Civ. Eng. Dimens. 2024, 26, 160–172. [Google Scholar] [CrossRef]
  27. Yin, R.K. Case Study Research and Applications: Design and Methods, 8th ed.; SAGE Publication Inc.: London, UK, 2018. [Google Scholar]
  28. Hendradewa, A.P. Schedule Risk Analysis by Different Phases of Construction Project Using CPM-PERT and Monte-Carlo Simulation. IOP Conf. Ser. Mater. Sci. Eng. 2019, 528, 012035. [Google Scholar] [CrossRef]
  29. Paz de Sousa, K.M.; Rosana de Araújo Oliveira, S.; Alencar Sousa Macau Furtado, B.M.; Ribeiro de Vasconcelos, A.L.; Gomes de Medeiros, S.; Cazarin, G.; Soares Sampaio, A.; Ridde, V. Hospital Resilience in Three COVID-19 Referral Hospitals in Brazil. Heal. Syst. Reform. 2023, 9, 2205726. [Google Scholar] [CrossRef] [PubMed]
  30. Han, S.H.; Yun, S.; Kim, H.; Kwak, Y.H.; Park, H.K.; Lee, S.H. Analyzing Schedule Delay of Mega Project: Lessons Learned from Korea Train Express. IEEE Trans. Eng. Manag. 2009, 56, 243–256. [Google Scholar] [CrossRef]
  31. Sharma, M.K. Monte Carlo Simulation Applications for Construction Project Management. Int. J. Civ. Eng. Technol. 2020, 11, 88–100. [Google Scholar] [CrossRef]
  32. Gashaw, T.; Jilcha, K. Design Risk Modeling and Analysis for Railway Construction Projects. Int. J. Constr. Manag. 2023, 23, 2488–2498. [Google Scholar] [CrossRef]
  33. Mittal, Y.K.; Paul, V.K. Identification of Critical Factors for Delay in Metro Rail Projects in India. Int. J. Stud. Res. Technol. Manag. 2018, 6, 30–39. [Google Scholar] [CrossRef]
  34. Ramli, M.Z.; Abidin, M.Z.Z.; Hamid, N.B.; Razman, R.; Noh, N.A.M. Ranking of Railway Construction Project Delay Factors in Malaysia by Using Relative Importance Index (RII). AIP Conference Proceedings 2021, 2339, 020114. [Google Scholar] [CrossRef]
  35. Zhang, D.; Zhang, H.; Cheng, T. Causes of Delay in the Construction Projects of Subway Tunnel. Adv. Civ. Eng. 2020, 2020, 8883683. [Google Scholar] [CrossRef]
  36. Danisworo, B.; Latief, Y. Estimation Model of Jakarta MRT Phase 1 Project Cost Overrun for the Risk Based next Phase Project Funding Purpose. IOP Conf. Ser. Earth Environ. Sci. 2019, 258, 012049. [Google Scholar] [CrossRef]
  37. Nikjow, M.A.; Liang, L.; Qi, X.; Sepasgozar, S.M.E.; Chileshe, N. Triggers of Delays in International Projects Using Engineering Procurement and Construction Delivery Methods in the Belt and Road Initiative: Case Study of a High-Speed Railway Projects. Sustainability 2021, 13, 9503. [Google Scholar] [CrossRef]
  38. Welde, M.; Bukkestein, I. Over Time or on Time? A Study of Delays in Large Government Projects. Procedia Comput. Sci. 2021, 196, 772–781. [Google Scholar] [CrossRef]
  39. Zou, P.X.W.; Zhang, G.; Wang, J. Understanding the Key Risks in Construction Projects in China. Int. J. Proj. Manag. 2007, 25, 601–614. [Google Scholar] [CrossRef]

Figure 1. Progress of Jakarta Central Railway Station Construction Project Phase II at the end of the contract on 30 September 2021. Source: [7] and author’s research.
Figure 1. Progress of Jakarta Central Railway Station Construction Project Phase II at the end of the contract on 30 September 2021. Source: [7] and author’s research.
Applsci 15 07464 g001

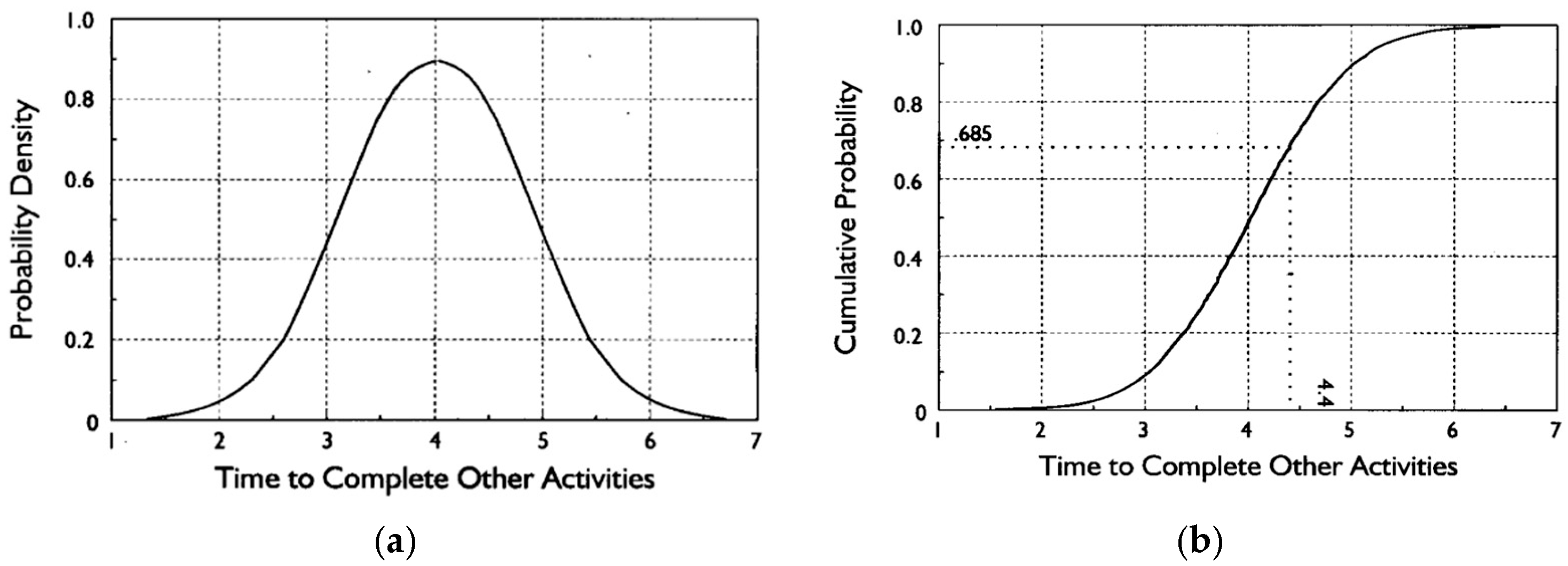

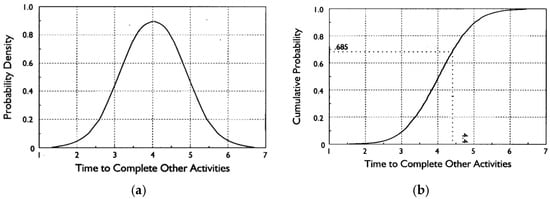

Figure 2. (a) Example of probability density distribution for input. (b) Example of cumulative probability distribution. Source from [25].
Figure 2. (a) Example of probability density distribution for input. (b) Example of cumulative probability distribution. Source from [25].
Applsci 15 07464 g002
Table 1. Validation results of delay indicators by experts for the Jakarta Central Railway Station project phase II.
Table 1. Validation results of delay indicators by experts for the Jakarta Central Railway Station project phase II.
Risk IDRisk FactorRisk CategoriesReference
R1Land acquisition delays(I) Technical risk[30,31]
R2Delay in handover of work land
R3Many utilities are not detected at the start of work.
R4Difficult and limited project road access
R5The project owner’s time-consuming decision-making process(II) Project owner risk[30,32,33,34,35]
R6Delay in issuing work permits
R7Changes in scope of work
R8Inaccuracy in predicting the budget
R9Project delay by the owner
R10Sequencing work activities must be adjusted to train operating patterns (switch over)(III) Construction risk[24,32]
R11Inconsistencies in the order of schedule priorities that can affect project execution
R12Many changes to the design of drawings, specifications, and scope-of-work packages during the project by the project owner/external(IV) Project design and methods risk[5,30,32,35,36,37]
R13Incomplete design from the planner
R14Request for changes in work method/design from clients/external parties during the construction period
R15Design inconsistencies and ambiguity
R16Project complexity (design)
R17Lots of additional work(V) Contract risk[32,36,38]
R18High indirect costs(VI) Financial risk[5,30,36]
R19There are complicated procedures for permitting construction projects from various parties.(VII) External risks[5,24,30,32,33,34]
R20Interfaces, dependencies between phases, and work packages
R21High-risk project location(VIII) HSE and environmental risks[24,30,35]
R22Working on active train tracks
Source: [7] and author’s research.
Table 2. The dominant risk in critical work activities.
Table 2. The dominant risk in critical work activities.
No. ActivityCritical Work ActivityDuration (in Days)Risk IDDominant Risk
ADemolition Zone 150.00R10Sequencing work activities must be adjusted to train operating patterns (switch over)
BBuilding Work Zone 1290.00R6Delay in issuing work permits
CDemolition Zone 225.00R20Interfaces, dependencies between phases, and work packages
DTrack Work Zone 2122.00R22Working on active train tracks
EDemolition Zone 329.00R6Delay in issuing work permits
FTrack Work Zone 3114.00R22Working on active train tracks
GDemolition Zone 4-Sub A44.00R6Delay in issuing work permits
HBuilding Work Zone 4-Sub A196.00R5The project owner’s time-consuming decision-making process
ISafety Assessment29.00R19There are complicated procedures for permitting construction projects from various parties.
Source: [7] and author’s research.
Table 3. Quantitative analysis of Monte Carlo Simulation using @Risk software with PERT distribution approach on inherent risk conditions (pre-risk mitigation).
Table 3. Quantitative analysis of Monte Carlo Simulation using @Risk software with PERT distribution approach on inherent risk conditions (pre-risk mitigation).
No. ActivityDuration (Days)Risk IDAdditional Days
(Inherent Risk)
PERT (Day)Theoretical Value
(in Days)
Simulation Value (*)
(in Days)
P (in Days)ML (in Days)O (in Days)α = 80α = 90α = 95α = 80α = 90α = 95
A50.00R10720.00700.00680.00700.00706.94710.13712.44706.94710.13712.43
B290.00R645.0030.0030.0032.5034.1335.5336.7634.1335.5336.76
C25.00R2045.0030.0030.0032.5034.1335.5336.7634.1335.5336.76
D122.00R2240.0035.0030.0035.0036.7337.5338.1136.7337.5338.11
E29.00R645.0035.0030.0035.8337.7838.3139.6737.7838.3139.67
F114.00R2245.0035.0030.0035.8338.3139.6740.7038.3139.6740.70
G44.00R645.0035.0030.0035.8337.7838.3139.6737.7838.3139.67
H196.00R550.0040.0030.0040.0043.4745.0746.2143.4745.0746.21
I29.00R1945.0035.0025.0035.0038.4740.0741.2138.4740.0741.21
Ʃ (day)899.00 982.501007.731020.161031.521007.731020.161031.52
Ʃ (Month)29.97 32.7533.5934.0134.3833.5934.0134.38
Source: author’s research. (*) The Monte Carlo Simulation is performed using @Risk Software with 10000 iterations.
Table 4. Comparison of duration and project completion time based on the Railway Station Phase II Project Implementation Schedule Model under inherent risk conditions (pre-risk mitigation).
Table 4. Comparison of duration and project completion time based on the Railway Station Phase II Project Implementation Schedule Model under inherent risk conditions (pre-risk mitigation).
No.Schedule ModelDuration
(in Days) 1
Completion Time
(Pre-Risk Mitigation)
Comparison with Initial Duration (%)
1Initial contract674.00 days 30 September 2021-
2PERT value1555.66 days16 April 2024130.81%
3Theoretical value (confidence level 80%)1575.70 days6 May 2024133.78%
4Theoretical value (confidence level 90%)1584.78 days15 May 2024135.13%
5Theoretical value (confidence level 95%)1592.33 days23 May 2024136.25%
6Simulation value (confidence level 80%)1575.70 days6 May 2024133.78%
7Simulation value (confidence level 90%)1584.78 days15 May 2024135.13%
8Simulation value (confidence level 95%)1592.33 days23 May 2024136.25%
Source: Author’s research. 1 The total duration is calculated using MS Project by entering the number of related activities identified in Table 2.
Table 5. Quantitative analysis of Monte Carlo Simulation using @Risk software with PERT distribution approach on residual risk conditions (post-risk mitigation).
Table 5. Quantitative analysis of Monte Carlo Simulation using @Risk software with PERT distribution approach on residual risk conditions (post-risk mitigation).
No. ActivityDuration (Days)Risk
ID
Additional Days (Residual Risk)PERT (Day)Theoretical ValueSimulation Value (*)
P (in Days)ML (in Days)O (in Days) α = 80α = 90α = 95α = 80α = 90α = 95
A50.00R10550.00500.00470.00503.33516.80523.85529.15516.80523.85529.15
B290.00R630.0025.0020.0025.0026.7327.5328.1126.7327.5328.11
C25.00R2035.0025.0020.0025.8328.3129.6730.7028.3129.6730.70
D122.00R2230.0025.0025.0025.8326.3826.8427.2526.3826.8427.25
E29.00R635.0025.0020.0025.8328.3129.6730.7028.3129.6730.70
F114.00R2240.0035.0030.0035.0036.7337.5338.1136.7337.5338.11
G44.00R635.0025.0025.0026.6727.7528.7029.5127.7528.7029.51
H196.00R540.0030.0025.0030.8333.3134.6735.7033.3134.6735.70
I29.00R1930.0025.0020.0025.0026.7327.5328.1126.7327.5328.11
Ʃ (day)899.00 723.33751.07765.99777.33751.07765.99777.33
Ʃ (Month)29.97 24.1125.0325.5325.9125.0325.5325.91
Source: Author’s research. (*) The Monte Carlo Simulation is performed using @Risk Software with 10000 iterations.
Table 6. Comparison of duration and project completion time based on the Railway Station Phase II Project Implementation Schedule Model under residual risk conditions (post-risk mitigation).
Table 6. Comparison of duration and project completion time based on the Railway Station Phase II Project Implementation Schedule Model under residual risk conditions (post-risk mitigation).
No.Schedule ModelDuration (in Days) 1Completion Time (Post-Risk Mitigation)Comparison with Initial Duration (%)
1Initial contract674.00 days30 September 2021-
2PERT value1319.82 days24 August 202395.82%
3Theoretical value (confidence level 80%)1342.26 days16 September 202399.15%
4Theoretical value (confidence level 90%)1345.10 days28 September 202399.57%
5Theoretical value (confidence level 95%)1363.02 days7 October 2023102.23%
6Simulation value (confidence level 80%)1342.26 days16 September 202399.15%
7Simulation value (confidence level 90%)1354.10 days28 September 2023100.91%
8Simulation value (confidence level 95%)1363.02 days7 October 2023102.23%
Source: Author’s research. 1 The total duration is calculated using MS Project by entering the number of related activities identified in Table 4.
Table 7. Cause–effect analysis, preventive–corrective actions, risk response strategies (Source: current research work).
Table 7. Cause–effect analysis, preventive–corrective actions, risk response strategies (Source: current research work).
Act.Duration (Days)Risk IDRisk CausesCodeAdditional Days (Inherent Risk)CodePreventive ActionsCodeRisk Response (Inherent)
P
(in Days)
ML
(in Days)
O
(in Days)
A50.00R10Land acquisitionC1720.00700.00680.00IR1Creating a land acquisition mitigation planPA1Mitigate
Interface, dependencies between packagesC2 Create integration of work stages togetherPA2Transfer
Many design changesC3 Check all DED drawings before starting work.PA3Mitigate
B290.00R6Poor communication between partiesC445.0030.0030.00IR2Creating a communication management planPA4Mitigate
Complicated bureaucracyC5 Prepare a licensing flowchartPA5Accept
Licensing is complicated by various partiesC6 Developing a licensing plan strategyPA6Mitigate
C25.00R20Waiting for other work packages to completeC745.0030.0030.00IR3Make a joint planning schedulePA7Transfer
D122.00R22Limited job accessC840.0035.0030.00IR4Create the right working methodPA8Mitigate
High-risk project locationC9 Creating an HSE work planPA9Mitigate
Work during the window timeC10 Socialization to passengersPA10Accept
E29.00R6Inadequate communication among partiesC1145.0035.0030.00IR5Creating a communication management planPA11Mitigate
Complicated bureaucracyC12 Prepare a licensing flowchartPA12Accept
Licensing is complicated by various partiesC13 Developing a licensing plan strategyPA13Mitigate
F114.00R22Limited job accessC1445.0035.0030.00IR6Create the right working methodPA14Mitigate
High-risk project locationC15 Creating an HSE work planPA15Mitigate
Work during the window timeC16 Socialization to passengersPA16Accept
G44.00R6Inadequate communication among partiesC1745.0035.0030.00IR7Creating a communication management planPA17Mitigate
Complicated bureaucracyC18 Prepare a licensing flowchartPA18Accept
Licensing is complicated by various partiesC19 Developing a licensing plan strategyPA19Mitigate
H196.00R5Poor communication between partiesC2050.0040.0030.00IR8Creating a communication management planPA20Mitigate
Complicated bureaucracyC21 Creating a communication flowchartPA21Accept
Project owner’s inconsistency in schedule priority orderC22 Develop a plan for the method and appropriate stages of workPA22Mitigate
I29.00R19Complicated bureaucracyC2345.0035.0025.00IR9Creating a communication flowchartPA23Accept
Incomplete administrative filesC24 Create a document monitoring planPA24Mitigate
Poor communication between partiesC25 Creating a communication management planPA25Mitigate
Act.Duration (Days)Risk IDRisk EffectCodeAdditional Days (Residual Risk)CodeCorrective ActionCodeRisk Response (Residual)
P
(in Days)
ML
(in Days)
O
(in Days)
A50.00R10Delay in work timeE1550.00500.00470.00RR1Coordinate with parties to accelerate land acquisitionCA1Transfer
Changes to the implementation drawingE2 Conduct joint meetings between packages to integrate drawingsCA2Transfer
Changes in the scope of workE3 Conduct design reviews with expertsCA3Mitigate
B290.00R6Work is hamperedE430.0025.0020.00RR2communicate well with all partiesCA4Accept
Delay in work timeE5 Write officially regarding any problemsCA5Transfer
Administrative approval is delayedE6 Complete the necessary administrationCA6Mitigate
C25.00R20Delay in completion timeE735.0025.0020.00RR3Hold regular meetings togetherCA7Transfer
D122.00R22The safety of passengers, workers, and train operations is disruptedE830.0025.0025.00RR4Create a mutually agreed standard operating procedure (SOP)CA8Mitigate
Delay in work timeE9 Conducting socialization of labor hazardsCA9Transfer
Increase in overtime costs for manpowerE10 Make monitoring of work activitiesCA10Mitigate
E29.00R6Work is hamperedE1135.0025.0020.00RR5Communicate well with all partiesCA11Accept
Delay in work timeE12 Write officially regarding any problemsCA12Transfer
Administrative approval is delayedE13 Complete the necessary administrationCA13Mitigate
F114.00R22The safety of passengers, workers, and train operations is disruptedE1440.0035.0030.00RR6Create a mutually agreed standard operating procedure (SOP)CA14Mitigate
Delay in work timeE15 Conducting socialization of labor hazardsCA15Transfer
Increase in overtime costs for manpowerE16 Make monitoring of work activitiesCA16Mitigate
G44.00R6Work is hamperedE1735.0025.0025.00RR7Communicate well with all partiesCA17Accept
Delay in work timeE18 Write officially regarding any problemsCA18Transfer
Administrative approval is delayedE19 Complete the necessary administrationCA19Mitigate
H196.00R5Delay in issuing work permitsE2040.0030.0025.00RR8Write officially regarding any problemsCA20Transfer
Lots of work reworkedE21 Monitor any changes in scopeCA21Mitigate
Cost increaseE22 Submitting a claim for a fee increaseCA22Transfer
I29.00R19Delay in handover of workE2330.0025.0020.00RR9Conduct a joint planning meetingCA23Transfer
Delay in administrative approvalE24 Complete the necessary administrationCA24Accept
Delay in issuing safety assessment permitsE25 Immediately follow up on the safety assessment test findingsCA25Accept
Source: Current research work.
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Ichsan, M.; Isvara, W.; Karim, S. Monte Carlo Simulation for Enhancing the Schedule Completion Forecast of Jakarta Central Railway Station Construction Project. Appl. Sci. 2025, 15, 7464. https://doi.org/10.3390/app15137464

AMA Style

Ichsan M, Isvara W, Karim S. Monte Carlo Simulation for Enhancing the Schedule Completion Forecast of Jakarta Central Railway Station Construction Project. Applied Sciences. 2025; 15(13):7464. https://doi.org/10.3390/app15137464

Chicago/Turabian Style

Ichsan, Mohammad, Wisnu Isvara, and Syaeful Karim. 2025. "Monte Carlo Simulation for Enhancing the Schedule Completion Forecast of Jakarta Central Railway Station Construction Project" Applied Sciences 15, no. 13: 7464. https://doi.org/10.3390/app15137464

APA Style

Ichsan, M., Isvara, W., & Karim, S. (2025). Monte Carlo Simulation for Enhancing the Schedule Completion Forecast of Jakarta Central Railway Station Construction Project. Applied Sciences, 15(13), 7464. https://doi.org/10.3390/app15137464

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
