Probability Analysis of Overtopping During Construction Period of Dam Based on Improved Interval Non-Probabilistic Reliability
Abstract
1. Introduction
2. Materials and Methods
2.1. Project Overview

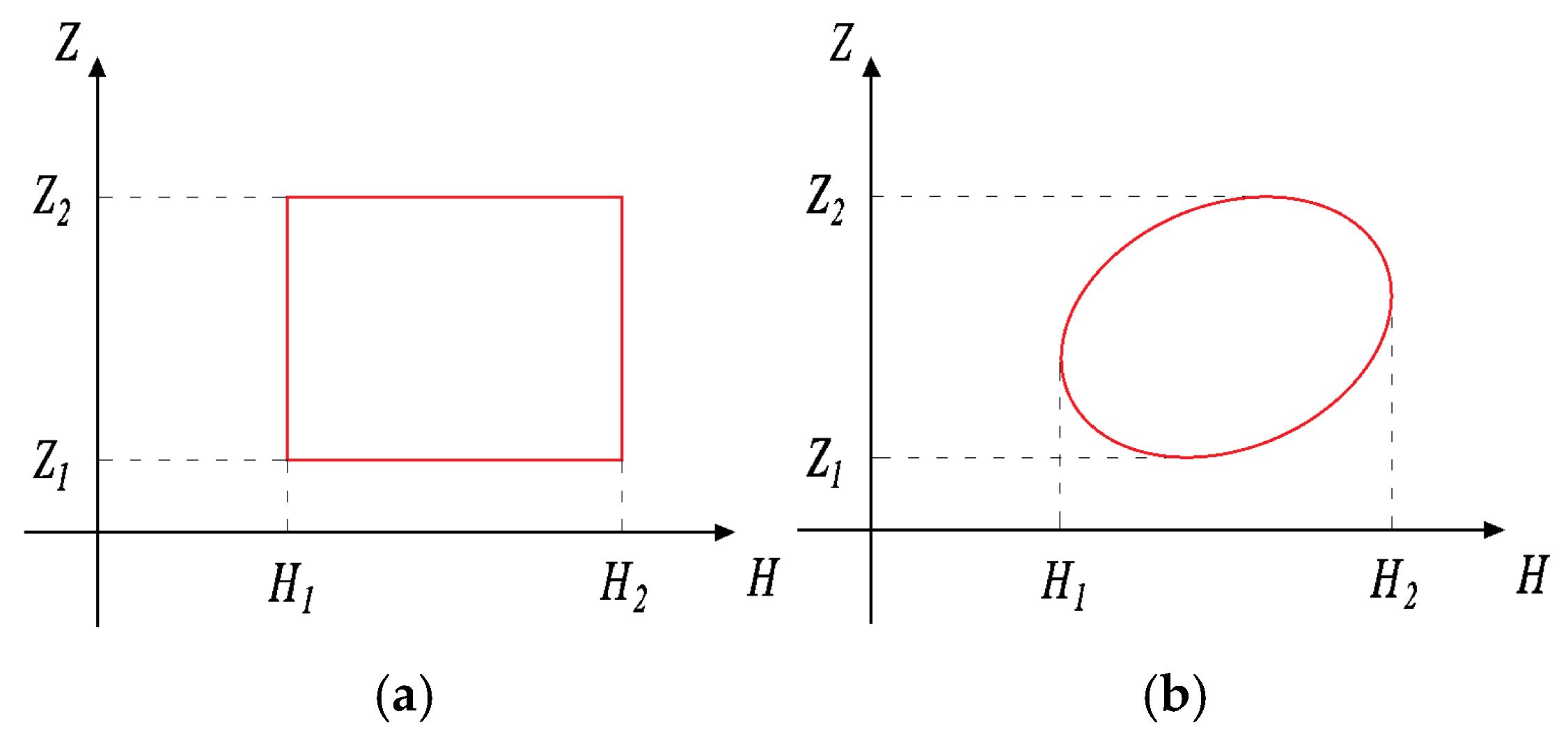

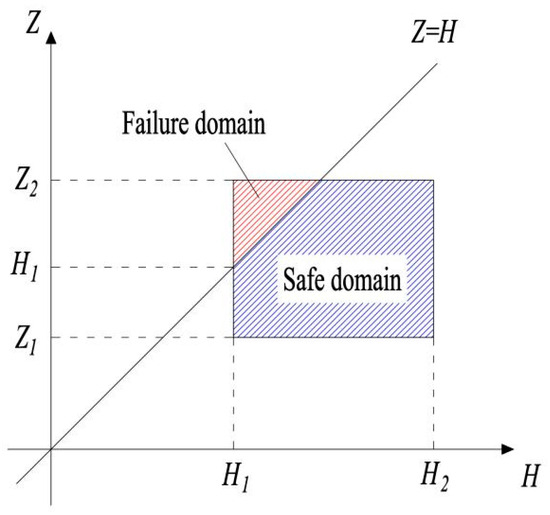

2.2. Definition of Overtopping Probability

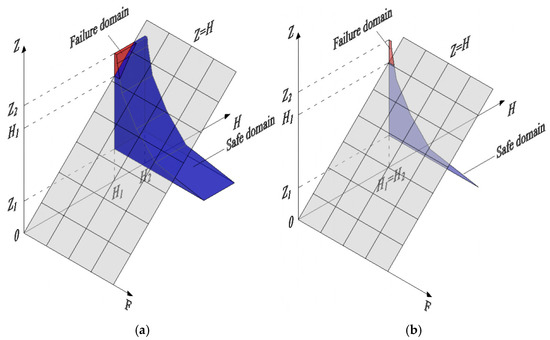

2.3. INPR Theory

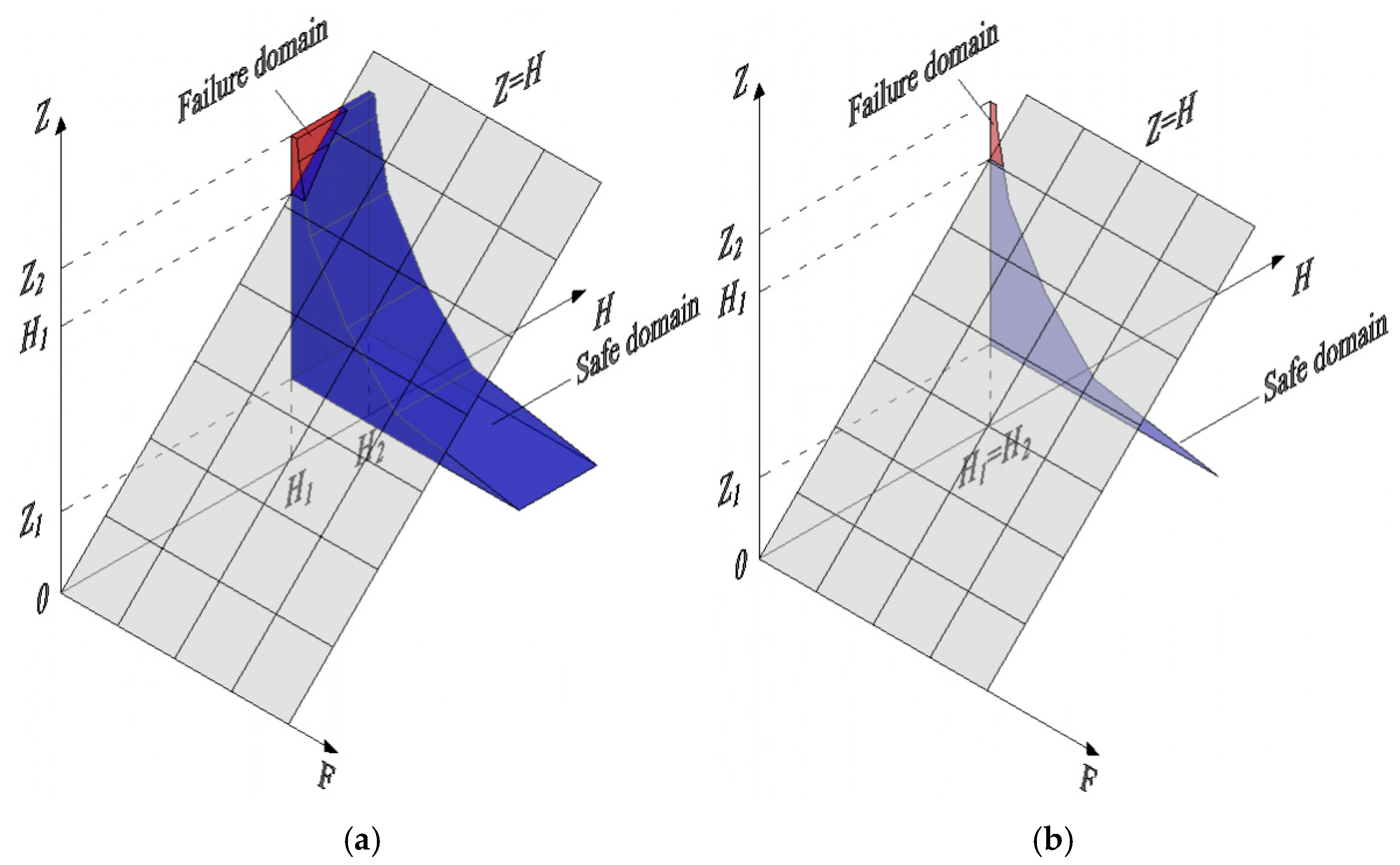

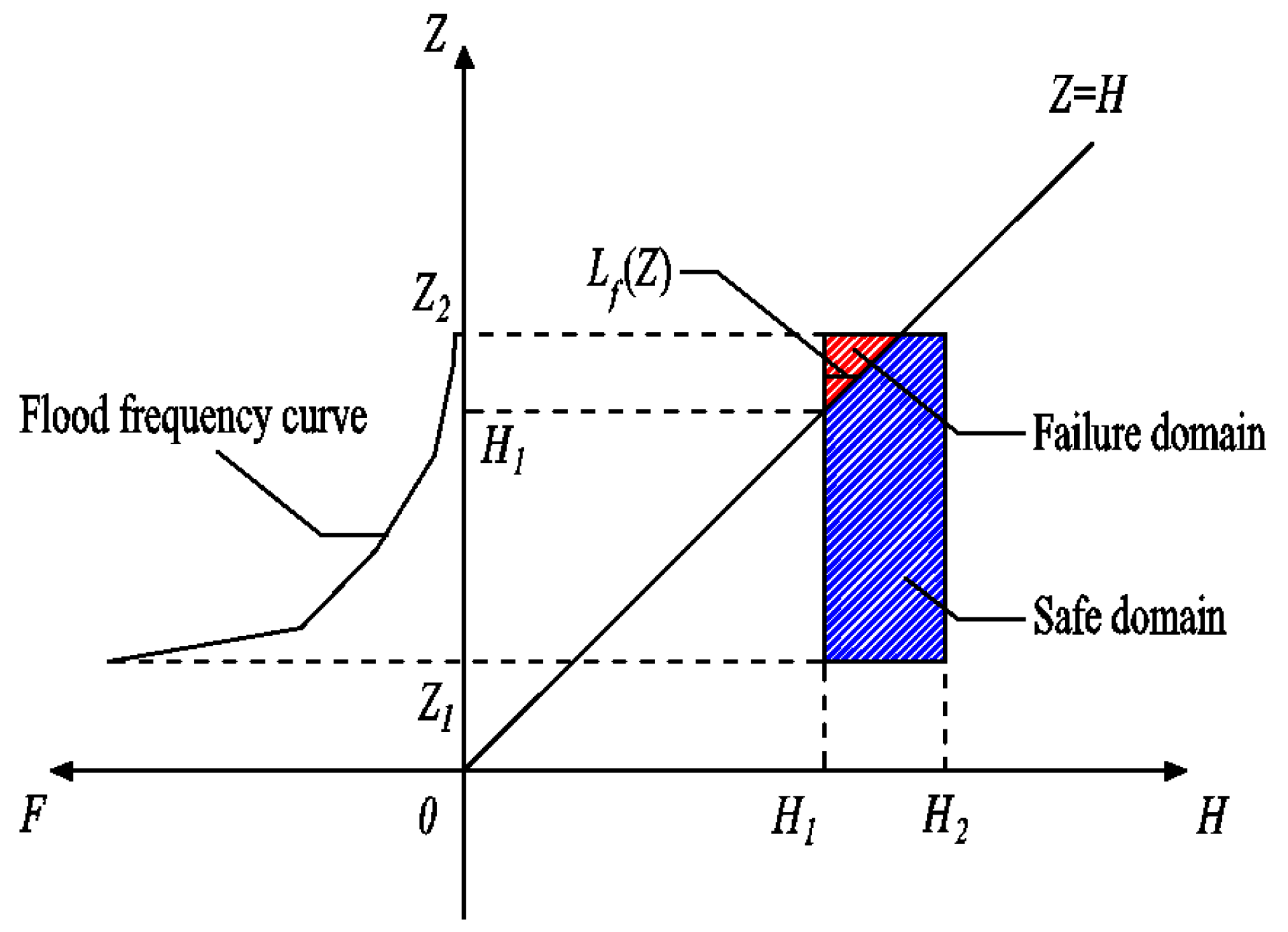

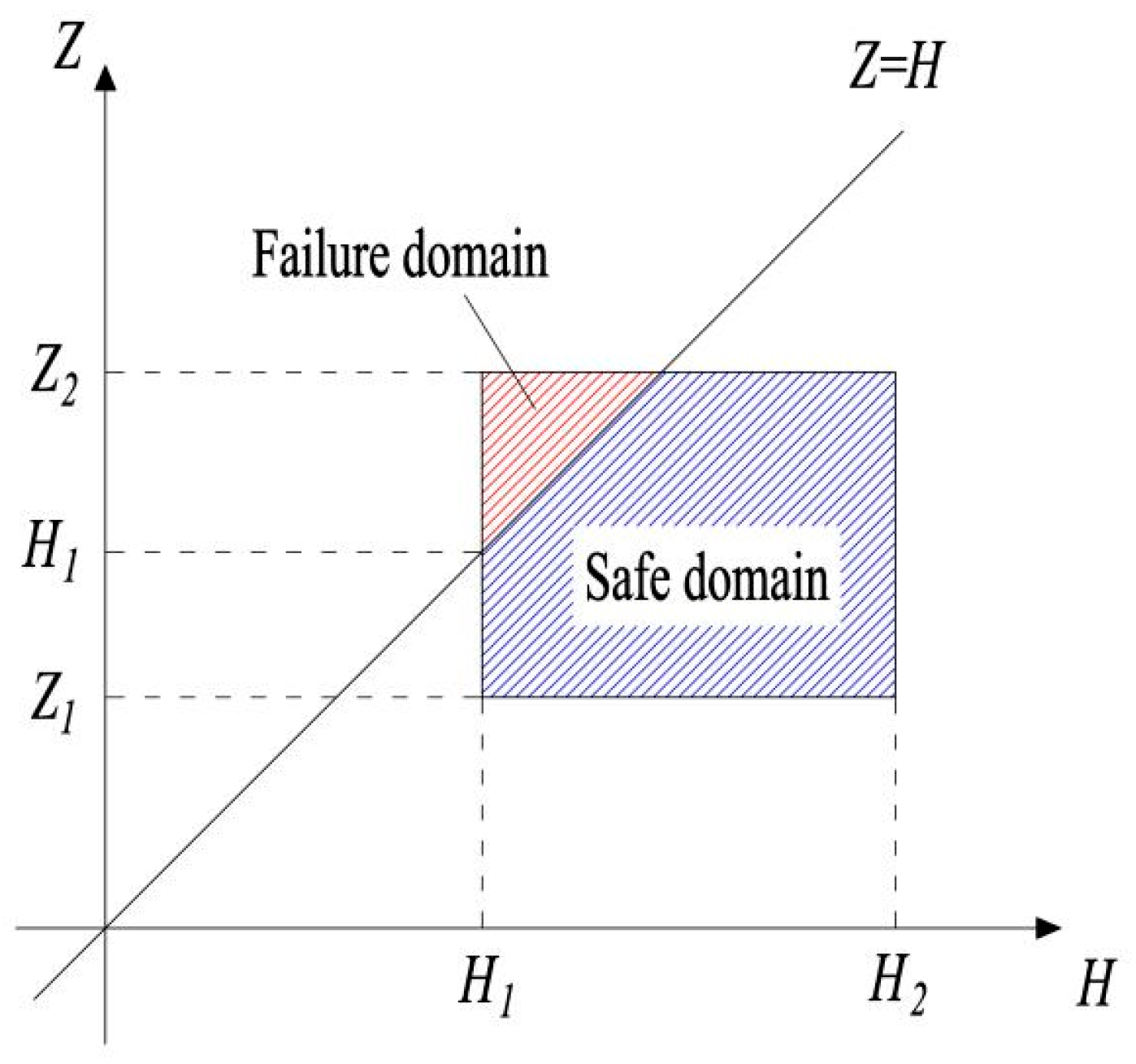

2.3.1. Traditional INPR Theory
2.3.2. Improved INPR Calculation Method
3. Results
3.1. Quantitative Analysis of Z and H
3.1.1. Upstream Water Level Range Z
3.1.2. The Range of Top Elevation of the Water-Retaining Structure H
3.2. Probability Calculation of Overtopping During the Construction Period
4. Discussion
- (1)
- According to the data in Table 4, the obtained probabilities are 10 times higher than flood routing calculations, with the highest ratio reaching 104 times, such as in the calculations for schedule 1 of the floods in 2019. This is because the traditional methods assume that the upstream flood levels follow a uniform distribution, neglecting the significant differences in flood frequencies corresponding to different flood levels. From Table 4 and Figure 7, it can be observed that the improved INPR model aligns well with the results obtained from flood routing calculations, demonstrating the rationality and feasibility of the proposed method in this study. Additionally, the improved method in this study considers the uncertainty of construction progress, which is more in line with the actual situation of dam construction progress being influenced by multiple factors and characterized by uncertainty.
- (2)
- There is no fixed relationship between the calculated results of the improved method proposed in this study and the results obtained from flood routing calculations. This is because the uncertainty of the construction progress affects the range of elevation values for flood retaining structures during the flood season. When the construction progress can be easily ensured, the elevation of the flood retaining structures tends to be higher than the planned elevation, and the calculated results of the improved method will be smaller than those of the flood routing calculations. When the construction progress cannot be easily ensured, the calculated results of the improved method will be higher than those of the flood routing calculations. For example, in schedule 2 during the flood season of 2019, the planned elevation for the dam crest is 392.0 m, with an elevation range of [389.2, 399.6], and the progress risk is 0.27. It is evident that the construction progress can be easily ensured; thus, the calculated result of the improved method is 0.0048, which is smaller than the flood simulation result of 0.0063.
- (3)
- Theoretically, a faster construction schedule can reduce the probability of overtopping during the flood season in dam construction. However, considering the uncertainty in the construction progress, excessive construction intensity makes it difficult to guarantee the construction schedule. For example, in schedule 3, the planned elevation during the 2018 flood season is 392.0 m, which is a fast schedule, but it increases the construction intensity. Therefore, the elevation range during the 2018 flood season is [387.6, 394.2], the progress risk is 0.67, and it is difficult to ensure the construction progress. According to the calculation results, the probability of overtopping considering the uncertainty in construction progress for schedule 3 during the 2018 flood season is 0.0072, which is higher than the probability of overtopping corresponding to the planned elevation, which is 0.0063. Therefore, the formulation of construction schedules should be in line with the average advanced level of current construction techniques in order to reduce the difficulty of construction progress control and ensure that the probability of overtopping during the construction period of the dam is not higher than the probability of overtopping corresponding to the planned elevation.
- (4)
- Comparing the calculation results of the two methods in Figure 2, the results of the improved method are not significantly different from those of the flood regulation simulation. For example, the probability calculations of the flood overtopping in 2017 for schedule 1 and schedule 2 using the improved INPR method and the flood regulation simulation method are 0.0522 and 0.0446, respectively. Although the results calculated by the two methods differ slightly, they may lead to significant deviations in the risk assessment results. For instance, assuming that the potential loss of life due to flood overtopping during the 2017 flood season was two people, and considering the dam life risk standard formulated in the “Guidelines for the Classification and Evaluation of Dam Risks” of China [36], it can be known that the two different probability results and the accident with a loss of two lives are of extremely high risk and high risk, respectively. This indicates that a small difference in probability results may lead to a significant difference in risk evaluation results. Therefore, a small change in the probability of flood overtopping should not be ignored.
- (5)
- This paper improves the traditional INPR method to enhance the rationality of the calculation results for the overtopping probability during the construction period of earth–rock dams. The purpose of this is twofold. Firstly, when the probability distribution of the construction progress is difficult to be accurately described, the influence of construction progress uncertainty on the overtopping probability is considered. The improved INPR method is proposed to make the calculation results more accurate and reasonable, providing a reference for subsequent risk decision-making and management. Secondly, this study expands the application scope of non-probabilistic reliability theory. It is not to replace the probabilistic reliability theory but to make it better serve as a supplement to the probabilistic reliability theory.
5. Conclusions
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
References
- Wang, T.; Li, Z.; Ge, W.; Zhang, Y.; Jiao, Y.; Zhang, H.; Sun, H.; Gelder, P.V. Risk assessment methods of cascade reservoir dams: A review and reflection. Nat. Hazards 2022, 115, 1601–1622. [Google Scholar] [CrossRef]
- Zhang, H.; Ge, W.; Zhang, Y.; Li, Z.; Li, W.; Zhu, J.; Wang, W. Risk Management Decision of Reservoir Dams Based on the Improved Life Quality Index. Water Resour. Manag. 2023, 37, 1223–1239. [Google Scholar] [CrossRef]
- Ge, W.; Qin, Y.; Li, Z.; Zhang, H.; Gao, W.; Guo, X.; Song, Z.; Li, W.; Gelder, P.V. An innovative methodology for establishing societal life risk criteria for dams: A case study to reservoir dam failure events in China. Int. J. Disaster Risk Reduct. 2020, 49, 101663. [Google Scholar] [CrossRef]
- Zhu, Y.; Zhang, Z.; Gu, C.; Li, Y.; Zhang, K.; Xie, M. A Coupled Model for Dam Foundation Seepage Behavior Monitoring and Forecasting Based on Variational Mode Decomposition and Improved Temporal Convolutional Network. Struct. Control Health Monit. 2023, 2023, 3879096. [Google Scholar] [CrossRef]
- Zhu, Y.; Tang, H. Automatic Damage Detection and Diagnosis for Hydraulic Structures Using Drones and Artificial Intelligence Techniques. Remote Sens. 2023, 15, 615. [Google Scholar] [CrossRef]
- Chen, Z.; Yin, Y.; Yu, J.; Cheng, X.; Zhang, D.; Li, Q. Internal deformation monitoring for earth-rockfill dam via high-precision flexible pipeline measurements. Autom. Constr. 2022, 136, 104177. [Google Scholar] [CrossRef]
- Taskaya, E.; Bombar, G.; Tayfur, G. Experimental investigation of sediment movement as a result of homogeneous earth-fill dam overtopping break over a simplified urban area. J. Hydrol. 2023, 617, 128924. [Google Scholar] [CrossRef]
- Wang, T.; Li, Z.; Ge, W.; Zhang, H.; Zhang, Y.; Sun, H.; Jiao, Y. Risk consequence assessment of dam breach in cascade reservoirs considering risk transmission and superposition. Energy 2023, 265, 126315. [Google Scholar] [CrossRef]
- Amaral, S.; Caldeira, L.; Viseu, T.; Ferreira, R.M.L. Designing Experiments to Study Dam Breach Hydraulic Phenomena. J. Hydraul. Eng. 2020, 146, 04020014. [Google Scholar] [CrossRef]
- Lempérière, F. Dams and Floods. Engineering 2017, 3, 144–149. [Google Scholar] [CrossRef]
- Zhao, W.; Wang, L. A novel interval dynamic topology optimization methodology of piezoelectric structures under reliable active control. Comput. Methods Appl. Mech. Eng. 2024, 421, 116766. [Google Scholar] [CrossRef]
- Hmarengo, M. Case Study: Dam Safety during Construction, Lessons of the Overtopping Diversion Works at Aguamilpa Dam. J. Hydraul. Eng. 2006, 132, 1121–1127. [Google Scholar] [CrossRef]
- Marengo, H.; Arreguin, F.I.; Aldama, A.A.; Morales, V. Case study: Risk analysis by overtopping of diversion works during dam construction: The La Yesca hydroelectric project, Mexico. Struct. Saf. 2013, 42, 26–34. [Google Scholar] [CrossRef]
- Song, Z.; Liu, Q.; Hu, Z.; Li, H.; Xiong, J. Assessment of Sediment Impact on the Risk of River Diversion during Dam Construction: A Simulation-Based Project Study on the Jing River, China. Water 2018, 10, 217. [Google Scholar] [CrossRef]
- Liu, L.; Bricker, J.D.; Hu, C. Late-stage diversion risk assessment for high dams considering early initial impoundment: A case study of Lianghekou Station, China. Front. Earth Sci. 2023, 11, 1232481. [Google Scholar] [CrossRef]
- Hosseinian, S.M.; Arjomand, A.; Li, C.Q.; Zhang, G. Developing a Model for Assessing Project Completion Time Reliability during Construction Using Time-Dependent Reliability Theory. J. Constr. Eng. Manag. 2022, 148, 04022006. [Google Scholar] [CrossRef]
- Li, C.; Zhang, G.; Hosseinian, M. A fast and Accurate Method to Predict Reliability of Project Completion Time. J. Civ. Eng. Manag. 2016, 23, 37–46. [Google Scholar] [CrossRef]
- Zhang, C.; Hu, Z. Risk model of flow diversion in the initial through middle stages for high arch dam construction and its application. Adv. Water Sci. 2019, 30, 102–111. [Google Scholar]
- Beer, M.; Ferson, S.; Kreinovich, V. Imprecise probabilities in engineering analyses. Mech. Syst. Signal Process. 2013, 37, 4–29. [Google Scholar] [CrossRef]
- Jiang, C.; Ni, B.; Han, X.; Tao, Y. Non-probabilistic convex model process: A new method of time-variant uncertainty analysis and its application to structural dynamic reliability problems. Comput. Methods Appl. Mech. Eng. 2014, 268, 656–676. [Google Scholar] [CrossRef]
- Yang, C.; Shi, Q. An interval perturbation method for singular value decomposition (SVD) with unknown-but-bounded (UBB) parameters. J. Comput. Appl. Math. 2024, 436, 115436. [Google Scholar] [CrossRef]
- Yakov, B. A non-probabilistic concept of reliability. Struct. Saf. 1994, 14, 227–245. [Google Scholar]
- Wang, L.; Liu, Y.; Xu, H. Review: Recent Developments in Dynamic Load Identificationfor Aerospace Vehicles Considering Multi-source Uncertainties. Trans. Nanjing Univ. Aeronaut. Astronaut. 2021, 38, 271–287. [Google Scholar]
- Wang, X.; Zhu, J.; Ni, B. Structural reliability-based design optimization with non-probabilistic credibility level. Comput. Methods Appl. Mech. Eng. 2024, 418, 116489. [Google Scholar] [CrossRef]
- Wang, L.; Liu, D.; Yang, Y.; Wang, X.; Qiu, Z. A novel method of non-probabilistic reliability-based topology optimization corresponding to continuum structures with unknown but bounded uncertainties. Comput. Methods Appl. Mech. Eng. 2017, 326, 573–595. [Google Scholar] [CrossRef]
- Xin, T.; Zhao, J.; Cui, C.; Duan, Y. A non-probabilistic time-variant method for structural reliability analysis. Proc. Inst. Mech. Eng. Part O J. Risk Reliab. 2020, 234, 664–675. [Google Scholar] [CrossRef]
- Li, Y.; Wang, X.; Wang, L.; Fan, W.; Qiu, Z. Non-probabilistic stability reliability measure for active vibration control system with interval parameters. J. Sound Vib. 2017, 387, 1–15. [Google Scholar] [CrossRef]
- Chen, Q.; Ma, H.; Yu, J.; Fei, Q. A modified interval perturbation statistical energy analysis method for structural reliability analysis of vibro-acoustic systems with interval uncertain parameters. Structures 2024, 60, 105902. [Google Scholar] [CrossRef]
- Wang, X.; Qiu, Z.; Elishakoff, I. Non-probabilistic set-theoretic model for structural safety measure. Acta Mech. 2008, 198, 51–64. [Google Scholar] [CrossRef]
- Zhao, T.; Zhang, C.; Tian, Y.; Li, Y.; Chen, Z.; Chen, X. Research progresses and prospects of catchment hydrological forecasting driven by global climate forecasts. Adv. Water Sci. 2024, 35, 156–166. [Google Scholar]
- SL 252-2017; Standard for Rank Classification and Flood Protection Criteria of Water and Hydropower Projects. China Water & Power Press: Beijing, China, 2017.
- Gui, Z.; Zhang, H.; Sun, H.; Zhang, F. Research and application of early warning model of vibration deterioration for hydroelectric-generator unit. J. Hydraul. Eng. 2018, 49, 216–222. [Google Scholar]
- Zhang, F.; Pan, L.; An, L. Study on statistical characteristics and maintenance alarm strategy for stability parameters of hydraulic turbine generator unit. J. Hydroelectr. Eng. 2013, 32, 269–272, 293. [Google Scholar]
- Jiang, C.; Xiong, L.; Huang, J.; Yang, S. A derivation method of flood frequency distribution incorporatingrainfall stochastic variable. J. Hydraul. Eng. 2023, 54, 45–53. [Google Scholar]
- SL 303-2017; Specifications for Construction Planning of Water Resources and Hydropower Projects. China Water & Power Press: Beijing, China, 2017.
- SL/T 829-2024; Ministry of Water Resources of the People’s Republic of China. Guidelines for Risk Classification and Assessment of Reservoir Dam. China Water & Electric Press: Beijing, China, 2024.
Frequency of floods | 20% | 50% | 75% | 90% | 95% |
Annual flow (10 thousand m3/s) | 46,961 | 28,484 | 18,599 | 12,921 | 10,677 |
Flood Return Period (Years) | Flood Frequency (%) | Upstream Water Level (m) | Flood Return Period (Years) | Flood Frequency (%) | Upstream Water Level (m) |
---|---|---|---|---|---|
1 | 100.00 | 344.12 | 100 | 1.00 | 387.69 |
2 | 50.00 | 347.20 | 200 | 0.50 | 393.48 |
5 | 20.00 | 353.06 | 500 | 0.20 | 401.55 |
10 | 10.00 | 360.28 | 1000 | 0.10 | 407.35 |
20 | 5.00 | 372.60 | 5000 | 0.02 | 416.67 |
50 | 2.00 | 381.62 |

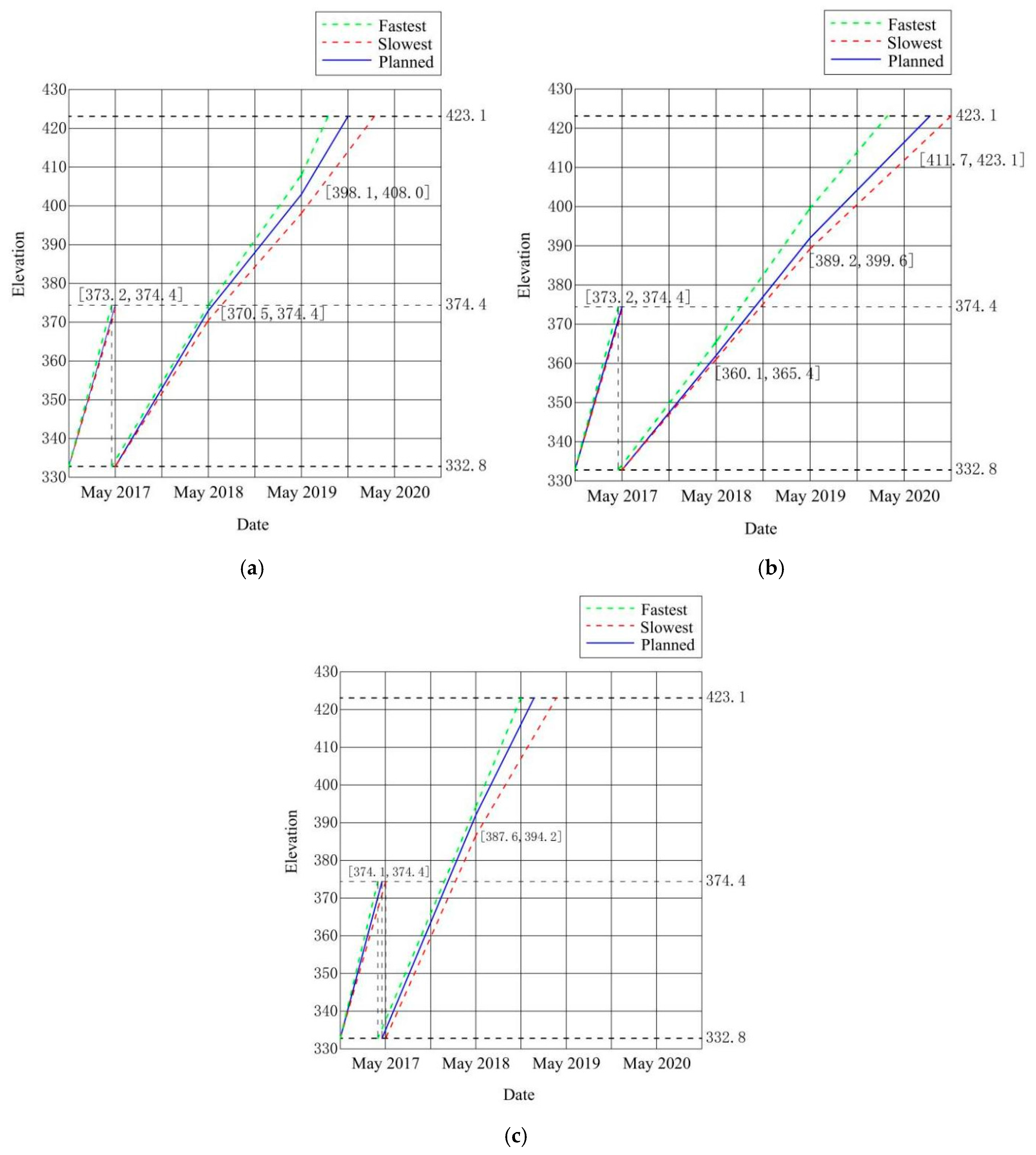

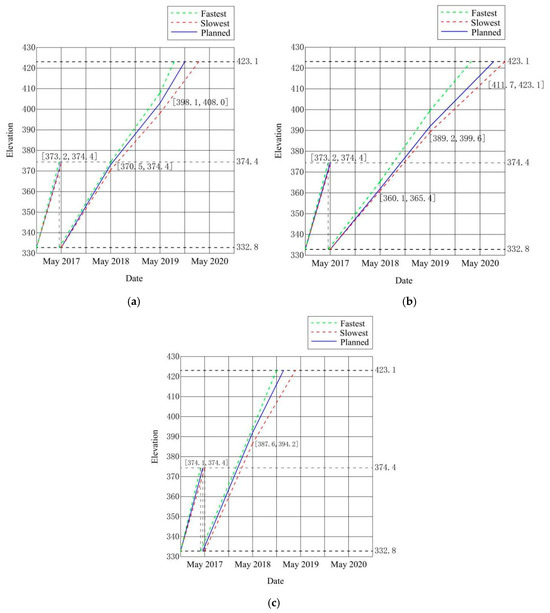

Schedule | Year 2017 | Year 2018 | Year 2019 | Year 2020 | |
---|---|---|---|---|---|
Schedule 1 | Planned elevation | 374.4 | 374.4 | 403.0 | - |
Interval elevation | [373.2, 374.4] | [374.4, 374.4] | [398.1, 408.0] | - | |
progress risk | 1.00 | - | 0.49 | - | |
Schedule 2 | Planned elevation | 374.4 | 374.4 | 392.0 | 416.0 |
Interval elevation | [373.2, 374.4] | [374.4, 374.4] | [389.2, 399.6] | [411.7, 423.1] | |
progress risk | 1.00 | - | 0.27 | 0.38 | |
Schedule 3 | Planned elevation | 374.4 | 392.0 | - | - |
Interval elevation | [374.1, 374.4] | [387.6, 394.2] | - | - | |
progress risk | 1.00 | 0.67 | - | - |

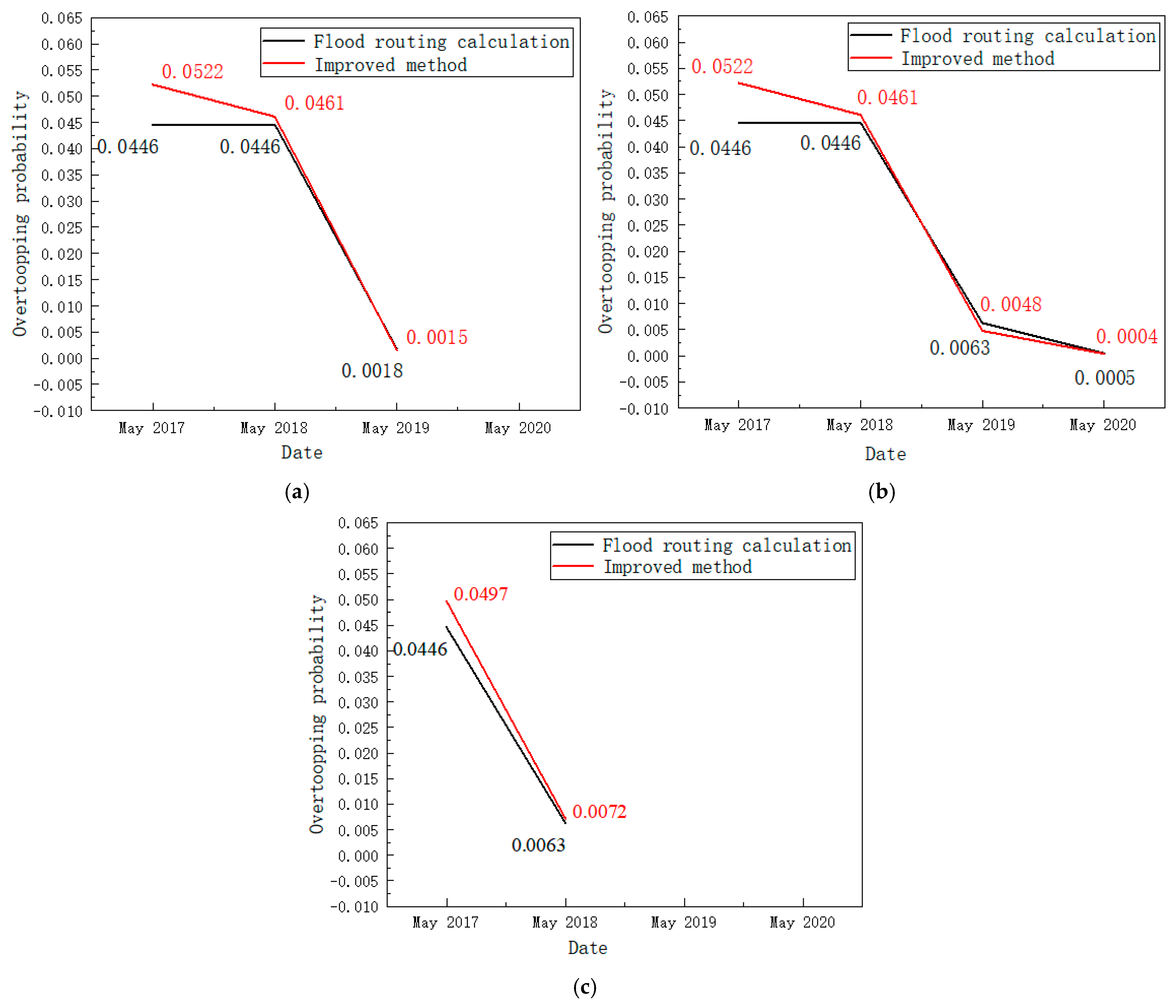

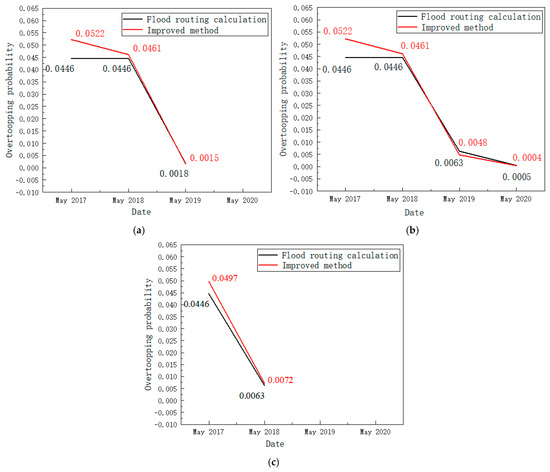

Schedule | Method | Year 2017 | Year 2018 | Year 2019 | Year 2020 |
---|---|---|---|---|---|
Schedule 1 | Improved method | 0.0522 | 0.0461 | 0.0015 | - |
Traditional method | 0.5909 | 0.5826 | 0.1877 | - | |
Flood routing calculation | 0.0446 | 0.0446 | 0.0018 | - | |
Schedule 2 | Improved method | 0.0522 | 0.0461 | 0.0048 | 0.0004 |
Traditional method | 0.5909 | 0.5826 | 0.3070 | 0.0149 | |
Flood routing calculation | 0.0446 | 0.0446 | 0.0063 | 0.0005 | |
Schedule 3 | Improved method | 0.0497 | 0.0072 | - | - |
Traditional method | 0.5847 | 0.3552 | - | - | |
Flood routing calculation | 0.0446 | 0.0063 | - | - |
