The Impact of the Learning and Forgetting Effect on the Cost of a Multi-Unit Construction Project with the Use of the Simulated Annealing Algorithm
Abstract
:1. Introduction
2. Materials and Methods
2.1. Project Scheduling Problems—The Overview
2.1.1. Multi-Mode Problems
2.1.2. Schedule Optimization for Multi-Unit Construction Projects
2.2. Learning and Forgetting Phenomena
2.2.1. LAF Models
- -

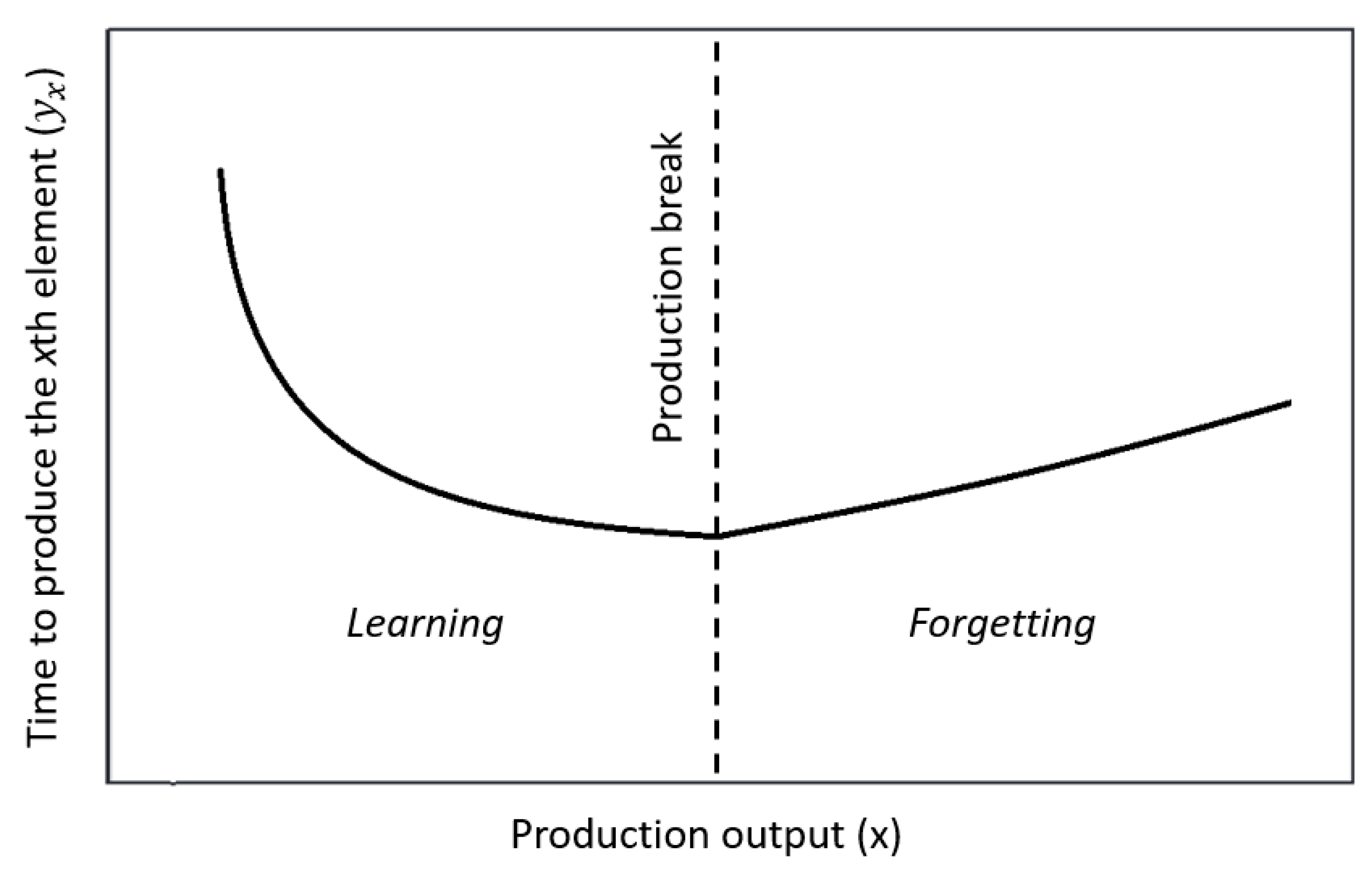

- —the time to produce the xth unit,
- -
- —the time to produce the first unit,
- -
- —the production count,
- -
- —the learning curve exponent.
2.2.2. LAF in Construction Industry
2.3. The Construction Project Model
2.3.1. The Model of the Learning and Forgetting Effect Used in the Research
- -
- —current performance,
- -
- —asymptotic limit of y value,
- -
- —amount of accumulated work performed,
- -
- —previous experience in the same unit as ,
- -
- —amount of work to be performed to achieve efficiency of ,
- -
- —forgetting factor,
- -
- —the ratio of the time elapsed from the first timestamp to the time that has elapsed since the last unit x was produced.
2.3.2. The Optimization Model
- The task of the contractor in the project is to construct a set of construction units:
- The set of working groups performing one type of work is as follows:
- Each unit Zi ∈ Z requires implementation of m activities which form the set:
- Each working group Bj can perform activity Oij ∈ Oi using a maximum of p different methods (technologies) of execution:Dj = {Dj1, …, Djk, …, Djp},
- -

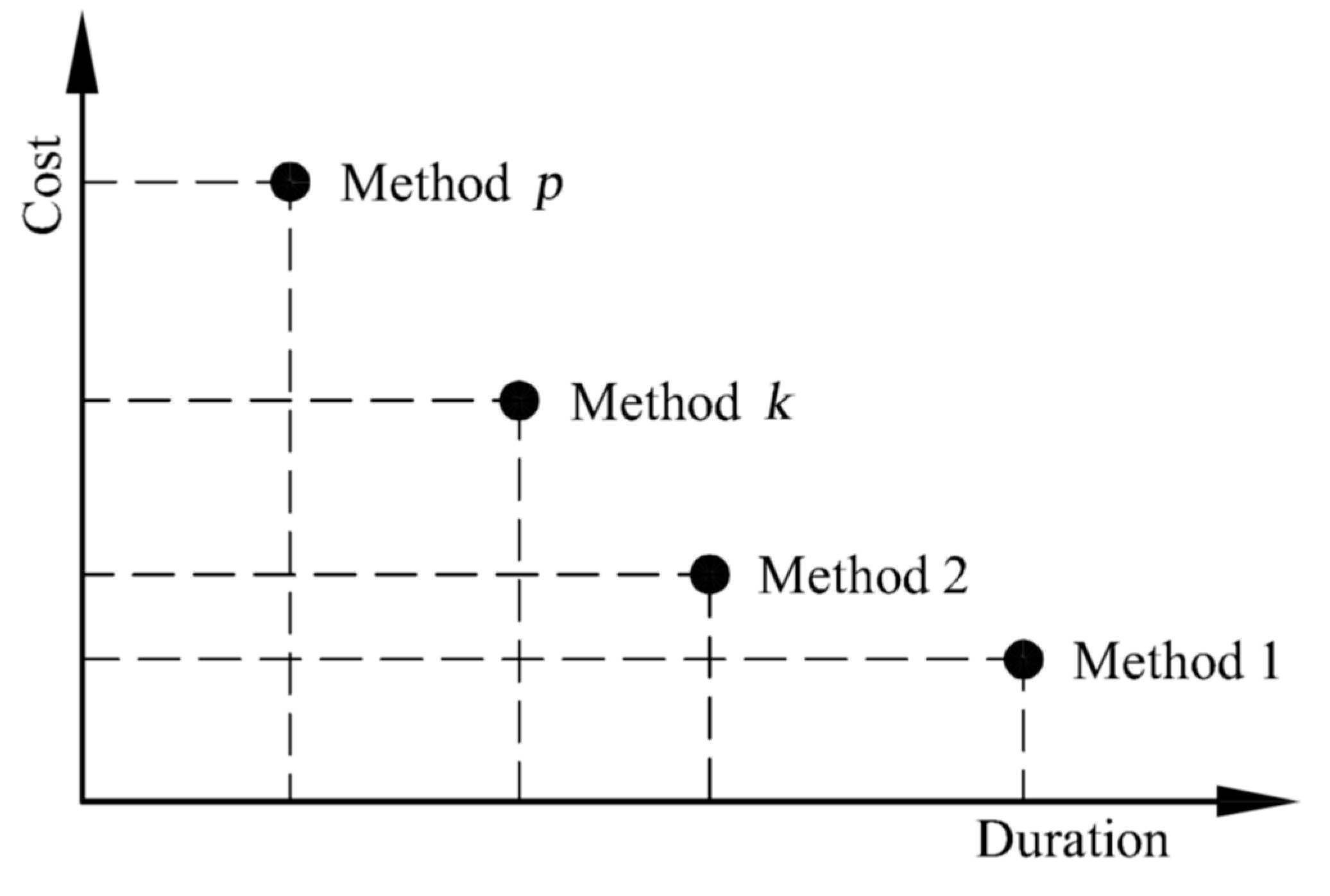

- Dj—set of possible execution modes (methods) for performing activity j by a working group Bj,
- -
- Djk—k method of performing activity j by a working group Bj, a k = 1 ... p.
- It is assumed that the activity Oij ∈ Oi can be done by the working group Bj. The durations of activities from the set Oi are defined by a vector:
- Similarly, as the above, it is assumed that the activity Oij ∈ Oi can be implemented by the working group Bj. The cost of realization of the activity Oij by the working group Bj defines a variable cijk ≥ 0. The set of possible costs of activities ci from the set Oi is defined by the vector:
- The LAF effect is considered for the whole duration of activities from the set Oi within vector tu_i = [tu_i1, tu_i2, tu_i3, ..., tu_ik, ..., tu_im], where tu_ik is a real duration of activity Oij taking into account the LAF effect calculated in accordance with the formula:
- -
- —the efficiency (performance) of the jth working group in carrying out the ith job on the zth day in turn.
- The order of execution of the activities resulting from work technology is assumed such that:
- It is assumed that only one job can be performed at a time.
- It is assumed that the activity cannot be stopped during its performance (preemption is not allowed).
- the order π of execution of units (permutation):
- set of numbers of methods of activity execution (from k = 1 to k = p):
- -
- π(0) = 0,
- -
- F0,j = 0,
- -
- Fi,0 = 0.
- -
- direct costs , which are the sum of the costs of all activities in the project,
- -
- indirect costs (all costs that do not become a final part of the installation but are crucial for the operation of the contractor) depending on the duration of the project,
- -
- penalty costs (optional) charged in case of delays (failure to meet the directive deadlines for the completion of construction works),
- -
- cost bonuses (optional) awarded in case of finishing the works early (earlier than directive deadlines). Such bonuses reduce the overall cost of the project.
- -
- —daily indirect construction costs,
- -
- —deadline for completion of works in the project,
- -
- —deadline for completion of works on i unit,
- -
- —the finish time for construction works on i unit,
- -
- —daily cost of the penalty for exceeding the directive deadlines for finishing works on units,
- -
- —the contractor’s daily bonus for not exceeding the directive deadlines for completion of works in the units,
- -
- —a set of all possible permutations in a given project,
- -
- n—number of all units (objects),
- -
- m—number of works (activities) to be completed on each of the units.
2.4. The Optimization Method of the Multi-Unit Project Discussed in the Article
2.4.1. Simulated Annealing Algorithm
Algorithm 1: SA |
Step 0. Determine the initial solution π ∈ Π. Substitute πSA = π0, k = 0, T = T0.
Step 1. Perform steps 1.1–1.3 x times. Step 1.1. Substitute k: = k + 1. Choose at random π ∈ N(V, πk−1). Step 1.2. If c(π) > c(πSA) then substitute πSA = π. Step 1.3. If c(π) > c(πk-1) then substitute πk = π. Otherwise, accept solution π with a probability of p = exp((c(π) − c(πk-1))/T, where πk = π’. If solution π was accepted, and πk = πk-1 if solution π was not accepted. Step 2. Change the temperature T according to the defined pattern of cooling. Step 3. If T > TN return to the step 1; otherwise, STOP. |
2.4.2. The Algorithm for Solving the Optimization Problem in the Presented Model of a Multi-Unit Project
- Let π ∈ Π be any random permutation (π* the best solution found so far, π* = π to start with), let R be a randomly determined set of methods for performing activities (R* the best solution found so far, R* = R to start with), and let MaxIter be the accepted maximum number of iterations of the algorithm.
- Step 1. Find the solution of the optimization problem using the SA metaheuristic (permutation δ) minimizing the cost of the project with the assumption of R as a set of methods for the implementation of activities.
- Step 2. Find the solution of the optimization problem using the SA metaheuristic (set of ρ methods of carrying out activities) minimizing the cost of the project with the assumption of the order of implementation of the units expressed by the permutation ρ.
- Step 3. If U(δ, ρ) ≤ U(π*, R*), to π* = δ, R* = ρ. Assume that R = ρ.
- Step 4. If Termination_Condition, then STOP;otherwise, go to Step 1.
- the Nπ neighborhood contains permutations generated from π by the “insert” movement,
- the Boltzmann acceptance function was used,
- a geometric cooling scheme was adopted, i.e., Ti+1 = λTi and T0 = 60, λ = 0.99, and the number of considered solutions at a fixed temperature—7,
- the maximum number of iterations of the SA algorithm in step 2—500.
- sets of numbers of the methods of carrying out works generated from R by means of a movement consisting in changing a randomly selected method of carrying out activities by a value selected at random +1 or −1 are contained in the neighboring set NR,
- the Boltzmann acceptance function was used,
- a geometric cooling scheme was adopted, i.e., Ti+1 = λTi and T0 = 60, λ = 0.99, and the number of considered solutions at a fixed temperature—35,
- the maximum number of iterations of the SA algorithm in step 3—20,000.
3. Results
3.1. Testing the Accuracy of the Results Obtained Using the SA Algorithm
- —the value of the adopted objective function obtained by means of the SA + SA algorithm,
- —the value of the adopted objective function obtained by means of the RS algorithm,
- —the value of the adopted objective function obtained by means of the CR algorithm.
3.2. Case Study
- R1 = (2,2,2,2,1),
- R2 = (2,2,2,3,2),
- R3 = (2,1,2,2,2),
- R4 = (2,2,2,1,1),
- R5 = (3,3,2,2,2),
- R6 = (1,1,2,2,1),
- R7 = (1,1,3,2,1).
4. Conclusions
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
References
- Arditi, D.; Tokdemir, O.B.; Suh, K. Challenges in Line-of-Balance Scheduling. J. Constr. Eng. Manag. 2002, 128, 545–556. [Google Scholar] [CrossRef]
- Mattila, K.G.; Park, A. Comparison of Linear Scheduling Model and Repetitive Scheduling Method. J. Constr. Eng. Manag. 2003, 129, 56–64. [Google Scholar] [CrossRef]
- Sobieraj, J.; Metelski, D. Project Risk in the Context of Construction Schedules—Combined Monte Carlo Simulation and Time at Risk (TaR) Approach: Insights from the Fort Bema Housing Estate Complex. Appl. Sci. 2022, 12, 1044. [Google Scholar] [CrossRef]
- Krzemiński, M. Conctruction scheduling and stability of the resulting schedules. Arch. Civ. Eng. 2016, 62, 89–100. [Google Scholar] [CrossRef] [Green Version]
- Nicał, A.; Anysz, H. The quality management in precast concrete production and delivery processes supported by association analysis. Int. J. Environ. Sci. Technol. 2020, 17, 577–590. [Google Scholar] [CrossRef]
- Arditi, D.; Tokdemir, O.B.; Suh, K. Effect of learning on line-of-balance scheduling. Int. J. Proj. Manag. 2001, 19, 265–277. [Google Scholar] [CrossRef]
- Lam, K.C.; Lee, D.; Hu, T. Understanding the effect of the learning-forgetting phenomenon to duration of projects construction. Int. J. Proj. Manag. 2001, 19, 411–420. [Google Scholar] [CrossRef]
- Zhang, L.; Zou, X.; Kan, Z. Improved Strategy for Resource Allocation in Repetitive Projects Considering the Learning Effect. J. Constr. Eng. Manag. 2014, 140, 04014053. [Google Scholar] [CrossRef]
- Biruk, S.; Rzepecki, L. Scheduling Repetitive Construction Processes Using the Learning-Forgetting Theory. IOP Conf. Ser. Mater. Sci. Eng. 2019, 471, 112039. [Google Scholar] [CrossRef]
- Sroka, B.; Rosłon, J.; Podolski, M.; Bożejko, W.; Burduk, A.; Wodecki, M. Profit optimization for multi-mode repetitive construction project with cash flows using metaheuristics. Arch. Civ. Mech. Eng. 2021, 21, 1–17. [Google Scholar] [CrossRef]
- Rosłon, J.; Książek-Nowak, M.; Nowak, P. Schedules Optimization with the Use of Value Engineering and NPV Maximization. Sustainability 2020, 12, 7454. [Google Scholar] [CrossRef]
- Herroelen, W. Project Scheduling-Theory and Practice. Prod. Oper. Manag. 2009, 14, 413–432. [Google Scholar] [CrossRef] [Green Version]
- Węglarz, J. Project Scheduling—Recent Models, Algorithms and Applications; Springer Science & Business Media: New York, NY, USA, 2012. [Google Scholar]
- Kolisch, R.; Padman, R. An integrated survey of deterministic project scheduling. Omega 2001, 29, 249–272. [Google Scholar] [CrossRef]
- Herroelen, W.; De Reyck, B.; Demeulemeester, E. Resource-constrained project scheduling: A survey of recent developments. Comput. Oper. Res. 1998, 25, 279–302. [Google Scholar] [CrossRef]
- Brucker, P.; Drexl, A.; Möhring, R.; Neumann, K.; Pesch, E. Resource-constrained project scheduling: Notation, classification, models, and methods. Eur. J. Oper. Res. 1999, 112, 3–41. [Google Scholar] [CrossRef]
- Kulejewski, J.; Ibadov, N.; Krzemiński, M. Scheduling Construction Projects Under Fuzzy Modelling of Resource Constraints. MATEC Web Conf. 2018, 196, 04045. [Google Scholar] [CrossRef]
- Habibi, F.; Barzinpour, F.; Sadjadi, S.J. Resource-constrained project scheduling problem: Review of past and recent developments. J. Proj. Manag. 2018, 55–88. [Google Scholar] [CrossRef]
- Senouci, A.B.; Eldin, N.N. Use of Genetic Algorithms in Resource Scheduling of Construction Projects. J. Constr. Eng. Manag. 2004, 130, 869–877. [Google Scholar] [CrossRef]
- Tiwari, V.; Patterson, J.H.; Mabert, V.A. Scheduling projects with heterogeneous resources to meet time and quality objectives. Eur. J. Oper. Res. 2009, 193, 780–790. [Google Scholar] [CrossRef]
- Mika, M.; Waligóra, G.; Węglarz, J. Simulated annealing and tabu search for multi-mode resource-constrained project scheduling with positive discounted cash flows and different payment models. Eur. J. Oper. Res. 2005, 164, 639–668. [Google Scholar] [CrossRef]
- Geiger, M.J. A multi-threaded local search algorithm and computer implementation for the multi-mode, resource-constrained multi-project scheduling problem. Eur. J. Oper. Res. 2017, 256, 729–741. [Google Scholar] [CrossRef]
- Rosłon, J.H.; Kulejewski, J.E. A hybrid approach for solving multi-mode resource-constrained project scheduling problem in construction. Open Eng. 2019, 9, 7–13. [Google Scholar] [CrossRef]
- Deblaere, F.; Demeulemeester, E.; Herroelen, W. Reactive scheduling in the multi-mode RCPSP. Comput. Oper. Res. 2011, 38, 63–74. [Google Scholar] [CrossRef]
- Ghoddousi, P.; Eshtehardian, E.; Jooybanpour, S.; Javanmardi, A. Multi-mode resource-constrained discrete time-cost-resource optimization in project scheduling using non-dominated sorting genetic algorithm. Autom. Constr. 2012, 30, 216–227. [Google Scholar] [CrossRef]
- Chen, A.H.-L.; Liang, Y.-C.; Padilla, J.D. An Entropy-Based Upper Bound Methodology for Robust Predictive Multi-Mode RCPSP Schedules. Entropy 2014, 16, 5032–5067. [Google Scholar] [CrossRef] [Green Version]
- Rosłon, J. The multi-mode, resource-constrained project scheduling problem in construction: State of art review and research challenges. Tech. Trans. 2017, 5, 67–74. [Google Scholar] [CrossRef]
- Zhou, J.; Love, P.; Wang, X.; Teo, K.L.; Irani, Z. A review of methods and algorithms for optimizing construction scheduling. J. Oper. Res. Soc. 2013, 64, 1091–1105. [Google Scholar] [CrossRef] [Green Version]
- Van Peteghem, V.; Vanhoucke, M. A genetic algorithm for the preemptive and non-preemptive multi-mode resource-constrained project scheduling problem. Eur. J. Oper. Res. 2010, 201, 409–418. [Google Scholar] [CrossRef]
- Liao, T.W.; Egbelu, P.; Sarker, B.; Leu, S. Metaheuristics for project and construction management—A state-of-the-art review. Autom. Constr. 2011, 20, 491–505. [Google Scholar] [CrossRef]
- Mika, M.; Waligóra, G.; Węglarz, J. Tabu search for multi-mode resource-constrained project scheduling with schedule-dependent setup times. Eur. J. Oper. Res. 2008, 187, 1238–1250. [Google Scholar] [CrossRef]
- Li, H.; Zhang, H. Ant colony optimization-based multi-mode scheduling under renewable and nonrenewable resource constraints. Autom. Constr. 2013, 35, 431–438. [Google Scholar] [CrossRef]
- Jarboui, B.; Damak, N.; Siarry, P.; Rebai, A. A combinatorial particle swarm optimization for solving multi-mode resource-constrained project scheduling problems. Appl. Math. Comput. 2008, 195, 299–308. [Google Scholar] [CrossRef]
- Sebt, M.H.; Afshar, M.R.; Alipouri, Y. Hybridization of genetic algorithm and fully informed particle swarm for solving the multi-mode resource-constrained project scheduling problem. Eng. Optim. 2016, 49, 513–530. [Google Scholar] [CrossRef]
- Zhang, L.; Luo, Y.; Zhang, Y. Hybrid Particle Swarm and Differential Evolution Algorithm for Solving Multimode Resource-Constrained Project Scheduling Problem. J. Control Sci. Eng. 2015, 2015, 1–6. [Google Scholar] [CrossRef] [Green Version]
- Rosłon, J.; Książek-Nowak, M.; Nowak, P.; Zawistowski, J. Cash-Flow Schedules Optimization within Life Cycle Costing (LCC). Sustainability 2020, 12, 8201. [Google Scholar] [CrossRef]
- Galloway, P.D. Survey of the Construction Industry Relative to the Use of CPM Scheduling for Construction Projects. J. Constr. Eng. Manag. 2006, 132, 697–711. [Google Scholar] [CrossRef]
- Rogalska, M.; Hejducki, Z. The application of time coupling methods in the engineering. Tech. Trans. 2017, 9, 67–74. [Google Scholar] [CrossRef]
- Li-hui, Z.; Xi, Z. Repetitive Project Scheduling Theory and Methods, 1st ed.; Elsevier: New York, NY, USA, 2015. [Google Scholar]
- Gupta, J.N.; Stafford, E.F. Flowshop scheduling research after five decades. Eur. J. Oper. Res. 2006, 169, 699–711. [Google Scholar] [CrossRef]
- Bożejko, W.; Hejducki, Z.; Wodecki, M. Applying metaheuristic strategies in construction projects management. J. Civ. Eng. Manag. 2012, 18, 621–630. [Google Scholar] [CrossRef] [Green Version]
- Bozejko, W.; Hejducki, Z.; Wodecki, M. Flowshop scheduling of construction processes with uncertain parameters. Arch. Civ. Mech. Eng. 2019, 19, 194–204. [Google Scholar] [CrossRef]
- Podolski, M. Management of resources in multiunit construction projects with the use of a tabu search algorithm. J. Civ. Eng. Manag. 2016, 23, 263–272. [Google Scholar] [CrossRef] [Green Version]
- Podolski, M.; Sroka, B. Cost Optimization of Multiunit Construction Projects Using Linear Programming and Metaheuristic-Based Simulated Annealing Algorithm. J. Civ. Eng. Manag. 2019, 25, 848–857. [Google Scholar] [CrossRef]
- Tomczak, M. Modeling of the harmonization method for executing a multi-unit construction project. Open Eng. 2019, 9, 282–291. [Google Scholar] [CrossRef] [Green Version]
- Glock, C.H.; Grosse, E.H.; Jaber, M.Y.; Smunt, T.L. Applications of learning curves in production and operations management: A systematic literature review. Comput. Ind. Eng. 2018, 131, 422–441. [Google Scholar] [CrossRef] [Green Version]
- Wright, T.P. Factors affecting the cost of airplanes. J. Aeronaut. Sci. 1936, 3, 122–128. [Google Scholar] [CrossRef] [Green Version]
- Badiru, A.B. Multivariate analysis of the effect of learning and forgetting on product quality. Int. J. Prod. Res. 1995, 33, 777–794. [Google Scholar] [CrossRef]
- De Jong, J.R. The effects of increasing skill on cycle time and its consequences for time standards. Ergonomics 1957, 1, 51–60. [Google Scholar] [CrossRef]
- Thomopoulos, N.T.; Lehman, M. The Mixed Model Learning Curve. AIIE Trans. 1969, 1, 127–132. [Google Scholar] [CrossRef]
- Jaber, M.Y.; Guiffrida, A.L. Learning curves for imperfect production processes with reworks and process restoration interruptions. Eur. J. Oper. Res. 2008, 189, 93–104. [Google Scholar] [CrossRef]
- Grosse, E.H.; Glock, C.; Müller, S. Production economics and the learning curve: A meta-analysis. Int. J. Prod. Econ. 2015, 170, 401–412. [Google Scholar] [CrossRef]
- Carlson, J.G.; Rowe, A.J. How much does forgetting cost. Ind. Eng. 1976, 8, 40–47. [Google Scholar]
- Elmaghraby, S.E. Economic manufacturing quantities under conditions of learning and forgetting (EMQ/LaF). Prod. Plan. Control 1990, 1, 196–208. [Google Scholar] [CrossRef]
- Jaber, M.Y.; Bonney, M. Production breaks and the learning curve: The forgetting phenomenon. Appl. Math. Model. 1996, 20, 162–169. [Google Scholar] [CrossRef]
- Sikström, S.; Jaber, M.Y. The power integration diffusion model for production breaks. J. Exp. Psychol. Appl. 2002, 8, 118–126. [Google Scholar] [CrossRef]
- Sikström, S.; Jaber, M.Y. The Depletion-Power-Integration-Latency (DPIL) model of spaced and massed repetition. Comput. Ind. Eng. 2012, 63, 323–337. [Google Scholar] [CrossRef]
- Pellegrino, R.; Costantino, N.; Pietroforte, R.; Sancilio, S. Construction of multi-storey concrete structures in Italy: Patterns of productivity and learning curves. Constr. Manag. Econ. 2012, 30, 103–115. [Google Scholar] [CrossRef]
- Jarkas, A.; Horner, M. Revisiting the applicability of learning curve theory to formwork labour productivity. Constr. Manag. Econ. 2011, 29, 483–493. [Google Scholar] [CrossRef]
- Tai, H.-W.; Chen, J.-H.; Cheng, J.-Y.; Hsu, S.-C.; Wei, H.-H. Learn Curve for Precast Component Productivity in Construction. Int. J. Civ. Eng. 2021, 19, 1179–1194. [Google Scholar] [CrossRef]
- Panas, A.; Pantouvakis, J.P. Simulation-Based and Statistical Analysis of the Learning Effect in Floating Caisson Construction Operations. J. Constr. Eng. Manag. 2014, 140, 04013033. [Google Scholar] [CrossRef]
- Mályusz, L.; Pém, A. Prediction of the learning curve in roof insulation. Autom. Constr. 2013, 36, 191–195. [Google Scholar] [CrossRef]
- Hegazy, T. Optimization of construction time-cost trade-off analysis using genetic algorithms. Can. J. Civ. Eng. 1999, 26, 685–697. [Google Scholar] [CrossRef]
- Nembhard, D.A.; Uzumeri, M.V. Experiential learning and forgetting for manual and cognitive tasks. Int. J. Ind. Ergon. 2000, 25, 315–326. [Google Scholar] [CrossRef]
- Kirkpatrick, S.; Gelatt, C.D., Jr.; Vecchi, M.P. Optimization by Simulated Annealing. Science 1983, 220, 671–680. [Google Scholar] [CrossRef]
- Błażewicz, J. Złożoność Obliczeniowa Problemów Kombinatorycznych; Wydawnictwa Naukowo-Techniczne: Kraków, Poland, 1988. [Google Scholar]
- Karnopp, D.C. Random search techniques for optimization problems. Automatica 1963, 1, 111–121. [Google Scholar] [CrossRef]
- Taillard, E. Some efficient heuristic methods for the flow shop sequencing problem. Eur. J. Oper. Res. 1990, 47, 65–74. [Google Scholar] [CrossRef]
Example Name: Number of Units × Number of Works | PRD(SA + SA)_RS (%) − Algorithm RS | PRD(SA + SA)_CR (%) − Algorithm CR |
---|---|---|
Examples n = 6 units | ||
6 × 3 | −6.19 | −3.73 |
6 × 5 | −7.36 | −4.62 |
6 × 7 | −9.92 | −6.69 |
mean PRD for size n = 6 | −7.82 | −5.01 |
Examples n = 10 units | ||
10 × 3 | −11.17 | −6.67 |
10 × 5 | −14.95 | −8.71 |
10 × 7 | −18.07 | −11.93 |
mean PRD for size n = 10 | −14.73 | −9.10 |
Examples n = 15 units | ||
15 × 3 | −16.74 | −10.14 |
15 × 5 | −10.68 | −3.68 |
15 × 7 | −11.14 | −2.93 |
mean PRD for size n = 15 | −12.85 | −5.58 |
Examples n = 20 units | ||
20 × 3 | −16.64 | −9.31 |
20 × 5 | −11.48 | −4.23 |
20 × 7 | −20.48 | −13.31 |
mean PRD for size n = 20 | −16.20 | −8.95 |

Examples n = 6, 10, 15, 20 units | ||
mean PRD (%) | −12.90 | −7.16 |
Modes (Number/Details) | Units i = | |||||||
---|---|---|---|---|---|---|---|---|
1 | 2 | 3 | 4 | 5 | 6 | 7 | ||
Earthworks (j = 1) | ||||||||
1 | Execution time [working days] | 11 | 9 | 7 | 17 | 8 | 9 | 8 |
Execution cost [in thous. EUR] | 5.5 | 4.5 | 3.5 | 8.5 | 4 | 4.5 | 4 | |
2 | Execution time [working days] | 10 | 7 | 8 | 18 | 9 | 11 | 9 |
Execution cost [in thous. EUR] | 6.05 | 5.79 | 3.06 | 8.03 | 3.56 | 3.68 | 3.56 | |
3 | Execution time [working days] | 12 | 10 | 6 | 13 | 10 | 10 | 9 |
Execution cost [in thous. EUR] | 5.04 | 4.05 | 4.08 | 11.12 | 3.20 | 4.05 | 3.56 | |
Foundations (j = 2) | ||||||||
1 | Execution time [working days] | 17 | 11 | 25 | 24 | 17 | 14 | 26 |
Execution cost [in thous. EUR] | 24.00 | 15.53 | 35.29 | 33.88 | 24.00 | 19.76 | 36.71 | |
2 | Execution time [working days] | 14 | 10 | 27 | 26 | 14 | 16 | 24 |
Execution cost [in thous. EUR] | 29.14 | 17.08 | 32.68 | 31.28 | 29.14 | 17.29 | 39.76 | |
3 | Execution time [working days] | 22 | 8 | 28 | 25 | 14 | 17 | 28 |
Execution cost [in thous. EUR] | 18.55 | 21.35 | 31.51 | 32.53 | 29.14 | 16.28 | 34.08 | |
Walls. slabs (j = 3) | ||||||||
1 | Execution time [working days] | 35 | 13 | 45 | 44 | 35 | 36 | 52 |
Execution cost [in thous. EUR] | 65.50 | 24.33 | 84.21 | 82.34 | 65.50 | 67.37 | 97.31 | |
2 | Execution time [working days] | 31 | 13 | 35 | 54 | 42 | 30 | 67 |
Execution cost [in thous. EUR] | 73.95 | 24.33 | 108.28 | 67.09 | 54.58 | 80.85 | 75.53 | |
3 | Execution time [working days] | 34 | 13 | 56 | 42 | 30 | 37 | 36 |
Execution cost [in thous. EUR] | 67.43 | 24.33 | 67.67 | 86.26 | 76.42 | 65.55 | 140.57 | |
Rafter framings, roofing (j = 4) | ||||||||
1 | Execution time [working days] | 12 | 10 | 17 | 12 | 11 | 19 | 10 |
Execution cost [in thous. EUR] | 35.50 | 29.58 | 50.29 | 35.50 | 32.54 | 56.21 | 29.58 | |
2 | Execution time [working days] | 13 | 8 | 21 | 12 | 11 | 18 | 11 |
Execution cost [in thous. EUR] | 32.77 | 36.98 | 40.71 | 35.50 | 32.54 | 59.33 | 26.89 | |
3 | Execution time [working days] | 11 | 7 | 14 | 14 | 12 | 14 | 10 |
Execution cost [in thous. EUR] | 38.73 | 42.26 | 61.07 | 30.43 | 29.83 | 76.28 | 29.58 | |
Windows and doors (j = 5) | ||||||||
1 | Execution time [working days] | 9 | 9 | 4 | 14 | 17 | 7 | 14 |
Execution cost [in thous. EUR] | 38.00 | 38.00 | 16.89 | 59.11 | 71.78 | 29.56 | 59.11 | |
2 | Execution time [working days] | 8 | 10 | 4 | 16 | 19 | 7 | 13 |
Execution cost [in thous. EUR] | 42.75 | 34.20 | 16.89 | 51.72 | 64.22 | 29.56 | 63.66 | |
3 | Execution time [working days] | 10 | 7 | 3 | 16 | 16 | 9 | 16 |
Execution cost [in thous. EUR] | 34.20 | 48.86 | 22.52 | 51.72 | 76.26 | 22.99 | 51.72 |
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations. |
© 2022 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Podolski, M.; Rosłon, J.; Sroka, B. The Impact of the Learning and Forgetting Effect on the Cost of a Multi-Unit Construction Project with the Use of the Simulated Annealing Algorithm. Appl. Sci. 2022, 12, 12667. https://doi.org/10.3390/app122412667
Podolski M, Rosłon J, Sroka B. The Impact of the Learning and Forgetting Effect on the Cost of a Multi-Unit Construction Project with the Use of the Simulated Annealing Algorithm. Applied Sciences. 2022; 12(24):12667. https://doi.org/10.3390/app122412667
Chicago/Turabian StylePodolski, Michał, Jerzy Rosłon, and Bartłomiej Sroka. 2022. "The Impact of the Learning and Forgetting Effect on the Cost of a Multi-Unit Construction Project with the Use of the Simulated Annealing Algorithm" Applied Sciences 12, no. 24: 12667. https://doi.org/10.3390/app122412667
APA StylePodolski, M., Rosłon, J., & Sroka, B. (2022). The Impact of the Learning and Forgetting Effect on the Cost of a Multi-Unit Construction Project with the Use of the Simulated Annealing Algorithm. Applied Sciences, 12(24), 12667. https://doi.org/10.3390/app122412667
