Next Article in Journal
Hand Gesture Detection and Recognition Using Spectrogram and Image Processing Technique with a Single Pair of Ultrasonic Transducers
Next Article in Special Issue
Transforming Building Criteria to Evidence Index
Previous Article in Journal
Regularized Chained Deep Neural Network Classifier for Multiple Annotators
Previous Article in Special Issue
IoT Open-Source Architecture for the Maintenance of Building Facilities


Font Type:
Arial Georgia Verdana
Font Size:
Aa Aa Aa
Line Spacing:
Column Width:
Background:
Article

BIM-Based Research Framework for Sustainable Building Projects: A Strategy for Mitigating BIM Implementation Barriers

by
Bilal Manzoor
1,
Idris Othman
1,
Syed Shujaa Safdar Gardezi
2,
Haşim Altan
3,* and
Salem Buhashima Abdalla
4
1
Department of Civil & Environmental Engineering, University Technology PETRONAS (UTP), Seri Iskandar 32610, Perak, Malaysia
2
Department of Civil Engineering, Capital University of Science and Technology (CUST), Islamabad 44000, Pakistan
3
Department of Architecture, Faculty of Design, Arkin University of Creative Art and Design (ARUCAD), Kyrenia 99300, Cyprus
4
Department of Architectural Engineering, College of Engineering, University of Sharjah (UOS), Sharjah 27272, United Arab Emirates
*
Author to whom correspondence should be addressed.
Appl. Sci. 2021, 11(12), 5397; https://doi.org/10.3390/app11125397
Submission received: 19 May 2021 / Revised: 3 June 2021 / Accepted: 8 June 2021 / Published: 10 June 2021
(This article belongs to the Special Issue Cognitive Buildings)

Abstract

:
Although Building Information Modeling (BIM) can enhance efficiency of sustainable building projects, its adoption is still plagued with barriers. In order to incorporate BIM more efficiently, it is important to consider and mitigate these barriers. The aim of this study is to explore and develop strategies to alleviate barriers in developing countries, such as Malaysia, to broaden implementation of BIM with the aid of quantitative and qualitative approaches. To achieve this aim, a comprehensive literature review was carried out to identify the barriers, and a questionnaire survey was conducted with construction projects’ stakeholders. The ranking analysis results revealed the top five critical barriers to be “unavailability of standards and guidelines”, “lack of BIM training”, “lack of expertise”, “high cost”, and “lack of research and BIM implementation”. Comparative study findings showed that “lack of research and BIM implementation” is the least important barrier in other countries like China, United Kingdom, Nigeria, and Pakistan. Furthermore, qualitative analysis revealed the strategies to mitigate the BIM implementation barriers to enhance sustainable goals. The final outcome of this study is the establishment of a framework incorporated with BIM implementation barriers and strategies namely, the “BIM-based research framework”, which can assist project managers and policymakers towards effective sustainable construction.

1. Introduction

With the rapid growth of the construction industry, an increasing number of sustainable building projects are underway all over the world and have far-reaching consequences for national and regional economic development [1]. All other industries rely to some extent on the construction industry because of their high productivity flow through the economy [2]. Similarly, Malaysia’s construction industry, like other developing countries, varies from cost, time constraints, and efficiency, resulting in delays [3]. Moreover, due to budget and schedule overrun, most sustainable building projects struggle to achieve their goals. It is therefore important to use advanced digital technologies such as BIM in order to achieve the desired results effectively [4]. Using BIM in sustainable building projects has various advantages, such as reducing errors, rework, and waste [5,6,7]. In addition, the use of BIM in sustainable building projects facilitates multidisciplinary cooperation between different project teams, achieves the project objective, and increases the productivity of construction activities [8,9,10]. BIM can be used in any phase of sustainable building projects, such as visualization, cash detection, code checking, communication, collaboration, monitoring, time and cost management [11,12]. BIM also has the potential as a significant technical advancement in traditional CAD, offering more information and interoperability capabilities [13]. BIM has the power to transform the construction industry and is therefore considered to be the future of the construction industry [14].
Since buildings are of high economic value and have a major effect on the environment and quality of life, the construction industry can be considered one of the key elements for society’s long-term growth [15]. Buildings are deemed sustainable if their environmental, economic, and social effects on the community have been properly addressed and have contributed to society’s long-term growth [16]. In the past, it was anticipated that sustainable buildings would initially cost around 15% more than conventional ones [17].
In addition, it has been found that few studies have been conducted on barriers to the implementation of BIM in sustainable building projects. Memon et al. [4] used a survey of sample size questionnaires (n = 95) to report the barriers and found that BIM adoption in Malaysian construction was very low. However, the current analysis expands the scale of the study by increasing the number of survey respondents (n = 185). In addition, Zahrizan et al. [18] used the quantitative analysis approach through questionnaire surveys to identify barriers and to report that the lack of BIM awareness is a crucial barrier to the implementation of BIM. Subsequently, Hamid et al. [19] performed a report on barriers but limited to establishing only nine barriers. Wong et al. [20] conducted a recent study that emphasized the importance of transitioning from outdated approaches to sophisticated methodologies such as BIM in order to merge design and construction workflows with the goal of enhancing productivity. Therefore, strategies are needed to make the project successful and help construction stakeholders to perform effectively in order to achieve the sustainable goals.
Hence, this research aims to provide strategies for alleviating barriers with the approach of qualitative analysis and a BIM-based research framework for sustainable building projects. To fulfill the aim of the study, there were four research objectives as follows: (a) to identify barriers from the literature, (b) to rank the barriers with the aid of quantitative approach, (c) to provide strategies in order to mitigate the barriers with the aid of qualitative approach, and (d) to establish a BIM-based research framework integrating barriers and strategies for sustainable building projects. The intent of the research was to explore and uncover new knowledge gaps and practical needs of a BIM-based research framework for sustainable building projects. It would also serve as a theoretical foundation for adopting BIM in sustainable building projects.
The remainder of the paper is arranged in the following way: Section 2 addresses the theoretical background and research gaps. Section 3 explains the related works. Section 4 sets out the research methodology. Subsequently, Section 5 elaborates on the results and discussion. Section 6 explains the comparison of outcomes with other countries. Section 7 introduces the BIM-based research framework and is followed by Section 8, the conclusion, limitations, and future directions.

2. Theoretical Background and Research Gaps

BIM is defined as “a model of building information that provides full and necessary information to support all life-cycle processes and that can be directly interpreted by computer applications. It includes information on the building itself and its components, and involves information on the properties of the building, such as its structure, shape, material and life-cycle processes” [21]. The term “BIM” has several contradictory and misleading interpretations. Definitions may differ for different people in distinct organizations, depending on their point of views, work types, and functions. From a design perspective, for example, BIM is described as the digital representation of a project’s physical and functional qualities, which relates to the methodology and technologies required to generate a model [22]. In the construction industry, BIM is defined as the creation and application of a computer software model to simulate the construction and operation of a facility [23].
The genesis, creation, and expansion of BIM ultimately represented the growth profile of computerization. In the late 1950s, Itek Corporation, a U.S. defense contractor, developed a computer graphics technology suitable for engineering design. This helped design visual representation technologies that had been integrated into commercial engineering design and design products. Subsequently, the idea was transformed into an Electronic Drafting Machine (EDM) [24]. By the mid-1960s, EDMs had been marketed for use by other organizations. During the 1970s and early 1980s, Applicon (founded in 1969 as Analytics, Inc. in Burlington, Massachusetts by a group of MIT Lincoln Laboratory programmers) provided 2D products for electrical design tasks. This included the concept of the printed circuit board and a 3D product named BRAVO! Computer Art and Design [24]. In the early 1980s, the BRAVO! The product has been considerably advanced. Since the early 1980s, Autodesk had been a significant competitor of Applicon and other CAD suppliers. Autodesk continues to be a pioneer in this area [25]. Distinctive characteristics such as structural analysis, monitoring and analysis of energy buildings, construction management, and performance tracking and even worker safety have recently been provided on AEC computer platforms [26]. The word BIM attracted TM/®/©, who began to promote it with their products [27]. In order to increase infrastructure development, reduce costs, and provide general management assistance during any step of construction, the BIM idea was introduced to the construction industry [28].
In the construction industry, barriers to BIM implementation are a challenge for stakeholders to improve sustainable goals. Almost the bulk of research in literature is related to the identification of barriers. For instance, BIM implementation barriers have been highlighted in Hong Kong but are not capable of providing strategies [29]. Similarly, a study was conducted in China and Australia to define, classify, and prioritize these barriers but not to establish strategies [30]. Researchers have recently performed barrier-related research for promoting sustainable construction. For example, the barriers to strengthening team coordination in BIM-based construction networks and the construction of a conceptual model. This conceptual model offers an intermediate theory, that is, a theoretical basis for guiding further attempts at knowledge formation on the subject [8]. In addition, the advantages and barriers to the implementation of BIM have been applied with a quantitative approach but are not capable of having a strategy to overcome [31]. Therefore, to fill the aforementioned research gap, this study focuses on providing strategies in reducing the barriers for sustainable building projects with the aid of a BIM-based research framework.

3. Related Work

In this section, related works in the domain of barriers in the global and Malaysian context are discussed.

3.1. BIM Implementation Barriers in Global Context

Globally, fast growth demands and the overwhelming majority of construction companies have allocated BIM to improve the sustainability goals [32]. In sustainable building projects around the globe, the use of BIM has been advocated by government and professional bodies to provide more collaboration and cooperation between stakeholders in the construction sector and to ensure the quality of the projects [33]. Moreover, countries like the United Kingdom, the United States, Australia have adopted BIM in-depth research and other field areas like project management, facility management, and safety management [34,35]. In Australia and New Zealand, the implementation of BIM is only at level 2, with the main focus being on 2D and 3D collaboration [36]. The researchers revealed that “lack of faith in the integrity of BIM” and “lack of client demand” among other barriers were one of the factors behind the lack of BIM implementation in Australia [37]. Many researchers in Germany, the United Kingdom, Canada, the United States, Denmark, France, China, Brazil, South Korea, and the Middle East [38,39,40,41,42,43,44,45,46] have also found numerous BIM implementation barriers. It includes lack of BIM experience, investment costs, lack of awareness, lack of specified standards, market and cultural changes, interoperability problems, lack of specific guidelines for BIM implementation, and habitual resistance to change [31,44,47]. However, it has been found that the construction industry in the United States has engaged BIM in its ventures relative to other industries across the globe [48]. The government’s BIM initiative became compulsory in projects in the public sector, beginning in 2016 in the UK [43]. It is therefore noticed that implementation of the BIM in different countries is growing for effective and productive construction [49]. However, there is a need to explore BIM in sustainable building projects for the sake of an eco-friendly environment and prompt sustainable goals.

3.2. BIM Implementation Barriers in Malaysian Context

In Malaysia, BIM implementation is still in the developing stage. However, the construction industry in Malaysia has taken major steps to encourage and boost construction efficiency at the national level with the introduction of BIM [50,51]. In addition, BIM is mandatory for public projects with a budget of RM 100 million or more from 2018 [52]. According to Datuk Seri Dr Roslan Md Taha (PWD Director-General), a total of 18 construction projects have been initiated by BIM in various construction phases up to 2017 such as SMK Meru Raya Ipoh Perak, Health Clinic Maran Pahang, MACC Selangor Shah Alam, UTHM Batu Pahat Johor and Parit Buntar Hospital [53]. With the continuous implementation of BIM against sustainable building projects in Malaysia, the implementation of BIM still faces numerous barriers and BIM implementation in sustainable building projects has many concerns and challenges. Hence, there is a need to better understand barriers in order to make the construction smoother and more effective for boosting sustainability goals. Various researchers have also highlighted the barriers to BIM implementation. The most critical barrier which was identified by many researchers is high cost [54,55,56,57]. Likewise, in Hong Kong and China, high cost is also considered as the BIM implementation barrier [47,58]. Moreover, it was also described as the topmost critical barrier in the Middle East [59]. As a result, high costs are included as one of the barriers since they are commonly available in the literature. In the last year, another study was conducted to explore the level of adoption of BIM in Malaysia. This study found that only 13% of government and private participants use BIM in their organization, which is negative evidence that Malaysia remains a long way from the role it should play in implementing BIM [60]. Therefore, it is recommended to implement BIM by eliminating barriers and providing the strategies for sustainable building projects.

4. Research Methodology

In this section, a brief explanation of the research methodology has been discussed. The research methodology section comprises data collection and data analysis. In addition, the research design flowchart, as shown in Figure 1, comprises four phases to fulfill the aim and objectives of this study. In the first step, the research aim and objectives were formulated by evaluating the relevant literature and identifying research gaps in previous research performed by researchers. The second phase of the study consists of collecting data from the literature review by defining the implementation barriers of the BIM and developing a questionnaire survey to be distributed among stakeholders (contractors, clients, and consultants). In the third step, the triangulation approach was introduced to achieve the study goal and the study objectives. The method of triangulation consists of two forms of analysis, i.e., quantitative analysis and qualitative analysis. According to Altricher et al. [61], triangulation “gives the more detailed and fair image of the circumstances”. In quantitative analysis, the SPSS software package was used to assess the feedback of the respondents. The SPSS software was used to analyze the values of Cronbach’s alpha coefficient, Kendall’s coefficient of concordance (Kendall’s W), Chi-square analysis, and mean score analysis, while NVivo software was used in qualitative analysis to analyze the data collected from interviews. In the final and fourth phase of the study, the recommendation and conclusion were drawn from the analysis results.

4.1. Data Collection

After establishing the aim and objectives of the study in the introduction section, phase 2 of the study was conducted, which consisted of literature review, questionnaire survey, and interview session.

4.1.1. Literature Search Parameters

The purpose of the literature review was to identify barriers with various databases, such as Scopus, Web of Science, Google Scholar, and other relevant publications such as Elsevier, American Society of Civil Engineers (ASCE), Emerald and Taylor and Francis. Keywords such as “building information modeling”, “construction industry”, “construction projects”, and “barriers” were used. Subsequently, the listed publications were screened, primarily by concentrating on the title, abstract, and conclusions, as well as the figures and tables. Table 1 elaborates the BIM implementation barriers that were used in this research study based on the existing literature.
After rigorous review of current literature relating to BIM implementation barriers, various factors were identified. Table 1 elaborates a list of 20 factors that are well documented and hence more applicable. Prior to identification of BIM implementation barriers, it is kept in mind that the selection of well-known factors is more reliable and also easy for the respondents to understand the theme and feedback easily.
Previous studies were used to identify the aforementioned BIM implementation barriers. Following a thorough evaluation of these studies, this study identified 20 potential barriers to BIM implementation, which are presented in Table 1. For example, cost, lack of expertise, and lack of promotion are commonly acknowledged in the literature as crucial barriers to BIM implementation.

4.1.2. Questionnaire Survey

In this section, questionnaire design and responses were examined. The questionnaire survey method was used to collect the data through a quantitative approach. Therefore, the questionnaire was designed after careful consideration of existing literature in the domain of BIM implementation barriers. Prior to the final questionnaire survey, a semi-structured interview was arranged to ensure the potential and appropriateness of the questionnaire in the context of BIM implementation barriers. In the pilot study, the feedback from five participants was used to further improve the questions prior to the actual questionnaire survey. The pilot survey consisted of two professors, two assistant professors, and one postgraduate researcher. The questionnaire was finalized based on feedback from the pilot study. The final questionnaire consists of three parts: (a) research aim and objectives, (b) general information of respondents, (c) rank of the barriers using a Likert scale (1—Strongly Disagree, 2—Disagree, 3—Moderately Agree, 4—Agree, 5—Strongly Agree). A total of 300 questionnaires were sent via email, and 185 feedbacks were received, yielding a response rate of 61%. In addition, the sample size greater than 30 is reliable for further statistical analysis based on central limit theorem [108,109]. Figure 2 elaborates the breakdown of 185 returned questionnaires consisting of positions, working experience, education, and company type.

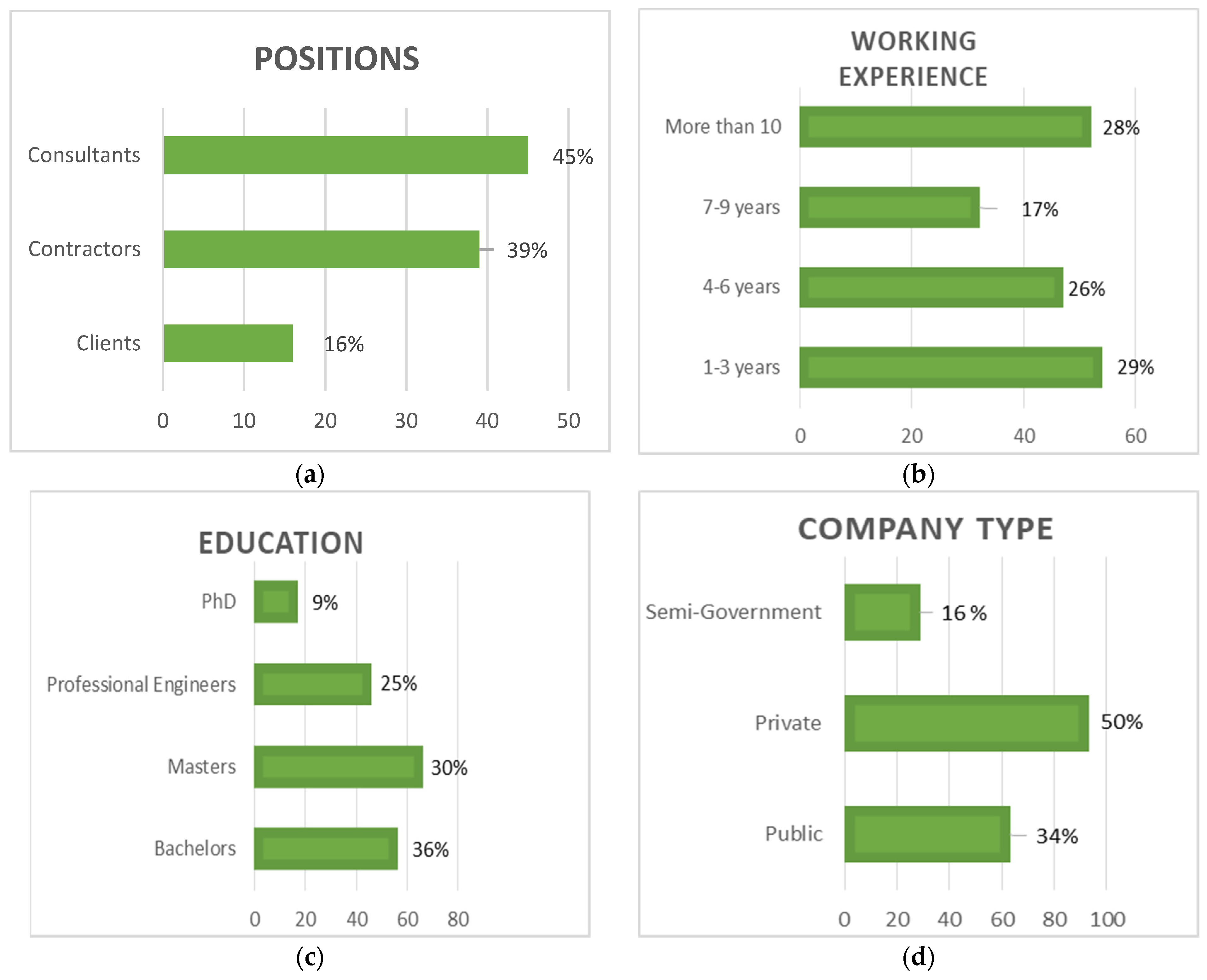

Figure 2 depicts the positions of respondents, which include consultants, contractors, and clients. Consultants accounted for 45% of the total, contractors accounted for 39%, and clients accounted for 16%. Furthermore, 28% had more than ten years of work experience. Similarly, 36% of respondents were Bachelor’s degree holders, 30% of respondents were Master’s degree holders, 25% of respondents were professional engineers, and 9% of respondents were PhD holders. Furthermore, 16% of respondents worked for a semi-government organization, 50% of respondents worked for a private organization and 34% of respondents worked for a public organization.

4.1.3. Interview Session

In this section, interview questions design and responses were examined. The method of interviewing was used to gather data using a qualitative approach.
Due to the covid-19 pandemic, the online interviews were conducted using ZOOM software. Prior to conducting an online interview with ZOOM software, a semi-structured interview was created to ensure that all information related to barriers in construction projects could be obtained. In addition, previous studies have shown that the sample size greater than fifteen is effective and accurate for qualitative analysis [110]. The sample size of twenty for this qualitative analysis was therefore deemed to be appropriate. Twenty BIM experts with experience working in academia, industry, and construction projects were selected as participants in this qualitative analysis. Before the interview started, participants received a short introduction to the study and were informed of the anonymity and confidentiality of the information collected. Before the interviews started, demographic information such as gender, educational qualifications, and job experience was collected from interviewees. Interviewees were interviewed on the basis of the intended interview questions and after each answer, additional follow-up questions were asked as needed. The criteria for selection of participants depends upon: (a) possess working experience more than five years, (b) having excellent educational qualifications, (c) possess strong knowledge of BIM in construction projects. The demographic detail of participants is shown in Table 2.
It was seen that 100% of the participants were male, while none were female. Similarly, 15% of the participants were Bachelor’s degree holders, while 25%, 30%, and 30% of the participants were Master’s degree holders, PhD holders, and professional engineers, respectively. In addition, 35% of the participants had career experience of more than 10 years. The demographic analysis indicates that they had broad working experience, qualifications, and skills. Thus, they were considered as suitable interviewees for this research study.

4.2. Data Analysis

The third stage of study was data analysis. For this purpose, two types of data analysis were elaborated: (a) qualitative analysis via questionnaire survey and (b) qualitative analysis via interview.

4.2.1. Quantitative Analysis

Cronbach’s alpha coefficient is used to calculate the internal consistency of the different variables in order to determine the strength of the five-point scales. The value for Cronbach’s alpha coefficient in this study is 0.876, which is greater than the threshold of 0.7, which suggests that the data are reliable for further statistical analysis [111]. Furthermore, the mean value technique is used to determine the relative importance of individual barriers. The mean values of individual barriers are computed, ranked, and compared between the three groups (contractors, consultants, clients). Mean value analysis is a technique used to effectively identify key factors among various factors [112]. In addition, Kendall’s coefficient of concordance (Kendall’s W) is also calculated to measure the agreement of responses in particular groups [113]. The range of the value of Kendall’s coefficient of concordance (W) is from 0 to 1. The higher value of W indicates the high level of consensus among the respondents within the group [114,115]. In addition, chi-square analysis should be carried out, if the number of items is greater than seven [116]. In addition, the Spearman’s rank correlation coefficient was introduced to calculate the strength of a relationship between two groups [117]. The range of the Spearman’s rank correlation coefficient (rs) is from −1 to +1. The higher the positive/negative value of rs, the stronger positive/negative linear correlation [90].

4.2.2. Qualitative Analysis

For analysis of the qualitative study, NVivo 11 was used as one of the available software packages [118]. Using software packages such as NVivo improves the degree of deeper understanding and makes qualitative data analysis quicker and more flexible [119]. In qualitative analysis, coding is considered to be an integrated part of the analysis. The theme of the interview is further summarized through coding for a better analysis of the idea put forward by the participants. The ideas of the interviewees were further listed in 200 codes for qualitative analysis. For instance, the “government must establish a BIM cell unit and allocate a defined budget for BIM implementation.” This theme and concept were broken down into “government policies”. The details of the coding theme are shown in Table 3.
It was shown that interviewees emphasized the enhancement of BIM integrated with academic curricula to overcome the lack of BIM research and implementation. Likewise, a positive attitude and learning environment together with the creation of BIM guidelines are essential for grooming BIM implementation. Furthermore, interviewees suggested that the professional bodies should conduct BIM workshops, courses, and seminars to convey the benefits of using BIM in construction projects. Stakeholders should take part in workshops, seminars, and courses to grow the concept of incorporating BIM in their construction projects. Moreover, interviewees facilitated the development of know-how of BIM implementation, the dissemination of BIM information, and the development of awareness and understanding. Interviewees indicated that the government should assign the budget to BIM and set up a separate BIM-based allocation cell to track the proper use of the allocation budget. However, cooperation with other universities and countries is necessary in order to address the lack of study in the implementation of BIM and in organizations.

5. Results and Discussion

The follow-up section explores in detail the results of SPSS statistical package, which consists of mean value analysis, Kendall’s coefficient of concordance (Kendall’s W), chi-square test, and Spearman’s rank correlation coefficient, and are summarized in the form of ranking.

5.1. Ranking of BIM Implementation Barriers

The ranking of BIM implementation barriers is categorized into four parts with the data analysis results using mean value: (a) overall ranking of BIM implementation barriers, (b) ranking according to contractors’ perspectives, (c) ranking according to consultants’ perspectives, and (d) ranking according to clients’ perspectives. Table 4 illustrates the detailed picture of mean value analysis.
Table 4 indicates that “unavailability of standards and guidelines” had the highest mean value of M = 4.89, while “competing initiatives” had the lowest mean value of M = 1.92. Likewise, the top five barriers were “unavailability of standards and guidelines”, with M = 4.89, “lack of BIM training”, with M = 4.78, “lack of expertise” with M = 4.52, “high cost”, with M = 4.45, and “lack of research and BIM implementation”, with M = 4.03.

5.2. Kendall’s Coefficient of Concordance (Kendall’s W)

The value of Kendall’s coefficient of concordance (Kendall’s W) of overall respondents, contractors’ perspectives, consultants’ perspectives, and clients’ perspectives were 0.183, 0.175, 0.169, and 0.145, respectively. The null hypothesis was rejected because all significance levels were 0.000, which was less than the threshold level of 5%. As a consequence, a substantial level was found among the respondents.

5.3. Chi-Square Test

The chi-square test was conducted as there were 20 factors in the analysis. The chi-square test should be performed if there are more than seven factors in the study, i.e., the chi-square test values for contactors’ perspectives, consultants’ perspectives, and clients’ perspectives were 68,432, 92,569, and 123,324, respectively. According to the analytical findings, the groups of respondents had significant levels dependent on each other in each group.

5.4. Spearman’s Rank Correlation Coefficient

Spearman’s rank correlation coefficient (rs) is calculated by the following equation:
r s = 1 [ 6 n = 1 5 ( d 2 ) n ( n 2 1 ) ]
where rs = Spearman’s rank correlation coefficient; d = the difference between ranks assigned to items; n = the number of respondents.
Using Spearman’s rank correlation coefficient, the relationship between the perspective of clients, consultants, and contractors with the implementation barriers was shown. Spearman’s rank correlation coefficients between all parties were established. The coefficient value between the consultant and contractor was 0.932. The correlation between the client and consultant was 0.892, whereas that between the client and contractor was 0.821. In addition, there was also a significant relationship among the three parties, namely 0.000, 0.000, and 0.005, respectively, which was smaller than the permissible amount of significance (5%). In other words, it can be said that there was a strong correlation between consultant and contractor, client and consultant, and client and contractor.

5.5. Results of Factor Analysis

Factor analysis was carried out to further explore the barriers of BIM implementation in this study. The KMO value of this study was 0.512, which is acceptable as it satisfies the threshold of 0.50. Values below 0.50 should lead the researcher “to either collect more data or rethink which variables to include” [120]. These results are illustrated in Table 5. The detailed picture of factor analysis of barriers to BIM implementation in sustainable building projects was composed of five groups. These groups were Group 1—Government-related barriers, Group 2—Market-related barriers, Group 3—Personal-related barriers, Group 4—Construction environment-related barriers, and Group 5—Cost–risk barriers.

6. Results Comparison with Other Countries

The findings of the current study were contrasted with other countries like China, the United Kingdom, Nigeria, and Pakistan. In addition, Table 6 elaborates the comparison of BIM implementation barriers with other countries.
By contrasting Malaysia’s current study with China, “unavailability of standards and guidelines” was ranked first, while in Nigeria, “unavailability of standards and guidelines” was ranked fourth. However, “unavailability of standards and guidelines” could not gain the attention of researchers in the United Kingdom and in Pakistan and thus was marked as not identified. The “lack of BIM training” was not ranked in the top five in the United Kingdom, Nigeria, or Pakistan. However, “lack of BIM training” was labeled as not identified in China. Furthermore, “lack of expertise” was ranked third in the current study in Malaysia as well as in the United Kingdom. The “lack of expertise” in Nigeria was perceived to be the most crucial barrier. Moreover, “high cost” was ranked fourth in the current study in both Malaysia and China, while in Nigeria, “high cost” was ranked third. In addition, “lack of research and BIM implementation” was the least consideration barrier in the United Kingdom, Nigeria, and Pakistan.
These findings provide evidence that more attention needs to be paid to BIM research and implementation in Pakistan and that “lack of research and implementation of BIM” is a crucial barrier that is largely unidentified by researchers. It is also understandable that variations in ranks are due to different cultures and environmental factors in different countries. From this analysis, the conclusion can be drawn that barriers are similar among different countries but rank distinctively.

7. BIM-Based Research Framework

In this section, strategies to mitigate the BIM implementation barriers, namely “unavailability of standards and guidelines”, “lack of BIM training”, “lack of expertise”, “high cost”, and “lack of research and BIM implementation” were developed with the aid of the BIM-based research framework. This framework consists of two layers, namely the outer layer and the inner layer. The inner layer consists of barriers, while the outer layer, called the “mitigation layer”, consists of strategies to overcome barriers.
The strategy to address the “unavailability of standards and guidelines” focused on the proper development of the BIM guidance plan and a positive attitude towards the learning environment. In developing countries, there is a lack of sound guidelines for sustainable building projects, which leads to cost overruns, delays, and waste. There is a need to establish a BIM guidance plan that can encourage and enhance the efficiency of sustainable construction, such as that in developing countries. It is important for owners to draw up a BIM execution plan during the pre-operation process. In addition, the strategy to reduce the “lack of BIM training” barrier is to strengthen BIM courses (linking with academia), seminars, and workshops. It is the liability of the professional bodies to control and track the essential eyes of construction stakeholders and organizations. Training should begin by educating workers on the relevance and usefulness of technology. Employee information on BIM technological innovation can be measured by a written analysis, such as an exit survey. These conclusions are based on responses such as “I think that recruiting skilled workers can be the best option”, “I think that professional bodies should track construction organizations”, and “I think that BIM courses, seminars and workshops should be made compulsory for stakeholders”. In addition, the approach to reduce the “lack of expertise” barrier is to attract BIM experts and generate possible ideas for the appreciation of the use of BIM technology. Hiring BIM experts from developed countries will help to mitigate the barrier. In order to ensure that adequate technical support and expertise is available from the technology partner, construction companies can obtain all relevant information from the manufacturer before promising to incorporate and use the BIM technology. These conclusions are based on responses such as “I think the appropriate approach is to recruit BIM experts from developing countries”, “I think the know-how to use BIM needs to be disseminated”. Furthermore, a strategy to reduce the barrier of “high cost” is to assign a specific budget for a BIM implementation cell. The government should set up a BIM cell to increase the trust and enthusiasm of building stakeholders. It is the utmost duty of the BIM cell unit to adequately track and monitor the allocation budget and prepare the report by the end of each month. In order to enable construction stakeholders to use BIM technology, vendors should consider modifying their business models to reduce the initial costs of using these technologies. A subscription-based model or monthly payment plan over a fixed period may be a preferred model, as construction stakeholders may adjust periodic payments to match their usual billing cycle—shifting most upstream costs. However, daily payments should be reasonable. This is supported by responses such as “I think the government should allocate a budget for the implementation of BIM”, “I think the government should adjust its policies”, and “I think there should be a BIM cell unit”. Furthermore, BIM-related topics have been included in the curriculum of civil and architectural engineering. Collaboration between universities and the promotion of a research culture will improve the implementation of the BIM. It is the government’s duty to expand opportunities for students and faculty members through the development of scholarship programs, as indicated by responses such as “I think by cooperation”, “I think fostering understanding of BIM technology”, and “I think student exchange programs between universities in developing countries”. In addition, a detailed picture of the BIM-based research framework is elaborated in Figure 3.

8. Conclusions, Limitation, and Future Directions

BIM has the ability to enhance and ease construction, but there are various barriers that hinder the effectiveness of sustainable building projects. These barriers need to be tackled in order to boost successful and efficient construction. In addition, a comprehensive literature review was undertaken to illustrate the barriers in order to achieve the objectives of this study. Twenty barriers were established with a thorough analysis and proceeded to the questionnaire survey. In this study, the triangulation method consisting of quantitative analysis and qualitative analysis was adopted. In quantitative analysis, the top most barriers were “unavailability of standards and guidelines”, with M = 4.89, “lack of BIM training”, with M = 4.78, “lack of expertise”, with M = 4.52, “high cost”, with M = 4.45, and “lack of research and BIM implementation”, with M = 4.03, whereas, “competing initiatives” had the lowest mean value of M = 1.92. In qualitative analysis, strategies to mitigate barriers were explored with the help of interviews of BIM experts in academia and in sustainable building projects. It was revealed that BIM workshops, courses, and seminars could enhance and promote the culture of BIM implementation. In addition, collaboration and budget allocation could increase the incentive and trust level of research to address the lack of research and implementation of BIM.
The theoretical contribution of this study is not only to fill the research gap but also to provide a valuable reference for helping stakeholders to mitigate the barriers. As far as the authors’ knowledge, the novelty of this study is that there is no comprehensive study conducted in Malaysia to explore strategies in mitigating BIM implementation barriers for sustainable building projects. For practical implications, this study suggests that the BIM-based research framework be executed with ongoing real projects to enable stakeholders to complete sustainable construction effectively. This study also recommends that researchers create slightly different frameworks on the basis of the same collection of quantitative and qualitative data. While the aim and objectives of this research were accomplished, this study still has some limitations that are worth noting. First, this study was conducted in Malaysia, and therefore the findings in this study might not be applicable in other countries because of cultural differences. Second, in the qualitative study, the sample size could be expanded in order to gain further insight into the reduction of BIM implementation barriers. Finally, these limitations offer a route for potential researchers to verify this research study through case studies of successful construction projects.

Author Contributions

B.M.: Conceptualization, investigation, data curation, writing—original draft. I.O.; supervision, writing—review and editing. S.S.S.G., H.A. and S.B.A.; resources, review and editing. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

Data sharing not applicable.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Mok, K.Y.; Shen, G.Q.; Yang, J. Stakeholder management studies in mega construction projects: A review and future directions. Int. J. Proj. Manag. 2015, 33, 446–457. [Google Scholar] [CrossRef]
  2. Chia, F.C.; Skitmore, M.; Runeson, G.; Bridge, A. Economic development and construction productivity in Malaysia. Constr. Manag. Econ. 2014, 32, 874–887. [Google Scholar] [CrossRef] [Green Version]
  3. Rahman, I.A.; Memon, A.H.; Nagapan, S.; Latif, Q.B.A.I.; Azis, A.A.A. Time and cost performance of construction projects in southern and central regions of Peninsular Malaysia. In 2012 IEEE Colloquium on Humanities, Science and Engineering (CHUSER); IEEE: Peninsular, Malaysia, 2012; pp. 52–57. [Google Scholar]
  4. Memon, A.H.; Rahman, I.A.; Memon, I.; Azman, N.I.A. BIM in Malaysian construction industry: Status, advantages, barriers and strategies to enhance the implementation level. Res. J. Appl. Sci. Eng. Technol. 2014, 8, 606–614. [Google Scholar] [CrossRef]
  5. Cheng, J.C.P.; Won, J.; Das, M. Construction and demolition waste management using BIM technology. In Proceedings of the 23rd Annual Conference of the International Group for Lean Construction, Perth, Australia, 29–31 July 2015; pp. 381–390. [Google Scholar]
  6. Hwang, B.-G.; Zhao, X.; Yang, K.W. Effect of BIM on rework in construction projects in Singapore: Status quo, magnitude, impact, and strategies. J. Constr. Eng. Manag. 2019, 145, 4018125. [Google Scholar] [CrossRef]
  7. Ham, N.; Moon, S.; Kim, J.-H.; Kim, J.-J. Economic analysis of design errors in BIM-based high-rise construction projects: Case study of Haeundae L project. J. Constr. Eng. Manag. 2018, 144, 5018006. [Google Scholar] [CrossRef]
  8. Oraee, M.; Hosseini, M.R.; Edwards, D.J.; Li, H.; Papadonikolaki, E.; Cao, D. Collaboration barriers in BIM-based construction networks: A conceptual model. Int. J. Proj. Manag. 2019, 37, 839–854. [Google Scholar] [CrossRef]
  9. Oraee, M.; Hosseini, M.R.; Papadonikolaki, E.; Palliyaguru, R.; Arashpour, M. Collaboration in BIM-based construction networks: A bibliometric-qualitative literature review. Int. J. Proj. Manag. 2017, 35, 1288–1301. [Google Scholar] [CrossRef]
  10. Doumbouya, L.; Gao, G.; Guan, C. Adoption of the Building Information Modeling (BIM) for construction project effectiveness: The review of BIM benefits. Am. J. Civ. Eng. Archit. 2016, 4, 74–79. [Google Scholar]
  11. Latiffi, A.A.; Mohd, S.; Kasim, N.; Fathi, M.S. Building Information Modeling (BIM) Application in Malaysian Construction Industry. Int. J. Constr. Eng. Manag. 2013, 2, 1–6. [Google Scholar] [CrossRef]
  12. Latiffi, A.A.; Brahim, J.; Fathi, M.S. Transformation of Malaysian construction industry with building information modelling (BIM). In MATEC Web of Conferences; EDP Sciences: Kuala Lumpur, Malaysia, 2016; p. 22. [Google Scholar]
  13. Lee, G.; Sacks, R.; Eastman, C.M. Specifying parametric building object behavior (BOB) for a building information modeling system. Autom. Constr. 2006, 15, 758–776. [Google Scholar] [CrossRef]
  14. Qureshi, A.H.; Alaloul, W.S.; Manzoor, B.; Musarat, M.A.; Saad, S.; Ammad, S. Implications of Machine Learning Integrated Technologies for Construction Progress Detection Under Industry 4.0 (IR 4.0). In Proceedings of the 2020 Second International Sustainability and Resilience Conference: Technology and Innovation in Building Designs, Sakheer, Bahrain, 11–12 November 2020. [Google Scholar]
  15. Ortiz, O.; Castells, F.; Sonnemann, G. Sustainability in the construction industry: A review of recent developments based on LCA. Constr. Build. Mater. 2009, 23, 28–39. [Google Scholar] [CrossRef]
  16. Lützkendorf, T.; Lorenz, D. Sustainable property investment: Valuing sustainable buildings through property performance assessment. Build. Res. Inf. 2005, 33, 212–234. [Google Scholar] [CrossRef]
  17. Hong, J.; Shen, G.Q.; Li, Z.; Zhang, B.; Zhang, W. Barriers to promoting prefabricated construction in China: A cost–Benefit analysis. J. Clean. Prod. 2018, 172, 649–660. [Google Scholar] [CrossRef]
  18. Zahrizan, Z.; Ali, N.M.; Haron, A.T.; Marshall-Ponting, A.; Abd, Z. Exploring the adoption of Building Information Modelling (BIM) in the Malaysian construction industry: A qualitative approach. Int. J. Res. Eng. Technol. 2013, 2, 384–395. [Google Scholar]
  19. Hamid, A.B.A.; Taib, M.Z.M.; Razak, A.H.N.A.; Embi, M.R. Building information modelling: Challenges and barriers in implement of BIM for interior design industry in Malaysia. In IOP Conference Series: Earth and Environmental Science; IOP Publishing: Langkawi Malaysia, 2018; p. 12002. [Google Scholar]
  20. Wong, J.H.; Rashidi, A.; Arashpour, M. Evaluating the Impact of Building Information Modeling on the Labor Productivity of Construction Projects in Malaysia. Buildings 2020, 10, 66. [Google Scholar] [CrossRef] [Green Version]
  21. van Nederveen, S.; Beheshti, R.; Gielingh, W. Modelling concepts for BIM. In Handbook of Research on Building Information Modeling and Construction Informatics: Concepts and Technologies; IGI Global: Delft, The Netherlands, 2010. [Google Scholar] [CrossRef]
  22. Latiffi, A.A.; Brahim, J.; Fathi, M.S. The development of building information modeling (BIM) definition. In Applied Mechanics and Materials; Trans Tech Publications Ltd.: Nilai, Malaysia, 2014; pp. 625–630. [Google Scholar]
  23. Heermann, D.W. Computer-simulation methods. In Computer Simulation Methods in Theoretical Physics; Springer: Berlin/Heidelberg, Germany, 1990; pp. 8–12. [Google Scholar] [CrossRef] [Green Version]
  24. Weisberg, D.E. The engineering design revolution: The people, companies and computer systems that changed forever the practice of engineering. Cyon Res. Corp. 2008, 12, 1–26. [Google Scholar]
  25. Becerik-Gerber, B.; Jazizadeh, F.; Li, N.; Calis, G. Application areas and data requirements for BIM-enabled facilities management. J. Constr. Eng. Manag. 2012, 138, 431–442. [Google Scholar] [CrossRef]
  26. EGarcia, G.; Zhu, Z. Interoperability from building design to building energy modeling. J. Build. Eng. 2015, 1, 33–41. [Google Scholar]
  27. Hannus, M. FIATECH Capital Projects Technology Roadmap, ECTP FA PICT. 2007. Available online: http//www.fiatech.org/Tech-Roadmap (accessed on 25 May 2012).
  28. Succar, B. Building information modelling framework: A research and delivery foundation for industry stakeholders. Autom. Constr. 2009, 18, 357–375. [Google Scholar] [CrossRef]
  29. Chan, C.T.W. Barriers of implementing BIM in construction industry from the designers’ perspective: A Hong Kong experience. J. Syst. Manag. Sci. 2014, 4, 24–40. [Google Scholar]
  30. Liu, S.; Xie, B.; Tivendal, L.; Liu, C. Critical barriers to BIM implementation in the AEC industry. Int. J. Mark. Stud. 2015, 7, 162. [Google Scholar] [CrossRef]
  31. Chan, D.W.M.; Olawumi, T.O.; Ho, A.M.L. Perceived benefits of and barriers to Building Information Modelling (BIM) implementation in construction: The case of Hong Kong. J. Build. Eng. 2019, 25, 100764. [Google Scholar] [CrossRef]
  32. Olawumi, T.O.; Chan, D.W.M. Identifying and prioritizing the benefits of integrating BIM and sustainability practices in construction projects: A Delphi survey of international experts. Sustain. Cities Soc. 2018, 40, 16–27. [Google Scholar] [CrossRef]
  33. Sepasgozar, S.M.E.; Hui, F.K.P.; Shirowzhan, S.; Foroozanfar, M.; Yang, L.; Aye, L. Lean Practices Using Building Information Modeling (BIM) and Digital Twinning for Sustainable Construction. Sustainability 2021, 13, 161. [Google Scholar] [CrossRef]
  34. Olawumi, T.O.; Chan, D.W.M.; Wong, J.K.W. Evolution in the intellectual structure of BIM research: A bibliometric analysis. J. Civ. Eng. Manag. 2017, 23, 1060–1081. [Google Scholar] [CrossRef]
  35. Wong, J.K.W.; Zhou, J. Enhancing environmental sustainability over building life cycles through green BIM: A review. Autom. Constr. 2015, 57, 156–165. [Google Scholar] [CrossRef]
  36. von Both, P. Potentials and barriers for implementing BIM in the German AEC market: Results of a current market analysis. In Proceedings of the 30th eCAADe Conference, Prague, Czech Republic, 12–14 September 2012; pp. 151–158. [Google Scholar]
  37. Aibinu, A.; Venkatesh, S. Status of BIM adoption and the BIM experience of cost consultants in Australia. J. Prof. Issues Eng. Educ. Pract. 2014, 140, 4013021. [Google Scholar] [CrossRef]
  38. Arayici, Y.; Khosrowshahi, F.; Ponting, A.M.; Mihindu, S.A. Towards implementation of building information modelling in the construction industry. In Proceedings of the Fifth International Conference on Construction in the 21st Century: Collaboration and Integration in Engineering, Management and Technology, Istanbul, Turkey, 20–22 May 2009; pp. 1342–1351. [Google Scholar]
  39. Porwal, A.; Hewage, K.N. Building Information Modeling (BIM) partnering framework for public construction projects. Autom. Constr. 2013, 31, 204–214. [Google Scholar] [CrossRef]
  40. Cao, Y.; Zhang, L.H.; McCabe, B.; Shahi, A. The Benefits of and Barriers to BIM Adoption in Canada. In Proceedings of the 36th International Association for Automation and Robotics in Construction (ISARC), Banff, AB, Canada, 21–24 May 2019; pp. 152–158. [Google Scholar]
  41. Ku, K.; Taiebat, M. BIM experiences and expectations: The constructors’ perspective. Int. J. Constr. Educ. Res. 2011, 7, 175–197. [Google Scholar] [CrossRef]
  42. Jensen, P.A.; Jóhannesson, E.I. Building information modelling in Denmark and Iceland. Eng. Constr. Archit. Manag. 2013, 20, 99–110. [Google Scholar] [CrossRef]
  43. Davies, R.; Crespin-Mazet, F.; Linne, A.; Pardo, C.; Havenvid, M.I.; Harty, C.; Ivory, C.; Salle, R. BIM in Europe: Innovation Networks in the Construction Sectors of Sweden France and the UK. In Proceedings of the 31st Annual ARCOM Conference, Lincoln, UK, 7–9 September 2015; pp. 1135–1144. [Google Scholar]
  44. Tan, T.; Chen, K.; Xue, F.; Lu, W. Barriers to Building Information Modeling (BIM) implementation in China’s prefabricated construction: An interpretive structural modeling (ISM) approach. J. Clean. Prod. 2019, 219, 949–959. [Google Scholar] [CrossRef]
  45. Obi, L.; Awuzie, B.; Obi, C.; Omotayo, T.S.; Oke, A.; Osobajo, O. BIM for Deconstruction: An Interpretive Structural Model of Factors Influencing Implementation. Buildings 2021, 11, 227. [Google Scholar] [CrossRef]
  46. Al-Yami, A.; Sanni-Anibire, M.O. BIM in the Saudi Arabian construction industry: State of the art, benefit and barriers. Int. J. Build. Pathol. Adapt. 2019, 39, 33–47. [Google Scholar] [CrossRef]
  47. Zhou, Y.; Yang, Y.; Yang, J.-B. Barriers to BIM implementation strategies in China. Eng. Constr. Archit. Manag. 2019, 26, 554–574. [Google Scholar] [CrossRef]
  48. Yan, H.; Demian, P. Benefits and Barriers of Building Information Modelling. In Proceedings of the 12th International Conference on Computing in Civil Building Engineering (ICCCBE XII), Beijing, China, 16–18 Octoner 2008. [Google Scholar]
  49. Volk, R.; Stengel, J.; Schultmann, F. Building Information Modeling (BIM) for existing buildings—Literature review and future needs. Autom. Constr. 2014, 38, 109–127. [Google Scholar] [CrossRef] [Green Version]
  50. Musa, S.; Marshall-Ponting, A.; Nifa, F.A.A.; Shahron, S.A. Building information modeling (BIM) in Malaysian construction industry: Benefits and future challenges. In AIP Conference Proceedings; AIP Publishing LLC: Melville, NY, USA, 2018; p. 20105. [Google Scholar] [CrossRef]
  51. Latiffi, A.A.; Mohd, S.; Brahim, J. Application of building information modeling (BIM) in the Malaysian construction industry: A story of the first government project. In Applied Mechanics and Materials; Trans Tech Publications Ltd.: Bäch, Switzerland, 2015; pp. 996–1001. [Google Scholar] [CrossRef] [Green Version]
  52. Hasni, M.I.A.K.; Ismail, Z.; Hashim, N.; Hassan, A.A. A Review of Building Information Modelling (BIM) Documents in the Malaysian Construction Industry: Public Works Department (PWD) and Construction Industry Development Board (CIDB). Adv. Sci. Lett. 2018, 24, 8913–8916. [Google Scholar] [CrossRef]
  53. CIDB Malaysia. Construction Industry Transformation Programme 2016–2020; CIDB: Kuala Lumpur, Malaysia, 2015. [Google Scholar]
  54. Wong, A.K.D.; Wong, F.K.W.; Nadeem, A. Attributes of building information modelling and its development in Hong Kong. HKIE Trans. 2009, 16, 38–45. [Google Scholar] [CrossRef]
  55. Hong, Y.; Hammad, A.; Zhong, X.; Wang, B.; Akbarnezhad, A. Comparative modeling approach to capture the differences in BIM adoption decision-making process in Australia and China. J. Constr. Eng. Manag. 2020, 146, 4019099. [Google Scholar] [CrossRef]
  56. Won, J.; Lee, G. Identifying the consideration factors for successful BIM projects. In Proceedings of the 17th International Workshop on Intelligent Computing in Engineering (EG-ICE 2010), Nottingham, UK, 12–13 July 2019. [Google Scholar]
  57. Czmoch, I.; Pękala, A. Traditional design versus BIM based design. Procedia Eng. 2014, 91, 210–215. [Google Scholar] [CrossRef]
  58. Ma, X.; Darko, A.; Chan, A.P.C.; Wang, R.; Zhang, B. An empirical analysis of barriers to building information modelling (BIM) implementation in construction projects: evidence from the Chinese context. Int. J. Constr. Manag. 2020. [Google Scholar] [CrossRef]
  59. Mehran, D. Exploring the Adoption of BIM in the UAE Construction Industry for AEC Firms. Procedia Eng. 2016, 145, 1110–1118. [Google Scholar] [CrossRef] [Green Version]
  60. Othman, I.; Al-Ashmori, Y.Y.; Rahmawati, Y.; Amran, Y.H.M.; Al-Bared, M.A.M. The level of Building Information Modelling (BIM) Implementation in Malaysia. Ain Shams Eng. J. 2020, 12, 455–463. [Google Scholar] [CrossRef]
  61. Altricher, H.; Feldman, A.; Posch, P.; Somekh, B. Teachers Investigate Their Work: An Introduction to Action Research across the Professions; Routledge: New York, NY, USA, 2005. [Google Scholar]
  62. Wong, S.Y.; Gray, J. Barriers to implementing Building Information Modelling (BIM) in the Malaysian construction industry. In IOP Conference Series: Materials Science and Engineering; IOP Publishing: Bristol, UK, 2019. [Google Scholar]
  63. Becerik-Gerber, B.; Kensek, K. Building information modeling in architecture, engineering, and construction: Emerging research directions and trends. J. Prof. Issues Eng. Educ. Pract. 2010, 136, 139–147. [Google Scholar] [CrossRef]
  64. Kassem, M.; Brogden, T.; Dawood, N. BIM and 4D planning: A holistic study of the barriers and drivers to widespread adoption. J. Constr. Eng. Proj. Manag. 2012, 2, 1–10. [Google Scholar] [CrossRef] [Green Version]
  65. Olanrewaju, O.I.; Chileshe, N.; Babarinde, S.A.; Sandanayake, M. Investigating the barriers to building information modeling (BIM) implementation within the Nigerian construction industry. Eng. Constr. Archit. Manag. 2020, 27, 2931–2958. [Google Scholar] [CrossRef]
  66. Shafiq, M.T.; Afzal, M. Improving Construction Job Site Safety with Building Information Models: Opportunities and Barriers. In International Conference on Computing in Civil and Building Engineering; Springer: Cham, Switzerland, 2020; pp. 1014–1036. [Google Scholar]
  67. Zahrizan, Z.; Ali, N.M.; Haron, A.T.; Marshall-Ponting, A.J.; Hamid, Z.A. Exploring the barriers and driving factors in implementing building information modelling (BIM) in the Malaysian construction industry: A preliminary study. J. Inst. Eng. Malays. 2014, 75, 1–10. [Google Scholar]
  68. Harding, J.; Suresh, S.; Renukappa, S.; Mushatat, S. Do building information modelling applications benefit design teams in achieving BREEAM accreditation? J. Constr. Eng. 2014, 2014, 1–8. [Google Scholar] [CrossRef]
  69. Hope, A.; Alwan, Z. Building the future: Integrating building information management and environmental assessment methodologies. In Proceedings of the First UK Academic Conference on BIM, Newcastle, UK, 5–7 September 2012. [Google Scholar]
  70. Lee, S.-K.; Kim, K.-R.; Yu, J.-H. BIM and ontology-based approach for building cost estimation. Autom. Constr. 2014, 41, 96–105. [Google Scholar] [CrossRef]
  71. Rogers, J.; Chong, H.-Y.; Preece, C. Adoption of building information modelling technology (BIM). Eng. Constr. Archit. Manag. 2015, 22, 424–445. [Google Scholar] [CrossRef]
  72. Gerges, M.; Austin, S.; Mayouf, M.; Ahiakwo, O.; Jaeger, M.; Saad, A.; El Gohary, T. An investigation into the implementation of Building Information Modeling in the Middle East. J. Inf. Technol. Constr. 2017, 22, 1–15. [Google Scholar]
  73. Gu, N.; London, K. Understanding and facilitating BIM adoption in the AEC industry. Autom. Constr. 2010, 19, 988–999. [Google Scholar] [CrossRef]
  74. Babatunde, S.O.; Udeaja, C.; Adekunle, A.O. Barriers to BIM implementation and ways forward to improve its adoption in the Nigerian AEC firms. Int. J. Build. Pathol. Adapt. 2020, 39, 48–71. [Google Scholar] [CrossRef] [Green Version]
  75. Li, H.; Wang, Y.; Yan, H.; Deng, Y. Barriers of BIM application in China—Preliminary research. In ICCREM 2016 BIM Application and Off-Site Construction; American Society of Civil Engineers: Reston, VA, USA, 2017; pp. 37–41. [Google Scholar]
  76. Ding, Z.; Zuo, J.; Wu, J.; Wang, J.Y. Key factors for the BIM adoption by architects: A China study. Eng. Constr. Archit. Manag. 2015, 22, 732–748. [Google Scholar] [CrossRef]
  77. Jin, R.; Hancock, C.M.; Tang, L.; Wanatowski, D. BIM investment, returns, and risks in China’s AEC industries. J. Constr. Eng. Manag. 2017, 143, 4017089. [Google Scholar] [CrossRef]
  78. Matthews, J.; Love, P.E.D.; Mewburn, J.; Stobaus, C.; Ramanayaka, C. Building information modelling in construction: Insights from collaboration and change management perspectives. Prod. Plan. Control 2018, 29, 202–216. [Google Scholar] [CrossRef]
  79. Bradley, A.; Li, H.; Lark, R.; Dunn, S. BIM for infrastructure: An overall review and constructor perspective. Autom. Constr. 2016, 71, 139–152. [Google Scholar] [CrossRef]
  80. Bui, N.; Merschbrock, C.; Munkvold, B.E. A review of Building Information Modelling for construction in developing countries. Procedia Eng. 2016, 164, 487–494. [Google Scholar] [CrossRef]
  81. Arayici, Y.; Coates, P.; Koskela, L.; Kagioglou, M.; Usher, C.; O’Reilly, K. Technology adoption in the BIM implementation for lean architectural practice. Autom. Constr. 2011, 20, 189–195. [Google Scholar] [CrossRef]
  82. Azhar, S.; Khalfan, M.; Maqsood, T. Building information modelling (BIM): Now and beyond. Constr. Econ. Build. 2012, 12, 15–28. [Google Scholar] [CrossRef] [Green Version]
  83. Matarneh, R.; Hamed, S. Barriers to the adoption of building information modeling in the Jordanian building industry. Open J. Civ. Eng. 2017, 7, 325–335. [Google Scholar] [CrossRef] [Green Version]
  84. Abubakar, M.; Ibrahim, Y.M.; Kado, D.; Bala, K. Contractors’ perception of the factors affecting Building Information Modelling (BIM) adoption in the Nigerian Construction Industry. In Proceedings of the Computing in Civil and Building Engineering, Orlando, FL, USA, 23–25 June 2014; pp. 167–178. [Google Scholar]
  85. Akerele, A.O.; Etiene, M. Assessment of the level of awareness and limitations on the use of building information modeling in Lagos State. Int. J. Sci. Res. Publ. 2016, 6, 229–233. [Google Scholar]
  86. SBabatunde, O.; Perera, S.; Ekundayo, D.; Adeleke, D.S. An investigation into BIM uptake among contracting firms: An empirical study in Nigeria. J. Financ. Manag. Prop. Constr. 2020, 26, 23–48. [Google Scholar] [CrossRef]
  87. Bernstein, P.G.; Pittman, J.H. Barriers to the adoption of building information modeling in the building industry. Autodesk Build. Solut. 2004, 32, 1–14. [Google Scholar]
  88. Gardezi, S.S.S.; Shafiq, N.; Nuruddin, M.F.; Farhan, S.A.; Umar, U.A. Challenges for implementation of building information modeling (BIM) in Malaysian construction industry. In Applied Mechanics and Materials; Trans Tech Publications Ltd.: Nilai, Malaysia, 2014; pp. 559–564. [Google Scholar]
  89. Thompson, D.B.; Miner, R.G. Building Information Modeling-BIM: Contractual Risks Are Changing with Technology. 2006. Available online: http//www.aepronet.org/ge/no35.html (accessed on 20 April 2020).
  90. Olawumi, T.O.; Chan, D.W.M.; Wong, J.K.W.; Chan, A.P.C. Barriers to the integration of BIM and sustainability practices in construction projects: A Delphi survey of international experts. J. Build. Eng. 2018, 20, 60–71. [Google Scholar] [CrossRef]
  91. Ahmed, S. Barriers to implementation of building information modeling (BIM) to the construction industry: A review. J. Civ. Eng. Constr. 2018, 7, 107–113. [Google Scholar] [CrossRef] [Green Version]
  92. Ahn, K.-U.; Kim, Y.-J.; Park, C.-S.; Kim, I.; Lee, K. BIM interface for full vs. semi-automated building energy simulation. Energy Build. 2014, 68, 671–678. [Google Scholar] [CrossRef]
  93. Sardroud, J.M.; Mehdizadehtavasani, M.; Khorramabadi, A.; Ranjbardar, A. Barriers Analysis to Effective Implementation of BIM in the Construction Industry. In ISARC, Proceedings of the International Symposium on Automation and Robotics in Construction; IAARC Publications: Berlin, Germany, 2018; pp. 1–8. [Google Scholar]
  94. Hamada, H.M.; Haron, A.; Zakiria, Z.; Humada, A.M. Benefits and barriers of BIM adoption in the Iraqi construction firms. Int. J. Innov. Res. Adv. Eng. 2016, 3, 76–84. [Google Scholar]
  95. Singh, V.; Gu, N.; Wang, X. A theoretical framework of a BIM-based multi-disciplinary collaboration platform. Autom. Constr. 2011, 20, 134–144. [Google Scholar] [CrossRef]
  96. Liu, Y.; van Nederveen, S.; Hertogh, M. Understanding effects of BIM on collaborative design and construction: An empirical study in China. Int. J. Proj. Manag. 2017, 35, 686–698. [Google Scholar] [CrossRef]
  97. Edirisinghe, R.; London, K.A.; Kalutara, P.; Aranda-Mena, G. Building information modelling for facility management: Are we there yet? Eng. Constr. Archit. Manag. 2017, 24, 1119–1154. [Google Scholar] [CrossRef]
  98. Xu, Y.Q.; Kong, Y.Y. Analysis of the influence factors of application and promotion of BIM in China. J. Eng. Manag. 2016, 30, 28–32. [Google Scholar]
  99. Khosrowshahi, F.; Arayici, Y. Roadmap for implementation of BIM in the UK construction industry. Eng. Constr. Archit. Manag. 2012, 19, 610–635. [Google Scholar] [CrossRef] [Green Version]
  100. Chien, K.-F.; Wu, Z.-H.; Huang, S.-C. Identifying and assessing critical risk factors for BIM projects: Empirical study. Autom. Constr. 2014, 45, 1–15. [Google Scholar] [CrossRef]
  101. Xu, H.; Feng, J.; Li, S. Users-orientated evaluation of building information model in the Chinese construction industry. Autom. Constr. 2014, 39, 32–46. [Google Scholar] [CrossRef]
  102. Zhang, X.; Azhar, S.; Nadeem, A.; Khalfan, M. Using Building Information Modelling to achieve Lean principles by improving efficiency of work teams. Int. J. Constr. Manag. 2018, 18, 293–300. [Google Scholar] [CrossRef]
  103. Nawi, M.N.M.; Haron, A.T.; Hamid, Z.A.; Kamar, K.A.M.; Baharuddin, Y. Improving integrated practice through building information modeling-integrated project delivery (BIM-IPD) for Malaysian industrialised building system (IBS) Construction Projects. Malays. Constr. Res. J. 2014, 15, 1–15. [Google Scholar]
  104. Yaakob, M.; Wan, W.N.A.; Radzuan, K. Critical success factors to implementing building information modeling in Malaysia construction industry. Int. Rev. Manag. Mark. 2016, 6, 252–256. [Google Scholar]
  105. Aranda-Mena, G.; Crawford, J.; Chevez, A.; Froese, T. Building information modelling demystified: Does it make business sense to adopt BIM? Int. J. Manag. Proj. Bus. 2009, 2, 419–434. [Google Scholar] [CrossRef] [Green Version]
  106. Enshassi, A.; AbuHamra, L.; Mohamed, S. Barriers to implementation of building information modelling (BIM) in the palestinian construction industry. Int. J. Constr. Proj. Manag. 2016, 8, 103. [Google Scholar]
  107. Eadie, R.; Odeyinka, H.; Browne, M.; McKeown, C.; Yohanis, M. Building information modelling adoption: An analysis of the barriers to implementation. J. Eng. Archit. 2014, 2, 77–101. [Google Scholar]
  108. Ott, R.L.; Longnecker, M.T. An Introduction to Statistical Methods and Data Analysis; Cengage Learning: Boston, MA, USA, 2015. [Google Scholar]
  109. Ling, F.Y.Y.; Low, S.P.; Wang, S.Q.; Lim, H.H. Key project management practices affecting Singaporean firms’ project performance in China. Int. J. Proj. Manag. 2009, 27, 59–71. [Google Scholar] [CrossRef]
  110. Flick, U. The Sage Qualitative Research Kit: Collection; SAGE Publications Limited: London, UK, 2009. [Google Scholar]
  111. Pallant, J.; Manual, S.S. A step by step guide to data analysis using SPSS for windows. In SPSS Survival Manual; Open University Press: New York, NY, USA, 2007. [Google Scholar]
  112. Lam, P.T.I.; Chan, E.H.W.; Ann, T.W.; Cam, W.C.N.; Jack, S.Y. Applicability of clean development mechanism to the Hong Kong building sector. J. Clean. Prod. 2015, 109, 271–283. [Google Scholar] [CrossRef]
  113. Field, A.P. K endall’s Coefficient of Concordance. Wiley StatsRef Stat. Ref. Online 2014. [Google Scholar] [CrossRef] [Green Version]
  114. Chan, D.W.M.; Choi, T.N.Y. Difficulties in executing the Mandatory Building Inspection Scheme (MBIS) for existing private buildings in Hong Kong. Habitat Int. 2015, 48, 97–105. [Google Scholar] [CrossRef] [Green Version]
  115. Daniel, W.M.; Hung, H.T.W. An empirical survey of the perceived benefits of implementing the Mandatory Building Inspection Scheme (MBIS) in Hong Kong. Facilities 2015, 33, 337–366. [Google Scholar]
  116. Hartmann, A.; Love, P.E.D.; Hon, C.K.H.; Chan, A.P.C.; Chan, D.W.M. Strategies for improving safety performance of repair, maintenance, minor alteration and addition (RMAA) works. Facilities 2011, 29, 591–610. [Google Scholar]
  117. Chen, P.Y.; Smithson, M.; Popovich, P.M. Correlation: Parametric and Nonparametric Measures; SAGE: London, UK, 2002. [Google Scholar]
  118. Lewin, A.; Silver, C. Using Software in Qualitative Research; SAGE: London, UK, 2014. [Google Scholar]
  119. Bazeley, P.; Jackson, K. Qualitative Data Analysis with NVivo; SAGE Publications Limited: London, UK, 2013. [Google Scholar]
  120. Field, A. Discovering Statistics Using IBM SPSS Statistics; SAGE: London, UK, 2013. [Google Scholar]
  121. Farooq, U.; Rehman, S.K.U.; Javed, M.F.; Jameel, M.; Aslam, F.; Alyousef, R. Investigating BIM Implementation Barriers and Issues in Pakistan Using ISM Approach. Appl. Sci. 2020, 10, 7250. [Google Scholar] [CrossRef]
Figure 1. Research design flowchart.
Figure 1. Research design flowchart.
Applsci 11 05397 g001
Figure 2. Breakdown of 185 returned questionnaires by Positions, Working Experience, Education, and Company Type (ad).
Figure 2. Breakdown of 185 returned questionnaires by Positions, Working Experience, Education, and Company Type (ad).
Applsci 11 05397 g002
Figure 3. BIM-based research framework incorporating barriers and strategies for sustainable building projects.
Figure 3. BIM-based research framework incorporating barriers and strategies for sustainable building projects.
Applsci 11 05397 g003
Table 1. Building information modeling (BIM) implementation barriers.
Table 1. Building information modeling (BIM) implementation barriers.
BIM Implementation BarriersReferences
High cost [54,55,56,57]
Lack of expertise[58,62,63,64]
Inadequate government policies[47,65,66]
Lack of clients demand[62,67]
Poor collaboration among stakeholders[56,68,69]
Lack of vision of benefits[4,38,70]
Unavailability of standards and guidelines[18,58,71,72,73]
Lack of BIM training
Lack of promotion[44,74,75]
Lack of initiative and hesitance[76,77,78]
Incompatibility and interoperability problems[79,80,81]
Lack of industry standards[71,82,83]
Competing initiatives[84,85,86]
Lack of well-developed practical strategies[77,87,88]
Licensing issues[30,82,89,90,91]
Security issues[82,92,93,94]
Insufficient external motivation (insufficient customer and market demands)[95,96,97,98]
Misunderstanding of BIM[99,100,101,102]
Lack of research and BIM implementation[60,103,104]
Cultural barrier (resistance to change)[63,105,106,107]
Table 2. Participant demographics (n = 20).
Table 2. Participant demographics (n = 20).
ItemDescriptionNumber of ParticipantsPercentage (%)
GenderMale20100
Female--
Educational qualificationBachelors315
Masters525
PhD630
Professional Engineers630
Working experience5–7 years420
8–9 years945
More than 10 years735
Table 3. Coding theme and appropriate definition.
Table 3. Coding theme and appropriate definition.
Categories (n = 200)SubcategoriesDefinition
Development BIM guidelines (49)
  • Positive attitude
Favor in developing BIM guidelines.
  • Appropriate learning environment
Enhance BIM seminars/course/workshops (27)
  • Compulsion
Made compulsion to adopt BIM seminars.
  • Appreciation
  • Professional bodies
Hiring BIM experts (26)
  • Awareness
To develop the know-how of BIM implementation, hire BIM experts.
  • Understanding
Budget allocation (44)
  • Government policies
Government should enhance the budget allocation to BIM organizations and establish BIM cell.
BIM and academic curriculum (54)
  • Collaboration
To overcome the lack of research, adopt more collaboration and exchange idea with different countries.
Table 4. Ranking of BIM implementation barriers.
Table 4. Ranking of BIM implementation barriers.
BIM Implementation BarriersOverall
Respondents
Contractors’
Perspectives
Consultants’
Perspectives
Clients’
Perspectives
Mean ValueRankMean ValueRankMean ValueRankMean ValueRank
Unavailability of standards and guidelines4.8914.0243.8554.275
Lack of BIM training4.7823.8954.0044.603
Lack of expertise4.5234.6514.3214.712
High cost4.4544.5424.1034.076
Lack of research and BIM implementation4.0354.2133.4174.831
Cultural barrier (resistance to change)3.8963.6174.2224.424
Lack of promotion3.6273.6172.88103.4310
Incompatibility and interoperability problems3.4383.02112.88103.2311
Insufficient external motivation (insufficient customer and market demands)3.2293.4492.65123.2311
Lack of well-developed practical strategies3.09102.83133.0193.0113
Security issues2.98112.61143.7062.9814
Lack of clients demand2.82122.90111.95162.8715
Lack of vision of benefits2.67133.23103.2092.8715
Poor collaboration among stakeholders2.44143.7362.21153.887
Lack of initiative and hesitance2.32152.01172.42133.887
Misunderstanding of BIM2.27161.92182.42133.887
Inadequate government policies2.18171.88191.65191.9020
Licensing issues2.13181.88191.72172.0119
Lack of industry standards1.98192.32161.72172.4518
Competing initiatives1.92202.43151.54202.6117
Table 5. Results of factor analysis (FA) on barriers to BIM implementation in sustainable building projects.
Table 5. Results of factor analysis (FA) on barriers to BIM implementation in sustainable building projects.
Variables (Barriers)12345Grouping
Inadequate government policies0.987----Government-related barriers
Unavailability of standards and guidelines0.820----
Lack of industry standards0.712----
Lack of well-developed practical strategies0.620----
Licensing issues0.567----
Lack of expertise-0.834---Market-related barriers
Lack of clients demand-0.621---
Poor collaboration among stakeholders-0.601---
Lack of promotion-0.542---
Insufficient external motivation (insufficient customer and market demands)-0.521---
Lack of vision of benefits--0.821--Personal-related barriers
Lack of BIM training--0.743--
Misunderstanding of BIM--0.612--
Cultural barrier (resistance to change)--0.590--
Lack of initiative and hesitance---0.798-Construction Environment-related barriers
Incompatibility and interoperability problems---0.656-
Competing initiatives---0.532-
Lack of research and BIM implementation ---0.432-
High cost----0.712Cost-risk barriers
Security issues----0.677
Table 6. Comparison of BIM implementation barriers.
Table 6. Comparison of BIM implementation barriers.
Top Five
BIM Implementation Barriers
Malaysia
(Current Study)
China
[47]
United Kingdom
[107]
Nigeria
[74]
Pakistan
[121]
Unavailability of standards And guidelines(Rank 1)(Rank 1)Not Identified(Rank 4)Not Identified
Lack of BIM training(Rank 2)Not Identified(Rank 7)(Rank 15)(Rank 12)
Lack of expertise(Rank 3)(Rank 5)(Rank 3)(Rank 1)(Rank 7)
High cost(Rank 4)(Rank 4)(Rank 3)(Rank 11)(Rank 9)
Lack of research and BIM implementation(Rank 5)(Rank 7)Not IdentifiedNot IdentifiedNot Identified
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Manzoor, B.; Othman, I.; Gardezi, S.S.S.; Altan, H.; Abdalla, S.B. BIM-Based Research Framework for Sustainable Building Projects: A Strategy for Mitigating BIM Implementation Barriers. Appl. Sci. 2021, 11, 5397. https://doi.org/10.3390/app11125397

AMA Style

Manzoor B, Othman I, Gardezi SSS, Altan H, Abdalla SB. BIM-Based Research Framework for Sustainable Building Projects: A Strategy for Mitigating BIM Implementation Barriers. Applied Sciences. 2021; 11(12):5397. https://doi.org/10.3390/app11125397

Chicago/Turabian Style

Manzoor, Bilal, Idris Othman, Syed Shujaa Safdar Gardezi, Haşim Altan, and Salem Buhashima Abdalla. 2021. "BIM-Based Research Framework for Sustainable Building Projects: A Strategy for Mitigating BIM Implementation Barriers" Applied Sciences 11, no. 12: 5397. https://doi.org/10.3390/app11125397
