Delay Causes and Emerging Digital Tools: A Novel Model of Delay Analysis, Including Integrated Project Delivery and PMBOK
Abstract
:1. Introduction
2. Review Method

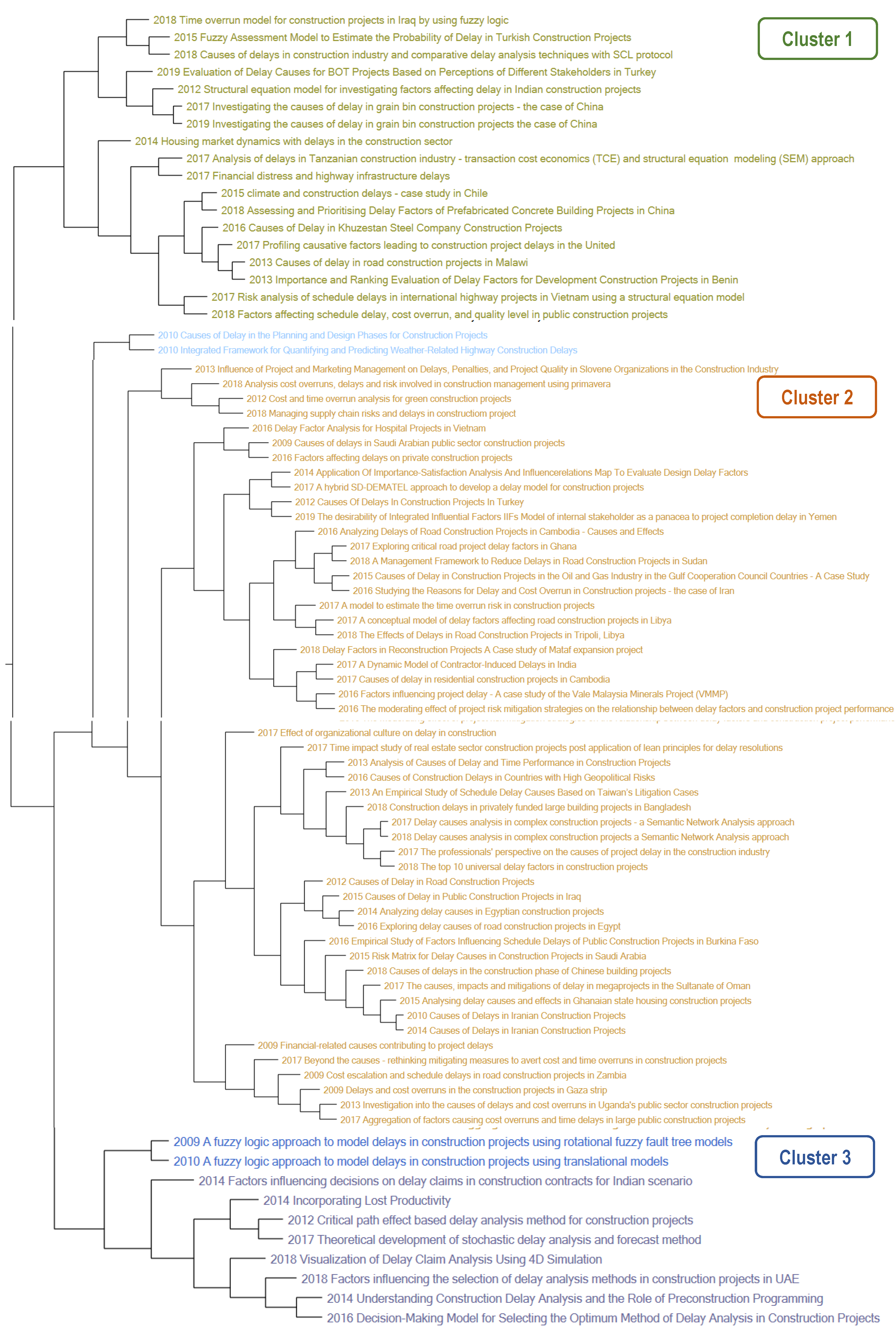

3. Bibliography Analysis
4. Content Analysis and Data Mining
5. Current Practices in Delay and Time Overrun Investigations
Key Factors Identified in the Delay Literature
6. Technology Applications for Time Control and Risk Management
- What data need to be assembled as inputs to record the delay events for the update, and what methods will be used to collect the data?
- How often should projects be updated?
- Are resources local or offsite?
- Which project teams are resources participating in?
- Who on each team will be gathering the information used for the project update, and with what frequency are the data updated within the schedule?
- Who needs to see the results of the update, and when do they need to see them?
- What types of information need to be generated after each update to communicate progress before the next update?
- Total float consuming status compared with the previous month schedule.
- Critical path schedule analysis.
- Based on the above analysis, if problem areas are found, these are identified and reported to the project manager. The project control manager implements suggested countermeasures in conjunction with the related managers and under the project managers’ instruction. Once the project manager approves the counter measures, they are incorporated in the schedule. Close monitoring is made to meet the corrective action plan. Until a decision on the countermeasures is made, the schedule is not changed.
- The updated schedule is issued to each project management office (PMO), project control department, or project manager as an updated project control for their work and for the next monthly update.
- When compared with the initial estimate, the updated information may indicate some variances in the scheduling basis. On the other hand, along with the project progress, schedule deviations may be detected from the initial scenario caused by various factors.

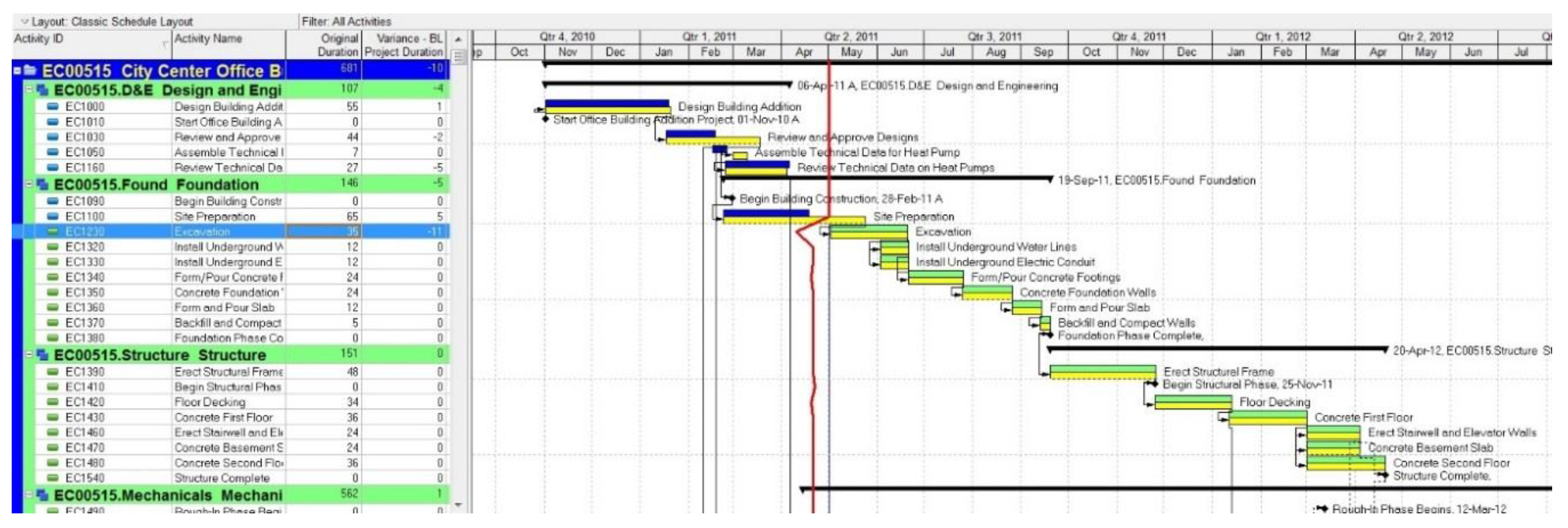

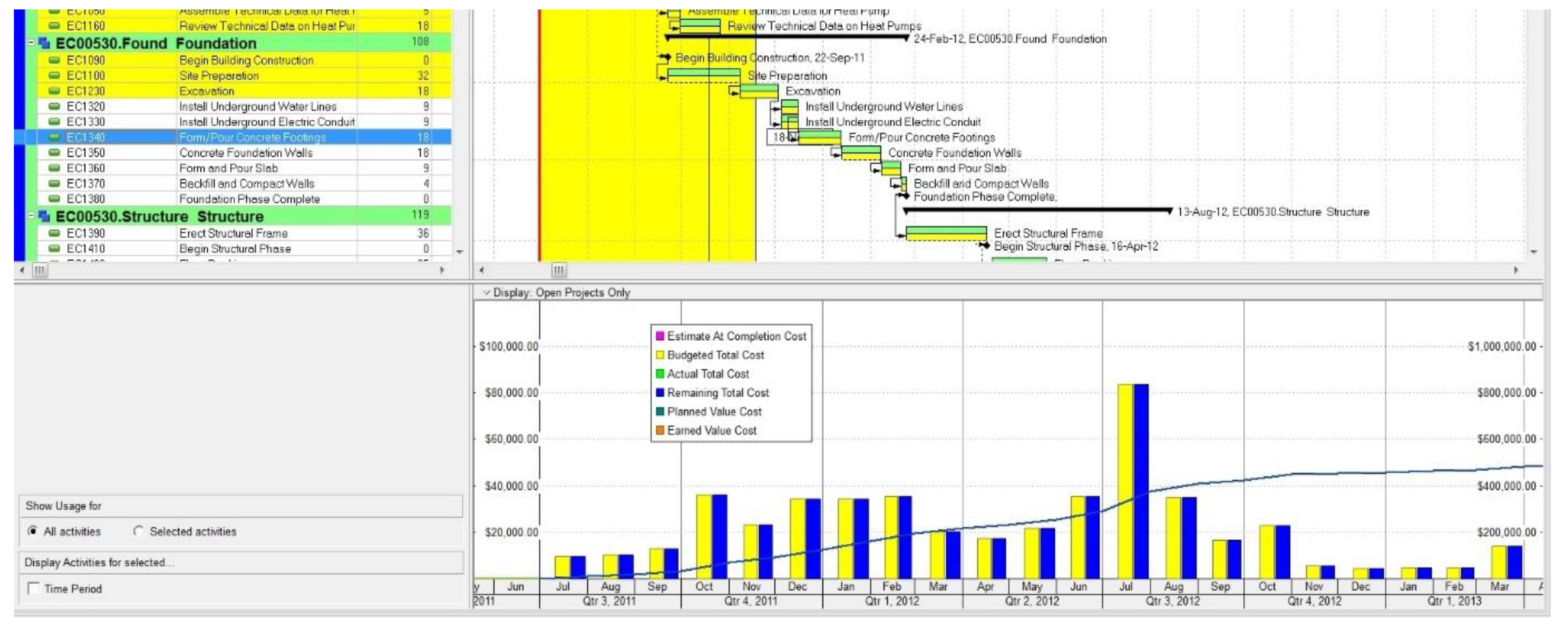

6.1. Progress Measurement Method in Scheduling Software
6.2. Primavera P6 and Delay Analysis
7. Project Schedule Delay Analysis from Project Management Methodology Perspectives
7.1. Project Management Body of Knowledge (PMBOK)
7.2. Practice Standard for Scheduling
7.3. Agile Practice Guide
8. Discussion and the DEC conceptual model
- Digital design communication tools: Digital Twin, Building Information Systems (BIM) including Revit, ArchiCAD, Navisworks, BIMx, BricsCAD, Archibus, Constructor, IntelliCAD, VisualARQ, Revizto; Geographic Information Systems (GIS) including QGIS, ArcGIS, and ArcMap [17]. The literature frequently reports that design mistakes, errors, changing orders and scopes, later approvals, and late technical decision makings were the main causes of delay in different contexts [95,99,104].
- Digital scheduling and planning tools: Microsoft Project, Oracle Primavera P6, FastTrack Schedule, ZOHO Projects, @risk, Workfront, eResource Scheduler, ConceptDraw Project, Resource Guru, Open Plan by Deltek, Smartsheet, and other software, packages, and platforms.
- Digital contract management tools: intelligent or smart contracts. The literature shows that many projects suffer from weak administration of contracts [96].
- Digital devices to increase the productivity of heavy equipment: real-time locating systems, Global Positioning System (GPS), and radar.
- Digital production technologies: 3D printers [148].
9. Conclusions and an Agenda for Future
Author Contributions
Funding
Conflicts of Interest
Appendix A
References
