Abstract
Public–private partnerships (PPPs) are contractual schemes that have relative success in Latin America due to their configuration, where the spirit of the contract lies in an appropriate distribution of risks. This is both the most important and fundamental aspect of this contractual scheme but also the most complex, as it is the main cause of contract modifications (addenda) in countries across the region. In this context, different concessionary contractual frameworks for PPPs on the national road network of Peru were evaluated, revealing common failure indicators that lead to contract modifications within the first six years of the concession. This study offers the development of a management model that includes the good practices of contractual management of NEC4 Option F and the application of BIM information management processes, optimizing the management of infrastructure through emerging technologies of information management supported by agile contractual schemes.
1. Introduction
Public–private partnerships (PPPs) in Latin America and the Caribbean have consistently evolved over the past 10 years as this mode of execution has become more common in countries across the region. This evolution has led these countries to develop regulations, institutions, and conditions that enable them to create successful partnerships between the public and private sectors [].
However, the infrastructure deficit in Peru is a chronic concern. Peru has one of the weakest infrastructures in Latin America [], particularly when compared to regional peers and countries in the Organisation for Economic Cooperation and Development (OECD). Consequently, Peru ranks 85th out of 137 countries in the infrastructure quality indicator of the Global Competitiveness Index []. This infrastructure deficit translates into a series of disadvantages that negatively impact the country’s competitiveness. These disadvantages include low efficiency in public services, high transportation costs, high energy costs, limited telecommunications service offerings, low levels of information access, limited accessibility to education, poor quality of life, and low security []. In response, the government has taken measures to address the infrastructure deficit, such as the enactment of the National Competitiveness and Productivity Policy in December 2018, aimed at implementing high-impact reforms []. This policy includes the creation of a National Infrastructure Plan to assess the quality, deficit, and existing infrastructure gap, as well as the establishment of the Multiyear Investment Programming Directorate within the Ministry of Economy and Finance (MEF) as part of its public investment strategy. In 2023, the MEF also published the National BIM Guide, aiming to standardize concepts related to the application of BIM information management processes in investment development [].
Despite these efforts, infrastructure management in Peru has been one of the main challenges for the country’s economy. In recent years, 90% of the projects analyzed by the Comptroller General of the Republic were paralyzed, and these projects typically followed a contractual scheme of direct administration or contracting []. In response to this situation, the government is seeking to implement an institutional reform [] that will allow the use of international standard contracts under the State Procurement Law. Additionally, the National Infrastructure Plan proposes large-scale projects under the PPP scheme, given the high risks associated with the previously mentioned schemes.
The analysis conducted in this study leads to the development of several sections that describe and justify the proposed management model. After examining the current situation and historical background, Section 2 of this document provides a comprehensive literature review aimed at identifying the synergy between international standard contracts and emerging construction management technologies and how these could enhance existing frameworks, particularly PPP contracts. In Section 3, a management model is proposed to optimize the contractual management of infrastructure, suggesting organizational parameters that can streamline the management process among the involved parties. This includes the use of NEC4 contracts and the guidelines of ISO 19650 [] for BIM implementation. Finally, Section 4 presents the validation of the proposed management model by experts through the Delphi methodology [], where specialists analyze and offer improvement proposals for the management model outlined in this research.
2. Literature Review
2.1. The Importance of Standardized Contracts
In a collaborative approach, contract management is extremely important. This means the proper administration of the rights and obligations assumed by the parties while keeping the overall project objectives in focus []. It is also important to remember that construction contracts involve a high degree of uncertainty; these are not just commercial agreements but rather the execution of a new element that does not yet exist at the time the parties sign the contract. Although a scope may be defined in this agreement, its realization is a new process that must be managed considering the inherent uncertainty and complexity [].
Contracts play a crucial role in any construction project, as they essentially regulate processes and ensure that all parties understand what is expected of them, providing a clear legal framework for interaction. It is now recognized that collaborative processes should ideally be embedded in a binding contract for the parties involved [].
There are several reasons why non-British countries have not adopted New Engineering Contracts (NECs) in the construction sector. These reasons may include cultural disparities, legal and regulatory frameworks, lack of awareness and familiarity, and resistance to change. Cultural disparities arise because different countries have their own established contractual frameworks. Adopting NECs requires a significant shift in mindset, which may not align with existing practices [].
To ensure the success of standardized contracts, the study recommends that collaboration members establish detailed guidelines for all contracting agreements. Additionally, it is advised that the members harmonize or establish a common contractual document that includes standard terms and conditions [].
In Peru, there are three crucial precedents that apply the tools proposed by the NEC. Understanding the different scenarios created by the inconsistent execution of these infrastructure projects is necessary []. On one hand, there is the successful execution of the Special Project for the 2019 Pan American Games (PEJP), which was recognized for its efficient optimization of time, cost, and objective achievement, thanks to the use of NEC3 tools []. On the other hand, there is the delayed and questioned execution of the Reconstruction with Changes Program portfolio, whose consulting services were conducted under NEC3 terms. Finally, there is the relatively new execution of the Special Public Investment Project “Bicentennial Schools”, involving seventy-five (75) projects awarded under NEC4 standards, from which optimistic results are still anticipated [].
Conventional contracts have led to limited offers for employees and companies, featuring a model that is less innovative and carries high risk, resulting in variations in technical, financial, and administrative aspects []. In contrast, standardized schemes have enabled digitalization by incorporating enhanced technologies that bring transparency to the contracting process []. Supported by these changes, there has been an increase in productivity, efficiency, and benefits. This, in turn, has motivated both large and small companies to take advantage of this opportunity to reduce risks and improve outcomes.
Among the standardized contractual models reviewed, the one that includes the elements developed in this article is the ECC of the NEC. While this contractual model imposes a severe penalty (such as the possible loss of a right) for failing to comply with the early warning obligation, it does so within the framework of other clauses that establish a collaborative environment, with duties and incentives for both parties. This makes it reasonable for the contractor who failed to follow the early warning procedure to lose certain rights, such as the right to claim costs that could have been avoided if the procedure had been properly followed [].
Table 1 summarizes the relevant literature consulted, highlighting the global use of information management tools, best practices and experiences with standardized contracts, and the recurrent use of methodologies by the authors.
Table 1.
Relevant bibliography consulted.
The literature emphasizes the importance of implementing new models of contract management, such as the standard NECs []. However, a knowledge gap has been identified regarding their implementation in conjunction with BIM tools for better management, particularly in a system like Peru’s. Therefore, this study aims to close this gap by proposing an innovative model for optimizing PPP projects in the country.
2.2. Risk Analysis in Construction Contracts
2.2.1. Risks in Traditional Contractual Models
In the more conservative approaches to contract management, the traditional models include design–build (DB) and design–bid–build (DBB). Additionally, some authors categorize other types of contracts, such as engineering, procurement, and construction management (EPCM) contracts, under traditional models. These are derivatives or modifications of the DB contract. It is worth mentioning that the EPCM contractual model could be considered within a collaborative framework or at an intermediate point [].
According to some authors, the main problems with conventional contracting can be summarized as follows:
- (a)
- Risk allocation and blame assignment.
- (b)
- Fixed prices that discourage additional work by participants.
- (c)
- Asymmetric information between parties.
- (d)
- Difficulty in managing changes.
- (e)
- Lack of genuine cooperation.
In the ideal scenario, this implies a transfer of risk from the client or owner to the contractor, where any difference between the actual cost and the budgeted cost, as long as no changes affect the project scope, is irrelevant and, therefore, does not lead to a price increase [].
2.2.2. Risks in Standardized Contractual Models
Within what is considered standardized in contract management we find the most representative models such as “alliancing” or “integrated project delivery” (IPD) [].
From the literature reviewed, of all the standardized contracts under analysis, alliancing or IPD is the most agile contracting model, which seeks to align the interests of all the parties involved, who will share the project risks, mainly through the participation in the final profits and losses, encouraging their participation in the decision making and management of the project [].
Regarding risk sharing, traditional construction contracts are structured on a classic exchange relationship, in which one party is obliged to deliver the work and the other to pay the price. In this logic, the profit margin of one of the contracting parties will generally be at the expense of the other, generating the classic tension of a sales contract [].
The alliance contract is structured on a regime of absolute transparency between the project participants in terms of the handling of all information relating to the project and especially with regard to the financial aspects. The raison d’être of this principle is to end or at least reduce the double asymmetry of information inherent in traditional construction contracts and thereby eliminate factors that contribute to mutual distrust, an unquestionable source of conflict between the parties [].
Notwithstanding the fact that the alliance model tends to reduce the level of tension between the parties to the contract by aligning interests, it is pointed out that there are certain situations in which the parties find themselves in opposing positions, such as, for example, when defining the target cost and term, where the interest may have the highest possible target cost and term, provided that this does not invalidate the continuity of the project. Therefore, it is essential to introduce other factors or elements, beyond the price and term, that can foster a collaborative environment among the parties involved [].
Federation Internationale des Ingenieurs-Conseils, in French, or International Federation of Consulting Engineers, in English, better known by its acronym FIDIC, is an international non-governmental organization based in Geneva with 106 years of history, which has contractual models in the field of construction that enjoy wide acceptance and recognized prestige in the international context []. Thus, the analysis of the way in which it establishes the distribution or allocation of risks is of special relevance.
Its contractual models are characterized by providing internationally known and accepted solutions to carry out the execution of different stages of the construction project, providing a balanced and harmonious scheme between the guiding and configuring principles of Common Law and Continental Law [].
One of the keys to the success and recognized international prestige of the FIDIC contractual models is related to the establishment of an adequate risk distribution structure, based on the guiding principle that the risk should be assumed by the party to the construction contract that is in the best position to manage it []. Adequate risk management is in the interest of both parties: The principal will be able to award the contract at a lower price and will only have to assume additional costs in the event of extraordinary risks, while the constructor will not be obliged to specify risks that are difficult to quantify [].
Regarding the distribution of risks in NECs, this model arises from the recommendations made by the Institution of Civil Engineers of the United Kingdom, with the aim of changing the traditional forms of contracting in construction and related areas, which focused on the rights and obligations of the parties, creating a model that would promote proper project management []. NECs were conceived with the construction of infrastructure projects in mind, but they are also applicable to other contractual objects, such as, for example, the contracting of goods and services related to the construction industry [].
As for the most recent model, the NEC4 was constituted from the lessons learned from user and industry practice and has been specially designed to support innovation through digital advances and foster collaboration around the world []. Highlights include greater flexibility in each contractual model, a design for international use, better value, and greater certainty [].
The NEC4 introduces two new contractual models: The NEC4 Design, Build and Operate Contract (DBO) and the NEC4 Alliance Contract (ALC) [].
In short, without going into the details of the clauses specific to each NEC, the literature points out that these models have generated an important innovation in terms of risk management, especially those that arise during the development of the project, which are the most difficult for the parties to address and face.
2.3. Public–Private Partnerships (PPPs) in Peru and Latin America
Public–private partnerships (PPPs) in Peru are established as one of the modalities for private investment participation. These partnerships typically involve appropriately distributing project risks and allocating resources, often from the private sector, for the construction, operation, and maintenance of infrastructure to guarantee service levels throughout the concession period [,].
Best practices suggest that the first step is to conduct a socioeconomic analysis to compare the costs and benefits generated by the project from a social perspective []. This requires methodologies that include determining social prices and using one or more appropriate social discount rates []. It is recommended that these methodologies come from the country’s public investment regulatory authorities and be applied to all projects. Only those projects that contribute to societal well-being should be developed [].
Project evaluation from a societal perspective (economy-wide) considers all costs and is generally conducted incrementally, comparing the market equilibrium in a scenario with the project to the baseline scenario without the project (including an optimized baseline scenario) []. Economically, a project is a flow of benefits and costs occurring over different periods. The objective of a socioeconomic project evaluation is, therefore, to estimate the benefit and cost flows associated with the project to determine its viability [].
The current financial crisis has posed a new challenge for Latin America and the Caribbean within a proactive strategy of productive transformation and strengthening international integration in the medium and long term []. The region must improve its positioning in the global market to take advantage of growth momentum when the global economy regains its dynamism, avoiding the contradictions observed in the adjustments of the 1980s [].
Regarding road concessions, in several Latin American countries, concessions have been awarded by combining one or more variables related to toll values, contract duration, a payment to the government, or a subsidy requested to obtain the concession, among other factors []. The resulting contracts are characterized by having a specific term, a defined tariff structure, and some adjustment method [].
2.4. Building Information Modeling and the BIM Plan Peru
Building information modeling (BIM) is one of the most promising developments in the architecture, engineering, and construction industry. It is defined as the representation of the physical and functional characteristics of an infrastructure, with a collaborative approach between the various stakeholders in the different phases of a project’s life cycle [].
Since its introduction to the industry in the 1970s, BIM has been developed over more than three decades and is now a key technology in the construction industry for collecting, storing, sharing, and managing infrastructure information at different stages of infrastructure management, such as formulation, construction, operation, and maintenance [].
BIM is transforming the way the construction sector operates. The public sector has the potential to play a leading role in promoting and facilitating the adoption of BIM within the industry []. In recent years, BIM implementations have significantly increased as more government agencies and organizations in various countries around the world have adopted BIM [].
Recent research highlights the need to achieve the best cost–benefit ratio on a large scale, while also helping each project meet its objectives []. Successful integration of BIM in a single project can be achieved by ensuring that all stakeholders follow the same guidelines, leading to a regulated system [].
To promote the adoption of the BIM methodology across the country, the Ministry of Housing, Construction, and Sanitation (MVCS) of Peru developed this strategy with the assistance of the Peruvian Association of Construction Engineers (APIC) and other industry stakeholders [].
The Peru BIM Plan establishes the following: There are several objectives and actions to drive the implementation of the BIM methodology in the country. Among them are:
- Establishing a certification system for professionals and companies that use the BIM methodology to ensure quality and efficiency in its application.
- Establishing a digital platform for the interconnection of various actors in the construction sector, enabling greater collaboration and efficiency in project management.
It is important to note that BIM is a significant technological tool offering numerous advantages to the parties involved in a given project. However, according to the literature review, various obstacles affect the BIM adoption rate, which varies according to specific factors present in different countries [].
Public Investment, BIM, and Barriers
Implementing BIM in the public sector is complex, with a perceived resistance to change, a very natural societal factor. Uncertainty about change causes people to try to remain unchanged, just like the stakeholders in a construction project. One of the most important factors identified is the traditional contracting method. Stakeholders have been familiar with and adapted to the traditional method for a long time and are “experts” and efficient with this method. Therefore, replacing this method is not easy for stakeholders and is not universally accepted [].
In Peru, the Fourth Final Complementary Provision was introduced in 2018 to gradually adopt collaborative digital information modeling methodologies. This was an effort to increase transparency, quality, and efficiency in public investments. BIM, or building information modeling, is the acronym for this initiative [].
“Policy Measure 1.2: BIM Plan” of the cited Priority Objective is established in the National Competitiveness and Productivity Plan 2019–2030, aiming to gradually integrate BIM into the public sector.
2.5. Current Situation of PPP Contracts in Road Infrastructure in Peru
Situational Analysis of the Peruvian National Road Network
The current state of various road networks in Peru reveals disparities in service levels, particularly regarding pavement conditions. A significant portion of the national road network is managed through public–private partnerships (PPPs) []. Challenges related to road quality and maintenance are highlighted, impacting not only economic considerations but also safety aspects, as indicated by studies on accident rates in Peru [].
An important point to consider in this study is that the concessions analyzed are part of an initial pool of contracts where the regulatory agency, PROINVERSION, was beginning to implement this type of bidding process in the country [].
After reviewing the contracts for each of the concession projects analyzed, we observed a common trend in negotiations during the first six years. Of the 55 total addenda signed, 40% were made in the early years of contract execution.
Common indicators found include those related to construction execution and financing. These results were consolidated in the attached table.
From the initial analysis, it can be established that technical and financial aspects consistently recur during negotiations. This suggests an apparently inadequate risk distribution, leading to modifications in clauses and changes in the project execution schedule.
On the other hand, we focused on rigid aspects that trigger renegotiations in the contract, and a table was consolidated to support the hypothesis presented in this research. Figure 1 shows a consolidation of the most common causes of contract modification in the Peruvian national road network.

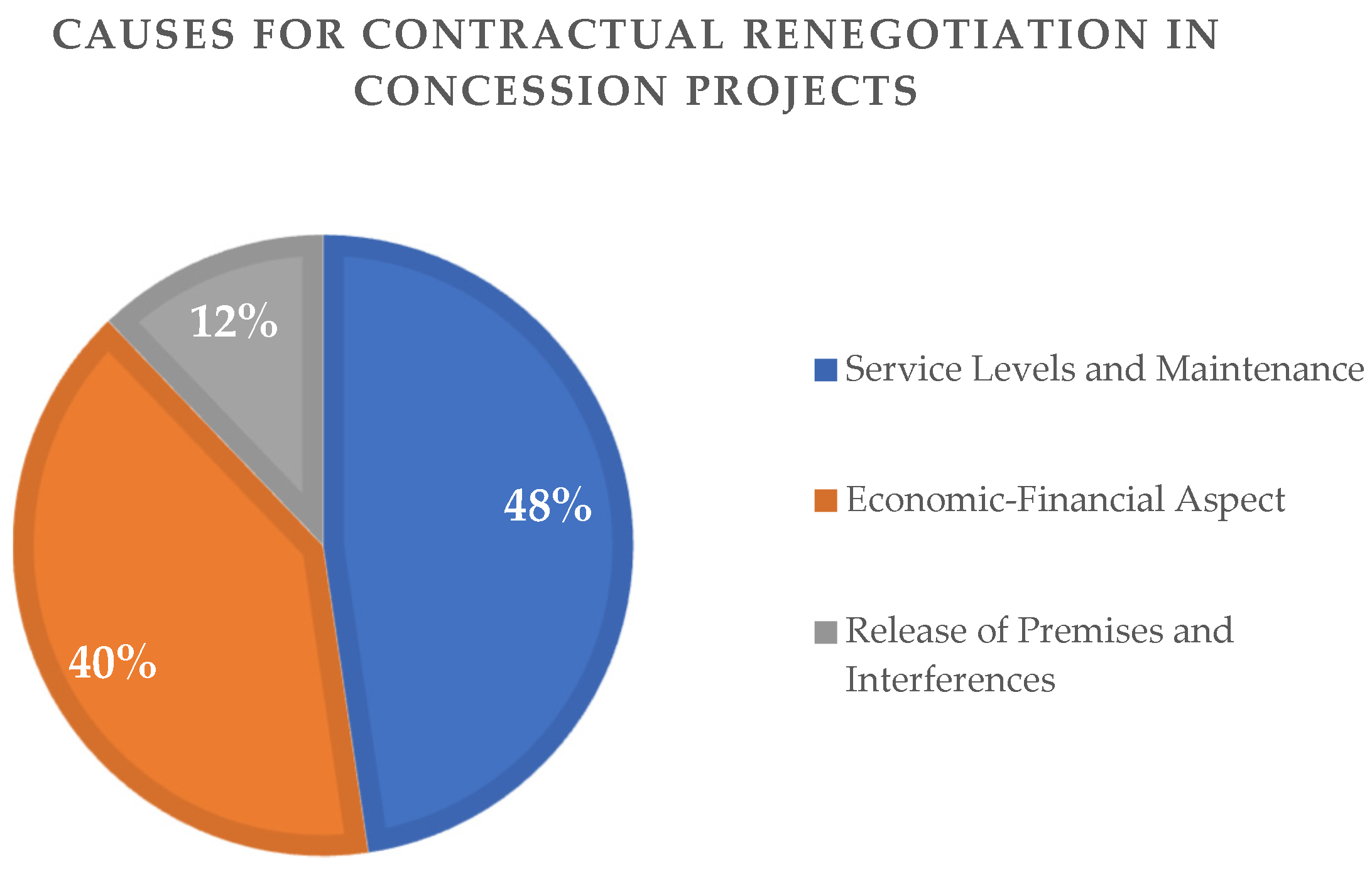

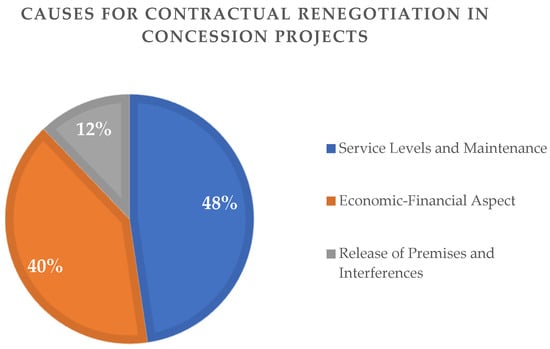

Figure 1.
Causes for contractual renegotiation in the Peruvian national road infrastructure under PPP modality [].
3. Methods and Management Model
It is necessary to analyze the current situation of concession projects in Peru, specifically public–private partnership (PPP) contracts, to identify the tools currently available for contract management in these ongoing concession projects. Following this analysis, elements for improvement were proposed through a management model that integrates BIM tools and standardized contracts to optimize the processes currently in use [].
This way, a system was developed to optimize processes and improve the existing contract management framework, utilizing information management tools such as BIM and the flexibility of standardized contracts. This system is in line with the guidelines and projections of the National Infrastructure Plan for Competitiveness [] and the National BIM Guide [], which are currently part of the Peruvian government’s strategic plan to enhance infrastructure management.
To this end, the research examined ten of the sixteen road concession contracts currently supervised by the Supervisory Agency for Investment in Public Use Transport Infrastructure (OSITRAN). The selection criteria include the number of addenda, the investment level, and the concession period, covering 63% of the PPP contracts currently in force. The process map will be developed based on ISO 19650 [], the National BIM Guide, and the process management manual of the Ministry of Transport and Communications.
For the validation of the study, eight experts related to contract management, NEC management, and BIM tools were selected, following the recommendations of the Delphi methodology. This methodology suggests collecting data through document analysis, observing individual behaviors, or conducting interviews with involved parties using a specific protocol or instrument to gather data [].

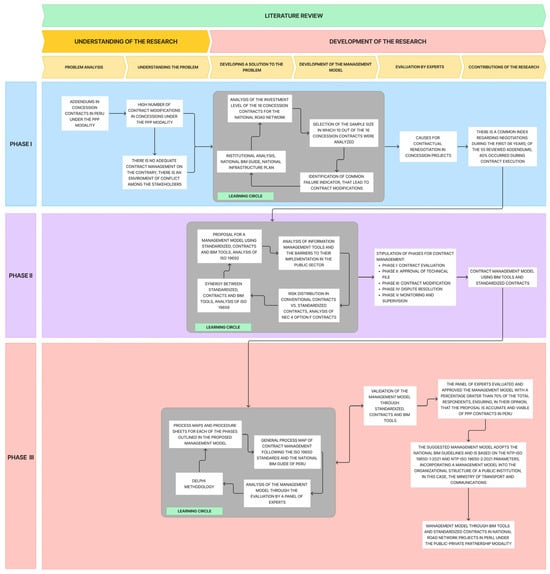

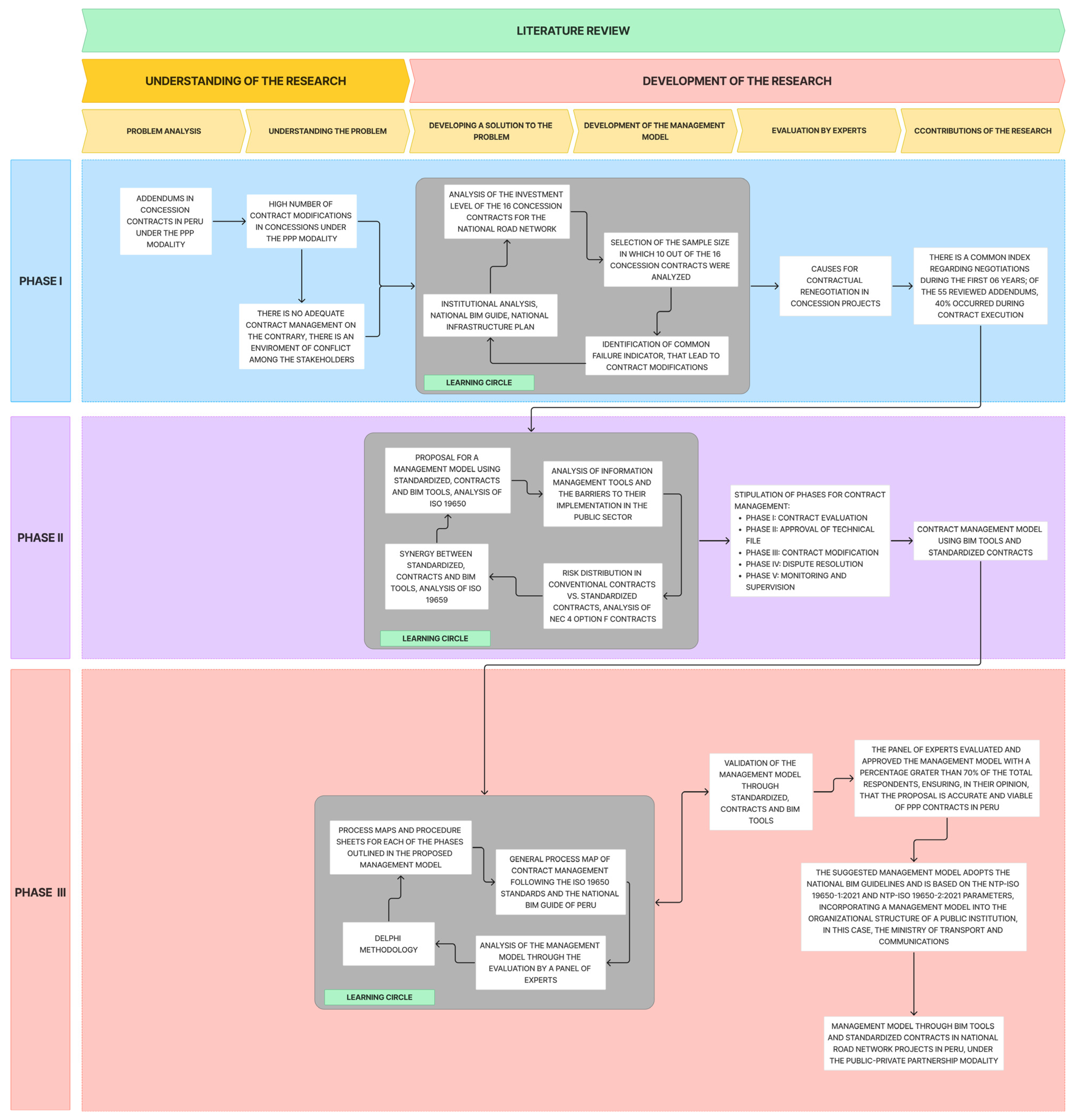

The analysis of the literature review and the diagnosis of the case studies, in this instance, the national road network under concession, made it possible to identify a synergy between information management tools and standardized contracts. This synergy was used to propose a management model that can optimize infrastructure under the PPP modality in the Peruvian context. Figure 2 summarizes the research design in a diagram.
Figure 2.
Research design process map.
3.1. Management Model Using Standardized Contracts and BIM Tools
The proposed approaches in the model could be applied to any technical assistance contract related to the construction, management, and maintenance of the planned infrastructure, depending on the specific requirements of each project.
The preparation phase of the structured information model is included within the scope to carry out the necessary analysis procedures to specifically describe and graphically represent the proposed solution using the improvement mechanisms provided in the contract.
A public–private collaboration project has a complex contractual structure with numerous variables. The current model focused on the infrastructure maintenance phase and falls within the framework of the Public–Private Partnership Law.
Since the presented model is based on the premise that the State must optimize the implementation of infrastructure within the public system across all areas, managing the various phases of infrastructure (design, construction, conservation/maintenance/operation) independently from a contractual perspective does not hinder the application of BIM and international standard contracts.
From a contractual standpoint, three distinct phases were identified: bidding, offer, and contract execution. For the purposes of this study, we focus on the contract execution phase, particularly from the perspective of infrastructure operation and maintenance.
The following list of tasks represents the information management method for this study. It is important to note that adjustments should be made based on the conditions of the institutional environment.
According to the guidelines given in NTP-ISO 19650-1:2021 [] and NTP-ISO-2:2021 [] and the Peruvian national BIM guide, the responsibilities of the actors as part of an integrated information management process are stipulated in Figure 3.

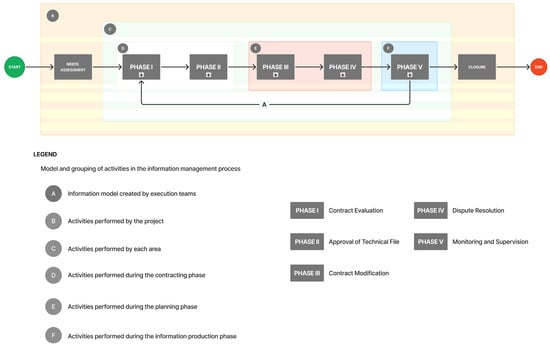

Figure 3.
Contract management, BIM tools–NEC (ECC) adapted from the BIM Peru plan [] and ISO 19650 2:2021 [].
In this regard, the involved parties in the management process are as follows:
Execution team:
- A team consisting of the assigning party and the designated party in the development of the investment applying BIM.
- Working team:
- A team composed of the designated parties in the development of information management using BIM.
- Project team:
- Composed of all parties involved in the development of information management using BIM.
The grantor, through the body responsible for the executing unit’s competencies, commits to providing optimal infrastructure management according to the parameters for development during the execution phase within the application of the public–private partnership (PPP) law. Key factors such as the grantor, the regulator, and the concessionaire are established, with the latter being responsible for preparing the technical file and executing the works. Figure 4 shows the actors involved.

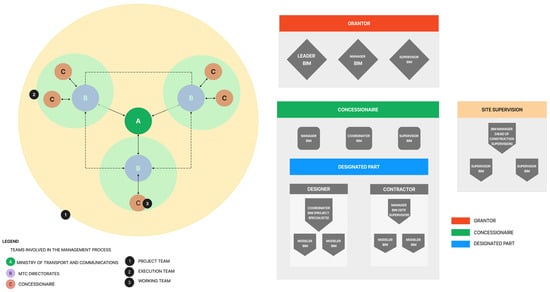

Figure 4.
Teams involved in the BIM information management process adapted from the BIM Peru plan [] and ISO 19650 2:202 [].
3.2. Phase I: Evaluation of the NEC (ECC) Contract
Initial Contract Version (VIC)
After establishing the needs assessment by the designating party, the scope of BIM utilization must be defined, along with the initial contract version (VIC) for developing the exchange information requirements (EIRs).
For the initial version of the contract (VIC) the contractual model New Engineering Contract (NEC) Option F (Management Contract) engineering and construction contract will be used, the procedure sheets Table 2 and Table 3 are shown below as well as the process map in Figure 5.
Table 2.
Procedure sheet—Contract evaluation.
Table 3.
Procedures—Contract Evaluation.

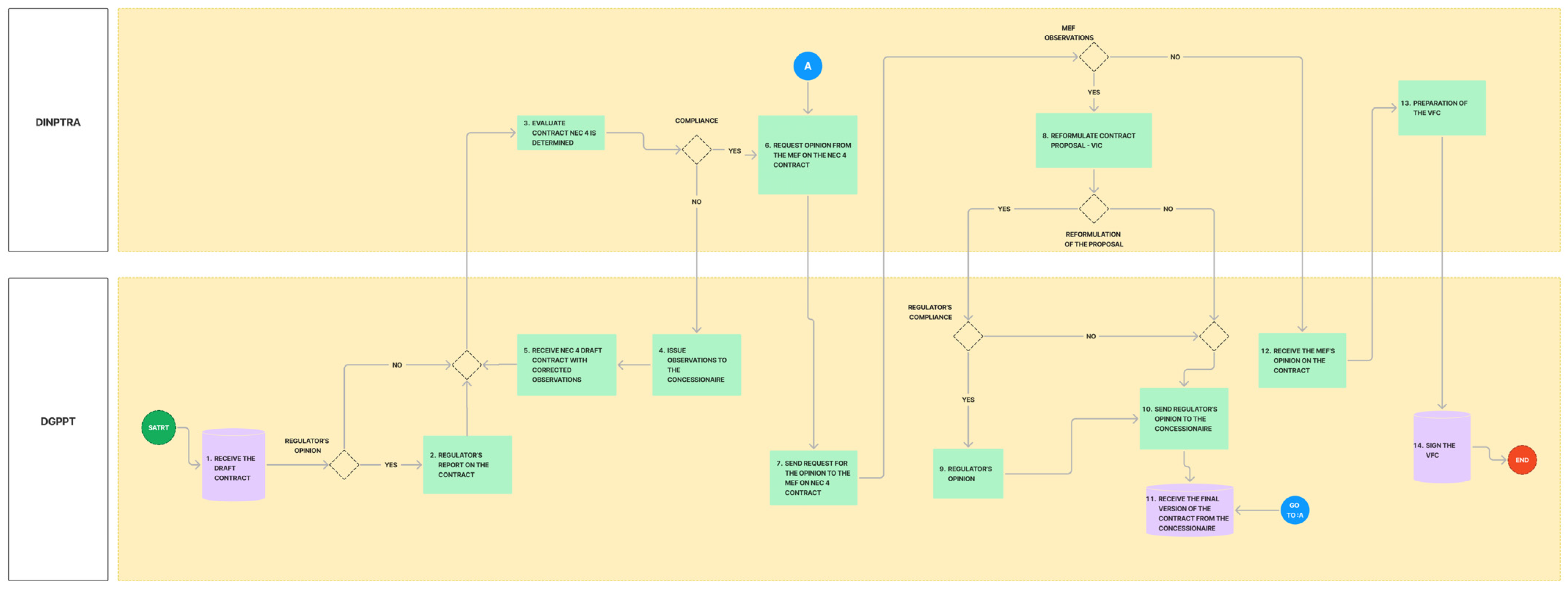

Figure 5.
Phase I management model, process map—contract evaluation.
3.3. Phase II: Evaluation and Approval of the Technical File
BIM Execution Plan (BEP)
The BIM Execution Plan (BEP) will be validated in consultation with the involved parties, ensuring that the plan reflects the use of information technologies (ITs) and the coordination of work between the execution teams. The validation process may also involve the designating party working cooperatively to add or correct certain methodologies and/or procedures in information management., the procedure sheets Table 4 and Table 5 are shown below as well as the process map in Figure 6 and Figure 7.
Table 4.
Procedure sheet—Evaluation and approval of the technical file.
Table 5.
Procedures—Evaluation and approval of the technical file.
Figure 6.

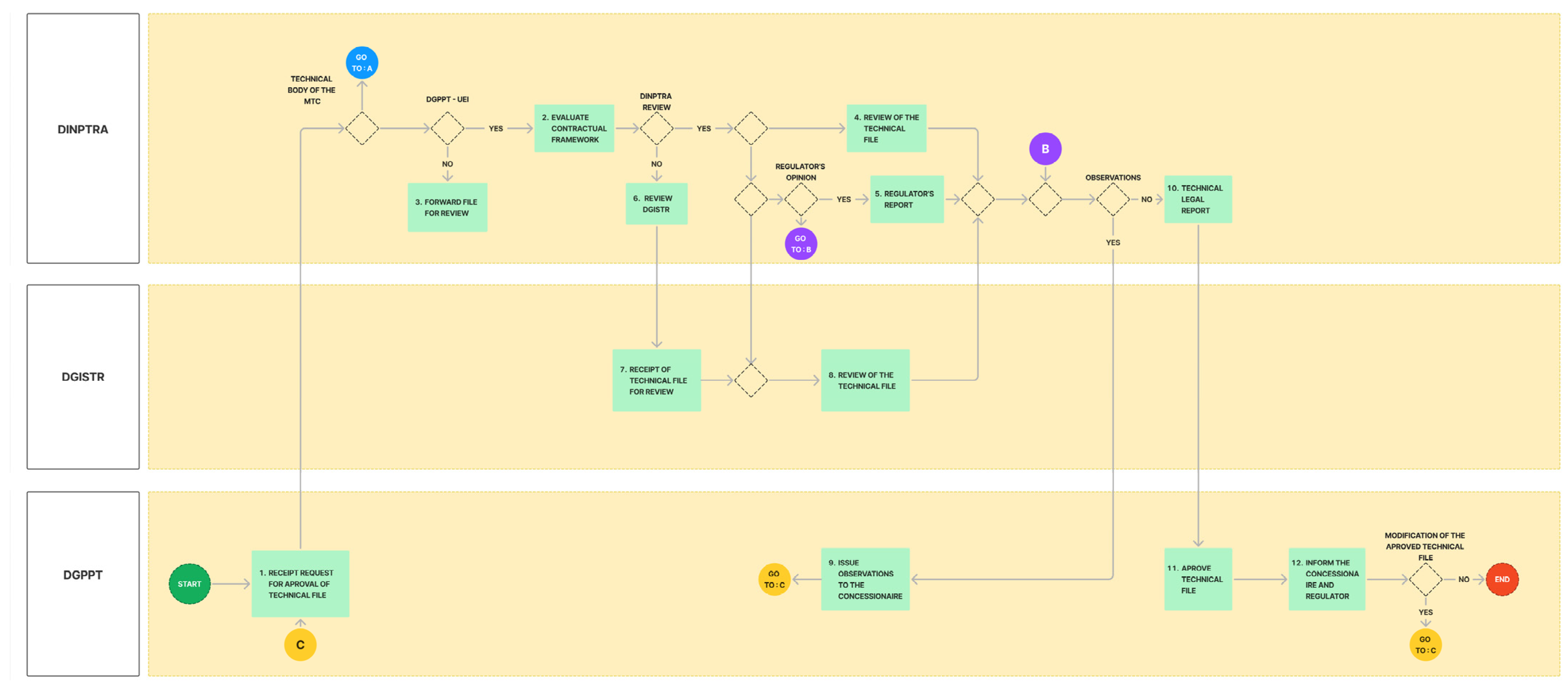

Phase II management model, Process map—Evaluation and approval of the technical file (01).
Figure 7.

Phase II management model, Process map—Evaluation and approval of the technical file (02).
3.4. Phase III: Contract Modification
Change Management
This phase involves considering or evaluating the need for contract modifications and/or addenda, assessing the competitive conditions among the actors, and reconfiguring the allocation of risks, responsibilities, early warnings, compensable events, and the BIM Execution Plan, the procedure sheets Table 6 and Table 7 are shown below as well as the process map in Figure 8.
Table 6.
Procedure sheet—Contract modification.
Table 7.
Procedures—Contractual modification.

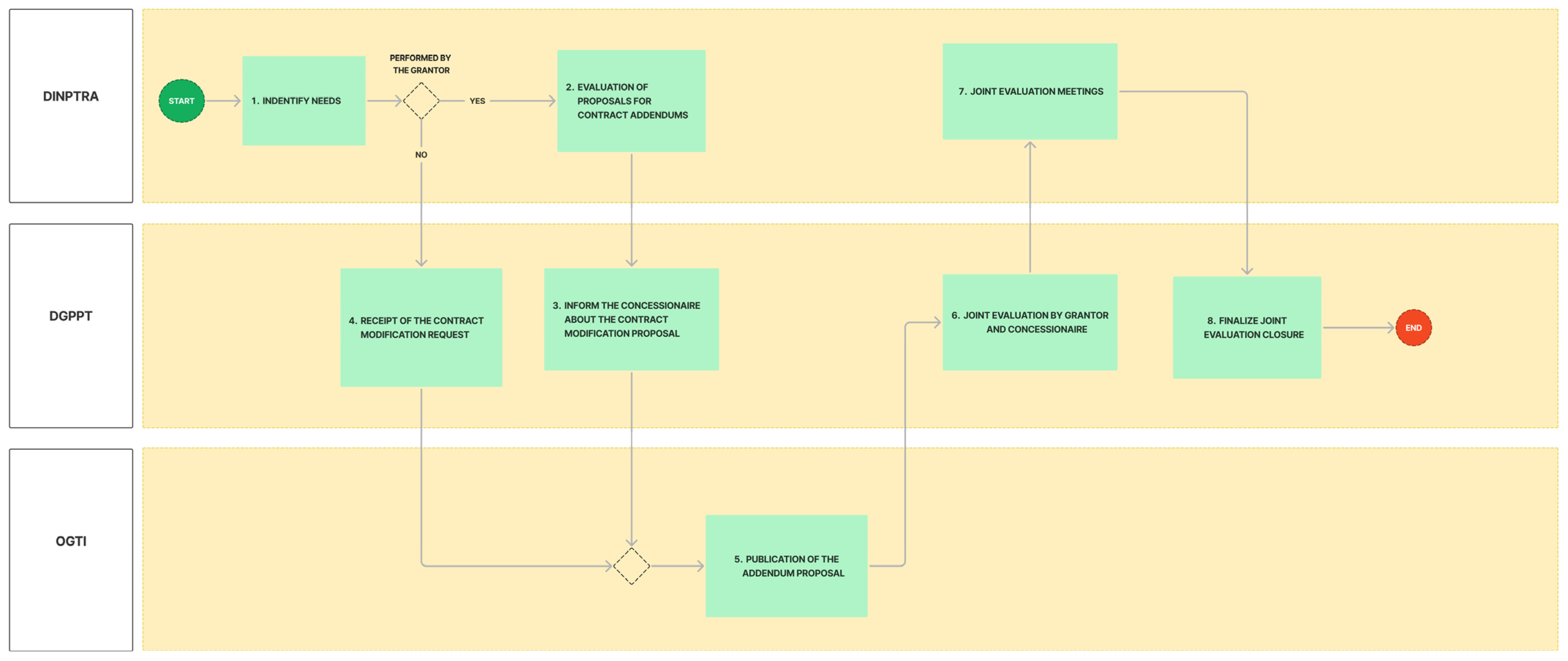

Figure 8.
Phase III management model, Process map—modification.
3.5. Phase IV: Dispute Resolution Management
Dispute Resolution
The Dispute Avoidance Board (DAB) will be formed to generate consensus in the event of disputes arising during contract execution, ensuring that the project’s progress or execution is not adversely affected, the procedure sheets Table 8 and Table 9 are shown below as well as the process map in Figure 9 and Figure 10.
Table 8.
Procedure sheet—Dispute resolution management.
Table 9.
Procedures—Dispute resolution management.

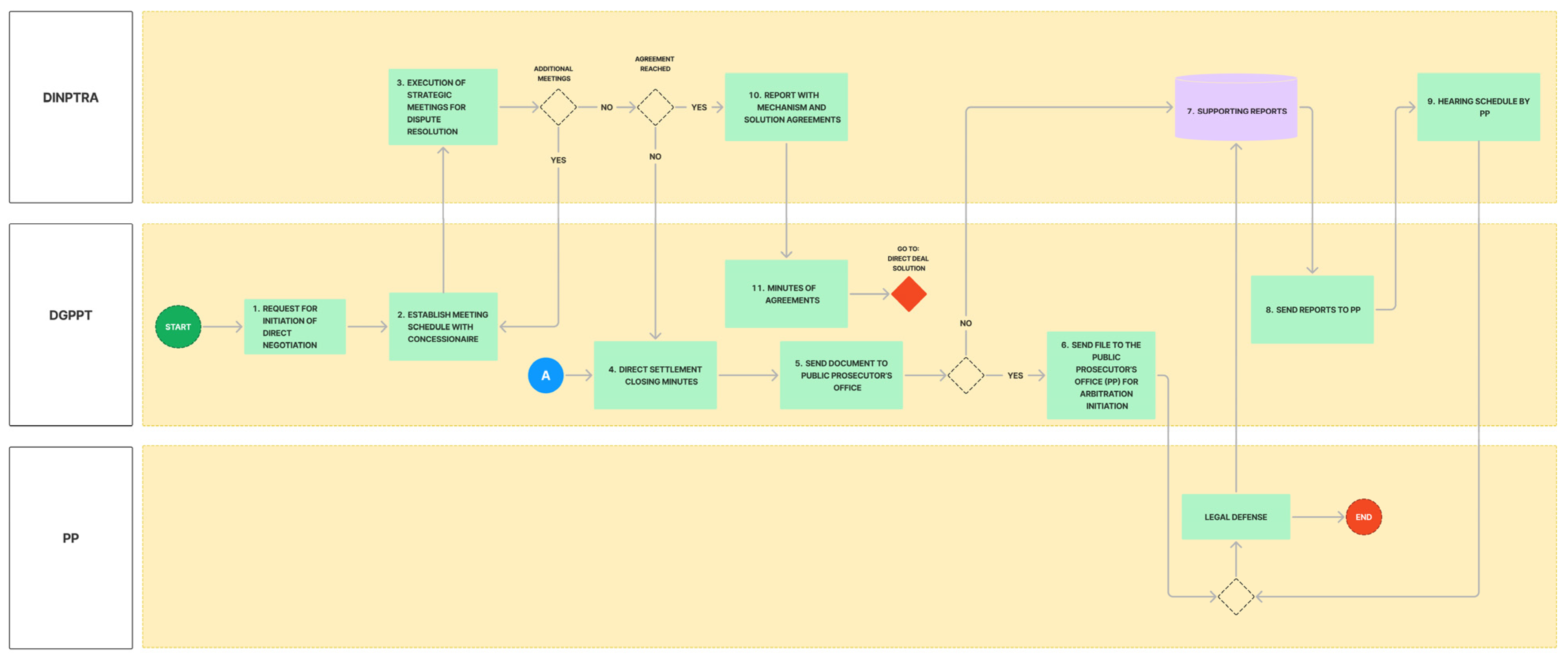

Figure 9.

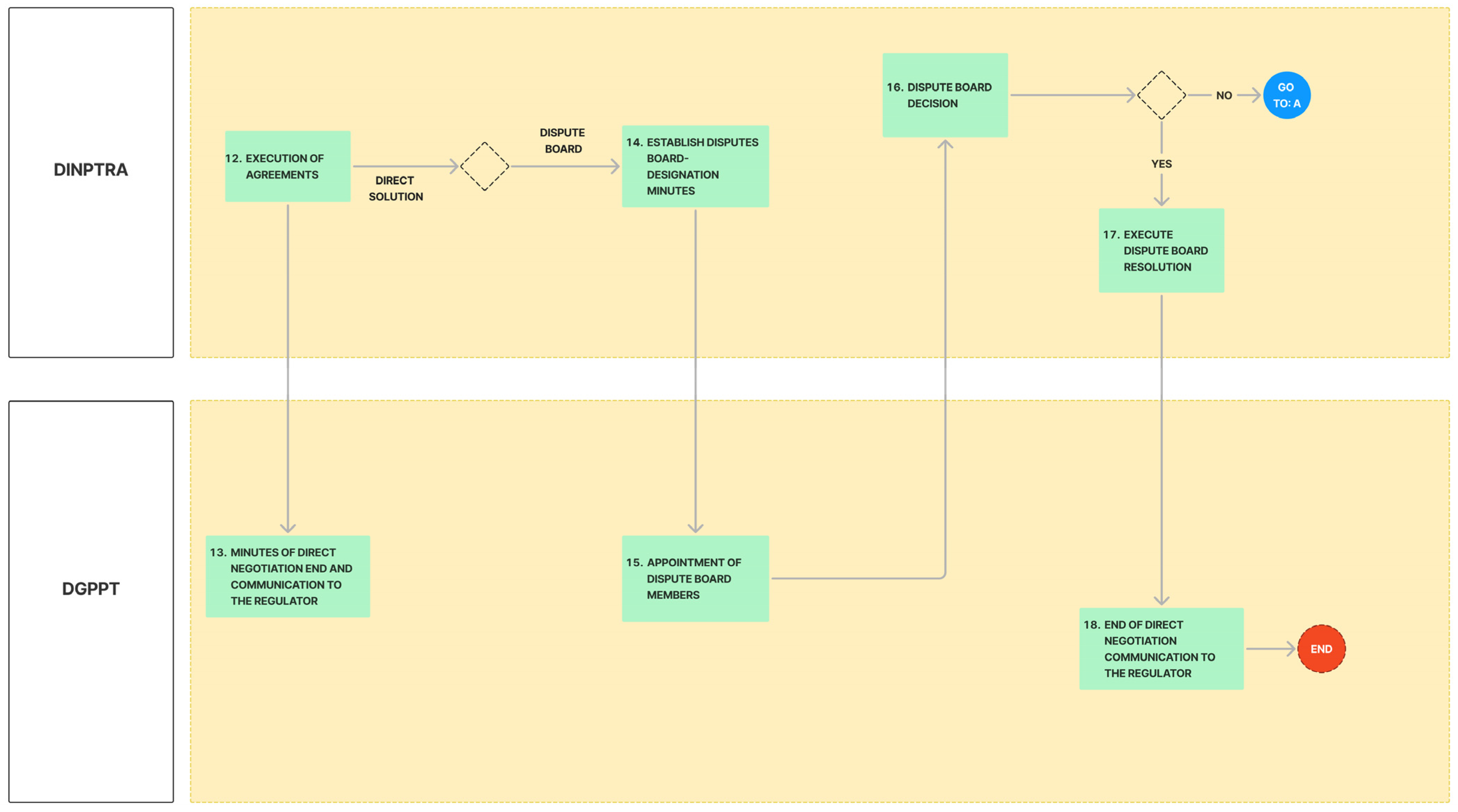

Phase IV management model, Process map—dispute resolution management (01).
Figure 10.
Phase IV management model, Process map—dispute resolution management (02).
3.6. Phase V: Monitoring and Follow-Up of Work Execution
3.6.1. Master Information Delivery Plan (MIDP)
The designated organization must create the Master Information Delivery Plan (MIDP), which essentially compiles the TIDP described in the previous process. This MIDP allows the designated organization to verify the delivery plans of the different work teams while ensuring the project’s cost and time benchmarks.
3.6.2. Information Production
The development of information that meets the requirements outlined in the TIDP will be the responsibility of all working teams, with the TIDP serving as the main guide for producing all information efficiently and collaboratively.
3.6.3. Quality Control
These methods and procedures serve as a means of external control or project supervision. They ensure that the information produced aligns with the project’s requirements. Additionally, they review and approve the information exchange according to the established review and approval process.
The project’s information standards will set the minimum criteria to be considered in the information containers, each with a unique identity (ID) for classification. This entire process is supported by checks that can be conducted through the workflow displayed in the CDE.
Table 10.
Procedure sheet—Follow-up and monitoring of work execution.
Table 11.
Procedure—Follow-up and monitoring of work execution.

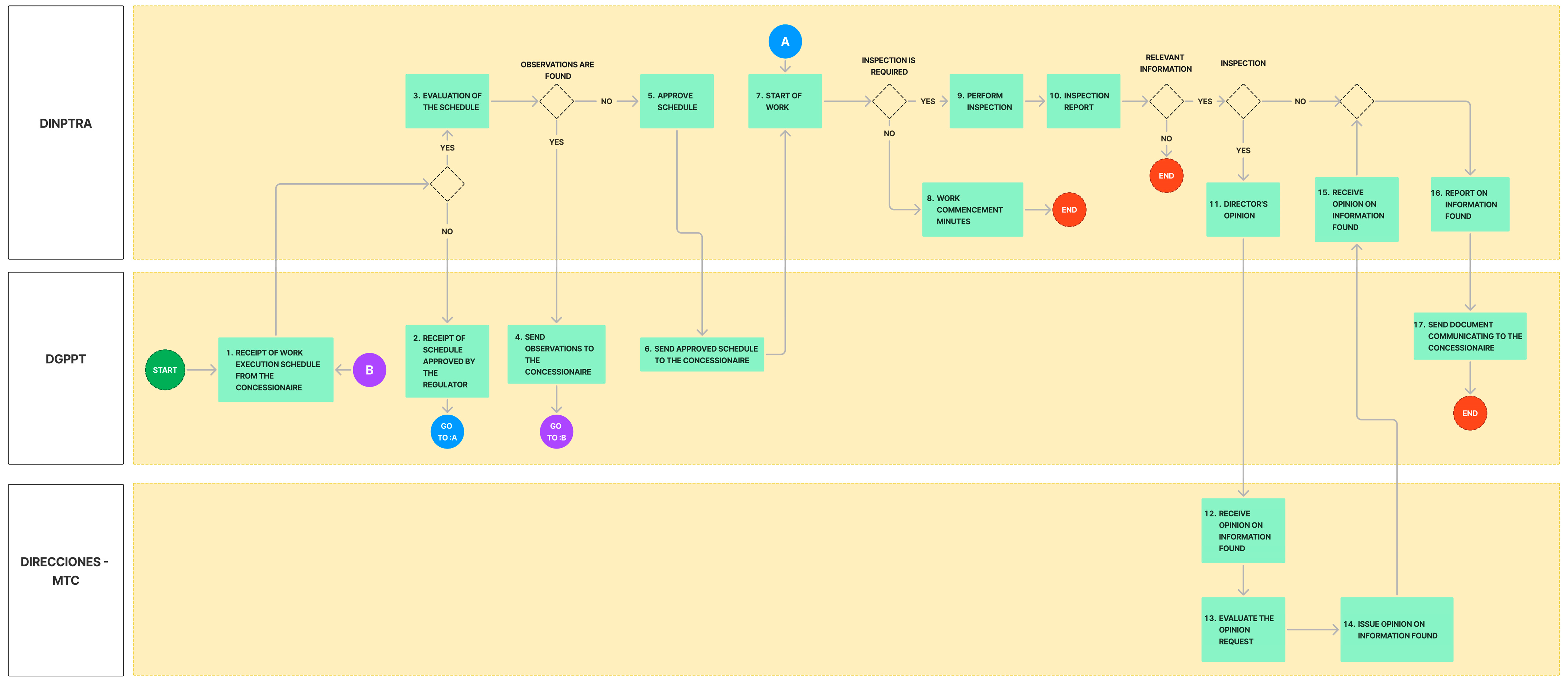

Figure 11.
Phase V management model, Process map—monitoring and follow-up of work execution.
4. Model Validation Results
4.1. Scope
The primary goal of the Delphi method is to achieve a highly reliable group opinion by systematically and interactively consulting a panel of experts individually about their views on the study topics []. Through questionnaires and interviews, experts can respond anonymously and independently in successive rounds to achieve maximum consensus []. Researchers can contact the experts personally, via email, or online []. The Delphi method has been successfully applied in construction project management [].
According to established guidelines, Delphi validation studies typically include between 8 and 16 specialists []. Based on these assumptions, this research method was applied to 10 contract management experts to validate the proposal made in this study.
The time required to disseminate the questionnaire among the experts and collect data from each iteration was a maximum of one week.
4.2. Selection of Experts
The following criteria were used for the selection of experts, Table 12:
Table 12.
Selection of experts.
The selected experts hold the following positions:
- Civil engineer—project management technical specialist.
- Lawyer specializing in arbitration.
- Civil engineer—contract management technical specialist.
The participants acted as contract managers from both technical and legal perspectives within a concession contract framework.
4.3. Survey or Questionnaire
The measurement tool, in this case a survey or questionnaire, was digital and was configured as follows:
First part: A virtual meeting was used to bring together experts in the research topic.
Second part: A questionnaire regarding the suggested management model was provided, focusing on whether the proposed management model is accepted or not. Using an adapted Likert scale Table 13, responses ranged from “totally disagree”, representing the most unfavorable scenario, to “totally agree”, representing the most favorable. The rating scale is as follows:
Table 13.
Likert scale.
At the end of the survey, respondents had the option to suggest changes and/or make observations on the evaluated model.
The survey included three primary questions:
- Do you agree with the model? Please quantify.
- Can you improve the model? Please detail.
- Could you propose an alternative? Please detail.
4.4. Delivery of the Document or Management Model to Specialists
The selected professionals, Table 14, were contacted via email and received a summarized version of the management model along with the questionnaire in Google Forms format. The presentation outlined all the specific steps that the respondents should follow when completing the survey for the suggested research, along with the expected response time.
Table 14.
Specialist data, summary.
4.5. Results
The first section processed data that supports the structure of the management model, Figure 12, Figure 13, Figure 14, Figure 15 and Figure 16.

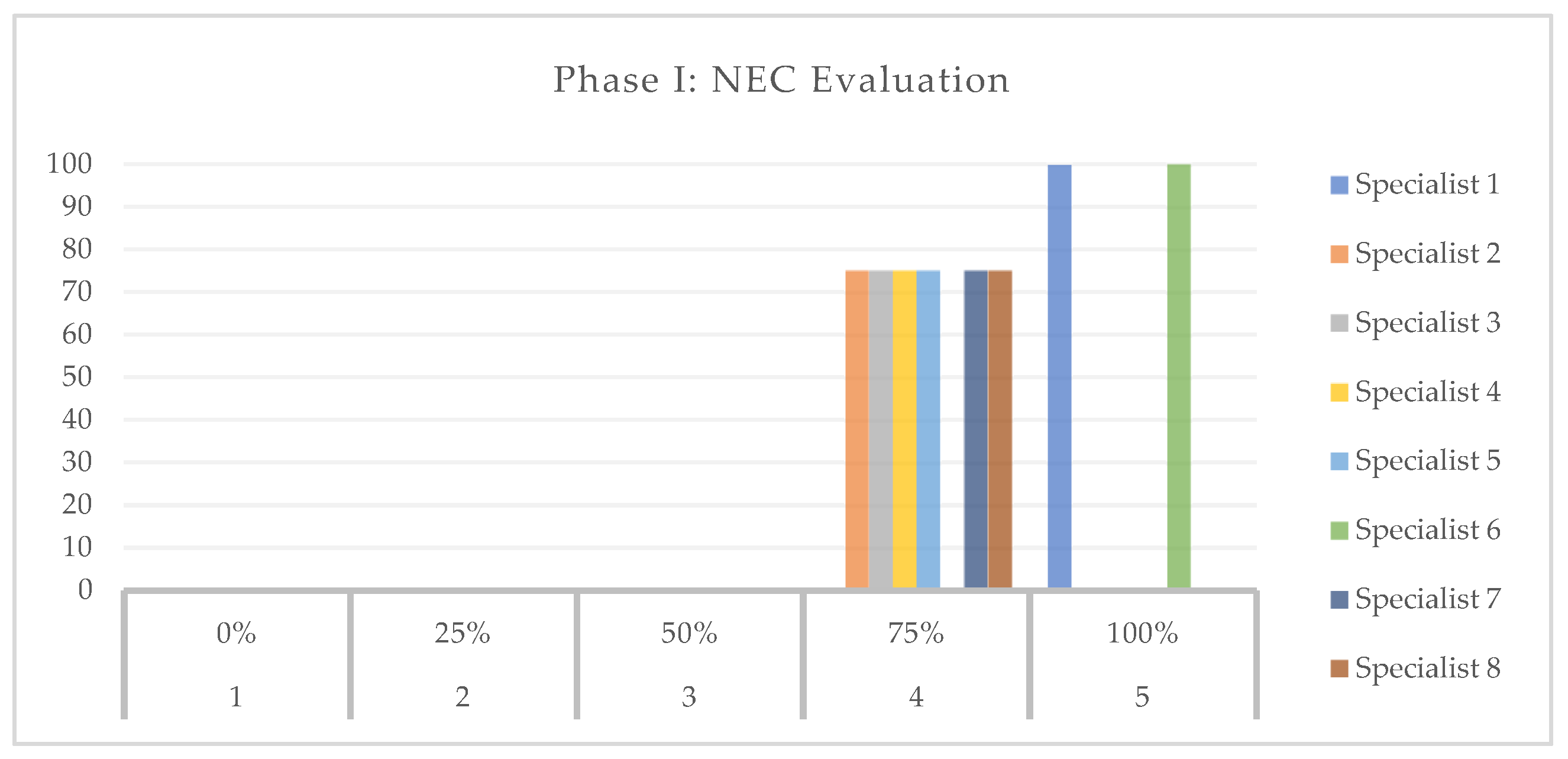

Figure 12.
Expert Validation (Phase I: NEC Evaluation).
Figure 13.

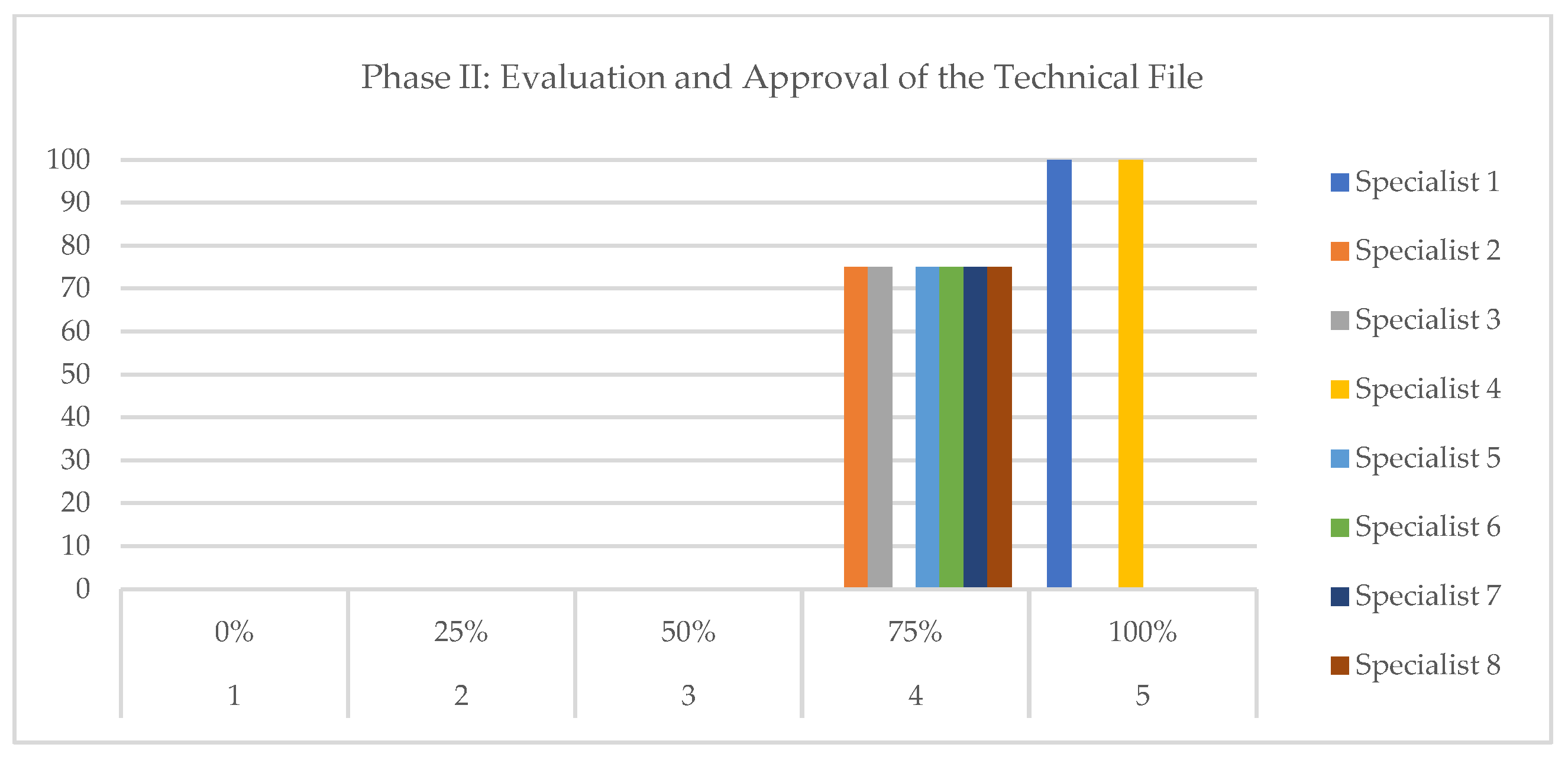

Expert validation (Phase II: Evaluation and approval of the technical file).
Figure 14.

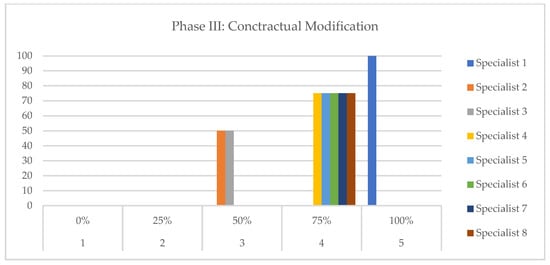

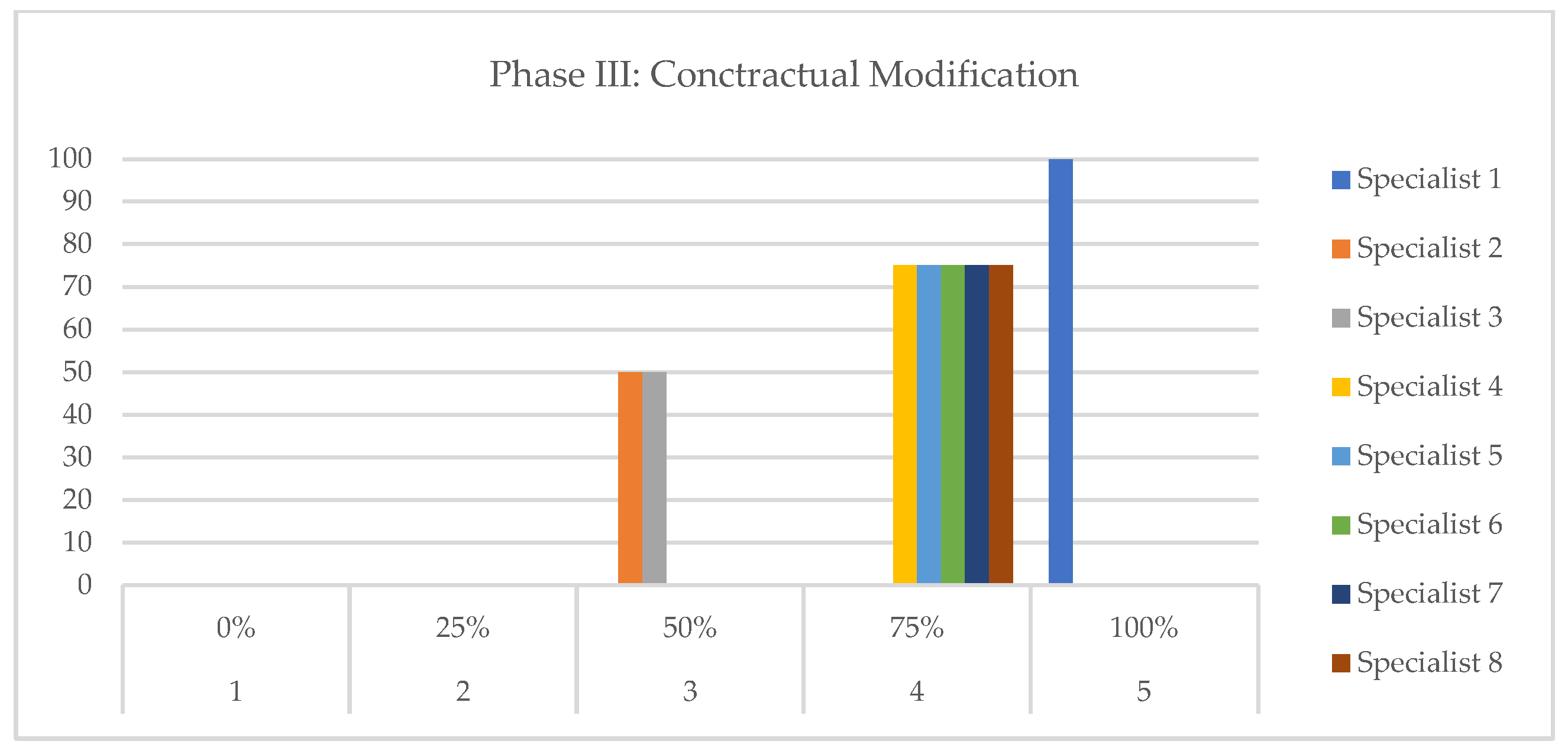

Expert validation (Phase III: Contractual modification).

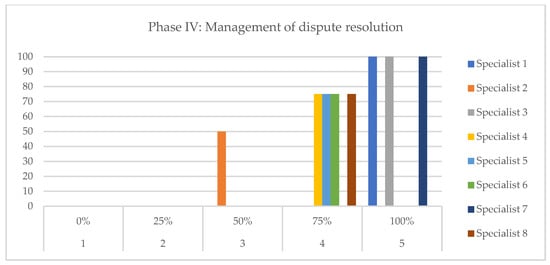

Figure 15.

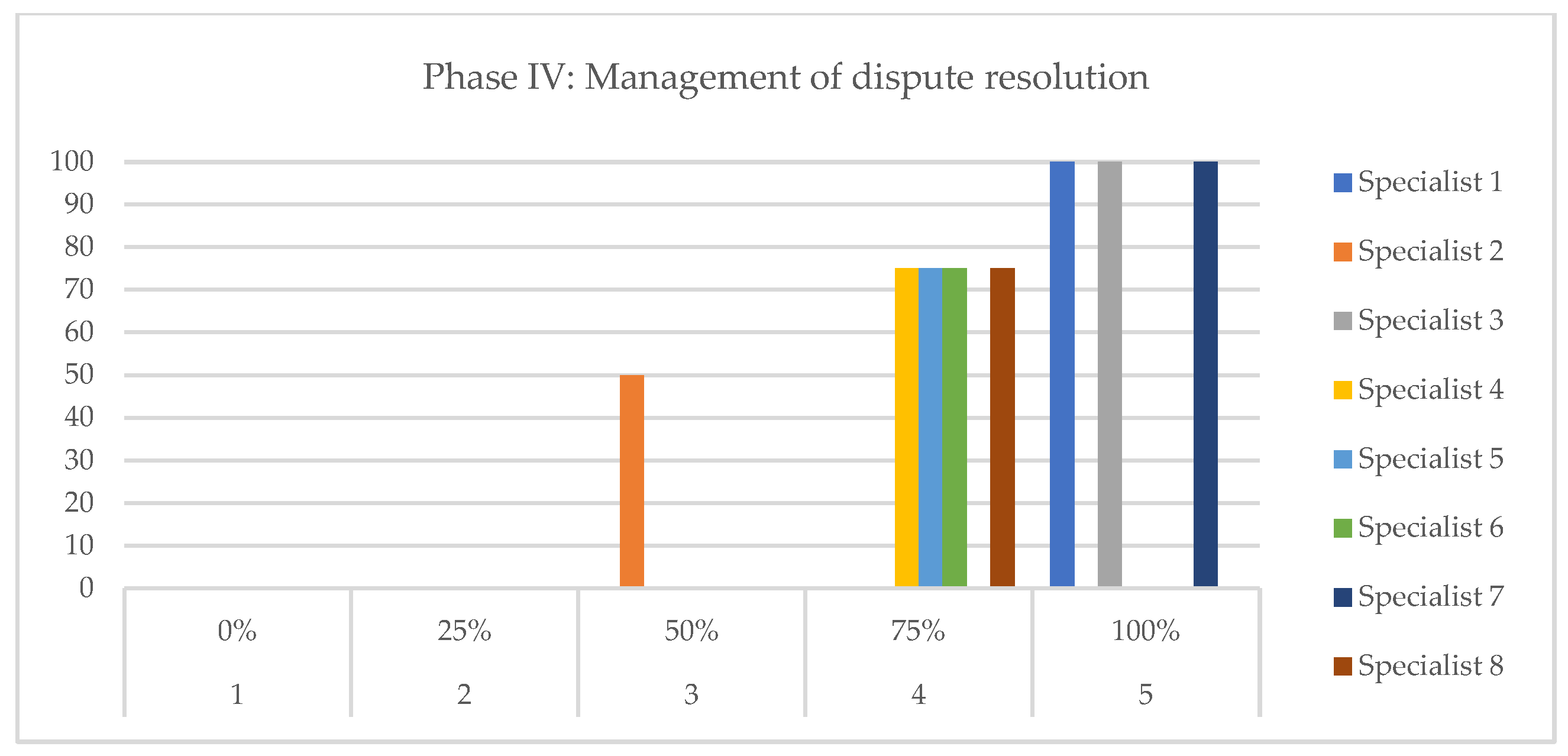

Expert validation (Phase IV: Dispute resolution management).
Figure 16.

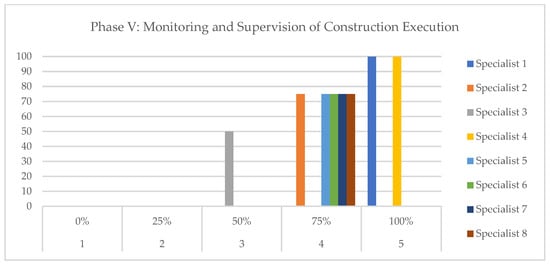

Expert validation (Phase V: Monitoring and follow-up of works execution).
The second section documents data showing a level of acceptability similar to or higher than that of the first segment.
5. Discussion and Conclusions
From this study we conclude that the current contractual configuration added to the existing bureaucracy in the organizational maps of public institutions generate rigid and conflicting elements. One of these points, according to the data processing, is the release of land and interference, since this parameter is key and is a critical point that the Peruvian State does not clearly define, at least in the contracts analyzed in this study, generating stagnation in the programmed investment and prolonging the objectives of the contracts, allowing the emergence of addenda, since the grantor offers deadlines that become uncertain, giving rise to controversies that later lead to arbitration. The present model, based on the literature, proposes the use of BIM information management tools, since this tool allows the transparency of various processes throughout the infrastructure life cycle [], which is why the process maps shown include suggestions from NTP-ISO 19650-1:2021 [] and NTP-ISO 19650-2:2021 [], which allows an alignment with regard to the standardization of processes in the public sector and in turn we align ourselves to the BIM Peru plan proposed by the Peruvian State in which it is proposed to integrate BIM in all areas of the public sector by 2030.
Also, within the wide range of existing international standard contracts, for the model shown we chose the NEC4 Option F contracts, because we found a synergy between the NEC and BIM, specifically in clause X10 (information modeling). It is worth mentioning that before considering the use of this type of contract, as part of the literature review [], we consulted the Peruvian Law of Public–Private Partnerships, which in its latest update allows the use of standardized contracts and, in turn, the Peruvian State already has successful experience in the use of this type of contract in the 2019 Pan American Games held in the city of Lima.
For the validation of the model, the Delphi methodology was used, in which specialists related to contract management, professionals involved in the technical operational part of PPP projects, civil engineers by profession, as well as professionals in charge of the legal part, such as lawyers with expertise in arbitration issues, were summoned [,,]. These professionals evaluated the management model through surveys in which the recommendations of the experts were taken into account with the objective of improving the model in iterative processes. The panel of experts evaluated and approved the management model with a percentage of more than 70% of the total number of respondents, assuring under their opinion that the proposal is accurate and viable for the optimization of PPP contracts in the Peruvian case study.
As a recommendation for future research it is proposed to include financing factors, as the present research stipulated that this parameter is a critical point at the time of project formulation either by state or private initiative []. Considering this parameter we could evaluate how BIM from its 5D and 7D dimensions could help to improve certain indicators generated by project finance in a PPP project [], as well as the inclusion of other types of standardized contracts such as those of FIDIC, IPD, collaborative contracts such as PPC 2000, and sustainable contracts that would have an interesting synergy with the landscape information model (LIM) [], with the objective of generating alternatives for improvement in the formulation, execution, and operation and maintenance of PPP projects in Peru and Latin America.
Author Contributions
Conceptualization, F.R.M.V.; Methodology, F.R.M.V. and X.B.; Formal analysis, F.R.M.V. and X.B.; Investigation, F.R.M.V.; Resources, F.R.M.V. and X.B.; Data curation, F.R.M.V.; Writing—original draft, F.R.M.V.; Writing—review & editing, X.B.; Visualization, F.R.M.V.; Project administration, F.R.M.V. All authors have read and agreed to the published version of the manuscript.
Funding
This research has been funded by the Vice-Rectorate for Research of the Catholic University of Santa Maria.
Data Availability Statement
The original contributions presented in the study are included in the article, further inquiries can be directed to the corresponding author.
Conflicts of Interest
The authors declare no conflict of interest.
References
- Infrascopio. Capacidad de los Países para Movilizar Inversión Privada a Través de Asociaciones Público-Privadas (APP); Economist Impact: London, UK, 2019. [Google Scholar]
- Organización para la Cooperación y el Desarrollo Económicos. In-depth Analysis and Recommendations. In Multi-Dimensional Review of Peru; Organización para la Cooperación y el Desarrollo Económicos: Paris, France, 2016; Volume 2. [Google Scholar]
- Foro Económico Mundial. The Global Competitiveness Report; Foro Económico Mundial: Cologny, Switzerland, 2017. [Google Scholar]
- PNIC. Plan Nacional de Infraestructuras Para la Competitividad. 2019. Available online: https://www.mef.gob.pe/contenidos/inv_privada/planes/PNIC_2019.pdf (accessed on 18 August 2024).
- MEF. Guia Nacional BIM; MEF: Camp Pendleton, Calif, 2023; pp. 17–28. [Google Scholar]
- Contraloría General de la República del Perù. Reporte de Obras Paralizadas en el Territorio Nacional; Contraloría General de la República del Perú: Jesús María, Peru, 2022; pp. 1–79. [Google Scholar]
- INTERNATIONAL STANDARD 19650 1:2; Organization and Digitization of Information about Buildings and Civil Engineering Works, including Building Information Modelling (BIM)—Information Management Using Building Information Modelling. ISO: Geneva, Switzerland, 2022.
- Hallowell, M.R.; Gambatese, J.A. Qualitative research: Application of the Delphi method to CEM research. J. Constr. Eng. Manag. 2010, 136, 99–107. [Google Scholar] [CrossRef]
- Campos Medina, A.; Bedoya Aranda, N. Towards collaborative contract management in public works in Perú: Implementation proposals. Derecho Soc. 2020, 163–174. [Google Scholar]
- Regjo, E.F. The inclusion of collaborative processes in the contract to achieve high performance construction projects. Derecho Soc. 2020, 21. [Google Scholar]
- Abougamil, R.A.; Thorpe, D.; Heravi, A. Investigating the Source of Claims with the Importance of BIM Application on Reducing Construction Disputable Claims in KSA. Buildings 2023, 13, 2219. [Google Scholar] [CrossRef]
- Nkunda, R.M.; Kazungu, I.; Changalima, I.A. Collaborative Procurement Practices in Public Organizations: A Review of Forms, Benefits and Challenges. Ghana J. Dev. Stud. 2023, 20, 1–18. [Google Scholar] [CrossRef]
- Yabar-Ardiles, O.; Sanchez-Carigga, C.; Vigil, A.J.E.; Málaga, M.S.G.; Zevallos, A.A.M. Seeking the Optimisation of Public Infrastructure Procurement with NEC4 ECC: A Peruvian Case Study. Buildings 2023, 13, 2828. [Google Scholar] [CrossRef]
- Yeung, J.F.Y.; Chan, D.W.M.; Chan, J.H.L.; Lok, K.L. Development of a Composite Project Performance Index for the New Engineering Contract (NECPPI) of construction projects in Hong Kong: A Delphi study. Int. J. Constr. Manag. 2022, 23, 2804–2817. [Google Scholar] [CrossRef]
- Taylor, F. Nec 4 Contract: Early Contractor Involvement (ECI); HKA: London, UK, 2015; pp. 1–3. [Google Scholar]
- REALES. Industria 4.0: La Undécima Revolucion. Available online: https://www.areales.com/industria-4-0-la-undecima-revolucion/ (accessed on 18 August 2024).
- Campos, M.A.; Bedoya, A.N. Hacia la administración contractual colaborativa en la obra pública en el Perú: Propuestas de aplicación. Derecho Soc. 2020, 55, 163–174. [Google Scholar]
- Kaleem, U.; Irene, L.; Emlyn, W. An Overview of BIM Adoption in the Construction Industry: Benefits and Barriers. In Emerald Reach Proceedings Series, 7, Proceedings of the 10th Nordic Conference on Construction Economics and Organization, Tallinn, Estonia, 7–8 May 2019; Emerald Publishing Limited: Bingley, UK, 2019. [Google Scholar] [CrossRef]
- Cheng, J.C.P.; Lu, Q. A Review of the Efforts and Roles of the Public Sector for BIM Adoption Worldwide. J. Inf. Technol. Constr. 2015, 20, 442–478. [Google Scholar]
- Devlin, R.T.; Moguillansky, G. Alianzas público-privadas como estrategias nacionales de desarrollo a largo plazo. Rev. CEPAL 2009, 2009, 97–116. [Google Scholar] [CrossRef]
- Sergio, A. Hinojosa et al. In Análisis Costo-Beneficio Integral Para Evaluar la Convivencia de Aplicar Esquemas de Asociaciones Público-Privadas en América Latina y El Caribe; Nota Tecnica IDB-TN-01925; BID: Milan, Italy, 2020; pp. 1–95. [Google Scholar]
- Collao, J.; Lozano-Galant, F.; Lozano-Galant, J.A.; Turmo, J. BIM Visual Programming Tools Applications in Infrastructure Projects: A State-of-the-Art Review. Appl. Sci. 2021, 11, 8343. [Google Scholar] [CrossRef]
- Bonifaz, J.; Fasanando, A. Asociaciones Público-Privadas Versus Obra Pública: Una Comparación Para el Caso de Redes Viales en Perú y la Región. Red de Análisis y Buenas Prácticas en Asociaciones Público-Privadas (Red APP) BID; IADB (Inter-American Development Bank): Washington, DC, USA, 2019; pp. 1–106. [Google Scholar]
- Ahmed, M.; Camilo, R. The implementation of the early warning system for the paradigm shift towards efficient and collaborative project management. Derecho Soc. 2020, 145–161. [Google Scholar]
- Cisneros-Herrera, D.; Lara-Galera, A.; Alcaraz Carrillo de Albornoz, V.; Muñoz-Medina, B. Driving Peru’s Road Infrastructure: An Analysis of Public–Private Partnerships, Challenges, and Critical Success Factors. Buildings 2024, 14, 230. [Google Scholar] [CrossRef]
- Lee, G.; Borrmann, A. BIM policy and management. Constr. Manag. Econ. 2020, 38, 413–419. [Google Scholar] [CrossRef]
- Valdés, J.E. The Assignment of Risks in Collaborative Construction Contracts. Derecho Soc. 2020, 1–25. [Google Scholar]
- Shiyao, K.; Alan, H.; Barry, M.; Roger, W. Public Sector BIM Adoption: Development and Evaluation of Government Policy Interventions: A Systematic Literature Review. In Proceedings of the 30th EG-ICE: International Conference on Intelligent Computing in Engineering, London, UK, 4–7 July 2023; pp. 1–10. [Google Scholar]
- Esteves, V.; Sanhudo, L.; Costa, A.A. Revisão Sistemática Sobre a Integração de Smart Contracts e BIM No Ambiente Construtivo; Collaborative Laboratory for the Future Built Environment: Porto, Portugal, 2020. [Google Scholar]
- MEF. Asociaciones Público Privadas (APP)—PROINVERSION. 2021. Available online: https://www.mef.gob.pe/es/?option=com_content&language=es-ES&Itemid=101931&lang=es-ES&view=article&id=3971 (accessed on 18 August 2024).
- Ardila-Gomez, J.; Rosero-Medina, A. Framework for Managing Risks with the Managing Contractor and Other Project Delivery Models. In Proceedings of the International Conference on Engineering and Technology (IACSIT), 14–16 October 2020; Volume 80, pp. 14–19. [Google Scholar]
- Khadka, P.; Lehtomäki, J.; Länsiluoto, A. Evaluación y predicción del rendimiento de los contratos de construcción. Estud. Informática Ing. Construcción 2019, 15, 21–41. [Google Scholar]
- Shafik, N.; Qodsi, S.; Serag, E.; Helmi, M. Application of FIDIC Contracts under the Egyptian Civil Code. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2016, 8, 04516004. [Google Scholar] [CrossRef]
- Eriksson, P.E.; Volker, L.; Kadefors, A.; Lingegård, S.; Larsson, J.; Rosander, L. Collaborative procurement strategies for infrastructure projects: A multiple-case study. Manag. Procure. Law 2019, 172, 197–205. [Google Scholar] [CrossRef]
- Rankin, J.; Jameson, P.; Yarwood, N. NEC X12 at the heart of Worcestershire Highways. Proc. Inst. Civ. Eng. 2007, 160, 31–36. [Google Scholar] [CrossRef]
- Lau, C.H.; Mesthrige, J.W.; Lam, P.T.I.; Javed, A.A. The challenges of adopting new engineering contract: A Hong Kong study. Eng. Constr. Arch. Manag. 2019, 26, 2389–2409. [Google Scholar] [CrossRef]
- Figueroa, V.J.E. La distribución de los riesgos en los contratos colaborativos de construcción. Derecho Soc. 2020, 55, 197–221. [Google Scholar]
- Flores, J.C. Government to Government Agreements and New Engineering Contracts: Are They Solutions to Normative Deficiencies in State Contracting that could be Replicated by all Entities? Rev. IUS ET VERITAS 2019, 110–127. [Google Scholar]
- MEF. Decreto Legislativo N°1362, articulo 29. 2018. Available online: https://www.mef.gob.pe/es/?option=com_docman&language=es-ES&Itemid=101611&lang=es-ES&view=list&slug=decreto-legislativo (accessed on 18 August 2024).
- Bonifaz, J.; Fasanando, A. The use of propensity scores matching methodology for analysis of concession: The case of road networks in Peru. Case Stud. Transp. Policy 2022, 10, 2350–2357. [Google Scholar] [CrossRef]
- Suárez-Alemán, A.; Castrosin, M.P.; Fioravanti, R.; Bonifaz, J.L.; Chackiel, J.E.; Debaeke, P.; Lima, C.L.; Benozatti, E.; Campos-Serna, M.E.; Gil, S.P.; et al. Planificación y priorización en el desarrollo de infraestructura, y el rol de las asociaciones público-privadas—BID. En busca de una coordinación eficiente de los ciclos de inversión, presupuestario y de financiamiento en América Latina y Caribe. DOCUMENTO PARA DISCUSIÓN Nº IDB-DP-00867. 2021, pp. 1–67. Available online: https://publications.iadb.org/es/planificacion-y-priorizacion-en-el-desarrollo-de-infraestructura-y-el-rol-de-las-asociaciones (accessed on 18 August 2024).
- Gray, S.; Greener, S. Managing Risk in Public-Private Partnerships: Mapping Responsibility and Risk Sharing. J. Risk Manag. Financ. Inst. 2019, 12, 2–20. [Google Scholar]
- Puyo, C.; Stiglitze, T.; Yrigoyen, E. Asociaciones Público-Privadas en el Perú: Una Visión Amplia de Desempeño. Revista Electrónica de Investigación Educativa Especial, 18. Recuperado de. Available online: https://ref.scielo.org/f9hvgz (accessed on 18 August 2024).
- Servín, V.; Rodríguez, K. Razones por las Cuales Fracasan PPP en el Perú: El Compromiso Hacia el Desarrollo Colaborativo. Derecho Projects. Recuperado de. Available online: https://derechoprojects.com/blog/ppp-peru-desarrollo-colaborativo/ (accessed on 18 August 2024).
- Jerzak, K. The Design of Contracts for Public-Private Partnerships. CBOK Research Paper. Available online: https://www.cbok.com/wp-content/uploads/2020/04/CW200114_Jerzak_Design.pdf (accessed on 18 August 2024).
- Ministerio de Economía y Finanzas del Perú—Guía Nacional BIM. Guía Nacional BIM Gestión de la información para inversiones desarrolladas con BIM. Sistema Nacional de Programación Multianual y Gestión de Inversiones. 2023, pp. 1–291. Available online: https://www.mef.gob.pe/contenidos/inv_publica/anexos/anexo_RD003_2023EF6301.pdf (accessed on 18 August 2024).
- Bonifaz, J.L.; Urrunaga, R.; Aguirre, J.; Quequezana, P. Brecha de Infraestructura en el Perú. Estimación de la Brecha de Infraestructura de Largo Plazo 2019–2038; Bonifaz, J.L., Urrunaga, R., Aguirre, R., Quequezana, P., Eds.; IADB: Washington, DC, USA, 2020. [Google Scholar]
- Medina, F.J.C. Contratación pública y la experiencia de los Juegos Panamericanos. El modelo de gestión que promueve el gobierno. Rev. Derecho Adm. 2019, 18, 113–142. [Google Scholar]
- Linstone, H.A.; Turoff, M. The Delphi Method: Techniques and Applications; Addison-Wesley: London, UK, 1975. [Google Scholar]
- Okoli, C.; Pawlowski, S.D. The Delphi method as a research tool: An example, design considerations and applications. Inf. Manag. 2004, 42, 15–29. [Google Scholar] [CrossRef]
- Cruzado-Ramos, F.; Brioso, X. Sustainability Performance Evaluation in Building Projects by Integrating Lean and Sustainable Management Using the Delphi Method. In Proceedings of the 28th Annual Conference of the International Group for Lean Construction (IGLC), Berkeley, CA, USA, 6–10 July 2020; pp. 805–816. [Google Scholar]
- Mitera-Kiełbasa, E.; Zima, K. BIM Policy Trends in Europe: Insights from a Multi-Stage Analysis. Appl. Sci. 2024, 14, 4363. [Google Scholar] [CrossRef]
- Vigil, A.J.E. Infraestructure Asset Management, Local infraestructure governance in Peru: A systems thinking appraisal. Asset Manag. 2024, 11, 145–160. [Google Scholar] [CrossRef]
- World Bank. Public-Private Partnerships Reference Guide, 3rd ed.; World Bank: Washington, DC, USA, 2017. [Google Scholar]
- Paz, M. El Cofinanciamiento de las APP: Concepto, Naturaleza, Evolución y Experiencias. Rev. Derecho Soc. 2017, 49, 339–358. [Google Scholar]
- Andrzej, S.B.; Natalia, L. Landscape Information Model (LIM): A case studyof Ołtarzew Parkin Ożarów Mazowiecki municipality, Poland. Bud. Archit. 2023, 22, 41–56. Available online: https://ph.pollub.pl/index.php/bia/article/view/3547/3137 (accessed on 18 August 2024).
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2024 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
