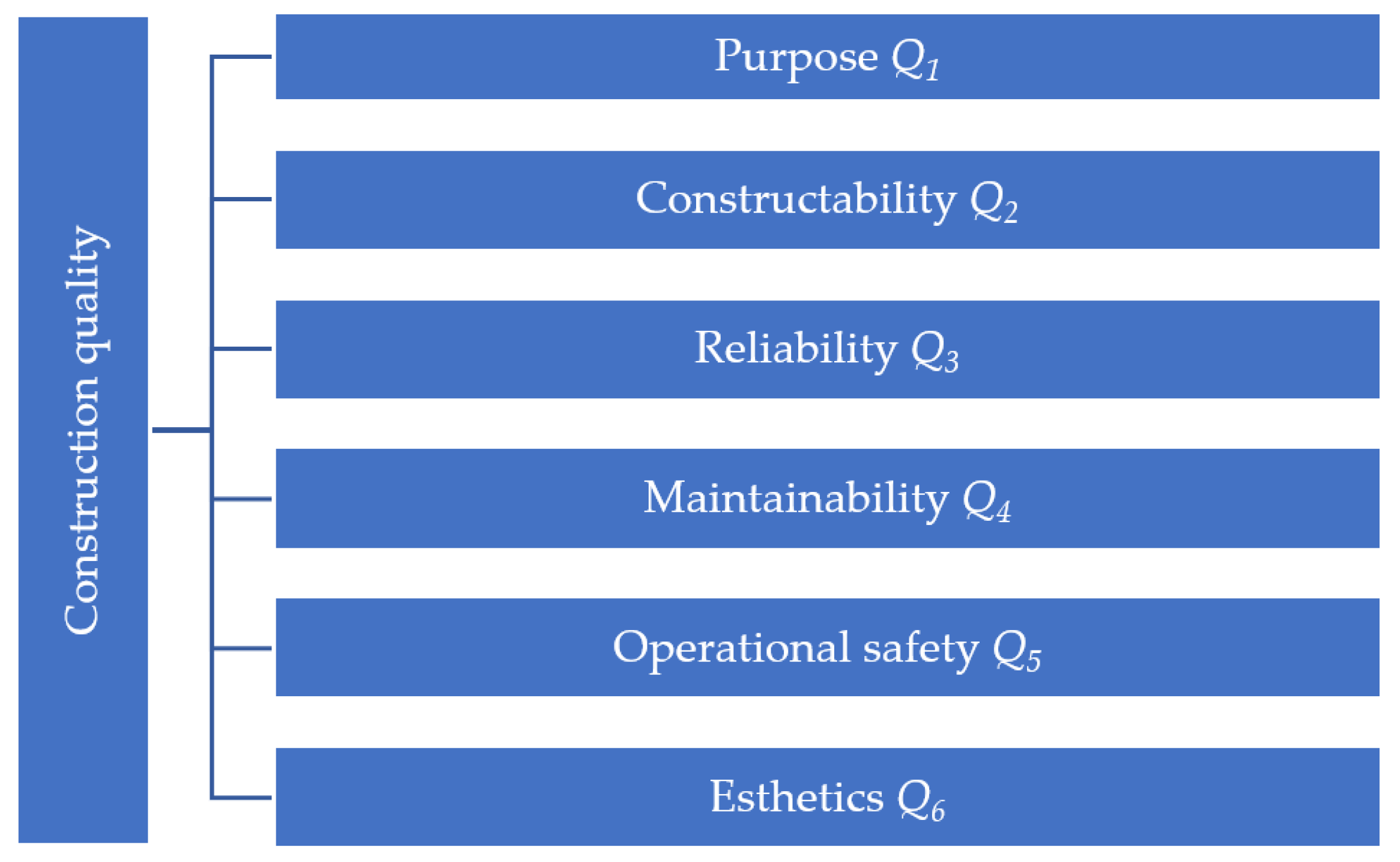

A Decision Support System for Organizing Quality Control of Buildings Construction during the Rebuilding of Destroyed Cities

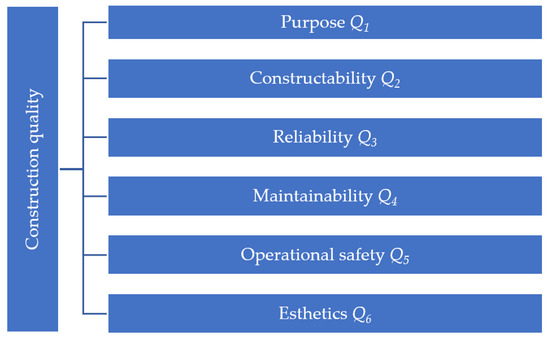

Abstract
1. Introduction
2. Literature Review
3. Materials and Methods
4. Results

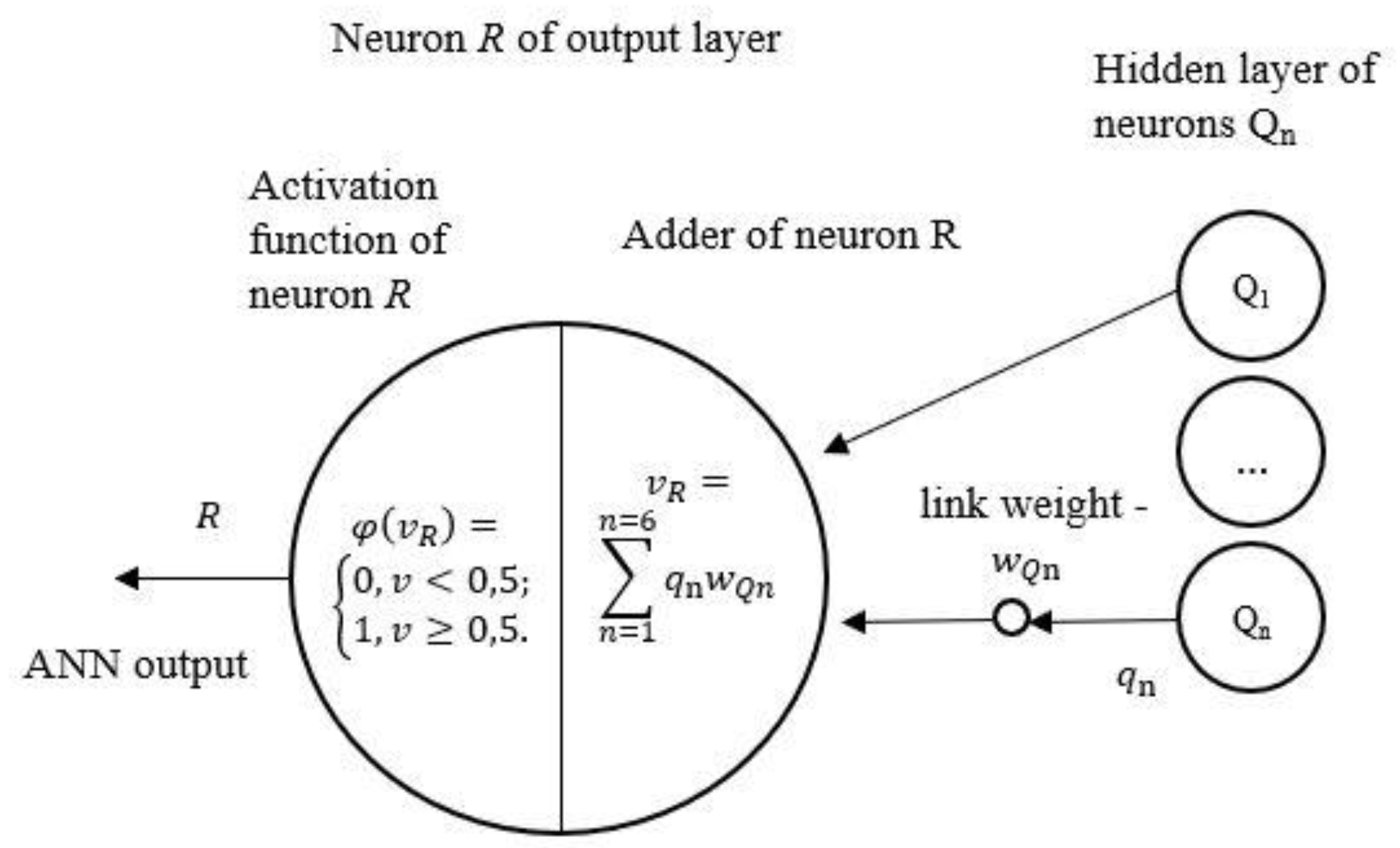

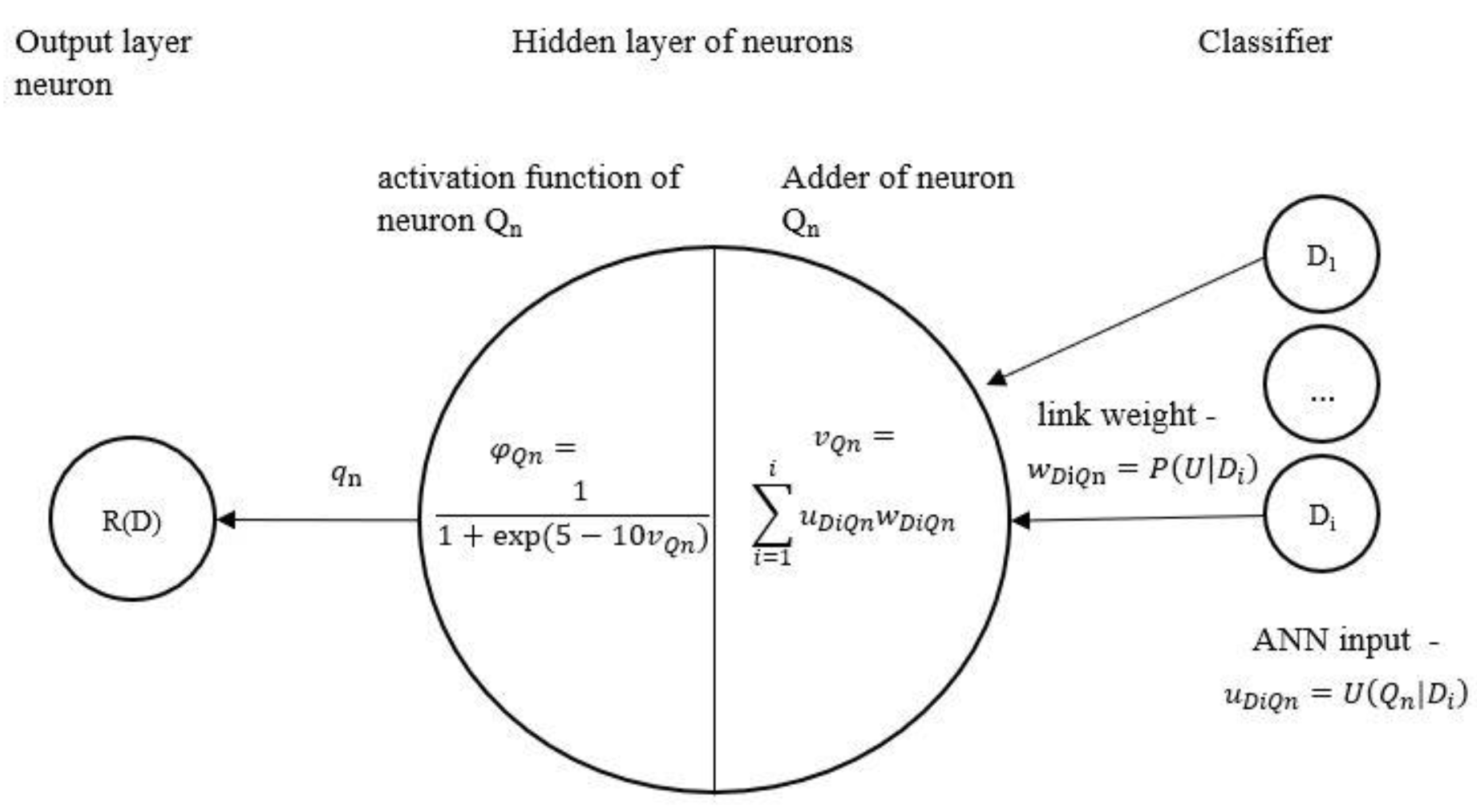

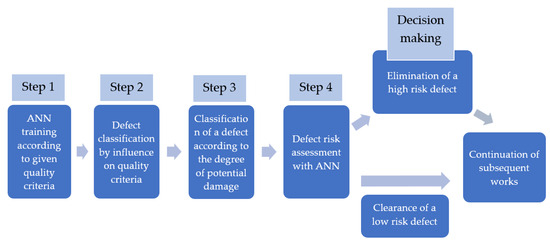

4.1. Preliminary Training of ANNs

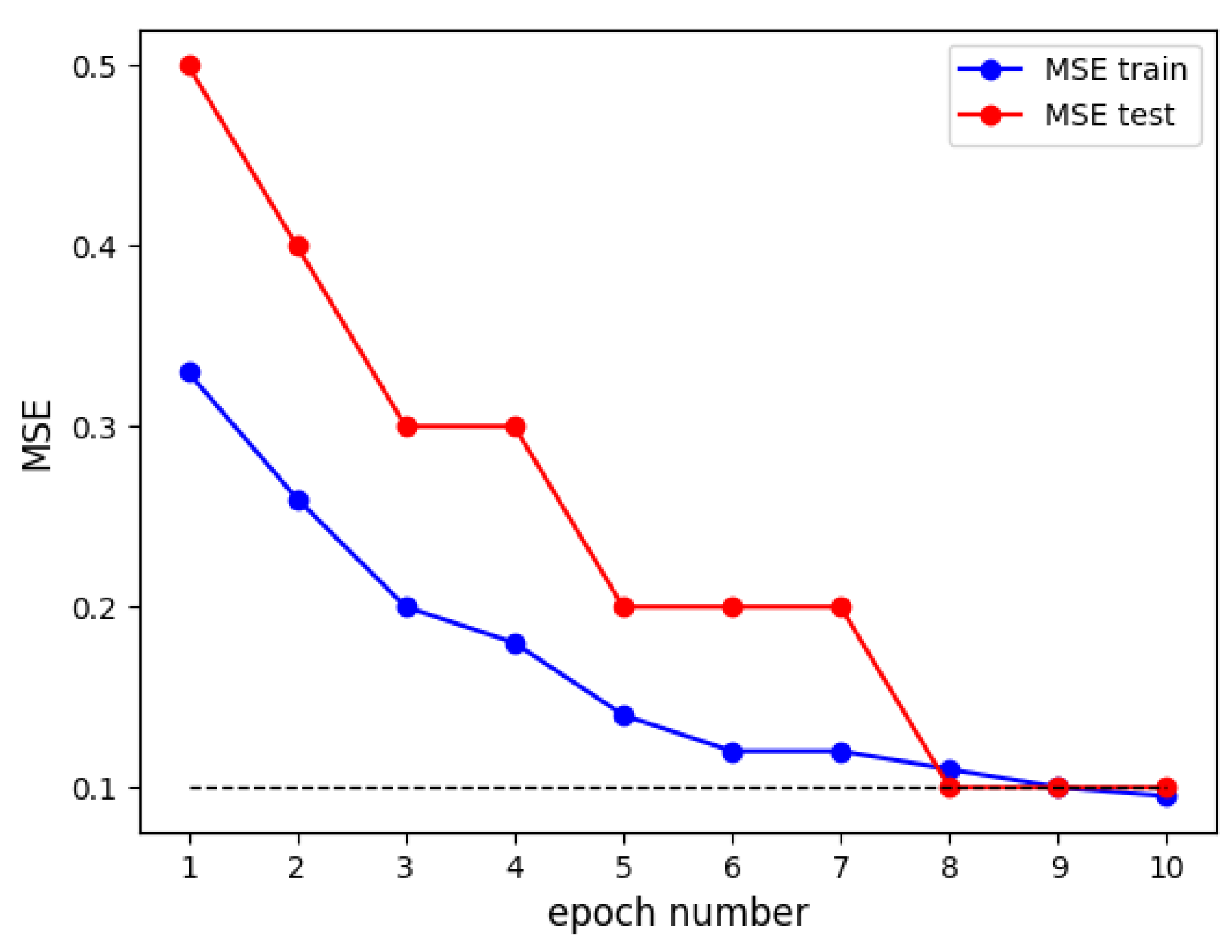

4.2. ANN Training
5. Discussion
6. Conclusions
- Reducing construction duration due to reduced costs of defect rework with a low risk level;
- Reduction in time for decision-making on defect criticality assessments;
- Reduction in financial costs by involving fewer experts for defect criticality assessments.
Author Contributions
Funding
Data Availability Statement
Conflicts of Interest
References
- Diaz, R.; Behr, J.; Acero, B. Coastal housing recovery in a postdisaster environment: A supply chain perspective. Int. J. Prod. Econ. 2022, 247, 108463. [Google Scholar] [CrossRef]
- Hamideh, S.; Peacock, W.; Van Zandt, S. Housing type matters for pace of recovery: Evidence from Hurricane Ike. Int. J. Disaster Risk Reduct. 2021, 57, 102149. [Google Scholar] [CrossRef]
- Lin, C.-L.; Chen, B.-K. Research for Risk Management of Construction Projects in Taiwan. Sustainability 2021, 13, 2034. [Google Scholar] [CrossRef]
- Bhandari, S.; Riggio, M.; Jahedi, S.; Fischer, E.; Muszynski, L.; Luo, Z. A review of modular cross laminated timber construction: Implications for temporary housing in seismic areas. J. Build. Eng. 2023, 63, 105485. [Google Scholar] [CrossRef]
- Maracchini, G.; D’Orazio, M. Improving the livability of lightweight emergency architectures: A numerical investigation on a novel reinforced-EPS based construction system. Build. Environ. 2022, 208, 108601. [Google Scholar] [CrossRef]
- Faragallah, R. Fundamentals of temporary dwelling solutions: A proposed sustainable model for design and construction. Ain Shams Eng. J. 2021, 12, 3305–3316. [Google Scholar] [CrossRef]
- Komatsuzaki, N.; Otsuyama, K.; Hiroi, U. How the choice of temporary housing impacts on widespread displacement after large-scale flooding? A disaster recovery simulation in Tokyo metropolitan area. Int. J. Disaster Risk Reduct. 2022, 81, 103243. [Google Scholar] [CrossRef]
- Qin, M.; Chew, B.; Yau, Y.; Yang, Z.; Han, X.; Chang, L.; Liu, Y.; Pan, S. Characteristic analysis and improvement methods of the indoor thermal environment in post-disaster temporary residential buildings: A systematic review. Build. Environ. 2023, 235, 110198. [Google Scholar] [CrossRef]
- Faculty of Societal Safety Sciences (Ed.) Chapter 3—Current Status of Rebuilding Houses and Reconstructing Local Regions after the Great East Japan Earthquake. In The Fukushima and Tohoku Disaster; Butterworth-Heinemann: Oxford, UK, 2018; pp. 47–69. [Google Scholar] [CrossRef]
- Messaoudi, M.; Nawari, O. BIM-based Virtual Permitting Framework (VPF) for post-disaster recovery and rebuilding in the state of Florida. Int. J. Disaster Risk Reduct. 2019, 42, 101349. [Google Scholar] [CrossRef]
- Das, A.; Haldar, A. Health assessment of structures exposed to seismic excitations. ISET J. Earthq. Technol. 2011, 48, 11–27. [Google Scholar]
- Fayazi, M.; Lizarralde, G. Conflicts between recovery objectives: The case of housing reconstruction after the 2003 Earth quake in Bam, Iran. Int. J. Disaster Risk Reduct. 2017, 27, 317–328. [Google Scholar] [CrossRef]
- Haddow, G.; Bullock, J.; Coppola, D. The Disciplines of Emergency Management: Recovery. In Introduction to Emergency Management, 6th ed.; Butterworth-Heinemann: Oxford, UK, 2017; pp. 281–330. [Google Scholar] [CrossRef]
- Mercader-Moyano, P.; Camporeale, P.; Serrano-Jiménez, A. Integrated urban regeneration for high-rise multi-family buildings by providing a multidimensional assessment model and decision support system. J. Build. Eng. 2023, 76, 107359. [Google Scholar] [CrossRef]
- Mukilan, K.; Rameshbabu, C.; Velumani, P. A modified particle swarm optimization for risk assessment and claim management in engineering procurement construction projects. Mater. Today Proc. 2021, 42, 786–794. [Google Scholar] [CrossRef]
- He, X.; Jeong, C.E. Modeling the damage and recovery of interdependent critical infrastructure systems from natural hazards. Reliab. Eng. Syst. Saf. 2018, 177, 162–175. [Google Scholar] [CrossRef]
- Ebekozien, A.; Aigbavboa, C.; Samsurijan, M.; Firdaus, R.; Ayo-Odifiri, S.; Amadi, G. Disasters recovery and rehabilitation in informal settlements: The role of fourth industrial revolution technologies. Int. J. Constr. Manag. 2023, 2023, 1–11. [Google Scholar] [CrossRef]
- Egorochkina, I.; Shlyakhova, E. Express Method of Examination of Construction Units of Buildings and Structures. In Networked Control Systems for Connected and Automated Vehicles; Springer: Cham, Swizterland, 2022; Volume 509. [Google Scholar] [CrossRef]
- Huang, X.; Bei, Y.; Sui, L.; Li, L.; Hu, B.; Zhou, Y. Reliability assessment on maximum crack width of concrete beams reinforced with high-strength steel bars. J. Build. Eng. 2022, 45, 103564. [Google Scholar] [CrossRef]
- Senthil, J.; Muthukannan, M. Predication of construction risk management in modified historical simulation statistical methods. Ecol. Inform. 2021, 66, 101439. [Google Scholar] [CrossRef]
- Abdollahzadeh, G.; Rastgoo, S. Risk Assessment in Bridge Construction Projects Using Fault Tree and Event Tree Analysis Methods Based on Fuzzy Logic. ASCE-ASME J. Risk Uncert. Engrg. Sys. Part B Mech. Eng. 2015, 1, 031006. [Google Scholar] [CrossRef]
- Renuka, S.; Kamal, S.; Umarani, C. A model to estimate the time overrun risk in construction projects. Empir. Res. Urban Manag. 2017, 12, 64–76. [Google Scholar]
- Kozień, E.; Kozień, M. Ex-Ante Risk Estimation in the Production Project. Syst. Saf. Hum. Tech. Facil. Environ. 2019, 1, 708–715. [Google Scholar] [CrossRef]
- Enny, M.; Purba, H. Construction Project Risk Analysis Based on Fuzzy Analytical Hierarchy Process (F-AHP): A Literature Review. Adv. Res. Civ. Eng. 2021, 3, 1–20. [Google Scholar]
- Belal, A.; Shcherbina, E. Heritage in post-war period challenges and solutions. IFAC Pap. 2019, 52, 252–257. [Google Scholar] [CrossRef]
- Junichi, K.; Masayuki, K.; Shinji, M.; Hideaki, T.; Torajiro, F. Damage to railway earth structures and foundations caused by the 2011 off the Pacific Coast of Tohoku Earthquake. Soils Found. 2012, 52, 872–889. [Google Scholar] [CrossRef]
- Lozano, J.; Tien, I. Data collection tools for post-disaster damage assessment of building and lifeline infrastructure systems. International. J. Disaster Risk Reduct. 2023, 94, 103819. [Google Scholar] [CrossRef]
- Goyal, P.; Datta, T. Effect of wind directionality on the vulnerability of rural houses due to cyclonic wind. Nat. Hazards Rev. 2013, 14, 258–267. [Google Scholar] [CrossRef]
- Fujiwara, T.; Suzuki, Y.; Kitahara, A. Risk management for urban planning against strong earthquakes. In Post-Earthquake Rehabilitation and Reconstruction; Cheng, F., Wang, Y., Eds.; Pergamon Press: Oxford, UK, 1996; pp. 131–145. [Google Scholar] [CrossRef]
- Owen, J. Windborne debris in the urban environment. Tech. Trans. 2015, 112, 145–165. [Google Scholar]
- Mashwama, N.; Aigbavboa, C.; Thwala, D. An Assessment of the Critical Success factor for The Reduction of Cost of Poor Quality in Construction Projects in Swaziland. Procedia Eng. 2017, 196, 447–453. [Google Scholar] [CrossRef]
- Oshungade, O.; Kruger, D. A comparative study of causes and effects of project delays and disruptions in construction projects in the south african construction industry. J. Constr. Eng. Proj. Manag. 2017, 7, 13–25. [Google Scholar] [CrossRef]
- Adeyemi, A.; Masalil, K. Delay Factors and Time-Cost Performance of Construction Projects in Gaborone City Council, Botswana. J. Adv. Perform. Inf. Value 2016, 8, 4–18. [Google Scholar] [CrossRef]
- Viles, E.; Rudell, N.; Santilli, A. Causes of delay in construction projects: A quantitative analysis. Eng. Constr. Archit. Manag. 2019, 27, 917–935. [Google Scholar] [CrossRef]
- Qudah, A.; Battaineh, H. Causes of construction delay: Traditional contracts. Int. J. Proj. Manag. 2002, 20, 67–73. [Google Scholar] [CrossRef]
- Tahmasebinia, F. Significant Factors Causing Delay in the Cambodian Construction Industry. Sustainability 2022, 14, 3521. [Google Scholar] [CrossRef]
- Adamu, N. Time implication of delays in construction projects in Addis Ababa city. SSRN Electron. J. 2022, 2022, 1–17. [Google Scholar] [CrossRef]
- Mamdouh, M.; Tran, D. Risk-based inspection for concrete pavement construction using fuzzy sets and bayesian networks. Autom. Constr. 2021, 128, 103761. [Google Scholar] [CrossRef]
- Love, P.; Matthews, J. Quality, requisite imagination and resilience: Managing risk and uncertainty in construction. Reliability Eng. Syst. Saf. 2020, 204, 107172. [Google Scholar] [CrossRef]
- Chen, L.; Lu, Q.; Han, D. A Bayesian-driven Monte Carlo approach for managing construction schedule risks of infrastructures under uncertainty. Expert Syst. Appl. 2023, 212, 118810. [Google Scholar] [CrossRef]
- Nasirzadeh, F.; Kashi, M.; Khanzadi, M.; Carmichael, D.; Akbarnezhad, A. A hybrid approach for quantitative assessment of construction projects risks: The case study of poor quality concrete. Comput. Ind. Eng. 2019, 131, 306–319. [Google Scholar] [CrossRef]
- Ma, G.; Wu, M.; Wu, Z.; Yang, W. Single-shot multibox detector- and building information modeling-based quality inspection model for construction projects. J. Build. Eng. 2021, 38, 102216. [Google Scholar] [CrossRef]
- Chow, J.; Liu, K.; Tan, P.; Su, Z.; Wu, J.; Li, Z.; Wang, Y. Automated defect inspection of concrete structures. Autom. Constr. 2021, 132, 103959. [Google Scholar] [CrossRef]
- Hüthwohl, P.; Lu, R.; Brilakis, I. Multi-classifier for reinforced concrete bridge defects. Autom. Constr. 2019, 105, 102824. [Google Scholar] [CrossRef]
- Chew, M. Defect analysis in wet areas of buildings. Constr. Build. Mater. 2005, 19, 165–173. [Google Scholar] [CrossRef]
- Uchaeva, T.V.; Loganina, V.I. Analysis of the risk at the finishing of the building products and construction of paint compositions. Case Stud. Constr. Mater. 2018, 8, 213–216. [Google Scholar] [CrossRef]
- May, K.W.; KC, C.; Ochoa, J.J.; Gu, N.; Walsh, J.; Smith, R.T.; Thomas, B.H. The Identification, Development, and Evaluation of BIM-ARDM: A BIM-Based AR Defect Management System for Construction Inspections. Buildings 2022, 12, 140. [Google Scholar] [CrossRef]
- Yoon, S.; Son, S.; Kim, S. Design, Construction, and Curing Integrated Management of Defects in Finishing Works of Apartment Buildings. Sustainability 2021, 13, 5382. [Google Scholar] [CrossRef]
- Lapidus, A.; Topchiy, D.; Kuzmina, T.; Shesterikova, Y.; Bidov, T. An integrated quality index of high-rise residential buildings for all lifecycle stages of a construction facility. Appl. Sci. 2023, 13, 2014. [Google Scholar] [CrossRef]
- Lapidus, A.; Topchiy, D.; Kuzmina, T.; Chapidze, O. Influence of the Construction Risks on the Cost and Duration of a Project. Buildings 2022, 12, 484. [Google Scholar] [CrossRef]
- Lapidus, A.A.; Makarov, A.N. Risk-based approach for the organization of construction supervision of the developer. AIP Conf. Proc. 2022, 2559, 060003. [Google Scholar] [CrossRef]
- Makarov, A. Organization of construction quality control based on a priori risks of works. International. J. Eng. Trends Technol. 2023, 71, 134–140. [Google Scholar] [CrossRef]
- Meijer, F.; Visscher, H. Quality control of constructions: European trends and developments. Int. J. Law Built Environ. 2017, 9, 143–161. [Google Scholar] [CrossRef][Green Version]
- Baiburin, A. Civil Engineering Quality Assessment in Terms of Construction Safety Index. Procedia Eng. 2017, 206, 800–806. [Google Scholar] [CrossRef]
- Park, Y.-J.; Yi, C.-Y. Resource-Based Quality Performance Estimation Method for Construction Operations. Appl. Sci. 2021, 11, 4122. [Google Scholar] [CrossRef]
- ISO 13824:2009; Bases for Design of Structures—General Principles on Risk Assessment of Systems Involving Structures. International Organization for Standardization (ISO): Geneva, Switzerland, 2009.
- Kaneko, F.; Yuzui, T. Novel method of dynamic event tree keeping the number of simulations in risk analysis small. Reliab. Eng. Syst. Saf. 2023, 231, 109009. [Google Scholar] [CrossRef]
- Yılmaz, E.; German, B.; Pritchett, A. Optimizing resource allocations to improve system reliability via the propagation of statistical moments through fault trees. Reliab. Eng. Syst. Saf. 2023, 230, 108873. [Google Scholar] [CrossRef]
- Andrews, J.; Tolo, S. Dynamic and dependent tree theory (D2T2): A framework for the analysis of fault trees with dependent basic events. Reliab. Eng. Syst. Saf. 2023, 230, 108959. [Google Scholar] [CrossRef]
- Efron, B. Bootstrap methods: Another look at the Jackknife. Ann. Stat. 1979, 7, 1–26. [Google Scholar] [CrossRef]
- Breiman, L. Bagging predictors. Mach. Learn. 1996, 24, 123–140. [Google Scholar] [CrossRef]
- Tibshirani, R.; Tibshirani, R. A bias correction for the minimum error rate in cross-validation. Ann. Appl. Stat. 2009, 3, 822–829. [Google Scholar] [CrossRef]

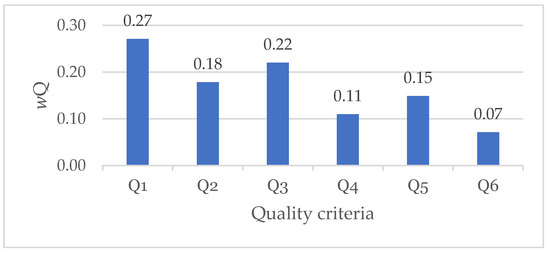

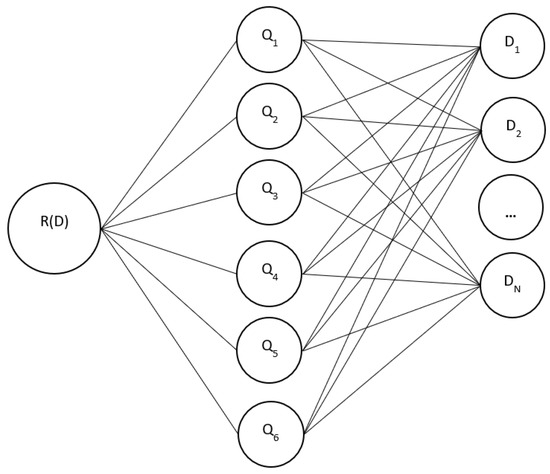

No | Name of the Defect (Di) | Quality Criteria (Qn) |
---|---|---|
1 | Reduction in the strength of the concrete structure | Q1, Q3, Q4, Q5 |
2 | Reduction in frost resistance, water resistance of concrete | Q3, Q4 |
3 | Cracks in concrete with an opening width of more than 0.2 mm | Q1, Q3, Q5, Q6, Q4 |

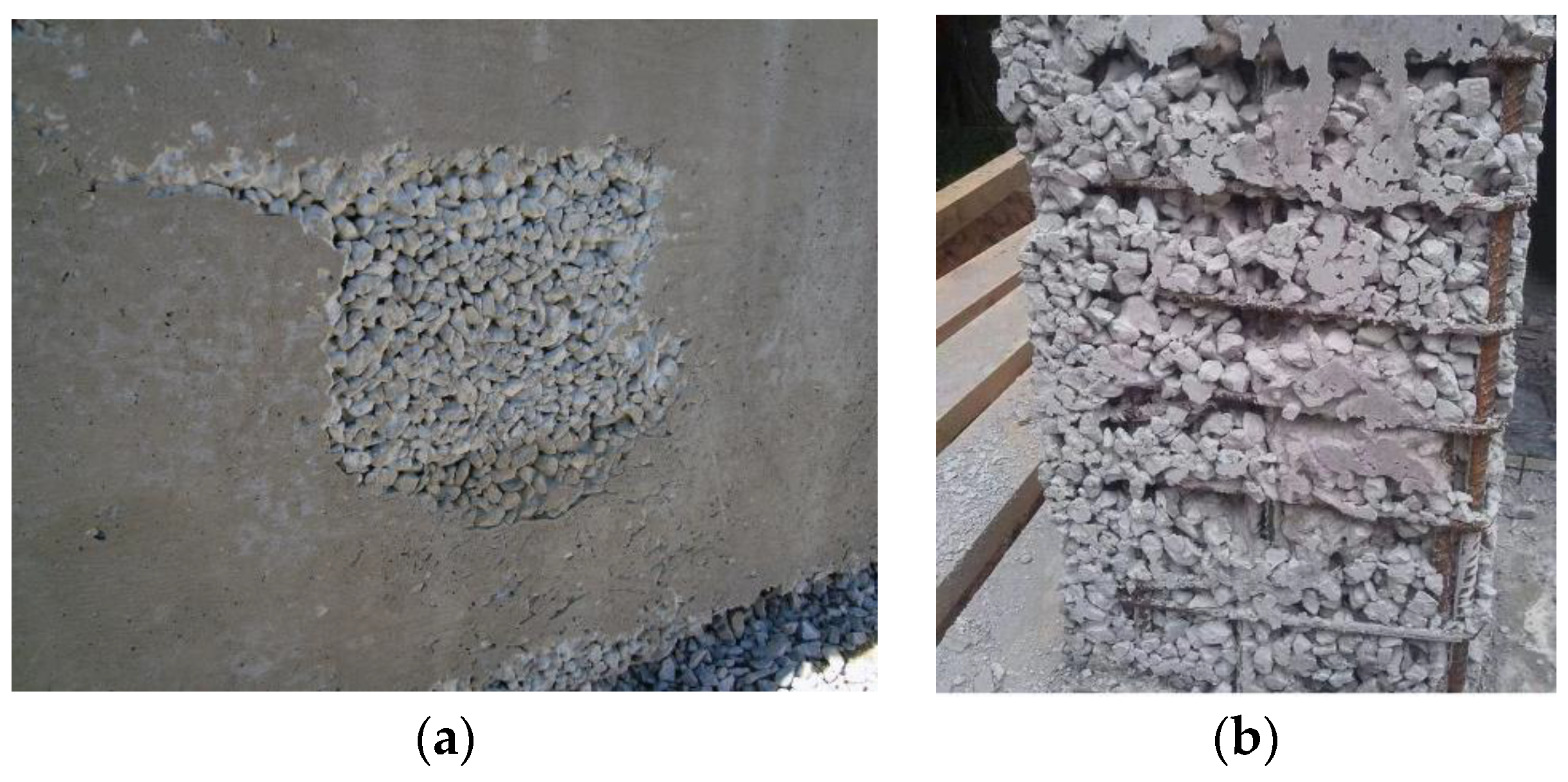

4 | Areas of unconsolidated concrete | Q1, Q3, Q5, Q6, Q4 |
5 | Reduction in the concrete cover | Q3, Q5, Q4 |
6 | Vertical deviation, straightness, horizontality of structure, deviations of the cross-section dimensions | Q1, Q2, Q3, Q5, Q4, Q6 |
7 | Irregularities and chips on the concrete surface | Q3, Q4 |
8 | Grease and rust stains on the concrete surface | Q6, Q4 |
9 | Reduction in the diameter, distance and/or quantity of the reinforcement | Q1, Q3, Q4, Q5 |
10 | Violations when connecting reinforcement | Q1, Q3, Q4, Q5 |
11 | Increased level of chemical/radiation contamination of concrete | Q5, Q4 |
12 | Reduction in the strength of the concrete structure | Q1, Q3, Q4, Q5 |
13 | Reduction in frost resistance, water resistance of concrete | Q1, Q3, Q4, Q5 |

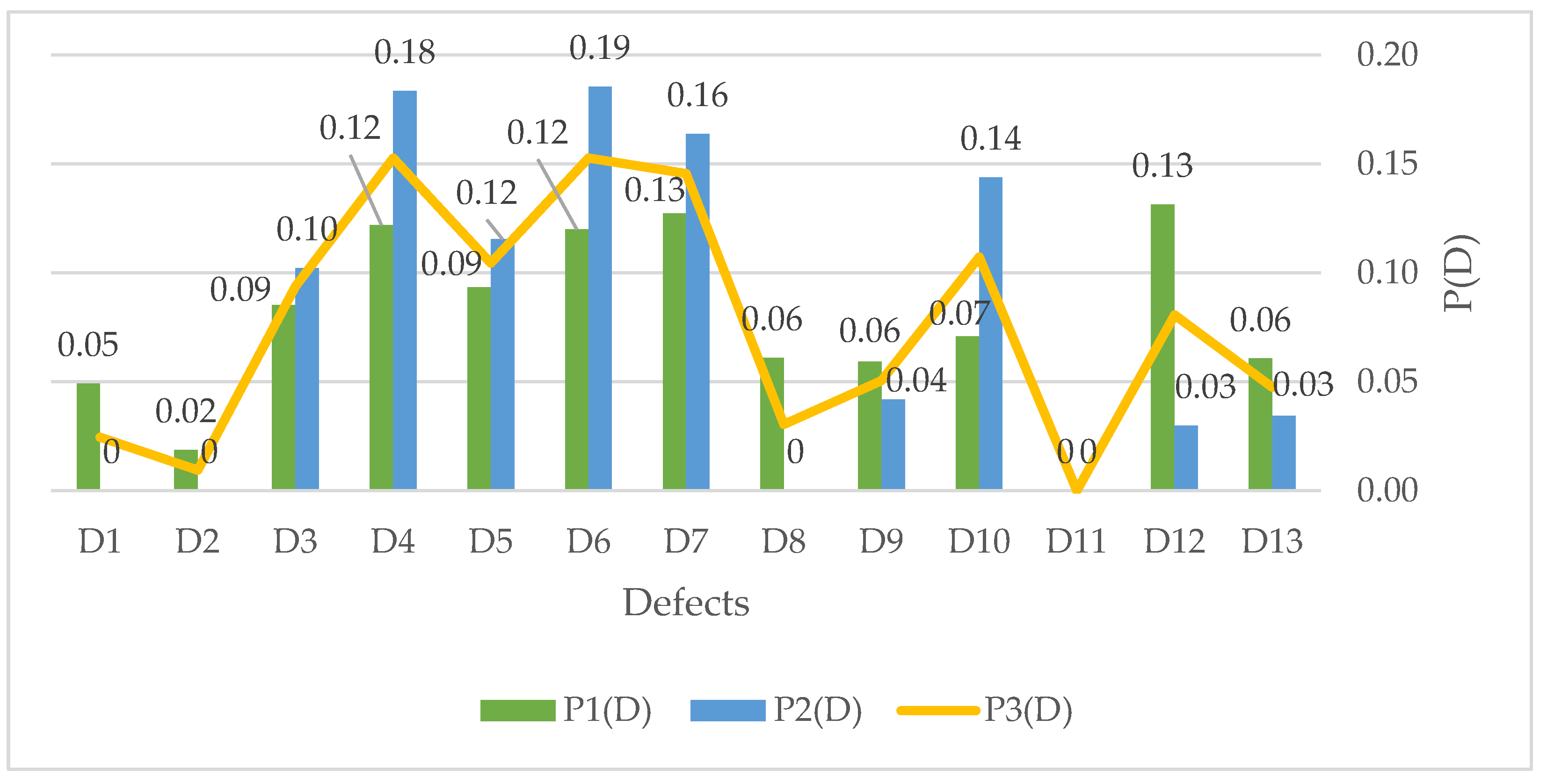

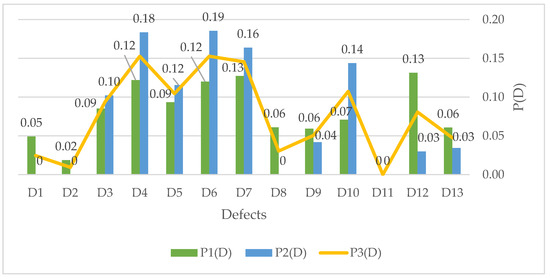

No | Defect Category by Potential Damage | ANN Input Value |
---|---|---|
1 | Permissible defect | 0 |
2 | Significant defect where the structure with reduced quality against the Qn criterion can be operated | 0.5 |
3 | Critical defect where the use of construction products is limited or impossible against the Qn quality criterion | 1 |
No | Name of the Defect (Di) | ||||
---|---|---|---|---|---|
1 | Reduction in the strength of the concrete structure | 0.02 | 0.07 | 0.21 | 0.60 |
2 | Reduction in frost resistance, water resistance of concrete | 0.01 | 0.03 | 0 | 0 |

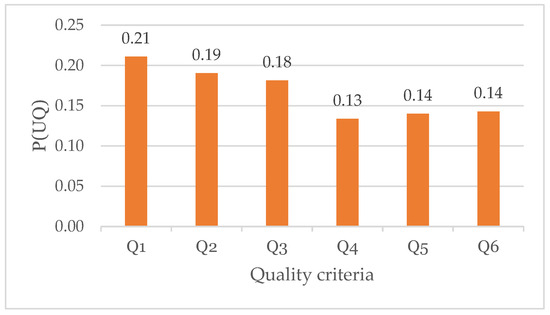

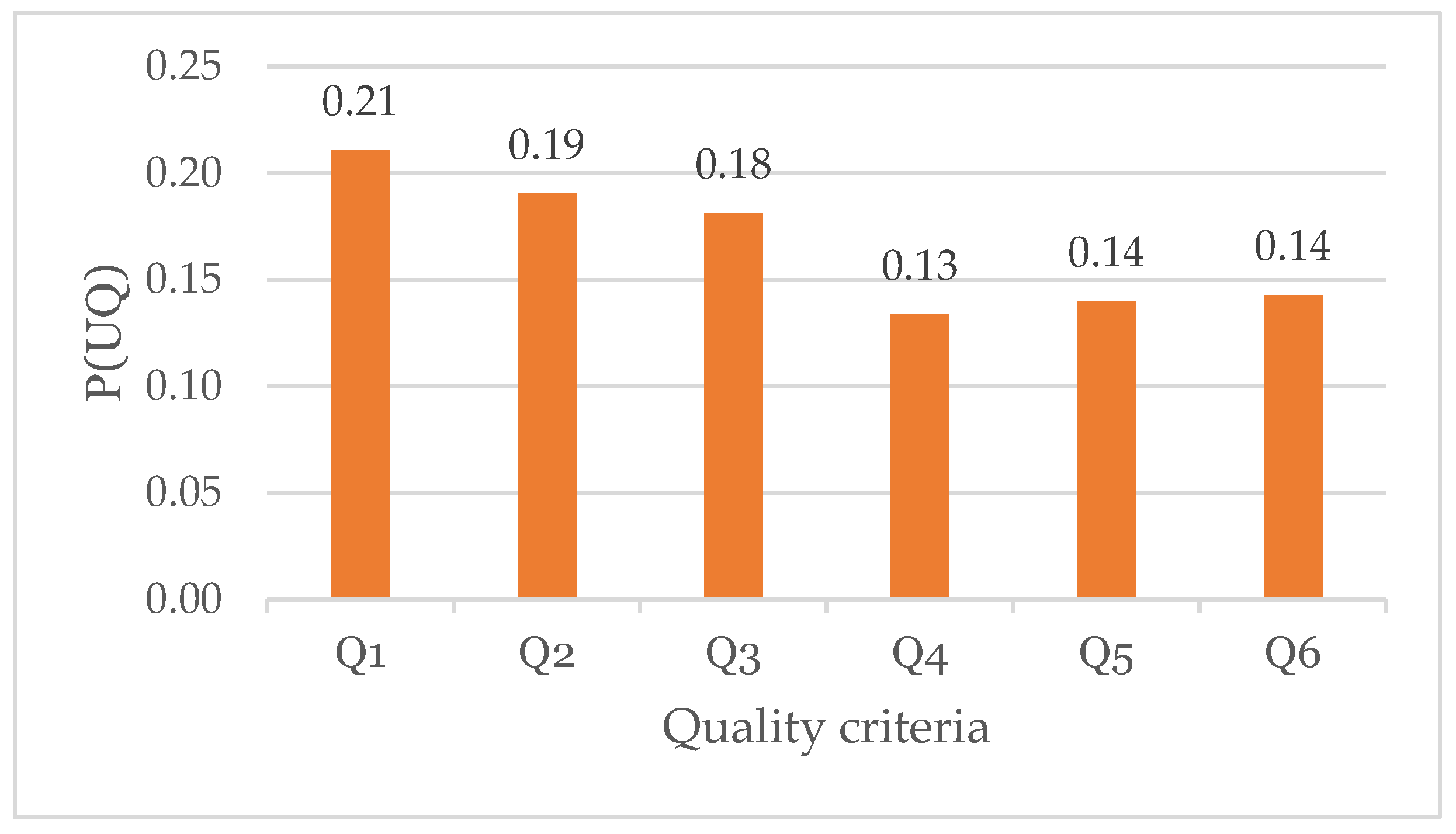

3 | Cracks in concrete with an opening width of more than 0.2 mm | 0.09 | 0.12 | 0.21 | 0.27 |
4 | Areas of unconsolidated concrete | 0.15 | 0.11 | 0.21 | 0.15 |
5 | Reduction in the concrete cover | 0.10 | 0.13 | 0 | 0 |
6 | Vertical deviation, straightness, horizontality of structure, deviations of the cross-section dimensions | 0.15 | 0.11 | 0.21 | 0.15 |
7 | Irregularities and chips on the concrete surface | 0.15 | 0.14 | 0 | 0 |
8 | Grease and rust stains on the concrete surface | 0.03 | 0.05 | 0 | 0 |
9 | Reduction in the diameter, distance and/or quantity of the reinforcement | 0.05 | 0.08 | 0.21 | 0.33 |
10 | Violations when connecting reinforcement | 0.11 | 0.05 | 0.21 | 0.10 |
11 | Increased level of chemical/radiation contamination of concrete | 0 | 0.01 | 0 | 0 |
12 | Reduction in the strength of the concrete structure | 0.08 | 0.01 | 0.21 | 0.02 |
13 | Reduction in frost resistance, water resistance of concrete | 0.05 | 0.05 | 0.21 | 0.24 |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
