Article

BIM for CREM: Exploring the Benefit of Building Information Modelling for Facility Management in Corporate Real Estate Management

Institute for Construction Economics, University of Stuttgart, Keplerstraße 11, 70174 Stuttgart, Germany
*
Author to whom correspondence should be addressed.
Buildings 2022, 12(4), 400; https://doi.org/10.3390/buildings12040400
Submission received: 9 February 2022 / Revised: 17 March 2022 / Accepted: 23 March 2022 / Published: 25 March 2022
(This article belongs to the Special Issue Advanced BIM Application in Construction and Buildings)

Abstract

:
The implementation of BIM in FM has been of steadily growing interest for academic research. Yet the benefits of BIM for the FM in CREM have, to the present day, been explored to a limited extent. As research on BIM for FM in CREM remains narrowly investigated, this study follows an exploratory approach to formulate implications for further research directions. Therefore, a four-stage procedure was adopted: (1) identification and definition of BIM uses for FM in CREM; (2) validation of the BIM uses for FM in CREM and the expert survey questionnaire; (3) assessment of each BIM use’s benefit by experts; and (4) analysis of the correlations between BIM uses’ benefit assessments and the respondents’ industries, the resulting associations, and the prioritisation for the development of BIM uses for FM in CREM. Based on that methodology, it was shown that the BIM use for FM in CREM with the highest priority for development is 46 Facilities and Equipment: Repair and Renewal. The BIM use with the lowest priority is 21 Visualisation. As a result, four implications on the development of BIM uses for FM in CREM were formulated regarding case studies, information requirements, and technical requirements, as well as process and personnel requirements.

1. Introduction

Digitisation in the construction sector remains delayed compared to most other industries, even though it has been accelerated considerably by the advent of technologies such as the internet of things (IoT), 3D scanning, distributed ledger technologies (DLT), and—arguably most prominent—building information modelling (BIM) [1,2,3,4]. Accordingly, actors such as the EU BIM Task Group identified the implementation of BIM as “the construction sector’s moment of digitisation” for all building life cycle phases [5] (p. 8). Among the beneficial implications of BIM implementation, direct or indirect financial benefits are among the most frequently mentioned. Estimations regarding the cost-saving potential through BIM are assessed between 8% and 23%, depending on the buildings’ life cycle phase [6].
Concerning a building’s life cycle cost, it is widely acknowledged that the cost accumulating during the operational phase greatly exceeds the cost of the design and construction phase combined. Nevertheless, estimations vary regarding the operational phase’s precise percentage of the overall life cycle cost. This may extend from 60% [7] to 80% [8] and even up to 85% [9] of a building’s total life cycle cost accumulating during the operational phase. Given the impact of a building’s operational phase on its life cycle cost, potential cost savings by implementing BIM in that life cycle phase are expected to be considerable. Therefore the implementation of BIM in facility management (FM) has been of steadily growing interest for academic research [10].
However, the benefits of BIM for the FM in corporate real estate management (CREM)—i.e., the management of real estate that is related directly to an organisation’s core business [11,12]—have, to the present day, been explored to a rather limited extent [13]. Corporate real estate can be defined as “all forms of properties that corporates need for the execution of their core business, including administrative buildings, social buildings, training centres, research and application technology buildings, agricultural buildings such as greenhouses, etc.” [11] (p. 6).
In a prototypical case study, Gerbert et al. [6] evaluated the impact of BIM implementation on the life cycle cost of different building types. Results showed that of all buildings compared, the highest cost-saving potential of 14% to 23% was identified within the group of commercial and institutional buildings. These findings support the assumption that BIM offers great benefit for FM in CREM, as real estate operation often presents one of the biggest cost blocks for companies [11]. Nonetheless, BIM implementation in this specific context progresses unevenly. Of the many obstacles encountered, one that has been identified repeatedly lies within the identification of FM processes and corresponding BIM uses for implementation [14,15,16]. A second one lies within the subsequent implementation due to a lack of guides and standardisation documents for specific BIM uses, posing a challenge to many FM professionals [10,14]. Within this context, related research furthermore suggests that different industries might have different implementation priorities based on benefit assessments of specific BIM uses for FM in CREM [16,17].
In order to accelerate the implementation of BIM for FM in CREM, high-priority BIM uses for FM in CREM providing a high benefit for all industries must be identified. This allows the identification of further research directions regarding the development of guides and templates for high-priority BIM uses for FM in CREM.
Consequently, this study focuses on the benefit assessments of BIM uses for FM in CREM and their association with industries. In order to outline this study’s objectives, four questions have been formulated:
  • RQ 1: Which BIM uses supporting FM processes in CREM can be identified?
  • RQ 2: How do experts assess the benefit of BIM uses for FM in CREM?
  • RQ 3: How strong are the associations between each BIM use’s benefit assessment and the respondents’ industries?
  • RQ 4: What prioritisation for the development of BIM uses for FM in CREM can be derived from the BIM uses’ benefit assessments and their association with industries?
Regarding RQ 2, related studies by Becerik-Gerber et al. [18] and McArthur and Sun [19] investigated the benefit of selected BIM uses. Since both studies focus on the complete life cycle within a heavily public real-estate-related context, no prior hypothesis could be deduced from them. Regarding RQ 3, no prior hypothesis has been proposed as related research indicating such associations is still too limited to allow substantiated assumptions—notably by Munir et al. [17] and Cavka et al. [16]. Given the limited amount of prior related research, this study consequently follows an exploratory approach to distinguish implications and further research directions [20,21].

2. Methodology

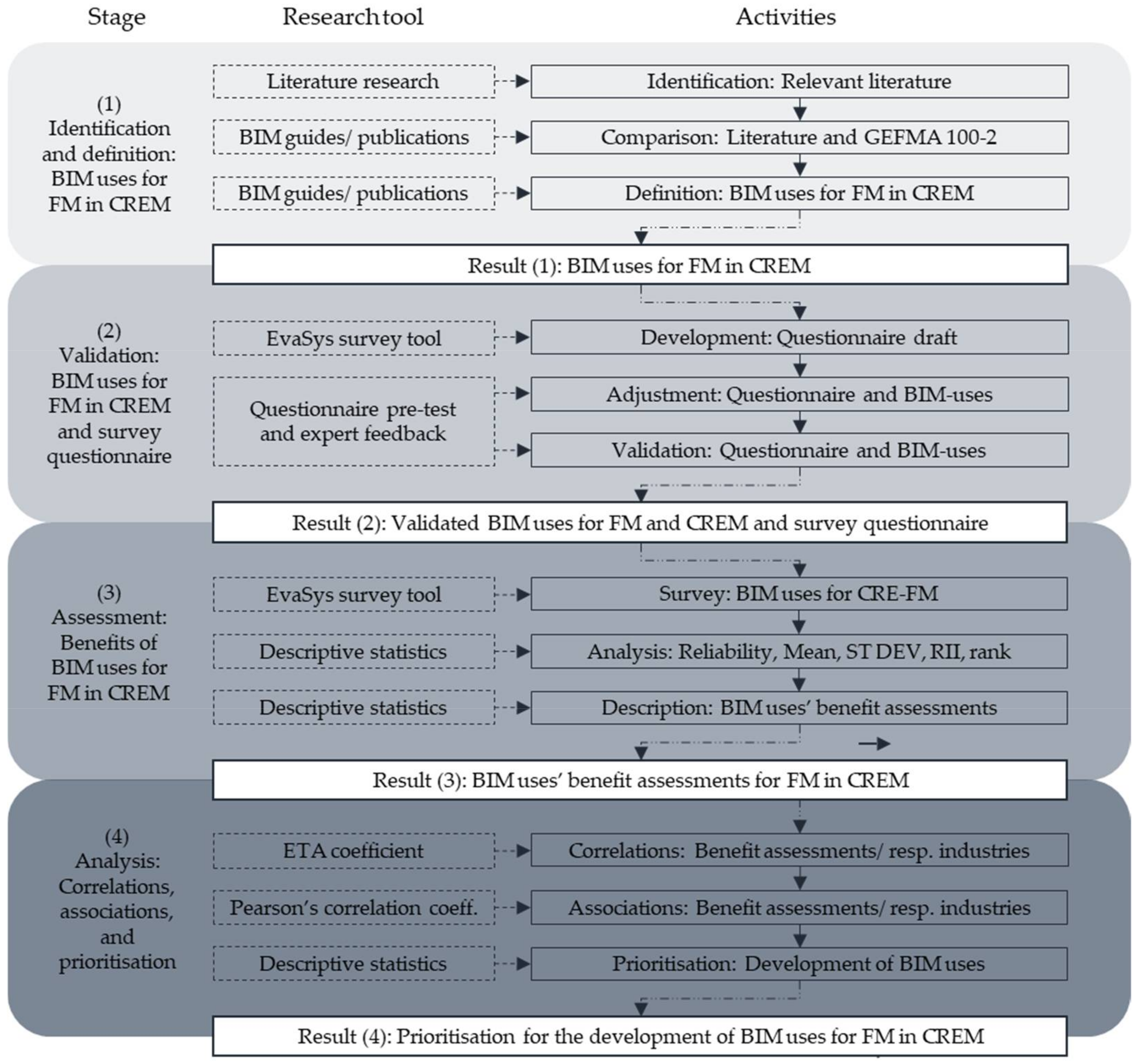

To investigate BIM for FM in CREM and deduce implications as well as further research directions, this study follows an exploratory approach. Exploratory approaches are applied to fields with little or no prior body of knowledge or theories [20,21]. Thus, a four-stage mixed-methods procedure was adopted, as shown in Figure 1: (1) identification and definition of BIM uses for FM in CREM; (2) validation of the identified BIM uses for FM in CREM and the expert survey questionnaire; (3) assessment of each BIM use’s benefit by experts; and (4) analysis of the correlations between BIM uses’ benefit assessments and the respondent’s industries, the resulting associations, and the conclusive prioritisation for the development of BIM uses for FM in CREM. Each stage conducted during this study is further elaborated in the following paragraphs of this section.
Stage (1) aims at identifying literature for creating a baseline catalogue of BIM uses supporting FM processes in CREM. To do so, three steps were conducted during this stage. Initially, the determination of sources was accomplished through systematic literature research and analysis of reports on international BIM maturity to identify leading nations in BIM implementation. The literature research aimed at identifying BIM guides provided and published by state organisations or NGOs that outline terminology and BIM uses that are already established, thus known by experts. The keywords included: BIM; Building Information Modelling; BIM guide; BIM guideline; BIM standard; BIM use; BIM use case. The databases for literature research included: Web of Science, Google Scholar, and Engineering Village. In terms of internationally leading countries with high BIM maturity levels, the UK, Singapore, China, Hong Kong, Finland, Norway, and the United States were identified [22]. On a European level, the Netherlands, Spain, France, and Germany are also rapidly accelerating their BIM implementation efforts [23]. A total of 14 international BIM guides were identified and used as a source for BIM uses in FM. Subsequently, the BIM guides identified were systematically analysed and matched with the list of FM processes provided by the German Facility Management Association e.V. [24] in their GEFMA 100-2 guideline. This guideline contains a comprehensive list of categorised FM main processes and corresponding FM processes developed by an expert committee, making it a reliable reference structure. Comparative analysis of the 14 international BIM guides with GEFMA 100-2 resulted in the first list of 34 BIM uses for FM as a base for further elaboration. To define the BIM uses specifically for FM in CREM, a second literature analysis addressing this specific context was conducted [11,25].
The second literature review aimed at the identification of scientific publications on BIM in a CREM context. The keywords included: BIM; Building Information Modelling; BIM use; BIM use case; Facility Management (FM); Operations; Maintenance; O&M; Corporate Real Estate (CRE). The databases for literature research included: Web of Science, Google Scholar, and Engineering Village. A comparative analysis of the guides used in the first stage as well as the scientific publications identified in the second stage allowed the development of specific definitions of BIM uses supporting FM processes in CREM. The result of the comparative analysis is shown in Table A1.
Stage (2) comprises the expert validation of the BIM uses for FM in CREM as well as the validation of the survey questionnaire. Preparatory expert validation was conducted during a pretest involving FM experts in CREM with BIM experience. Therefore, the list of BIM uses for FM in CREM from stage (1) and a draft of the survey questionnaire were prepared for validation. The pretest then allowed the validation of both the list of BIM uses and the survey questionnaire. Participants were explicitly informed of the pretest status, encouraging a critical view of the questionnaire to improve feedback [26]. Based on the pretest feedback, the questionnaire’s processing time could be asserted and one further BIM use was added: 63 Cleaning Management: Outdoor Facilities Cleaning. As a result, stage (2) provided a validated expert survey questionnaire comprising a comprehensive list of BIM uses for FM in CREM, answering this study’s RQ 1.
Stage (3) consists of an initial online survey targeting experts for FM in CREM with prior BIM experience. The pool of possible participants was assumed to be rather limited due to the prerequisite of having experience in the fields of CREM and BIM. Hence, a cross-section online survey was chosen for data collection to reach a larger number of potential participants [27]. Questionnaire distribution by the Austrian IFMA Austria, the German RealFM e.V., and the Swiss SVIT FM Schweiz ensured that purposive sampling was restricted to the predefined target group of experts for FM in CREM with BIM experience [27]. Starting the questionnaire, participants were asked to (1) confirm that they have understood the prerequisites for participating in the study regarding FM and BIM experience, (2) state their position in the organisation they work for, and (3) state their own or their customers’ industry, following the SNA/ISIC intermediate aggregation A 38 of economic activities by the European Commission [28]. Question (1) actively reminds the respondents of the requirements to ensure purposive sampling. Question (2) considers the participants’ point-of-view from an operational, tactic, or strategical level. Question (3) ensures that only data from experts with experience in CREM are included in the analysis. Eventually, all participants were asked to assess each BIM use’s benefit on a 5-point scale from (1—very low benefit) to (5—very high benefit). Concerning terminology, the term “benefit” was selected due to its utilisation for the evaluation of positive effects of BIM in FM in several related publications [3,29], notably [19]. The results’ internal consistency was measured by determining Cronbach’s alpha [30]. The subsequent analysis of valid responses was performed conducting data description and analysis techniques.
Stage (4) aimed at answering RQ 3 and 4 by further analysing the results from stage (3). The measurement of correlations was conducted by calculating each BIM use’s ETA coefficient depending on the respondents’ industries. As a result of the calculated ETA coefficients, the association between each BIM use’s benefit assessment and the respondents’ industries could be determined by applying Pearson’s correlation coefficient [31]. Conclusively, each BIM use’s benefit assessment and their association with the respondents’ industries were used to derive a prioritisation for the development of BIM uses for FM in CREM to answer RQ 4.

3. Scientific Background

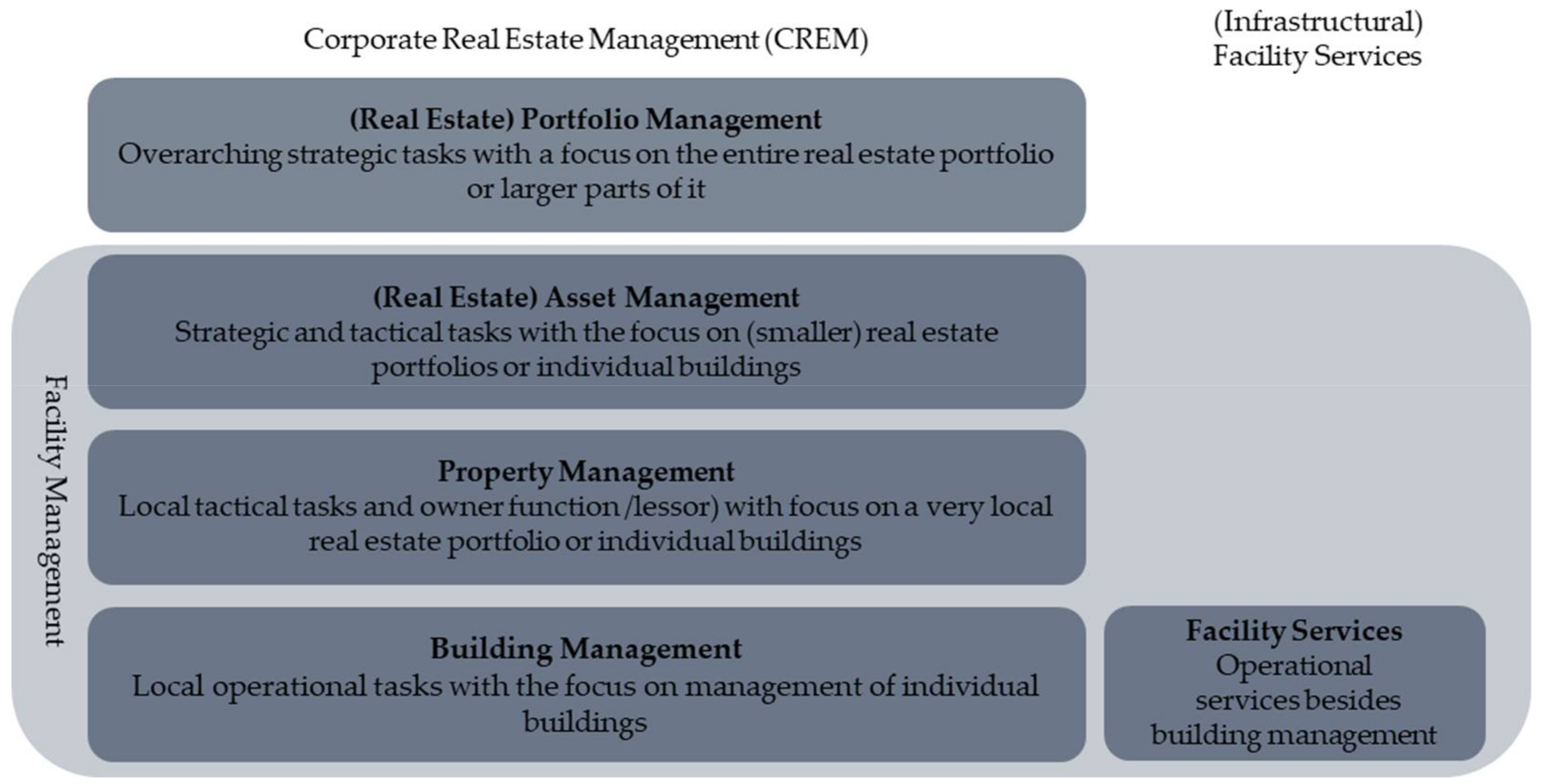

3.1. CREM

Concerning the precise definition and delimitation of CREM, the term corporate real estate (CRE) requires a prior definition. Heywood and Kenley [12] describe two possible definitions: either including all real estate owned by a company—core-business-related or not core-business-related—or only including real estate being related directly to the core business of a company, provided that the core business is not real estate. As Heywood and Kenley [12] favour the latter definition, Glatte [11] equally defines CRE as core-business-related, “including all forms of properties that corporates need for the execution of their core business, including administrative buildings, social buildings, training centres, research and application technology buildings, agricultural buildings such as greenhouses, etc.” [11] (p. 6). Predominant building types in CRE are buildings for offices, storage, production, and/or retail, depending on the company’s industry [8,32]. In this context of direct relation to a company’s core business, aligning CREM objectives with a company’s strategic goals can contribute greatly to its success. This can be achieved in multiple ways, including “property management, handling facilities, reducing operating cost, and many other contributions […]” [33] (p. 61). According to Glatte [11], CREM, therefore, includes the aspects of asset management, property management, and building management of FM, whereas infrastructural facility services of FM stand apart, as shown in Figure 2.

3.2. CREM and FM

The exact relationship between CREM and FM gives rise to discussions within the community of FM and CREM experts [34,35]. van der Voordt [34] affirms that FM and CREM do share similarities regarding conferences and organisations and that both align to corporate strategies. Concerning disparities, van der Voordt [34] distinguishes two main differences between FM and CREM: (1) FM focuses on non-core business services and their management whereas CREM focuses on the integration of management disciplines and cost control; and (2) CREM focuses on real estate as an asset used for its purpose, whereas FM is service-oriented and therefore focuses on demands related to space, infrastructure, people, and organisations.
Nonetheless, van der Voordt [34] observes a clear convergence between CREM and FM and an ever-increasing integration and alignment of both. This raises the question of future terminology, as shown in Figure 3.
As the question of the exact relationship of CREM and FM remains disputed and the question of the terminology itself provides ample material for discussion, this publication cannot give terminology describing the relationship of CREM and FM conclusively. Instead, the term “FM in CREM” is applied to describe all aspects of asset, property, and building management and those of infrastructural facility services, constituting FM in CREM.

3.3. BIM for FM

ISO 41011:2017 defines FM as an “organizational function which integrates people, place and process within the built environment to improve the quality of life of people and the productivity of the core business” [36] (p. 1).
Previous studies have shown that FM can benefit in several ways from the implementation of BIM: gains in efficiency due to automatic generation of geometric information for FM [37], advanced decision-making and data management [38], optimised communication and coordination of FM processes [15], enhanced collaboration [39], improved building performance [40], and enhanced levels of competitiveness [41] are some examples. Even though research on BIM implementation in FM has intensified recently, its application in the FM industry remains rather limited compared to design and construction [10,25,42,43]. In this context, the identification of FM processes and corresponding BIM uses for implementation constitutes a major obstacle hampering BIM implementation in FM [14,15,16].
BIM uses can be defined as “a method or strategy of applying Building Information Modelling during a facility’s lifecycle to achieve one or more specific objectives” [44] (p. 5). The achievement of these specific objectives through BIM uses is a core concept of BIM implementation. In the case of FM, these specific objectives often describe generating a benefit for FM processes through information stored in or extracted from a BIM [16,45].

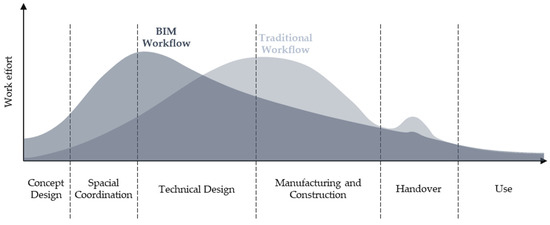

Due to the BIM workflow concentrating efforts in earlier planning phases, the identification of BIM uses shifts to earlier project phases accordingly, as shown in Figure 4. Therefore, BIM uses need to be identified in early project phases, beginning with the end in mind [46]. Since FM has highly accurate and specific information requirements, early identification of beneficial BIM uses is essential for information collection and delivery to effectively implement identified BIM uses [37,45,47,48,49].
As many FM professionals still struggle with adopting BIM for FM in general, the initial identification of BIM uses based on supported FM processes poses an additional challenge to many [15,49,51]. Alshorafa and Ergen [14] point out that “there is no guidance to determine what information should be included in a BIM model for different BIM uses” [14] (p. 564). Correspondingly, Miettinen et al. [52] identified insecurity about BIM benefits and applications in FM as one of the biggest concerns for professionals. To tackle these barriers to BIM implementation in FM, Edirisinghe et al. [10] conclude that further research is required concerning the development of specific BIM applications for FM. Recently, the German standardisation organisation DIN correspondingly proposed the analysis of BIM uses to lay the ground for standardisation and template development [53].

3.4. BIM for FM in CREM

CREM portfolios are often large and diverse, comprising a variety of sometimes highly complex buildings [25]. Hence, FM in CREM represents a particularly intriguing field of BIM application with a variety of potential applications. It is essential to determine which information for which FM processes is relevant for CREM to efficiently operate buildings, as data and information management itself can be a considerable cost factor [13]. The definition of BIM uses should therefore be conducted carefully and in direct correspondence to objectives and FM processes.
Research also suggests that organisation types are a factor influencing the identification of beneficial BIM uses for FM in CREM. In their 2020 study, Munir et al. [17] analysed and compared the type and nature of information needs of different organisation types. The authors concluded that there is a strong relationship between an organisation’s industry and the FM processes it wants to support with BIM, based on its objectives and asset management strategy. Cavka et al. [16] made a similar observation when investigating the BIM information requirements of large owner organisations. They found that requirements vary considerably between organisations from different industries, as BIM-supported FM processes vary. Based on Munir et al. [17] and Cavka et al. [16], it can therefore be assumed that different industries assess the benefit of specific BIM uses for FM in CREM differently.

4. Research Background

4.1. Related Studies: BIM in FM

In recent years, research on BIM uses for FM has intensified considerably [54]. Several studies concerning their identification and definition in different contexts have been published. However, the focus often lies on the information requirements themselves. Without a link to specific FM processes within a specific context, BIM use identification may only be conducted during project execution, jeopardising the principles of “beginning with the end in mind” [46]. Table 1 shows related studies that have been analysed for the identification of BIM uses for FM.

4.2. Related Studies: BIM Uses for CREM

Even though research on BIM in FM has been growing steadily, studies focusing on its implementation in the context of CREM are rare. Within the studies identified, two approaches could be determined. The first one started with the information that can be stored in a BIM and investigated which information might be potentially beneficial to CREM professionals or processes [56]. The second approach identified CREM processes initially and, based on that, looked for potential benefits through BIM and useful information [25]. Table 2 shows related studies analysed for the identification of BIM uses for CREM.

5. BIM Uses for FM in CREM

As described in Section 2, the list of FM processes provided by the German Facility Management Association e.V. [24] in the GEFMA 100-2 guideline constitutes the baseline for identifying BIM uses for FM in CREM. It defines nine FM main processes and their corresponding FM processes for the operational phase. Eight out of nine FM main processes and their FM processes are included in this study. FM main process number nine was excluded as it covers refurbishment projects during the operational phase, making it construction-related. For clarity, BIM uses were clustered based on the GEFMA 100-2 FM main processes, as shown in Table 3.
Based on Table 3, a total of 35 distinct BIM uses for FM in CREM could be identified, answering RQ 1.

6. Online Survey

6.1. Questionnaire

For the assessment of each BIM use’s benefit and the investigation of potential correlations between benefit assessments and respondents’ industries, an online expert survey was designed and distributed via German-speaking FM associations as described in Section 2. The questionnaire itself targeted the study’s RQ 2–4. Experts were asked to state their industry based on the SNA/ISIC intermediate aggregation A 38 of economic activities by the European Commission [28] as well as their position before assessing the benefit of each BIM use from (1—very low benefit) to (5—very high benefit).

6.2. Survey Distribution

The distribution of the finalised questionnaire was supported by three leading FM associations, as described in Section 2. To maximise the number of potential participants, each association distributed invitations to the survey by their respective newsletters. As the participants’ experience within the fields of CREM and BIM was a prerequisite for receiving valid and meaningful results, the letter also explicitly stated that the survey addressed experts with experience in both fields.

6.3. Data Collection

After the survey distribution, the data collection lasted from September 2021 until January 2022. The rather extended data collection phase was due to different distribution dates of the online survey by each supporting association. During the data collection, a total of 38 responses from CREM experts were collected. One response had to be excluded due to implausible data, resulting in 37 responses included in the data description and analysis.

7. Data Description and Analysis

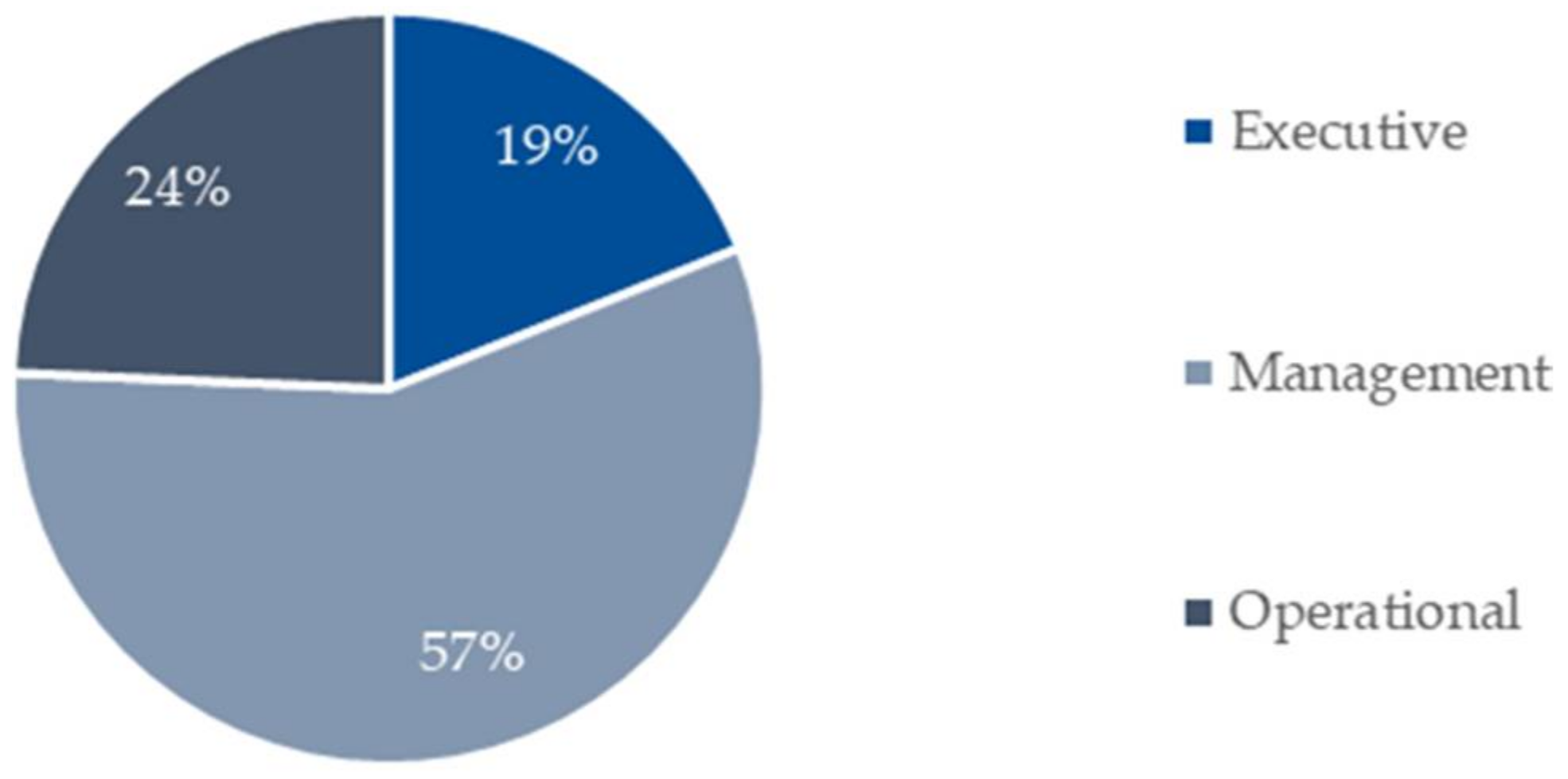

Regarding the respondents’ demographic distribution, it was shown that the largest groups of respondents are those from the construction and human health services industries, followed by the chemicals and chemical products industry, as shown in Figure 5.
Regarding the respondents’ positions within their respective companies, 19% of the respondents have a position on the executive level, 57% on the management level, and 24% on the operational level, as shown in Figure 6. It can therefore be assumed that assessments collected during this survey mainly display the management perspective, i.e., the tactical perspective, on BIM in FM for CREM.

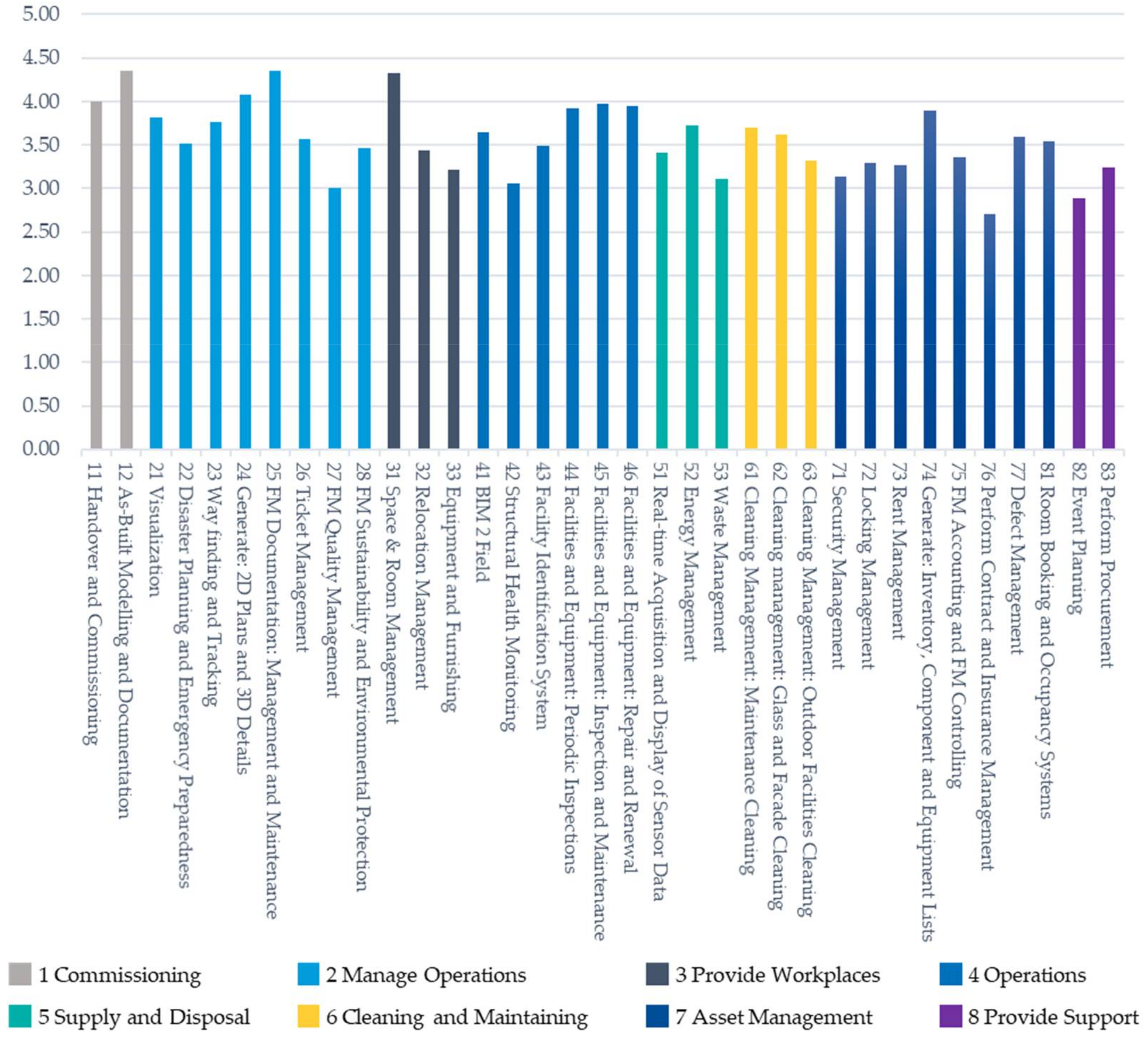

The calculation of each BIM use’s benefit assessment was conducted by determining their arithmetic mean (AM). Thirty-five items were included in the benefit assessment and the formula was applied accordingly. The arithmetic mean was calculated using the formula:
x ˜ = 1 n × i = 1 n x i
With x ˜ = weight given to response, n = number of items in the sample, and i = 1 n x i = the sum of the sampled values, the arithmetic mean of each BIM use’s benefit assessment was calculated based on the respondents’ assessments. The arithmetic mean of each BIM use’s benefit assessment is shown in Figure 7, answering RQ 2.
The internal consistency measurement of the constructs examined in the survey was performed by analysing Cronbach’s alpha for each FM main process. The reliability for each FM main process was therefore calculated based on the BIM uses constituting them, meaning a total of 35 variables. When analysing Cronbach’s alpha, values of α 0.6 per construct are acceptable for exploratory studies while α 0.7 is considered desirable, with the limitation that too high values of α 0.9 may indicate redundancies within the construct [20,57]. As Table A2 shows, the values for each main process range from α = 0.683 to 0.932, indicating adequate interrelatedness of the BIM uses within each FM main process.
The determination of the association between each BIM use’s benefit assessment and the respondents’ industries was conducted by calculating their respective ETA coefficients. The ETA coefficient is a method to determine the correlation between an independent categorical variable (e.g., blood type, profession, hair colour) and a dependent scale variable (e.g., Likert, temperature, weight) [31].

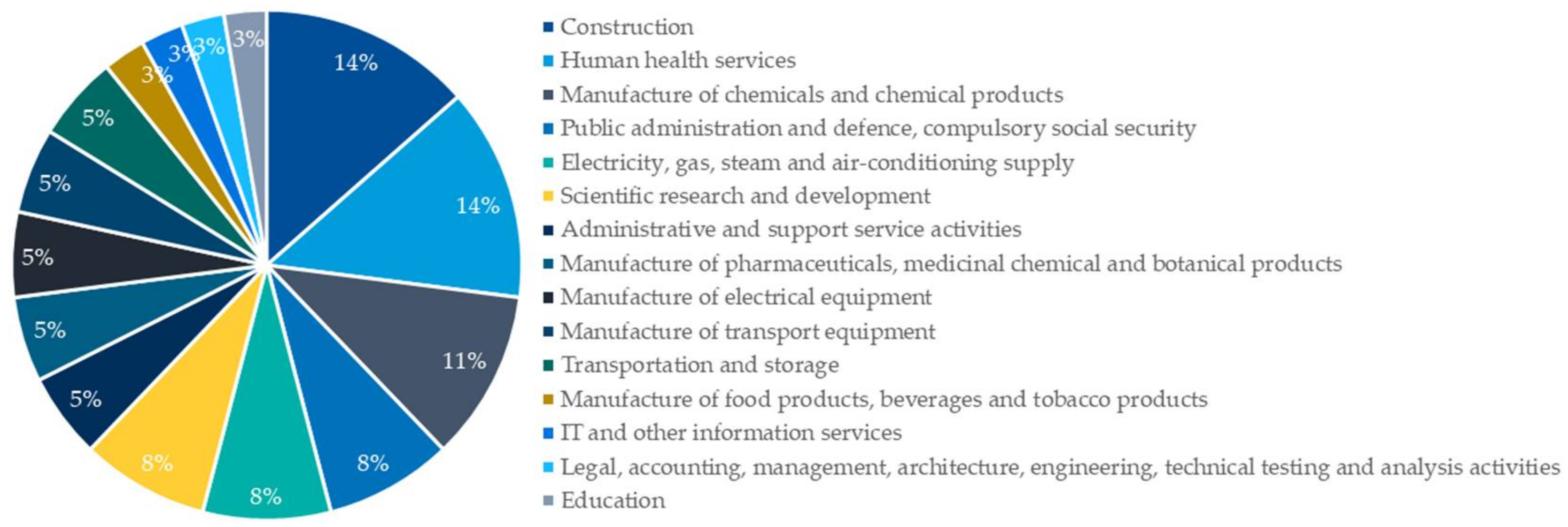

For this study, the respondents’ industries were captured as a categorical variable and each BIM use’s benefit assessment as a scale variable. The calculation of the ETA coefficients was conducted using the formula:
η = 1 n 1 × j k × n j ( y ¯ j y ¯ ) 2 s y 2
With n = number of items, y ¯ = mean value of the variable, and s y = variance of y ¯ . Interpretation of the Pearson’s correlation coefficient shown in Table 4 indicated the association between each BIM use’s benefit assessment and the respondents’ industries.
Only questionnaires from industries with at least two responses could be included in the correlation analysis. Thus, n = 33 for the ETA coefficient calculation and subsequent association determination.
By interpreting Pearson’s correlation coefficient presented in Table 4, the results shown in Figure 8 can be analysed to determine the association between each BIM use’s benefit assessment and the respondents’ industries. As described in Table 4, an ETA coefficient of 0.7 indicates a strong association, an ETA coefficient of 0.4–0.69 indicates a medium association, and an ETA coefficient of 0.2–0.39 indicates a weak association between the variables. Thus, a low ETA coefficient suggesting that a BIM use’s benefit assessment only has a weak association with specific industries is desirable in this context.

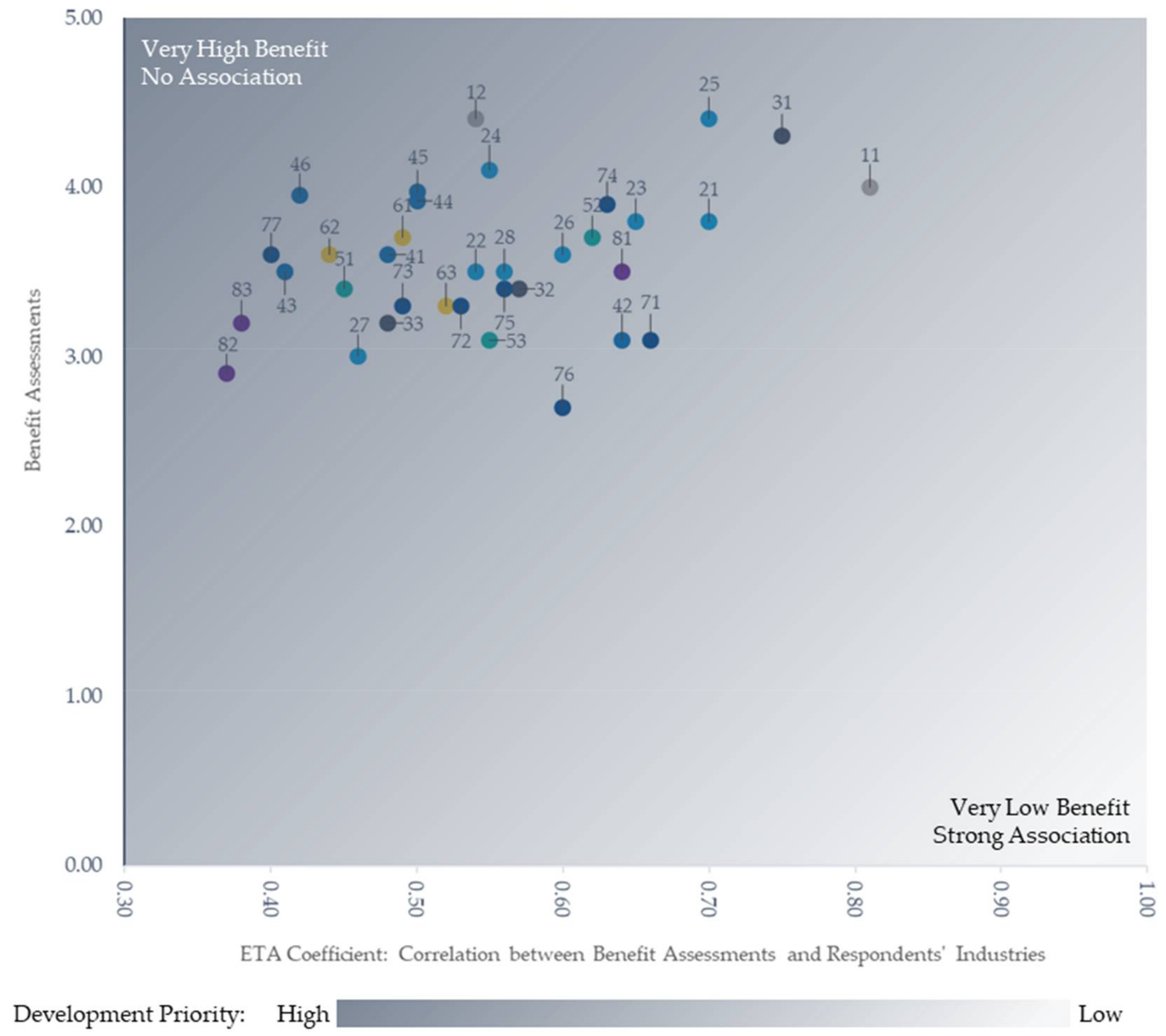

The interpretation of the results shown in Figure 8 thus answer RQ 3. Particularly strong associations can be identified for the BIM uses 11 Handover and Commissioning; 21 Visualisation; 25 FM Documentation: Management and Maintenance; and 31 Space and Room Management.
The BIM uses’ benefit assessments in connection with the determination of their respective associations with the respondents’ industries also allow one to derive a prioritisation for the development of BIM uses for FM in CREM. Given the measured differences regarding the BIM uses’ benefit assessments as well as the strength of their respective association, it can be assumed that some BIM uses are of high or very high benefit for FM in CREM in general, regardless of the specific industry. This assumption is based on the observation that those BIM uses’ benefit assessments show only medium to weak associations with the respondents’ industries. Consequently, it can also be assumed that some BIM uses are of high to very high benefit for FM in CREM but that their benefit assessments are highly associated with the respondents’ industries, questioning their benefit for CREM in general.

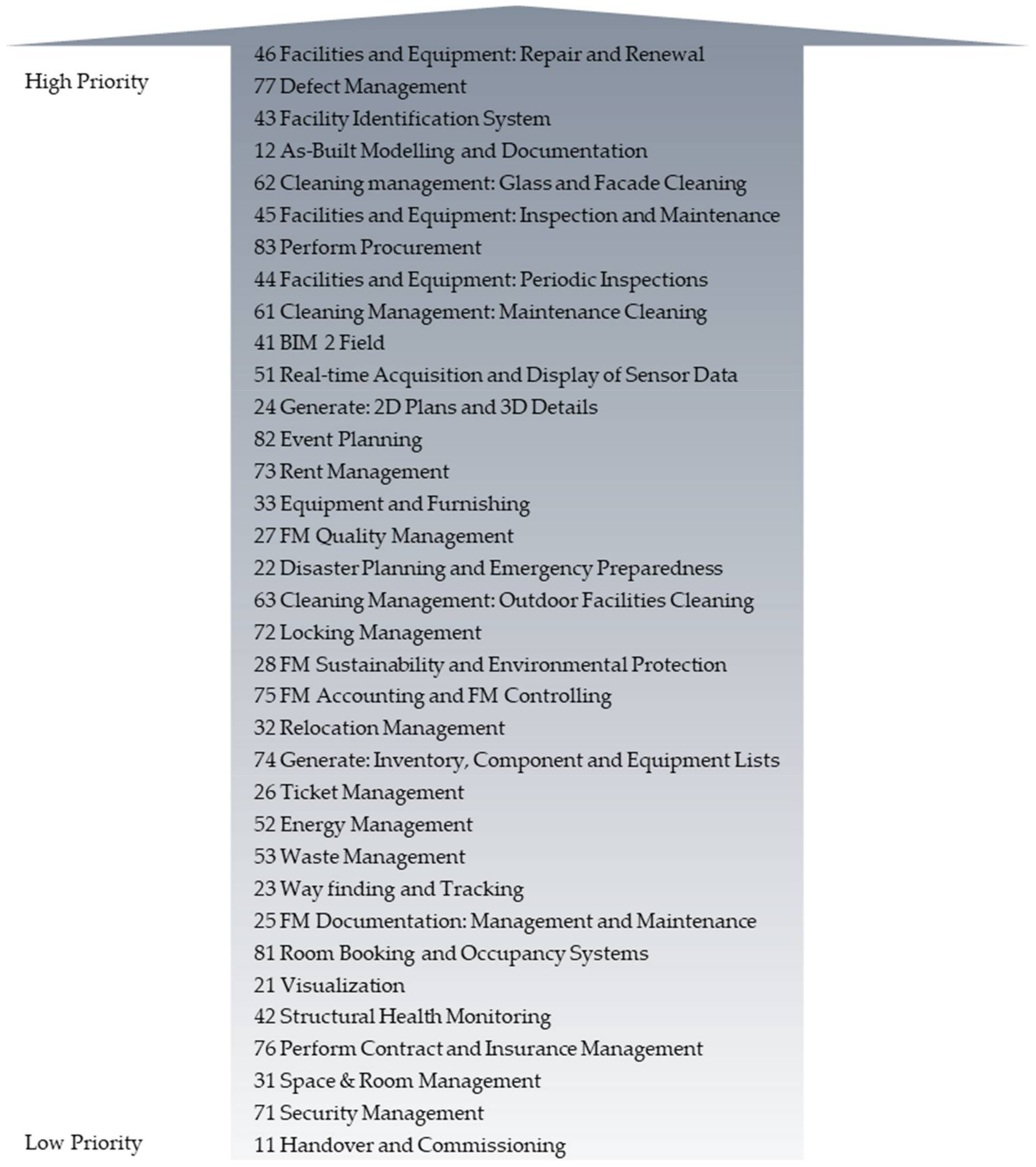

Following these assumptions, prioritisation for the development of those BIM uses can be derived, answering this study’s RQ 4. Due to their assumed benefit for FM in CREM regardless of the specific industry, BIM uses with a weak to medium association with the respondents’ industries are by default considered to be of higher priority than BIM uses with strong associations with the respondents’ industries, as shown in Figure 9.
The prioritisation for the development of BIM uses for FM in CREM has been conducted based on their respective benefit assessments and ETA coefficients. Since the benefit assessments and the ETA coefficients are not directly comparable, the weighted product model was chosen for determining each BIM use’s score. The weighted product model can be applied in multi-criteria analysis to determine the value of non-comparable units, as it is dimensionless. This means it eliminates units and can be applied to relative values instead of actual ones, making it a more suitable choice than the weighted sum model [58,59]. Each BIM use’s weighted product has been calculated using the formula:
A j W P M = j = 1 n x i j w i
With A j W P M = weighted product score, n = number of criteria, x i j = the actual value of the ith alternative in terms of the jth criterion, and w = the weight of importance of the jth criterion. Weightings have been determined neither for the BIM uses’ benefit assessments nor for the ETA coefficients. Regarding each BIM use’s ETA coefficient, 1 x i j = the actual value of the ith alternative in terms of the jth criterion. Thus, by multiplying each BIM use’s benefit assessment with its respective ETA coefficient, each BIM use’s multiplicative score could be determined [59]. Based on the weighted product model, BIM uses with a high benefit assessment and weak to medium associations are considered to be of high priority for the development of BIM uses for FM in CREM in general. Accordingly, BIM uses with a low benefit assessment and strong associations are considered to be of low priority for the development of BIM uses for FM in CREM in general.

8. Discussion

Utilising the potential of BIM for FM in CREM remains a challenge and numerous obstacles remain to be tackled and overcome. Of those obstacles, one lies within the initial identification and definition of BIM uses supporting FM processes in CREM. A second obstacle lies within the selection of specific BIM uses to be implemented, as insecurities about the benefit and application of BIM persist. To overcome these obstacles, this study answers the following research questions:
  • RQ 1: Which BIM uses supporting FM processes in CREM can be identified?
  • RQ 2: How do experts assess the benefit of BIM uses for FM in CREM?
  • RQ 3: How strong are the associations between each BIM use’s benefit assessment and the respondents’ industries?
  • RQ 4: What prioritisation for the development of BIM uses for FM in CREM can be derived from the BIM uses’ benefit assessments and their association with industries?
Concerning RQ 1, a comprehensive, literature-based and expert-validated list of BIM uses for FM in CREM is provided, as shown in Table 3.
As for RQ 2, a survey with BIM-experienced CREM experts assessed each BIM use’s benefit, identifying the most beneficial BIM uses for FM in CREM, as shown in Figure 7.
Furthermore, research suggests that the benefit of BIM uses is strongly influenced by the implementing organisation’s industry [15,16]. RQ 3 thus analysed the associations between each BIM use’s benefit assessment and respondents’ industries. It showed that the benefit assessments of certain BIM uses had strong associations with the respondents’ industries—namely 11 Handover and Commissioning; 21 Visualisation; 25 FM Documentation: Management and Maintenance; and 31 Space and Room Management. These results confirm the findings of Munir et al. [15] and Cavka et al. [16] highlighting the strong influence of an organisation’s industry background on its BIM priorities and requirements for supporting specific FM processes. This study affirms the results by Munir et al. [17] and Cavka et al. [16] by showing that different industries assess the benefit of BIM uses for FM differently.
As the implementation of BIM for FM in CREM requires the identification of further research directions regarding the development of guides and templates, this study also aims at deriving a prioritisation for the development of BIM uses for FM in CREM by answering this study’s RQ 4. As shown in Figure 9, prioritisation for the development of BIM uses for FM in CREM can be derived from each BIM use’s benefit assessment in connection with its respective association with the respondents’ industries. The BIM use with the highest priority for further development is 46 Facilities and Equipment: Repair and Renewal. The BIM use with the lowest priority for further development is 21 Visualisation.
The findings described above result in four implications concerning the development of BIM uses for FM in CREM:
(1)
It is important to emphasise that the benefit assessments collected in this study are not or are only partly based on experience gathered during the BIM uses’ implementation in reality. This means the benefit assessments rely largely on the experts’ experience in the fields of BIM and FM in CREM and do, to a certain extent, reflect expectations of each BIM use’s potential benefit. Therefore, further research in the form of case studies is suggested to develop and implement BIM uses under real conditions for quantifiable benefit assessments.
(2)
Based on this study’s results regarding the prioritisation for the development of BIM uses for FM in CREM and implication (1), further research is suggested to define information requirements for high-priority BIM uses. Since an obstacle to the implementation of BIM for FM in CREM lies within a lack of guides and templates, basic information requirements need to be identified to support the implementation of BIM in this context [10,14].
(3)
An additional implication comes from the identification of technical requirements. Regarding the implementation of high-priority BIM uses within the context of FM in CREM, an investigation of the technical requirements is suggested. Given the diversity of software solutions and programmes used within CREM, further research might address questions of information exchange and data formats within this specific context.
(4)
On a process and personnel level, the definition of processes and personnel activities to support the implementation of high-priority BIM uses within the context of FM in CREM is suggested as further research. This fourth implication derives from the fact that established FM processes may require the development of new processes to allow personnel to adapt the processes and personnel activities of FM tasks to the BIM-based processes and personnel activities.

9. Conclusions

The number of current state initiatives, road maps, and associations promoting the implementation of BIM illustrates the expectations it raises regarding the digitisation of the construction industry as a whole. However, most efforts and research projects still target its application in the design and construction phases. Even though buildings accumulate the largest part of their life cycle cost during their operational phase, the implementation of BIM in this life cycle phase has been investigated to a comparably small extent. Related research suggests that one of the main obstacles hampering BIM implementation in FM lies within the identification of FM processes that can be supported with BIM and the subsequent definition of information requirements. In other terms, FM professionals often do not know which FM process can or should be supported with BIM and which information a BIM should contain to do so. Due to the complexity of modern FM, professionals frequently rely on guides and templates to perform certain tasks. Currently, a lack of guides or templates for the definition of specific BIM requirements for FM has been observed. In this current state, the process of information requirement definition for FM requires deeper knowledge of BIM and active participation in the design and construction process to assure that FM requirements are sufficiently considered during these phases—prerequisites that not all FM professionals can fulfil. Given this lack of guides or templates, this study lays the ground for further research aiming at the provision of such supporting documents.
As a result, a total of 35 BIM uses were identified and defined. As related research suggests that different industries expect different benefits from BIM uses due to their specific real estate portfolios, BIM uses that benefit all industries had to be identified subsequently.
It showed that the BIM use with the highest priority for development is 46 Facilities and Equipment: Repair and Renewal whereas the BIM use with the lowest priority is 21 Visualisation. Based on the study’s results, the following conclusions can be drawn:
  • Many of the FM processes from GEFMA 100-2 can be supported with BIM, opening up a multitude of application areas for BM in FM.
  • The implementation of BIM in CREM remains narrow, as the limited number of available participants illustrates.
  • High-priority BIM uses can be identified for a variety of FM main processes, namely 1 Commissioning, 4 Operations, 6 Cleaning and Maintaining, and 8 Provide Support.
  • Further research will need to develop reliable quantitative methods to measure how beneficial the implementation of a BIM use is compared to the current solutions.
The present study extends the knowledge on BIM in the context of CREM by providing a base for further research. It provides a literature-based list of potential applications of BIM for FM in CREM, opening up a variety of case studies to accelerate digitisation within this context. In order to identify further research directions with high impact, it also provides a prioritisation of BIM uses expected to generate high benefit, regardless of the industry concerned.

10. Limitations

Furthermore, the limitations of this study might also be addressed in future research:
(1)
The list of BIM uses supporting FM processes in CREM may not apply in other countries as the identification of BIM uses is based on FM processes listed in the GEFMA 100-2. This is because there is no international standard defining specific FM processes. This limitation could not be overcome at this point and it may impact the studies’ findings regarding the definition of the BIM uses identified. Future research could repeat the study using other national standards as a base. Alternatively, by using a yet-to-be-published international standard, further research could help to define a list of internationally acknowledged and standardised BIM uses supporting FM processes in CREM.
(2)
The identification of significant relationships between industries and beneficial BIM uses may be affected by the limited sample size. Due to the two prerequisites for participating in the online survey conducted—being a CREM expert and possessing prior BIM experience—the potential number of participants was highly restricted by default. As the implementation of BIM in the field of FM, in general, and in CREM, in particular, remains narrow, this limitation could not be overcome at this point. Thus, the study’s findings may be biased as several industries have not engaged in the implementation of BIM in FM yet, exempting their perspective from the survey. This may impact the study’s findings, as it may limit the extent to which they can be generalised. Further research could address this limitation by either repeating the survey as a whole or investigating specific industries individually.
Subsequent application of the proposed analysis approach for limitations (1) and (2) would allow further identification of high-priority BIM uses and BIM uses with strong associations with certain industries. Subsequently, comparisons with the results presented in this study could be conducted.

Author Contributions

Conceptualization, M.B. and C.S.; methodology, M.B. and C.S.; software, M.B.; validation, M.B. and C.S.; formal analysis, M.B. and C.S.; investigation, M.B.; resources, M.B.; data curation, M.B.; writing—original draft preparation, M.B.; writing—review and editing, M.B. and C.S.; visualization, M.B.; supervision, C.S.; project administration, C.S.; funding acquisition, M.B. All authors have read and agreed to the published version of the manuscript.

Funding

This publication was supported by the Open Access Publishing Fund of the University of Stuttgart.

Data Availability Statement

The data presented in this study is available on request from the corresponding author.

Acknowledgments

The authors would like to thank the IFMA Austria, the RealFM e.V., and the SVIT FM Schweiz for their support in survey distribution.

Conflicts of Interest

The authors declare no conflict of interest.

Appendix A

Table A1. Identified BIM uses for FM in CREM—FM main processes, sources, and frequency.
Table A1. Identified BIM uses for FM in CREM—FM main processes, sources, and frequency.
FM Main
Process
No.BIM UseSourcesFrequ.
1 Commissioning11Handover and
Commissioning
[16,61,62,63,64,65,66,67,68,69]10
12As-Built Modelling and
Documentation
[18,52,61,62,63,64,65,66,67,68,69,70,71,72,73]15
2 Manage
Operations
21Visualisation[18,61,62,63,65,66,67,68,70,71,74]11
22Disaster Planning and
Emergency Preparedness
[18,19,25,55,61,62,63,64,65,66,68,70,74]13
23Wayfinding and
Tracking
[16,18,55,61,62,63,64,65]8
24Generate: 2D Plans and 3D Details[16,19,56,61,62,63,64,65,66,67,68,69,70,71,72,74]16
25FM Documentation:
Management and
Maintenance
[14,16,19,52,56,61,62,63,64,65,66,67,68,69,70,71,72,73,74]19
26Ticket Management[56,61,63,68,72]5
27FM Quality Management[25]1
28FM Sustainability and
Environmental Protection
[19,25,62,64,65,66,67,70,71,72,74]11
3 Provide
Workplaces
31Space and Room
Management
[18,19,25,55,56,61,62,63,64,65,66,67,68,70,71,72,74]17
32Relocation Management[62,63,68]3
33Equipment and
Furnishing
[61,62,68,72]4
4 Operations41BIM 2 Field[52,61,62,63,65]5
42Structural Health
Monitoring
[62,63,65,67,68,71,72,74]8
43Facility Identification
System
[14,63,65,68,71]5
44Facilities and Equipment:
Periodic Inspections
[14,16,18,55,56,62,63,65,68,71,72]11
45Facilities and Equipment:
Inspection and
Maintenance
[14,16,18,19,25,55,56,61,62,63,64,65,66,67,68,69,70,72,74]19
46Facilities and Equipment:
Repair and Renewal
[14,16,18,25,55,56,61,62,63,64,65,67,68,69,70,71,72,73,74]19
5 Supply and Disposal51Real-time Acquisition and
Display of Sensor Data
[18,62,63,65,68,72]6
52Energy Management[16,18,19,55,62,63,64,65,66,67,68,69,70,71,72,73,74]17
53Waste Management[62,68,72]3
6 Cleaning and
Maintaining
61Cleaning Management:
Maintenance Cleaning
[61,63,65,67,68,72,74]7
62Cleaning Management:
Glass and Facade
Cleaning
[61,63,65,67,68,72,74]7
63Cleaning Management:
Outdoor Facilities
Cleaning
[Pretest]-
7 Asset
Management
71Security Management[25,61,62,65,68,72]6
72Locking Management[25,61,62,65,68,72]6
73Rent Management[16,19,25,68,72]5
74Generate: Inventory, Component, and  Equipment Lists[16,19,61,62,64,65,66,68,69,70,71,72,74]13
75FM Accounting and FM Controlling[16,18,19,25,61,62,63,65,68,70,71,72,73,74]14
76Perform Contract and
Insurance Management
[16,19,25,62,63,65,72] 7
77Defect Management[16,19,62,63,65,68,72]7
8 Provide
Support
81Room Booking and
Occupancy Systems
[25,62,63,65,72]5
82Event Planning[62]1
83Perform Procurement[16,25,61,62,63,65,68,72]8
Alshorafa and Ergen [14]; Cavka et al. [16]; Becerik-Gerber et al. [18]; McArthur and Sun [19]; Carbonari et al. [25]; Miettinen et al. [52]; Mayo and Issa [55]; Lazar and McArthur [56]; buildingSMART International [61]; Institut für Technologie und Management im Baubetrieb [62]; BIMe initiative [63]; Statsbygg [64]; Bouw Informatie Raad [65]; NATSPEC [66]; Construction Industry Council [67]; Direction générale de l’Aménagement, du Logement et de la Nature [68]; buildingSMART France [69]; College of Engineering [70]; New York City Department of Design and Construction [71]; buildingSMART Finland [72]; Building and Construction Authority [73]; AEC [74].
Table A2. Main processes’ Cronbach’s alpha and the arithmetic mean (AM) of each BIM uses’ benefit assessment with corresponding standard deviation (ST DEV), and rank.
Table A2. Main processes’ Cronbach’s alpha and the arithmetic mean (AM) of each BIM uses’ benefit assessment with corresponding standard deviation (ST DEV), and rank.
FM Main
Process
Cronbach’s AlphaNo.BIM UseAMST DEVRank
1 Commissioning0.68311Handover and
Commissioning
4.000.855
12As-Built Modelling and
Documentation
4.350.681/2
2 Manage
Operations
0.72921Visualisation3.810.9710
22Disaster Planning and
Emergency Preparedness
3.510.9919
23Wayfinding and
Tracking
3.760.9311
24Generate: 2D Plans and 3D Details4.080.864
25FM Documentation:
Management andMaintenance
4.350.751/2
26Ticket Management
3.571.0117
27FM Quality Management3.001.1833
28FM Sustainability and
Environmental Protection
3.461.1721
3 Provide
Workplaces
0.70231Space and Room
Management
4.320.753
32Relocation Management3.431.0722
33Equipment and
Furnishing
3.221.0329
4 Operations0.79941BIM 2 Field3.651.0114
42Structural Health
Monitoring
3.051.1832
43Facility Identification
System
3.491.0420
44Facilities and Equipment:
Periodic Inspections
3.921.128
45Facilities and Equipment:
Inspection andMaintenance
3.971.046
46Facilities and Equipment:
Repair and Renewal
3.951.107
5 Supply and Disposal0.71651Real-time Acquisition and
Display of Sensor Data
3.411.0723
52Energy Management3.731.0712
53Waste Management3.111.0731
6 Cleaning and
Maintaining
0.93261Cleaning Management:
Maintenance Cleaning
3.701.0213
62Cleaning Management:
Glass and FacadeCleaning
3.621.0415
63Cleaning Management:
Outdoor Facilities
Cleaning
3.321.1825
7 Asset
Management
0.84171Security Management3.141.0830
72Locking Management3.301.0226
73Rent Management3.271.0227
74Generate: Inventory,
Component, and  Equipment Lists
3.890.819
75FM Accounting and FM Controlling3.351.0124
76Perform Contract and
Insurance Management
2.701.0035
77Defect Management3.591.0416
8 Provide
Support
0.73481Room Booking and
Occupancy Systems
3.541.0418
82Event Planning2.891.0734
83Perform Procurement3.241.0928

References

  1. European Construction Sector Observatory. Digitalisation in the Construction Sector: Analytical Report. Available online: https://ec.europa.eu/docsroom/documents/45547 (accessed on 2 August 2021).
  2. Sigalov, K.; Ye, X.; König, M.; Hagedorn, P.; Blum, F.; Severin, B.; Hettmer, M.; Hückinghaus, P.; Wölkerling, J.; Groß, D. Automated Payment and Contract Management in the Construction Industry by Integrating Building Information Modeling and Blockchain-Based Smart Contracts. Appl. Sci. 2021, 11, 7653. [Google Scholar] [CrossRef]
  3. Daniotti, B.; Pavan, A.; Lupica Spagnolo, S.; Caffi, V.; Pasini, D.; Mirarchi, C. BIM-Based Collaborative Building Process Management; Springer International Publishing: Cham, Switzerland, 2020; ISBN 978-3-030-32888-7. [Google Scholar]
  4. McKinsey & Company. Imagining Construction’s Digital Future. Available online: https://www.mckinsey.com/business-functions/operations/our-insights/imagining-constructions-digital-future (accessed on 2 August 2021).
  5. EU BIM Task Group. Handbook for the Introduction of Building Information Modelling by the European Public Sector: Strategic action for Construction Sector Performance: Driving Value, Innovation and Growth. Available online: http://www.eubim.eu/handbook-selection/ (accessed on 2 August 2021).
  6. Gerbert, P.; Castagnino, S.; Rothballer, H.; Re, A.; Filitz, R. The Transformative Power of Building Information Modeling: Digital in Engineering and Construction. Available online: https://www.bcg.com/de-de/publications/2016/engineered-products-infrastructure-digital-transformative-power-building-information-modeling (accessed on 2 August 2021).
  7. Lewis, A.; Riley, D.; Elmualim, A. Defining High Performance Buildings for Operations and Maintenance. IJFM 2010, 1, 1–16. [Google Scholar]
  8. Pfnür, A. Volkswirtschaftliche Bedeutung von Corporate Real Estate in Deutschland. Available online: https://www.aurelis-real-estate.de/fileadmin/user_upload/Bilder/News/Studien/Studie_CREM.pdf (accessed on 15 February 2021).
  9. Scarponcini, P. Editorial: Time for an Integrated Approach to Facility Management. JCCE 1996, 10, 1. [Google Scholar] [CrossRef]
  10. Edirisinghe, R.; London, K.A.; Kalutara, P.; Aranda-Mena, G. Building information modelling for facility management: Are we there yet? ECAM 2017, 24, 1119–1154. [Google Scholar] [CrossRef]
  11. Glatte, T. Corporate Real Estate Management; Springer Fachmedien Wiesbaden: Wiesbaden, Germany, 2021; ISBN 978-3-658-32221-2. [Google Scholar]
  12. Heywood, C.; Kenley, R. Five axioms for corporate real estate management: A polemical review of the literature. In Proceedings of the PRRES Conference—2013, Melbourne, Australia, 13–16 January 2013. [Google Scholar]
  13. Wilkinson, S.J.; Jupp, J.R. Exploring the value of BIM for corporate real estate. JCRE 2016, 18, 254–269. [Google Scholar] [CrossRef] [Green Version]
  14. Alshorafa, R.; Ergen, E. Identification of information requirements for implementing Building Information Modeling based on model uses. ITcon 2020, 25, 561–574. [Google Scholar] [CrossRef]
  15. Munir, M.; Kiviniemi, A.; Jones, S.W. Business value of integrated BIM-based asset management. ECAM 2019, 26, 1171–1191. [Google Scholar] [CrossRef] [Green Version]
  16. Cavka, H.B.; Staub-French, S.; Poirier, E.A. Developing owner information requirements for BIM-enabled project delivery and asset management. AIC 2017, 83, 169–183. [Google Scholar] [CrossRef]
  17. Munir, M.; Kiviniemi, A.; Jones, S.; Finnegan, S. BIM-based operational information requirements for asset owners. AEDM 2020, 16, 100–114. [Google Scholar] [CrossRef]
  18. Becerik-Gerber, B.; Jazizadeh, F.; Li, N.; Calis, G. Application Areas and Data Requirements for BIM-Enabled Facilities Management. JCEM 2012, 138, 431–442. [Google Scholar] [CrossRef]
  19. McArthur, J.J.; Sun, X. Best practices for BIM Execution Plan development for a Public–Private Partnership Design-Build-Finance-Operate-Maintain project. In Building Information Modelling (BIM) in Design, Construction and Operations; BIM 2015; Mahdjoubi, L., Brebbia, C.A., Laing, R., Eds.; WIT Press: Southampton, UK, 2015; pp. 119–130. [Google Scholar]
  20. Sarstedt, M.; Mooi, E. A Concise Guide to Market Research; Springer: Berlin/Heidelberg, Germany, 2019; ISBN 978-3-662-56706-7. [Google Scholar]
  21. Casula, M.; Rangarajan, N.; Shields, P. The potential of working hypotheses for deductive exploratory research. Qual. Quant. 2020, 55, 1703–1725. [Google Scholar] [CrossRef] [PubMed]
  22. McGraw Hill Construction Research & Analytics. The Business Value of BIM for Construction in Global Markets: How Contractors Around the World Are Driving Innovation with Building Information Modeling. Available online: https://www.construction.com/toolkit/reports/bim-business-value-construction-global-markets (accessed on 22 March 2022).
  23. Construction IT Alliance Limited. BICP Global BIM Study: Lessons for Ireland’s BIM Programme. Available online: http://www.bicp.ie/bicp-global-bim-study (accessed on 21 July 2021).
  24. German Facility Management Association e.V. Facility Management: Leistungsspektrum; German Facility Management Association: Berlin, Germany, 2004. [Google Scholar]
  25. Carbonari, G.; Stravoravdis, S.; Gausden, C. Improving FM task efficiency through BIM: A proposal for BIM implementation. JCRE 2018, 20, 4–15. [Google Scholar] [CrossRef]
  26. Campanelli, P. Testing survey questions. In International Handbook of Survey Methodology; Online-Ausgabe; de Leeuw, E.D., Hox, J.J., Dillman, D., Eds.; Taylor and Francis: Florence, Italy, 2008; pp. 176–200. ISBN 9780203843123. [Google Scholar]
  27. Stockemer, D. Quantitative Methods for the Social Sciences; Springer International Publishing: Cham, Switzerland, 2019; ISBN 978-3-319-99117-7. [Google Scholar]
  28. European Commission. NACE Rev. 2: Statistical Classification of Economic Activities in the European Community; Office for Official Publications of the European Communities: Luxemburg, 2008; ISBN 9789279047411. [Google Scholar]
  29. Love, P.E.; Matthews, J.; Simpson, I.; Hill, A.; Olatunji, O.A. A benefits realization management building information modeling framework for asset owners. AIC 2014, 37, 1–10. [Google Scholar] [CrossRef]
  30. Hox, J.J. Accommodating measurement errors. In International Handbook of Survey Methodology; Online-Ausgabe; de Leeuw, E.D., Hox, J.J., Dillman, D., Eds.; Taylor and Francis: Florence, Italy, 2008; pp. 387–402. ISBN 9780203843123. [Google Scholar]
  31. Scott Jones, J. Learn to Use the Eta Coefficient Test in R with Data from the NIOSH Quality of Worklife Survey. 2014. Available online: https://methods.sagepub.com/dataset/eta-coefficient-niosh-qwl-2014?fromsearch=true (accessed on 20 December 2021).
  32. Krumm, P.J. History of real estate management from a corporate perspective. Facilities 2001, 19, 276–286. [Google Scholar] [CrossRef]
  33. Jalil Omar, A.; Heywood, C.A. Defining a corporate real estate management’s (CREM) brand. JCRE 2014, 16, 60–76. [Google Scholar] [CrossRef] [Green Version]
  34. van der Voordt, T. Facilities management and corporate real estate management: FM/CREM or FREM? JFM 2017, 15, 244–261. [Google Scholar] [CrossRef] [Green Version]
  35. Redlein, A. Modern Facility and Workplace Management; Springer International Publishing: Cham, Switzerland, 2020; ISBN 978-3-030-35313-1. [Google Scholar]
  36. International Organisation for Standardisation. Facility Management—Vocabulary; International Organisation for Standardisation (ISO): Geneva, Switzerland, 2017. [Google Scholar]
  37. Kassem, M.; Kelly, G.; Dawood, N.; Serginson, M.; Lockley, S. BIM in facilities management applications: A case study of a large university complex. Built Environ. Proj. Asset Manag. 2015, 5, 261–277. [Google Scholar] [CrossRef] [Green Version]
  38. Carbonari, G.; Ashworth, S.; Stravoravdis, S. How facility management can use building information modelling (BIM) to improve the decision making process. JfFM 2015, 10, 55–69. [Google Scholar]
  39. Eadie, R.; Browne, M.; Odeyinka, H.; McKeown, C.; McNiff, S. BIM implementation throughout the UK construction project lifecycle: An analysis. AIC 2013, 36, 145–151. [Google Scholar] [CrossRef]
  40. Pärn, E.A.; Edwards, D.J.; Sing, M. The building information modelling trajectory in facilities management: A review. AIC 2017, 75, 45–55. [Google Scholar] [CrossRef] [Green Version]
  41. Evjen, T.Å.; Raviz, S.R.H.; Petersen, S.A. Enterprise BIM: A Holistic Approach to the Future of Smart Buildings. In REAL CORP 2020: Shaping Urban Change—Livable City Regions for the 21st Century, Proceedings of the 25th International Conference on Urban Planning, Regional Development and Information Society, Virtual Conference, 15–18 September 2020; Schrenk, M., Popovich, V.V., Zeile, P., Elisei, P., Beyer, C., Ryser, J., Reicher, C., Çelik, C., Eds.; Schrenk, M., Popovich, V.V., Zeile, P., Elisei, P., Beyer, C., Ryser, J., Reicher, C., Çelik, C., Eds.; CORP-Competence Center of Urban and Regional Planning: Wien, Österreich, 2020; pp. 251–260. [Google Scholar]
  42. McGraw Hill Construction Research & Analytics. Measuring the Impact of BIM on Complex Buildings. Available online: https://www.construction.com/toolkit/reports/measuring-impact-bim-complex-buildings (accessed on 22 March 2022).
  43. Terreno, S.; Asadi, S.; Anumba, C. An Exploration of Synergies between Lean Concepts and BIM in FM: A Review and Directions for Future Research. Buildings 2019, 9, 147. [Google Scholar] [CrossRef] [Green Version]
  44. BuildingSMART Alliance. National BIM Standard—United States® Version 3–5.7 BIM Planning Guide for Facility Owners, Version 2.0—June 2013. Available online: https://www.nationalbimstandard.org/nbims-us (accessed on 30 April 2021).
  45. Wijekoon, C.; Manewa, A.; Ross, A.D. Enhancing the value of facilities information management (FIM) through BIM integration. ECAM 2018, 27, 809–824. [Google Scholar] [CrossRef]
  46. Messner, J.; Anumba, C.; Dubler, C.; Goodman, S.; Kasprzak, C.; Kreider, R.; Leicht, R.; Saluja, C.; Zikic, N. BIM Project Execution Planning Guide—Version 2.2. Available online: https://bim.psu.edu/ (accessed on 3 February 2021).
  47. Godager, B.; Onstein, E.; Huang, L. The Concept of Enterprise BIM: Current Research Practice and Future Trends. IEEE Access 2021, 9, 42265–42290. [Google Scholar] [CrossRef]
  48. Jupp, J.; Awad, R. BIM-FM and Information Requirements Management: Missing Links in the AEC and FM Interface. In Proceedings of the 14th IFIP International Conference on Product Lifecycle Management (PLM), Seville, Spain, 10–12 July 2017; Ríos, J., Bernard, A., Bouras, A., Foufou, S., Eds.; Springer International Publishing: Cham, Switzerland, 2017; pp. 311–316, ISBN 978-3-319-72904-6. [Google Scholar]
  49. Lin, Y.-C.; Chen, Y.-P.; Huang, W.-T.; Hong, C.-C. Development of BIM Execution Plan for BIM Model Management during the Pre-Operation Phase: A Case Study. Buildings 2016, 6, 8. [Google Scholar] [CrossRef] [Green Version]
  50. Bähre, B. Building Information Modeling: The ‘C’ in BIM. In Informed Architecture; Hemmerling, M., Cocchiarella, L., Eds.; Springer International Publishing: Cham, Switzerland, 2018; pp. 39–52. ISBN 978-3-319-53134-2. [Google Scholar]
  51. Ashworth, S.; Tucker, M. FM Awareness of Building Information Modelling (BIM). Available online: https://www.iwfm.org.uk/resource/fm-awareness-of-bim.html (accessed on 15 July 2021).
  52. Miettinen, R.; Kerosuo, H.; Metsälä, T.; Paavola, S. Bridging the life cycle: A case study on facility management infrastructures and uses of BIM. JFM 2018, 16, 2–16. [Google Scholar] [CrossRef] [Green Version]
  53. Deutsches Institut für Normung e.V. Deutsche Normungsroadmap BIM: Version 1. Available online: https://www.din.de/de/din-und-seine-partner/presse/mitteilungen/breite-anwendung-von-bim-foerdern-847244 (accessed on 16 December 2021).
  54. Hilal, M.A.; Maqsood, T.; Abdekhodaee, A. A scientometric analysis of BIM studies in facilities management. IJBPA 2019, 37, 122–139. [Google Scholar] [CrossRef]
  55. Mayo, G.; Issa, R.R.A. Nongeometric Building Information Needs Assessment for Facilities Management. JME 2016, 32, 4015054. [Google Scholar] [CrossRef]
  56. Lazar, S.; McArthur, J.J. BIM for Corporate Real Estate Data Visualization from Disparate Systems. In Smart City 360°; Leon-Garcia, A., Lenort, R., Holman, D., Staš, D., Krutilova, V., Wicher, P., Cagáňová, D., Špirková, D., Golej, J., Nguyen, K., Eds.; Springer International Publishing: Cham, Switzerland, 2016; pp. 504–516. ISBN 978-3-319-33680-0. [Google Scholar]
  57. Taber, K.S. The Use of Cronbach’s Alpha When Developing and Reporting Research Instruments in Science Education. Res. Sci. Educ. 2018, 48, 1273–1296. [Google Scholar] [CrossRef]
  58. Triantaphyllou, E.; Mann, S.H. An examination of the effectiveness of multi-dimensional decision-making methods: A decision-making paradox. Decis. Support Syst. 1989, 5, 303–312. [Google Scholar] [CrossRef]
  59. Tofallis, C. Add or Multiply? A Tutorial on Ranking and Choosing with Multiple Criteria. INFORMS Trans. Educ. 2014, 14, 109–119. [Google Scholar] [CrossRef]
  60. Fang, Z.; Liu, Y.; Lu, Q.; Pitt, M.; Hanna, S.; Tian, Z. BIM-integrated portfolio-based strategic asset data quality management. AIC 2022, 134, 104070. [Google Scholar] [CrossRef]
  61. BuildingSMART International. Use Case Documentation. Available online: https://www.buildingsmart.org/wp-content/uploads/2019/02/bSI-Awards-2019-Use-Case-Documentation-V4-1.xlsx (accessed on 1 June 2021).
  62. Institut für Technologie und Management im Baubetrieb. Katalog der BIM-Anwendungsfälle. Available online: https://www.tmb.kit.edu/download/Katalog_der_BIM-Anwendungsfaelle.pdf (accessed on 17 March 2021).
  63. BIMe Initiative. BIMe Initiative Model Uses List. Available online: https://bimexcellence.org/resources/200series/211in/ (accessed on 1 June 2021).
  64. Statsbygg. Statsbygg Building Information Modelling Manual. Version 1.2.1. Available online: www.statsbygg.no/bim (accessed on 1 June 2021).
  65. Bouw Informatie Raad. Poster BIM Uses. Available online: https://www.bouwinformatieraad.nl/main.php?mode=download_cat&cat_id=10 (accessed on 2 June 2021).
  66. NATSPEC. NATSPEC National BIM Guide. Available online: https://bim.natspec.org/documents/natspec-national-bim-guide (accessed on 8 June 2021).
  67. Construction Industry Council. CIC BIM Standards General Version 2. Available online: https://www.bim.cic.hk/en/resources/publications?cate=48 (accessed on 9 June 2021).
  68. Direction générale de l’Aménagement, du Logement et de la Nature. Plan BIM 2022. Available online: https://www.cohesion-territoires.gouv.fr/sites/default/files/2019-07/Plan%20BIM%202022.pdf (accessed on 21 April 2021).
  69. BuildingSMART France. Guide: Comment Rédiger Une Convention BIM? Available online: https://buildingsmartfrance-mediaconstruct.fr/memos-pratiques-BIM/ (accessed on 11 May 2021).
  70. College of Engineering. BIM Uses. Available online: https://bim.psu.edu/uses/ (accessed on 1 June 2021).
  71. New York City Department of Design and Construction. BIM Guidelines. Available online: https://www1.nyc.gov/site/ddc/resources/publications.page (accessed on 2 June 2021).
  72. buildingSMART Finland. COBIM Common BIM Requirements: Series 12 Use of Models in Facility Management. Available online: https://buildingsmart.fi/en/common-bim-requirements-2012/ (accessed on 7 June 2021).
  73. Building and Construction Authority. Singapore BIM Guide Version 2. Available online: https://www.corenet.gov.sg/media/586132/Singapore-BIM-Guide_V2.pdf (accessed on 7 June 2021).
  74. AEC. AEC (UK) BIM Protocol Project BIM Execution Plan. Available online: https://aecuk.wordpress.com/documents/ (accessed on 8 February 2022).
Figure 1. Research methodology.
Figure 1. Research methodology.
Buildings 12 00400 g001
Figure 2. Disciplines of corporate real estate management and infrasturctural facility services.
Figure 2. Disciplines of corporate real estate management and infrasturctural facility services.
Buildings 12 00400 g002
Figure 3. (a) CREM with a focus on real estate management; (b) CREM with a focus on end users; (c) Possible integration of FM and CREM into FREM (according to van der Voordt [34]).
Figure 3. (a) CREM with a focus on real estate management; (b) CREM with a focus on end users; (c) Possible integration of FM and CREM into FREM (according to van der Voordt [34]).
Buildings 12 00400 g003
Figure 4. Effort distribution on the life cycle phases in the traditional workflow compared to the BIM workflow [50].
Figure 4. Effort distribution on the life cycle phases in the traditional workflow compared to the BIM workflow [50].
Buildings 12 00400 g004
Figure 5. Distribution of respondents’ industries (n = 37).
Figure 5. Distribution of respondents’ industries (n = 37).
Buildings 12 00400 g005
Figure 6. Distribution of respondents’ positions (n = 37).
Figure 6. Distribution of respondents’ positions (n = 37).
Buildings 12 00400 g006
Figure 7. The arithmetic mean of BIM uses’ benefit assessments from (1—Very Low Benefit) to (5—Very High Benefit) (n = 38).
Figure 7. The arithmetic mean of BIM uses’ benefit assessments from (1—Very Low Benefit) to (5—Very High Benefit) (n = 38).
Buildings 12 00400 g007
Figure 8. BIM uses’ benefit assessments and their respective correlation to the respondents’ industries as ETA coefficient (n = 33).
Figure 8. BIM uses’ benefit assessments and their respective correlation to the respondents’ industries as ETA coefficient (n = 33).
Buildings 12 00400 g008
Figure 9. Prioritisation for the development of BIM uses for FM in CREM [60].
Figure 9. Prioritisation for the development of BIM uses for FM in CREM [60].
Buildings 12 00400 g009
Table 1. Related studies investigating BIM uses for FM.
Table 1. Related studies investigating BIM uses for FM.
AuthorsYearApproach
Becerik-Gerber et al. [18]2012Potential FM application areas that BIM can
be used for, mainly within the context of PRE
McArthur and Sun [19]2015Analysis and prioritisation of BIM uses in
public-private partnerships in different industries
Mayo and Issa [55]2016Examination of BIM use information requirements based on categories within the context of PRE
Cavka et al. [16]2017Definition of owner information requirements based on O&M functions within the context of PRE
Miettinen et al. [52]2018Analysis of the current state of implementation
of BIM for FM within the context of PRE
Alshorafa and Ergen [14]2020Definition of specific IR and their LOD, depending on BIM uses for FM identified during an expert survey
Table 2. Related studies investigating BIM uses for CREM.
Table 2. Related studies investigating BIM uses for CREM.
AuthorsYearApproach
Lazar and McArthur [56]2016Case study demonstration of BIM data
visualisation benefits within the context of CRE
Carbonari et al. [25]2018Analysis of possible BIM application areas
for operations within the context of CRE
Table 3. Identified BIM uses for FM in CREM.
Table 3. Identified BIM uses for FM in CREM.
FM Main ProcessNo.BIM Use
1 Commissioning11Handover and Commissioning
12As-Built Modelling and Documentation
2 Manage
Operations
21Visualisation
22Disaster Planning and Emergency Preparedness
23Wayfinding and Tracking
24Generate: 2D Plans and 3D Details
25FM Documentation: Management and Maintenance
26Ticket Management
27FM Quality Management
28FM Sustainability and Environmental Protection
3 Provide
Workplaces
31Space and Room Management
32Relocation Management
33Equipment and Furnishing
4 Operations41BIM 2 Field
42Structural Health Monitoring
43Facility Identification System
44Facilities and Equipment: Periodic Inspections
45Facilities and Equipment: Inspection and Maintenance
46Facilities and Equipment: Repair and Renewal
5 Supply and Disposal51Real-time Acquisition and Display of Sensor Data
52Energy Management
53Waste Management
6 Cleaning and
Maintaining
61Cleaning Management: Maintenance Cleaning
62Cleaning management: Glass and Facade Cleaning
63Cleaning Management: Outdoor Facilities Cleaning
7 Asset
Management
71Security Management
72Locking Management
73Rent Management
74Generate: Inventory, Component, and Equipment Lists
75FM Accounting and FM Controlling
76Perform Contract and Insurance Management
77Defect Management
8 Provide
Support
81Room Booking and Occupancy Systems
82Event Planning
83Perform Procurement
Table 4. Pearson’s correlation coefficient for the interpretation of the ETA coefficient.
Table 4. Pearson’s correlation coefficient for the interpretation of the ETA coefficient.
Pearson’s Correlation CoefficientInterpretation
0.00No association between the two variables
0.01–0.19No or negligible association between the variables
0.2–0.39A weak association between the variables
0.4–0.69Medium association between the variables
0.70–1.0Strong association between the variables
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Benn, M.; Stoy, C. BIM for CREM: Exploring the Benefit of Building Information Modelling for Facility Management in Corporate Real Estate Management. Buildings 2022, 12, 400. https://doi.org/10.3390/buildings12040400

AMA Style

Benn M, Stoy C. BIM for CREM: Exploring the Benefit of Building Information Modelling for Facility Management in Corporate Real Estate Management. Buildings. 2022; 12(4):400. https://doi.org/10.3390/buildings12040400

Chicago/Turabian Style

Benn, Maximilian, and Christian Stoy. 2022. "BIM for CREM: Exploring the Benefit of Building Information Modelling for Facility Management in Corporate Real Estate Management" Buildings 12, no. 4: 400. https://doi.org/10.3390/buildings12040400

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
