System Dynamics Modeling Strategy for Civil Construction Projects: The Concept of Successive Legislation Periods
Abstract
:1. Introduction
1.1. Background
1.2. Literature Review
1.3. Research Objectives

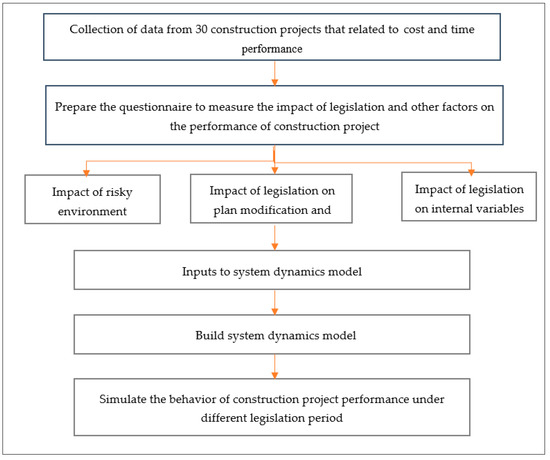

2. Methods
2.1. Introduction
2.2. Mathematical Formulations
2.3. Data Collection
2.4. Development of System Dynamics Model

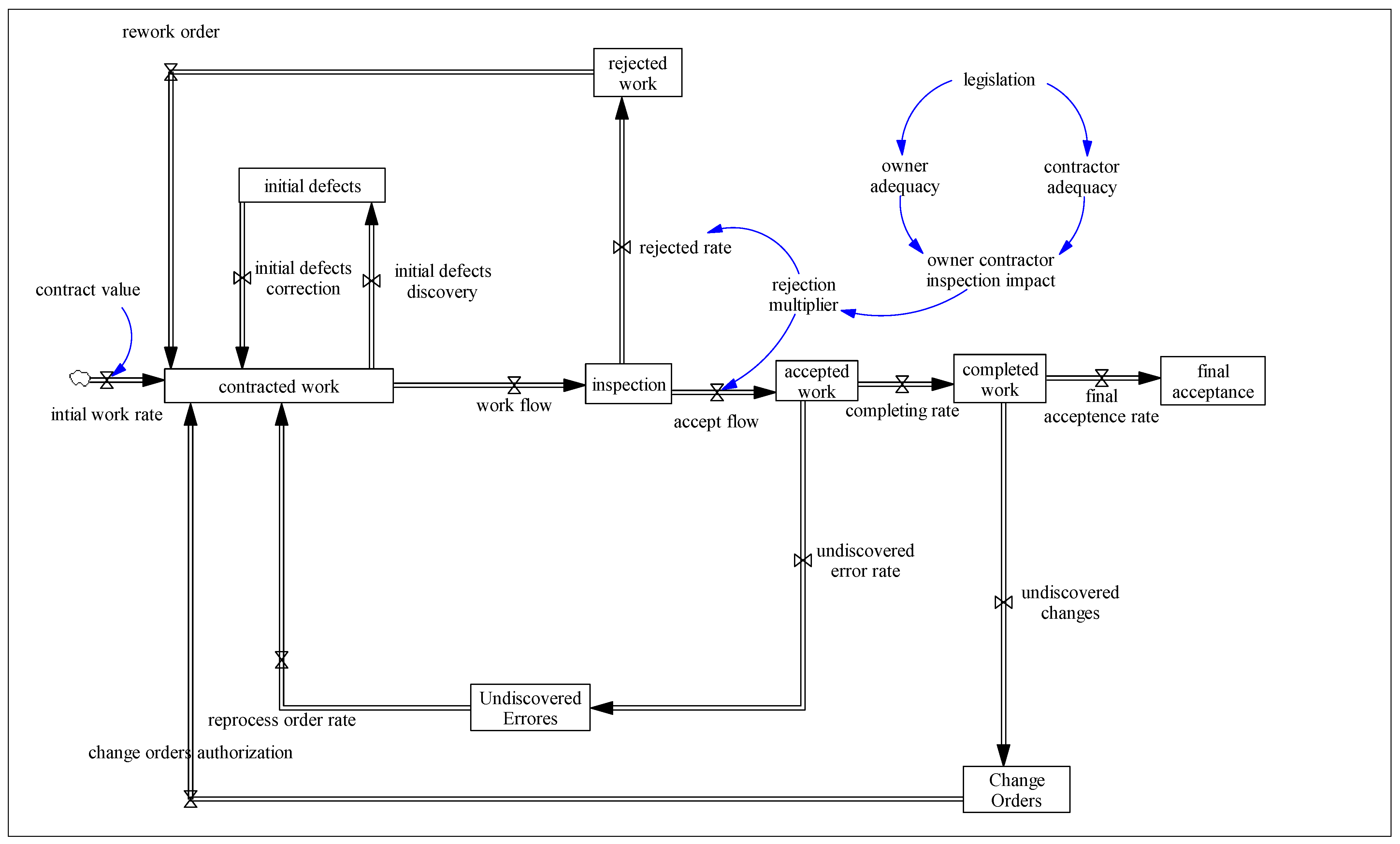

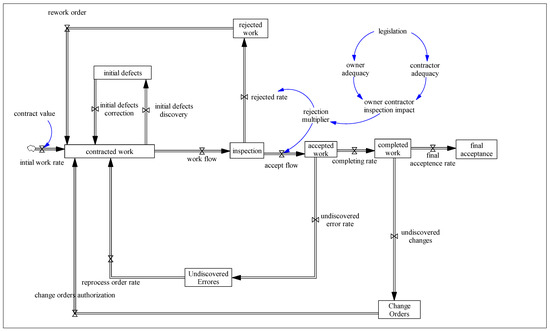

- 1-
- The accumulated items as obligation on the contractor in the “contracted work” stock is dispersed through the flow rate “workflow” that convey the tasks or obligations to the “inspection” stock.
- 2-
- The initial defects that are mainly related to the original errors either in the bill of quantities due to miscalculation or estimation or due to discrepancies in designs. These defects are often discovered at the early beginnings of the project commence [14]. The accumulated values of these defects are computed in the “initial defects” stock and are reconsidered as obligation items at the rate of “initial defects correction”, which governs the flow of items between the stocks of “initial defects” and “contracted work”.
- 3-
- The “workflow” rate is affected by the external risky environment factors, such as inflation, terrorism, and budget shortage, as well as the internal factors, such as owner adequacy and contractor adequacy, which both vary a great deal according to the legislative period. The effect of these factors varies with the time ratio, which represents the remaining time divided by the total contract time.
- 4-
- The raw materials to be supplied as well as every work item to be accomplished must be inspected for quality assurance. This process is simulated in the accumulation in the “inspection” stock in which the item is either accepted. In this case, it is dispersed through the “accept flow” rate to the “accepted work” stock and goes on or rejected being transferred through the “rejection” rate to the “rejected work” stock to be reinitiated once again [39]. The amount of rejected work is dependent on owner adequacy and contractor adequacy, which legislation constrains.
- 5-
- The rejected works simulated by transferring these items to the stoke “rejected work” and then reinitiating them by issuing by issuing rework orders, as done in the rate “rework orders” by which these rejected items are flown back to the stock “contracted work”.
- 6-
- The stock “accepted work” represents all of the completed and accepted items that are mostly transferred to the “completed work” stock by the flow rate “accepting rate.
- 7-
- The undiscovered requirements that often lately emerge mostly due to neglecting certain aspects in the design phase or the presence of some sort of conflict between the documents of the contract that do not materialize until the completion of some stages in the project [14]. Such items usually arise as a percentage of the accepted work that may require ordering the initiation of the required items that are represented in the stock “undiscovered errors”. These items are transferred to the “contracted work” stoke at the rate of the “reprocess order rate”.
- 8-
- The change orders that includes all newly added groups of items either due to emerging needs to augment certain recently completed parts of the project or due to a request by the owner to fulfill its own requirements.
- 9-
- The “completing rate” flows into the stock “completed work” in which all of the competed and accepted items are accumulated, and no action should be taking on them until the final acceptance, unless some major change orders are issued that will definitely affect some of the completed and accepted items.
- 10-
- The final stock is the “final acceptance”, in which all of the completed and accepted items are accumulated after the issuing of the final acceptance certificate of the project. The total cost accumulated in this stock represents the final cost of the project and the project legally terminates when the value of this stock reaches the total summation of the contract cost, plus the total cost of the additional change orders.
- 11-
- The change in time is then determined by subtracting the value of contract duration from the duration that is required to implement the project that is mathematically calculated in the auxiliary “conclusion reference”, and the difference is then divided on the value of contract duration [40].
2.5. Model Calibration and Validation
3. Research Results and Discussion
4. Conclusions
Author Contributions
Conflicts of Interest
References
- Vorakulpipat, C.; Rezgui, Y.; Hopfe, C.J. Value creating construction virtual teams: A case study in the construction sector. Autom. Constr. 2010, 19, 142–147. [Google Scholar] [CrossRef]
- Memon, A.H.; Abdul Rahman, I.; Abdul Azis, A.A. Preliminaries Study on Causative Factors Leading to Construction Cost Overrun. Int. J. Sustain. Constr. Eng. Technol. 2011, 2, 57–71. [Google Scholar]
- Love, P.; Mandal, P.; Smith, J. Modelling the dynamics of design error induced rework in construction. Constr. Manag. Econ. 2000, 18, 567–574. [Google Scholar] [CrossRef]
- Sun, M.; Meng, X. Taxonomy for change causes and effects in construction projects. Int. J. Manag. 2009, 27, 560–572. [Google Scholar] [CrossRef]
- Erdogan, B.; Anumba, C.; Bouchlaghem, D.; Nielsen, Y. Change Management in Construction: The Current Context. In Proceedings of the 21st Annual ARCOM Conference, London, UK, 7–9 September 2005; pp. l085–l095. [Google Scholar]
- Hsieh, T.; Lu, S.; Wu, C. Satistical analysis of causes for change orders in metropolitan works. Int. J. Proj. Manag. 2004, 22, 679–686. [Google Scholar] [CrossRef]
- Wu, C.; Hsieh, T.; Cheng, W. Statistical analysis of causes for design change in highway construction on Taiwan. Int. J. Manag. 2005, 23, 554–563. [Google Scholar] [CrossRef]
- Ahmed, H.; Yusuff, R. Factors Affecting Quality During The Construction Phase in Iraqi Government Companies. Int. J. Appl. Eng. Res. 2016, 11, 7974–7981. [Google Scholar]
- Naji, H.; Ibrahim, A.; Hassan, Z. evaluation of legislation adequacy in managing time and quality performance in construction projects—A bayesian decision tree approach. Civ. Eng. J. 2018, 4, 993. [Google Scholar]
- Zhao, Z.Y.; Lv, Q.L.; Zuo, J.; Zillante, G. Prediction system for change management in construction project. J. Constr. Eng. Manag. 2009, 136, 659–669. [Google Scholar] [CrossRef]
- Iyagba, R.O.; Ijaola, I.A. A comparative study of causes of change orders in public construction project in Nigeria and Oman. J. Emerg. Trends Econ. Manag. Sci. 2012, 3, 495–501. [Google Scholar]
- Elawi, G.; Algahtany, M.; Sullivan, K. Major Factors Causing Construction Delays in Mecca. J. Adv. Perform. Inf. Value 2015, 31, 7. [Google Scholar]
- Al-Ageeli, H.; Alzobaee, A.S. The Most Influential Factor on the Stumble and Failure of the governmental Projects. J. Eng. 2016, 22, 93–110. [Google Scholar]
- Naji, H.; Zehawi, R.; Hasan, Z. Managing Quality performance by Legislation in Iraqi Construction Projects: A system Dynamics Approach. J. Eng. Appl. Sci. 2018, 13, 8511–8519. [Google Scholar]
- Rodrigues, A.; Williams, T. System dynamics in project management: Assessing the impacts of client behaviour on project performance. J. Oper. Soc. 1998, 49, 2. [Google Scholar] [CrossRef]
- Park, M.; Peña-Mora, F. Dynamic change management for construction: Introducing the change cycle into model-based project management. Syst. Dyn. Rev. 2003, 19, 213–242. [Google Scholar] [CrossRef]
- Lee, S.H.; Peña-Mora, F.; Park, M. Dynamic planning and control methodology for strategic and operational construction project management. Autom. Constr. 2006, 15, 84–97. [Google Scholar] [CrossRef]
- Elbeltagi, E.; Hegazy, T.; Eldosouky, A. Dynamic layout of construction temporary facilities considering safety. J. Constr. Eng. Manag. 2004, 130, 534–541. [Google Scholar] [CrossRef]
- Lyneis, J.; Cooper, K.; Els, S. Strategic management of complex projects: A case study using system dynamics. Syst. Dyn. Rev. 2001, 17, 237–260. [Google Scholar] [CrossRef]
- Lyneis, J.; Ford, D. System dynamics applied to project management: A survey, assessment, and directions for future research. Syst. Dyn. Rev. 2007, 23, 157–189. [Google Scholar] [CrossRef]
- Shen, L.Y.; Wu, Y.Z.; Chan, E.H.W.; Hao, J.L. Application of system dynamics for assessment of sustainable performance of construction projects. J. Zhejiang Univ. Sci. A 2005, 6, 339–349. [Google Scholar] [CrossRef]
- Love, P.E.D.; Holt, G.D.; Shen, L.Y.; Li, H.; Irani, Z. Using systems dynamics to better understand change and rework in construction project management systems. Int. J. Proj. Manag. 2002, 20, 425–436. [Google Scholar] [CrossRef]
- Ding, Z.; Zhu, M.; Tam, V.W.Y.; Yi, G.; Tran, C.N.N. A system dynamics-based environmental benefit assessment model of construction waste reduction management at the design and construction stages. J. Clean. Prod. 2018, 176, 676–692. [Google Scholar] [CrossRef]
- Ivancevich, J.M.; McMahon, J.T. The effects of goal setting, external feedback, and self-generated feedback on outcome variables: A field experiment. Acad. Manag. J. 1982, 25, 359–372. [Google Scholar]
- Ogunlana, S.O.; Li, H.; Sukhera, F.A. System Dynamics Approach to Exploring Performance Enhancement in a Construction Organization. J. Constr. Eng. Manag. 2003, 129, 528–536. [Google Scholar] [CrossRef]
- Nasirzadeh, F.; Nojedehi, P. Dynamic modeling of labor productivity in construction projects. Int. J. Proj. Manag. 2013, 31, 903–911. [Google Scholar] [CrossRef]
- Ford, D.; Sterman, J. Dynamic modeling of product development processes. Syst. Dyn. Rev. 1998, 14, 31–68. [Google Scholar] [CrossRef]
- Lee, S.; Peña-Mora, F.; Park, M. Quality and Change Management Model for Large Scale Concurrent Design and Construction Projects. J. Constr. Eng. Manag. 2005, 131, 890–902. [Google Scholar] [CrossRef]
- Lee, S.H.; Peña-Mora, F. Understanding and managing iterative error and change cycles in construction. Syst. Dyn. Rev. 2007, 23, 35–60. [Google Scholar] [CrossRef]
- Motawa, I.A.; Anumba, C.J.; Lee, S.; Peña-Mora, F. An integrated system for change management in construction. Autom. Constr. 2007, 16, 368–377. [Google Scholar] [CrossRef]
- Han, S.; Love, P.; Peña-Mora, F. A system dynamics model for assessing the impacts of design errors in construction projects. Math. Comput. Model. 2013, 57, 2044–2053. [Google Scholar] [CrossRef]
- Yuan, H.P.; Shen, L.Y.; Hao, J.J.L.; Lu, W.S. A model for cost–benefit analysis of construction and demolition waste management throughout the waste chain. Resour. Conserv. Recycl. 2011, 55, 604–612. [Google Scholar] [CrossRef]
- Golroudbary, S.R.; Zahraee, S.M. System dynamics model for optimizing the recycling and collection of waste material in a closed-loop supply chain. Simul. Model. Pract. Theory 2015, 53, 88–102. [Google Scholar] [CrossRef]
- Chen, C. A Proactive Approach for Change Management and Control on Construction Projects; University of California: Berkeley, CA, USA, 2015. [Google Scholar]
- Thomas, S.J. Using Web and Paper Questionnaires for Data-Based Decision Making: From Design to Interpretation of the Results; Corwin Press: Thousand Oaks, CA, USA, 2004; ISBN 1506318487. [Google Scholar]
- Botter, C.H. Project management: A systems approach to planning, scheduling and controlling. Eur. J. Oper. Res. 1982, 10, 211. [Google Scholar] [CrossRef]
- Panova, Y.; Hilletofth, P. Managing supply chain risks and delays in construction project. Ind. Manag. Data Syst. 2018, 118, 1413–1431. [Google Scholar] [CrossRef]
- Nasirzadeh, F.; Carmichael, D.G.; Jarban, M.J.; Rostamnezhad, M. Hybrid fuzzy-system dynamics approach for quantification of the impacts of construction claims. Eng. Constr. Arch. Manag. 2019, 1–16. [Google Scholar] [CrossRef]
- Hussain, S.; Fangwei, Z.; Siddiqi, A.; Ali, Z.; Shabbir, M. Structural equation model for evaluating factors affecting quality of social infrastructure projects. Sustainability 2018, 10, 1415. [Google Scholar] [CrossRef]
- Xu, X.; Wang, J.; Li, C.Z.; Huang, W.; Xia, N. Schedule risk analysis of infrastructure projects: A hybrid dynamic approach. Autom. Constr. 2018, 95, 20–34. [Google Scholar] [CrossRef]
References | Contribution of Research |
---|---|
[3] | They used system dynamics model to describe the impact of changes and rework on the construction project management. |
[28] | The developed system dynamics model to measure the impact of iterative cycle on the performance of concurrent Design and Construction Projects. |
[29] | They proposed system dynamics model to control error and change in construction project. |
[30] | They developed system dynamics model to evaluate the impact of rework cycle on the performance of construction project. |
[31] | They used system dynamics to understand the dynamics of deign defects and their impacts on the performance of construction project. |
[32] | They used system dynamics model to simulate the effect of different strategies and change in traditional construction culture and behavior in construction and demolition waste reduction. |
[23] | They developed system dynamics model to assess waste reduction outcome in both design and construction stage. The research can provide reference in reduction management outcomes of construction projects and environmental benefits. |
[33] | They evaluate the system behavior of the recycling and collection of waste material by using system dynamics model in a closed loop supply chain. The results showed that can used this method to investigate the effect of CLSC system before using them in construction project. |
Current study | The current study aims to study the impact of changes that related to owner, contractor, design and changes that happen in the environment during the period 2003 to 2014. System dynamics was developed to study these changes in more detail and simulate the behavior of project performance under these circumstances. |
Legislative Period | Duration | Cost Change % | Time Schedule Change % |
---|---|---|---|
1 | 2003–2006 | 16.85 | 205.37 |
2 | 2007–2008 | 9.62 | 156.36 |
3 | 2009–2011 | 8.61 | 113.1 |
4 | 2012–2014 | 8.53 | 66.67 |

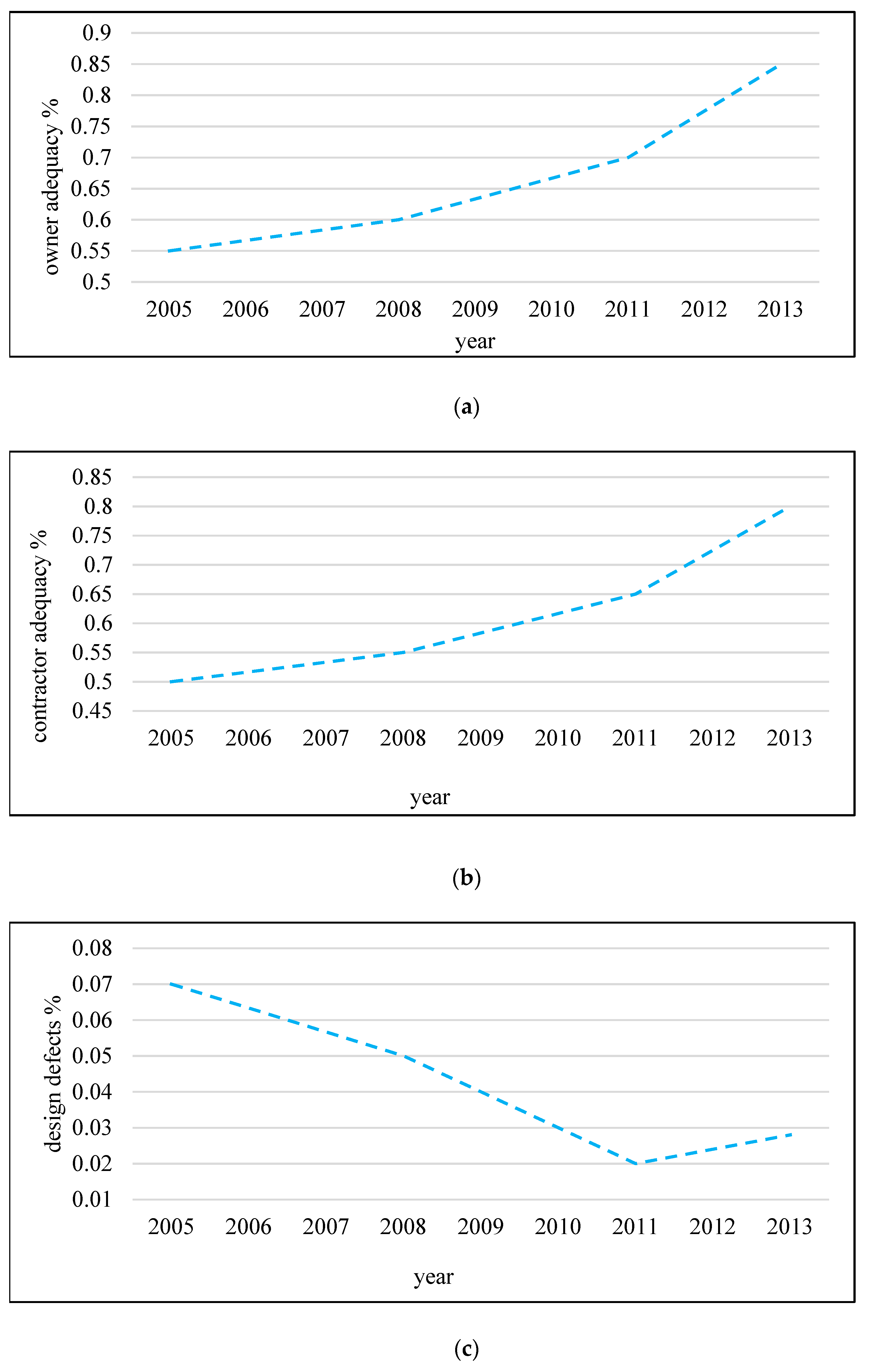

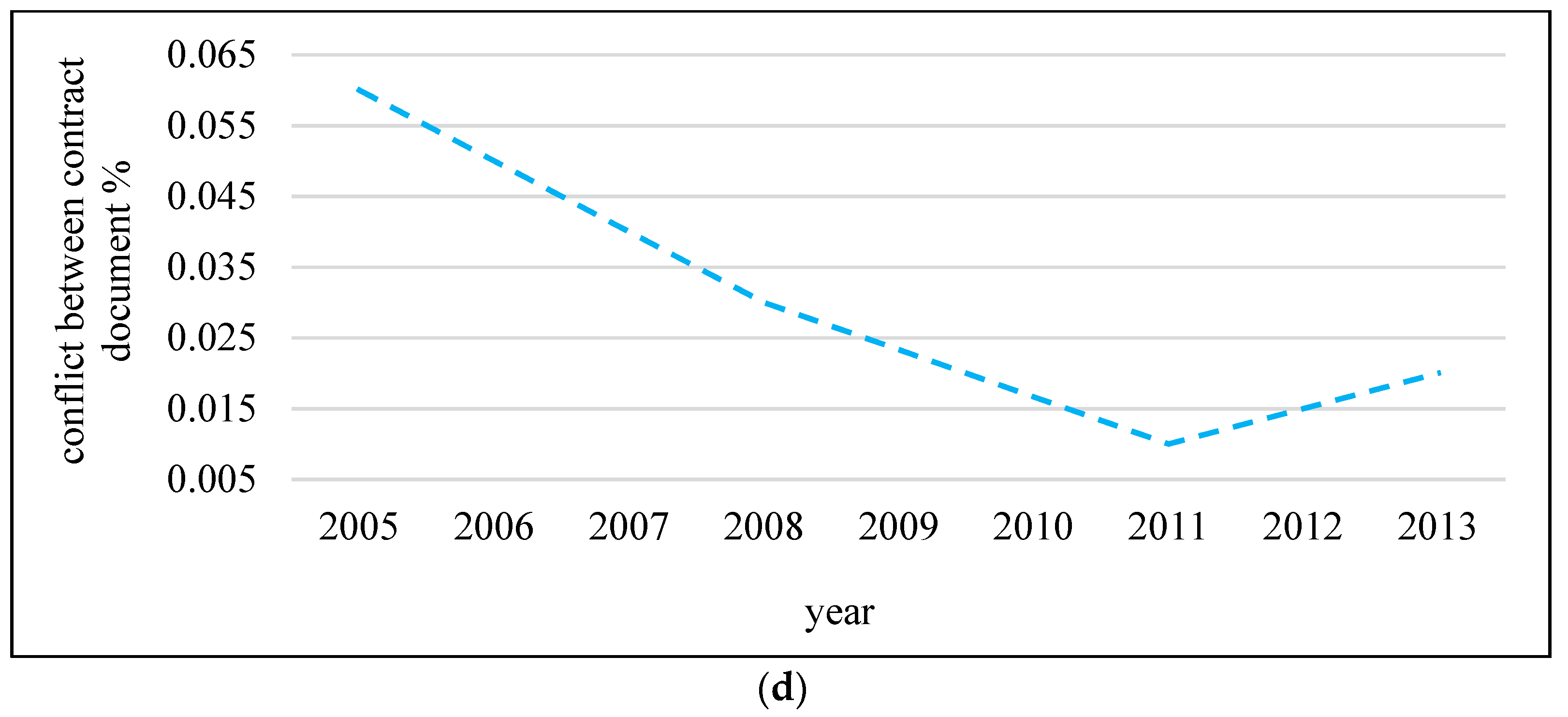

Legislative Period | Owner Adequacy% | Contractor Adequacy % | Design Defects% | Conflict between Contract Document% |
---|---|---|---|---|
1 | 44–55 | 44–55 | 6–9 | 6–7.5 |
2 | 56–66 | 44–55 | 3–6 | 2.6–5 |
3 | 66–77 | 56–66 | 0–3 | 0–2.5 |
4 | 78–88 | 78–88 | 0–3 | 0–2.5 |

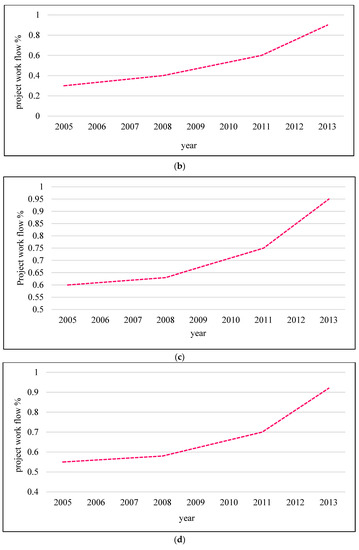

Legislative Period | Impact of Owner on the Plan Modification% | Impact of Owner on the Project Workflow% | Impact of Contractor on the Project Workflow % |
---|---|---|---|
1 | 0–6 | 55–66 | 55–66 |
2 | 0–6 | 55–66 | 55–66 |
3 | 24–30 | 66–77 | 66–77 |
4 | 12–18 | 88–100 | 88–100 |
Legislative Period | Inflation % | Terrorism % | Budget Shortage % |
---|---|---|---|
1 | 22–33 | 11–22 | 22–33 |
2 | 33–44 | 22–33 | 33–44 |
3 | 55–66 | 44–55 | 66–77 |

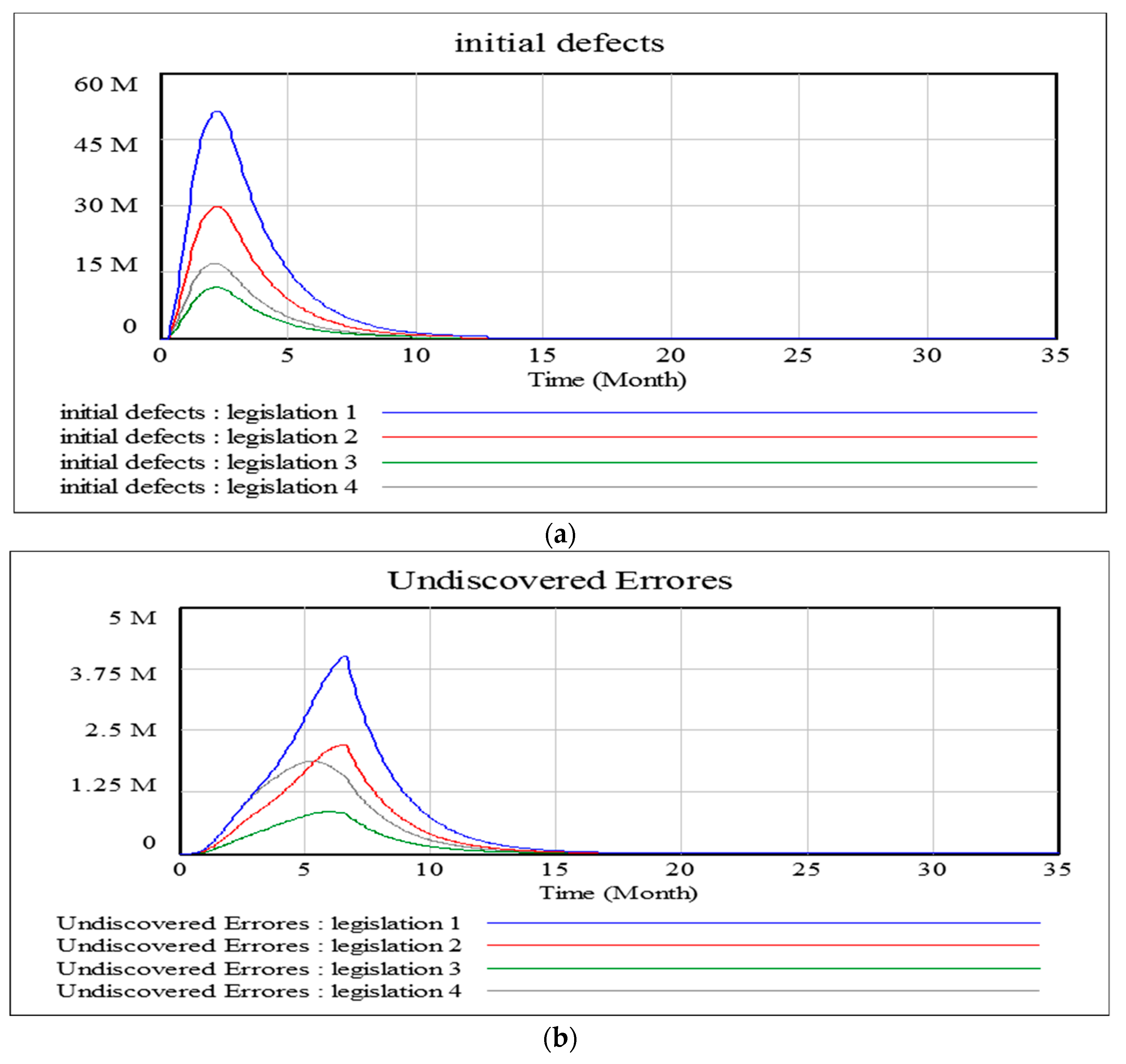

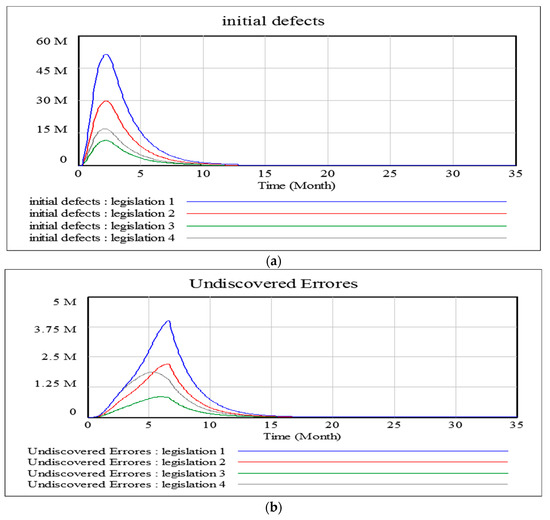

4 | 88–100 | 77–88 | 88–100 |

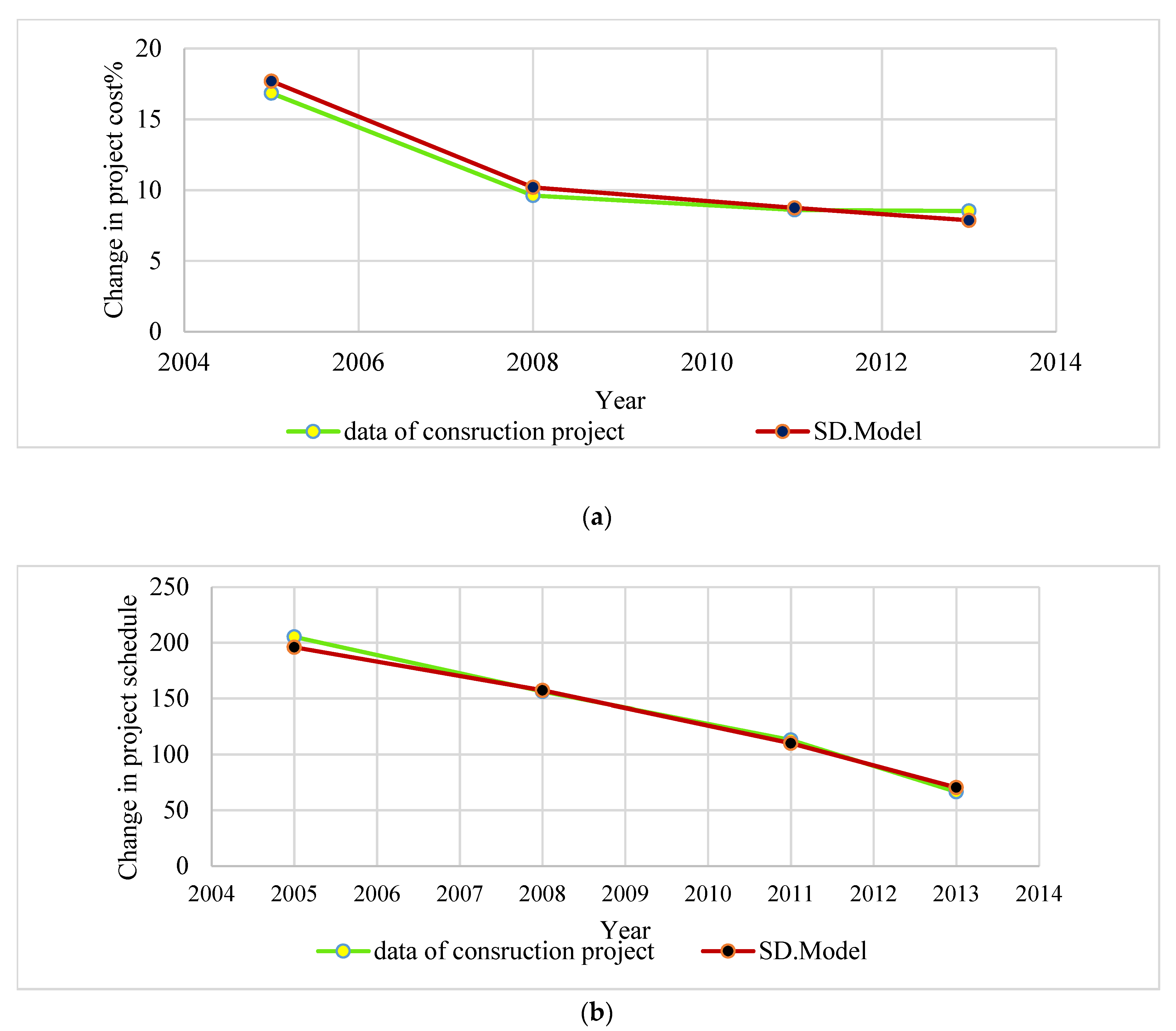

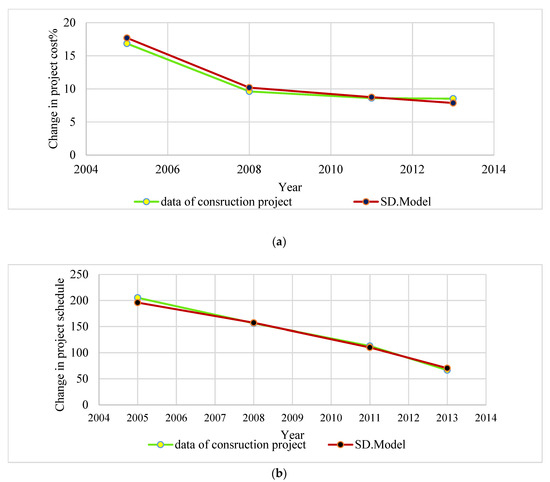

Legislation | Period | Actual Cost Change % | Simulated Cost Change % | Difference |
---|---|---|---|---|
1 | 2003–2006 | 16.85 | 17.7 | 0.85% |
2 | 2007–2008 | 9.62 | 10.2 | 0.58% |
3 | 2009–2011 | 8.61 | 8.75 | 0.14% |
4 | 2012–2014 | 8.53 | 7.87 | 0.66% |
Average | 0.55% |
Legislation | Period | Actual Schedule Change % | Simulated Schedule Change % | Difference |
---|---|---|---|---|
1 | 2003–2006 | 205.37 | 196 | 9.37% |
2 | 2007–2008 | 156.36 | 157.36 | 1% |
3 | 2009–2011 | 113.1 | 110.22 | 2.9% |
4 | 2012–2014 | 66.67 | 70.45 | 3.78% |
Average | 4.24% |
