Residential Rooftop Photovoltaic Adoption Using a Sequential Mixed Methods Approach in Qatar
Next Article in Special Issue
Investigating the Causal Relationships among Enablers of the Construction 5.0 Paradigm: Integration of Operator 5.0 and Society 5.0 with Human-Centricity, Sustainability, and Resilience
Previous Article in Journal
Recovery of Metals from Printed Circuit Boards by Gold-REC 1 Hydrometallurgical Process
Previous Article in Special Issue
Synergies of Lean, BIM, and Extended Reality (LBX) for Project Delivery Management

Font Type:
Arial Georgia Verdana
Font Size:
Aa Aa Aa
Line Spacing:
Column Width:
Background:
Article

Assessment of Building Information Modeling (BIM) as a Time and Cost-Saving Construction Management Tool: Evidence from Two-Story Villas in Jeddah

Department of Civil Engineering, College of Engineering, Taif University, P.O. Box 11099, Taif City 21974, Saudi Arabia
Sustainability 2023, 15(9), 7354; https://doi.org/10.3390/su15097354
Submission received: 2 March 2023 / Revised: 27 March 2023 / Accepted: 28 March 2023 / Published: 28 April 2023

Abstract

:
Building Information Modelling (BIM) is a well-known construction technology for improving management. Its implementation in Saudi Arabia’s construction industry is increasing as it adapts to futuristic construction management practices. This quantitative case study examines the factors that led to the success of employing the BIM tool in managing a recent home development project in Jeddah, Saudi Arabia. After a survey of the available literature, 28 success criteria were identified and validated by an expert panel of 18 industry professionals. Exploratory Factor Analysis (EFA) is used to analyze data from a pilot survey of 132 people. A total of three factors are deleted because of factors leading to a value of less than 0.6. Further, there were 212 people who filled out the main survey questionnaire, and the data are analyzed using structural equation modeling (SEM). The findings show that BIM significantly improved the house development project in terms of cost, time, quality, safety, efficiency and environmental effect. Implications for management are highlighted, along with the study’s limitations and suggestions for further investigation. Overall, this research offers helpful information for residential building experts who want to make the most of BIM.

1. Introduction

The construction business is complicated and dynamic, with many variables influencing project timetables, quality, safety and prices. Building Information Modeling (BIM) may help manage building projects more efficiently and effectively [1,2]. BIM is used to manage two-story villas in Jeddah, saving time and money, among other benefits. BIM can solve these issues. BIM lets construction project managers simulate, visualize and evaluate their projects virtually. This platform integrates construction data seamlessly, improving stakeholder engagement and decreasing construction time and costs. BIM is beneficial in the early phases of building project design. Project managers may utilize BIM to construct comprehensive architectural models to spot concerns early on. Early detection helps save expensive redesigns and construction delays. BIM also lets project managers simulate and test design decisions to see how they could affect timelines and budgets [3,4].
BIM helped design the two-story residences in Jeddah by integrating construction data. BIM was used to assess design viability and identify concerns [5]. BIM helped project managers avoid expensive redesigns and delays by testing multiple design possibilities before construction. BIM also tracked the project’s progress and identified opportunities for improvement, saving time and money [6]. BIM enhanced stakeholder engagement and communication. BIM enabled real-time cooperation among stakeholders to accomplish goals. BIM helped designers, architects, builders and other stakeholders collaborate on the two-story homes in Jeddah. Collaboration improved project quality and reduced miscommunications [7,8]. BIM also improved project management by centralizing construction data. Project managers could track progress and make modifications by constructing a digital model of the construction project. This sped up construction and cut expenses. BIM in building projects needs fixing [6,9]. BIM requires particular abilities. BIM requires extensive training for project managers. BIM integration with project management systems might require significant technology and software investments [10,11].
This case study shows how BIM saves time and money while building two-story residences in Jeddah. Two-story residential buildings are very common in the residential communities of all Saudi Arabia [12]. It is the reason that this study only involves two-story buildings, to effectively focus on the application of BIM. This case study uses structural equation modeling (SEM) to explore variable correlations and evaluate BIM implementation. SPSS and Smart PLS 4, popular data analysis tools, are utilized for SEM. SEM research shows that BIM improved the project results, construction time and cost. The results also demonstrate that stakeholder participation and communication were crucial to BIM deployment [13]. The report also emphasizes the necessity for stakeholder participation and project managers with BIM capabilities. SEM is a robust data analysis technique, but it has limits. SEM needs a significant sample size for accurate findings. Some businesses may need more experience and understanding to implement SEM. SEM may help evaluate BIM deployment in building project management despite these limitations. SEM helps construction professionals assess project success elements and improve. Therefore, this case study aims to show how BIM improves project management, construction timetables, quality, safety, the environment, costs and project results. It examines the merits of implementing BIM in building two-story homes in Jeddah. This case study can help construction professionals understand how BIM improves project results. Budget overruns, delays and quality control concerns affect the construction business. This case study shows how BIM saves time and money while building two-story residences in Jeddah. The report also emphasizes stakeholder participation and project managers’ BIM proficiency. SEM is used to evaluate BIM deployment and find areas for improvement. Construction professionals may choose the finest tools and tactics for project management by studying the pros and downsides of BIM and SEM.

2. Current Status of BIM in Jeddah

The construction sector has extensively embraced Building Information Modeling (BIM) because it can improve project management and communication, decrease mistakes and rework, and improve project results [14]. BIM is a digital representation of a building or facility’s physical and functional qualities that may be utilized for design, construction and operational reasons. BIM has been proven to result in considerable time and cost savings for construction projects, as well as improved overall quality and safety. BIM’s capacity to enhance cooperation and communication among project stakeholders, including architects, engineers, contractors and owners, is one of its primary advantages [15,16]. Using a shared digital model, stakeholders may collaborate in real time and make choices based on accurate and current data. This decreases the possibility of mistakes, disputes and the requirement for rework, saving time and money [17,18]. Several studies have examined the advantages of BIM for building projects. In a case study, Lin et al. (2016) showed that the use of BIM on a healthcare project reduced the length of the design phase by 40 percent and the construction expenses by 20 percent [19].
Similarly, D. Liu et al. (2019) showed that the use of BIM on a commercial office building project reduced the number of Requests for Information (RFIs) by 50 percent and modification orders by 60 percent [20]. BIM has been shown to enhance project results in the setting of home buildings. Ahmad and Thaheem (2018) conducted a case study on using BIM to design and construct a single-family home in China [21]. The research concluded that BIM improved project coordination, decreased mistakes and rework, and increased project quality and safety. Another case study by Alothman et al. (2021) evaluated the application of BIM in South Korean affordable housing development and maintenance [22]. According to the report, BIM helped minimize construction waste and expenses and increase the project’s efficiency and sustainability. Some more critical relevant studies are shown below in Table 1.
In the context of Jeddah, Saudi Arabia, a study on the advantages of BIM for residential development is required. Although BIM has been extensively accepted in other areas of the globe, it is still in its infancy in Saudi Arabia. Thus, the purpose of this case study is to evaluate the use of BIM for the design and construction of two-story villas in Jeddah, with a particular emphasis on its influence on time and cost reductions. The data are analyzed using structural equation modeling using SPSS and Smart PLS 4 to make findings. In doing so, this study intends to add to the expanding body of literature on the advantages of BIM for building projects and to shed light on its potential for the Saudi Arabian construction sector. Table 2 presents the success factors reviewed from the literature and evaluated by experts.

3. Methodology

This study’s objective was to learn what makes Building Information Modeling (BIM) effective as a resource for construction management, reducing both the time and money spent on projects. The study used a quantitative methodology to get the job done. There were four primary phases to the process, and they are the following: literature research, expert consultation, a pilot survey and a preliminary questionnaire survey [15,16]. As a construction management tool, BIM was evaluated via a literature study to determine its characteristics of success. At this point, this study involved intensive search of relevant academic publications, books and other resources. The databases that were used in the research were ScienceDirect (9 Articles), MDPI (13 Articles), Springer (16 Articles) and Web of Science (7 Articles). The keywords that were used for searching the databases were Building Information Modelling, Construction Management Tool, Two-Story Villas and Jeddah. Only English language articles with significant relativity to the keywords and goals of the study were included in the analysis. In total, 46 open-access credible research articles were reviewed. What was learned from the literature study shaped the research tools for later phases. The second phase entailed consulting with 18 specialists about BIM and the regional construction sector to validate the confirmed success factors. A structured interview was used for the consultation, and the results were used to improve the research tools [17,20].
During the third phase, 132 two-story Jeddah villas residents were surveyed as part of a pilot project. The validity and trustworthiness of the research tools were evaluated with the aid of the pilot survey. To determine what makes BIM effective as a management tool in construction, this study examined the pilot survey results of 28 factors using Exploratory Factor Analysis (EFA). In the last phase, 212 residents of Jeddah’s two-story villas completed the primary questionnaire survey. The results of the literature study, the contact with experts and the preliminary survey informed the development of the questionnaire.
A model of BIM’s success criteria for Jeddah’s two-story villas was developed using SEM. Participants’ informed permission was acquired to cover any potential ethical issues. The information provided by the participants was kept strictly secret, and participants were ensured of their privacy. This study used a quantitative research approach to determine what makes BIM effective as a resource-conserving construction management tool. This study conducted a literature study, interacted with subject matter experts, conducted a pilot survey and then administered the main questionnaire. EFA and SEM were used to examine the dependability and validity of the study tools. The anonymity and privacy of the study’s participants were respected at all times by adhering to strict ethical guidelines. Figure 1 presents the research methodology.

3.1. Exploratory Factor Analysis

In statistics, EFA refers to a method used to uncover the underlying structure of data collection. Its purpose is to simplify the analysis by eliminating non-essential components and narrowing the focus on those that best explain the data. EFA was applied to the data from the pilot survey of 113 residents of Jeddah’s two-story villas. The research team behind this study set out to determine what makes BIM such an effective tool for construction management, saving both time and money [19]. Factors were kept if their eigenvalues were more significant than 1, and the scree plot analysis passed muster. The factor structure was simplified, and the factors’ meanings were clarified using a varimax rotational component matrix. Simplifying the factor structure, varimax rotation is an orthogonal rotation that reduces the number of variables with high loadings on each component. The loadings of each variable on each factor after rotation are shown in the varimax rotated component matrix [20]. The most excellent loadings of the variables were used to interpret the factors. The factors were labeled after the variables that contributed the most to their loadings. Using the EFA findings in designing the primary survey questions and the structural equation modeling yielded valuable results.

3.2. Development of SEM Model

Complex interactions between many variables may be analyzed utilizing SEM, a statistical method. Researchers may evaluate the stability and direction of links between observable and latent variables in complicated models. An SEM-based model of the variables contributing to the implementation of BIM in Jeddah’s two-story villas was created for this research. A model was created based on responses to the primary survey questions from 202 individuals [21]. The SEM analysis demonstrated that the model matched the data well. It was determined that BIM’s effectiveness as a time- and cost-saving construction management tool in Jeddah’s two-story villas was significantly influenced by the success criteria discovered in the EFA. The SEM study also made it possible to examine how the success criteria, directly and indirectly, influenced BIM implementation [22,33]. As a result, the most crucial aspects for the practical application of BIM to the building of two-story villas in Jeddah could be isolated and studied in more depth. Overall, SEM created a thorough and precise model of BIM’s success elements throughout the building of Jeddah’s two-story villas.
The reliability and validity of the measuring equipment used in structural equation modeling may be evaluated using convergent validity (SEM). It is the extent to which different indicators of a construct measure the same underlying notion [37]. The Fornell–Larcker criterion was used to determine convergent validity in this research. This requires checking the levels of correlation between the latent variables and their indicators to see whether they are significant [50,53]. To pass the Fornell–Larcker criterion, the correlation between any two model components must be less than the square root of the average variance extracted (AVE) for that component. The degree of variation in the indicators that can be attributed to the concept is what AVE measures in terms of convergent validity. To what extent one idea is different from the others in the model is what is meant by the term “discriminant validity.” There should be no overlap in the concepts being measured by the various constructions [48]. Each construct’s AVE must be higher than the squared correlations between that construct and any other construct in the model to satisfy the Fornell–Larcker criterion for discriminant validity.
A statistical technique called the Heterotrait–Monotrait Ratio of Correlations (HTMT) is used in structural equation modeling to assess the model’s discriminant validity and convergent validity (SEM). A value of 1 implies complete correlation, whereas a value of 0 indicates no correlation, making it a measure of the degree to which two conceptions are comparable. According to the HTMT criteria, the correlation between two constructs in a model should be lower than the square root of the average variance extracted (AVE) for that construct [44,47]. If the number is less than 0.85, discriminant validity may be an issue; if it is more than 0.9, it is an issue. Convergent validity may also be assessed using an empirical correlation matrix and HTMT statistics. The matrix displays correlation coefficients for all possible combinations of constructs; a strong correlation suggests that the two constructs may be measuring the same underlying notion [40,45]. For testing for convergent validity, it is customary to compare the square roots of the AVEs for each construct to the diagonal values of the matrix. Higher diagonal values suggest that the construct measures more than one underlying notion, which calls into doubt its convergent validity.
It is common research practice to utilize a statistical technique called structure path analysis to probe the connections between different latent variables. Using this method, one may calculate the estimated impacts of external (independent) factors on endogenous (dependent) variables directly and indirectly. In this analysis, SPA was used to create a template for the elements that contribute to the success of Building Information Modeling for two-story villas in Jeddah. Several experiments were conducted to guarantee the SPA model’s accuracy. The level of multicollinearity among the model’s independent variables may be evaluated using the Variance Inflation Factor (VIF), one of the tests. Multicollinearity, which may cause erroneous coefficient estimations when present when the VIF value is larger than 5, is indicated by a VIF value greater than 5 [39,42]. The predicted relevance analysis is another test used to verify the SPA model. By comparing the model’s out-of-sample predictive power to that of a benchmark model, this technique helps to evaluate the model’s overall predictive ability.

4. Results

4.1. EFA Analysis

According to the findings of the EFA, the 28 success elements of BIM may be narrowed down to only six different types of constructs, as indicated in Table 3. EFA’s six recognized constructs are time, money, quality, safety, efficiency and the environment. A thorough examination of the eigenvalues and factor loadings allowed for the isolation of these concepts. Furthermore, the EFA revealed that the six constructs mentioned above jointly account for 66.23 percent of the total variance in the data. This shows that the six constructs are all-encompassing and may capture a substantial part of the elements that determine the efficacy of BIM in building projects [41]. According to the EFA, BIM has the potential to be a helpful construction management technology that cuts down on costs without sacrificing quality, safety, efficiency or environmental sustainability.
The construct of time has four success factors assigned to it, namely S3, S9, S26 and S20. These aspects relate to how BIM can aid project teams in precisely organizing construction operations, reducing the time needed to complete a building project, working in a coordinated and collaborative manner and providing accurate project information before construction to guarantee that prefabricated components are built to specs and delivered on time [20,22].
The construct of cost has five success factors assigned to it, namely S8, S10, S5, S17 and S18. These considerations are associated with how BIM can aid project teams in estimating building costs, saving construction costs by detecting and fixing flaws before building starts, determining what resources are required, finding ways to increase the project’s value through value engineering and meeting project specifications while keeping costs down [30,31].
The construct of quality has four success factors assigned to it, namely S7, S2, S23 and S1. These aspects concern how BIM can help designers create a 3D virtual model of the project to find and fix design flaws before construction, how it can bring all of the project’s stakeholders together to work towards the same goals, how it can provide accurate project information to fulfill obligations and improve project excellence and how it can aid project teams in managing the project more effectively, all of which contribute to the overall quality of the project [55].
The safety construct has five success factors assigned to it, namely S19, S14, S16, S15 and S28. These considerations concern how the virtual 3D model created by BIM can aid project teams in spotting potential dangers before construction begins, in enhancing safety planning through the delivery of accurate and complete project information, in developing virtual training programs for construction personnel to understand project safety measures better, in avoiding construction conflicts and in relieving site congestion through the delivery of accurate project information [44,48].
The efficiency construct had three success factors assigned to it, namely S24, S13 and S21. These considerations are associated with how BIM can bring together project stakeholders to work toward the same ideas and reduce misunderstandings; to improve construction project sequencing, which enhances productivity; and to improve construction project data, which improves efficiency [45].
The environment construct had three success factors assigned to it, namely S4, S12 and S25. Some ways in which BIM may assist in reducing a project’s carbon footprint include providing accurate data on energy performance, optimizing material consumption and ensuring that all available resources are used effectively. Table 4 summarizes the constructs and their associated success factors.

4.2. Demographics

The demographics (Figure 2) for the primary questionnaire survey show that the majority of respondents hold a master’s degree (55%), followed by those with a Ph.D. (12%). Only a tiny percentage of respondents had a high school education (6%), 18% had a bachelor’s degree, and 9% were classified as “Others.” In terms of age, the largest group of respondents fell within the 31 to 35 age range (51%), followed by those within the 26 to 30 age range (20%). A small percentage of respondents were above 40 years old (3%). Regarding experience, the largest group of respondents had 11 to 15 years of experience (31%), followed by those with 5–10 years of experience (31%). A smaller percentage of respondents had less than 5 years of experience (22%), 11% had 16 to 20 years of experience, and 5% had more than 20 years of experience. Regarding profession, most respondents were civil engineers (61%), followed by safety managers (11%). Only a tiny percentage of respondents identified as architects (6%), project managers (3%) or “Others” (19%).

4.3. Structure Equation Modelling (SEM) and Analysis

The model reliability and validity results for the constructs are shown in Table 5. Validity refers to the extent to which the measurements are accurate and suitable for measuring the targeted construct, whereas reliability refers to the extent to which the measures are consistent and stable. Cronbach’s alpha, composite reliability (rho-a), composite reliability (rho-c) and AVE are all included in the table. As a measure of internal consistency, Cronbach’s alpha determines how well each item on a scale measures the same construct. A Cronbach’s alpha of 0.7 or above is generally accepted as statistically significant. Cronbach’s alpha scores for all constructs in this research were more than 0.775, suggesting high levels of internal consistency. A measure of the construct’s dependability, composite reliability (rho-a and rho-c) determines how free of error the measurements are. Values closer to 1 for rho-a and rho-c indicate more consistency between observations. This analysis showed strong reliability with composite reliability scores >0.793 for all constructs [49]. To what degree the elements in a construct measure the same underlying dimension is what convergent validity attempts to determine. AVE values may be anything from 0 to 1, with higher values suggesting more convergent validity. This research had strong convergent validity, with all components having AVEs of greater than 0.613. The results of the reliability and validity analyses support the conclusion that the measures that were employed to evaluate the components in this research have high levels of consistency, reliability and validity. This ensures that the study’s findings and conclusions may be trusted [38]. The trend of the reliability and validity statistics of the model are indicated in Figure 3. Figure 4 presents the model with relationship significance for all items and constructs. Figure 5 shows the items and constructs’ path coefficients and factor loadings.
Each cell in Table 6 of the empirical correlation matrix displays a pairwise correlation coefficient. A correlation coefficient statistic may quantify the strength and direction of a linear link between two variables. The correlation coefficient may take on any value between −1 and 1, where −1 indicates absolutely zero connection, 0 indicates no correlation and 1 indicates a perfect positive correlation [47,48]. For instance, the 0.104 coefficient between S1 and S10 in the correlation matrix indicates a moderately weak positive connection. Similarly, there is a minor negative connection between S1 and S12 (r = −0.153).

4.3.1. Second-Order Analysis

Results for the Fornell–Larcker criterion’s six dimensions (time, quality, safety, cost, environment and efficiency) are shown in Table 7. According to the Fornell–Larcker criterion, how well each construct’s indicators reflect the construct’s variation can be stated. The AVE is compared to the square of the correlation between each concept and its indicators. Calculating the amount of a construct’s variation that can be attributed to its indicators yields the AVE. Table 6 shows that the diagonal values (representing the AVE for each construct) are superior to the off-diagonal ones (i.e., the correlations between constructs). This means that the indicators for each concept explain more variation for that construct than they do for the others, a sign of strong convergent validity [39,40].
Most importantly, the constructions seem relatively well-defined and separate because the diagonal values span from 0.105 (Safety) to 0.398 (Time). The strongest association between the dimensions was found between time and quality (0.43), followed by efficiency and time (0.274). These correlations are concerning but not too high to raise concerns about discriminant validity [45,51]. Overall, Table 6’s Fornell–Larcker criterion findings imply that the measurement model for these constructs has strong convergent and discriminant validity, giving confidence in the fact of the constructs and their indicators.
The HTMT analysis is shown in Table 8; it is a typical method for evaluating discriminant validity in SEM. The diagonal components in this table represent the construct’s connection with itself, which are all set to 1. The off-diagonal features suggest that the notions have some discriminant validity. In particular, there is little overlap between the constructs, as seen by the fact that all HTMT values are below the suggested threshold of 0.9. Regardless, there are a few pairs of constructs with relatively high HTMT values. For instance, the HTMT value between efficiency and cost is 0.154, which is close to the cutoff point of 0.9. This provides evidence of a connection or overlap between these concepts. The negative HTMT score (−0.023) between quality and environment is also surprising and may point to problems with the model’s measurement or overall design [37,47]. There may be some difficulties with some construct combinations that need additional investigation, but overall, the HTMT findings show that the measurement model for the constructs in the research is usually valid.
Each item’s connection to the related construct is shown in the cross-loadings in Table 9. In this scenario, time, money, quality, security and the environment are concerned. The high quality of the cross-loadings suggests that the items successfully assess the targeted constructs. Most items have high loadings (0.753 and 0.935) for their target build. A few items, however, have very low loadings for their target build, indicating that they may not be the greatest indicators of that construct [40,43]. To illustrate, item S8’s loading for the cost construct is lower than its loading for the efficiency construct, at 0.837. (0.117). Items S21 and S22 have high loadings for the efficiency build and low loadings for the environment construct (0.774). Very high cross-loadings may also point to issues with the measurement model, because this indicates that a single item may be measuring many constructs. The measurement model seems sufficient, with no obviously excessive cross-loadings.
The variables that were removed from the study are listed in Table 10. Due to factors such as low factor loadings or strong cross-loadings, these variables were not included in the final model. According to the data in the table, variables S6, S11 and S22 were removed from consideration during the EFA pilot phase, and variables S14, S17, S27 and S28 were removed from consideration during the SEM major analysis phase. The choice to exclude these variables was made only on the basis of statistical criteria, not on any theoretical or philosophical considerations. Their omission from the final model suggests that they made little to no contribution to the elucidation of the hidden constructs [41,42]. Thus, the final measurement model is composed of a reduced set of the original variables that were judged to be superior in their ability to assess the target constructs.
The factors’ group impact rank, VIF and outer weights are all shown in Table 11. The outer weights represent how strongly one concept is related to another. An increase in the VIF score suggests increased multicollinearity. Finally, the group impact rank illustrates the weight of each component of the model. Time (composed of S26, S20, S3 and S9) has the greatest influence on the model as a whole, followed by cost (S5, S8, S10 and 18), quality (S1, S2, S23 and 7), efficiency (S13, S21 and 24), safety (S15, S16 and 19) and environment (S15, S16 and 19). It is important to keep in mind that the greatest outer weights do not always correspond to the highest group impact rank. For instance, despite S23’s larger outer weight compared to those of S7 and S15, it ranks lower for group impact because it belongs to the auality construct, which has less overall influence compared to that of the time, cost and safety constructs. Table 10 shows that all aspects of manufacturing need consideration when assessing its worth. However, time itself seems to be the most significant factor regarding outcomes.

4.3.2. Path Analysis

Formative construct route analyses are shown in Table 12. Each path’s coefficient (β), standard error (SE), t-value (t), p-value (p) and variance inflation factor (VIF) are listed in the table below. According to the findings, BIM implementation in the New Jeddah Housing Development project benefited from the attention paid to the six formative constructs (cost, efficiency, environment, quality, safety and time). The route coefficients represent the strength of the connections between the formative structures and the overall effectiveness of BIM implementation. To what extent the cost of implementing BIM affects its overall performance is shown by its path coefficient of 0.324. Similarly, positive path coefficients of 0.257, 0.173, 0.281 and 0.250 for the efficiency, environment, quality and safety constructs, respectively, show that they are also significant variables in BIM success. Time has the greatest influence on the BIM success of any of the formative components, as seen by its path coefficient of 0.411. This might be because timely construction project completion is vital for customer satisfaction, budget management and income production [31,34]. There is no major multicollinearity problem among the predictors because the VIF values for all the formative components are less than 5 [29,56]. Overall, the findings of the path analysis are helpful for project managers and decision makers in the construction sector because they provide light on the elements that impact the effectiveness of BIM within the context of the New Jeddah Housing Development project. Figure 6 presents the model with the results of the bootstrapping analysis. The significance of each construct and item is indicated in the model, which confirms the relationship of all constructs with latent variables.
Results of the model’s predictive relevance analysis are presented in Table 13, which includes the Q2 value for the endogenous latent variable “Assessing BIM success in New Jeddah Housing Construction (Two-Story Villas).” The amount of variation in the endogenous construct that can be anticipated by the exogenous variables in the model is quantified by Q2, a measure of the model’s predictive accuracy. The Q2 value of 0.131 in this table indicates a reasonable level of prediction accuracy for applying the model to evaluate the performance of BIM in the New Jeddah Housing Development. This means that the endogenous construct is only partially explained by the exogenous variables included in the model (by roughly 13.1%) [27,55]. Although this is not a very high threshold, it does provide some insight into the model’s ability to correctly forecast the endogenous construct. Quantiles of Q2 greater than 0 suggest that the model has some prognostic value. However, improved prediction accuracy is associated with a more considerable Q2 value [29,54]. The model has some predictive capacity for evaluating BIM performance in the new Jeddah housing construction, even if the Q2 value of 0.131 is not exceptionally high [52,54]. While attempting to make sense of these findings, it is also crucial to think about their potential application and the degree to which they match the model as a whole.

5. Discussion

The time formative construct includes S3, “By providing a virtual 3D model of the project, BIM may assist project teams in more precisely organizing construction operations”; S9, “BIM may minimize the amount of time required to finish a building project by giving precise and thorough information about the project. This may assist in eliminating construction mistakes, rework and delays, resulting in speedier project completion timeframes”; S26, “BIM allows parties to operate in a coordinated and collaborative way, streamlining communication and reducing misunderstandings. This may contribute to the timely and cost-effective completion of building projects”; and S20, “BIM provides accurate project information before construction to ensure that prefabricated components are built to specs and delivered on schedule to the building site.” Many aspects that might affect BIM’s performance in the new Jeddah housing construction are included in the time-formative build. Improved collaboration and resource management may shorten the time it takes to finish a project [39,43]. Building errors, rework and delays may be avoided with its help, which would shorten the project’s duration. It may help in finishing construction jobs quickly and cheaply. Successful project completion on schedule and within budget may be the result. BIM may aid in expediting the building process and staying on budget by enhancing collaboration, communication and resource management.
The cost formative construct includes S8, “BIM helps project teams estimate building costs by providing precise and thorough project information. This reduces cost overruns and delays”; S10, “BIM may save construction costs by detecting and fixing flaws before building starts. This reduces construction mistakes, rework and delays”; S5, “BIM helps project teams identify project resource needs. This improves resource management and reduces waste”; and S18, “BIM may assist achieve project specs while reducing expenses”. Using BIM may result in cost reductions and effective resource management, as shown by the influence of the cost formative build on BIM success in the new Jeddah housing construction (two-story villas). The route analysis findings show that a 1-unit increase in the cost construct is associated with a 0.324-unit increase in BIM success. This indicates that the New Jeddah Housing Development may benefit significantly from BIM’s capacity to assist project teams with cost estimation, defect detection and correction prior to construction, resource identification and attaining project specifications at lower prices [23,57].
The quality formative construct includes S7, “BIM lets designers develop a virtual 3D model of the project to discover and fix design faults before construction. This may enhance the design and decrease construction mistakes and rework”; S2, “BIM helps project stakeholders work together toward the same objectives. Ensuring that stakeholders agree on project requirements and specifications may increase project value”; S23, “BIM delivers accurate project information to meet obligations and improves project excellence”; and S1, “BIM may assist project teams in managing the project better, improving project quality.” Four potential aspects that might affect the effectiveness of BIM in the new Jeddah housing construction are included in the quality formative build. This might benefit the endeavor as a whole. Second, if the project successfully satisfies all the stakeholders’ requirements, the value of the project might rise. Project teams may have better judgment and prevent mistakes that lower quality if they can access accurate and thorough information about the project [26,58]. By giving teams access to real-time data, BIM improves project results by helping teams see and fix problems before they escalate. The quality formative construct concludes that BIM contributes positively to the quality of the New Jeddah Housing Development by facilitating improved design, stakeholder cooperation, information management and project management.
The safety formative construct includes S19, “BIM’s virtual 3D model may assist project teams in discovering dangers before building starts. This reduces the number of construction accidents and injuries”; S16, “BIM may be used to create virtual training programs for construction personnel to understand project safety measures better”; and S15, “BIM’s 3D model may prevent construction conflicts”. The success of BIM implementation in the New Jeddah Housing Development project largely depended on the safety formative construct, consisting of S15, S16 and S19. Better safety policies and procedures may be implemented as a result of the use of BIM on the project, making the workplace safer for everyone involved. By educating employees on proper safety procedures, these programs may help cut down on workplace mishaps and injuries. Unsafe situations in the workplace may be avoided if the team takes the time to anticipate and resolve possible disputes before they arise [32,59]. In conclusion, the safety construct and its associated aspects may significantly contribute to the overall success of BIM implementation in the New Jeddah Housing Development project by improving safety standards, lowering the number of accidents and injuries and preventing disputes.
The efficiency formative construct includes S24, “BIM helps project stakeholders work together toward the same ideas, reduces misconceptions and aligns everyone on project needs and specs, improving productivity”; S13, “BIM enhances construction project sequencing, resulting in productivity improvement”; and S21, “BIM improves construction project data, resulting in efficiency improvements.” The efficiency formative construct analyzes how several elements influence the project team’s output and performance. BIM may improve productivity on the New Jeddah Housing Development project. BIM may help groups organize construction activities and determine the necessary sequence of tasks more precisely because it provides a 3D representation of the project. More effective and timely completion of the project may result from this. Increased efficiency and production may be the outcome [15,16]. When this occurs, resources may be used more effectively and efficiently, leading to more production with fewer expenditures. BIM implementation in the New Jeddah Housing Development project may benefit from the efficiency construct and its elements, leading to greater efficiency, productivity and cost-effectiveness.
The environment formative construct includes S4, “BIM can increase energy efficiency by giving precise energy performance data. This may uncover energy savings and improve building systems to minimize energy consumption and greenhouse gas emissions”; S12, “BIM provides precise project information to optimize material utilization”; and S25, “BIM’s precise energy usage and greenhouse gas emission data help lower the project’s carbon impact.” This not only follows the current fashion for eco-friendly construction methods, but it also has the potential to save money in the long term by cutting down on energy use and carbon tax obligations. The project’s effect on the environment and natural resources may be lessened by cutting down on waste and increasing the efficiency with which materials are used [18]. As a whole, the environment construct stresses the significance of taking environmental considerations into account during construction, and BIM can play a pivotal role in facilitating this by providing reliable information for use in making informed decisions and improving the efficiency of the built environment.

5.1. Empirical and Theoretical Contributions

The results show that BIM has the ability to improve several facets of building projects, such as timeline, budget, quality, safety, efficiency and environmental impact. In addition, the findings give concrete case studies of how BIM may be utilized in building a new Jeddah housing complex (two-story villas), demonstrating the methodology’s relevance in the actual world. The findings add to our knowledge of BIM’s function in building projects, especially its ability to boost project outcomes in many ways. The results illustrate the potential advantages of BIM as a digital technology in enhancing project performance, and they add to the more considerable theoretical debate on technology acceptance and implementation in the construction sector. The findings provide light on how Building Information Modeling (BIM) was used in the New Jeddah Housing Development (Two-Story Villas), illustrating the significance of contextual elements in determining the utility of BIM in any given project scenario.

5.2. Managerial Suggestions

BIM may increase efficiency and effectiveness by facilitating better interaction and coordination among all parties involved in a project. Stakeholders in a project may reap the software’s full advantages if they have received proper training on how to use it. BIM may aid in detecting design flaws and disputes, resulting in a more streamlined and successful design process. Prioritizing BIM deployment during the design phase may help teams avoid making expensive adjustments or redoing work during the building phase. Building Information Modeling (BIM) helps reduce a project’s carbon footprint by providing accurate information on energy efficiency, optimizing the use of materials, and more. Costs may be cut, and sustainable development practices can be more closely aligned using BIM to improve energy efficiency and environmental sustainability. Building Information Modeling (BIM) may be used to design virtual training programs for construction staff to help them learn about and practice the project’s safety procedures and spot possible safety concerns before they start building. To guarantee a safer and healthier workplace, project teams may include BIM in safety training and processes. Project teams should regularly monitor and evaluate its implementation to ensure that BIM is being utilized to its maximum potential. Results from BIM implementation should be tracked so that teams may change their approaches based on things such as money saved, time saved and increased quality and safety.

5.3. Limitations and Future Implications

The use of EFA and structural equation modeling is one of the drawbacks of SEM. These statistical techniques are frequently used in the academic world, but they are not without their caveats and may only sometimes provide the same findings when applied to other data sets or circumstances. Moreover, the results may not be transferable to other projects or cases because this research only examines how BIM affected one construction project’s performance. The effect of BIM on the completion of particular building types, such as skyscrapers, hospitals or bridges, can be the subject of future study. Future research can also examine how project management techniques and stakeholder involvement affect the success of BIM-based building projects. Last, future studies can investigate how BIM affects project performance in other areas, taking into account cultural and regulatory issues that can affect BIM’s deployment and efficacy.
There is an increasing trend toward villas in the Saudi Arabian residential construction sector. Further, because of significant economic growth in recent years, Jeddah’s local government and urban authorities are focusing on improving the performance of construction in affordable residential villas. The outcomes of this study are specifically differentiating the success outcomes of BIM in villas. Previously, for two-story villas, studies have not focused on the perspective of BIM. It is known, however, that BIM application and its success outcomes are completely different for every structure. In two-story villas, there is a limited scope, cost and elements of the project where BIM functions can be easily implemented with minimal risk. This study uniquely indicates the success outcomes of BIM while relating to the limited structural constraints and requirements of two-story villas.

6. Conclusions

BIM has been shown to improve the efficiency and accuracy of building projects significantly, and this study sheds light on the many aspects that contribute to this improvement. This research found many formative dimensions that affect BIM performance, including quality, time, cost, safety, efficiency and the environment, via a comprehensive quantitative case study examination of newly constructed housing developments in Jeddah, Saudi Arabia. The practical ramifications of this study’s empirical results for construction project managers and stakeholders are substantial. Researchers found that BIM helped them locate and solve design flaws before construction began, boosted communication and cooperation among project participants and ensured that everyone had the knowledge they needed to fulfill their responsibilities. By simplifying communication, optimizing resource management and finding and repairing defects before construction begins, BIM may help cut down on project time and expenses. By facilitating the early identification of possible threats and the development of virtual training programs for construction staff, BIM may help cut down on construction accidents and injuries. BIM may boost efficiency through better project sequencing, enhanced construction project data and a unified consensus on project requirements and specifications. This research concludes that BIM has the potential to benefit the environment by reducing the project’s carbon footprint via increased energy efficiency, optimized material usage and reduced waste.
Nevertheless, this research has certain caveats, such as the case study analytic approach, which might make it hard to generalize the findings. This investigation of BIM success determinants in building projects uncovers important theoretical and practical implications for project managers and stakeholders. This research shows that BIM adoption is crucial for the construction industry’s quality, timeliness, cost-effectiveness and efficiency and for fostering sustainability. The results of this study may be used to educate best practices for using BIM on construction projects and to guide future research on the elements that contribute to the effectiveness of Building Information Modeling.

Funding

This study was funded by Taif University, Deanship of Scientific Research with Project Number−20223, Taif University, Taif, Saudi Arabia.

Informed Consent Statement

Informed consent was obtained from all subjects involved in the study.

Data Availability Statement

Not applicable.

Acknowledgments

The author would like to acknowledge the Deanship of Scientific Research, Taif University, for funding this work.

Conflicts of Interest

The author declares no conflict of interest.

References

  1. Alfieri, E.; Seghezzi, E.; Sauchelli, M.; Di Giuda, G.M.; Masera, G. A BIM-based approach for DfMA in building construction: Framework and first results on an Italian case study. Arch. Eng. Des. Manag. 2020, 16, 247–269. [Google Scholar] [CrossRef]
  2. Alrashed, I.; Kantamaneni, K. A 5D Building Information Model (BIM) for Potential Cost-Benefit Housing: A Case of Kingdom of Saudi Arabia (KSA). Infrastructures 2018, 3, 13. [Google Scholar] [CrossRef]
  3. D’Angelo, L.; Hajdukiewicz, M.; Seri, F.; Keane, M.M. A novel BIM-based process workflow for building retrofit. J. Build. Eng. 2022, 50, 104163. [Google Scholar] [CrossRef]
  4. Marzouk, M.; Abdelakder, E.M. A hybrid fuzzy-optimization method for modeling construction emissions. Decis. Sci. Lett. 2020, 9, 1–20. [Google Scholar] [CrossRef]
  5. Abanda, F.H.; Musa, A.M.; Clermont, P.; Tah, J.H.M.; Oti, A.H. A BIM-based framework for construction project scheduling risk management. Int. J. Comput. Aided Eng. Technol. 2020, 12, 182. [Google Scholar] [CrossRef]
  6. Georgiadou, M.C. An overview of benefits and challenges of building information modelling (BIM) adoption in UK residential projects. Constr. Innov. 2019, 19, 298–320. [Google Scholar] [CrossRef]
  7. Almuntaser, T.; Sanni-Anibire, M.O.; Hassanain, M.A. Adoption and implementation of BIM—Case study of a Saudi Arabian AEC firm. Int. J. Manag. Proj. Bus. 2018, 11, 608–624. [Google Scholar] [CrossRef]
  8. Liao, L.; Teo, E.A.L.; Low, S.P. A project management framework for enhanced productivity performance using building information modelling. Constr. Econ. Build. 2017, 17, 1–26. [Google Scholar] [CrossRef]
  9. Mesaros, P.; Spisakova, M.; Mandicak, T. Analysing the implementation motivations of BIM Technology in Construction Project Management. IOP Conf. Series Mater. Sci. Eng. 2020, 960, 042064. [Google Scholar] [CrossRef]
  10. Mayer, P.; Funtík, T.; Gašparík, J.; Makýš, P. Analysis of the Current State of Automation of Hazard Detection Processes in BIM in Slovakia. Appl. Sci. 2021, 11, 8130. [Google Scholar] [CrossRef]
  11. Sinaga, T.; Husin, A.E. Analysis of Time Efficiency with CCPM Method and BIM in Construction Projects Construction of High-Rise Residential Building Basement. Civ. Eng. Arch. 2021, 9, 1465–1477. [Google Scholar] [CrossRef]
  12. RezaHoseini, A.; Ghannadpour, S.F.; Noori, S.; Yazdani, M. Analyzing the Influence of Building Information Modeling (BIM) on Construction Project Management Areas of Knowledge: Using a Hybrid FANP-FVIKOR Approach. Int. J. Ind. Eng. Prod. Res. 2019, 30, 57–92. [Google Scholar] [CrossRef]
  13. Jununkar, S.M.; Aswar, P.D.S.; Mittapalli, P.D.L. Application of Bim and Construction Process Simulation Using 5d Bim for Residential Building Project. Int. Res. J. Eng. Technol. 2017, 4, 1063–1067. [Google Scholar]
  14. Khalesi, H.; Balali, A.; Valipour, A.; Antucheviciene, J.; Migilinskas, D.; Zigmund, V. Application of Hybrid SWARA–BIM in Reducing Reworks of Building Construction Projects from the Perspective of Time. Sustainability 2020, 12, 8927. [Google Scholar] [CrossRef]
  15. Bosch-Sijtsema, P.; Gluch, P. Challenging construction project management institutions: The role and agency of BIM actors. Int. J. Constr. Manag. 2019, 21, 1077–1087. [Google Scholar] [CrossRef]
  16. Ma, X.; Xiong, F.; Olawumi, T.O.; Dong, N.; Chan, A.P.C. Conceptual Framework and Roadmap Approach for Integrating BIM into Lifecycle Project Management. J. Manag. Eng. 2018, 34, 05018011. [Google Scholar] [CrossRef]
  17. Hamid, S.A.; Zainon, N. Development of Bim Capabilities Model for Malaysia Airport Project Management. Malays. Constr. Res. J. 2021, 12, 1. [Google Scholar]
  18. Valinejadshoubi, M.; Bagchi, A.; Moselhi, O. Development of a BIM-Based Data Management System for Structural Health Monitoring with Application to Modular Buildings: Case Study. J. Comput. Civ. Eng. 2019, 33, 05019003. [Google Scholar] [CrossRef]
  19. Lin, Y.-C.; Chen, Y.-P.; Huang, W.-T.; Hong, C.-C. Development of BIM Execution Plan for BIM Model Management during the Pre-Operation Phase: A Case Study. Buildings 2016, 6, 8. [Google Scholar] [CrossRef]
  20. Liu, D.; Chen, J.; Hu, D.; Zhang, Z. Dynamic BIM-augmented UAV safety inspection for water diversion project. Comput. Ind. 2019, 108, 163–177. [Google Scholar] [CrossRef]
  21. Ahmad, T.; Thaheem, M.J. Economic sustainability assessment of residential buildings: A dedicated assessment framework and implications for BIM. Sustain. Cities Soc. 2018, 38, 476–491. [Google Scholar] [CrossRef]
  22. Alothman, A.; Ashour, S.; Krishnaraj, L. Energy Performance Analysis of Building for Sustainable Design Using Bim: A Case Study on Institute Building. Int. J. Renew. Energy Res. 2021, 11, 556–565. [Google Scholar] [CrossRef]
  23. He, R.; Li, M.; Gan, V.J.L.; Ma, J. BIM-enabled computerized design and digital fabrication of industrialized buildings: A case study. J. Clean. Prod. 2021, 278, 123505. [Google Scholar] [CrossRef]
  24. Baik, A.; Almaimani, A.; Al-Amodi, M.; Rahaman, K.R. Applying digital methods for documenting heritage building in Old Jeddah: A case study of Hazzazi House. Digit. Appl. Archaeol. Cult. Heritage 2021, 21, e00189. [Google Scholar] [CrossRef]
  25. Alyami, A.; Sanni-Anibire, M.O. BIM in the Saudi Arabian construction industry: State of the art, benefit and barriers. Int. J. Build. Pathol. Adapt. 2019, 39, 33–47. [Google Scholar] [CrossRef]
  26. Namlı, E.; Işıkdağ, Ü.; Kocakaya, M.N. Building Information Management (BIM), A New Approach to Project Management. J. Sustain. Constr. Mater. Technol. 2019, 4, 323–332. [Google Scholar] [CrossRef]
  27. Boton, C.; Forgues, D. Practices and Processes in BIM Projects: An Exploratory Case Study. Adv. Civ. Eng. 2018, 2018, 7259659. [Google Scholar] [CrossRef]
  28. Banawi, A. Barriers to Implement Building Information Modeling (BIM) in Public Projects in Saudi Arabia. In Advances in Human Factors, Sustainable Urban Planning and Infrastructure: Proceedings of the AHFE 2017 International Conference on Human Factors, Sustainable Urban Planning and Infrastructure, 17–21 July 2017, The Westin Bonaventure Hotel, Los Angeles, CA, USA; Springer International Publishing: Berlin/Heidelberg, Germany, 2018; pp. 119–125. [Google Scholar] [CrossRef]
  29. Kim, S.; Chin, S.; Han, J.; Choi, C.-H. Measurement of Construction BIM Value Based on a Case Study of a Large-Scale Building Project. J. Manag. Eng. 2017, 33, 05017005. [Google Scholar] [CrossRef]
  30. Baik, A. From point cloud to Jeddah Heritage BIM Nasif Historical House—Case study. Digit. Appl. Archaeol. Cult. Herit. 2017, 4, 1–18. [Google Scholar] [CrossRef]
  31. Mesároš, P.; Mandičák, T. Exploitation and Benefits of BIM in Construction Project Management. IOP Conf. Ser. Mater. Sci. Eng. 2017, 245, 062056. [Google Scholar] [CrossRef]
  32. Olawumi, T.O.; Chan, D.W.M. Building Information Modelling and Project Information Management Framework for Construction Projects. J. Civ. Eng. Manag. 2019, 25, 53–75. [Google Scholar] [CrossRef]
  33. Aljobaly, O.; Banawi, A. Evaluation of the Saudi Construction Industry for Adoption of Building Information Modelling. In Advances in Artificial Intelligence, Software and Systems Engineering: Proceedings of the AHFE 2019 International Conference on Human Factors in Artificial Intelligence and Social Computing, the AHFE International Conference on Human Factors, Software, Service and Systems Engineering, and the AHFE International Conference of Human Factors in Energy, 24–28 July 2019, Washington, DC, USA; Springer International Publishing: Berlin/Heidelberg, Germany, 2020; pp. 488–498. [Google Scholar]
  34. Abazid, M.; Gökçekuş, H.; Çelik, T. Implementation of TQM and the Integration of BIM in the Construction Management Sector in Saudi Arabia. Adv. Mater. Sci. Eng. 2021, 2021, 1232620. [Google Scholar] [CrossRef]
  35. Xie, W.; Fu, W.; Lyu, B.; Li, Z.; Huang, J.; Xu, F. Incorporating Building Information Modeling (BIM) into the Super High-Rise Industrialized Housing Project: A Case Study. Bol. Tec. Bull. 2017, 55, 234–243. [Google Scholar]
  36. Ciribini, A.L.C.; Mastrolembo Ventura, S.; Paneroni, M. Implementation of an interoperable process to optimise design and construction phases of a residential building: A BIM Pilot Project. Autom. Constr. 2016, 71, 62–73. [Google Scholar] [CrossRef]
  37. Zhang, Y.; Huang, C.; Zhu, C. Research on the Application of Railway Engineering Project Management System Based on BIM. J. Railw. Eng. Soc. 2019, 36, 98–103. [Google Scholar]
  38. Liu, Y.; Zub, A.T. Research on the Application of BIM Technology in the Efficiency and Effectiveness of Construction Project Management. J. Phys. Conf. Ser. 2020, 1574, 012081. [Google Scholar] [CrossRef]
  39. Shaqour, E. The role of implementing BIM applications in enhancing project management knowledge areas in Egypt. Ain Shams Eng. J. 2021, 13, 101509. [Google Scholar] [CrossRef]
  40. Daniotti, B.; Masera, G.; Bolognesi, C.M.; Spagnolo, S.L.; Pavan, A.; Iannaccone, G.; Signorini, M.; Ciuffreda, S.; Mirarchi, C.; Lucky, M.; et al. The Development of a BIM-Based Interoperable Toolkit for Efficient Renovation in Buildings: From BIM to Digital Twin. Buildings 2022, 12, 231. [Google Scholar] [CrossRef]
  41. Narlawar, G.S.; Chaphalkar, N.B.; Sandbhor, S. Time and Resource Management of Residential Apartment Construction using Building Information Modeling. Int. J. Innov. Technol. Explor. Eng. 2019, 8, 4238–4246. [Google Scholar] [CrossRef]
  42. Baik, A. The Use of Interactive Virtual BIM to Boost Virtual Tourism in Heritage Sites, Historic Jeddah. ISPRS Int. J. Geo-Inf. 2021, 10, 577. [Google Scholar] [CrossRef]
  43. Alhumayn, S.; Chinyio, E.; Ndekugri, I. The Barriers and Strategies of Implementing Bim in Saudi Arabia. WIT Trans. Built Environ. 2017, 169, 55–67. [Google Scholar] [CrossRef]
  44. Hamida, M.B.; Ahmed, W.; Asif, M.; Almaziad, F.A. Techno-Economic Assessment of Energy Retrofitting Educational Buildings: A Case Study in Saudi Arabia. Sustainability 2020, 13, 179. [Google Scholar] [CrossRef]
  45. Elshafey, A.; Saar, C.C.; Aminudin, E.B.; Gheisari, M.; Usmani, A. Technology acceptance model for Augmented Reality and Building Information Modeling integration in the construction industry. J. Inf. Technol. Constr. 2020, 25, 161–172. [Google Scholar] [CrossRef]
  46. Al-Saggaf, A.; Taha, M.; Hegazy, T.; Ahmed, H. Towards Sustainable Building Design: The Impact of Architectural Design Features on Cooling Energy Consumption and Cost in Saudi Arabia. Procedia Manuf. 2020, 44, 140–147. [Google Scholar] [CrossRef]
  47. Abazid, M.; Gökçekuş, H.; Çelik, T. Study of the Quality Concepts Implementation in the Construction of Projects in Saudi Arabia by Using Building Information Modelling (BIM). Int. J. Innov. Technol. Explor. Eng. 2019, 8, 84–87. [Google Scholar]
  48. Hu, S.; Chen, Y.; Guo, F. Research on the Optimization of Old Residential Reconstruction Project Based on BIM. RISTI—Rev. Iber. Sist. e Tecnol. Inf. 2016, 8, 421. [Google Scholar]
  49. Lou, T.; He, B.; Zhang, B.; Duan, Z. Research and Application of BIM Project Group Management. IOP Conf. Ser. Earth Environ. Sci. 2019, 218, 012056. [Google Scholar] [CrossRef]
  50. Jin, R.; Yang, T.; Piroozfar, P.; Kang, B.-G.; Wanatowski, D.; Hancock, C.M.; Tang, L. Project-based pedagogy in interdisciplinary building design adopting BIM. Eng. Constr. Archit. Manag. 2018, 25, 1376–1397. [Google Scholar] [CrossRef]
  51. Maraqa, M.J.; Sacks, R.; Spatari, S. Quantitative assessment of the impacts of BIM and lean on process and operations flow in construction projects. Eng. Constr. Arch. Manag. 2021, 28, 2176–2198. [Google Scholar] [CrossRef]
  52. Alshibani, A. Prediction of the Energy Consumption of School Buildings. Appl. Sci. 2020, 10, 5885. [Google Scholar] [CrossRef]
  53. Majzoub, M.; Eweda, A. Probability of Winning the Tender When Proposing Using BIM Strategy: A Case Study in Saudi Arabia. Buildings 2021, 11, 306. [Google Scholar] [CrossRef]
  54. Elhendawi, A.; Omar, H.; Elbeltagi, E.; Smith, A. Practical approach for paving the way to motivate BIM non-users to adopt BIM. Int. J. BIM Eng. Sci. 2020, 2, 1–22. [Google Scholar] [CrossRef]
  55. Elhendawi, A.; Smith, A.; Elbeltagi, E. Methodology for BIM implementation in the Kingdom of Saudi Arabia. Int. J. BIM Eng. Sci. 2019, 2, 1–21. [Google Scholar] [CrossRef]
  56. Alattas, A.; Kalogianni, E.; Alzahrani, T.; Zlatanova, S.; van Oosterom, P. Mapping private, common, and exclusive common spaces in buildings from BIM/IFC to LADM. A case study from Saudi Arabia. Land Use Policy 2021, 104, 105355. [Google Scholar] [CrossRef]
  57. Mia, F.H.; Nawari, N.O. BIM-Based Metric for Sustainable Built Environment in Saudi Arabia. In Proceedings of the Construction Research Congress 2020: Computer Applications—Selected Papers from the Construction Research Congress 2020, Tempe, AZ, USA, 8–10 March 2020. [Google Scholar]
  58. Ahmed, W.; Asif, M. BIM-based techno-economic assessment of energy retrofitting residential buildings in hot humid climate. Energy Build. 2020, 227, 110406. [Google Scholar] [CrossRef]
  59. Al-Hammadi, M.A.; Tian, W. Challenges and Barriers of Building Information Modeling Adoption in the Saudi Arabian Construction Industry. Open Constr. Build. Technol. J. 2020, 14, 98–110. [Google Scholar] [CrossRef]

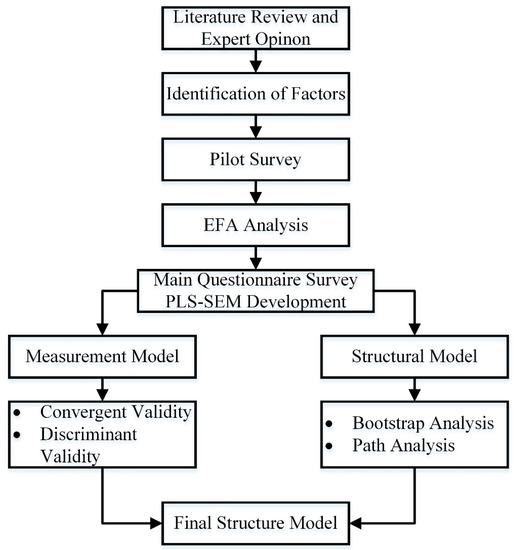

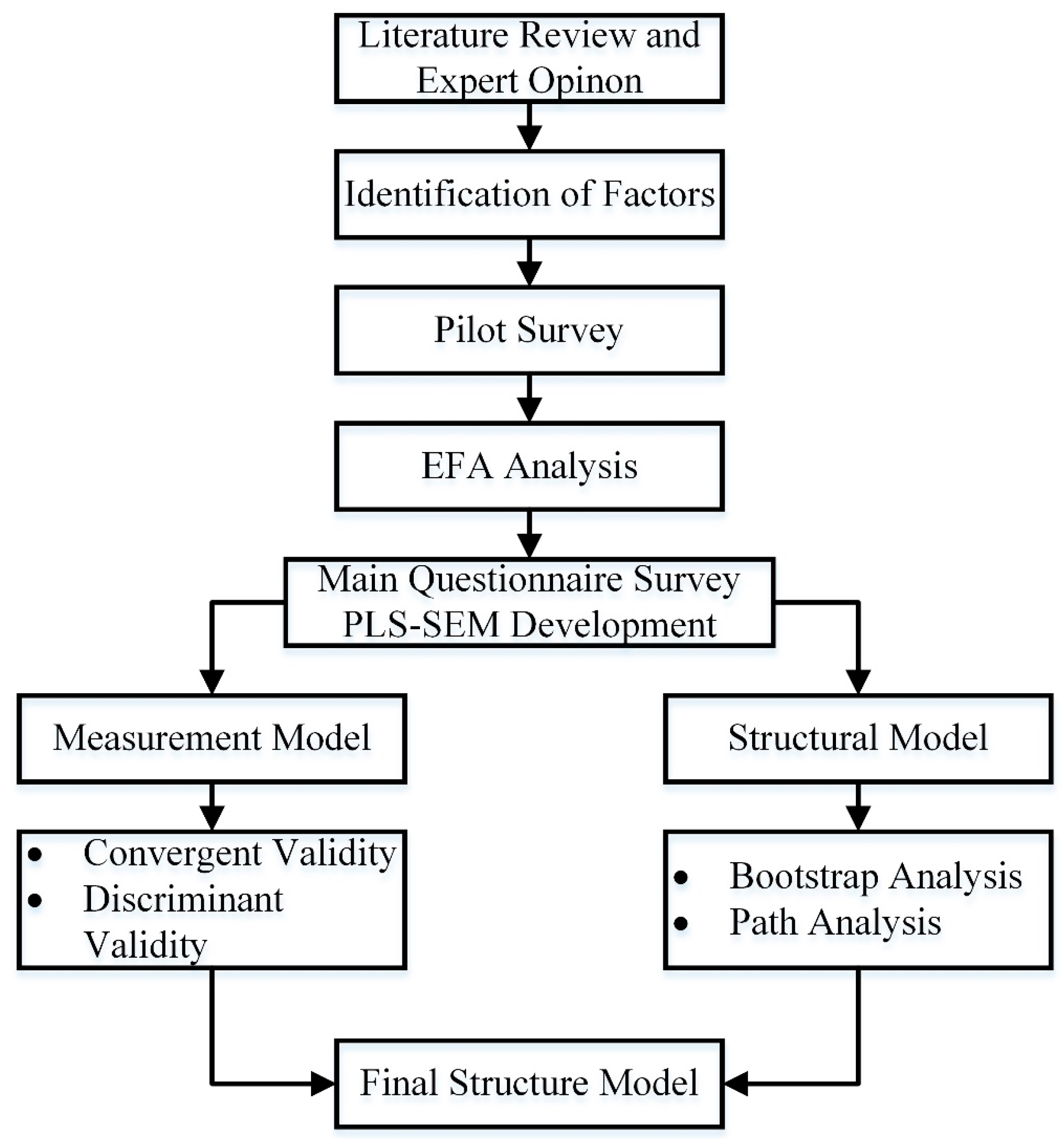

Figure 1. Flow chart of the work.
Figure 1. Flow chart of the work.
Sustainability 15 07354 g001

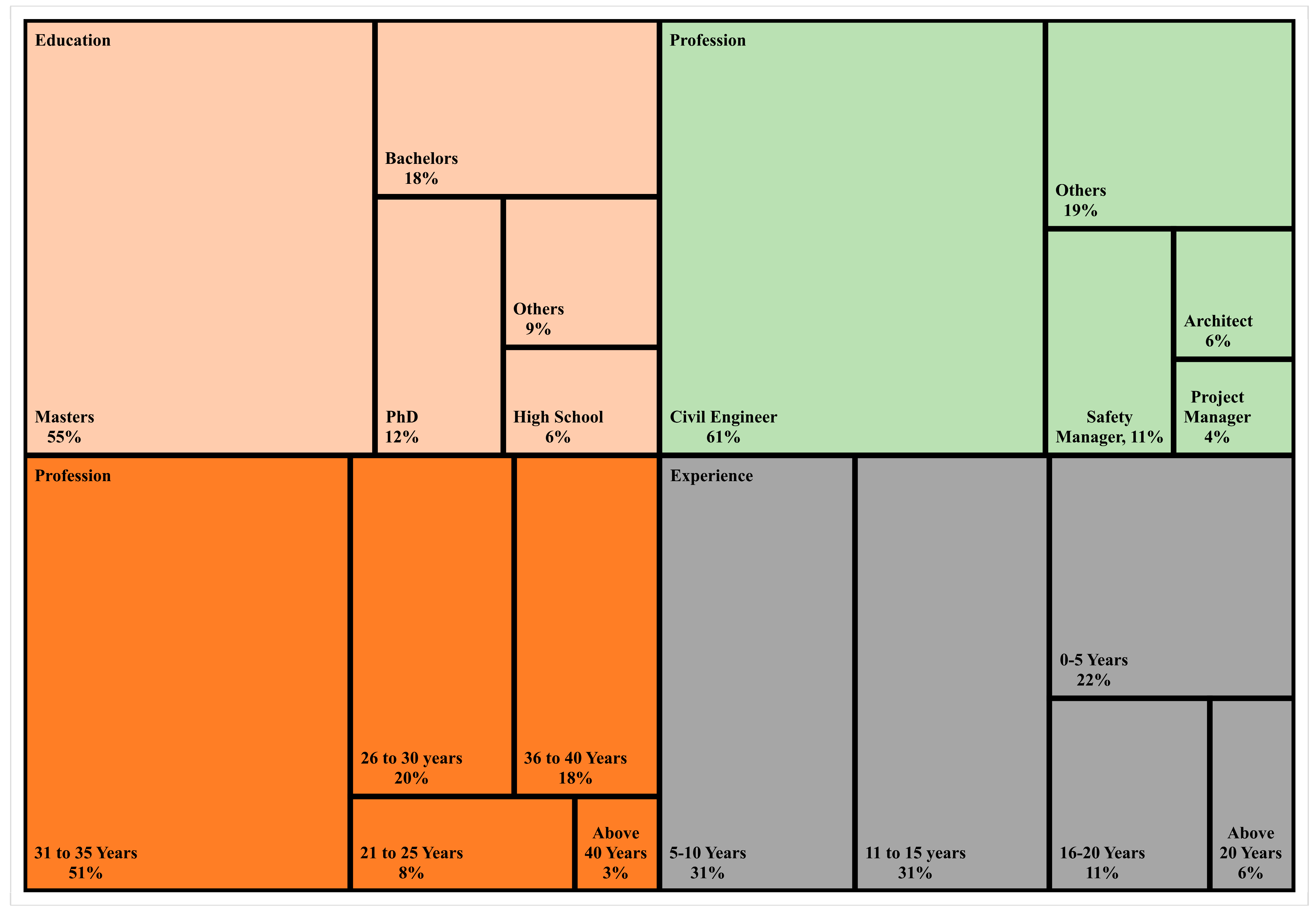

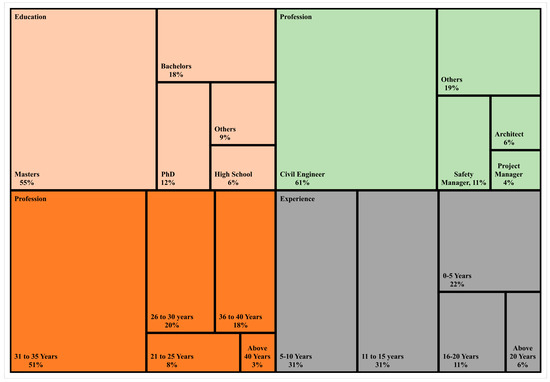

Figure 2. Demographic details.
Figure 2. Demographic details.
Sustainability 15 07354 g002

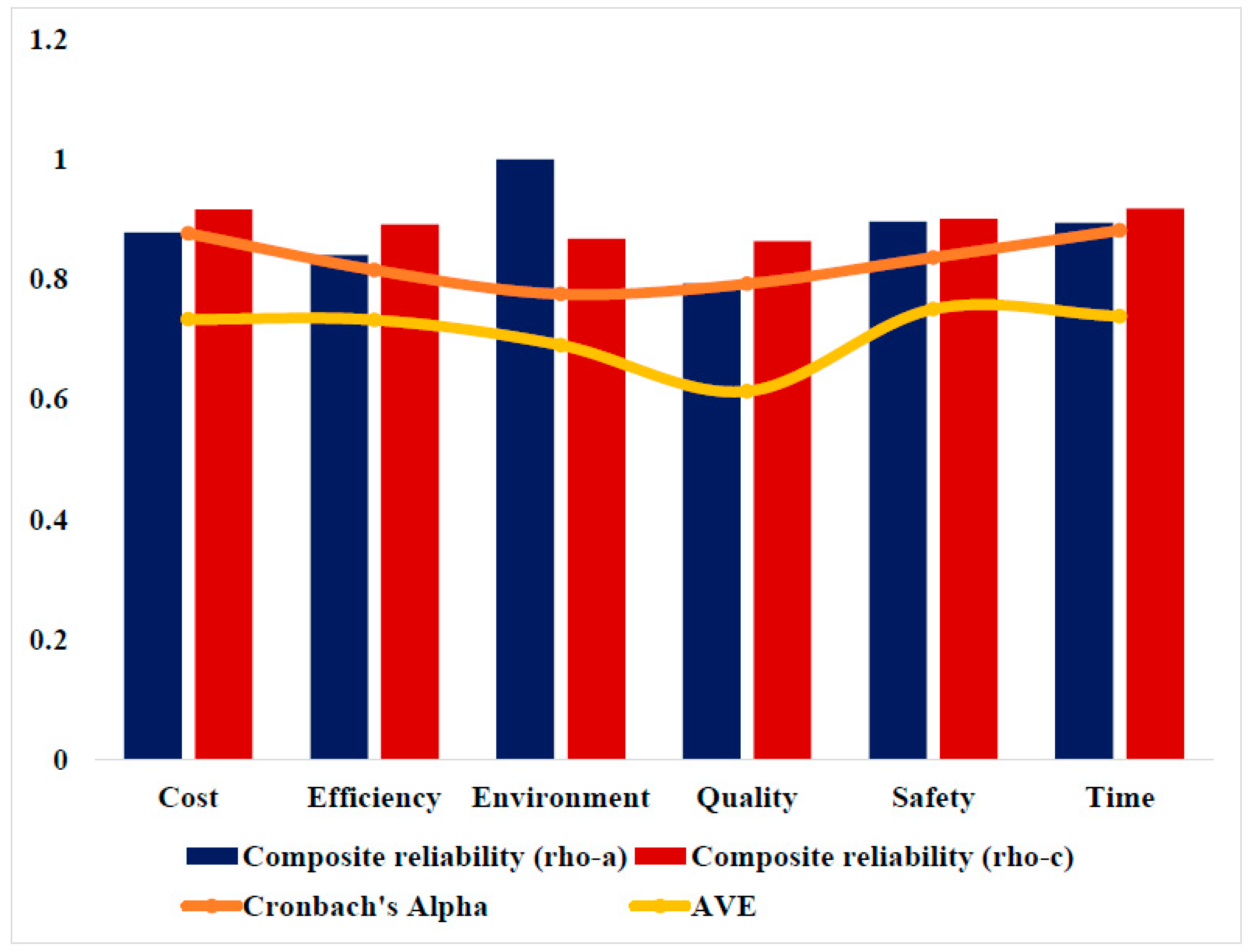

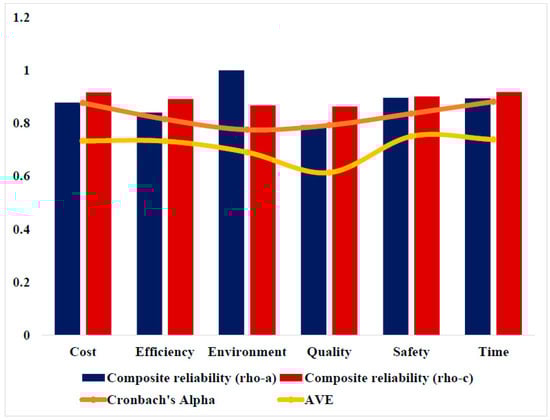

Figure 3. Trend of reliability statistics.
Figure 3. Trend of reliability statistics.
Sustainability 15 07354 g003

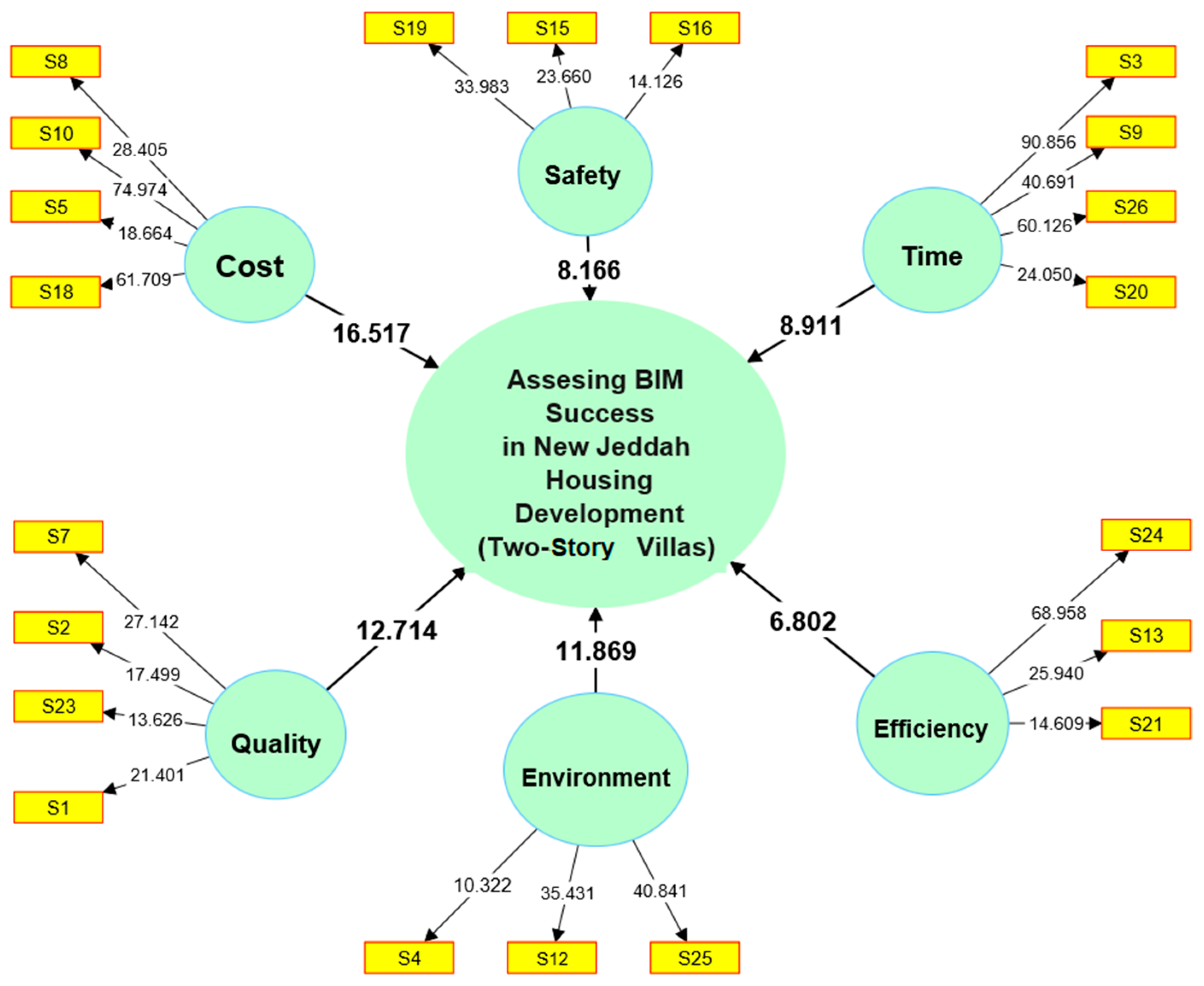

Figure 4. Structure model indicating relationship significance of success factors.
Figure 4. Structure model indicating relationship significance of success factors.
Sustainability 15 07354 g004

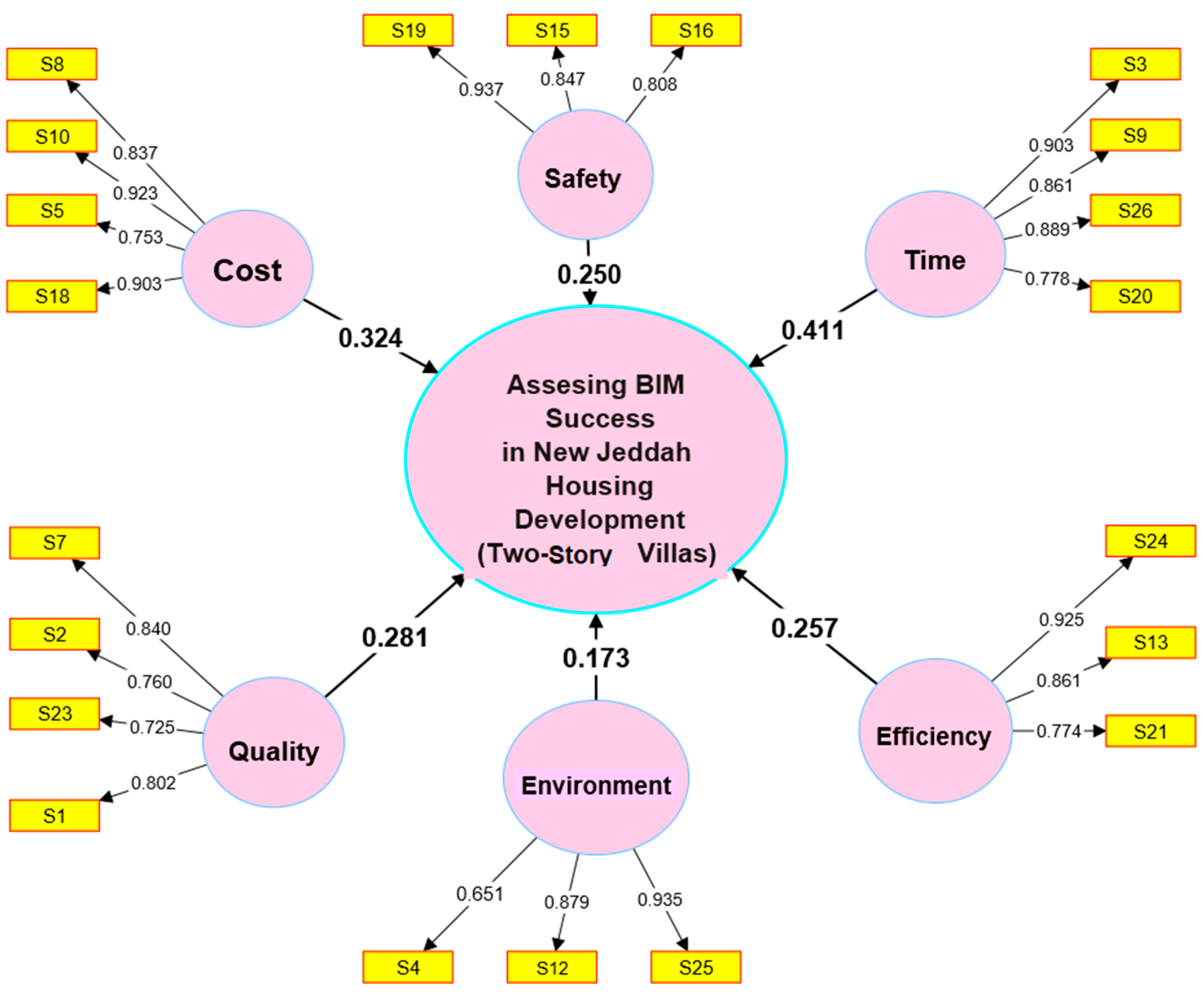

Figure 5. Model with items, item loadings and path coefficients.
Figure 5. Model with items, item loadings and path coefficients.
Sustainability 15 07354 g005

Figure 6. Path significance results after bootstrapping analysis.
Figure 6. Path significance results after bootstrapping analysis.
Sustainability 15 07354 g006
Table 1. Critical findings from the literature.
Table 1. Critical findings from the literature.
Serial No.TitleProject TypeFindingsMethodologyReferences
1BIM-based green building evaluation and optimization: A case studyMulti-Story Residential BuildingBIM implementation increases the impact of green building initiatives and project management performance.Case study analysis focusing on green building framework[19]
2BIM-enabled computerized design and digital fabrication of industrialized buildings: A case studyIndustrial BuildingsBIM-based management can enhance building performance and increase the efficiency of construction.State-of-the-art review case study[23]
3Energy Performance Analysis of Building for Sustainable Design Using BIM: A Case Study on Institute BuildingCommercial Sector Multi-Story BuildingsBIM was found to be positively linked with project sustainability and maximized performance.Case study on a single education building in Egypt[22]
4Challenging construction project management institutions: the role and agency of BIM actorsMulti-Story Residential BuildingBIM is critically related to improvements in all aspects of project management.Case study involving semi-structured interviews and observations[15]
5Applying digital methods for documenting heritage building in Old Jeddah: A case study of Hazzazi HouseTwo-Story Single HouseBIM implementation was found to be better for increased quality and cost reduction.Case-study-based surveying of Hazzazi House[24]
6BIM in the Saudi Arabian construction industry: state of the art, benefit and barriersMulti-Story Residential BuildingBIM implementation can bring more accuracy and efficiency to construction projects.State-of-the-art review case study[25]
7A BIM-based approach for DfMA in building construction: framework and first results on an Italian case studyMulti-Story Residential BuildingBIM is linked with increasing construction sustainability, and projects have become more reliable both in the UK and Singapore.Case-study-based evaluation of frameworks[1]
8Development of a BIM-Based Data Management System for Structural Health Monitoring with Application to Modular Buildings: Case StudyModular Multi-Story BuildingsBIM can effectively optimize construction output, reducing performance time.Case study approach focusing on structural health monitoring of the project’s end phase[18]
9Building Information Management (BIM), A New Approach to Project ManagementMulti-Story Residential BuildingBIM can improve project management and bring greater control over project management challenges.Qualitative case study analysis of the project management of construction projects.[26]
10Practices and Processes in BIM Projects: An Exploratory Case StudyMulti-Story Residential BuildingBIM can help mitigate gaps in stages of project management.Exploratory case study analysis[27]
11Barriers to implementing Building Information Modeling (BIM) in public projects in Saudi ArabiaPublic Sector Multi-Story Building ProjectBIM implementation and project management performance improvement barriers were identified.Case study focusing on Saudi construction projects only[28]
12Measurement of Construction BIM Value Based on a Case Study of a Large-Scale Building ProjectHigh-Rise Building ProjectProject management value can be enhanced by implementing BIM in large-scale construction projects.Case study evaluation of large-scale building projects only[29]
13From point cloud to Jeddah Heritage BIM Nasif Historical House—case studyTwo-Story Single HouseBIM was found to be efficient for the maintenance projects of buildings.Exploratory case study analysis approach[30]
14Exploitation and Benefits of BIM in Construction Project ManagementMulti-Story Residential BuildingBIM has significant benefits if it is implemented with greater control and accuracy.Case study approach involving a review method[31]
15Development of BIM Execution Plan for BIM Model Management during the Pre-Operation Phase: A Case StudyMulti-Story Residential BuildingBIM can manage project challenges while improving the ability to optimize costs and time.Case study only focusing on the operational phase of projects[19]
Table 2. Identified success factors of BIM.
Table 2. Identified success factors of BIM.
Sr. #Success FactorsReferences
1BIM may assist project teams in managing the project better, improving project quality.[23]
2BIM helps project stakeholders work together toward the same objectives. Ensuring that stakeholders agree on project requirements and specifications may increase project value.[15,32]
3By providing a virtual 3D model of the project, BIM may assist project teams in more precisely organizing construction operations.[31,33]
4BIM can increase energy efficiency by giving precise energy performance data. This may uncover energy savings and improve building systems to minimize energy consumption and greenhouse gas emissions.[30,34]
5BIM helps project teams identify project resource needs. This improves resource management and reduces waste.[35,36]
6BIM optimizes the design and identifies problems, making it more efficient and effective.[37,38]
7BIM lets designers develop a virtual 3D model of the project to discover and fix design faults before construction. This may enhance the design and decrease construction mistakes and rework.[39,40]
8BIM helps project teams estimate building costs by providing precise and thorough project information. This reduces cost overruns and delays.[41,42]
9BIM may minimize the time required to finish a building project by giving precise and thorough information about the project. This may assist in eliminating construction mistakes, rework and delays, resulting in speedier project completion timeframes.[43,44]
10BIM may save construction costs by detecting and fixing flaws before the building starts. This reduces construction mistakes, rework and delays.[40,45]
11BIM streamlines design engineers’ process and reduces iteration time and expense.[37,38]
12BIM provides precise project information to optimize material utilization[46]
13BIM enhances construction project sequencing, resulting in productivity improvements.[41,42]
14BIM helps improve safety planning by providing accurate and complete project information.[39,40]
15BIM’s 3D model may prevent construction conflicts.[43]
16BIM may be used to create virtual training programs for construction personnel to understand project safety measures better.[44,45]
17BIM can assist project teams in uncovering value engineering possibilities to increase project value.[47]
18BIM may assist in achieving project specs while reducing expenses.[37,48]
19BIM’s virtual 3D model may assist project teams in discovering dangers before building starts. This reduces construction accidents and injuries.[38,49]
20BIM provides accurate project information before construction to ensure that prefabricated components are built to specs and delivered to the building site on schedule.[50,51]
21BIM improves construction project data, resulting in efficiency improvement.[52,53]
22BIM improves design integration.[27,54]
23BIM delivers accurate project information to meet obligations and improves project excellence.[55]
24BIM helps project stakeholders work together toward the same ideas, reduces misconceptions and aligns everyone on project needs and specs, improving productivity.[29,56]
25BIM’s precise energy usage and greenhouse gas emission data help lower the project’s carbon impact.[35]
26BIM allows parties to operate in a coordinated and collaborative way, streamlining communication and reducing misunderstandings. This may contribute to the timely and cost-effective completion of building projects.[34]
27BIM provides better planning, resource management and project stakeholder consultation.[30,36]
28BIM may alleviate site congestion by delivering precise project information.[31,33]
Table 3. Exploratory Factor Analysis output.
Table 3. Exploratory Factor Analysis output.
Variables123456
S30.863
S90.834
S260.822
S200.811
S8 0.787
S10 0.745
S5 0.743
S17 0.708
S18 0.703
S7 0.732
S2 0.704
S23 0.702
S1 0.684
S27 0.620
S19 0.857
S14 0.808
S16 0.780
S15 0.750
S28 0.701
S24 0.817
S13 0.806
S21 0.741
S4 0.854
S12 0.802
S25 0.717
Eigenvalue4.644.123.453.232.892.83
% Variance
ExtractionS6, S22, S11
Table 4. Barriers along with constructed categories from EFA analysis.
Table 4. Barriers along with constructed categories from EFA analysis.
BIM Success PhaseAssigned CodeDescription
TimeS3By providing a virtual 3D model of the project, BIM may assist project teams in more precisely organizing construction operations.
S9BIM may minimize the time required to finish a building project by giving precise and thorough information about the project. This may assist in eliminating construction mistakes, rework and delays, resulting in speedier project completion timeframes.
S26BIM allows parties to operate in a coordinated and collaborative way, streamlining communication and reducing misunderstandings. This may contribute to the timely and cost-effective completion of building projects.
S20BIM provides accurate project information before construction to ensure that prefabricated components are built to specs and delivered to the building site on schedule.
CostS8BIM helps project teams estimate building costs by providing precise and thorough project information. This reduces cost overruns and delays.
S10BIM may save construction costs by detecting and fixing flaws before the building starts. This reduces construction mistakes, rework and delays.
S5BIM helps project teams identify project resource needs. This improves resource management and reduces waste.
S17BIM can assist project teams in uncovering value engineering possibilities to increase project value.
S18BIM may assist in achieving project specs while reducing expenses.
QualityS7BIM lets designers develop a virtual 3D model of the project to discover and fix design faults before construction. This may enhance the design and decrease construction mistakes and rework.
S2BIM helps project stakeholders work together toward the same objectives. Ensuring that stakeholders agree on project requirements and specifications may increase project value.
S23BIM delivers accurate project information to meet obligations and improves project excellence.
S1BIM may assist project teams in managing the project better, improving project quality.
S27BIM provides better planning, resource management and project stakeholder consultation.
SafetyS19BIM’s virtual 3D model may assist project teams in discovering dangers before building starts. This reduces the number of construction accidents and injuries.
S14BIM helps improve safety planning by providing accurate and complete project information.
S16BIM may be used to create virtual training programs for construction personnel to understand project safety measures better.
S15BIM’s 3D model may prevent construction conflicts.
S28BIM may alleviate site congestion by delivering precise project information.
EfficiencyS24BIM helps project stakeholders work together toward the same ideas, reduces misconceptions and aligns everyone on project needs and specs, improving productivity.
S13BIM enhances construction project sequencing, resulting in productivity improvements.
S21BIM improves construction project data, resulting in efficiency improvements.
EnvironmentS4BIM can increase energy efficiency by giving precise energy performance data. This may uncover energy savings and improve building systems to minimize energy consumption and greenhouse gas emissions.
S12BIM provides precise project information to optimize material utilization.
S25BIM’s precise energy usage and greenhouse gas emission data help lower the project’s carbon impact.
Table 5. Model reliability and validity findings.
Table 5. Model reliability and validity findings.
ConstructsCronbach’s AlphaComposite Reliability (rho-a)Composite Reliability (rho-c)Average Variance Extracted (AVE)
Cost0.8760.8780.9160.733
Efficiency0.8150.840.8910.732
Environment0.7750.9990.8670.69
Quality0.7920.7930.8630.613
Safety0.8360.8960.90.75
Time0.8810.8940.9180.738
Table 6. Empirical correlation matrix.
Table 6. Empirical correlation matrix.
VariablesS1S10S12S13S15S16S18S19S2S20S21S23S24S25S26S3S4S5S7S8S9
S110.104−0.153−0.0120.094−0.1110.123−0.0480.3780.230.040.370.074−0.0990.1260.1270.0970.220.9040.1310.152
S100.10410.090.1520.2030.110.940.2290.1650.2110.1260.020.1450.0970.2480.2680.0350.5220.0480.6920.275
S12−0.1530.0910.036−0.017−0.040.081−0.071−0.156−0.075−0.066−0.088−0.0140.8050.0620.2520.4250.041−0.1150.0310.065
S13−0.0120.1520.03610.1790.0640.130.120.1580.0230.4580.2290.730.1470.1580.1440.0640.078−0.0230.0660.202
S150.0940.203−0.0170.17910.4830.180.6590.12−0.040.0540.1620.1860.0570.1290.225−0.0650.2250.1090.1710.134
S16−0.1110.11−0.040.0640.48310.0620.7450.0520.0210.0520.0240.0160.0010.1350.193−0.1010.015−0.1510.0330.086
S180.1230.940.0810.130.180.06210.1840.1630.1860.1140.0330.0950.0810.1770.2310.0080.480.060.6710.236
S19−0.0480.229−0.0710.120.6590.7450.18410.1460.1860.0670.1470.1440.0950.3150.366−0.10.223−0.0920.1630.298
S20.3780.165−0.1560.1580.120.0520.1630.14610.3320.0850.4260.1580.020.3870.3890.0550.0720.4290.0510.388
S200.230.211−0.0750.023−0.040.0210.1860.1860.33210.080.1950.1360.110.5470.5210.0480.3380.2440.1930.701
S210.040.126−0.0660.4580.0540.0520.1140.0670.0850.0810.1230.596−0.0020.1790.205−0.0090.0860.0610.1160.206
S230.370.02−0.0880.2290.1620.0240.0330.1470.4260.1950.12310.2290.0410.2430.255−0.0050.2420.4190.0220.223
S240.0740.145−0.0140.730.1860.0160.0950.1440.1580.1360.5960.22910.1270.2530.1970.10.120.0790.120.263
S25−0.0990.0970.8050.1470.0570.0010.0810.0950.020.11−0.0020.0410.12710.3730.4450.3730.141−0.0290.060.24
S260.1260.2480.0620.1580.1290.1350.1770.3150.3870.5470.1790.2430.2530.37310.8590.0530.3520.1890.1880.608
S30.1270.2680.2520.1440.2250.1930.2310.3660.3890.5210.2050.2550.1970.4450.85910.10.370.1930.2060.662
S40.0970.0350.4250.064−0.065−0.1010.008−0.10.0550.048−0.009−0.0050.10.3730.0530.110.1330.1230.2480.046
S50.220.5220.0410.0780.2250.0150.480.2230.0720.3380.0860.2420.120.1410.3520.370.13310.1810.5280.355
S70.9040.048−0.115−0.0230.109−0.1510.06−0.0920.4290.2440.0610.4190.079−0.0290.1890.1930.1230.18110.1310.2
S80.1310.6920.0310.0660.1710.0330.6710.1630.0510.1930.1160.0220.120.060.1880.2060.2480.5280.13110.264
S90.1520.2750.0650.2020.1340.0860.2360.2980.3880.7010.2060.2230.2630.240.6080.6620.0460.3550.20.2641
Table 7. Fornell–Larker criterion results.
Table 7. Fornell–Larker criterion results.
CostEfficiencyEnvironmentQualitySafetyTime
Cost
Efficiency0.182
Environment0.1490.111
Quality0.1980.1970.16
Safety0.2360.160.1050.189
Time0.3980.2740.2640.430.277
Table 8. HTMT analysis results.
Table 8. HTMT analysis results.
CostEfficiencyEnvironmentQualitySafetyTime
Cost0.856
Efficiency0.1540.856
Environment0.1260.0870.831
Quality0.1670.165−0.0230.783
Safety0.2240.145−0.0020.0860.866
Time0.3550.240.2670.3770.2570.859
Table 9. Cross-loadings of items.
Table 9. Cross-loadings of items.
VariablesCostEfficiencyEnvironmentQualitySafetyTime
S80.8370.1170.1230.10.1560.247
S100.9230.1650.0940.1130.2210.293
S50.7530.1120.1390.2210.2030.411
S180.9030.130.0730.1250.1770.242
S240.1410.9250.1070.1820.1490.251
S130.1260.8610.120.130.1470.16
S210.1290.774−0.020.1030.0670.201
S40.1220.0660.6510.081−0.10.073
S120.072−0.0140.879−0.165−0.0510.102
S250.1130.1130.935−0.0130.0690.354
S70.1240.047−0.0080.84−0.0380.236
S230.0980.2310.0020.7250.1430.268
S20.1330.159−0.0080.760.1320.437
S10.1710.042−0.0690.802−0.0130.179
S190.2370.1330.0090.0670.9370.346
S150.230.170.0110.1580.8470.142
S160.0650.049−0.041−0.0450.8080.134
S30.3190.2110.3690.3280.3160.903
S200.2760.0960.0640.3280.0780.778
S260.2880.2330.2630.3220.2380.889
S90.3340.2630.1790.3250.2190.861
Table 10. Summary of deleted factors.
Table 10. Summary of deleted factors.
VariablesStageStatus
S6EFA (Pilot)Deleted
S22EFA (Pilot)Deleted
S11EFA (Pilot)Deleted
S17SEM (Main)Deleted
S27SEM (Main)Deleted
S14SEM (Main)Deleted
S28SEM (Main)Deleted
Table 11. Outer weights and group impact rank.
Table 11. Outer weights and group impact rank.
VariablesOuter WeightsVIFGroup Impact Rank
S1 ← Quality0.8022.488Rank 3
S2 ← Quality0.761.347
S23 ← Quality0.7251.334
S7 ← Quality0.841.898
S15 ← Safety0.8471.77Rank 5
S16 ← Safety0.8082.252
S19 ← Safety0.9373.055
S26 ← Time0.8892.031Rank 1
S20 ← Time0.7782.079
S3 ← Time0.9032.373
S9 ← Time0.8612.584
S4 ← Environment0.6511.225Rank 6
S25 ← Environment0.9352.847
S12 ← Environment0.8792.992
S5 ← Cost0.7531.489Rank 2
S8 ← Cost0.8372.09
S10 ← Cost0.9232.328
S18 ← Cost0.9032.627
S13 ← Efficiency0.8612.145Rank 4
S21 ← Efficiency0.7741.555
S24 ← Efficiency0.9252.629
Table 12. Path analysis results of formative constructs.
Table 12. Path analysis results of formative constructs.
PathβSEt-Valuesp-ValuesVIF
Cost → Assessing BIM success in New Jeddah Housing Development (Two-Story Villas)0.3240.02616.517<0.0011.077
Efficiency → Assessing BIM success in New Jeddah Housing Development (Two-Story Villas)0.2570.0256.802<0.0011.2
Environment → Assessing BIM success in New Jeddah Housing Development (Two-Story Villas)0.1730.02611.869<0.0011.519
Quality → Assessing BIM success in New Jeddah Housing Development (Two-Story Villas)0.2810.02912.714<0.0011.153
Safety → Assessing BIM success in New Jeddah Housing Development (Two-Story Villas)0.2500.0268.166<0.0011.222
Time → Assessing BIM success in New Jeddah Housing Development (Two-Story Villas)0.4110.038.911<0.0011.106
Table 13. Endogenous latent variable Q2.
Table 13. Endogenous latent variable Q2.
Predictive Relevance Analysis of ModelSSOSSEQ2 (=1 − SSO/SSE)
Assessing BIM success in New Jeddah Housing Development (Two-Story Villas)14,980.00013,011.4950.131
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Almujibah, H. Assessment of Building Information Modeling (BIM) as a Time and Cost-Saving Construction Management Tool: Evidence from Two-Story Villas in Jeddah. Sustainability 2023, 15, 7354. https://doi.org/10.3390/su15097354

AMA Style

Almujibah H. Assessment of Building Information Modeling (BIM) as a Time and Cost-Saving Construction Management Tool: Evidence from Two-Story Villas in Jeddah. Sustainability. 2023; 15(9):7354. https://doi.org/10.3390/su15097354

Chicago/Turabian Style

Almujibah, Hamad. 2023. "Assessment of Building Information Modeling (BIM) as a Time and Cost-Saving Construction Management Tool: Evidence from Two-Story Villas in Jeddah" Sustainability 15, no. 9: 7354. https://doi.org/10.3390/su15097354
