Article

Cost-Effective Target Capacity Assessment in the Energy Transition: The Italian Methodology †

1
Italian Transmission System Operator, Terna S.p.A., 00156 Rome, Italy
2
Italian Regulatory Authority for Energy, Networks and Environment, 20121 Milan, Italy
3
Italian Electrotechnical Experimental Center, CESI S.p.A., 20134 Milan, Italy
*
Authors to whom correspondence should be addressed.
This paper is an extended version of the final Dissertation published in 2021 “Power system planning methods and experiences in the energy transition framework”, Migliori, Michela.
Energies 2024, 17(12), 2824; https://doi.org/10.3390/en17122824
Submission received: 29 March 2024 / Revised: 30 May 2024 / Accepted: 4 June 2024 / Published: 8 June 2024

Abstract

:
Long-term transmission expansion planning has to face the energy transition in a restructured electricity market environment. Increased transmission capacity within and between Member States is likely to play an essential role in maintaining the secure and economic operation of the whole European power system and ensuring the integration of growing renewable generation. This paper proposes a novel iterative methodology aimed at assessing an optimal level of interconnection between relevant bidding zones, simultaneously investigating different potential alternatives. Starting from a reference grid, a multi-criteria analysis is adopted to select the additional transmission capacities to be tested in each iteration via network and market simulations in order to confirm that transmission expansion benefits outweigh the estimated realization costs. The proposed approach is applied to the Italian case in two contrasting energy scenarios for the mid-term 2030 and very-long-term 2040 horizons: different development strategies are derived, and the least regret criterion is applied to define the most cost-effective as the target development strategy for the Transmission System Operator (TSO). Furthermore, sensitivity analyses on relevant input data variation are performed to test the robustness of the results obtained.

1. Introduction

In recent years, the unbundling of the electricity sector together with the profound energy landscape transformation has raised new challenges to network planners and regulators. The European climate and energy objectives aim at an increasing penetration of Renewable Energy Sources (“RES”), a greater diversification of generation sources, the use of sustainable solutions, and increased market integration [1]. The electricity sector is recognized as one of the main contributors to the energy transition processes, taking place in most countries all over the world [2]. In the European context, the Member States have made the crucial commitment to become climate-neutral and zero-gas-emission economies by 2050 [3], as established by the European Green Deal. It is now clear that the energy transition will have an increasingly important impact on economies, labor markets, regulatory directives, and power system development [4].
Consequently, expansion planning became a very complex multi-objective problem [5,6] including the following: the efficient location of transmission expansion developments, the mitigation of transmission congestion, the fulfillment of security and reliability requirements, the nondiscriminatory access to generation resources, the market participants’ competition facilitation, and social and environmental aspects [7,8].
New methods are required to identify cost-effective development strategies in the presence of increased uncertainties about load and generation trends, fuel availability, commodity prices, market rules, energy–climate policies, transmission infrastructure costs, and realization of energy storage systems [8,9,10,11,12].
In Italy, for the first time in 2017, the Italian Regulatory Authority for Energy, Networks and Environment (ARERA) requested the Italian Transmission System Operator (Terna) to assess the “Target Capacity”, defined as the efficient level of additional transmission capacity to be realized, for each cross-border and cross-zonal boundary of the Italian power system in each significant planning scenario.
This paper presents the novel methodology developed and the results obtained by its third application to the Italian power system real case study, carried out in 2023 [13].

1.1. The Concept of Target Capacity and Its Implementation in the Italian Regulatory Framework

This section of this paper explains the concept of target capacity and the discussions leading to its implementation in the period 2015–2018.
In the European Council of Barcelona in March 2002, an electricity interconnection target equivalent to at least 10% of the installed generation capacity for Member States by 2005 was established. In October 2014, the Council concluded that “the European Commission supported by the Member States will take urgent measures in order to ensure the achievement of a minimum target of 10% of existing electricity interconnections, as a matter of urgency, and no later than 2020”. Furthermore, the European Commission proposed to extend the interconnection target up to 15% by 2030.
These one-size-fits-all interconnection targets received heavy criticisms, among others from the Agency for the Cooperation of Energy Regulators (ACER) [14], the Council of European Energy Regulators [15], and the Italian Energy Regulatory Authority [16,17]. These criticisms relate to the risks of building inefficient transmission capacity (because the benefits could be lower than costs), to a potential risk of under-investment (when additional capacity above the interconnection target would be efficient), and to double counting effects when used in a cost–benefit analysis or in a multi-criteria analysis.
Also, for these reasons, since its public consultation 464/2015 [18], ARERA proposed the concept of target capacity, meaning the transmission capacity which is economically efficient to build because its benefits outweigh its costs.
The concept of target capacity was initially proposed in 2012 by ACER in its Opinion 06/2012 on the draft Ten Year Network Development Plan (TYNDP) 2012 [19]: “since the main purpose of the TYNDP is to identify the investment gaps, notably with respect to cross border capacities, the Agency expects ENTSO-E to develop a specific assessment of cross-border capacities. The aim should be to identify a target value (MW) for the additional transfer capacities at cross-border boundaries”. In the same opinion, ACER acknowledged the complexity related to the quantification of the target and the possibility to identify capacity ranges according to each scenario’s assumptions and each sensitivity case. We note that ACER initially proposed the concept of target capacity as the efficient additional capacity (beyond the existing capacity).
In order to help identify an optimal level of interconnection capacity between bidding zones, ENTSO-E introduced the definition and calculation of target capacities at each border in the TYNDP 2014 and refined them in the ENTSO-E Regional Investment Plans 2015 and in the TYNDP 2016. In particular, the target capacity for every boundary between bidding zones corresponds to the value above which further transmission capacity realization would not be beneficial because the economic benefit corresponding to the additional capacity cannot outweigh the deriving costs. We note that under such a definition (retained by ARERA), the target capacity is the total efficient capacity at a specific boundary.
After carrying out a second consultation in 2017, ARERA adopted its Decision 884/2017 [20], which requested the Italian Transmission System Operator Terna to prepare during the year 2018 a report about the identification of the target capacities for the relevant internal market sections and towards external network borders of the Italian power system.
In 2018, as already envisaged during the public consultations, ARERA adopted an output-based regulatory scheme applicable at that time until 2023 and afterwards with amendments until 2027 [21,22], which rewards the commissioning of new transmission capacity at a number of boundaries of the Italian power system (till the target capacity level) related to the achieved system benefits. No rewards are foreseen for capacity increases which exceed the target capacity values set out by ARERA.
For each boundary, the maximum reward (which is granted to Terna when the target capacity is reached) is defined as a combination of a percentage of congestion revenues and of a percentage of the benefit related to the increase in Socio-Economic Welfare at that boundary. The choice of these parameters aims at providing more rewards for capacity increases at the boundaries where the congestion revenues and the expected benefits are higher.
If the increase in the transmission capacity does not reach the target capacity, the reward is granted as a part of the maximum reward proportionally to the ratio between the capacity increase and the difference between the target capacity and the previously available capacity.
Later, ARERA also requested the preparation of three editions of the Target Capacity Report (2020, 2022/2023, and 2024) and their review by several independent experts, publicly available [23,24]: from the first version in 2018 [25], relevant improvements based on experts’ suggestions were introduced in the second [26] and in the third editions of the target capacity assessment methodology.
Meanwhile, at European level, from 2018 onwards, ENTSO-E progressively implemented the same concept in the biennial editions of the “Identification of System Needs” report.
Since 2022, the concept of target capacity (under a new term “infrastructure gaps”) became an element of European legislation: Article 13 of Regulation (EU) 869/2022 requires ENTSO-E to perform an identification of infrastructure gaps every two years. In addition, Article 14 of the same regulation requires a specific “target capacity” exercise for offshore networks [27].
In the rest of this paper, the target capacity can be interpreted as the cost-effective target value (MW) for the transfer capacity development across internal market sections/external borders.

1.2. Aim and Contribution

The aim of this paper is to present a novel iterative methodology for the identification of target capacities and its application to the Italian power system across internal market sections and external borders. To assess the cost-effective additional transmission capacity, both market simulations based on zonal models and network simulations based on detailed network topology have been performed so as to include in the analysis economic considerations (e.g., market design, regulation, generation costs, and power units bidding strategy) and technical network aspects (e.g., power flow distribution, losses, network topology, and reliability aspects).
The analyses have been carried out in two relevant planning contrasting scenarios for the long-term 2030 and very-long-term 2040 horizons, i.e., the policy scenario “Fit for 55” in 2030 (“FF55 2030”) and “Distributed Energy” in 2040 (“DE 2040”) and the technology-driven scenario “Late Transition” in 2030 and 2040 (“LT 2030”, “LT 2040”) [28], with the aim to consider the uncertainty affecting the provisional demand, generation, and energy storage capacity trends and commodity prices in a long-term view.
The novel contributions of this paper are as follows:
(1)
The formulation of a new heuristic methodology for assessing the cost-effective additional transmission capacity, adopting a multi-criteria analysis solved by the means of “Technique for Order Performance by Similarity to Ideal Solution” (“TOPSIS”) [29,30,31,32] to select transmission capacity increases to be implemented in each iteration of the process;
(2)
The identification of different development strategies (one for each considered scenario) based on an iterative process adopting market and network simulators able to include several relevant planning aspects and benefit categories;
(3)
The definition of marginal investment cost and benefit curves of new transmission capacity for each section/border in each considered planning scenario;
(4)
The representation and discussion of the results obtained from a real case study application and the output stability when considering relevant input variations in specific sensitivity analysis.

1.3. Paper Organization

The rest of this paper is organized as follows: Section 2 reports a literature review, while Section 3 presents the formulation of the developed methodology. The simulation tools are described in Section 4. Section 5 illustrates the results obtained for the Italian power system case study for both the 2030 and 2040 horizons, together with sensitivity analysis outputs. Lastly, Section 6 provides the main conclusions.

2. Literature Review

The purpose of the target capacity assessment methodology is to identify the additional cost-effective transfer capacity between internal bidding zones and at external borders of the Italian power system. The purpose of the activity is twofold: first, to facilitate the development of an efficient and economical transmission system, by supporting the decisions on new projects in the Ten Year National Development Plan (“NDP”) and, second, to support the definition of the output-based regulatory scheme rewarding the increases in transmission capacities.
It is worth highlighting that the proposed methodology does not replace the cost–benefit analysis associated with planned projects included in the NDP, neither is it aimed at verifying the individual planned projects’ usefulness. It instead provides the cost-effective level of interconnection within the national transmission system and to other external borders so to give indications where it is expected to be more beneficial to locate new transmission projects. The methodology aims at addressing the complexity of multiple capacity increases at several boundaries and at exploring an optimal development of the entire transmission system under study. Such a dimension is hardly addressed by the traditional cost–benefit analysis of individual projects, which has the purpose of confirming the features of pre-identified candidate projects and of quantifying their societal added value, while it cannot provide a holistic view about project interdependencies across the whole system.
As the target capacity across a market section/border is defined as the “cost-effective transfer capacity”, the present methodology is based on the definition of a marginal cost curve at each boundary and on an iterative process defining the marginal benefit of the new capacity addition for each section/border in each relevant planning scenario.
In the literature, several mathematical optimization, heuristic, and meta-heuristic methods [33] have been proposed to solve the transmission expansion problem and identify robust development strategies in an uncertain environment. A complete literature review on transmission expansion models is presented in [34].
The first category (mathematical optimization) includes all approaches formulizing the transmission planning as an optimization problem: once the objective function is defined, it is subjected to all relevant technical and economic constraints manageable by the algorithm. The solution is obtained by means of different techniques, such as linear programming [35,36], non-linear programming, mixed-integer linear programming (“MILP”) [5,37], and mixed-integer non-linear programming (“MINLP”) [7]. The practical limitations of the use of the optimization methods are the substantial computational efforts and the need for simplifications reducing the quantity of transmission expansion problem aspects under consideration. In fact, the mathematical formulation of multiple conflicting planning objectives made the application of rigorous optimization methods to large power systems very difficult: most of the proposed approaches are then applied to the Garver 6-bus system, IEEE 14-bus system, IEEE 24-bus systems, or larger systems under perfect competition assumptions.
According to [34], the heuristic methods proceed “step-by-step, generating, evaluating and selecting expansion options” with or without direct user actions. Some works based on heuristic methods are [38], describing a transmission expansion tool based on the “least effort” criterion, ref. [39] presenting a transmission expansion model based on the decomposition in different investment and operation subproblems, and ref. [40] proposing a branch and bound technique to solve the investment sub-problem.
A further classification of transmission expansion planning methods can be based on different relevant aspects included in [41]. The two network probabilistic reliability criteria, Lack Of Load Expectation (LOLE) and Expected Energy Not Supplied (EENS), are considered in [42,43], and the maintenance impacts on transmission expansion costs and reliability are included in [44]. The maximization of producers’ surplus, consumers’ surplus, and transmission operator profit is modeled in [38]. The investment cost is included in methods proposed in [10,45], while a formulation considering bidding strategy estimation from historical data and fuel costs is presented in [7]. The environmental constraints related to CO2 emissions are addressed in [46] together with network security aspects.
With the aim of developing a methodology able to find feasible solutions to the target capacity assessment regulator request, obtaining reasonable computational times while taking into account all relevant information about the main characteristics of the whole interconnected European power market and the detailed national grid topology for transmission (400–230 kV) and sub-transmission (150–132 kV) voltage levels, Terna adopted a heuristic approach. Standard development options are early assessed in terms of investment costs and transfer capacity increase size and then tested in each suitable section/border to define the related benefits. A multi-criteria decision-making (MCDM) problem is applied to rank the alternatives and reduce the computational effort: the congestion hours, the average values of hourly price spreads, the investment cost, and the project progress indicators are used to select the market sections/borders where transmission capacity increases might be profitable, in order to have shortened running time requirements. This kind of approach allows us to fix robust sub-optimal development strategies in a multi-scenario analysis, exploring a large research solution space under the constraints derived from empirical evidence. Three different custom-written tools enclosing the specific characteristics and inherent complexity of the Italian power system in the restructured competitive environment are adopted: demand hourly profiles, reliability and security costs, maintenance constraints, multiple contingencies, ohmic losses, hydrological scenarios, and bidding strategies are all aspects considered in the Day-Ahead zonal Market, Ancillary Services zonal Market, and Grid Reliability and Adequacy nodal network simulators in our analysis [47,48,49]. The investment costs are included based on the most recent information about already planned projects and reference values available in the literature.
The developed approach represents a relevant novelty in planning methods adopted by the other European TSOs. In fact, the yearly “Network Option Assessment Report” (“NOA”) carried out by the Great British System Operator “National Grid” [50] aims at recommending in which development projects proposed by the Transmission Owners (“TOs”) there should be investment during the coming year, performing a market analysis consistent with the significant energy scenarios and the system requirements identified in the “Electricity Ten Years Statement” [51] and providing a prioritization of the candidate options. The “Power System Needs 2030 and 2040 Report” [52] of ENTSO-E is a partial exercise detecting the one cross-border cost-efficient capacity-specific dimension of the European power system. Moreover, this latter analysis is performed in one energy scenario, and only the Socio-Economic Welfare benefit is evaluated (“SEW-based” needs). However, both the mentioned practices adopt only the market simulations performed through a single tool.
The iterative methodology developed by Terna detects the cost-efficient target capacity for each internal section and external border of the Italian power system in a multi-scenario and multi-year analysis including network topology details, evaluating several benefits and exploring new solutions able to increase the interconnection levels besides the transmission capacity provided by the already planned projects, avoiding the risk of profitable investment underestimation.
Terna developed the methodology for the target capacity assessment consistently with regulator directives and academic experts’ reviews and launched its consultation: relevant stakeholders’ feedback supported improving the methodology before its application.

3. Target Capacity Assessment Methodology

3.1. Formulation

The present methodology provides the cost-effective target capacity for each scenario under study and in each considered time horizon; the least regret technique [51,53,54] is then applied to define the unique recommended development strategy for a reference time horizon.
The initial network (or “base case”) is made up of the existing grid and the projects that have a strong chance of being implemented by the date of the considered scenarios.
The benefits related to these projects are initially evaluated using the “Take Out One at the Time” (TOOT) method [52], in compliance with the cost–benefit analysis performed in the European context.
Starting from the base case, an iterative approach is adopted. All sections/borders of the power system under study are investigated as development alternatives by the means of the TOPSIS method considering the following decision criteria:
  • Criterion 1 ( C 1 ), equal to the number of congestion hours across the k-th section/border H k [h]:
    C 1 = H k
  • Criterion 2 ( C 2 ), equal to the k-th section/border average of absolute market energy hourly price spread in the i-th iteration and in the s-th scenario, p i , k s [EUR/MWh]:
    C 2 = 1 8760 r = 1 8760 p i , k s = p i , k s ¯
  • Criterion 3 ( C 3 ), equal to the marginal investment cost on the i-th transmission capacity unitary increase on the k-th section/border M C i , k [MEUR/MW];
  • Criterion 4 ( C 4 ), equal to the “project progress” of the specific network development project considered as a reference for the k-th section/border marginal investment cost in the i-th iteration.
C 1 and C 2 result from market simulation performed at the beginning of each i-th iteration, while C 3 , C 4 , and criteria weight values are input data defined by the Decision Maker (DM).
The multi-criteria analysis allows us to assess the alternative performances with respect to all considered criteria in each iteration: a section/border is considered suitable for additional transfer capacity if its performance index P i + triggers the respective reference threshold, separately defined for external borders ( L E X T ) and for internal sections and ( L I T ):
P i + L E X T P i + L I T
Once the threshold is triggered on one (or more) section/border, additional transmission capacity is implemented using the “Put IN one at the Time” (PINT) method [55]: the new transfer capacity A C i , k is put on the k-th section/border of the reference grid in the i-th iteration and the associated marginal benefit M B i , k evaluated. If the “cost-effectiveness condition” is respected, the following is true:
M B i , k M C i , k > 1
The additional transfer capacity usefulness is confirmed on the reference grid in the i + 1-th iteration, and a point on the individual section/border marginal cost–benefit curve is depicted.
The iterative process stops when no section/border presents favorable conditions to new transmission capacity increases which means that P i + thresholds are not triggered or, if they are, Condition (4) is not satisfied.
Finally, at each section/border, the marginal cost and benefit curve is enriched with values related to the last iteration. An explicative example of the k-th section/border marginal cost and benefit curves resulting from the iterative process for two different scenarios and two different time horizons is illustrated in Figure 1: the target capacity is defined around the intersection of the decreasing marginal benefit and the increasing marginal cost curves, highlighted by the marked green and blue areas for Scenario A and B, respectively. The iteration to identify the development strategy in the second year horizon starts from the last PINT tested in the first ones.
The cost-effective transmission capacity increase for the k-th section/border in the s-th scenario, χ k s , is defined around the intersection of the marginal cost and benefit curves, as expressed in (5):
χ k s = i = 1 N + A C i , k s + A C l , k s · M B l , k s M C l , k s
where the following terms are used:
  • N + represents the number of iterations for which Condition (4) is satisfied for the i-th transmission capacity increase on the k-th section/border in the s-th scenario A C i , k s ;
  • A C l , k s is the last transmission capacity increase on the k-th section/border, corresponding to the last iteration in the s-th scenario;
  • M B l , k s M C l , k s represents the ratio between the marginal benefit and the marginal cost related to the last transmission capacity increase A C l , k s on the k-th section/border in the s-th scenario (i.e., the capacity increase with benefits below costs).
The target capacity is then defined as follows:
T C k s = E C k + χ k s
where E C k is the existing transmission capacity in the k-th section/border.

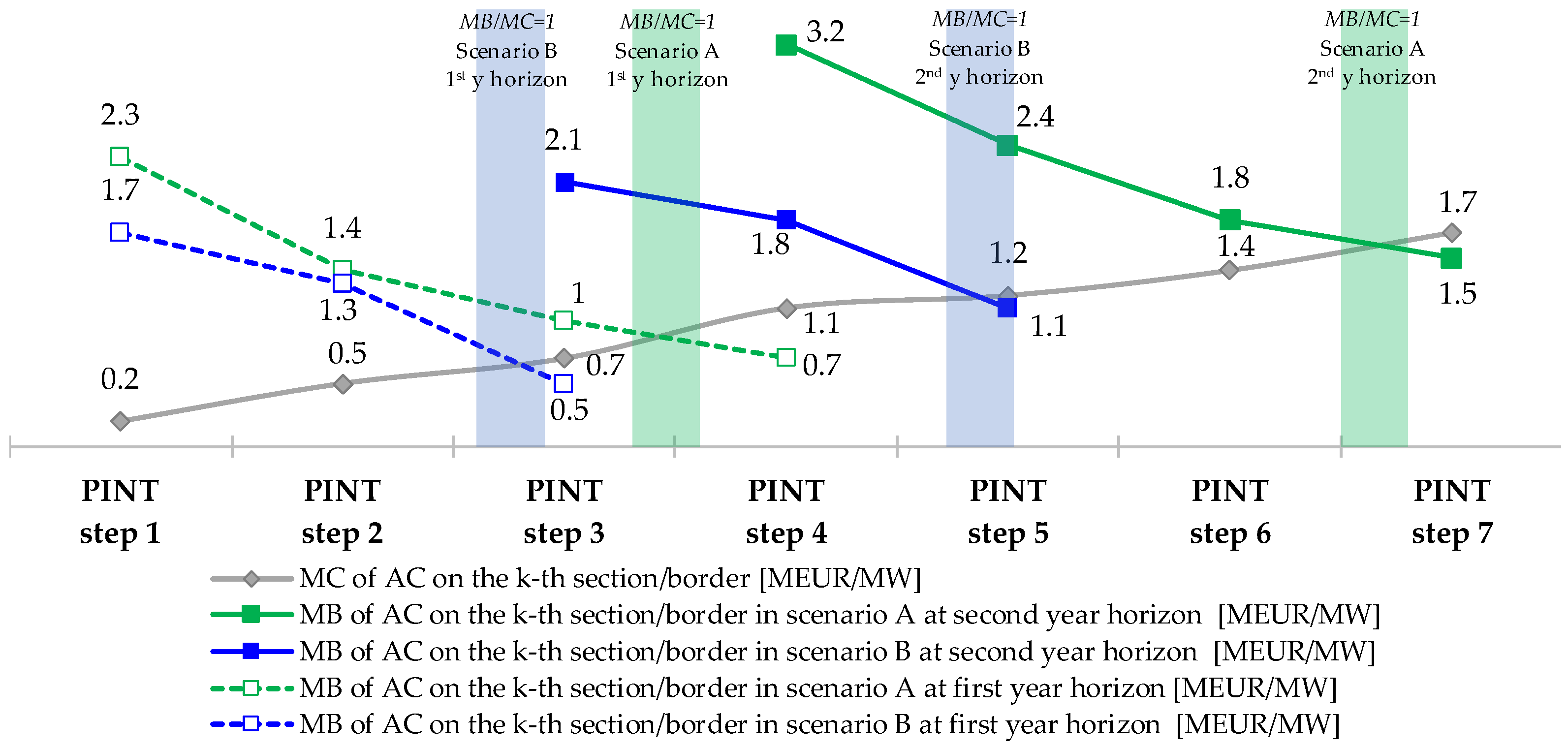

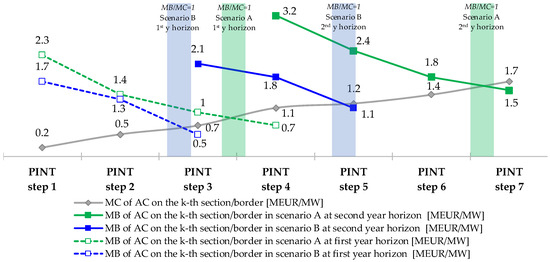

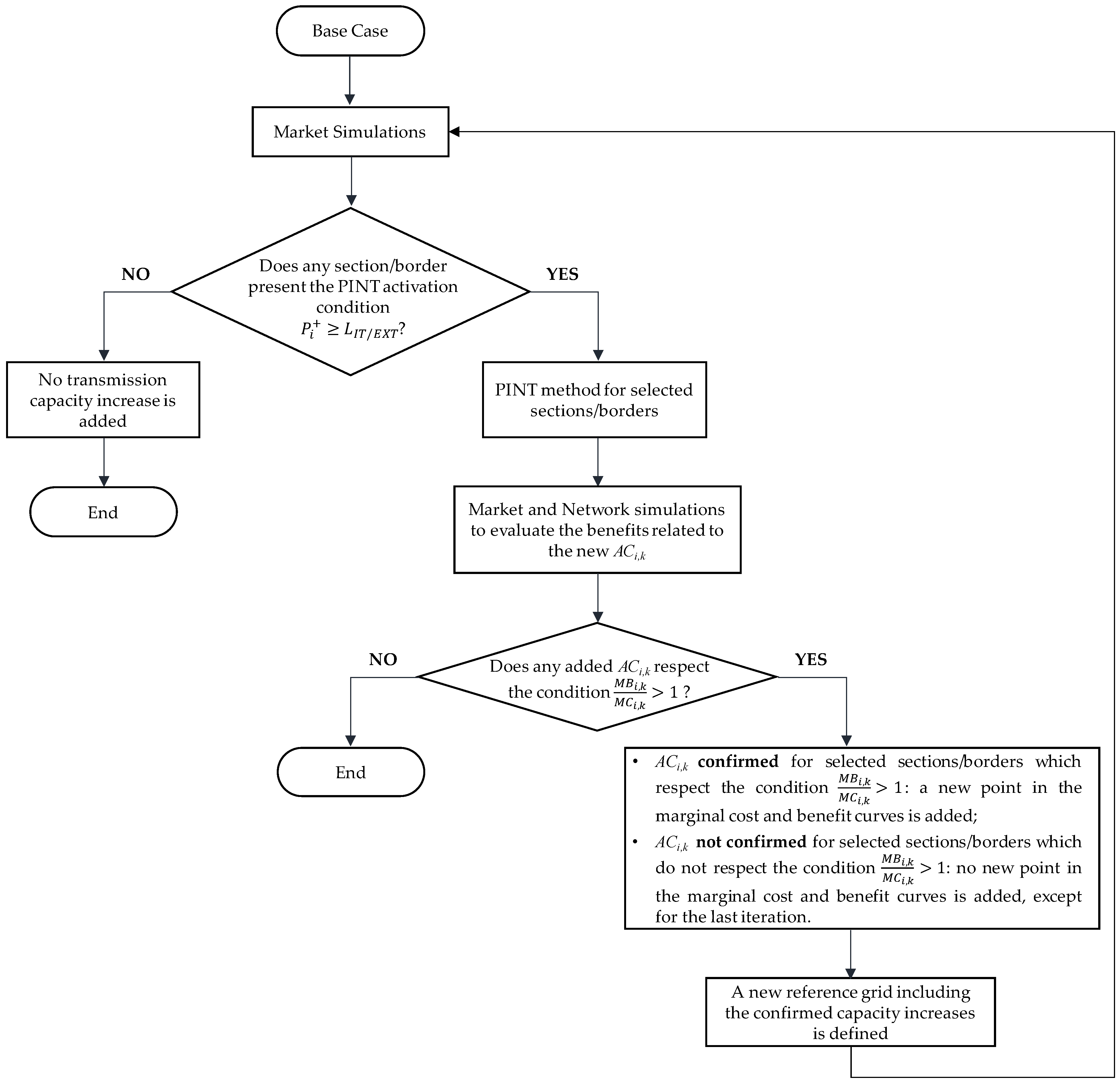

The workflow of the entire iterative process is depicted in Figure 2.

3.2. Marginal Cost Evaluation

First of all, the evaluation of the marginal cost at each section/border considers the unitary investment costs of already planned projects (included in the NDP). The order in which they are considered depends on the project progress.
If the target capacity needed on the k-th section/border exceeds those provided by the planned projects, further reference marginal costs must be assumed. It is clear that, in this case, the cost estimation is subject to significant uncertainty without supporting information on the details of the project realization. The report [56] provides useful reference values for relevant electricity infrastructures (overhead transmission lines, underground and subsea cables, onshore AC substations, and HVDC converters): the information is based on historical data collected under the TSOs and other developer experiences in electricity infrastructure realization.
In the Italian context, Terna developed a new methodology for the assessment of standard investment costs [57], approved by the regulator in 2017.
With particular reference to the unit investment costs of development projects affecting external borders, it is assumed that Italy covers half of the total cost, in the absence of any other information.
Since the capacity increases are fixed while the transmission capacity increases provided by the projects are case-specific, they can contribute in a different manner to the final target capacity in the subsequent iterations. Given i , the set of all the ω-th projects (planned or not) to be considered on the k-th section/border in the i-th iteration, the following different cases could occur:
  • If the Total Transfer Capacity (TTC) provided by the ω-th project is equal to the additional capacity needed, i.e., T T C ω , k = A C i , k , its unit investment cost C ω , k (MEUR/MW) matches the marginal cost M C i , k of the additional transfer capacity A C i , k :
    M C i , k = C ω , k = C t o t , ω T T C ω , k
  • If the additional capacity step is provided by two (or more) projects, the marginal investment cost of that capacity increase is the weighted average of the unit investment costs of the considered projects.
The weighting factor of the ω-th project in the set i compared to the needed i-th additional transmission capacity increase on the k-th section/border can be expressed as follows:
x ω , i , k = m a x 1 ; T T C ω , k t = 1 i 1 T T C t , ω , k A C i , k
All the ω-th projects on the k-th section/border contribute to the marginal cost curve definition in an orderly manner as a function of increasing unit investment cost. Once a specific project transmission capacity increase is fully considered up to the i-th iteration, i.e., T T C ω , k = t = 1 i T T C t , ω , k , it is no longer used in the following iterations.
The marginal cost expression can be generalized as follows:
M C i , k = ω Ω i x ω , i , k · C ω , k   w h e r e   ω i x ω , i , k = 1

3.3. Marginal Benefit Evaluation

The benefit categories included in the target capacity assessment and the respective simulators adopted are listed in Table 1.
The marginal benefit values need to be discounted to the present year, in order to allow the comparison with the expected unitary investment costs. The i-th transmission capacity unitary increase on the k-th section/border marginal benefit is defined as follows:
M B i , k = λ B t o t   i , k A C i , k
where the following terms are used:
  • B t o t   i , k is the yearly benefit calculated at the i-th iteration, including all the considered benefit categories;
  • λ is the discount factor defined setting the discount rate r at 4% (real), as provided in [55,59,60] and as expressed in (11).
    λ = τ = 1 25 1 ( 1 + r ) τ

3.4. Least Regret Approach

The developed iterative methodology results in the identification of n development strategies (or “options”), one for each scenario under study: the least regret approach is employed to define the unique set of cost-effective target capacities to aim for. In fact, it allows us to determine the best option as the one that leads to the lowest regret for the DM.
In this context, since the main objective is maximizing the benefit to the system, the net benefit (difference between total benefit and investment costs) is considered as the most significant indicator.
The regret related to the n-th development strategy in the s-th scenario, r e g r e t n s , can be expressed as follows:
r e g r e t n s = N B r e f s N B n s
where the following terms are used:
  • N B n s represents the net benefit of the n-th option in the s-th scenario;
  • N B r e f s represents the net benefit of the reference option, i.e., the development strategy that presents the highest net benefit in the s-th scenario.

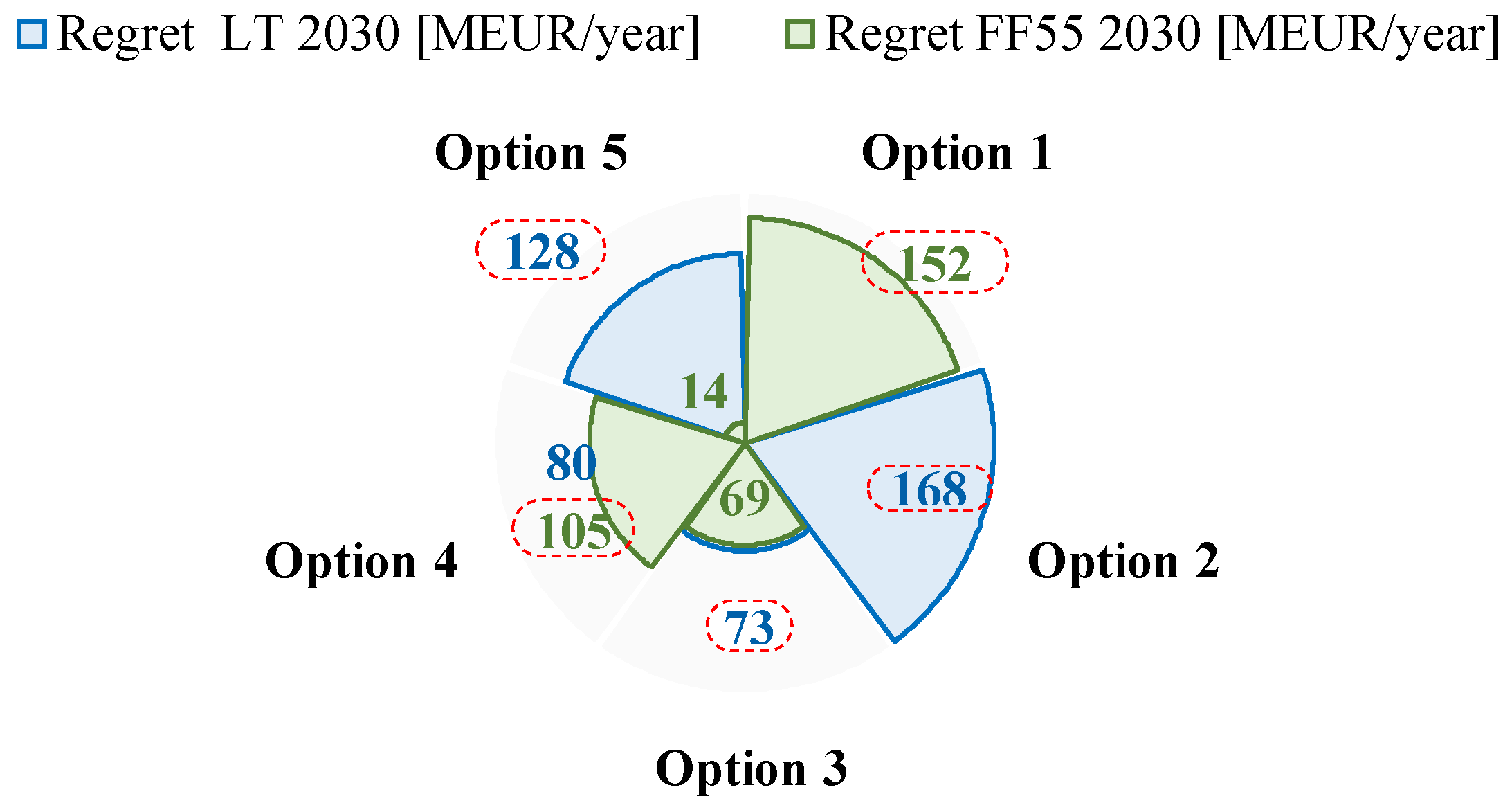

Selecting the development strategy with the lowest maximum regret exposes the entire system to the least amount of risk. Therefore, the set of final values of target capacity respects the min-max criterion:

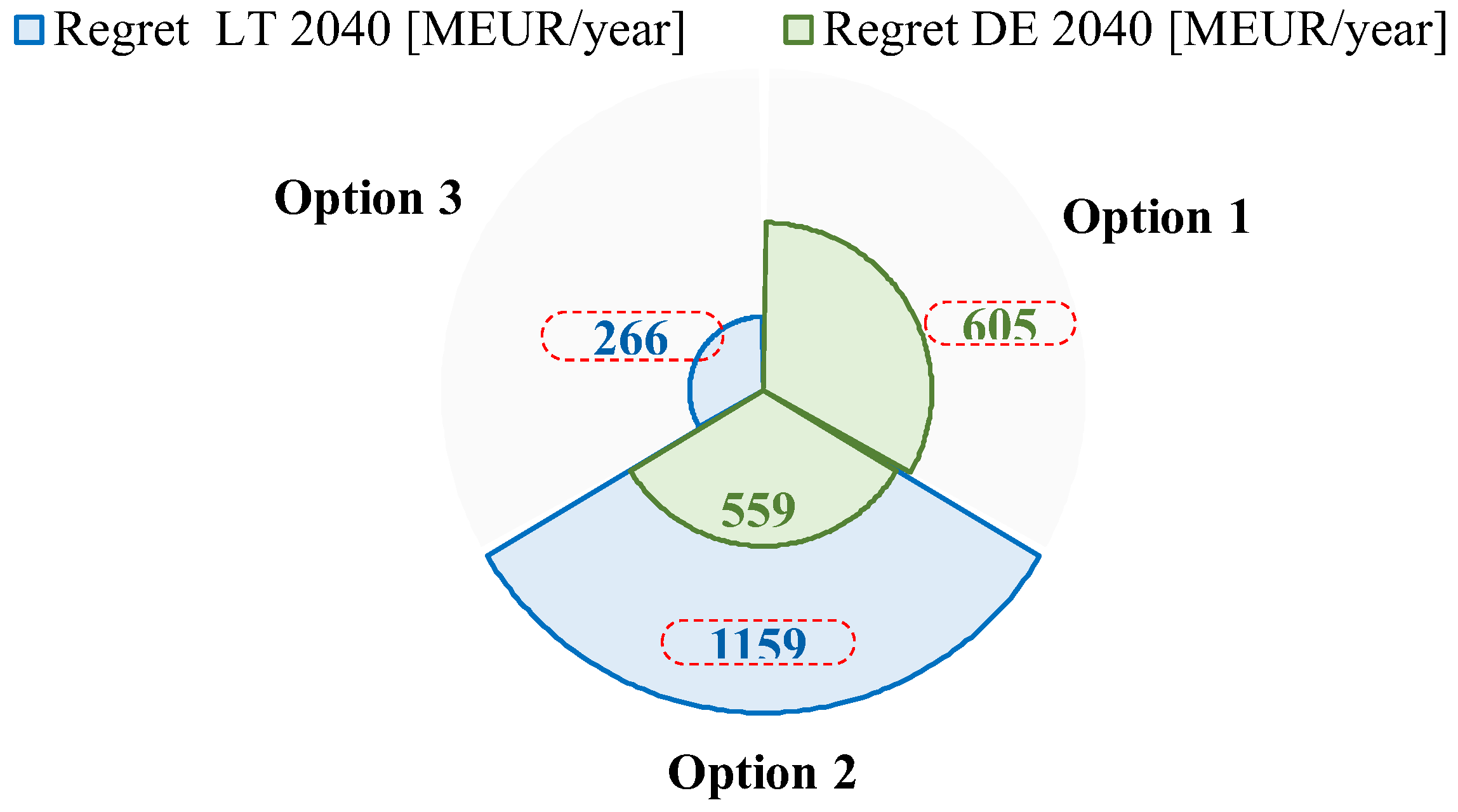

min s max n   r e g r e t n s

4. Simulation Tools

4.1. Day-Ahead and Ancillary Service Zonal Market Simulators

The electricity market simulations allow for the assessment of a first set of benefits (B1, B18, B19, B8), leaving the evaluation of the remaining benefits (B3, B5, B7) to the network analysis. To this aim, both Day-Ahead spot Market (DAM) and Ancillary Services Market (ASM) studies were sequentially performed, coherently with the sequential order of the real Italian power market sessions.
For DAM simulation studies, the full model of the European electric grid adopted by ENTSO-E for the TYNDP was used. This model represents the European bidding zones using a single branch to characterize the equivalent transmission capacity between interconnected market zones. The model considers a single node for each country, with the exception of Denmark, France, Greece, Italy, Luxembourg, Norway, Sweden, and the United Kingdom.
The DAM studies were performed through the market simulator “Promed Grid”, representing one of the standard tools at ENTSO-E level. Starting from a yearly scenario dataset, hourly profiles of renewable generation and load consumption are stochastically obtained by exploiting typical meteorological years and statistical demand trends. On this basis, the tool carries out an optimal coordinated hydro-thermal planning of the generation portfolio with an hourly time discretization over one year, implementing the day-ahead hourly energy market, characterized by a system marginal price and by congestion management determined through a zonal market-splitting procedure [47].
The Promed Grid is based on a deterministic model that considers both the economic and technical aspects of the power systems: the simplified market model, the hourly load, thermal generation fleet technical data, costs and constraints associated with different fuel types, thermal unit production constraints, and technical data of the hydro-generation set.
The simulator determines each generating unit hourly output and the flows in the equivalent links between the different bidding zones. It also calculates further indicators pertaining to the environmental impact associated with each market solution, such as the corresponding emissions (CO2, NOX, SOX) and dust emissions.
The DAM simulation is carried out in two different computational phases:
  • Unit commitment: according to a merit order and considering the system constraints, the on/off state of each thermal power unit is determined;
  • Dispatching: the coordinated hydro-thermal hourly production scheduling is defined in compliance with system constraints.
The final market solution results from an iterative converging process aimed at a bidding strategy recovering at least each generation unit’s variable costs, revised after each iteration loop. In each loop, the optimal operation generation schedule of the generating system is obtained solving a very large quadratic programming optimization problem. The objective function consists in the total variable generation costs minimization while respecting all the technical constraints.
The Ancillary Services Market (ASM) studies have been carried out by the means of the simulation tool “Modis” [48], a multi-area market simulator, specifically tailored to the Italian ASM, performing the yearly simulation of the ASM based on a pay-as-bid mechanism. It simulates ASM procurement actions for different services, such as secondary and tertiary reserve margins and real-time balancing, with hourly discretization for a whole year.
Starting from the preliminary schedules of generating units resulting from the DAM simulation, Modis emulates the ASM behavior modifying the generating schedules in order to ensure the appropriate reserve margins in each bidding zone and offsetting the gaps between demand and supply, consequent to simulated unbalances. For this reason, the deterministic model implemented in Modis belongs to the class of “security constrained differential unit commitment problems”, where upward and downward regulation of the controllable variables is conducted starting from an initial status inherited from the DAM solution. The objective function is the minimum rescheduling cost based on the bidding model included in the simulation tool.

4.2. Grid Reliability and Adequacy Simulator

The remaining set of benefits (B3, B5, B7) is assessed through network studies based on a Grid Reliability and Adequacy simulation model, using the Grid Reliability and Adequacy Risk Evaluator (named “Grare”) [49].
A network model derived from the Italian transmission grid including all the voltage levels (380, 220, 150, and 132 kV) was used. In particular, the nodal network model consists of about 11,000 nodes, 10,000 lines, and 4000 transformers. In addition, the busbar model of the European countries was included, considering the national loads and the generation fleet of each zone in accordance with the TYNDP scenarios, neglecting the internal transmission grid and the related network losses.
The adopted network simulator is able to evaluate large power systems’ reliability level through a probabilistic approach: security, operational, and economic constraints are all processed in a non-sequential Monte Carlo simulation, managing multiple different stochastic variables (i.e., climate conditions, renewable sources generation profiles, network element failure rates, and maintenance constraints).
At the end of each simulation, the two main power systems reliability indicators are evaluated:
  • The Expected Energy Not Supplied, or “EENS”, (in MWh) is defined as the average value of the annual not supplied demand among the several years simulated;
  • The Loss of Load Expectation, or “LOLE”, (in h/y) is defined as the expected amount of hours per time period when the available generation capacity is not sufficient to cover the demand.
In each Monte Carlo extraction, the total residual load RL is computed as follows:
R L = L + R R E S I G
where the following terms are used:
  • L is the total demand of the system;
  • R represents the system reserve requirements;
  • RES indicates the renewable sources output (solar, wind, and hydro);
  • IG represents the imposed production (e.g., bioenergy and geothermal).
Maintenance, faults, and other power unit constraints (i.e., must-run) are also considered to define the available thermal set.
The system condition is simulated by using weekly sampling, and the initial thermal unit commitment is obtained by the means of a mixed integer method, taking into account the requirements in terms of operational reserve to be satisfied in each bidding zone.
The optimal power unit dispatching is then evaluated by solving a linear problem according to the obtained cross-zonal exchanges, and possible load-shedding events resulting from available generation and import capacity inadequate to meet the demand are identified.
In the output from the simulation, the power production of each power unit and energy source, EENS and LOLE indicators, and power flows are provided. This procedure is replicated and parallelized for all weeks, and the results are weighted on the total test number.

5. Case Study and Results

The proposed methodology was built for real-world applications. The Italian power system case study in two contrasting energy scenarios and in two different year horizons is presented in this section.

5.1. Data and Scenarios

Given the academic independent experts’ indications and the system needs study approach adopted at the European level in the latest TYNDP [52], the target capacity assessment was performed for both long-term 2030 and very-long-term 2040 horizons in the same relevant planning scenarios adopted in the 2023 NDP cost–benefit analyses [61] and deeply described in [28], in particular the following:
  • The policy scenarios “Fit for 55” in 2030 (“FF55 2030”) and “Distributed Energy” in 2040 (“DE 2040”) in line with CO2 emissions reduction and share of renewables in the total electricity demand in Italy, requiring approximately +70 GW by 2030 and +120 GW by 2040 of new RES capacity;
  • The technology-driven scenarios “Late Transition” in 2030 and 2040 (“LT 2030” and “LT 2040”) mostly aligned with the less challenging objectives of the previous National Energy and Climate Plan (NECP).

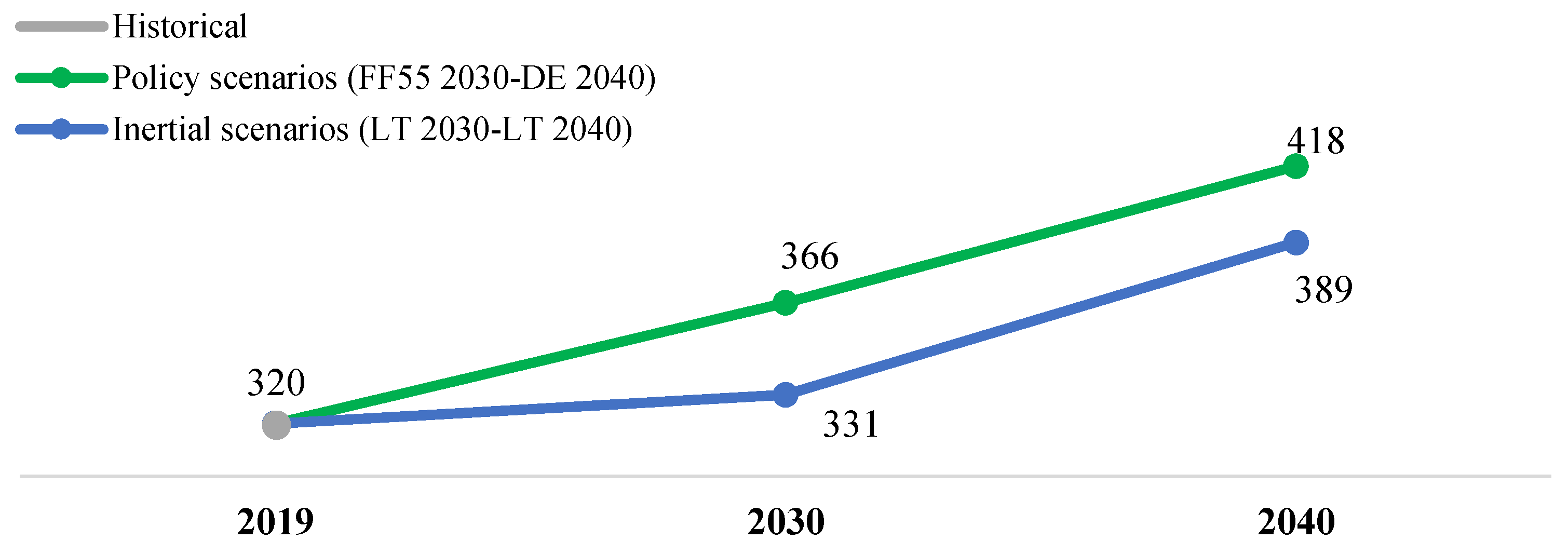

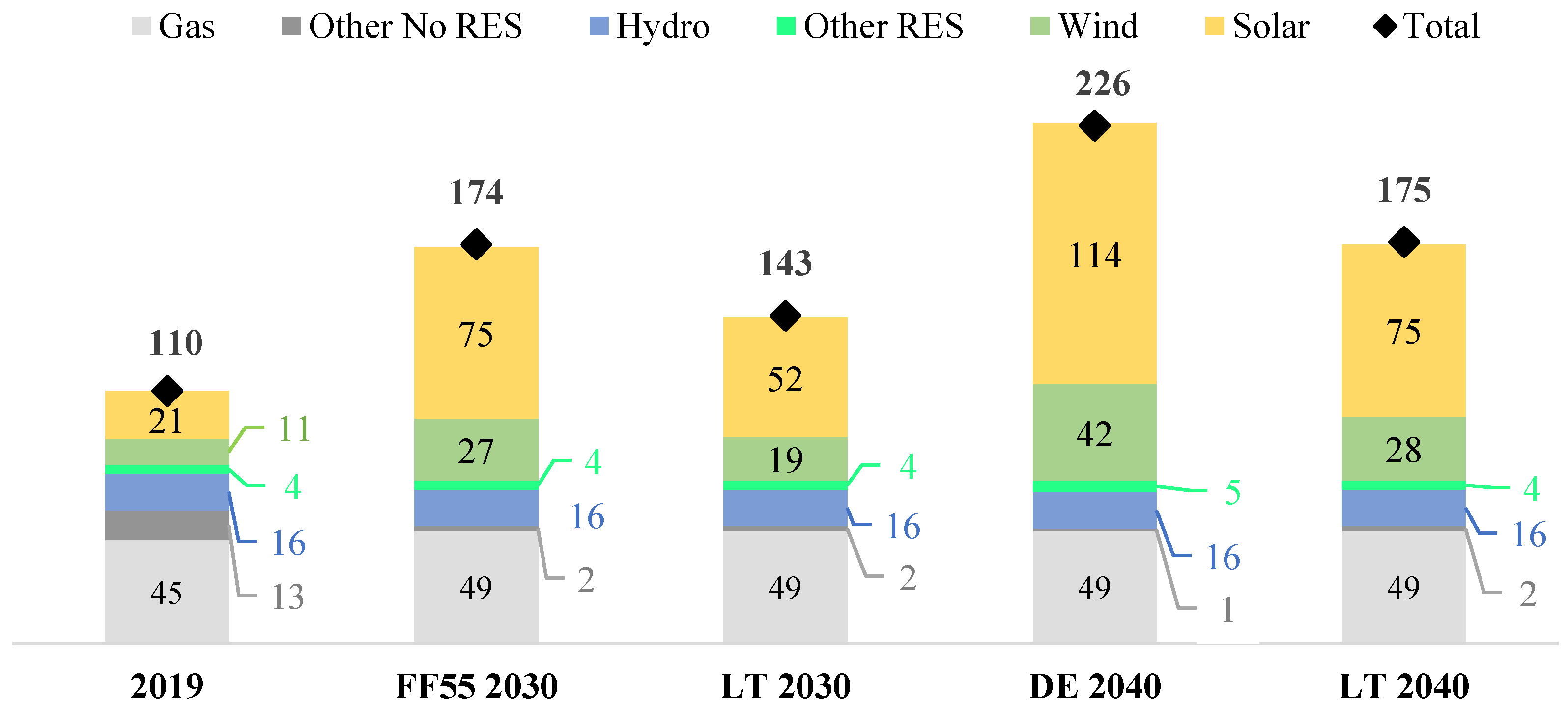

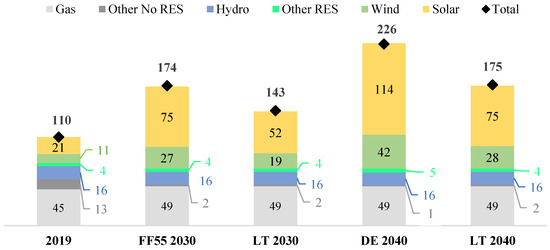

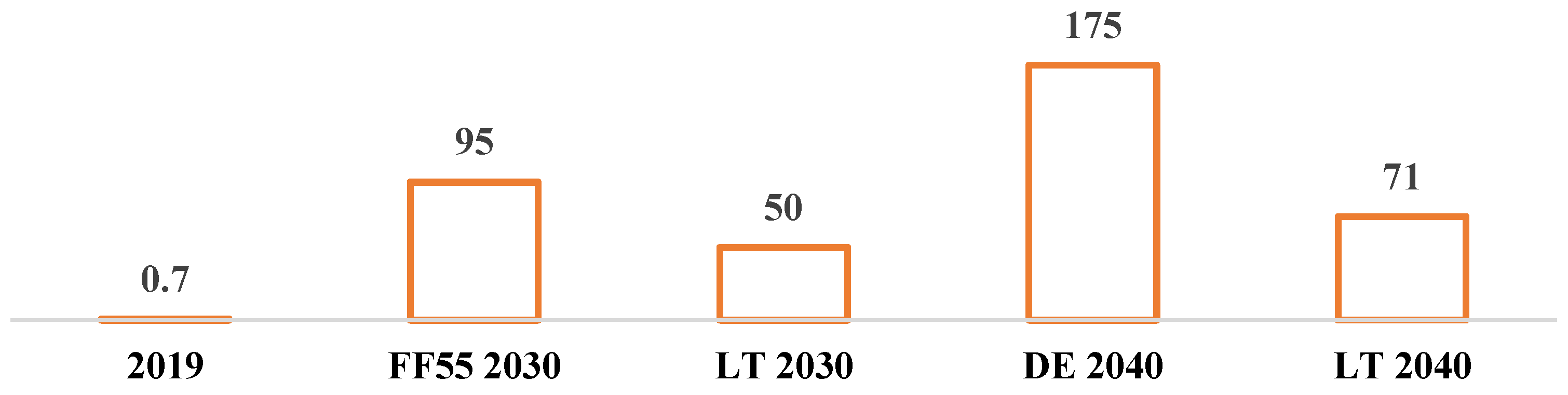

Figure 3, Figure 4 and Figure 5 depict the Italian electrical demand trend and the generation and storage capacity evolution in comparison with the final values for the year 2019. As can be seen, the policy scenarios are characterized by a significant increase in electricity demand and installed RES generation. Such challenging scenarios also require significant new storage capacity.
The market structure adopted in the target capacity assessment is depicted in Figure 6: the Italian power system is divided into seven different market zones (North, Center North, Center South, South, Calabria, Sardinia, and Sicily). This structure naturally leads to the individualization of the internal market sections, as represented in the same Figure.

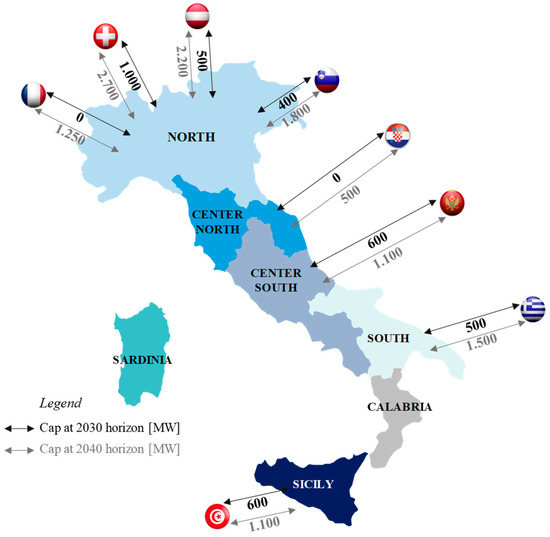

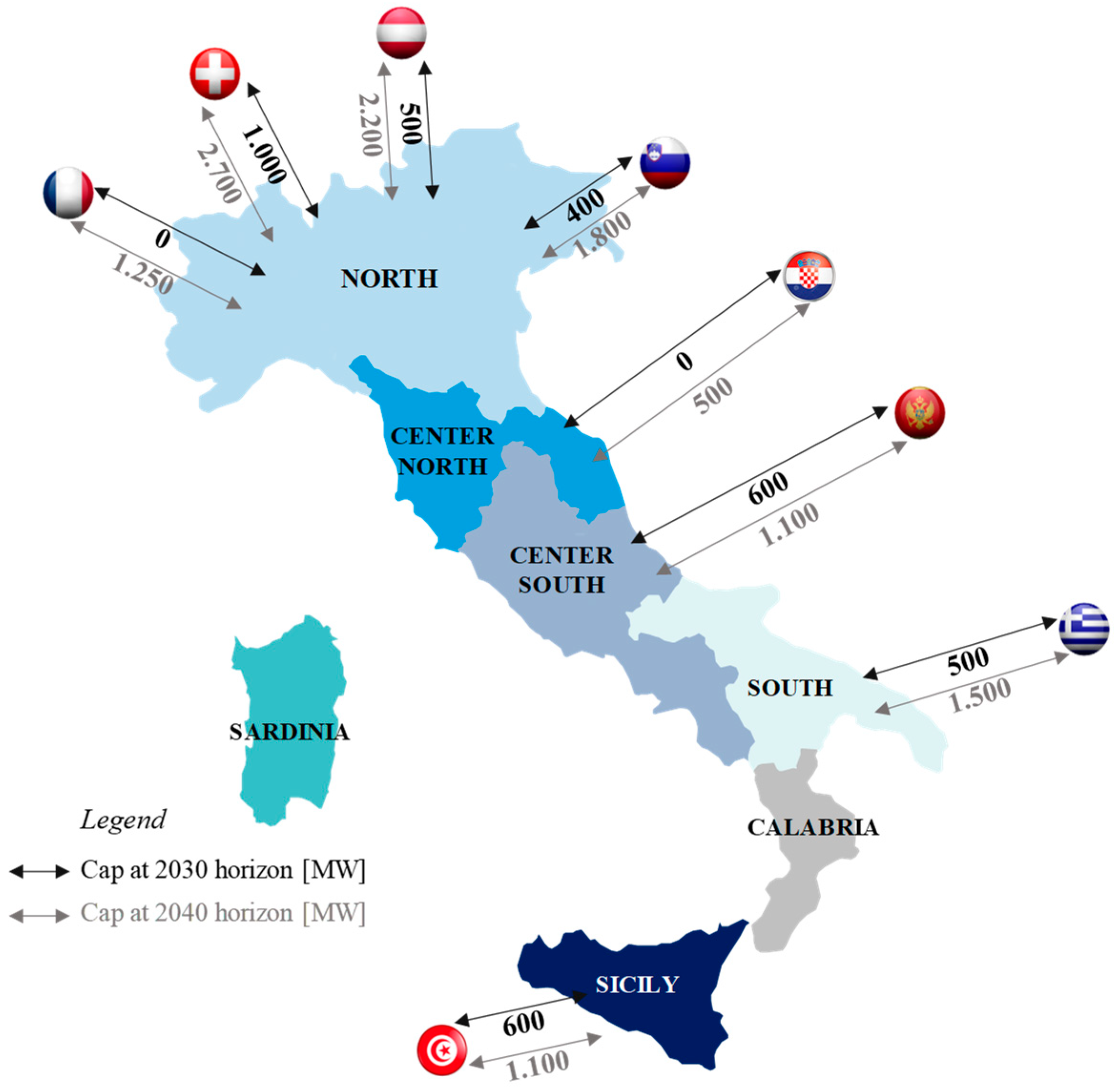

As regards the external boundaries, although the analysis was carried out considering the individual borders, these have been merged in assessing the global potential in terms of transmission capacity increase, according to the following criteria:
  • The “Northern border” comprises the borders with France, Switzerland, Austria, and Slovenia. Since they are geographically and electrically connected, the transfer capacity is currently evaluated considering the mutual influence in N-1 operational conditions;
  • The “Balkan border” comprises the borders with Croatia, Montenegro, and Greece, for the same reasons listed above;
  • The “Northern Africa border” includes the border with Tunisia, the only North African third country involved in a planned project.
Depending on whether the transmission capacity increase involves an internal section or an external border, different sizes for the ACi,k were defined, as follows:
ACi,k = +400 MW if k is an internal section
ACi,k = +500 MW if k is an external border
These values reflect the common sizes of most of the planned or yet in service projects. Then, these sizes were aligned considering +500 MW for both internal sections and external borders for the 2040 horizon due to the higher degree of uncertainty concerning the very long term.
An important novelty introduced in the last edition of the target capacity assessment, approved during the public consultation, is the constraint on the maximum additional capacity that can be reached at external borders: for the 2030 horizon, the constraint has been set equal to the sum of the transmission capacity provided by all planned projects (i.e., already included in the NDP) across each border. For the 2040 horizon, the constraint has been set equal to the 2030 constraint properly increased to take into account the potential new targetable developments in the following decade.
In view of the adopted scenarios characterized by relevant national RES penetration targets, this constraint (or “cap”) was introduced with the aim of prioritizing the use of renewable generation produced at national level. Furthermore, it allows us to integrate into the assessment a criterion of the real feasibility of projects, considering the timing and complexity related to the coordination with EU and non-EU TSOs in implementing interconnections. The maximum additional capacity at each border for the 2030 (black arrow) and 2040 (grey arrow) horizons is detailed in Figure 7. As expected, the maximum capacity allowed for 2030 is always lower than the one for 2040.
In the TOPSIS method application, the weighting factors of the four selected judgment criteria are the same ( w 1 = w 2 = w 3 = w 4 = 0.25). Concerning the C 4 (project progress), it is a coefficient from 1 to 4, depending on the status of the project defined as a reference in the specific iteration:
  • C 4 = 1 if the project cost is defined based on standard costs;
  • C 4 = 2 if the project cost refers to a planned project;
  • C 4 = 3 if the project cost refers to a designed project;
  • C 4 = 4 if the project cost refers to a project in authorization status.
The threshold values L E X T and L I T are equal to the median of the performance indexes, appropriately rounded to have reasonable total computing time, and are differently defined for the internal market sections and for the external borders, depending on criteria values assumed in each iteration.
Finally, the reference grid, or “base case”, consists of the existing grid plus the four projects already authorized and expected to be in service by 2025, as listed in Table 2.

5.2. Results

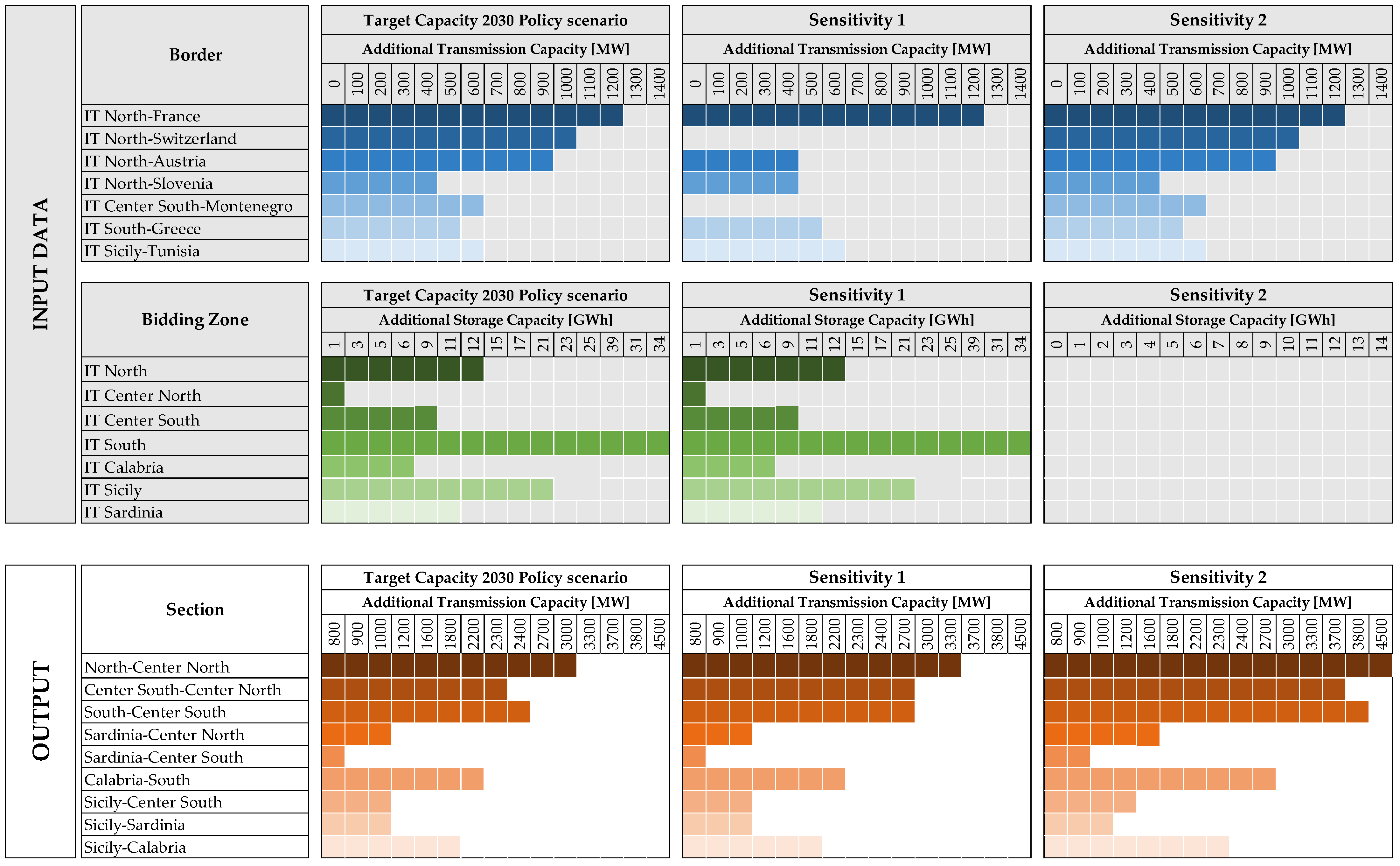

The cost-effective transmission capacity increases for each section/border of the Italian power system resulting from the application of the presented methodology for the 2030 horizon are provided in Figure 8 for each scenario under study.

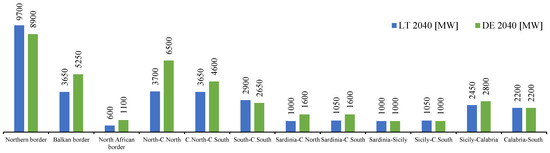

Given the cap on the maximum additional target capacity achievable at external borders according to the already planned interconnections for the 2030 horizon, the same development strategy was obtained for each border in both the contrasting scenarios simulated. Instead, a significant variation in the assessed transmission capacity increase can be observed where the analysis in the FF55 2030 scenario results in transmission capacity increases of, on average, +50% compared to those obtained in the LT 2030 scenario, basically due to the higher distributed renewable generation to be integrated and the higher load to be supplied. The highest differences were registered for IT North–IT Center North (+88%), IT Calabria–IT South (+83%), IT Center North–IT Center South, and IT Sicily–IT Calabria (+64%) and for IT Center South–IT South and IT Sardinia–IT Center South (+60%).
Let “Option 1” and “Option 2” be the set of transmission capacity increases resulting from the application of the proposed methodology in the FF55 2030 and in the LT 2030 scenarios, respectively, and considering three additional options defined as follows:
  • “Option 3”: set of transmission capacity increases defined as the average between the development strategies obtained in the FF55 2030 and in the LT 2030 scenarios for each border/section;
  • “Option 4”: set of transmission capacity increases defined as the average between the development strategies obtained in “Option 1” and in “Option 3” for each border/section;
  • “Option 5”: set of transmission capacity increases defined as the average between the development strategies obtained in “Option 3” and in “Option 2” for each border/section.
These options can be considered as different investment strategies to be compared with the aim of defining the most cost-efficient set of target capacity values as a reference for the TSO.
The net benefit metric (“NB”) is then used to compute the economic regrets associated with the different development strategies under the two considered scenarios, allowing the DM (TSO) to determine the maximum risk associated with each option across different scenarios and to select the one yielding the lowest maximum regret. The NB and consequent worst and least regrets related to each potential option in the two scenarios under study are evaluated in Table 3 and Table 4. Moreover, Figure 9 shows the magnitude of regret for each option in each scenario: the dashed red circle highlights the worst regret.
The least regret application leads to the choice of Option 3 as the investment strategy exposing the system to the minimum risk in both considered scenarios.
In order to check the robustness of the results obtained in the very-long-term horizon, accommodating main stakeholders’ and experts’ suggestions, the target capacity was also assessed for the year 2040. Figure 10 shows the cost-effective transmission capacity increases for each section/border of the Italian power system resulting from the application of the methodology in the DE 2040 and LT 2040 scenarios. Unlike the development strategies found for 2030, the results for 2040 show different values at the borders for the scenarios considered. In particular, the inertial scenario requires higher additional transmission capacity at the Northern border due to the increased import need (lower expected RES capacity installed at national level to cover the load compared with the policy scenario).
In compliance with the proposed methodology, the least regret approach was applied to identify the unique development strategy also for the 2040 horizon. The net benefits related to the following investment strategies were assessed:
  • “Option 1”: set of transmission capacity increases identified in the DE 2040 scenario;
  • “Option 2”: set of transmission capacity increases identified in the LT 2040 scenario;
  • “Option 3”: set of transmission capacity increases defined as the average between Option 1 and Option 2.
Looking at the results summarized in Table 5 and Table 6 and Figure 11, Option 3 turns out to be the best development strategy for the 2040 horizon.
Table 7 lists the final target capacity values [MW] to aim for regarding the 2030 and 2040 horizons, considering the existing “winter peak” transmission capacity, E C k , W P , in the main direction of power transfers statistically registered, consistent with the TSO objective to make the interconnection capacity available in an efficient way.
Finally, in Figure 12, the expected power flows resulting from the implementation of the identified additional target capacity on the base case in LT 2030 (Figure 12a), FF55 2030 (Figure 12b), LT 2040 (Figure 12c), and DE 2040 (Figure 12d) are shown. It can be observed that the power flows in the policy scenarios are more stressful in the South-to-North direction between internal market zones, due to the higher RES penetration expected.
The power exchanges across external borders are substantially aligned for the 2030 horizon in both contrasting scenarios because of the “cap” on achievable target capacity imposition; instead, for the 2040 horizon, more relevant import power flows from the Northern border are registered in the LT scenario, in front of the lower national RES generation simulated.

5.3. Sensitivity Analyses

Starting from the 2030 development strategies, described in Section 5.2, additional sensitivity analyses were performed for the policy scenario FF55 2030 to evaluate target capacity variance in the case of relevant input data variation:
  • Sensitivity 1 on cross-border additional transmission capacity: a constraint on feasible target capacity in 2030 has been enforced at each border of the Italian power system according to the status of already planned interconnection projects;
  • Sensitivity 2 on storage installed capacity: additional storage capacity of +95 GWh foreseen in service until 2030 within the policy scenario has been removed, and the analyses were repeated considering just the existing storage capacity.
The sensitivity results are illustrated in Figure 13: in the upper part of the graph (grey boxes), the input data simulated in each studied case are detailed, while at the bottom (white boxes), the outputs obtained continuing the iterative process from the development strategy originally derived are summarized. The identified additional transmission capacity on internal market sections is needed to cover, on one hand, the lower transmission capacity development on external borders (Sensitivity 1) and, on the other hand, the missing additional storage project concretization (Sensitivity 2). Looking at the results, an additional 1 GW of transmission capacity across internal sections is needed in the case of tight constraints on external borders and +6.2 GW as a result of storage capacity reduction: the greatest impact is registered in the North–C. North, C. North–C. South, and South–C. South market sections.
In addition, to further exploit the relevance of transmission and storage capacity synergic development as the most cost-efficient solution maximizing benefits for the entire system, different investment strategies were investigated and related impacts assessed by the means of the most significant indicators (i.e., “Total economic benefits”, “Socio-Economic Welfare” and “Overgeneration”). The cases under study are described in Figure 14, detailing the simulated grid and storage capacity, while the different strategies compared are represented in Figure 15, reporting also the indicators’ assessment.
Taking as a reference the incremental benefit obtained between Case B (optimal target capacity in the FF 55 scenario) compared to Case A (initial base case scenario) considering the simultaneous grid and storage capacity development, the benefit variations assessed in intermediate paths separately simulating the transmission network (from Case A to Case C) and the storage capacity (from Case A to Case D) evolutions are significantly lower. This evidence testifies to the importance of synergic and coordinated grid reinforcements and new storage installation combined solutions.
Finally, the investment option covering only the network development, leaving the storage capacity at current installed values, was investigated in the path from Case A to Case C until the transmission capacity values resulting from the target capacity assessment and from Case C to Case E including additional transmission capacity compensating for the absence of future storage systems: the benefit indicators appear significantly lower than the reference ones.
In conclusion, flexible energy storage systems are essential for achieving climate and energy objectives, and new methods are being developed to determine their optimal investment timing [62].

6. Conclusions

New methodologies capable of designing development strategies in an efficient manner are required to solve the transmission expansion problem in the framework of competitive electricity markets.
This paper presents a novel heuristic methodology developed by the Italian TSO for the assessment of cost-effective target capacity assessment, consistent with regulator directives and main stakeholders’ feedback collected during several consultation rounds. The expansion of each internal section and external boundary of the Italian power system is simultaneously studied on the basis of an iterative process in all relevant mid- and very-long-term planning scenarios in order to identify an optimal development strategy in each scenario. In addition, the least regret approach allows the identification of the reference development strategy for the transmission system.
The outputs of this work are relevant to the policy makers, regulatory authority, and market participants to assess and co-design the power system expansion and transition towards a renewable-generation-based one.
The first application of the methodology dates to the year 2018. After positive opinions expressed by the Italian regulator and independent academic reviewers, the methodology was upgraded and applied in two following editions of the target capacity report in 2020 and 2023. A new (fourth) edition is required by the end of 2024.

Author Contributions

Conceptualization, M.M., C.G., F.F. and R.V.; Methodology, M.M., C.G. and F.F.; Software, A.V. and C.P.; Validation, E.M.C. and R.V.; Investigation, A.V. and C.P.; Data Curation, A.V. and C.P.; Writing—Original Draft, M.M. and F.F.; Writing—Review and Editing, R.V.; Supervision, E.M.C. and C.G. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Data Availability Statement

The original contributions presented in the study are included in the article, further inquiries can be directed to the corresponding author.

Acknowledgments

The opinions expressed in this paper are the personal opinions of the authors; they do not necessarily represent ARERA’s official position and do not commit ARERA to any future action.

Conflicts of Interest

Authors Enrico Maria Carlini, Corrado Gadaleta, Michela Migliori, Francesca Ferretti were employed by the company Terna S.p.A. Authors Andrea Venturini and Cinzia Puglisi were employed by the company CESI S.p.A. The remaining authors declare that the research was conducted in the absence of any commercial or financial relationships that could be construed as a potential conflict of interest.

References

  1. Poncela, M.; Purvins, A.; Chondrogiannis, S. Pan-European Analysis on Power System Flexibility. Energies 2018, 11, 1765. [Google Scholar] [CrossRef]
  2. Iglinski, B.; Pietrzak, M.B.; Kielkowska, U.; Skrzatek, M.; Kumar, G.; Piechota, G. The assessment of renewable energy in Poland on the background of the world renewable energy sector. Energy 2022, 261, 19. [Google Scholar] [CrossRef]
  3. Iglinski, B.; Pietrzak, M.B.; Kielkowska, U.; Skrzatek, M.; Gajdos, A.; Zyadin, A.; Natarajan, K. How to Meet the Green Deal Objectives-Is It Possible to Obtain 100% RES at the Regional Level in the EU? Energies 2022, 15, 2296. [Google Scholar] [CrossRef]
  4. Iglinski, B.; Kielkowska, U.; Pietrzak, M.B.; Skrzatek, M.; Kumar, G.; Piechota, G. The regional energy transformation in the context of renewable energy sources potential. Renew. Energy 2023, 218, 15. [Google Scholar] [CrossRef]
  5. De la Torre, S.; Conejo, A.J.; Contreras, J. Transmission expansion planning in electricity markets. IEEE Trans. Power Syst. 2008, 23, 238–248. [Google Scholar] [CrossRef]
  6. Rosellón, J. Different approaches towards electricity transmission expansion. Rev. Netw. Econ. 2003, 2, 238–269. [Google Scholar] [CrossRef]
  7. Zhao, J.H.; Dong, Z.Y.; Lindsay, P.; Wong, K.P. Flexible transmission expansion planning with uncertainties in an electricity market. IEEE Trans. Power Syst. 2009, 24, 479–488. [Google Scholar] [CrossRef]
  8. Pesántez, G.; Guamán, W.; Córdova, J.; Torres, M.; Benalcazar, P. Reinforcement Learning for Efficient Power Systems Planning: A Review of Operational and Expansion Strategies. Energies 2024, 17, 2167. [Google Scholar] [CrossRef]
  9. Buygi, M.O.; Shanechi, H.M.; Balzer, G.; Shahidehpour, M.; Pariz, N. Network planning in unbundled power systems. IEEE Trans. Power Syst. 2006, 21, 1379–1387. [Google Scholar] [CrossRef]
  10. Buygi, M.O.; Balzer, G.; Shanechi, H.M.; Shahidehpour, M. Market-based transmission expansion planning. IEEE Trans. Power Syst. 2004, 19, 2060–2067. [Google Scholar] [CrossRef]
  11. Linares, P. Multiple criteria decision making and risk analysis as risk management tools for power systems planning. IEEE Trans. Power Syst. 2002, 17, 895–900. [Google Scholar] [CrossRef]
  12. Fang, R.; Hill, D.J. A new strategy for transmission expansion in competitive electricity markets. IEEE Trans. Power Syst. 2003, 18, 374–380. [Google Scholar] [CrossRef]
  13. Italian Transmission System Operator, Terna. Rapporto Identificazione delle Capacità Obiettivo. 2023. Available online: https://download.terna.it/terna/Terna_Rapporto_Capacita%CC%80_Obiettivo_2023_8db6776a1f286f1.pdf (accessed on 1 June 2023). (In Italian).
  14. European Union Agency for the Cooperation of Energy Regulators (ACER). Opinion 14/2017 on the Draft Regional Lists of Proposed Electricity Projects of Common Interest 2017, 10 October 2017, Ljubljana. Available online: https://www.acer.europa.eu/sites/default/files/documents/Official_documents/Acts_of_the_Agency/Opinions/Opinions/ACER%20Opinion%2014-2017.pdf (accessed on 1 June 2024).
  15. Council of European Energy Regulators. White Paper #VI on Infrastructures. 17 July 2017. Available online: https://www.ceer.eu/documents/104400/5937686/Infrastructure/a66d7d34-0922-bfa6-83bc-959706207c3b (accessed on 19 July 2017).
  16. Italian Regulatory Authority for Energy, Networks and Environment. Memoria 11 May 2015, 212/2015/I/COM. Available online: https://www.arera.it/fileadmin/allegati/docs/15/212-15.pdf (accessed on 13 May 2015). (In Italian).
  17. Italian Regulatory Authority for Energy, Networks and Environment. Memoria 29 October 2015, 501/2015/I/COM. Available online: https://www.arera.it/fileadmin/allegati/docs/15/501-15.pdf (accessed on 29 October 2015). (In Italian).
  18. Italian Regulatory Authority for Energy, Networks and Environment. Consultation Document 1 October 2015. 464/2015/R/eel. Available online: https://www.arera.it/fileadmin/allegati/docs/15/464-15.pdf (accessed on 2 October 2015). (In Italian).
  19. European Union Agency for the Cooperation of Energy Regulators (ACER). Opinion 06/2012 on the European Ten Year Network Development Plan 2012. 5 September 2012, Ljubljana. Available online: https://documents.acer.europa.eu/Official_documents/Acts_of_the_Agency/Opinions/Opinions/Forms/AllItems.aspx (accessed on 1 June 2024).
  20. Italian Regulatory Authority for Energy, Networks and Environment. Decision 21 December 2017. 884/2017/R/eel. Available online: https://www.arera.it/fileadmin/allegati/docs/17/884-17.pdf (accessed on 22 December 2017). (In Italian).
  21. Italian Regulatory Authority for Energy, Networks and Environment. Decision 8 March 2018. 129/2018/R/eel. Available online: https://www.arera.it/fileadmin/allegati/docs/18/129-18.pdf (accessed on 9 March 2018). (In Italian).
  22. Italian Regulatory Authority for Energy, Networks and Environment. Annex A to Decision 27 February 2024, 55/2024/R/eel. Available online: https://www.arera.it/fileadmin/allegati/docs/24/055-2024-R-eel-ALLEGATO_A.pdf (accessed on 28 February 2024). (In Italian).
  23. Pilo, F.G.L. Rapporto di Verifica su: Rapporto di Identificazione delle Capacità Obiettivo. 2019. Available online: https://www.arera.it/fileadmin/allegati/operatori/pds/Rapporto_verifica_Pilo.pdf (accessed on 24 April 2019). (In Italian).
  24. Trovato, M.A. Rapporto di Identificazione delle Capacità Obiettivo 2018. Verifica Esterna Indipendente. 2019. Available online: https://www.arera.it/fileadmin/allegati/operatori/pds/MA_TROVATO_Relazione_Finale_Target_Capacity_2018.pdf (accessed on 20 November 2019).
  25. Italian Transmission System Operator, Terna. Rapporto Identificazione delle Capacità Obiettivo. 2018. Available online: https://download.terna.it/terna/0000/1149/78.PDF (accessed on 19 December 2018).
  26. Italian Transmission System Operator, Terna. Rapporto Identificazione delle Capacità Obiettivo. 2020. Available online: https://www.terna.it/DesktopModules/AdactoBackend/API/download/get?guid=49cf8f88-cc3e-eb11-9104-00155d8bf435 (accessed on 7 December 2020).
  27. The European Parliament and the Council of the European Union. Regulation (EU) 2022/869 of the European Parliament and of the Council of 30 May 2022. Available online: https://eur-lex.europa.eu/legal-content/EN/TXT/PDF/?uri=CELEX:32022R0869#:~:text=(13)%20Security%20of%20supply%2C,through%20projects%20of%20common%20interest (accessed on 2 June 2022).
  28. Italian Transmission System Operator, Terna. Scenarios Description Document, 2022 Edition. Available online: https://download.terna.it/terna/Documento_Descrizione_Scenari_2022_8da74044f6ee28d.pdf (accessed on 11 August 2022).
  29. Hwang, C.L.; Yoon, K. Multiple Attribute Decision Making: Methods and Applications a State-of-the-Art Survey; Springer: Berlin, Germany, 1981. [Google Scholar]
  30. Mateo, J.R.S.C. TOPSIS. In Multi Criteria Analysis in the Renewable Energy Industry; Springer: Berlin/Heidelberg, Germany, 2012; pp. 43–48. [Google Scholar]
  31. Mazza, A.; Chicco, G. Application of TOPSIS in distribution systems multi-objective optimization. In Proceedings of the 9th World Energy System Conference, Suceava, Romania, 28–30 June 2012; pp. 625–633. [Google Scholar]
  32. Musbah, H.; Ali, G.; Aly, H.H.; Little, T.A. Energy management using multi-criteria decision making and machine learning. Electr. Power Syst. Res. 2022, 203, 107645. [Google Scholar] [CrossRef]
  33. Al-Kaabi, M.; Dumbrava, V.; Eremia, M. Multi Criteria Frameworks Using New Meta-Heuristic Optimization Techniques for Solving Multi-Objective Optimal Power Flow Problems. Energies 2024, 17, 2209. [Google Scholar] [CrossRef]
  34. Latorre, G.; Cruz, R.D.; Areiza, J.M.; Villegas, A. Classification of publications and models on transmission expansion planning. IEEE Trans. Power Syst. 2003, 18, 938–946. [Google Scholar] [CrossRef]
  35. Garver, L.L. Transmission Network Estimation Using Linear Programming. IEEE Trans. Power Appar. Syst. 1970, 89, 1688–1697. [Google Scholar] [CrossRef]
  36. Kim, K.J.; Park, Y.M.; Lee, K.Y. Optimal long term transmission expansion planning based on maximum principle. IEEE Trans. Power Syst. 1988, 3, 1494–1501. [Google Scholar] [CrossRef]
  37. Aguado, J.A.; De la Torre, S.; Contreras, J.; Conejo, A.J.; Martínez, A. Market-driven dynamic transmission expansion planning. Electr. Power Syst. Res. 2012, 82, 88–94. [Google Scholar] [CrossRef]
  38. Monticelli, A.; Santos, A.; Pereira, M.V.F.; Cunha, S.H.; Parker, B.J.; Praca, J.C.G. Interactive Transmission Network Planning Using a Least-Effort Criterion. IEEE Trans. Power Appar. Syst. 1982, 101, 3919–3925. [Google Scholar] [CrossRef]
  39. Latorre-Bayona, G.; Perez-Arriaga, I.J. CHOPIN, a heuristic model for long term transmission expansion planning. IEEE Trans. Power Syst. 1994, 9, 1886–1894. [Google Scholar] [CrossRef]
  40. Oliveira, G.C.; Costa, A.P.C.; Binato, S. Large scale transmission network planning using optimization and heuristic techniques. IEEE Trans. Power Syst. 1995, 10, 1828–1834. [Google Scholar] [CrossRef]
  41. Mahdavi, M.; Sabillon Antunez, C.; Ajalli, M.; Romero, R. Transmission Expansion Planning: Literature Review and Classification. IEEE Syst. 2019, 3, 3129–3140. [Google Scholar] [CrossRef]
  42. Choi, J.; Mount, T.D.; Thomas, R.J.; Billinton, R. Probabilistic reliability criterion for planning transmission system expansions. IET Proc. Gener. Transm. Distrib. 2006, 153, 719–727. [Google Scholar] [CrossRef]
  43. Zhan, J.; Chung, C.Y.; Zare, A. A Fast Solution Method for Stochastic Transmission Expansion Planning. IEEE Trans. Power Syst. 2017, 32, 4684–4695. [Google Scholar] [CrossRef]
  44. Mahdavi, M.; Monsef, H.; Romero, R. Reliability and Economic Effects of Maintenance on TNEP Considering Line Loading and Repair. IEEE Trans. Power Syst. 2016, 31, 3381–3393. [Google Scholar] [CrossRef]
  45. Delgado, D.; Claro, J. Transmission network expansion planning under demand uncertainty and risk aversion. Int. J. Electr. Power Energy Syst. 2013, 44, 696–702. [Google Scholar] [CrossRef]
  46. Kazerooni, A.K.; Mutale, J. Transmission Network Planning Under Security and Environmental Constraints. IEEE Trans. Power Syst. 2010, 25, 1169–1178. [Google Scholar] [CrossRef]
  47. Capurso, P.; Cova, B.; Elia, E.; Portoghese, P.; Stabile, M.; Vedovelli, F.; Venturini, A. Market integration in Europe: A market simulator taking into account different market zones and the increasing penetration of RES generation. In Proceedings of the Cigre General Session 2008, Paris, France, 24–29 August 2008. paper C1-104. [Google Scholar]
  48. Vicini, P.; Schulze, F.H.; Stabile, M.; Cabano, M.; Venturini, A. A new optimization tool for security constrained unit commitment in systems with high RES penetration in the GCC region. In Proceedings of the 14th GCC—CIGRE International Conference and 23rd Exhibition for Electrical Equipment, Salmiya, Kuwait, 11–13 November 2018. [Google Scholar]
  49. Bertoldi, O.; Innorta, M.; Demartini, G.; Marannino, P. New issues in bulk power system planning. In Proceedings of the Cigre Session, Paris, France, August 1996; Volume 1 of 2. Report 37-106. [Google Scholar]
  50. National Grid. Network Options Assessment 2021/2022. Available online: https://www.nationalgrideso.com/document/262981/download (accessed on 6 July 2022).
  51. National Grid. Electricity Ten Year Statement 2022. Available online: https://www.nationalgrideso.com/document/275611/download (accessed on 21 April 2023).
  52. European Network of Transmission System Operators. System Needs Study—Opportunities for a More Efficient European Power System in 2030 and 2040. Final Version, May 2023. Available online: https://eepublicdownloads.blob.core.windows.net/public-cdn-container/tyndp-documents/TYNDP2022/public/system-needs-report.pdf (accessed on 26 March 2023).
  53. Chen, B.; Wang, J.; Wang, L.; He, Y.; Wang, Z. Robust optimization for transmission expansion planning: Minimax cost vs. minimax regret. IEEE Trans. Power Syst. 2014, 29, 3069–3077. [Google Scholar] [CrossRef]
  54. Rahmani, M.; Romero, R.A.; Rider, M.J. Risk/investment-driven transmission expansion planning with multiple scenarios. IET Gener. Transm. Distrib. 2013, 7, 154–165. [Google Scholar] [CrossRef]
  55. European Network of Transmission System Operators. 3rd ENTSO-E Guideline for Cost Benefit Analysis of Grid Development Projects. 2019. Available online: https://docstore.entsoe.eu/Documents/TYNDP%20documents/Cost%20Benefit%20Analysis/191023_CBA3_Draft%20for%20consultation.pdf (accessed on 15 October 2019).
  56. European Union Agency for the Cooperation of Energy Regulators (ACER). Report on Unit Investment Cost Indicators and Corresponding Reference Values for Electricity and Gas Infrastructure. 2015. Available online: https://www.acer.europa.eu/sites/default/files/documents/Publications/UIC%20Report%20%20-%20Electricity%20infrastructure.pdf (accessed on 1 June 2024).
  57. Italian Transmission System Operator, Terna. Metodologia Analisi Costi—Benefici—A.C.B. 2.0. 2017. Available online: https://www.arera.it/fileadmin/allegati/docs/17/856-17_AllegatoA74.pdf (accessed on 1 December 2017).
  58. Terna. Documento Metodologico per l’Applicazione dell’Analisi Costi Benefici Applicata al Piano di Sviluppo 2023. Available online: https://download.terna.it/terna/Terna_Piano_Sviluppo_2023_Documento_Metodologico_applicazione_analisi_costi_benefici_8db254c3b3edff1.pdf (accessed on 7 March 2023).
  59. Italian Regulatory Authority for Energy, Networks and Environment. Order 4 November 2016. 627/2016/R/eel. Available online: https://www.arera.it/fileadmin/allegati/docs/16/627-16eng.pdf (accessed on 14 June 2018).
  60. European Union Agency for the Cooperation of Energy Regulators (ACER). Opinion 01/2014 on the ENTSO-E Guideline for CBA of Grid Development Projects. 31 January 2014, Ljubljana. Available online: https://documents.acer.europa.eu/Official_documents/Acts_of_the_Agency/Opinions/Opinions/Forms/AllItems.aspx (accessed on 1 June 2024).
  61. Italian Transmission System Operator, Terna. Piano di Sviluppo della Rete 2023. Available online: https://www.terna.it/en/electric-system/grid/national-electricity-transmission-grid-development-plan (accessed on 31 May 2023).
  62. Shin, K.; Lee, J. Investment Decision for Long-Term Battery Energy Storage System Using Least Squares Monte Carlo. Energies 2024, 17, 2019. [Google Scholar] [CrossRef]
Figure 1. Examples of the k-th section/border marginal cost and benefit curves resulting from the iterative process for two different scenarios for two different time horizons.
Figure 1. Examples of the k-th section/border marginal cost and benefit curves resulting from the iterative process for two different scenarios for two different time horizons.
Energies 17 02824 g001
Figure 2. Workflow of the iterative process.
Figure 2. Workflow of the iterative process.
Energies 17 02824 g002
Figure 3. Demand trend for Italy (TWh) in the reference scenarios for 2030 and 2040.
Figure 3. Demand trend for Italy (TWh) in the reference scenarios for 2030 and 2040.
Energies 17 02824 g003
Figure 4. Generation mix for Italy (GW) in the reference scenarios for 2030 and 2040.
Figure 4. Generation mix for Italy (GW) in the reference scenarios for 2030 and 2040.
Energies 17 02824 g004

Figure 5. Storage energy capacity for Italy (GWh) in the reference scenarios for 2030 and 2040.
Figure 5. Storage energy capacity for Italy (GWh) in the reference scenarios for 2030 and 2040.
Energies 17 02824 g005

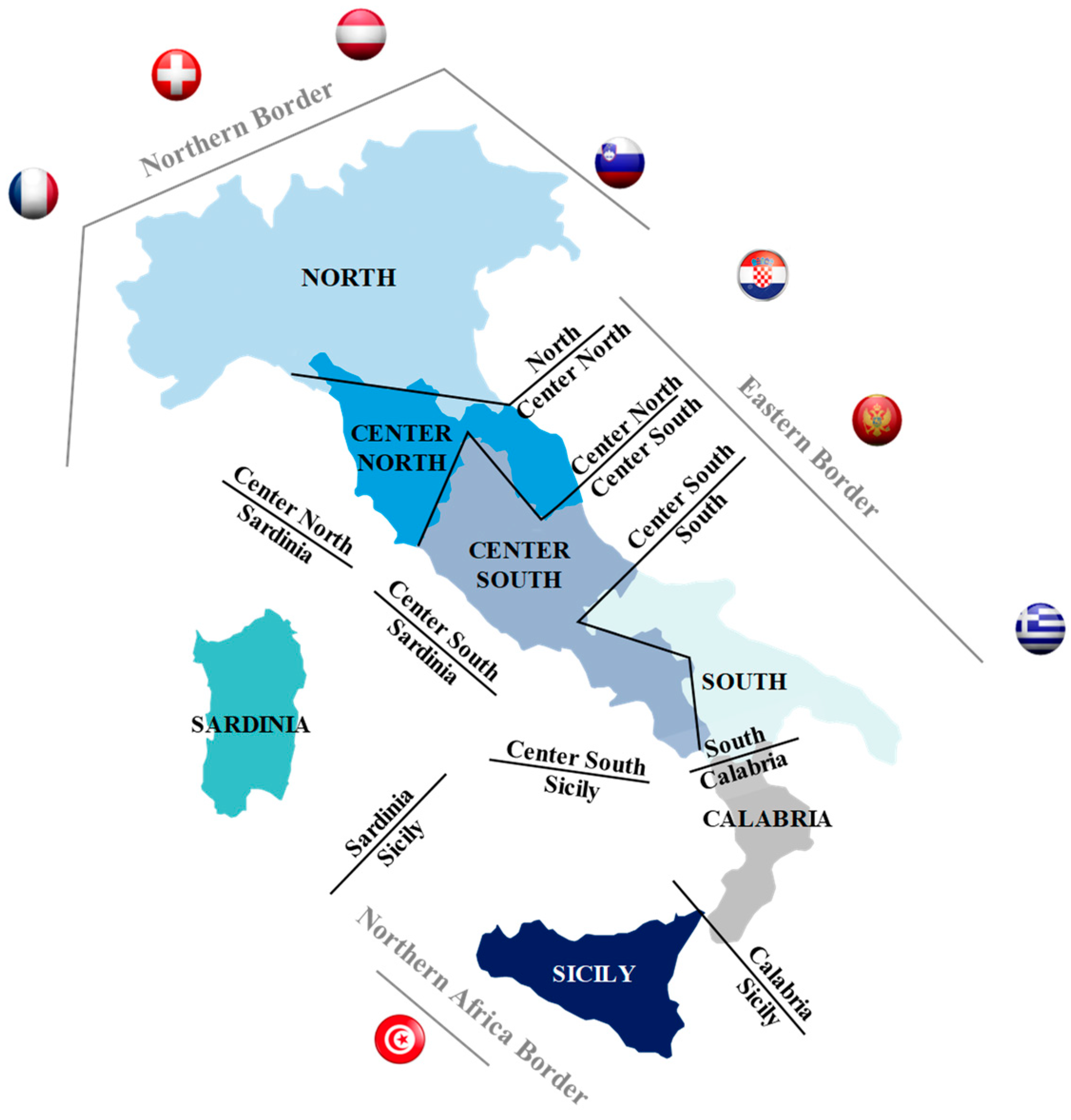

Figure 6. Bidding zones of the Italian power system: internal sections and external borders under study.
Figure 6. Bidding zones of the Italian power system: internal sections and external borders under study.
Energies 17 02824 g006
Figure 7. Constraints on the maximum additional transmission capacity at each border under study.
Figure 7. Constraints on the maximum additional transmission capacity at each border under study.
Energies 17 02824 g007

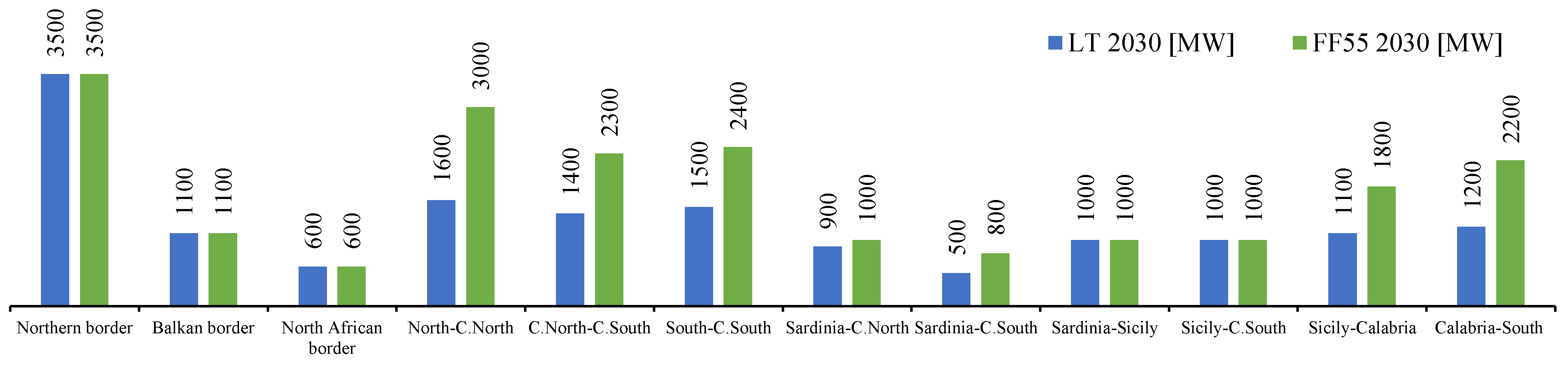

Figure 8. Cost-effective transmission capacity increases [MW] for each section/border of the Italian power system in each considered scenario for the 2030 horizon.
Figure 8. Cost-effective transmission capacity increases [MW] for each section/border of the Italian power system in each considered scenario for the 2030 horizon.
Energies 17 02824 g008

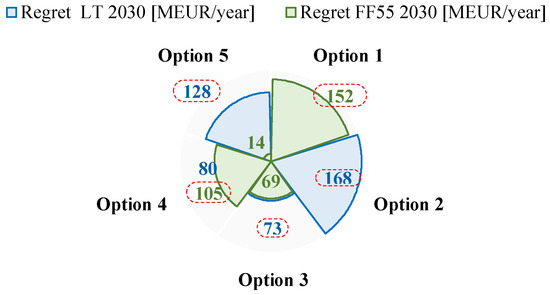

Figure 9. Least regret application for 2030 horizon: worst regret for each option in dotted red circle.
Figure 9. Least regret application for 2030 horizon: worst regret for each option in dotted red circle.
Energies 17 02824 g009

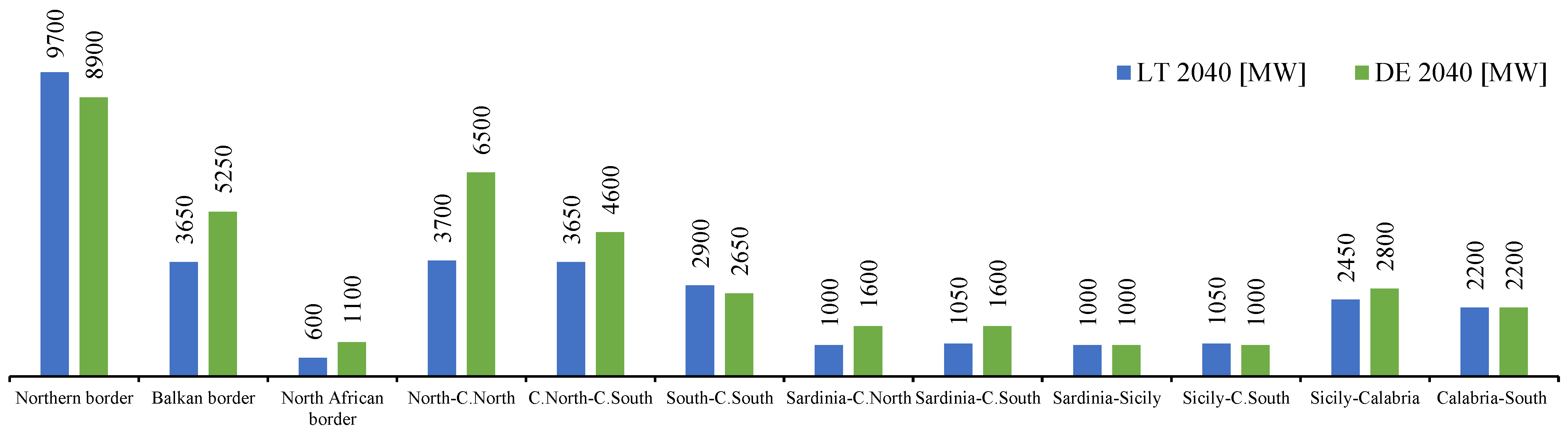

Figure 10. Cost-effective transmission capacity increases [MW] for each section/border of the Italian power system in each considered scenario for the 2040 horizon.
Figure 10. Cost-effective transmission capacity increases [MW] for each section/border of the Italian power system in each considered scenario for the 2040 horizon.
Energies 17 02824 g010
Figure 11. Least regret application for the 2040 horizon: worst regret for each option in dotted red circle.
Figure 11. Least regret application for the 2040 horizon: worst regret for each option in dotted red circle.
Energies 17 02824 g011

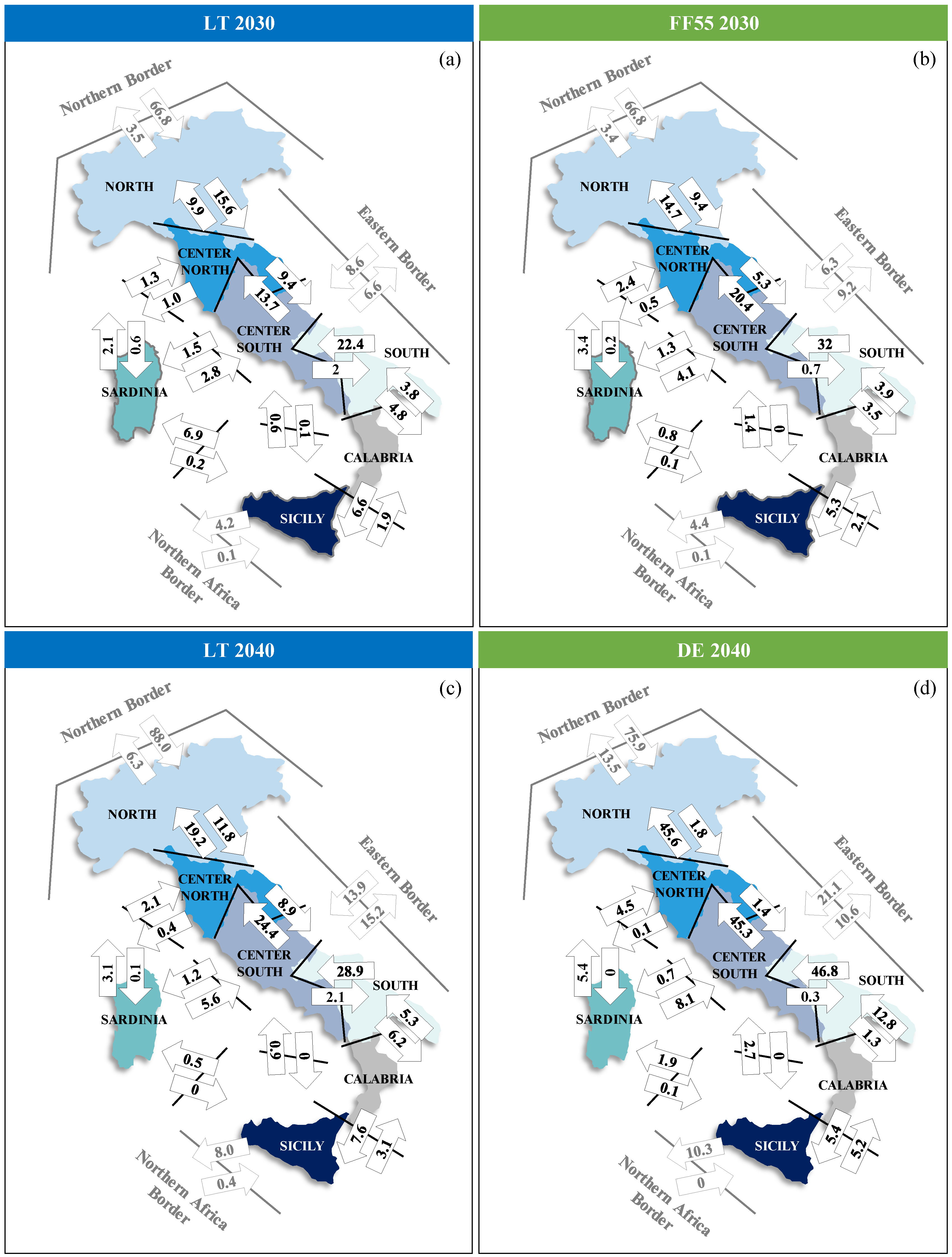

Figure 12. Expected power flows (TWh) resulting from the implementation of identified additional target capacity on the base case in 2030 and 2040 contrasting scenarios. (a) LT 2030; (b) FF55 2030; (c) LT 2040; (d) DE 2040.
Figure 12. Expected power flows (TWh) resulting from the implementation of identified additional target capacity on the base case in 2030 and 2040 contrasting scenarios. (a) LT 2030; (b) FF55 2030; (c) LT 2040; (d) DE 2040.
Energies 17 02824 g012
Figure 13. Sensitivity analyses results in the 2030 policy scenario: additional transmission capacity needs in internal market sections [MW] if additional capacity external borders (Sensitivity 1) and additional storage capacity (Sensitivity 2) are reduced.
Figure 13. Sensitivity analyses results in the 2030 policy scenario: additional transmission capacity needs in internal market sections [MW] if additional capacity external borders (Sensitivity 1) and additional storage capacity (Sensitivity 2) are reduced.
Energies 17 02824 g013

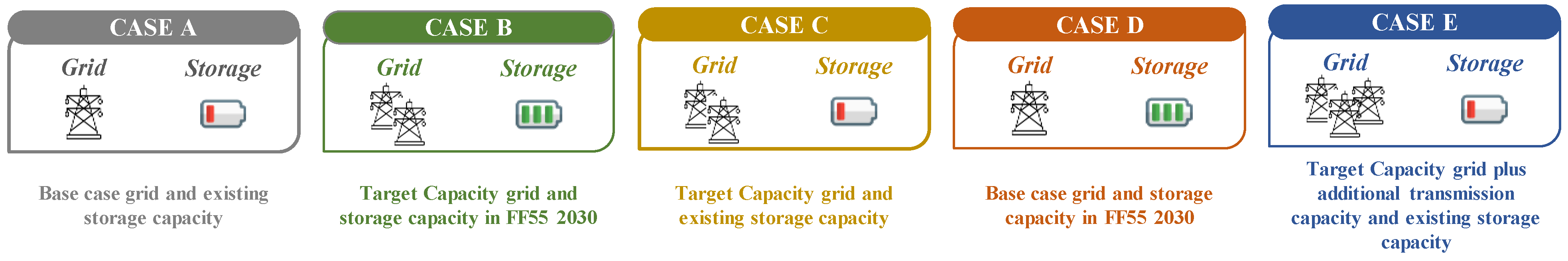

Figure 14. Sensitivity in storage capacity: cases analyzed.
Figure 14. Sensitivity in storage capacity: cases analyzed.
Energies 17 02824 g014

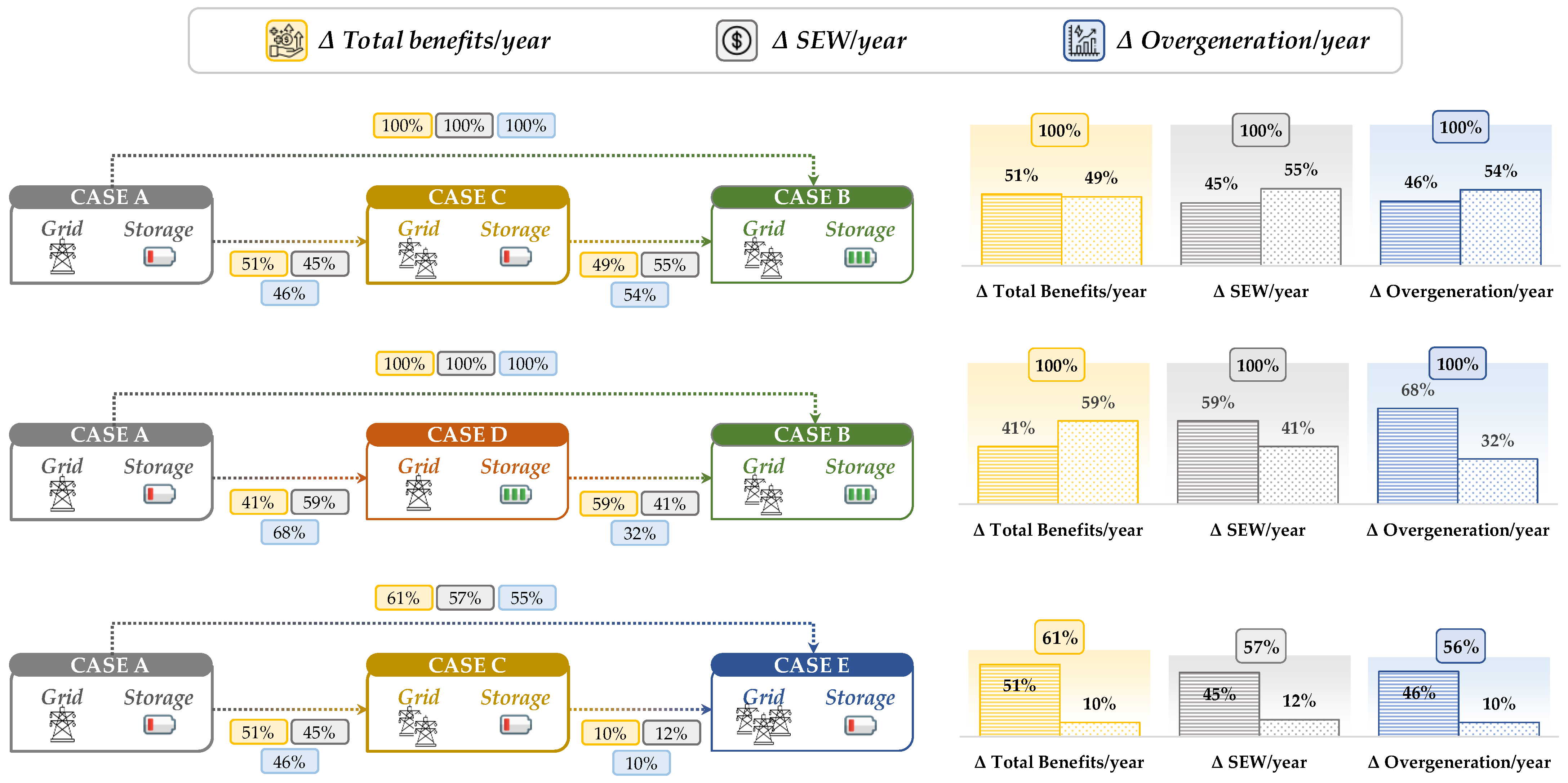

Figure 15. Sensitivity in storage capacity: computed indicators.
Figure 15. Sensitivity in storage capacity: computed indicators.
Energies 17 02824 g015
Table 1. Benefit categories included in the target capacity assessment methodology and corresponding simulator adopted.
Table 1. Benefit categories included in the target capacity assessment methodology and corresponding simulator adopted.
Code 1Benefit CategoriesSimulator
B1Socio-Economic Welfare (SEW)Day-Ahead zonal Market
B3Energy Not Supplied (ENS) reductionGrid Reliability and Adequacy nodal network
B5RES integrationGrid Reliability and Adequacy nodal network
B7Nodal dispatching cost variationGrid Reliability and Adequacy nodal network
B8Zonal dispatching cost variationAncillary Services zonal Market
B18CO2 variationDay-Ahead zonal Market
B19Non–CO2 emissions variationDay-Ahead zonal Market
1 Code used in the cost–benefit analysis carried out in the NDP [58].
Table 2. Planned development projects included in the base case: transmission capacity increase provided (MW) and section/border involved.
Table 2. Planned development projects included in the base case: transmission capacity increase provided (MW) and section/border involved.
ProjectTTC [MW]Section/Border Involved
320 kV Piossasco–Grand’Ile HVDC link+1200IT North–France
220 kV Nauders–Glorenza link+300IT North–Austria
132 kV Brennero–Steinach link+100IT North–Austria
380 kV Colunga–Calenzano link+200IT North–IT Center North
Table 3. Net benefit [MEUR/y] associated with each development strategy in each 2030 scenario under study.
Table 3. Net benefit [MEUR/y] associated with each development strategy in each 2030 scenario under study.
Scenario N B O p t 1 N B O p t 2 N B O p t 3 N B O p t 4 N B O p t 5
LT 20301067899994987939
FF 203023122464239523592450
Table 4. Regret [MEUR/y] associated with each development strategy in each 2030 scenario under study.
Table 4. Regret [MEUR/y] associated with each development strategy in each 2030 scenario under study.
ScenarioOption 1Option 2Option 3Option 4Option 5
LT 203001687380128
FF 203015206910514
Worst15216873105128
Least73
Table 5. Net benefit [MEUR/y] associated with each development strategy in each 2040 scenario under study.
Table 5. Net benefit [MEUR/y] associated with each development strategy in each 2040 scenario under study.
Scenario N B O p t 1 N B O p t 2 N B O p t 3
LT 20401011−148745
DE 2040141814642023
Table 6. Regret [MEUR/y] associated with each development strategy in each 2040 scenario under study.
Table 6. Regret [MEUR/y] associated with each development strategy in each 2040 scenario under study.
ScenarioOption 1Option 2Option 3
LT 204001159266
DE 20406055590
Worst6051159266
Least266
Table 7. Results of the target capacity assessment methodology for the 2030 and 2040 horizons [MW].
Table 7. Results of the target capacity assessment methodology for the 2030 and 2040 horizons [MW].
Section/BorderMain Direction E C k , W P χ k 2030 T C k 2030 χ k 2040 T C k 2040
Northern border–IT8935350012,435910018,035
Balkan border–IT11001100220044005500
110022005500
Northern Africa border–IT0600600800800
North–C. North31002300540051008200
430066009400
C. North–C. South28001800460041006900
290047007000
South–C. South50001900690027007700
Sardinia–C. North39590099513001395
315915-
Sardinia–C. South900600150013002200
7201320-
Sardinia–Sicily0100010001000-
010001000
Sicily–C. South01000100010001000
01000-
Sicily–Calabria13001400270026003900
150029004100
Calabria–South23501700405022004550
110028003300
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Carlini, E.M.; Gadaleta, C.; Migliori, M.; Ferretti, F.; Vailati, R.; Venturini, A.; Puglisi, C. Cost-Effective Target Capacity Assessment in the Energy Transition: The Italian Methodology. Energies 2024, 17, 2824. https://doi.org/10.3390/en17122824

AMA Style

Carlini EM, Gadaleta C, Migliori M, Ferretti F, Vailati R, Venturini A, Puglisi C. Cost-Effective Target Capacity Assessment in the Energy Transition: The Italian Methodology. Energies. 2024; 17(12):2824. https://doi.org/10.3390/en17122824

Chicago/Turabian Style

Carlini, Enrico Maria, Corrado Gadaleta, Michela Migliori, Francesca Ferretti, Riccardo Vailati, Andrea Venturini, and Cinzia Puglisi. 2024. "Cost-Effective Target Capacity Assessment in the Energy Transition: The Italian Methodology" Energies 17, no. 12: 2824. https://doi.org/10.3390/en17122824

APA Style

Carlini, E. M., Gadaleta, C., Migliori, M., Ferretti, F., Vailati, R., Venturini, A., & Puglisi, C. (2024). Cost-Effective Target Capacity Assessment in the Energy Transition: The Italian Methodology. Energies, 17(12), 2824. https://doi.org/10.3390/en17122824

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
