Abstract
FGH terminal is an operator that provides container services with an integrated and standardized network system. Activities at the FGH terminal have a high risk. There are accidents of workers being hit by trucks carrying containers, trucks crashing into road dividers, trucks crashing into electric poles, container damage, and even death. Thus, it is necessary to conduct a risk analysis to reduce the risk or even eliminate the existing risks. Risk analysis using the Importance Index (IMPI) method is carried out to assess risks by calculating the Frequency Index and Severity Index values, identifying the causes and consequences of risks that are classified as significant, analyzing the causes and impacts of risks and preventive actions and recovery actions from existing risks, and then will be described in a bowtie diagram. Based on risk identification, there are three variables: machine or equipment, human and environmental variables, and 45 indicators. Risk assessment using the IMPI method found 4 risks classified as significant, 12 risks classified as moderate, and 29 low categories.
    1. Introduction
Risk is a combination of the possibilities that occur from an event []. Risk management is a method to manage risks and take advantage of opportunities to achieve goals []. Risk management is also a systematic approach that includes culture, processes, and structures to determine actions that can reduce risk []. The implementation of risk management must be well structured to help organizations or companies in a better system and help organizations or companies in the risk management system to be more efficient and effective [].
Activities at the FGH terminal have high risks, such as accidents, workers being hit by trucks carrying containers, trucks crashing into road dividers, trucks hitting electric poles, container damage, and death. A work accident is an unexpected and unwanted event that can disrupt the process of an ongoing activity []. This risk can cause huge losses for the company because it must be responsible for material damage to death caused by accidents in its work area []. Overcoming this risk and loss requires a system that can control risk, namely, risk management.
A study by [] analyzed occupational safety and health using the bowtie method at PT X. The study’s results showed three significant risk variables: employees exposed to hot iron, employees inhaled/exposed to chemicals and noise, and two high variables: employees exposed to hot steam and employees exposed to bursts of fire.
The study conducted by [] analyzed the risk of work accidents using the bowtie analysis method on the One Galaxy Surabaya project. The results of this study indicate that there are dominant work accident risks, namely, piling work with the hazard of lifting piles using TC, the risk of breaking each other, casting work with the hazard of casting at height, and workers falling from a height.
This study uses two methods, the Importance Index, which assesses risks, and the bowtie analysis, to describe the causes and impacts of risks as well as actions to prevent and mitigate them. This method provides a strategy to control these risks both preventively based on the causes of risk and recovery based on the consequences of risk [].
2. Method
In addition to questionnaires and direct observation, this study also uses interview techniques that involve expert judgment, ranging from business processes to proposed improvements. Expert judgment is considered an organizational asset because it can provide input to plan and estimate important project activities [].
The subjects were managers of management systems, HSSE, Customer Development, operations, and engineering support. The data used in this study were primary and secondary. Primary data consisted of observations, interviews, and questionnaires, while secondary data consisted of risk management books, risk analysis journals, company history, and organizational structure.
The data collection technique involves direct interviews, observations in the field, and questionnaire distribution to related parties. The study flow is as follows:
Risk management aims to coordinate activities and control and manage the organization based on risk orientation []. Risk is an inseparable part of the growth factor of an organization/company, whether it comes from internal or external factors []. A risk is an event that leads to uncertainty that occurs within a specific time span that causes a loss, both small and large, which affects a company’s survival []. The types of risks include strategic and policy, operational, compliance, fraud, and financial risks, which can be seen in Figure 1.

    Figure 1.

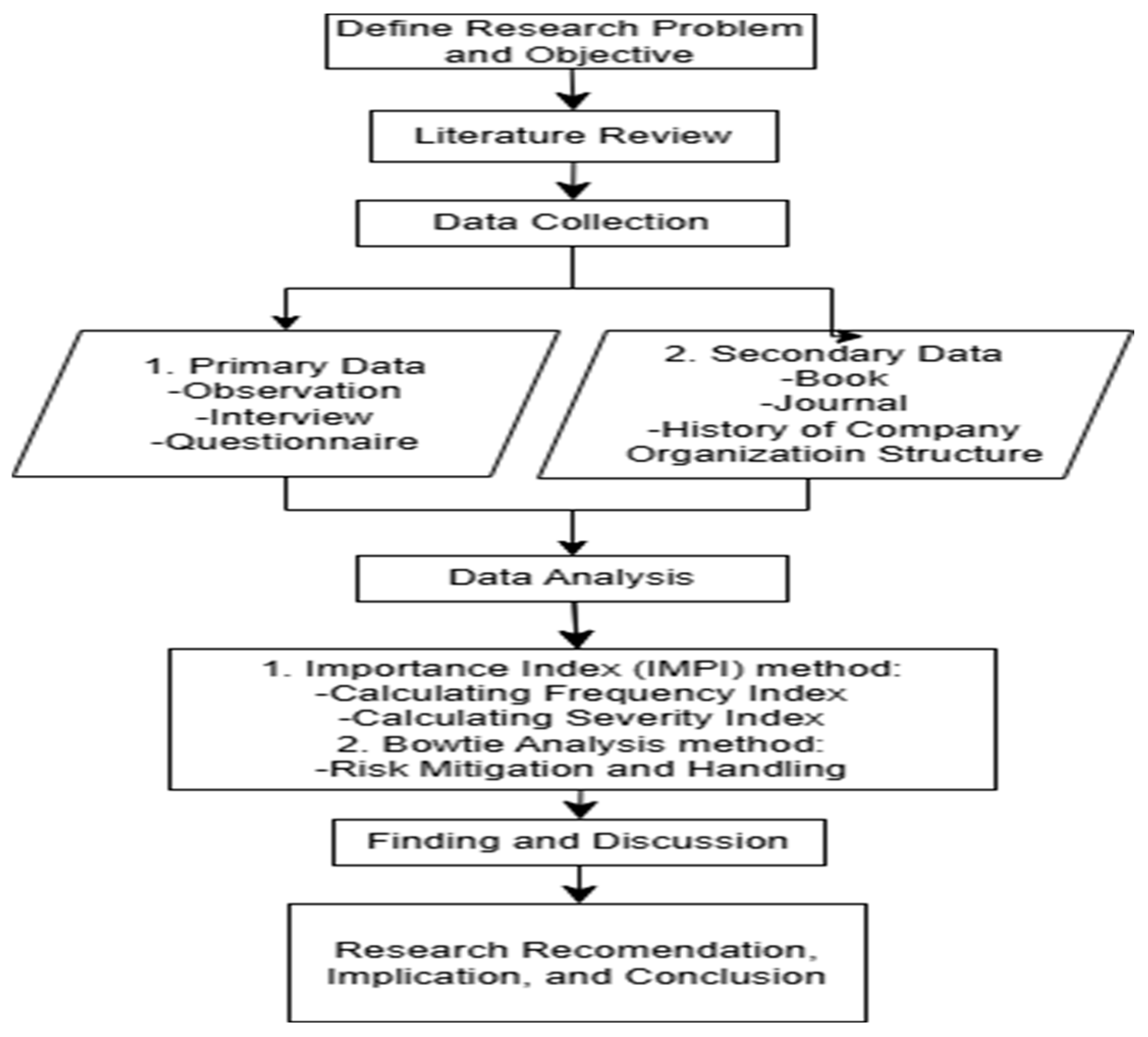

      Study flow chart.

Risk assessment is a process to determine work activities, estimate work actions, determine whether they have a fatal impact, and make decisions to overcome these causes []. Data processing uses the Importance Index (IMPI) method for risk assessment by calculating the Frequency Index and Severity Index. The Frequency Index is the percentage value of the probability or frequency of occurrence of a risk calculated based on respondents’ answers []. The Frequency Index value can be calculated using the following formula and Frequency scale in Table 1:

    Table 1.
    Frequency scale.

Means:
FI: Frequency Index
: The score given by the respondent with value i
 = 1, 2, 3, 4, 5
: Number of respondents who answer with value i
: Number of respondents
The Severity Index is the percentage value of the impact of the occurrence of a risk in terms of losses experienced []. The Severity Index value can be calculated with the following formula and Severity scale in Table 2:

    Table 2.
    Severity scale in AS/NZS 4360 standard [].

Means:
SI: Severity Index
 The score given by the respondent with value i
 = 1, 2, 3, 4, 5
: Number of respondents who answer with value i
: Number of respondents
Importance Index (IMPI) is a risk assessment method that refers to the Frequency Index and Impact Index of risk occurrence []. The formula for this method is as follows:

Means:
FI: Frequency Index
SI: Severity Index
Risks that need to be mitigated are those classified as significant and high. The classification in risk assessment is as follows in Table 3:

    Table 3.
    Risk score classification [].

The bowtie analysis method describes the causes and impacts of risks and preventive and recovery actions. The bowtie analysis is a bowtie-shaped diagram that describes or visualizes risk events []. The bowtie analysis is a combination of two techniques, namely, the fault tree analysis (FTA) technique and the event tree analysis (ETA) technique []. The bowtie method considers barriers to prevent accidents, such as safety measures, training, and equipment design []. The bowtie analysis diagram is shown in Figure 2.

    Figure 2.

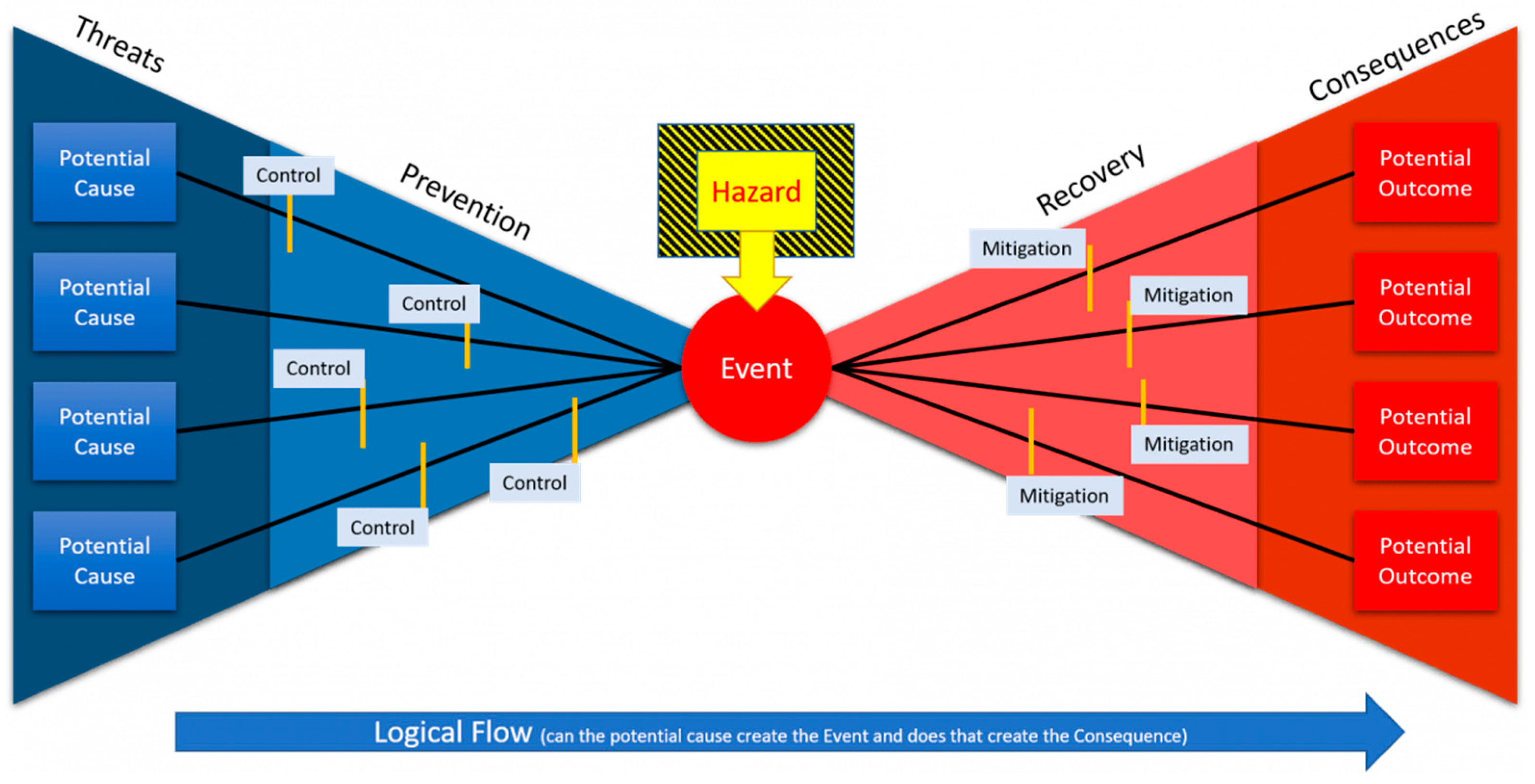

      Bowtie diagram [].

Bowtie’s analysis focuses on the barriers between causes and risks, as well as risks and their consequences. The input of bowtie analysis is an understanding of the causes and consequences of risk and the constraints and controls that can prevent, reduce, and stimulate the risk. The output of bowtie analysis is a simple diagram image that shows the main path of risks and obstacles to prevent or reduce unwanted consequences or stimulate and promote desired consequences [].
3. Findings and Discussion
The following Table 4 are risk identification methods based on the actual conditions at the FGH terminal, which have three variables and 45 indicators.

    Table 4.
    Risk identification of FGH terminal.

The risk assessment questionnaire was given to the Management System Manager, HSSE and Customer Care, one operation support person, and one engineering person. After distributing questionnaires to get the Importance Index value, it is necessary to calculate the Frequency Index and Severity Index of each risk first, which can be seen in Table 5.

    Table 5.
    Frequency survey results and Severity Index.

Means:
X1: Respondent 1
X2: Respondent 2
X3: Respondent 3
- Calculation of Frequency Index code F1:
 - Calculation of Severity Index code F1:
 - Calculation of Importance Index code F1:

The following is a recap of the Importance Index assessment of each risk, which can be seen in Table 6.

    Table 6.
    The calculation results of the Importance Index.

The Risk Description:
Significant: At risk, which requires immediate action in order to reduce or even eliminate the negative impact on organizational goals.
Moderate: Moderate risk, which requires SOP monitoring so that the risk does not develop into a serious risk.
Low: Low risk, the consequences of the risk are very small or manageable.
Based on Table 6, there are 29 low categories, 12 moderate categories, and 4 significant categories, namely, code F1 (container damage during unloading, stacking, or transferring to trucks), code F4 (loading and unloading equipment is damaged), code F29 (lack of lighting during loading and unloading at night), and H2 (different loading and unloading fields).
Proposed improvements using bowtie diagram analysis. Discussions with experts determine the significance of mitigation. Risks classified as significant are depicted in the bowtie analysis diagram because they can significantly impact the goals, success, or safety of a project or organization in reputation, finance, and human safety. After determining the cause and impact of existing risks, what will be analyzed next is determining preventive and recovery actions. Preventive action is used to stop the cause, while recovery action is used to stop the impact.
Bowtie diagrams of each significant category risk, namely, code F1 (container damage during unloading, stacking, or transferring to trucks), code F4 (damaged loading and unloading equipment), code F29 (lack of lighting during loading and unloading at night), and code H2 (dusty loading and unloading field), can be seen in Figure 3, Figure 4, Figure 5 and Figure 6.

    Figure 3.

      Bowtie diagram F1.

    Figure 4.

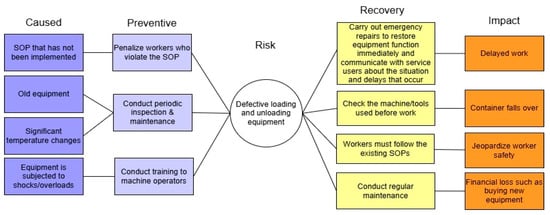

      Bowtie diagram F4..

    Figure 5.

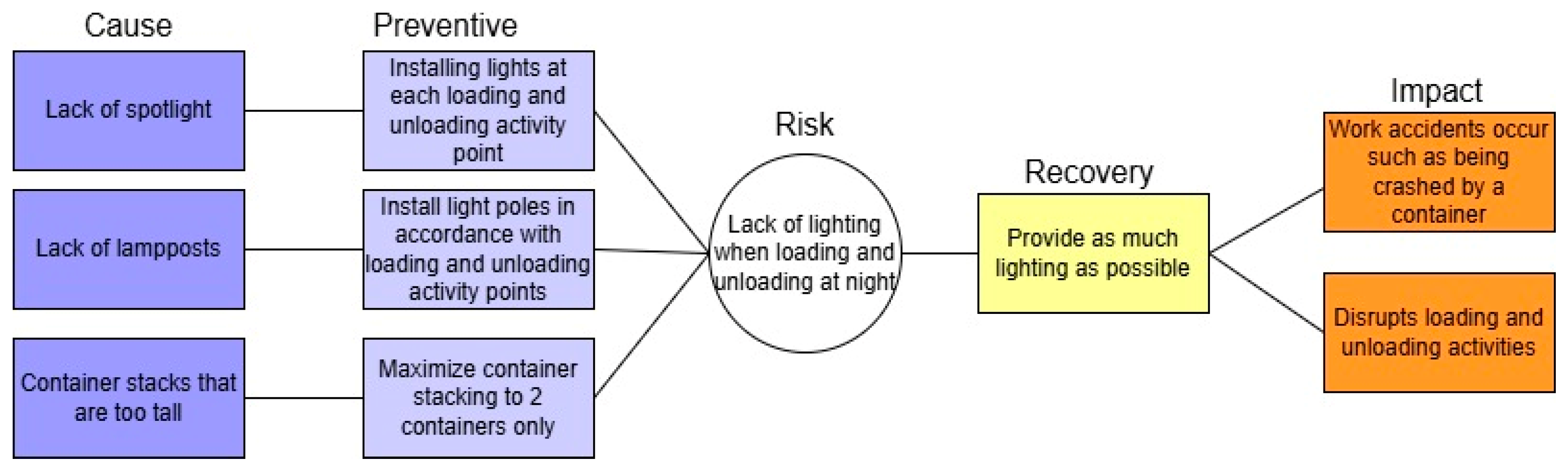

      Bowtie diagram F29.

    Figure 6.

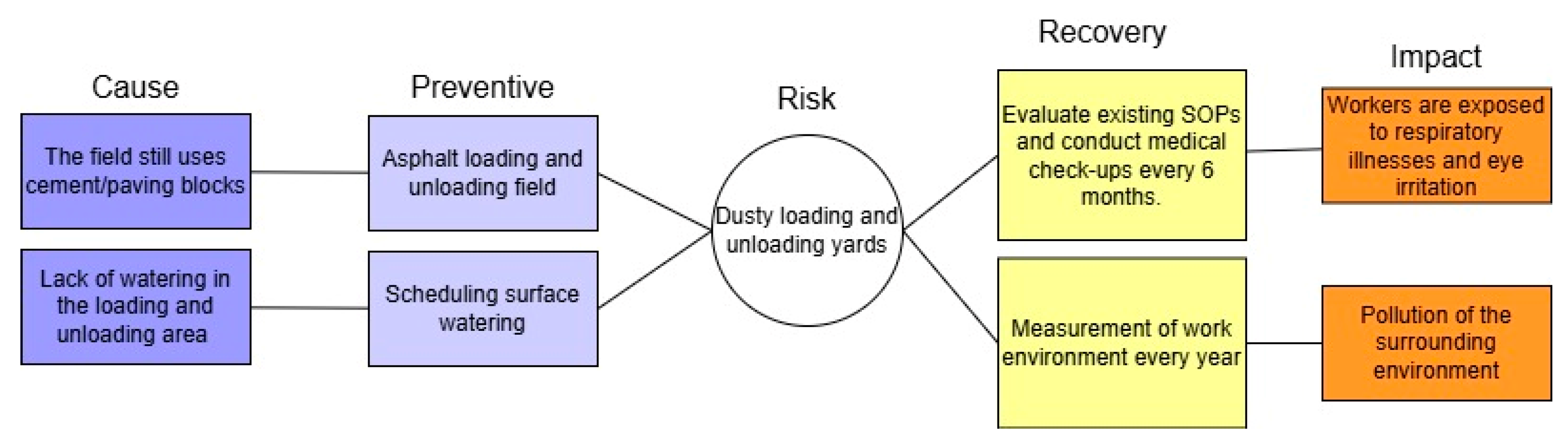

      Bowtie diagram H2.

4. Conclusions
Activities at the FGH terminal have high risks, such as accidents, workers being hit by trucks carrying containers, trucks crashing into road dividers, trucks hitting electricity poles, container damage, and death. This risk can cause enormous losses for the company because it must be responsible for material damage and death caused by accidents in its work area.
This study aims to reduce and eliminate existing risks. Prevention and handling of risks at the FGH terminal are contained in a bowtie diagram, where when handling risk code F1, risk codes F2 and F3 can be handled, then by preventing risk code F4, risk codes F5, F6, F7, F26, F27, and G11 can also be handled.
Based on the identification results above, the conclusion is that there are 3 variables and 45 indicators. The machine/equipment variable has 29 indicators with risk codes F1, F2, F3, F4, F5, F6, F7, F8, F9, F10, F11, F12, F13, F14, F15, F16, F17, F18, F19, F20, F21, F22, F23, F24, F25, F26, F27, F28, and F29. The human variables have 13 indicators with risk codes G1, G2, G3, G4, G5, G6, G7, G8, G9, G10, G11, G12, and G13. There are 3 indicators of environmental variables with risk codes H1, H2, and H3. The results of data processing are that using the Importance Index (IMPI) method there are four significant category risks, namely, code F1, container damage during unloading, stacking, or transferring to trucks; code F4, namely, damaged loading and unloading equipment (broken and bent); code 29, namely, lack of lighting when loading and unloading at night; and code H2, namely, the dusty loading and unloading field. Risk prevention and handling can be seen in the bowtie diagram, which is expected to be applied to the FGH terminal to reduce or eliminate existing risks.
