Digital Integration in Construction: A Case Study on Common Data Environment Implementation for a Metro Line Project
Abstract
1. Introduction
2. Literature Review
2.1. Digitalization and Collaboration in Construction Projects
2.2. The Common Data Environment as a Digital Backbone
- PAS 1192-2 and PAS 1192-3 [10], which define documentation requirements for the delivery and operational phases;
- The Singapore BIM Guide [11], which outlines roles and procedures within a CDE;
- ISO 19650 [12], the internationally recognized standard that formalizes information management in the context of BIM through standardized processes and clearly defined responsibilities.
2.3. Limitations of Interoperability and Implementation Challenges
3. Research Methodology
3.1. Research Objectives

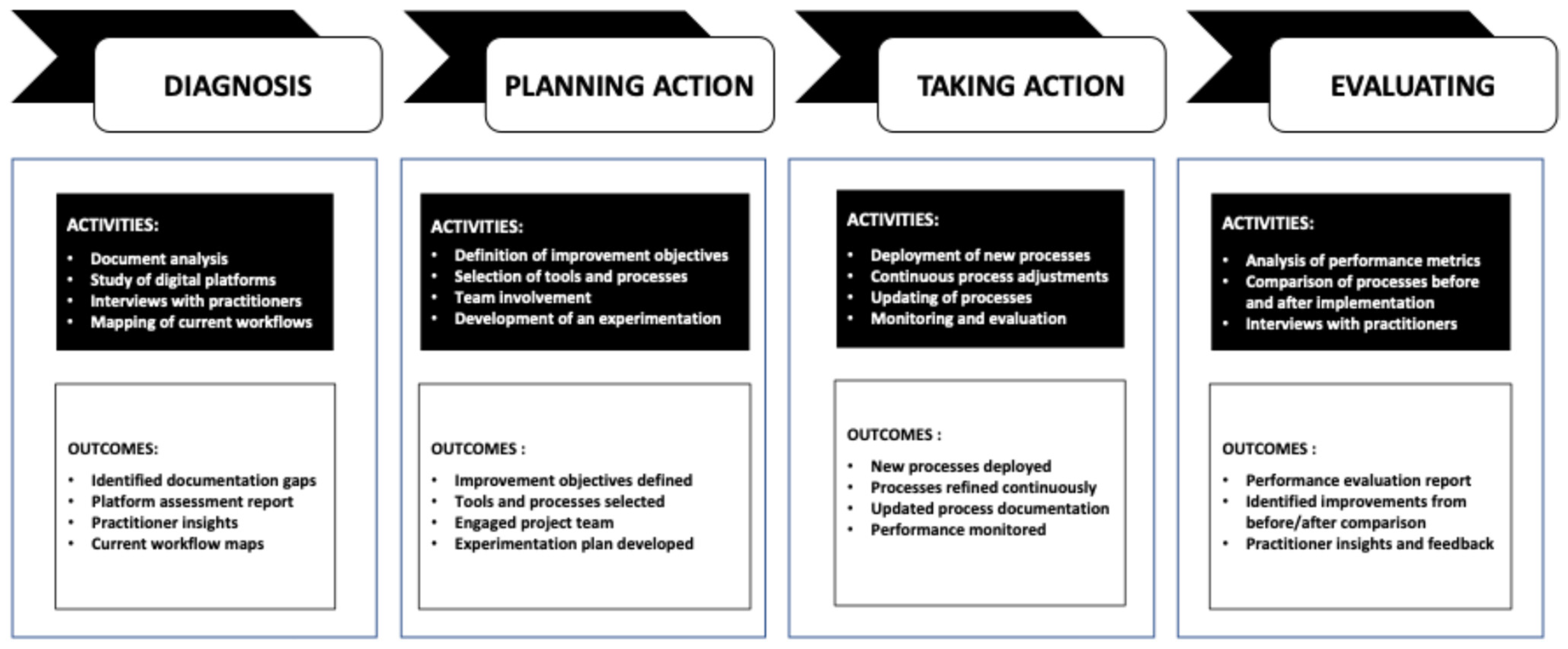

3.2. Research Approach
3.2.1. Diagnosis: Analyzing the Needs and Existing Processes
- How did they actually use the platforms in place?
- Which platform did they use the most?
- How did information flow in practice?
- How was it linked to the documents and elements necessary for construction?
- Which actions were causing time loss?
- How was the tracking process carried out?
- Key process steps: Identification of the starting and ending points of information flows.
- Stakeholders: Visualization of interactions between field teams, document controllers, and other involved parties.
- Interactions: Understanding how information circulates throughout the project.
- Tools used: Integration of digital platforms such as ACC and Aconex, as well as email, Unifier, SharePoint, and others. Aconex is a cloud-based platform that facilitates document exchange, structured workflows, and traceable communications among stakeholders. SharePoint is a collaborative platform that provides document storage, file sharing, and basic versioning features, often serving as a repository within organizations. Autodesk Construction Cloud (ACC) integrates various modules for document management, model coordination, field tracking, and reporting, supporting both design and construction activities. Oracle Unifier is a project controls platform that emphasizes cost management, contract administration, and process standardization. Each of these platforms offers specific functionalities, and their combined or parallel use illustrates the diversity of digital solutions currently available to the construction sector.
3.2.2. Project Planning
- Grouping of Issues: Recurrent problems were first categorized by theme, such as information access, traceability, and cross-platform coordination.
- Formulation of Objectives: These thematic issues were then translated into concrete and achievable objectives, designed to guide the subsequent phases.
- Prioritization of Objectives: Each objective was assessed in terms of criticality, cross-referenced with contractual requirements, and aligned with the issues identified in the diagnostic phase. This enabled the establishment of a clear order of priority.
- Validation with Teams: Finally, the objectives were discussed with the relevant teams to validate their relevance and ensure alignment with field realities.
3.2.3. Implementation
3.2.4. Evaluation
4. Results
4.1. Summary of Identified Needs and Issues
- Workflows were, in most cases, not automated: document controllers were still performing many manual actions, including the attachment of correspondence;
- Few subcontractors were actually present or active on Aconex: many exchanges still occurred via email or through other channels;
- The owner did not systematically respond via Aconex, with some of its departments already using Unifier for certain types of communication.
4.2. Process Mapping and Analysis

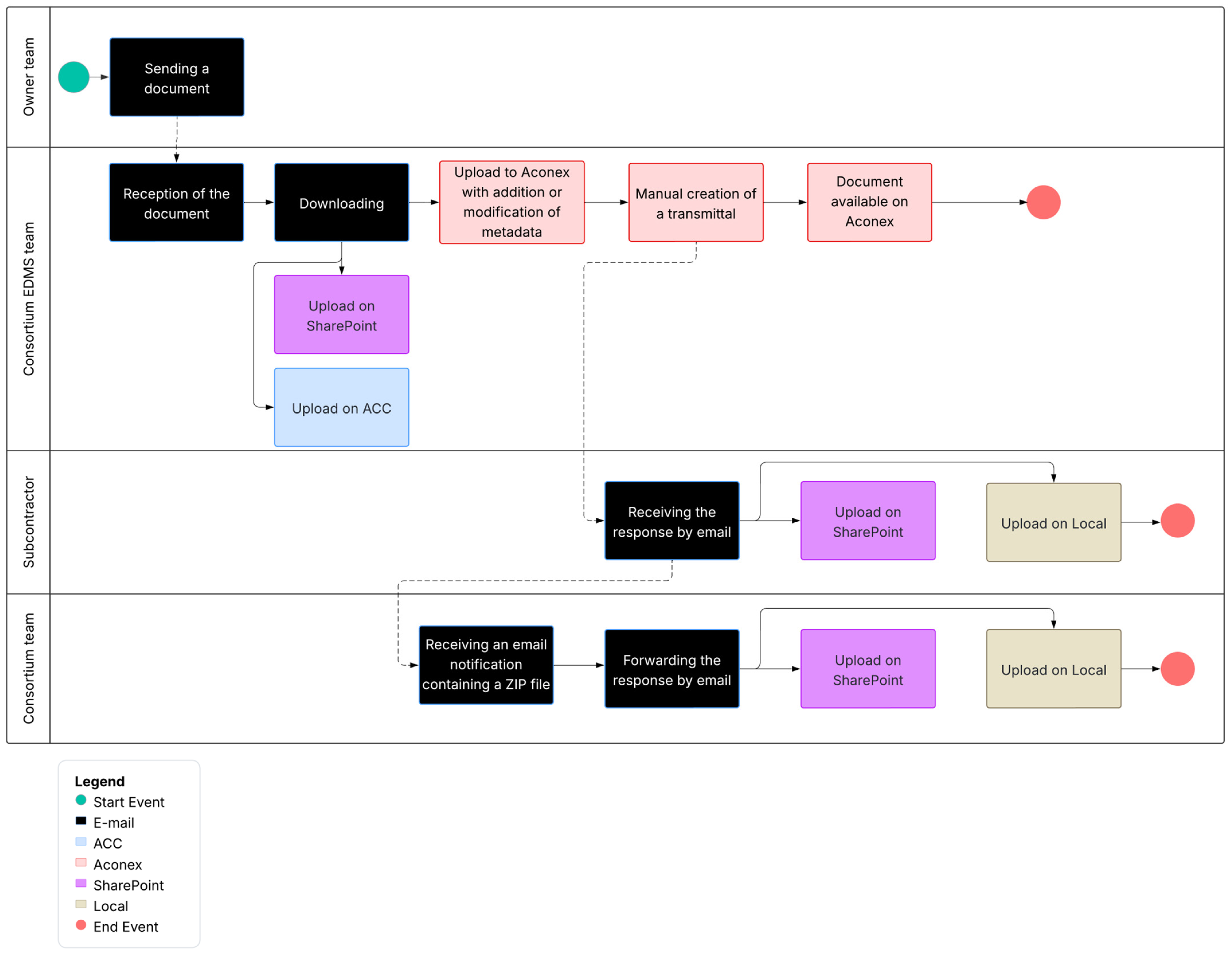

4.2.1. Information and Document Flow from Subcontractor to Client
- Email-based exchanges with subcontractors: All communication and document reviews with subcontractors are conducted outside the official platforms, via basic email, without systematic archiving or guaranteed traceability.
- Bypassing of official tools: Some stakeholders do not use the designated platforms and instead continue to operate according to their established habits (manual transfers, exclusive use of SharePoint, etc.).
- Redundant document deposits: As a direct consequence of the previous point, the same document may be uploaded to Aconex, then transferred to SharePoint and/or saved locally. This leads to duplication and weakens version control. Information becomes isolated from its source, making it impossible for users to ensure they are working with the correct version.
- Lack of clear synchronization with acc: Aligned with the previous issues, document transfers to ACC rely on a script that, in practice, does not function properly due to poorly entered metadata. Documents are misclassified or cannot be located, which significantly limits the usability of ACC in the field. As a result, document transfers are carried out manually rather than automatically.
- Numerous manual actions: Codification, envelope creation, workflow initiation, and attachment of correspondence are all performed without automation, increasing the risk of human error and causing delays. While some manual actions are unavoidable, it is both possible and necessary to reduce their number.
- Parallel and unsynchronized circuits: Although Aconex is intended to be the official platform, the gradual implementation of Unifier by the owner further disrupts the continuity of processes. This adds yet another layer of mandatory manual transfer.

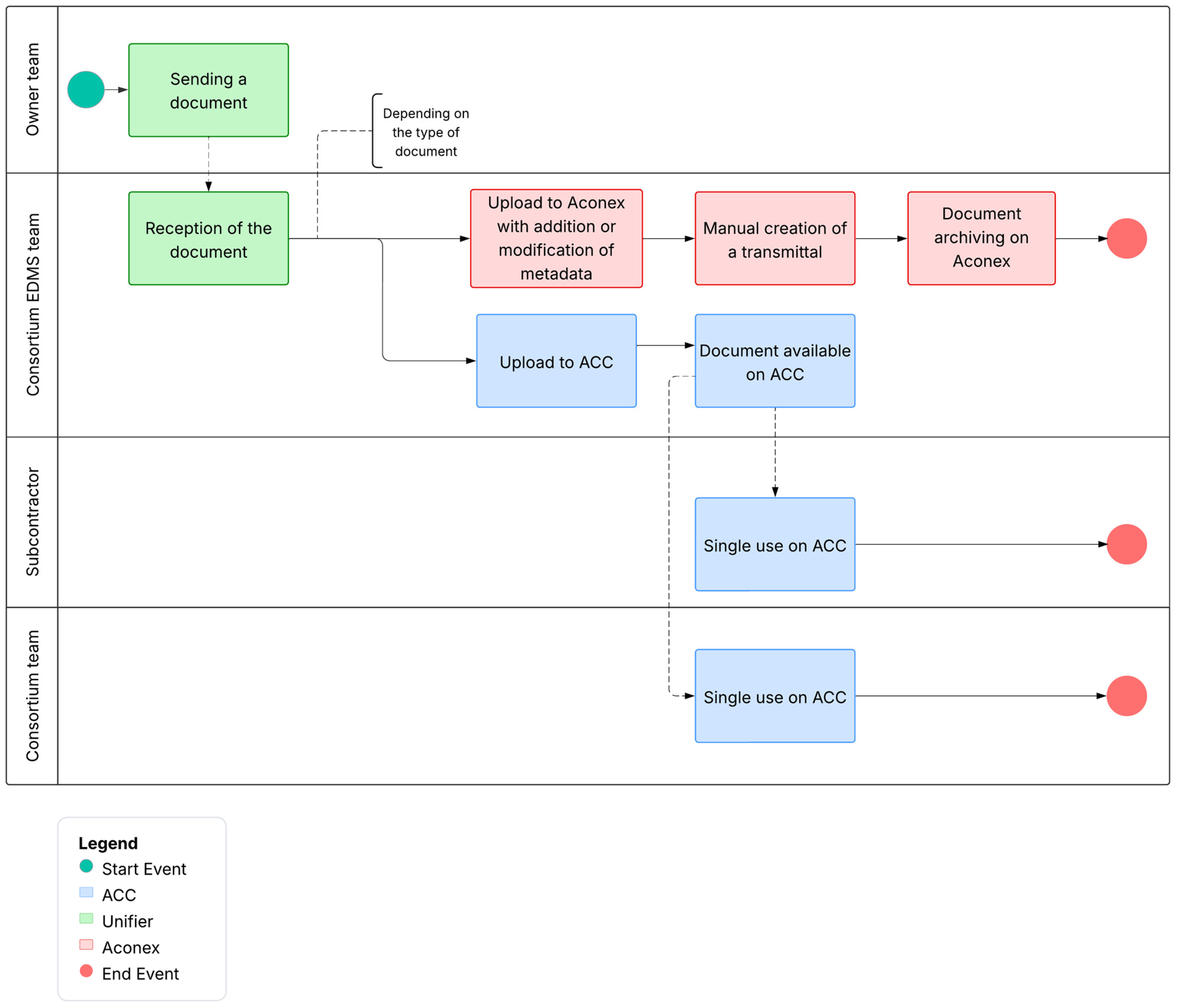

4.2.2. Information and Document Flow from Client to Subcontractor
4.3. Action Plan
4.3.1. Definition of Improvement Objectives
- Make construction documents available through a single access point, by promoting a work platform that centralizes information and connects data sources;
- Ensure the reliability of the information distributed, by reducing the risks of duplication, conflicting versions, or data loss;
- Regulate the exchange and transmission of documents, particularly with subcontractors and laboratories, in order to limit email communication and formalize information flow processes;
- Reduce manual tasks and low-value-added actions for teams, such as document searches, redundant sending, or non-automated process management;
- Ensure continuous monitoring between construction activities and quality requirements, by facilitating the link between production documents and quality control elements.
4.3.2. Selection of Platforms to Be Used
4.3.3. Mapping of the New Processes
4.3.4. Experimentation Plan
- Test Project and dedicated development environment: A test project was set up to centralize all preparatory developments, serving as a space to configure folder structures in ACC, create standard forms, simulate workflows, and model practical use cases. It also helped identify potential technical issues, such as interoperability, permissions, and ergonomics, while assessing how the system would integrate with other platforms.
- Presentations and validation exchanges: At the conclusion of the initial developments, presentation sessions were organized with the concerned teams, particularly quality and document management, the key decision-makers for the processes. These exchanges aimed to present the proposed operating logic, confront the scenarios with the reality of practices on-site, and gather targeted feedback, critiques, and adjustments before the test in real conditions. Since Document Management was responsible for Aconex, these exchanges allowed for a better understanding of the interface between ACC and Aconex to optimize the information exchange.
- Progressive deployment: Finally, the experimentation was deployed progressively. Initially, for processes involving the construction team, a construction site was selected as the “pilot” site, due to the advanced state of its works. For other processes, a group of individuals was selected to test with participants who were expected to use the process. Next, for the construction processes, the experimentation was extended to another construction site, stemming from another contract, in order to test the processes in a different operational context while maintaining a monitoring logic. The second site was selected based on three main criteria: (1) the use of a CDE platform that was actively adopted by project stakeholders, (2) the involvement of multiple disciplines requiring intensive coordination, and (3) the availability and willingness of the project team to participate in interviews and provide access to project data. This complementary case allowed us to strengthen the robustness of the analysis and demonstrate the broader applicability of the framework. For the remaining processes, the group of individuals concerned was expanded. Finally, a phase of generalization to all sites and all relevant personnel on the project was initiated, based on the adjustments derived from the initial feedback. This progressive deployment allowed for the approach to be secured and for identified gaps to be corrected in real time.

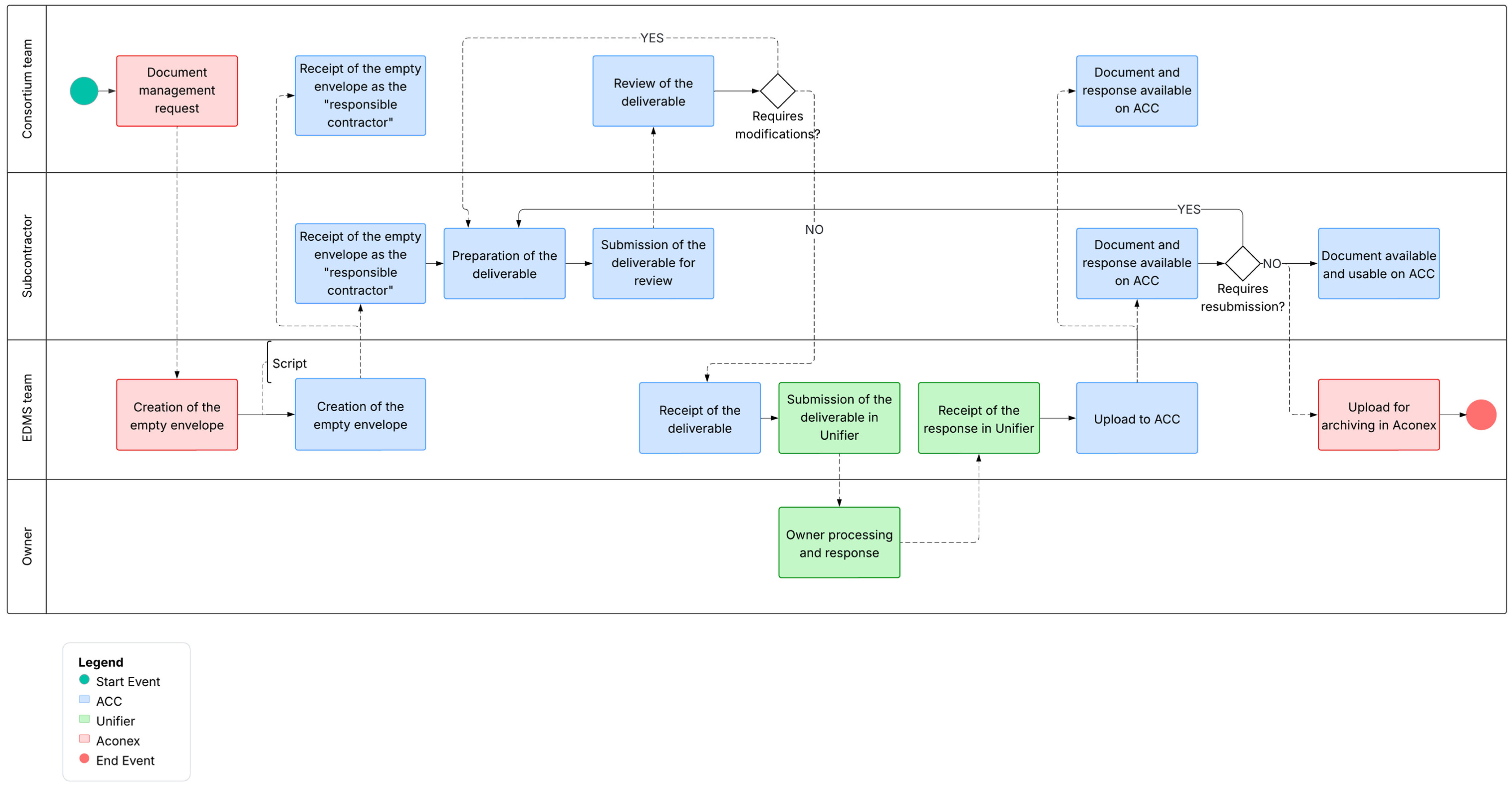

4.4. Implementation of Solutions
- The management process for Technical Questions (TQ), deployed in ACC;
- Internal processes developed for the technical department and methods, aimed at structuring document reviews and monitoring the production of drawings;
- The process for testing requests up to the submission of reports by the laboratory.

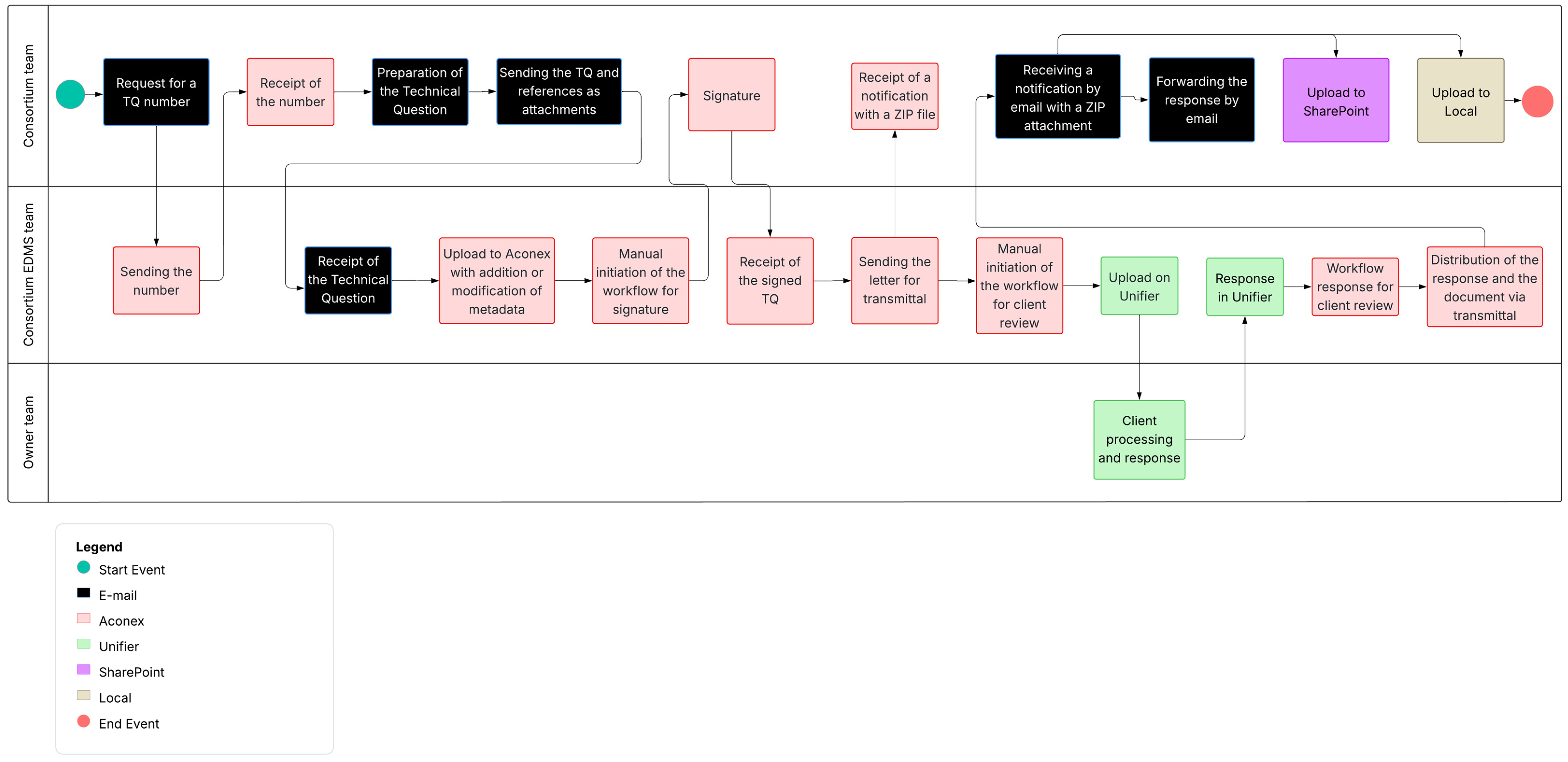

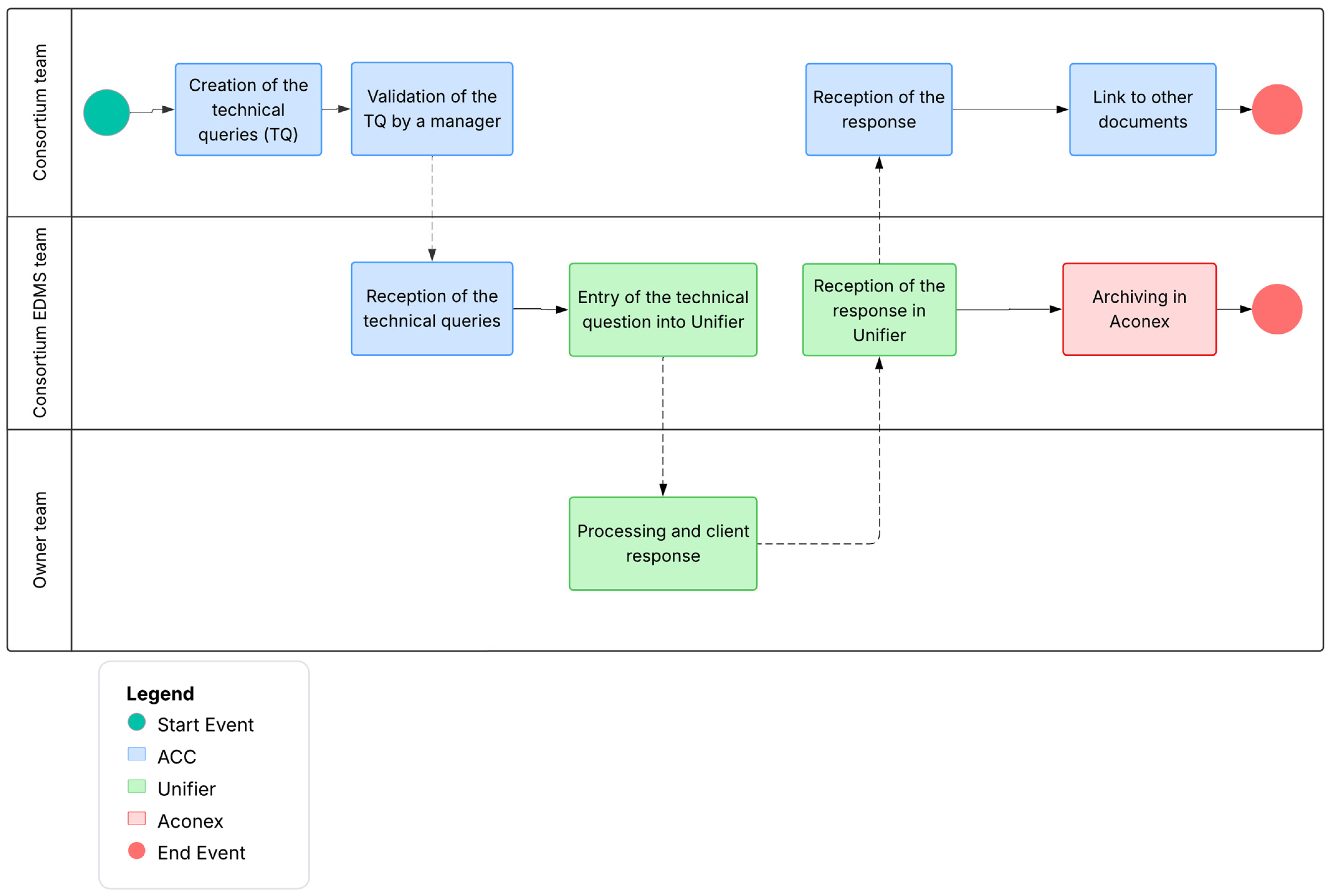

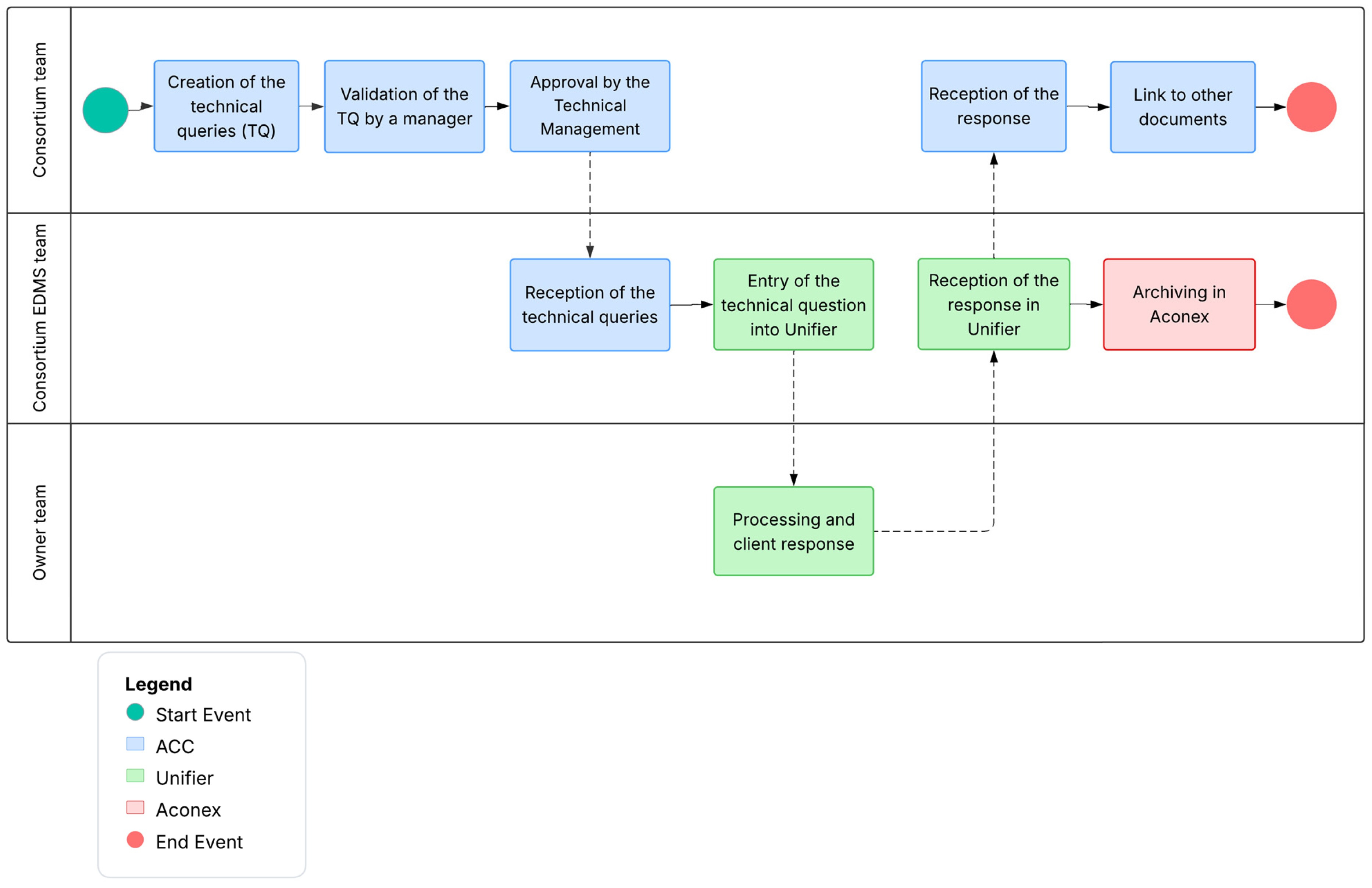

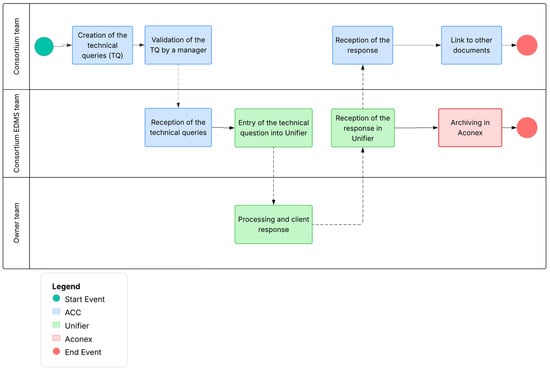

4.4.1. Implementation of the Technical Questions (TQ) Process in Real Conditions
- Filters were added to facilitate the search and management of Technical Questions (TQs). Since TQs are processed by the client in Unifier, there can be a gap between the reception date and the processing date. To address this, we added both the sending and actual receipt dates. This improves the tracking of the TQ lifecycle and ensures more accurate management.
- The default stakeholders were modified to better meet the specific needs of the experiment. The technical department managers needed to view all TQs to assess their impact on design and temporary works. This ensured that the right people were involved from the start, enhancing the efficiency and relevance of interventions.
- Certain steps in the process were simplified to make it more fluid. For example, a step initially required in Aconex was removed, as it became redundant with the introduction of ACC. Specifically, the technical department was an entire step in Aconex, whereas making them observers in ACC was sufficient. This helped reduce delays and streamlined the process, improving overall efficiency.
- Targeted reminders were implemented to encourage good practices and proper information sharing within ACC. These reminders ensure that all stakeholders follow the established protocols and use the tools optimally, enhancing the quality and consistency of shared information.
- Initially, there was confusion regarding the platform to use for creating TQs, due to the historical use of Aconex for formal document exchanges.
- There was reluctance to change established practices, especially among users who had previously managed TQs via email or shared files. This was exacerbated by the lack of clear directives from the management during the first weeks, which led to a temporary coexistence of the process in both ACC and Aconex. This situation resulted in double entry of Technical Questions and operational confusion.
- Additionally, the document management technicians, the primary users of the process, were unfamiliar with ACC, as they had exclusively worked with Aconex until then. The switch in platforms was perceived as a significant break from their familiar methods.

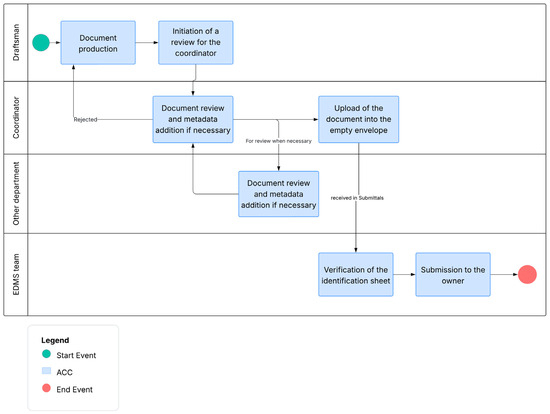

4.4.2. Implementation of Internal Processes at the Technical Department

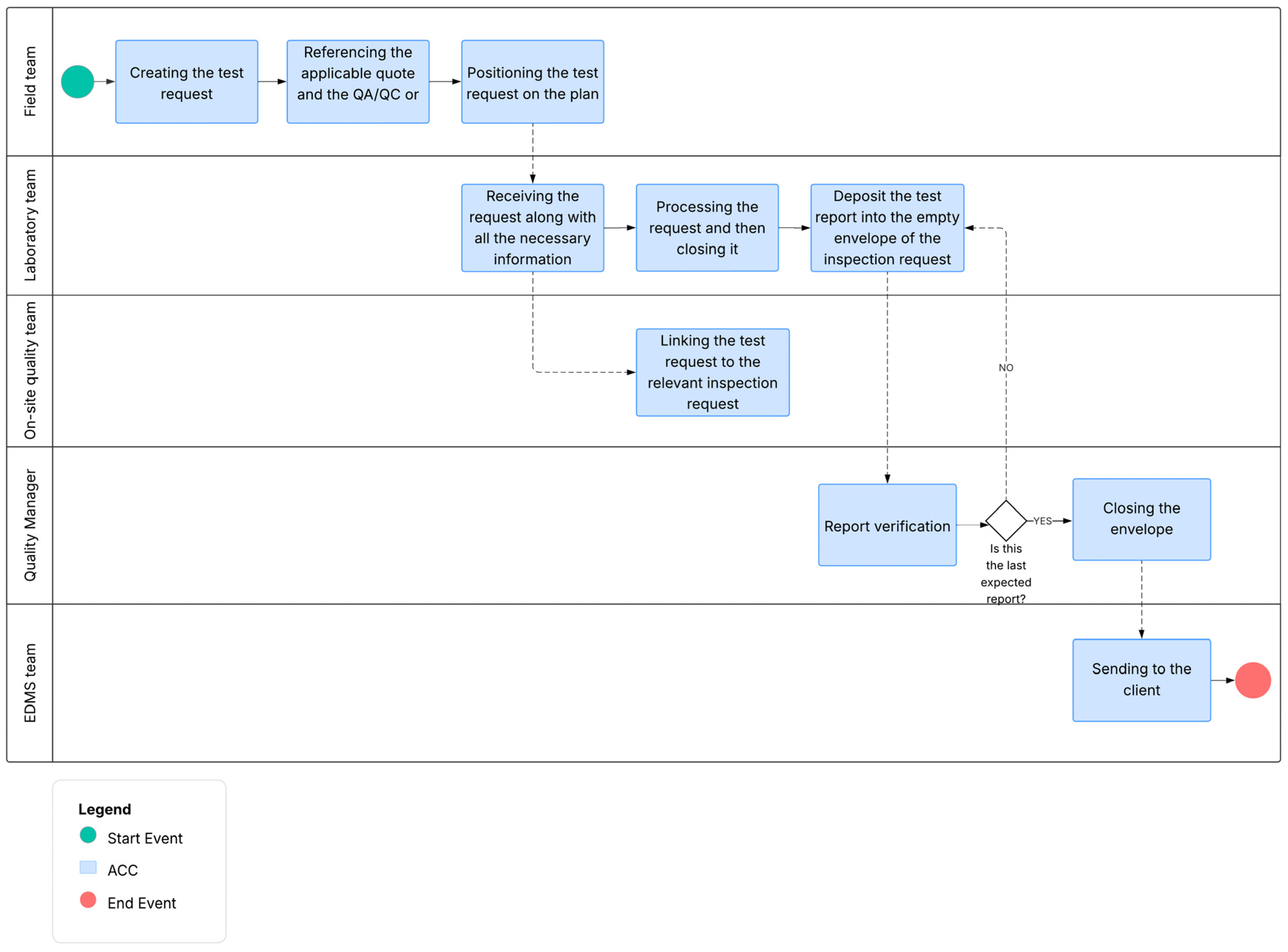

4.4.3. Implementation of the Laboratory Test Request Process
4.5. Evaluation
4.5.1. Comparison of Processes Before, During, and After Implementation
4.5.2. Achievement of Objectives
5. Discussion
5.1. Summary of Results
5.2. Key Success Factors for Sustainable Adoption
5.3. Project Limitations and Areas for Improvement
5.4. Lessons Learned
6. Conclusions
Author Contributions
Funding
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
References
- Doloi, H. Cost Overruns and Failure in Project Management: Understanding the Roles of Key Stakeholders in Construction Projects. J. Constr. Eng. Manag. 2013, 139, 267–279. [Google Scholar] [CrossRef]
- Shiau, Y.-C.; Lu, L.-T.; Lee, Y.-L.; Lu, Y.-M.; Chan, J.-C. Establish traceability system for construction projects in BIM environment. ICIC Express Lett. Part B Appl. 2013, 4, 1159–1166. [Google Scholar]
- Alashwal, A.M.; Fong, P.S.-W. Empirical Study to Determine Fragmentation of Construction Projects. J. Constr. Eng. Manag. 2015, 141, 04015016. Available online: https://ascelibrary.org/doi/full/10.1061/%28ASCE%29CO.1943-7862.0000986 (accessed on 22 September 2025). [CrossRef]
- Ramabodu, M.S.; Verster, J. Factors Contributing to Cost Overruns of Construction Projects. In Proceedings of the 5th Built Environment Conference, Durban, South Africa, 18–20 July 2010; pp. 131–143. [Google Scholar]
- Frimpong, Y.; Oluwoye, J.; Crawford, L. Causes of delay and cost overruns in construction of groundwater projects in a developing countries; Ghana as a case study. Int. J. Proj. Manag. 2003, 21, 321–326. [Google Scholar] [CrossRef]
- Preidel, C.; Borrmann, A.; Mattern, H.; König, M.; Schapke, S.-E. Common Data Environment. In Building Information Modeling; Springer International Publishing: Cham, Switzerland, 2018; pp. 279–291. [Google Scholar] [CrossRef]
- Bedoiseau, M.; Martin, D.; Boton, C. Use of KROQI as a Level-2 Common Data Environment in the French Construction Industry. Sustainability 2022, 14, 10455. [Google Scholar] [CrossRef]
- Lefebvre, G.; Boton, C. The Golden Day: Using Common Data Environments to Improve the Response Time in the Management of Change Orders. In Proceedings of the CIB W78, Luxembourg, 11–15 October 2021; pp. 751–761. [Google Scholar]
- Odriozola, S.; Manchado, C.; Gomez-Jauregui, V.; Otero, C. Requirements of a Common Data Environment (CDE). Study Case of VIRCORE. In Proceedings of the International Conference on The Digital Transformation in the Graphic Engineering, Valencia, Spain, 24–25 June 2021; pp. 30–37. [Google Scholar]
- BS PAS 1192-2:2013; Specification for Information Management for the Capital/Delivery Phase of Construction Projects Using Building Information Modelling. The British Standards Institution: London, UK, 2013.
- Building and Construction Authority. Singapore BIM Guide; the Building and Construction Authority: Singapore, 2012.
- UK BIM Alliance. Information Management According to BS EN ISO 19650 Guidance Part 1: Concepts; UK BIM Alliance: London, UK, 2019. [Google Scholar]
- Radl, J.; Kaiser, J. Benefits of Implementation of Common Data Environment (CDE) into Construction Projects. IOP Conf. Ser. Mater. Sci. Eng. 2019, 471, 022021. [Google Scholar] [CrossRef]
- Werbrouck, J.; Pauwels, P.; Beetz, J.; van Berlo, L. Towards a Decentralised Common Data Environment using Linked Building Data and the Solid Ecosystem. In Proceedings of the 36th CIB W78 2019 Conference, Newcastle, UK, 18–20 September 2019; pp. 113–123. [Google Scholar]
- Comiskey, D.; McKane, M.; Jaffrey, A. Comparing Common Data Environments Platforms for Students Collaborative Working. In Healthy Buildings: Innovation, Design & Technology, ICAT 2016, Proceedings of the 6th International Congress of Architectural Technology, Alicante, Spain, 12–14 May 2016; University of Alicante: Alicante, Spain, 2016; pp. 213–231. [Google Scholar]
- Guo, B.; Feng, T. Mapping Knowledge Domains of Integration in BIM-Based Construction Networks: A Systematic Mixed-Method Review. Adv. Civ. Eng. 2019, 2019, 5161579. [Google Scholar] [CrossRef]
- Khan, K.I.A.; Flanagan, R.; Lu, S.L. Managing information complexity using system dynamics on construction projects. Constr. Manag. Econ. 2016, 34, 192–204. [Google Scholar] [CrossRef]
- Ruparathna, R.; Hewage, K. Review of Contemporary Construction Procurement Practices. J. Manag. Eng. 2015, 31, 04014038. [Google Scholar] [CrossRef]
- Oraee, M.; Hosseini, M.R.; Banihashemi Namini, S.; Merschbrock, C. Where the Gaps Lie: Ten Years of Research into Collaboration on BIM-Enabled Construction Projects. Constr. Econ. Build. 2017, 17, 121. [Google Scholar] [CrossRef]
- Lahdenperä, P. Making sense of the multi-party contractual arrangements of project partnering, project alliancing and integrated project delivery. Constr. Manag. Econ. 2012, 30, 57–79. [Google Scholar] [CrossRef]
- Scherer, R.J. From Industy 4.0 to Construction 4.0. In Proceedings of the World Construction Forum. Building and Infrastructure Resilience, Ljubljana, Slovenia, 8–11 April 2019. [Google Scholar]
- Roland Berger GmbH. Digitization in the Construction Industry. Building Europe’s Road to “Construction 4.0”; Roland Berger GmbH: Munich, Germany, 2016; pp. 1–16. [Google Scholar]
- Boton, C.; Forgues, D. Construction 4.0: The Next Revolution in the Construction Industry; CanBIM Innovation Spotlight Publication 2020; Espace ÉTS: Montréal, QC, Canada, 2020. [Google Scholar]
- Klinc, R.; Turk, Ž. Construction 4.0—Digital Transformation of One of the Oldest Industries. Econ. Bus. Rev. 2019, 21, 4. [Google Scholar] [CrossRef]
- Boton, C.; Rivest, L.; Ghnaya, O.; Chouchen, M. What is at the Root of Construction 4.0: A Systematic Review of the Recent Research Effort. Arch. Comput. Methods Eng. 2020, 28, 2331–2350. [Google Scholar] [CrossRef]
- Kalay, Y.E. Enhancing multi-disciplinary collaboration through semantically rich representation. Autom. Constr. 2001, 10, 741–755. [Google Scholar] [CrossRef]
- Sacks, R.; Eastman, C.; Lee, G.; Teicholz, P. BIM Handbook: A Guide to Building Information Modeling for Owners, Designers, Engineers, Contractors, and Facility Managers; Wiley: Hoboken, NJ, USA, 2018. [Google Scholar]
- Crotty, R. The Impact of Building Information Modelling: Transforming Construction; SPON Press: Milton Park, UK, 2012. [Google Scholar]
- Boton, C.; St-Pierre, É.; Lefebvre, G. Should medium-sized contractors still implement home-made information technologies on construction sites? Front. Eng. Manag. 2020, 7, 142–158. [Google Scholar] [CrossRef]
- Koshy, E.; Valsa, K.; Waterman, H. What is action research? In Action Research in Healthcare; SAGE: Los Angeles, CA, USA, 2010; pp. 1–24. [Google Scholar]
- Azhar, S.; Ahmad, I.; Sein, M.K. Action research as a proactive research method for construction engineering and management. J. Constr. Eng. Manag. 2010, 136, 87–98. [Google Scholar] [CrossRef]
Category | Contractual Needs (Client) | Internal Needs (Consortium) |
---|---|---|
Document management | – Updated RDL – Annotated plans (as-built) – Revision tracking – Drafts linked to schedule | – Centralization of information – Easy search – Reduction of duplicates |
Traceability/compliance | – Formal validation workflow – Archiving of letters and deliverables – Clear statuses | – Ensure the document is up to date – Accessible history – Simple traceability |
Quality | – PIE – Hold points – Tracking of non-conformities (NCR, DAC) | – Digitalization of quality tracking – Automation of reports and follow-ups |
BIM/modeling | – Weekly model submissions – Clash detection – Constructability reviews | – Shared environment for modeling – Synchronization between models and documents |
Planning and progress | – Progress tracking – Progress dashboard – Shared schedules | – Clear link between documents and schedule – Easy visualization on site |
Tools interoperability | – Unified tool used by the owner – Compliance with required format | – Clarification of the ACC’s role – Simplified platform exchange |
Usability and on-site | – Annotate, highlight, measure on plans – Quick access on site | |
External relationships | – Access to deliverables for the owner – Client exchange management | – Traceability with subcontractors – Fast and secure sharing |
Support and Training | – Need for tool training – Support during change |
Risk | Description |
---|---|
No guarantee of up-to-date version | Multiple sources of the same document exist; there is no guarantee that the one consulted on site is the correct one, as no one checks directly in Aconex. |
Distribution errors | Manual actions (coding, attachment, distribution) are subject to omissions or incorrect handling. |
Loss of traceability | Exchanges take place via email or SharePoint without formal archiving. In case of a dispute, the justifications are difficult to retrieve. |
Loss of time | Non-automated workflows and multiple submissions cause delays in information distribution. |
Inefficient use of ACC | The platform is not used as intended: documents arrive in a random or incomplete manner. |
Confusion between platforms | No clear rule defines which tool should be used for which type of document or process. |
Contractual risk | If a transmitted document is not the validated or up-to-date version, it may lead to liability for the contractor toward the owner. |
Risk | Description |
---|---|
Multiple Submission Points | Documents are copied across multiple platforms: SharePoint, local servers, ACC. This increases workload and multiplies the versions in circulation. |
Lack of a Single Official Channel | There is no guarantee that the subcontractor receives the information via Aconex, as contractually required. Responses are sent only by email, without archiving. |
Very Low Traceability | No system reliably verifies whether a document was sent to the right person or at what time. |
Longer Processing Time | Lack of automation (uploading, submission, notifications) causes delays in dissemination, especially during major updates. |
Contractual Risk | The contractor is supposed to ensure that subcontractors work with valid documents. However, the multiple detours and channels used weaken this guarantee. |
Risk | Description |
---|---|
Transmission delay | Lengthening of processing times |
Loss of traceability between the TQ and its response | Impossible to prove that the TQ was processed or received |
Incorrect version | Execution of work based on outdated information |
Contractual risk in case of failure to consider a TQ response | Liability of consortium questioned |
Incomplete or erroneous dissemination | Lack of reliability in document management |
Non-positioning of TQs on the plans | Risk of error or oversight on the ground |
Duplication of information between platforms | Scattered information and divergent versions |
Category | Criteria | ACC | Aconex | SharePoint |
---|---|---|---|---|
Field | Field adoption/usability | 3 | 3 | 3 |
BIM support and plan visualization | 5 | 4 | 0 | |
Interoperability | 4 | 3 | 2 | |
Accessibility on mobile devices | 5 | 5 | 2 | |
Ability to work offline | 5 | 3 | 0 | |
Search capability | 5 | 5 | 2 | |
Navigation within the drawings | 5 | 3 | 3 | |
Subtotal | 32 | 26 | 12 | |
Document management | Information centralization | 5 | 5 | 3 |
Traceability/Logging | 5 | 5 | 1 | |
Archiving/Contractual reference | 3 | 4 | 2 | |
Access rights management | 3 | 5 | 2 | |
Folder organization | 5 | 1 | 2 | |
Customizable metadata | 5 | 5 | 1 | |
Status tracking | 4 | 5 | 0 | |
Timestamp/Signature | 4 | 5 | 0 | |
Subtotal | 34 | 35 | 11 | |
Automation and processes | Automation/workflow | 5 | 5 | 0 |
Internal validation | 5 | 5 | 0 | |
Automatic notifications | 5 | 5 | 0 | |
Interactive forms | 5 | 3 | 0 | |
Reports/Dashboards | 5 | 4 | 0 | |
Deadlines and reminders | 3 | 5 | 0 | |
Cross-referencing between documents | 5 | 3 | 0 | |
Subtotal | 33 | 30 | 0 | |
User experience | User-friendly navigation | 5 | 3 | 3 |
Loading time | 4 | 4 | 4 | |
Simplicity of common tasks | 3 | 3 | 2 | |
Ease of use without training | 5 | 3 | 3 | |
Interface consistency | 5 | 3 | 3 | |
Customizable interface | 5 | 5 | 3 | |
Integrated user support | 5 | 5 | 2 | |
Subtotal | 32 | 26 | 20 | |
TOTAL | 131 | 117 | 43 |
