1. Introduction
In the past few decades, public–private partnerships (PPPs) have attained an enviable spot in project delivery in every nation (
De Matteis et al. 2025).
Atamanov et al. (
2020) mentioned that 40–60% of the public infrastructure in many countries has been delivered by PPP arrangements between public institutions and private financiers. Projects such as the hospital of the University of Sunshine Coast (Australia), Enugu-Port Harcourt Road (Nigeria), Saglemi affordable public houses (Ghana) and the Shenzhen light rail (China) are prime examples PPP infrastructure (
Chileshe et al. 2022). These infrastructure projects generate a significant amount of carbon emissions with negative implications for climate change.
Akomea-Frimpong et al. (
2024) revealed that 20–33% of carbon emissions are associated with PPP infrastructure.
Batra (
2023) broke down the constituents of the carbon emissions of PPP projects as embodied (23%) and operational (77%). The source of embodied emissions includes the use of oil, bitumen, natural gas and other fossil fuel materials to carry out the projects (
Wang et al. 2024). Operational carbon emissions are generated from the cooling, lighting, maintenance and heating of the infrastructure (
Kumar et al. 2023).
Che et al. (
2024) and
Ali et al. (
2024) also argued that the negative effects of carbon emissions create extreme climate risks for PPP infrastructure.
The impact of climate change on PPP infrastructure has been widely reported in the literature and mass media. For instance, in early 2025, about 16,000 homes and valuable public properties in Southern California (United States) were burnt down by wildfires (
Amiri et al. 2025). A consequence of this incident was the culmination of an insurance crisis where parties to partnership contracts supporting mortgages and the operation of the structures (properties) experienced huge financial losses (
Xu et al. 2025). In the Guangdong Province of China, a section of the freeway (road network) was swept away by a heavy downpour of rain, including twenty (20) cars and forty-eight (48) people (
Xue et al. 2025). Three countries (Germany, Belgium and the Netherlands) within Europe have recorded the deaths of over one hundred (100) people and the destruction of many critical structures within the last two years due to torrential rain which is linked to climate change (
Birkmann et al. 2025). Between 1995 and 2025, Brazil has reported more than nine thousand cases of infrastructure damage caused by climatic risks (
de Souza et al. 2024). Sub-Sharan African countries continue to experience long delays in the completion of infrastructure as a result of unfavourable weather, with existing infrastructure not built to withstand climate change (
Fagbemi et al. 2025).
To manage these climate risks, there is an ongoing effort in the global PPP infrastructure sector to decarbonize and incorporate sustainable climate actions in alignment with the Paris Climate Accord and the Sustainable Development Goals or SDGs (
Ali et al. 2024;
Cheng et al. 2021). However, there is limited empirical information about this important issue for PPP infrastructure. Moreover, a thorough search and review of documents from databases such as Scopus, Web of Science and Google Scholar demonstrate insufficient investigations into climate risk strategies suitable for PPP infrastructure delivery models. For example,
Giesekam et al. (
2018) and
Sweet (
2019) listed climate change measures for construction projects but the studies failed to delve into their appropriateness for specific project delivery models such as those involving PPP infrastructure. Furthermore, the reviewed project reports demonstrate a lack of practice frameworks and policies aimed at ensuring PPP projects meet climate targets (
Huang et al. 2021;
Jin et al. 2025).
Liu et al. (
2022) also mentioned that very few studies on this topic have focused on the construction, demolition and waste management stages of PPP projects rather than the entire lifecycle. Therefore, this article’s purpose is the examination of the interrelationships between strategies for the climate risk management of PPP infrastructure projects. The implementation of the findings from this study is expected to support the understanding and development of strategies to achieve long-term net-zero and climate goals in PPP infrastructure. The next sections include a literature review, the conceptual framework, the method of study, a discussion of the findings and the conclusion.
3. Hypothesis Development

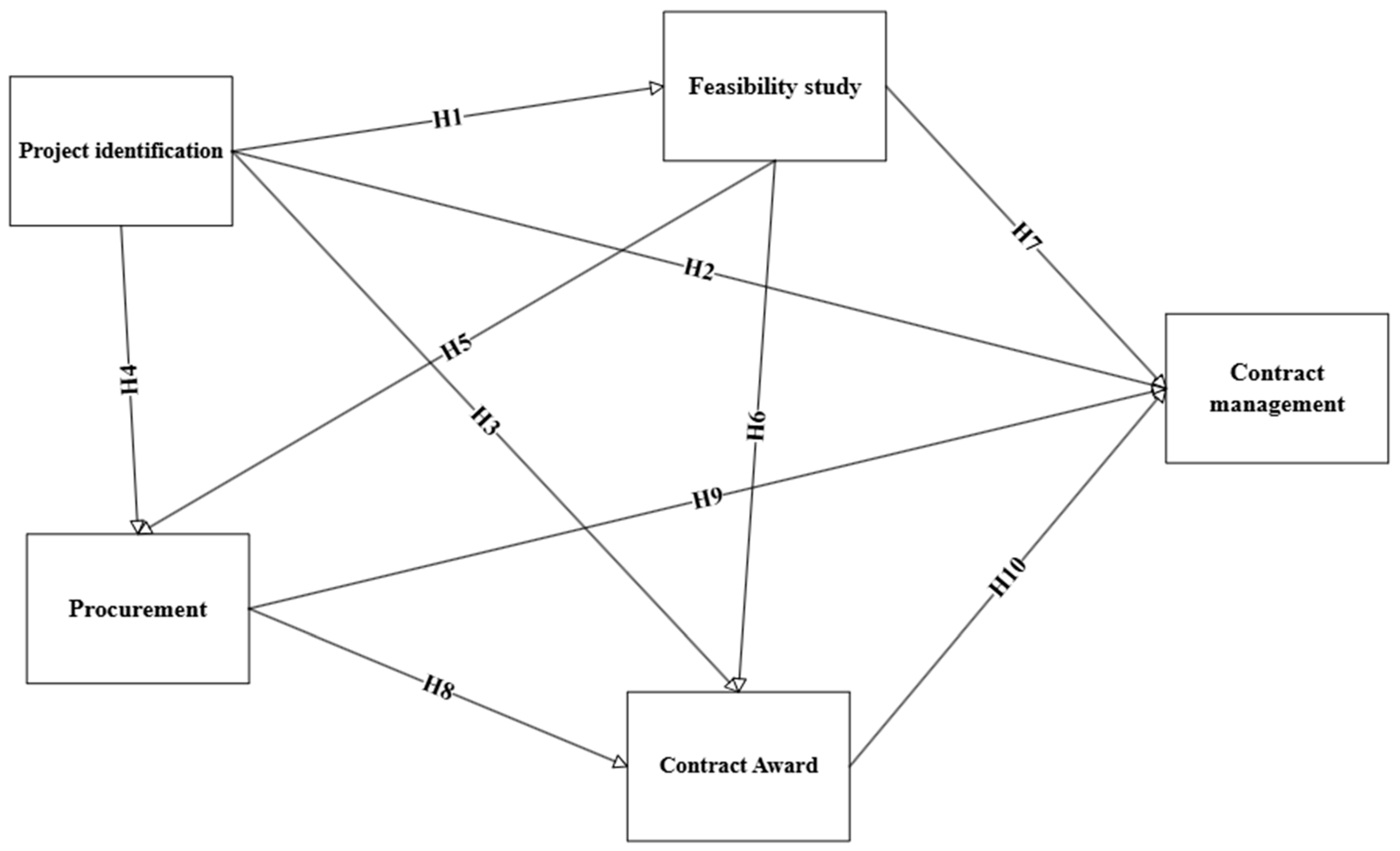

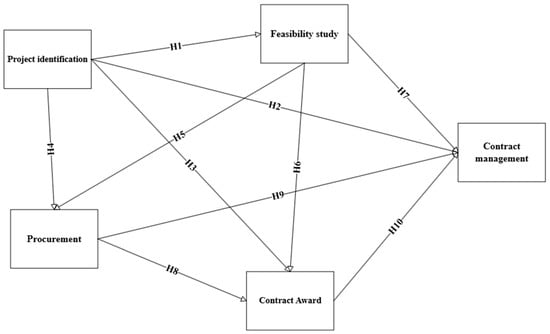

Figure 1 illustrates the five categories of strategy used to address climate risks in PPP infrastructure using the lifecycle stages of PPP projects from
PPIAF (
2009). It demonstrates the constructs (latent variables), which are the five groups of climate risk management strategies. It begins with the strategy involving the identification of projects. This strategy includes the setting and assessment of climate resilience targets for existing infrastructure (
Tipu et al. 2024). Further, this strategy enhances carbon emitting measures by setting carbon emission reduction targets. For new infrastructure projects,
Nguyen et al. (
2024) proposed the identification and selection of green and climate-resilient projects. Within this first strategy, climate targets should be set with a well-defined scope to mitigate potential risks.
Alqahtani et al. (
2024) argued for the involvement in this strategy of project leaders who have experience in selecting and executing climate-friendly PPP projects. Additionally,
Ampratwum et al. (
2023) argued that the project identification stage offers the chance to brainstorm ideas and experiences about the best way to manage climate risks. Senior project managers who have led similar climate-conscious projects in the past should lead discussions towards climate change solutions.
Lupton et al. (
2021) stated that the root cause of the vulnerability of projects to climate change should be identified and thoroughly discussed, including solutions to overcome it in the future.
Kim et al. (
2024) identified the goals, the location and the type of project as key strategy points to consider at this stage. There should be clear goals related to climate change that align with the short-term and long-term organizational values.
At this stage of the project, the following is hypothesized:
H1. Project identification strategies influence feasibility study strategies.
H2. Project identification strategies influence contract management strategies.
H3. Project identification strategies influence awarding of contract strategies.
H4. Project identification strategies influence procurement strategies.
In the next stage of feasibility assessment, the goal is to ascertain the practicality and impacts of the proposed project identification strategies to manage climate change (
Cheng et al. 2021;
Saif et al. 2025). There is a range of feasibility assessments suitable for realising the effects of climate risks in PPP projects. These include thermal resilience analysis (
Osei-Kyei and Ampratwum 2025), carbon emission analysis (
Hou et al. 2025), water analysis (
Tariq and Zhang 2022), biodiversity analysis (
Xiao et al. 2025) and people (stakeholder) analysis (
Ngo et al. 2024). Furthermore, the outcomes of feasibility studies enhance the smooth allocation of project resources to manage climate change (
Martimort and Straub 2016). The feasibility assessment encompasses the technical viability of the project. According to
Jiang et al. (
2025), this analysis determines whether there are enough materials and technical resources to counter climate change risks or not. It also involves economic impact assessments of the projects, which reveal the potential costs of addressing climate change (
Akomea-Frimpong et al. 2025b).
Akhtar et al. (
2023) explained that operational climate resilience and adaptation feasibility is another major component that addresses the operating lapses of projects with timeframes within climate change management. These measures require the implementation of climate risk assessments and testing of the applicability of climate models to PPP infrastructure. Therefore, the following is hypothesized:
H5. Feasibility study strategies influence procurement strategies.
H6. Feasibility study strategies influence contract award strategies.
H7. Feasibility study strategies influence contract management strategies.
Utilising sustainable procurement for PPP infrastructure projects is an actionable drive to meet climate targets.
Tipu et al. (
2024) analysed and explained the key climate-friendly materials from suppliers that promote green practices in PPP projects. The study found positive relationships between green supply chain practices and the climate adaptation of projects. Further,
Tuffour et al. (
2024) recounted the role of green procuring strategies in increasing the resilience of projects by 20%.
Montalbán-Domingo et al. (
2023) found that green procurement practices support the purchase of low- to zero-carbon materials, which are important in the management of construction contracts.
Perera et al. (
2021) argued that PPP stakeholders have positive views on projects that are built with renewable and sustainable materials instead of relying on fossil fuel products. Additionally,
Nguyen et al. (
2024) explained that contractors who source energy-efficient materials for the construction and management of projects could win contracts over others who do not practise green procurement. Therefore, strong partnerships with procurement stakeholders to supply recyclable and circular materials for PPP infrastructure are encouraged. The procurement processes should be guided by robust policies that are monitored regularly during contract management.
Thus, the following is hypothesized:
H8 : Procurement strategies influence contract award strategies.
H9 : Procurement strategies influence contract management strategies.
Finally,
Tian et al. (
2024) highlighted that the awarding of climate-induced contracts contributes to the successful management of PPP projects that can withstand climate change. Constantly reviewing climate risks, setting sound governance, and insisting on including sustainable contract requirements shape the climate adaptation and mitigation strategies of PPP projects.
Zhang et al. (
2024) added that the information provided to partners and stakeholders should be improved together with upskilling of workers to combat climate change.
Martimort and Straub (
2016) focused on the positive impacts of sound and climate-conscious contracts during the contract management stage. Their study found that addressing climate change issues during the contract award stage makes it easier for project managers to know what to expect in terms of climate risks when managing projects. Before the contract is awarded, clauses are set by contractors and the owners of the project to minimize climate risks. These clauses cause contractors to pledge their commitment to cut down emissions and incorporate climate practices (
Kumar et al. 2023). The expected punishment (or fines) for going against these clauses is also known before the contract management stage. Therefore, the following is hypothesized:
H10. Contract award strategies influence contract management strategies.
6. Discussion
In accordance with the research objectives and hypotheses set in
Section 1 and
Section 3 of this paper, the first hypothesis, H1 (

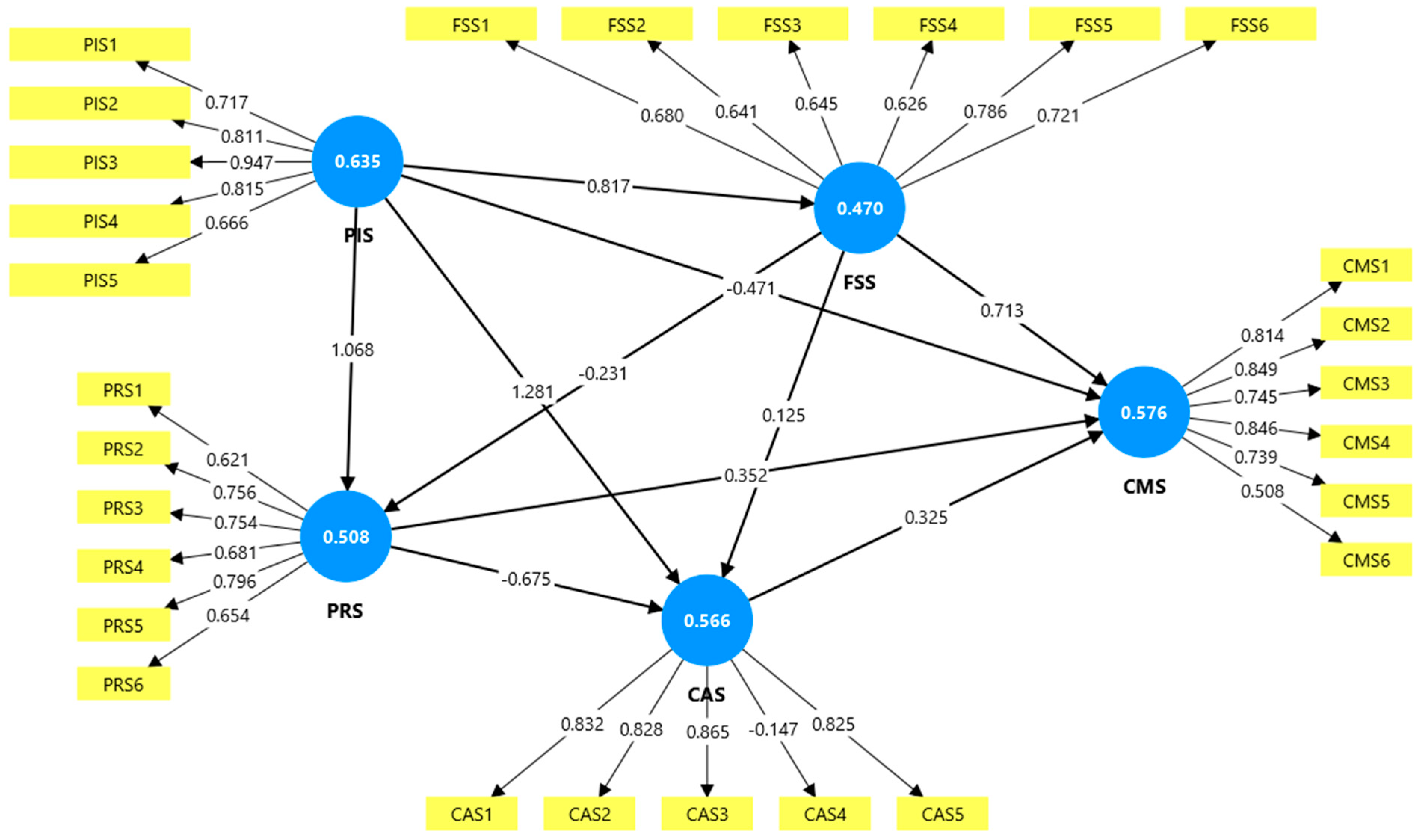

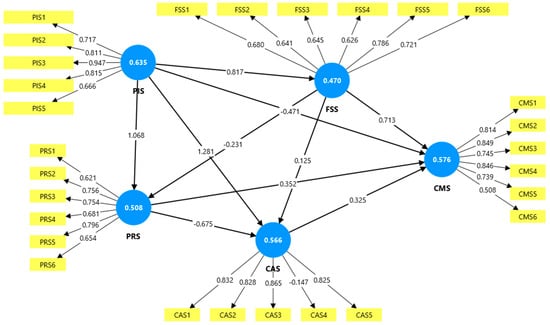

Table 7), confirms that identifying appropriate climate-resilient projects forms the foundation of better PPP project feasibility studies. This means that strategies to identify climate-friendly PPP infrastructure are essential in assessing the viability of PPP projects against the climate crisis.
Casady et al. (
2024) mentioned that these strategies determine the scope of threats, taking into account the extent and magnitude of potential climate risks at project proposal meetings.
Lupton et al. (
2021) expanded this with empirical evidence of the identifying climate adaptation and resilience issues at the identification stage of the projects. With respect to H2, the results in
Table 6 indicate rejection of the relationship between project identification and contract management. This means that identifying the right climate-conscious projects may not have any influence on ensuring the management of contracts that respond adequately to climate change. This is opposed by
Akomea-Frimpong et al. (
2024), whose research findings argue that project identification influences climate actions related to the contract management of PPP projects. Moreover, climate action documents from the governments of OECD countries such as Australia, Canada and New Zealand, for instance, recognize the strong links between project identification, the climate and the contract management strategies of PPP infrastructure (
Nguyen et al. 2024). This outcome for H2 provides a viable avenue for further studies to ascertain the relationship between the two climate risk measures. It is suggested that actionable measures should be effectively incorporated into project identification measures and practices at the contract management stage of the project (H2). This will demand appropriate timelines and resources to turn the targets into realistic outcomes for climate risk management. Leadership support is crucial in this, and the project steering committee and project leads should support the regular training of project team members to educate them on practical actions to resolve the climate crisis. There must be a team or senior project manager who will specifically supervise and monitor the transformation of the targets into elements of the contract within a defined scope. In the case of H3 and H4, project identification strategies were found to significantly influence contract award and procurement protocols. Increasingly, public projects that are executed within PPP arrangements have seen climate requirements as a key prerequisite in awarding contracts (
Amin 2025). Governments are taking note of bidding and procurement contractors who can accept and manage climate risks. Contractors who fail to incorporate and comply with climate-friendly procurement practices are likely to lose contracts or be fined. This scenario has been identified in the United Kingdom (UK), where more than 30 government contractors were fined for a lack of due diligence to safety and environmentally conscious practices towards reducing carbon emissions (
GovUK 2022).
Table 6 also demonstrates that two (H5 and H7) out of the three hypotheses on feasibility studies of the climate risks of PPP projects were found to be empirically significant. Sustainable feasibility studies influence procurement and contract management-based climate actions (
Batra 2023, Shivanna 2022).
Wang et al. (
2023) recounted that environmentally conscious feasible studies on mechanisms and systems, such as the studies on heat pumps and the carbon performance levels of infrastructure, are important in assessing the carbon emission status of projects. The feasibility analysis also considers the social support systems available within emission-neutral projects to assist community development and foster the preservation of indigenous cultures. Lastly, comprehensive feasibility analysis enhances the financial viability of PPP projects because it provides information about cost drivers on climate risks. When these cost drivers are managed effectively, they could improve the financial outcomes of the projects. Despite these outcomes, H6 discounts the relevance of feasibility studies in awarding climate-friendly contracts in the PPP sector. This finding is contrary to existing studies such as
Martimort and Straub (
2016) and
Feng et al. (
2024), which mentioned that feasibility is an integral part of awarding climate-sensitive contracts during infrastructure development. Where necessary, it is recommended that both strategies (H6) should be combined to ensure effective implementation of climate-conscious PPP projects. Before a contract is awarded to sub-contractors and suppliers, PPP project management firms should check the outcomes of feasibility studies, then make the decision to select sub-contractors. The carbon footprint status and adherence of contractors to climate change requirements in their past projects should be considered. Procurement strategies were found to impact the awarding of contracts, but not contract management with H8 and H9 (See
Table 6).
Akomea-Frimpong et al. (
2021) explained that contractors prioritize procuring recycling materials and construction inputs that produce the least emissions and financial risks. Sustainable packaging initiatives together with partnerships promote sustainable practices. Project managers adopt cleaner technologies and tracking systems in the supply chain for sustainable PPP development.
Giesekam et al. (
2018) argued that procuring tensile project materials and green facades for PPP housing and buildings is important for standing against climate change. Practically, it is recommended that PPP stakeholders should apply green supply chain policies at the contract management stage to address H9, inclusive of benchmarks to monitor the implementation of procurement practices. Additionally, the selection of contractors and subcontractors to manage the project should be largely dependent on their green materials and efforts towards addressing climate risks. Lastly, H10 was not supported statistically, and it was rejected where no significant connection was found to exist between the awarding of contracts and contract management towards climate risk management in PPP infrastructure. To address H10, it is important for PPP contractors to incorporate contract award strategies into the contract management of PPP projects. Also, contractors should be committed to mitigating climate change risks during and after the awarding of the contract. This involves the implementation of decarbonization measures such as securing low- to zero-carbon emission materials. There should be practical tools and procedures to implement climate-resilient measures to attain a low amount or lack of climate risks.
7. Conclusions, Implications and Limitations
The consequences of climate change negatively affect the sustainability of PPP infrastructure projects. In this research, various strategies to mitigate the risks have been presented considering the principal stages of the PPP project lifecycle. The study solicited primary data from key PPP stakeholders through an online survey involving questionnaires that were distributed to respondents in different parts of the world. The main data analysis tool used to analyse the relationships between the strategies was PLS-SEM analysis. The results from the data collected indicated that most of the participants were in Africa and Asia, indicating the two regions with most PPP infrastructure in recent times. Also, the PPP projects that featured prominently in the responses of the participants are housing and transportation infrastructure. From the measurement model analysis of the PLS-SEM, twenty-seven strategies were retained and CAS4 (incorporate sustainability requirements) was removed because it recorded a factor loading of −0.147. The structural model exhibits significant relationships and gaps between principal strategies of procurement, feasibility studies, contract management, project identification and the awarding of contracts related to climate risk management.
This article has two main potential implications. First, the findings provide an understanding of the effects of key project identification measures on the climate change management of PPP infrastructure. It encourages setting appropriate targets and the development of realistic timelines and defines the areas of climate risk management. Climate risk indicators for performance assessment should be set with project leaders’ supervision and evaluation. The results provide insights for feasibility assessment, taking into consideration retrofitting, cost, carbon footprint and the justification of assessing the state of climate resilience and the adaptation position of PPP projects. The findings also provide information on strategies to improve procurement, the awarding of contracts and management. It is recommended that project managers should consider these strategies to develop mitigating measures for climate risks at the beginning of projects after establishing the feasibility status of the project’s resilience. Supply chain measures should incorporate green procurement practices which can lead to carbon neutral projects. Sub-contractors with track records of implementing emission-free and climate-friendly practices should be awarded contracts. Project teams should insist on applying these measures to specific projects under the supervision of experienced project leaders. Secondly, the study is important for enriching the existing theoretical information and research on strategies for the climate change protection of PPP projects. The outcomes are essential for further investigations and the development of models to support future studies. Despite these contributions to research and practices, the study has the following limitations. The dataset for this analysis is limited to 147 PPP stakeholders. Even though it was proven to be significant for this research, further studies must expand the pool of participants to gather a wider variety of responses. Next, the strategies analysed in this study are linked to all forms of PPP infrastructure. It is suggested that further studies should embark on project-specific analysis using case studies of ongoing and completed projects. Further studies should test the strategies on PPP infrastructure using specific projects such as roads, schools and hospitals. Lastly, it would be useful if future studies were to assess the geographical differences of the strategies and delve into practice and policy frameworks in every country or region that implements the strategies.
