Article

Sustainable Operations: Risk Evolution and Diversification Strategies Throughout the Lifecycle of Wind Energy Public–Private Partnership Projects

1
College of Transportation and Civil Engineering, Fujian Agriculture and Forestry University, Fuzhou 350108, China
2
College of Public Administration and Law, Fujian Agriculture and Forestry University, Fuzhou 350002, China
*
Author to whom correspondence should be addressed.
Systems 2025, 13(4), 237; https://doi.org/10.3390/systems13040237
Submission received: 13 February 2025 / Revised: 11 March 2025 / Accepted: 29 March 2025 / Published: 30 March 2025

Abstract

:
As global energy demand grows and the focus on environmental sustainability intensifies, wind energy, as a form of clean energy, plays a pivotal role in the global energy transition. The public–private partnership (PPP) model, by integrating resources from both the public and private sectors, effectively propels the implementation of wind energy projects. However, these projects face a myriad of risks during both development and operation, making effective risk management crucial to project success. This paper, through literature analysis and System Dynamics methodology, develops a risk diversification indicator system that covers the entire project lifecycle. In addition, by combining the improved G1 weighting method and the entropy method, a dynamic risk model is established. Furthermore, through numerical simulation and sensitivity analysis, the risk levels of each subsystem and the key boundary risk factors are identified, and a set of highly adaptable risk diversification strategies is proposed. These strategies will enhance the resilience of wind energy PPP projects, foster trust among stakeholders, help participants effectively respond to and predict risk evolution, improve the project’s risk tolerance, and ensure its long-term sustainable operation.

1. Introduction

The growth of global energy demand and the increasing focus on environmental sustainability are driving the green transformation of the energy sector [1]. In this context, the international community is developing a series of policy frameworks to support renewable energy, aiming to optimize the energy structure and accelerate the transition to green energy [2]. These policies are intended to alleviate the environmental burden caused by traditional energy sources and to address the growing energy demand by promoting renewable resources, such as wind and solar energy, thereby achieving long-term environmental and economic sustainability [3]. Among these, wind energy, as a renewable, clean, and efficient form of energy, occupies a pivotal position in the global energy structure adjustment [4]. Thanks to its high technical maturity and environmental friendliness, wind energy has become a core component of many organizations’ and countries’ energy policies [5,6]. For example, the International Renewable Energy Agency (IRENA) encourages member countries to strengthen investment in and deployment of wind energy through technological innovation and policy support, to promote the widespread use of renewable energy [7]. The European Union’s “European Green Deal” plans to achieve carbon neutrality by 2050 through massive investments in wind energy and other renewable resources [8,9]. Additionally, the United States supports the development of wind energy projects through measures such as the Production Tax Credit (PTC) and the Investment Tax Credit (ITC), significantly reducing investment costs and accelerating the marketization process of wind technology [10,11,12]. These policies not only enhance the economic feasibility of wind energy but also provide solid policy and financial support for the global green energy transition.
Despite the many advantages of wind energy as a promising renewable resource, its development and operation face numerous challenges [13,14]. While technological maturity is continuously improving, it is still insufficient in some regions, increasing the risk of technology implementation [15]. Additionally, the site selection process for wind energy projects is complex, requiring comprehensive consideration of geographical, environmental, and community factors, all of which can affect the feasibility and social acceptance of the projects [16]. Furthermore, wind energy projects often require substantial initial investments and long construction periods, adding to the difficulty of fundraising and increasing financial risk [17]. The public–private partnership (PPP) model provides innovative solutions for wind energy projects [18]. By integrating the policy support and regulatory frameworks of the public sector with the capital and technological innovation of the private sector, the PPP model effectively propels the implementation of wind energy projects [19]. This collaborative approach not only helps diversify investment risks but also enhances the attractiveness and economic viability of projects by equitably distributing risks and benefits [20]. Moreover, the PPP model enhances the management efficiency and operational performance of projects, ensuring that wind energy projects can develop stably in complex market and technological environments.
In establishing and perfecting public–private partnership mechanisms, the core task is the accurate assessment of project risks and ensuring that these risks are equitably distributed among all parties [21]. In-depth risk analysis helps optimize resource allocation, ensures that key risks are properly managed, and avoids overinvestment in low-risk factors [22,23]. During the financing and operational phases of the project, investors often bear higher personal risks due to a lack of experience and flexible strategies [24]. Additionally, differences in institutional development between countries expose wind energy PPP projects to policy, legal, and social risks, increasing project uncertainty and affecting investor risk assessments [25,26,27]. Therefore, clearly delineating public and private responsibilities and implementing effective risk control measures are key to ensuring the sustainable development of wind energy PPP projects [28]. However, traditional risk management methods have certain limitations in addressing these complex risks. Risk control under the PPP model primarily relies on the risk-sharing and joint responsibility principles between the public and private sectors [29], with the party best able to control a risk typically assuming responsibility [30]. For external risks with unclear responsibilities, vague boundaries often lead to conflicts between the government and private enterprises, which may affect the normal operation of the project [31]. In wind energy PPP projects, investors have limited control over market demand and policy changes, and this uncertainty can weaken their investment intentions. Market development is influenced by the financial environment and policy regulations, but these factors are often beyond the government’s full control [32,33]. Introducing the concept of risk diversification helps to break through these limitations by integrating the strengths of multiple parties, providing adaptive solutions for complex risks, promoting public–private cooperation and trust [34], enhancing investor confidence [35], thereby attracting more capital, and laying a solid foundation for the long-term stability and success of the project.
Risk diversification is a crucial concept derived from agricultural disaster risk management [36], financial investment, and finance management [37]. In agricultural disaster risk management, risk diversification enhances capital efficiency and liquidity through temporal and spatial expansion, as well as the utilization of capital markets [38]. In the financial sector, risk is reduced and diversified by constructing a diversified investment portfolio [39,40]. In wind energy PPP projects, traditional risk management methods often fall short when addressing long-term or global issues, such as insufficient temporal and spatial diversification of risk, making it difficult to effectively monitor across different phases and entities [41]. Furthermore, unclear boundaries of risk responsibility not only hinder the effective segmentation of risk but also pose challenges in risk management and collaborative operations among partners, leading investors to prefer traditional over innovative financing models [42]. Additionally, the complexity of risks in wind energy PPP projects increases management difficulties [43,44], such as policy changes that may cause an increase in financing costs, thereby increasing financial risk; construction delays can weaken operational efficiency, thereby increasing operational risk [45]. These factors not only affect timely risk response but can also lead to the deterioration of project cooperation relationships and project delays.
To enhance the overall resilience and adaptability of wind energy PPP projects, targeted risk analysis and assessment, along with effective risk diversification measures, are especially crucial. This approach not only attracts more stakeholders to participate but also helps establish a cooperative mechanism for shared risk, ensuring the project’s long-term sustainability [46]. Although numerous studies have explored the risks of wind energy PPP projects and achieved certain results, these studies are primarily focused on static risk assessments, with less emphasis on the dynamic evolution of project risks; thus, they are slightly lacking in dynamic assessment capabilities. Moreover, while existing research pays attention to direct risk analysis, there is insufficient focus on the resilience of responses to risks. Many studies also tend to focus on a specific phase or participant of the project, overlooking the spatial and temporal dispersion of risks. This may lead to inadequate consideration of risk transmissibility between different entities and phases, while also lacking a systematic analysis of risk assessment and its diversification across time and space. Specifically, temporal dispersion focuses on how risks evolve over the course of a project’s timeline, while spatial dispersion concerns how risks are transferred and shared among different project participants. Insufficient attention to both can often lead to difficulties in accurately predicting and controlling the trend of risk development in practice.
To address the current research gaps, this study constructs a risk diversification indicator system and dynamic evolution model specifically for wind energy PPP projects based on the System Dynamics approach. By establishing the causal feedback mechanisms and stock–flow models between risk factors, this study more intuitively and quantitatively reveals the interactions among risk factors and their dynamic patterns over time. Additionally, by integrating subjective and objective weighting methods, the quantification of risk factor weights enhances the objectivity and accuracy of risk assessments, overcoming the limitations of traditional risk studies that rely solely on single methods or static analysis. Lastly, through the simulation of actual cases, this paper validates the effectiveness of the model and creatively proposes a series of diversified risk dispersion strategies and risk control measures, further enhancing the practicality and application value of the research findings. The main contributions of this research are: (1) for the first time, combining System Dynamics with the concept of risk dispersion, providing a novel dynamic analysis perspective for risk management in wind energy PPP projects, which helps stakeholders understand the mechanisms of risk dispersion more intuitively and in depth, and optimizes risk control pathways; (2) exploring the dynamic evolution of risks in wind energy PPP projects from a spatio-temporal perspective, the simulation reveals key boundary risk factors, clarifies the transferability and accountability boundaries of risks at different stages and among different participants, and offers in-depth risk management strategies and practical guidance for wind energy PPP projects.

2. Research Process and Methods

2.1. Research Process

This article aims to provide a theoretical basis for effective risk management by all parties involved in wind energy PPP projects. The specific research process, as shown in Figure 1, can be broadly divided into three main stages. Initially, through the literature analysis method, a systematic review and analysis of 126 relevant publications was conducted to identify representative and frequently occurring risk factors. Based on these, a comprehensive risk indicator system was constructed, encompassing subsystems such as construction delays, financing, construction quality, construction cost overruns, operational overruns, and insufficient expected returns. Subsequently, using System Dynamics methods, causal feedback and stock–flow diagrams for wind energy PPP project risks were created using Vensim PLE software (Vensim PLE version 6.3) to further analyze and reveal the interactions among risk factors and their dynamic change mechanisms.
Next, based on the dynamic analysis mentioned above, data were collected through expert surveys, and the weights of each boundary risk factor were determined using a combined subjective and objective weighting method. On this basis, a dynamic risk simulation model was built to simulate and predict risk trends, providing a scientific basis for risk quantification.
Finally, through model simulation and analysis of specific cases, the risk levels of six major target risks were identified. Further, through sensitivity analysis, 11 key boundary risk factors were determined that need special attention and control in actual project management. Based on these findings, this study proposes a series of targeted risk dispersion strategies and control measures, discussing their application methods and effects in actual wind energy PPP projects. The aim is to enhance the overall risk resistance of the projects through a scientific and systematic risk management approach, thereby fostering cooperation and trust among all stakeholders.

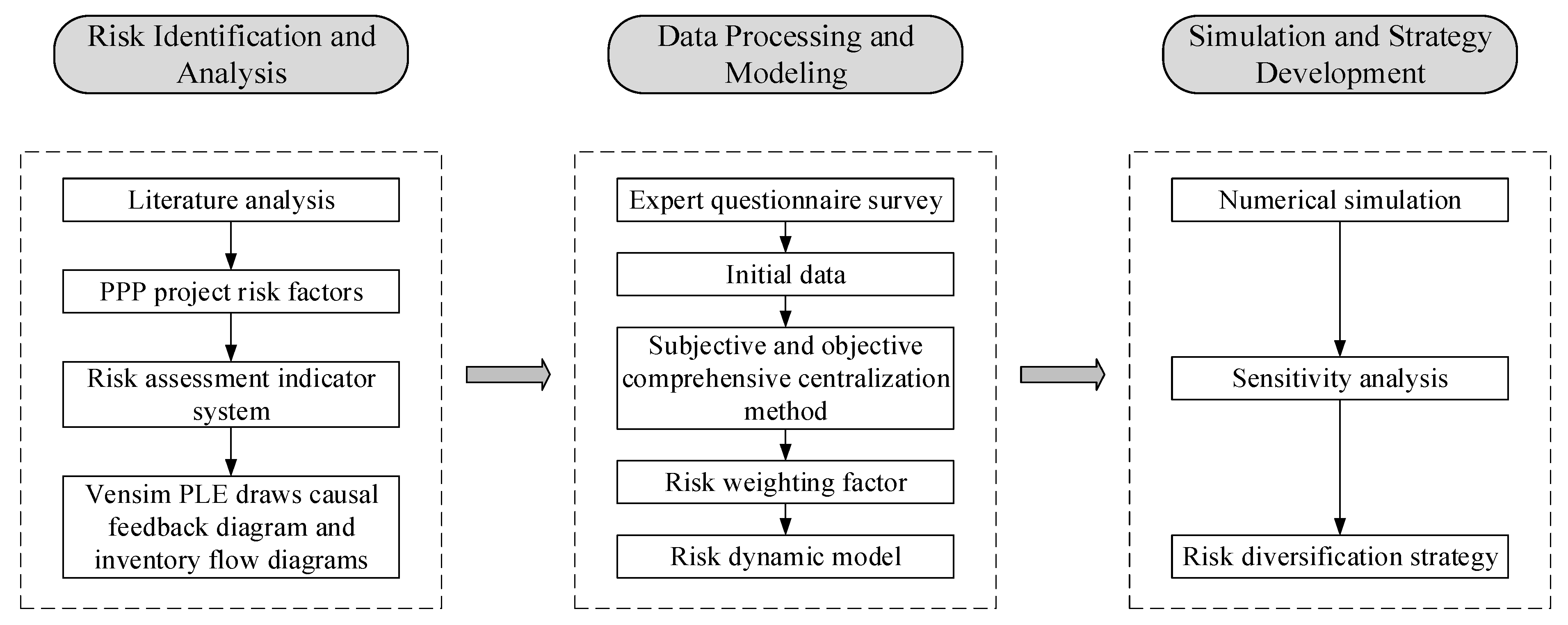

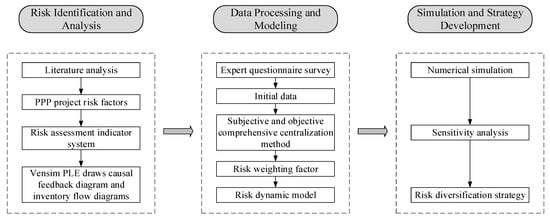

The flowchart in Figure 1 clearly demonstrates the logical relationships and information transfer processes among the three key stages. Specifically, the risk factor identification and indicator system construction stage lays the foundation for subsequent data processing and modeling work. The combination of the weights of boundary risk factors obtained from data processing with System Dynamics modeling further supports the subsequent simulation and sensitivity analysis, providing a basis for developing risk dispersion strategies and control measures. This clear structural path ensures the logical consistency and reliability of the entire research process.

2.2. Research Methods

Common risk assessment techniques include Event Tree Analysis (ETA) [47], Fault Tree Analysis (FTA) [48], Failure Modes and Effects Analysis (FMEA) [49], Monte Carlo simulation [50], and System Dynamics. Both ETA and FTA provide causal relationships and consequence pathways starting from an initial or top event, but they generally lack a dynamic perspective and consideration of system feedback mechanisms. While effective in revealing potential failure paths and possible outcomes, these methods mainly offer static risk analyses and do not cover the evolution of events over time or the dynamic changes in complex feedback mechanisms. FMEA focuses on identifying and assessing potential failure modes and their impacts on systems, providing a more detailed record for lifecycle management of projects. However, it remains limited to static risk assessments and does not consider the overall dynamic behaviors of systems. Monte Carlo simulation offers a powerful tool for handling randomness and uncertainty, effectively performing dynamic analyses and providing probabilities and forecasts of risks. However, this method focuses on quantifying randomness and uncertainty and may not adequately reveal the interactions and dynamic feedback within complex systems.
In contrast, System Dynamics offers a comprehensive analytical tool. System Dynamics was introduced by Jay Forrester in the 1950s at the Massachusetts Institute of Technology and is used to study the structure of complex systems, the impact of feedback loops, and time delays on behavior [51,52]. It can simulate and assess the dynamic changes in various variables over time and their interactions, addressing the limitations of the aforementioned methods. This method can simulate the dynamic behavior of systems, making it particularly suitable for understanding the interactions and changes among elements in PPP projects [53]. In wind energy PPP projects, risk management involves not only assessing the impact of individual events but also considering the long-term interactive effects of various economic, environmental, and technical factors. System Dynamics is capable of integrating these complex interdependencies and constructing dynamic models that include feedback loops, thereby providing detailed insights into how policy adjustments and market changes affect the sustainability and risk conditions of the projects. Its main advantages include clearly describing the risk structure, illustrating risk sources and transmission paths through causal diagrams [54], and using stock–flow models to simulate the dynamic changes and mutual influences of risk factors [55,56], thus providing decision support for managing complex risks [57]. System Dynamics also emphasizes the importance of feedback loops, helping to identify and understand the nonlinear characteristics of systems [58,59], and supports testing different risk response strategies, such as risk transfer and diversification, providing scientific evidence for decision-makers to choose the optimal risk management strategies [60]. Therefore, given the advantages of System Dynamics in analyzing and solving complex, dynamic problems, this paper opts to use the System Dynamics approach to study risks in wind energy PPP projects.

3. Construction of a Risk Index System

3.1. Induction and Analysis of Risk Factors Based on the Literature

3.1.1. Preliminary Identification of Risk Factors

Based on a literature review methodology, this paper collected 126 academic articles related to PPP project risk research published between January 2013 and August 2024 from the Web of Science using the keywords “PPP, wind energy, risk, PPP risk management, PPP risk diversification”. After an initial screening, the titles, abstracts, and keywords of these articles were examined in detail to ensure they met the research standards. The first round of filtering primarily excluded literature unrelated to the research objectives, while the second round involved a full-text reading to further confirm the relevance of the articles. Although this study primarily focuses on risk management and risk diversification in wind energy PPP projects, it also includes other types of PPP projects to obtain a more comprehensive perspective on public–private models. Through these two rounds of filtering, 26 representative articles on PPP risk factors were selected for in-depth analysis. These articles cover a broad range of risk factors in wind energy projects, thus providing a rich theoretical and practical foundation for this study.
In analyzing the risk factors from the selected literature, we noted variations in the expression of the same risk factors across different language backgrounds, such as “political opposition” and “political hostility”, both indicating government opposition. Based on frequency analysis, risk factors that appear more frequently are considered to have higher reference value. The results of the frequency analysis of PPP risk factors (see Appendix A, Table A1) focused on retaining the more frequently occurring risk factors, while those appearing less frequently (1–3 times) were eliminated based on quantitative data.

3.1.2. Identification and Definition of Risk Factors

Based on these analyses, it was determined that the risk factors in PPP projects are interrelated and span various stages, such as decision-making, financing, construction, operation, and the entire project lifecycle. By simplifying and categorizing these risk factors, a clear list was established (see Appendix A, Table A2). Among these, factors such as lack of support from government, unstable government, political interference, corruption and bribery, and nationalization/expropriation are categorized as political risks and have an impact on other risks across the entire SD system. Therefore, in the subsequent application of System Dynamics, these political risks were simplified and excluded from further consideration in this study.

3.2. Analysis Model Based on System Dynamics

3.2.1. Causal Feedback Diagram of Wind Energy PPP Project Risks

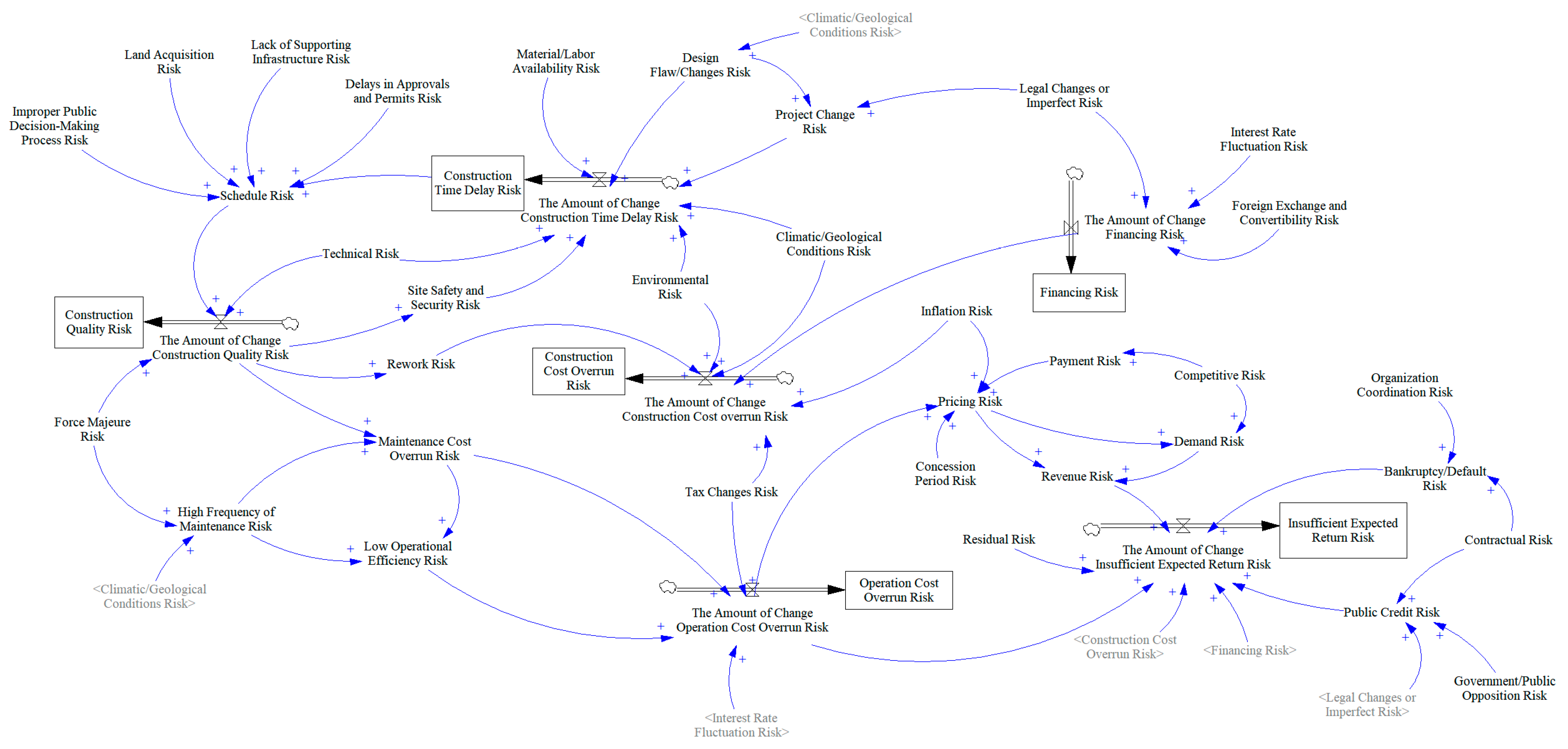

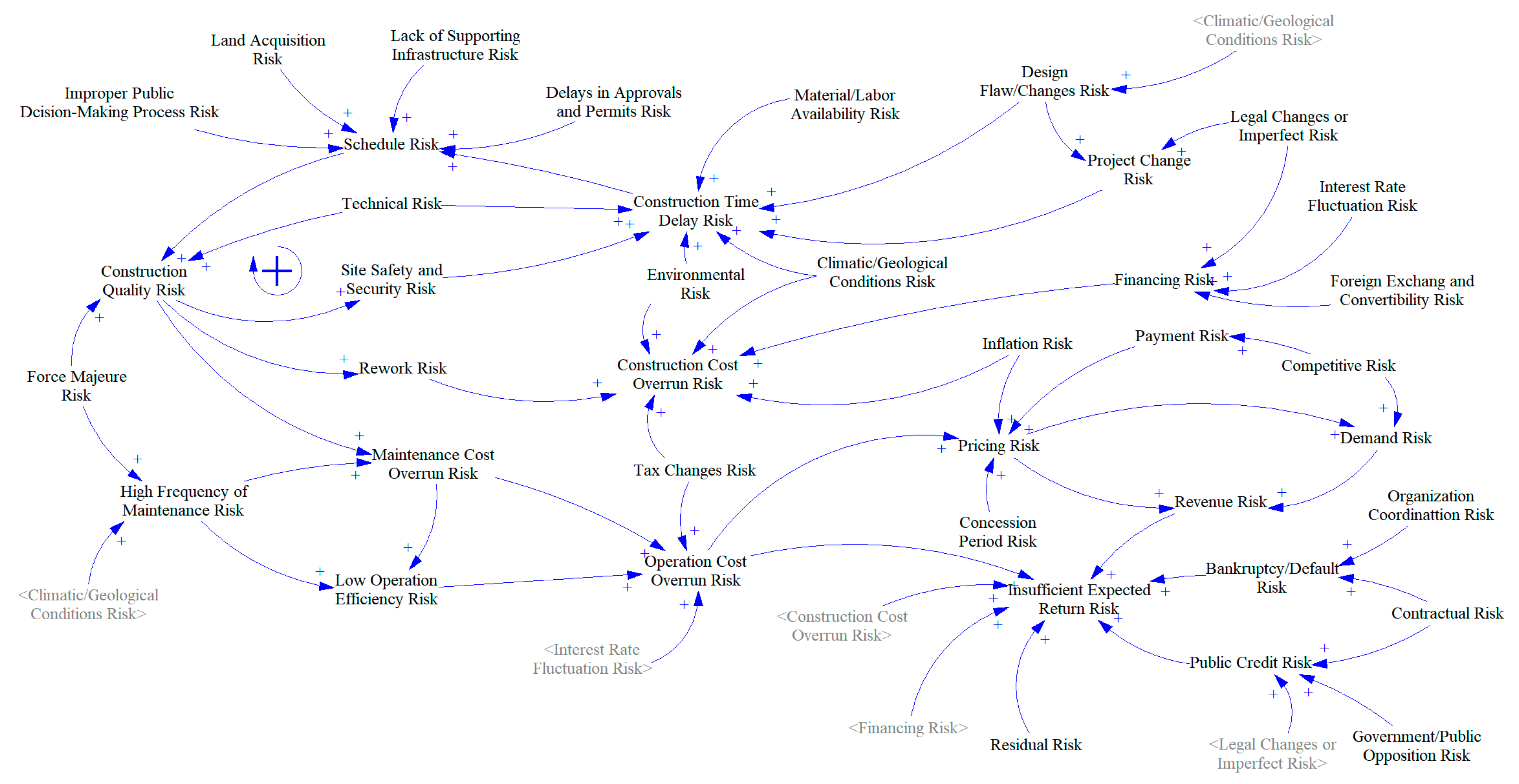

Based on the methods and characteristics of System Dynamics, a risk causal feedback model for wind energy PPP projects was constructed using Vensim PLE software (see Figure 2) to visually demonstrate the causal relationships between various risk factors in the project. By categorizing the identified risk factors according to the project stages and labeling the polarity of each arrow in the model, the nature of each feedback loop can be clearly identified. This feedback loop indicates that any deterioration in one factor will exacerbate other risk factors through a chain reaction, leading to an overall increase in the project’s risk.

3.2.2. Stock–Flow Diagram of Wind Energy PPP Project Risks

Through the analysis of the risk causal feedback diagram, the risks of construction delay, financing, construction quality, cost overruns, operational cost overruns, and insufficient expected returns were defined as state constants, while the corresponding risk factors were considered as rate variables. Other variables were categorized as auxiliary variables or constants, leading to the construction of the wind energy PPP project risk stock–flow diagram (Figure 3).

3.3. Boundary and Subsystem Risk Analysis

3.3.1. Identification of Boundary Risks

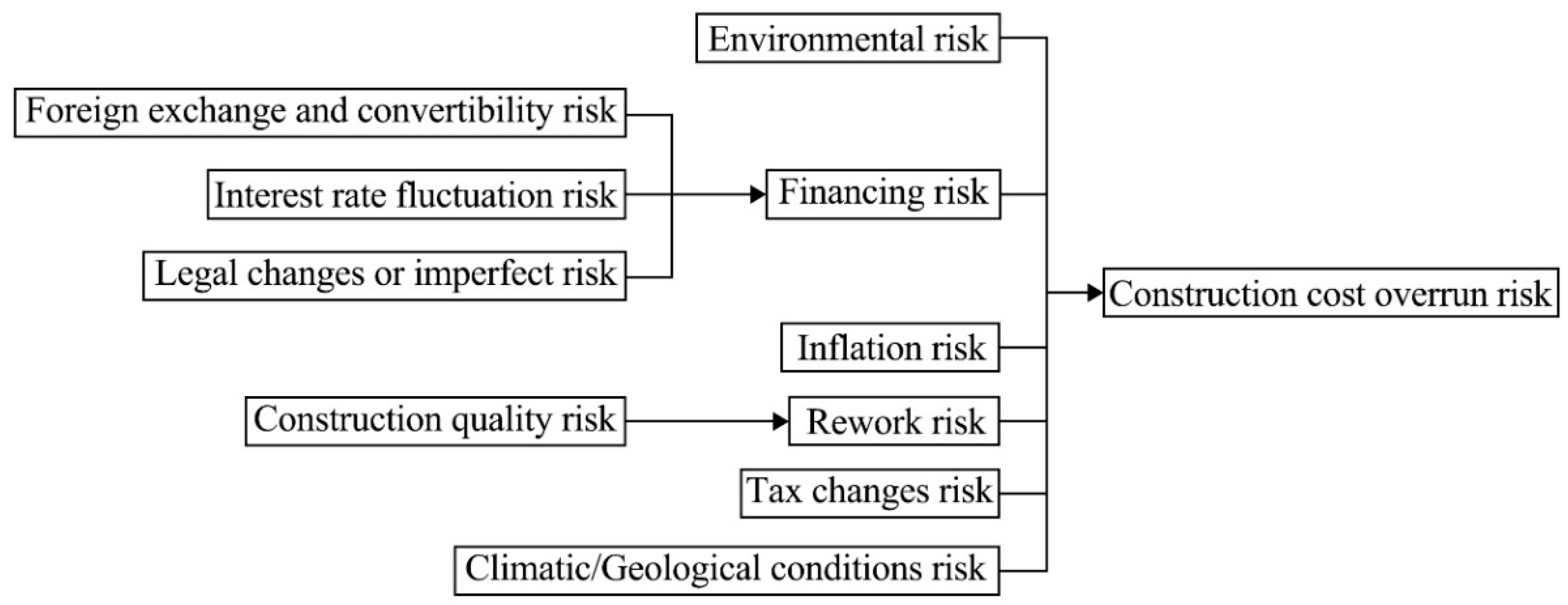

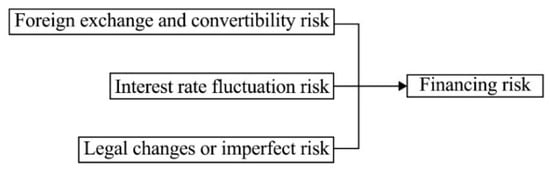

According to the risk stock–flow diagram, boundary risk factors can be identified as connection points between the system and the external environment. Boundary risks refer to the risks that may occur at the interface between a project or system and its external environment. These risks are typically caused by external factors and involve direct interactions with the external environment. The uniqueness of boundary risk factors lies in the fact that they are influenced solely by external factors, with no direct impact from the internal system of the project. This study identified the following 20 boundary risks: improper public decision-making process risk, land acquisition risk, lack of supporting infrastructure risk, delay in approval and permitting risk, materials/labor availability risk, legal changes/imperfections risk, interest rate fluctuation risk, exchange rate and convertibility risk, technological risk, environmental risk, climate/geological conditions risk, inflation risk, force majeure risk, tax changes risk, concession period risk, competition risk, organizational coordination risk, contractual risk, residual risk, and government/public opposition risk. The identification of these boundary risks provides a foundation for further analysis of risk transmission paths and their impacts.

3.3.2. Subsystem Risk Cause Tree Analysis

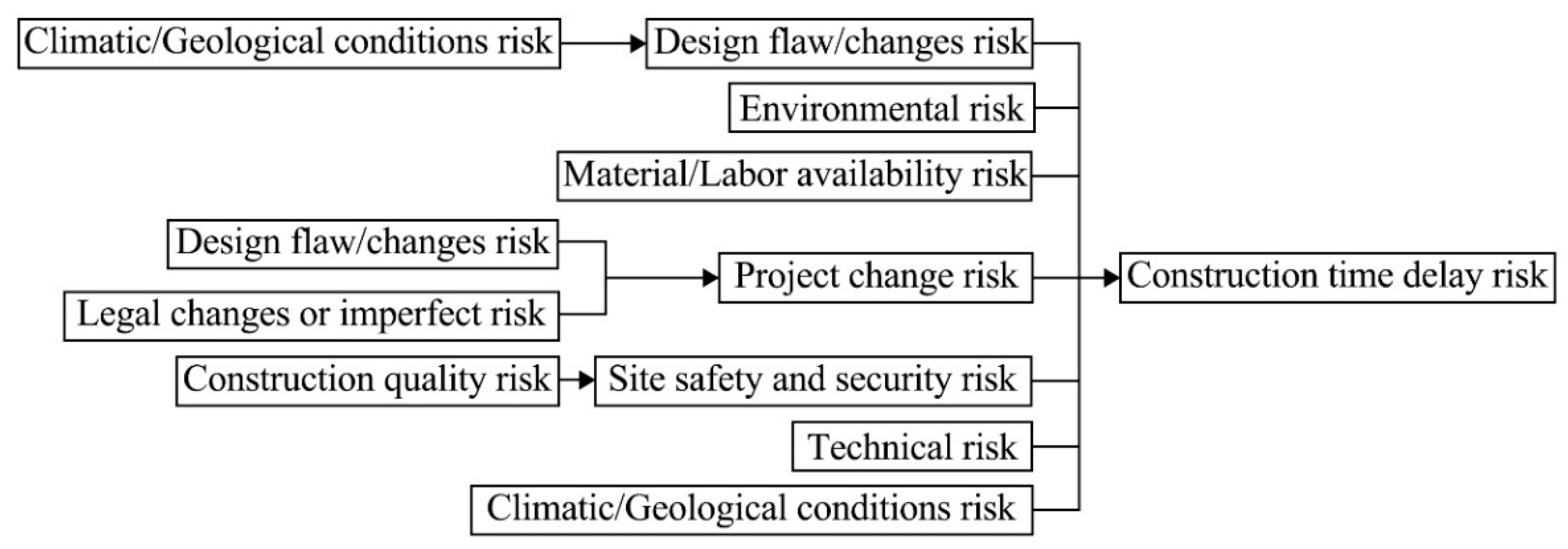

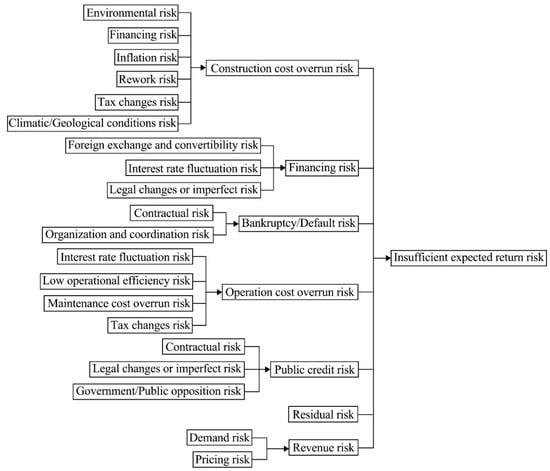

The cause tree analysis of the target risk subsystems (Figure 4, Figure 5, Figure 6, Figure 7, Figure 8 and Figure 9) reveals the primary sources of the target risks and helps project managers identify key intervention points to gain a deeper understanding of the root causes and potential consequences of the risks.

4. Calculation of Risk Weights and Construction of a Dynamic Risk Model

4.1. Questionnaire Survey and Data Collection

To ensure the breadth and reliability of the data, this study employed a detailed and specific survey method. The survey was conducted from June 2022 to February 2023, targeting seasoned experts and practitioners in the PPP field. The selection criteria included having at least five years of work and research experience in PPP projects and significant influence in project risk management. To enhance the validity of the survey questionnaire, researchers initially conducted online interviews and face-to-face discussions with several industry experts from wind energy PPP projects, performing multiple rounds of meticulous optimization regarding the questionnaire’s relevance, accuracy, wording, order, and layout. An example question from the optimized questionnaire is: “Please evaluate the impact of the following boundary risk factors on the overall performance of the PPP project based on your experience”. The optimized questionnaire was distributed through online forms to PPP-related academic forums on WeChat groups, and targeted invitations were sent to industry experts and scholars to ensure extensive data collection. Additionally, offline interviews were conducted to gain deeper insights into the respondents’ views and experiences, thereby enhancing the quality and depth of the data.
Furthermore, during the annual “China PPP Forum” conference, the author engaged in in-depth discussions with some of the conference participants, mainly experts from the PPP expert database of the Ministry of Finance and the National Development and Reform Commission, as well as relevant scholars, government officials, and consulting institutions. The data collected from this survey hold a certain level of professionalism and authority. The research is ethical and has been approved by relevant institutions for use within this research scope. Respondents represented multiple sectors, including construction, finance, and government, and ranged from project managers to senior management, ensuring diversity in industry and experience levels. A total of 972 questionnaires were distributed, and 135 valid responses were collected, resulting in an effective response rate of 13.89%. This rate is higher than the average response rates for similar studies on PPP models, such as 12% in Li et al. [61] and 9.4% in Salman et al. [62]. Therefore, the collected survey data effectively support the corresponding research and data analysis needs. The specific profile of the respondents is provided in Appendix B, Table A3.

4.2. Calculation of Risk Factor Weight Coefficients

(1)
Subjective Weighting Method
The subjective weighting method is a technique that allocates weights based on the personal assessments of decision-makers or experts regarding the importance of the indicators. This method primarily relies on the experts’ experience and judgment, emphasizing the scientific rigor and accuracy of the assessment. However, due to its strong subjectivity, the results of this method can sometimes be difficult for other decision-makers or analysts to accept.
(2)
Objective Weighting Method
The objective weighting method, on the other hand, allocates weights based on the original data by determining the functional relationship between the data and the weights. This method is independent of the decision-maker’s subjective opinions and typically provides a more accurate reflection of the actual situation. It can also more effectively represent the practical significance of multiple evaluation indicators.
To ensure the fairness of the evaluation results and reduce the influence of human factors, this study combines both subjective and objective weighting methods. The integrated approach uses the improved G1 method and the entropy method for weight allocation of the risk factors, aiming to overcome the subjectivity issues inherent in the traditional Analytic Hierarchy Process (AHP).

4.2.1. Calculation Using the Improved G1 Method

The G1 weighting method was originally a subjective weighting method based on comparing the importance ratios of evaluation indicators [63]. To increase the difference in weight values and improve the accuracy of the weights, the G1 method was improved by scoring the importance of neighboring evaluation indicators. In expert scoring standards, although the use of a 10-level scale can indicate more detailed attitudinal differences among the respondents, the increase in the number of levels will blur the definition of each level, which will cause the respondents to feel a certain amount of confusion. Therefore, to ensure reliable scoring, the meaning of the points on the metric scale must be clearly understood. If the meaning of the points on the metric scale is not clear, then the reliability and validity of the measure will be compromised. Based on this, combined with the ref. [64] and other related materials, this paper proposes to further optimize the improved G1 weighting method by using a seven-level scale. The specific calculation steps are as follows:
Expert scoring. Scores for the importance of adjacent indicators are collected through survey questionnaires from experts. Please refer to Table A4 in Appendix B for the scoring standards; higher values indicate greater importance of the indicators.
Ranking the importance of evaluation indicators. According to the score of the i -th expert on the importance of the indicator, according to the size of the score to rank, such as the indicator y 1 , the importance score, y 1 * , is greater than the importance of the indicator y n score, y n * , and then it is recorded as y 1 > y n , and the ranking of importance is as follows:
y 1 > y 2 > y 3 > > y n
Ratio of importance for adjacent indicators. Based on the score of the i -th expert on the importance of the evaluation indicator, the ratio of the importance scores of the adjacent indicators is taken as the ratio of the weights, and the ratio of the weights of the evaluation indicator, y k 1 , to the indicator y k is described as follows:
y k 1 y k = ω k 1 ω k = γ k
where ω k is the weight of the indicator, y k , based on the score of the i -th expert.
Calculation of indicator weights. The indicator, y n , is given a weight as follows:
ω n = ( 1 + k = 2 n j = k n γ k ) 1
The weights of the other indicators can be derived from the recursive formula as follows:
ω k 1 = ω k γ k
where k = n , n 1 , , 2 .
The weights of each target risk were calculated using the improved G1 weighting method, with the results detailed in Table A5 in Appendix B.

4.2.2. Calculation Using Entropy Method

The entropy method is an objective weighting method that determines weights by analyzing the statistical properties of the data, using the entropy value of each risk factor to measure its lack of information [65]. The coefficient of variation further measures the variability of each risk factor in the dataset, reflecting the importance of the different risk factors [66]. The objectivity of this method ensures that the weights are assigned scientifically and rationally, which is accomplished through the following steps:
Constructing the matrix. Expert ratings are collected and a scoring matrix, X , is constructed as follows:
X = x 11 x 1 n       x m 1 x m n
Quantification of risk indicators. Quantify the risk indicators in the matrix as follows:
P i j = x i j i = 1 m x i j
Calculate the risk factor entropy value, e j . Calculate the entropy value of each risk factor using the following entropy value formula:
e j = k × i = 1 n P i j log ( P i j )
where i , j is the number of samples, k = 1 ln n .
Calculation of the coefficient of variation of risk factors. The coefficient of variation of the indicators is calculated based on entropy as follows:
g i = 1 e j
The greater the difference in the indicator value, X i j , and the lower the entropy value, the greater the g i and the more important the indicator.
Find the weights. Find the weight of each risk factor based on the coefficient of variation as follows:
w j = g j j = 1 m g j , j = 1 , 2 , 3 , , m .
The entropy method was used to determine the proportion, entropy value, coefficient of variation, and final weight coefficients for each risk factor. The detailed results can be found in Table A6 in Appendix B.

4.2.3. Determining the Combined Weight of the Risk Factors

The improved G1 weighting method, by incorporating a seven-point scale, significantly enhances the precision and reliability of weight calculation. This optimization reduces the subjectivity of ratings and increases the reliability and validity of assessments, making the experts’ evaluation of the importance of risk factors more precise and distinctive. Furthermore, the entropy method, as an objective weighting approach, determines weights by analyzing data variability, adding necessary objectivity to the assessment process. This ensures that risk assessments not only reflect experts’ intuitive judgments but also accurately quantify the actual impact of each risk factor in the project.
The weight values obtained from the improved G1 weighting method and the entropy method are combined and assigned, and the combined weights are considered optimal when the sum of the squares of the deviations of the weights obtained using the two methods is minimized, i.e., the weights of the subjective and objective weighting methods are half of each other. This combined subjective and objective approach effectively balances the advantages of expert insights and data analysis, thereby enhancing the accuracy and reliability of risk weights. Derived from Equations (4) and (9), the formula for calculating the combined weights is as follows:
W j = 0.5 w j 1 + 0.5 w j 2
In this equation, w j 1 represents the weight value obtained from the improved G1 weighting method, and w j 2 represents the weight value derived from the entropy method. Using this approach, we have integrated and weighted the various types of risks in the table, with the final results detailed in Table A7 in Appendix B.

4.3. System Dynamics Equations for Risk Factors

Building upon the creation of causal feedback diagrams and stock–flow diagrams for risk factors, this study determined the weights of each risk factor through expert surveys and a combined subjective–objective weighting method. Utilizing these weights and the causal relationships of risk factors shown in Figure 2, along with existing theories in the field of System Dynamics [67], a set of System Dynamics equations suitable for risk analysis in wind energy PPP projects was established to dynamically simulate the interactions of risk factors and their evolving trends over time. The equations, as shown in Table 1, employ INTEG to represent integration and PULSE (Q, R) as the pulse function, which simulates pulses that change over time, where Q represents the time of the first pulse, and R is the pulse interval. The parameter “a” corresponds to the construction phase of the project, while “b” corresponds to the operational phase.

5. Dynamic Simulation of Risks

5.1. Numerical Simulation of Subsystems

The boundary risk factors of the project were quantitatively scored based on the actual construction situation and questionnaire data. To ensure the consistency of the data, the assignment range of the boundary risk factors was set between 0 and 1, where 0 indicates that the risk has no impact, and 1 indicates that the impact of the risk has a definite presence. By processing the arithmetic mean of the collected boundary risk expert scoring data, the risk estimates for each boundary risk factor were obtained, and the specific results are shown in Table 2.
The boundary risk factors of the wind energy PPP project were simulated and evaluated using Vensim PLE software. In the initial setup, the model’s starting value (initial time) was set to 0, and the final value (final time) was set to 120, with 0–12 representing the construction period and 13–120 the operational period. The time unit was set to quarters, with a time step (DT) of 1. The model inputs the numerical values and functional relationships of boundary risk factors and was thoroughly debugged before starting the simulation. The simulation results appeared normal (Figure 10, Figure 11, Figure 12, Figure 13, Figure 14 and Figure 15), consistent with expected trends, and showed no significant anomalies or unexplainable fluctuations. In Figure 10, Figure 11, Figure 12 and Figure 13, as the construction period ends, a stable slope change transitioning to a horizontal line is observed, indicating that the subsystem risks are no longer increasing and have stabilized. Figure 14 and Figure 15 show that subsystem risks are only active during the operational phase, remaining unchanged during the construction period. Furthermore, multiple repeat simulations of the model, including extreme testing of parameters and sensitivity checks, consistently demonstrate the model’s stability and reliability.
Based on the risk simulation results, to further clarify the assessment of risk levels, this study drew on the related findings of Wang [68] and John et al. [69]. Building on expert consensus and the Delphi method, the maximum risk value, X max , was divided into five levels within the range [ 0 , X max ] , with specific interval divisions presented in Table 3. In practice, we invited 10 experts with extensive experience in PPP project management to determine the criteria for risk level classification through two rounds of Delphi consultations. The expert panel conducted in-depth discussions and scoring based on industry practices and actual project data, and they unanimously agreed that the risk value should be divided into five intervals, from 0 to X max , with each interval increasing by 0.2 X max .

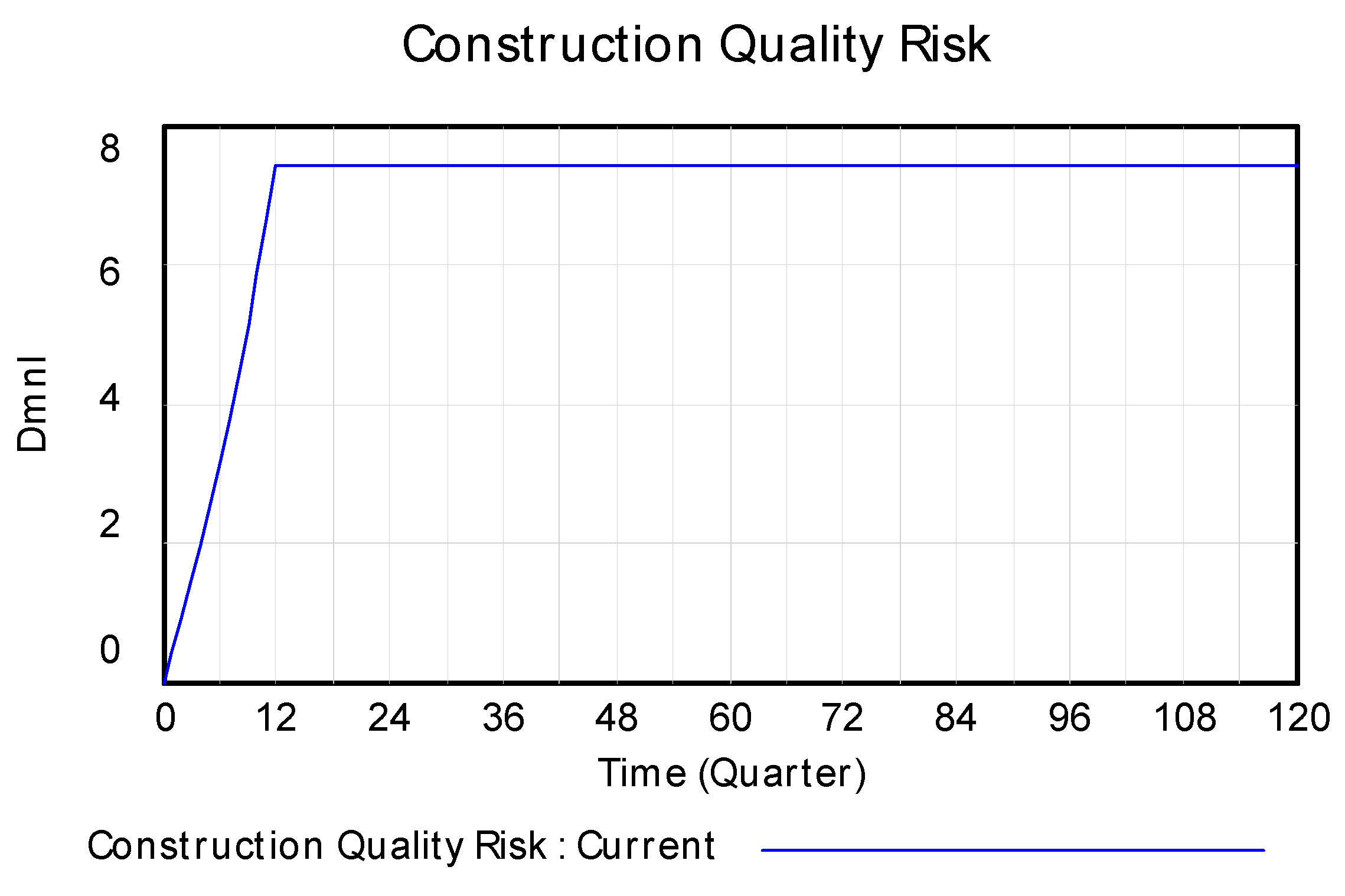

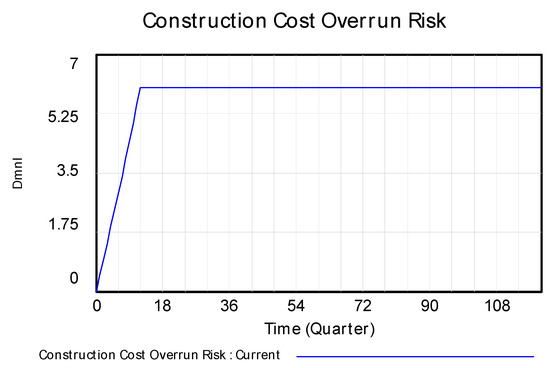

During the concession period of the wind energy PPP project, the risk values need to be treated differently according to the different risk spans of the construction and operation periods of the subsystems. The simulation results show that the risk maximum value, X max , of the construction time delay risk, financing risk, construction quality risk, and construction cost overrun risk in the construction phase is 7.418. According to Table 3, during the construction period, construction quality risk and construction cost overrun risk are categorized as major risks, while financing risk and construction time delay risk are categorized as relatively high risks. The simulation also shows that the order of risk is as follows: construction quality risk > construction cost overrun risk > financing risk > construction time delay risk.

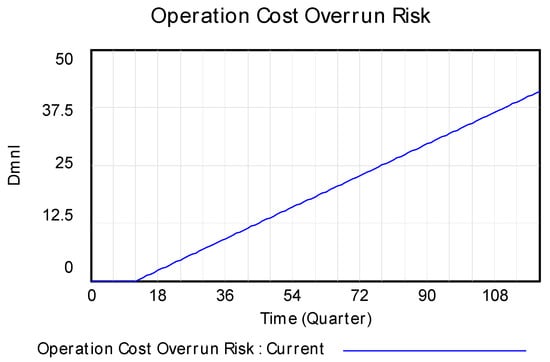

Similarly, during the operational phase, simulation analysis indicates that the maximum risk value, X max , for the operational cost overrun risk and insufficient expected return risk is 218.161. Therefore, in this case, the insufficiency of expected return risk is assessed as a significant risk, while the operational cost overrun risk is assessed as low-risk. This analysis provides a foundation for formulating risk control strategies, but specific risk control measures require further detailed analysis to effectively reduce risks.

5.2. Sensitivity Analysis of Boundary Risks

Sensitivity analysis is a technique used to assess the extent to which the output of a model or system responds to changes in one or more input parameters [69,70]. Simply put, it is used to determine how changes in specific variables affect the outcomes of a decision model. In the risk management of wind energy PPP projects, sensitivity analysis helps decision-makers identify key risk factors and evaluate how the cumulative impact of these factors over time influences the project, thereby optimizing decisions and controlling critical risks throughout the concession period.

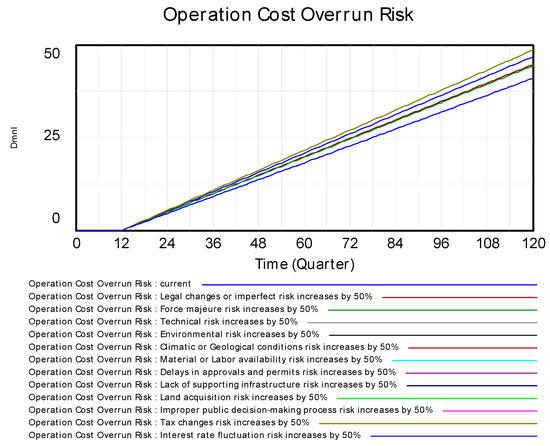

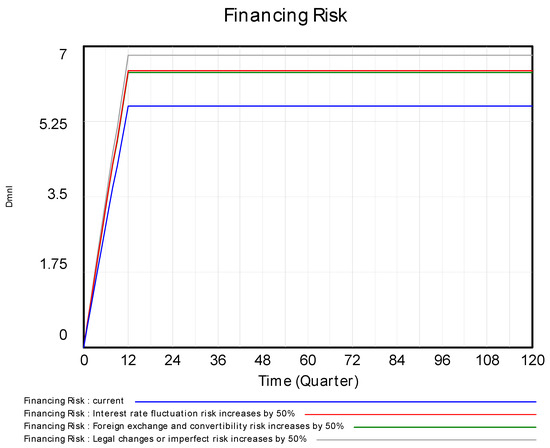

In this study, the method of controlling variables was employed to simulate single-factor changes, aiming to explore the impact paths of various boundary risk factors on target risks. Specifically, new datasets were generated in Vensim PLE, and while keeping other risk factors constant, the values of boundary risk factors that significantly impact the target risk were increased by 50% based on the results of the subsystem risk cause tree analysis to simulate changes in target risks. The parameter change range was set at 50%, a decision based on the variation intervals determined through multiple rounds of expert evaluations using the Delphi method. This setup not only ensures the feasibility of parameter changes in reality but also effectively reflects the sensitivity of the risks. This range represents extreme but possible scenarios used to assess the robustness of the system under different stress levels.

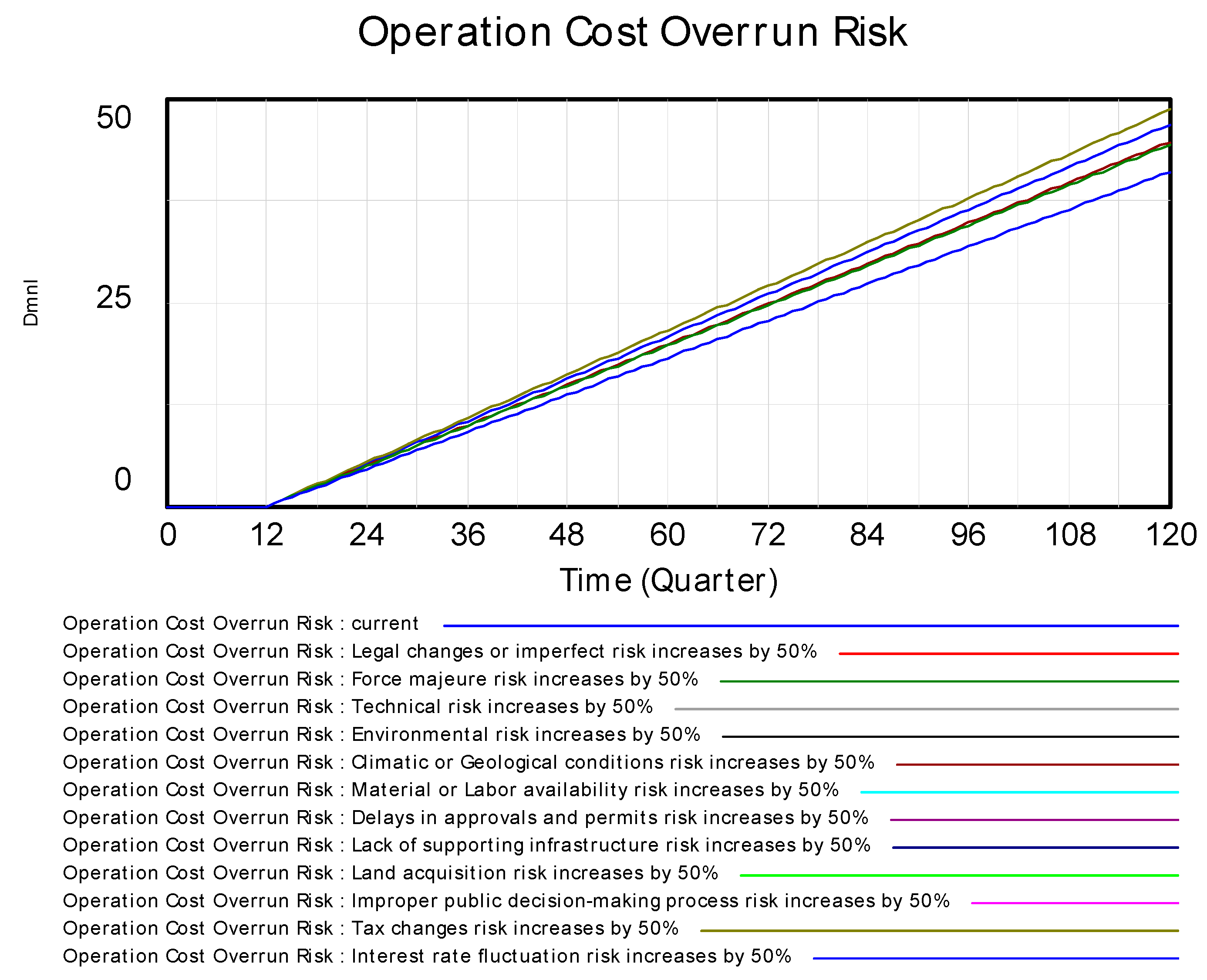

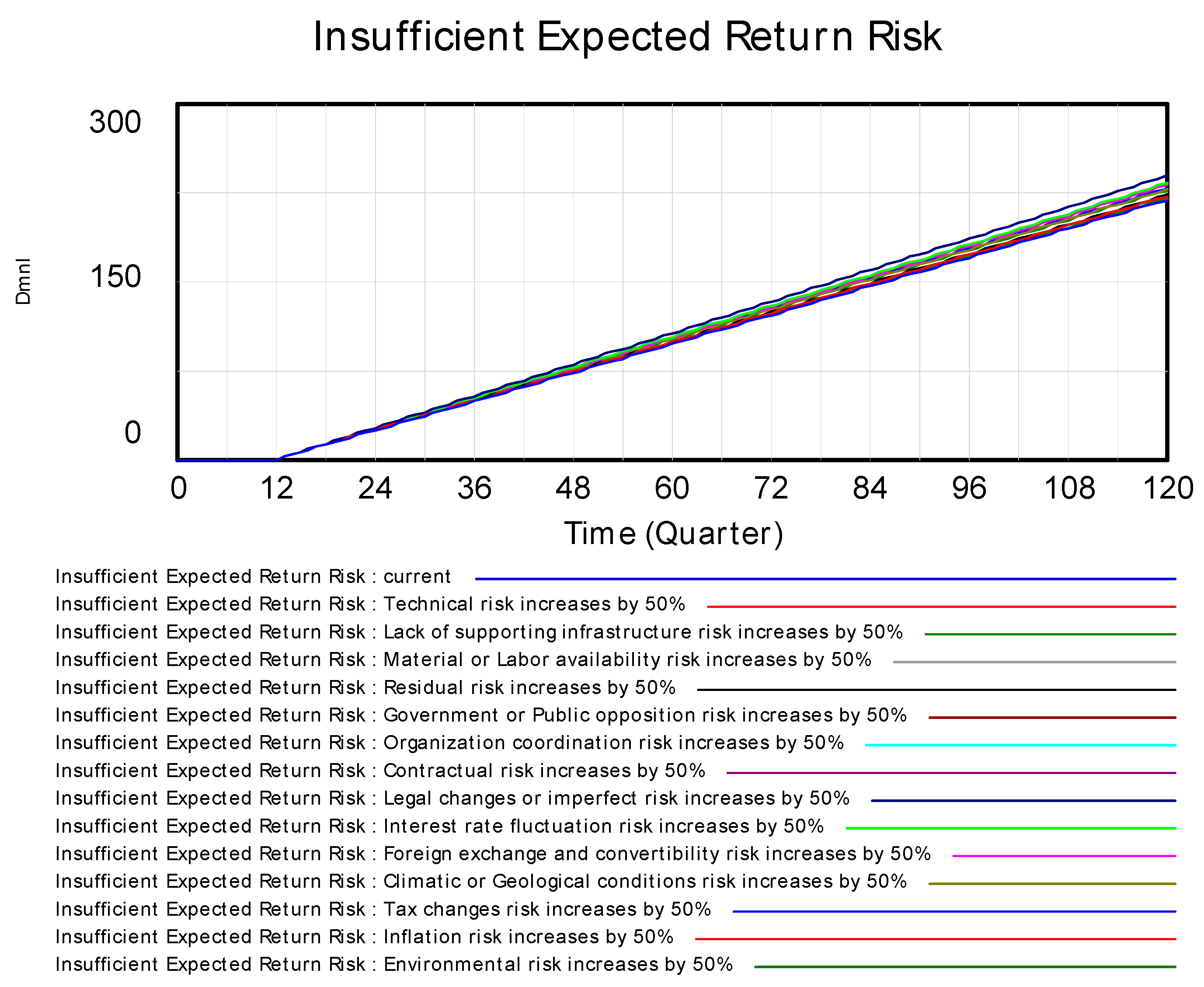

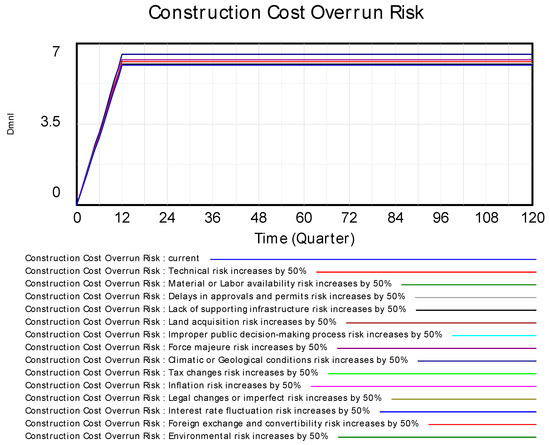

In analyzing the trends of risk changes in various subsystems, in addition to maintaining consistency with the results from Figure 10, Figure 11, Figure 12, Figure 13, Figure 14 and Figure 15, we found that changes in the parameters of individual risk factors led to significant changes in risk levels. This discovery reveals the high sensitivity of boundary risk factors to target risks, indicating the need to pay special attention to the uncertainties of these factors in actual projects and to determine which risk factors should be controlled during the concession period. The sensitivity analysis results of risk factors under each subsystem are detailed in Figure 16, Figure 17, Figure 18, Figure 19, Figure 20 and Figure 21. Boundary risk factors not listed are considered to have little or no impact on the target risks. Additionally, through multiple sensitivity analysis validations, results show that despite the impact of parameter changes, the key risk trends and sensitivity rankings remain relatively stable, thus confirming the robustness of the model.
During the 30-year concession period, the risk management system of the wind energy PPP project shows dynamic changes in risks based on certain trends, due to interactions among various subsystems. This paper conducted sensitivity analyses on individual risk factors and simulated the development trends of risks as the values of these risk factors change. The trends obtained are consistent with the simulation results shown in Figure 10, Figure 11, Figure 12, Figure 13, Figure 14 and Figure 15. Further observation revealed that changes in certain boundary risk factors have a significant impact on the target risks. Moreover, to further verify the reliability of the model, this study selected a specific offshore wind power PPP project in Yancheng, Jiangsu Province, for empirical validation. The project, which started in 2015, employs a typical PPP model involving local government departments, a wind energy development company (China Huaneng New Energy Co., Ltd.—Beijing, China), financial institutions (China Construction Bank– Beijing, China), and the local electricity grid company. By collecting and organizing operational data and risk management records of the project over the past five years, especially the actual performance of key factors such as technical risks, environmental risks, and policy risks, this study found that the risk trends simulated by the dynamic risk model developed in this paper closely match (with a similarity exceeding 85%) the actual risk trends of the project. This further indicates that the dynamic risk model constructed in this paper has good empirical applicability and can effectively reflect the patterns of risk changes in real projects.
Subsequently, by analyzing and ranking the sensitivity results for each subsystem, the boundary risk factors that have a significant impact on the target risks were identified. The ranking results are summarized in Table 4, which lists the top five boundary risks in each subsystem. Notably, the financing risk subsystem contains fewer risk factors (only three), indicating that other boundary risks have minimal impact on it.

6. Results and Discussion

Through numerical simulation, we identified six major risk subsystems in wind energy PPP projects: construction quality, construction cost overruns, and insufficient expected returns are considered significant risks; financing risks and construction delays are classified as higher risks; and operational overruns are low-risk. Among the three significant risks, the boundary risks that most impact construction quality are force majeure risk, technical risk, delays in approvals and permits risk, climatic/geological conditions risk, and environmental risk, with a 50% increase in their risk factor values leading to respective increases in construction quality risk factors of 14.209%, 11.267%, 5.088%, 4.116%, and 2.231%. The boundary risks with the greatest impact on construction cost overrun risk are tax changes risk, interest rate fluctuation risk, climatic/geological conditions risk, environmental risk, and force majeure risk, with a 50% increase in their risk factor values causing respective increases in construction cost overrun risk factors of 8.241%, 8.236%, 7.927%, 7.924%, and 3.833%. The boundary risks most impacting the risk of insufficient expected returns are legal changes or imperfect risk, interest rate fluctuation risk, foreign exchange and convertibility risk, tax changes risk, and inflation risk, with a 50% increase in their risk factor values resulting in respective increases in insufficient expected return risk factors of 9.342%, 6.457%, 5.661%, 4.558%, and 4.254%. Among the two higher risks, the boundary risks that most impact financing risk are legal changes or imperfect risk, interest rate fluctuation risk, and foreign exchange and convertibility risk, with a 50% increase in their risk factor values leading to respective increases in financing risk factors of 21.280%, 14.749%, and 13.971%. The boundary risks that most impact construction delay risks are climatic/geological conditions risk, technical risk, environmental risk, material/labor availability risk, and legal changes or imperfect risk, with a 50% increase in their risk factor values resulting in respective increases in construction delay risk factors of 14.999%, 11.381%, 8.132%, 6.844%, and 3.713%. Operational overrun risk is classified as low-risk, and the boundary risks that most affect it are tax changes risk, interest rate fluctuation risk, climatic/geological conditions risk, and force majeure risk, with a 50% increase in their risk factor values causing respective increases in operational overrun risk factors of 18.563%, 14.228%, 9.038%, and 8.172%. Therefore, the boundary risk factors that require particular control in the project include force majeure risk, technical risk, delays in approvals and permits risk, climatic or geological conditions risk, environmental risk, tax changes risk, legal changes or imperfect risk, interest rate fluctuation risk, foreign exchange and convertibility risk, inflation risk, and material/labor availability risk. These risk factors can have a profound impact on the feasibility, construction efficiency, and long-term operation of the project. To better prevent and address these risks, effective risk diversification measures must be implemented to manage them appropriately.
The principle of risk diversification emphasizes the reasonable sharing and management of risks, which is especially crucial in wind energy PPP projects that involve substantial funding and multiple stakeholders. Project risks may arise at any stage, so it is essential to comprehensively consider the interactions between all relevant parties and risk factors. In this study, project participants are categorized into three groups: government and regulatory agencies, project implementers, and market and societal stakeholders. Among these, government departments and project implementers are the two main risk-bearing entities. Government and regulatory agencies are responsible for providing policy support, establishing the legal framework, and overseeing project implementation. Project implementers, including developers, contractors, investors, and technology suppliers, are responsible for the development, construction, and operation of the project. Market and societal participants, such as electricity buyers, local communities, and environmental organizations, focus on the social benefits and environmental impact of the project. By incorporating market and societal stakeholders into the risk management system, this study proposes a more comprehensive risk control framework that ensures risks can be managed and diversified from multiple dimensions. It is particularly important to emphasize that, for specific risks, the main relevant participants should proactively assume greater responsibility. Additionally, all participants need to fully recognize that risks in the project should not be borne solely by the party directly affected but should be viewed as a shared responsibility for the entire project. The occurrence of any single risk may trigger other risks through a chain reaction, affecting the overall success of the project. Therefore, all stakeholders should actively collaborate, jointly bear risks, and reasonably allocate responsibilities to enhance the project’s overall risk resilience, ensuring its long-term stable operation and success. Based on these principles, Table 5 details the specific risk diversification measures for each participant concerning the 11 key risk factors that require focused control. This effort to strengthen cooperation and coordination aims to minimize the potential impact of risks on the project, ensuring the successful implementation and sustainable development of wind energy PPP projects.

7. Conclusions

In wind energy PPP projects, scientifically sound and effective risk management and mitigation strategies are key to achieving mutual benefits for all parties involved. This study has developed a risk mitigation indicator system that covers the entire project lifecycle, involving stakeholders such as government and regulatory agencies, project implementers, and market and societal participants. The system clearly delineates the boundaries of risk responsibility, helping projects identify and address potential risks in advance. It not only enhances the project’s risk management capabilities and predictability but also boosts investor confidence. The research further reveals the dynamic evolution patterns of risks in wind energy PPP projects and identifies key boundary risk factors. It proposes a multidimensional risk management strategy based on risk diversification theory. This strategy, by dispersing risks across different parties or stages, can not only improve the overall stability and success rate of the project but also enriches traditional risk identification and allocation mechanisms, providing practical reference for the field of risk management.
This study provides innovative strategies for risk management in wind energy PPP projects, but there is still room for improvement in their application and dissemination. Although the System Dynamics model offers a powerful tool for understanding and predicting risk evolution, its application relies on high-quality and accessible data, and the results may be influenced by initial model settings, data accuracy, and the reasonableness of parameter assumptions. The selection of specific parameters and the universality of the model require further validation with more extensive industry data. Therefore, future research could establish a more standardized and formalized risk assessment framework, integrating advanced methods such as big data analytics and intelligent technologies to enhance dynamic monitoring and real-time feedback capabilities for risks. Additionally, by expanding the data sample scope and gathering more data from industry experts and research institutions, the universality of the model could be further validated, and parameter settings optimized, improving the stability and reliability of assessment results. Exploring the integration of System Dynamics models with other economic models or machine learning algorithms could enhance the model’s predictive accuracy and automatic adjustment capabilities. It may also be beneficial to empirically test the model developed in this study in wind energy PPP projects across different regions, systems, and cultural environments to verify and enhance its cross-regional applicability. By pursuing these approaches, more effective methods for dynamic risk dispersion and real-time monitoring can be explored, further enhancing the operability of the risk management strategies proposed in this study in practice, thereby promoting the long-term success and global dissemination of wind energy PPP projects.

Author Contributions

Conceptualization, R.L.; methodology, R.L. and Y.W.; software, R.L.; validation, R.L., S.L. and Y.W.; formal analysis, R.L.; investigation, R.L. and S.L.; resources, Y.W.; data curation, S.L.; writing—original draft preparation, R.L.; writing—review and editing, R.L., S.L. and Y.W.; visualization, R.L. and S.L.; supervision, Y.W.; project administration, R.L.; funding acquisition, Y.W. All authors have read and agreed to the published version of the manuscript.

Funding

This work was supported by the Ministry of Education Humanities and Social Sciences Research Planning Fund Project of China under grant No.24YJA630093, and the National Natural Science Foundation of China under grant No. 71901068.

Data Availability Statement

Data Availability Statement: The authors confirm that the data supporting the findings of this study are available within the article.

Acknowledgments

The authors would like to express their sincere gratitude to the editor and the anonymous reviewers for their insightful and constructive comments.

Conflicts of Interest

The authors declare that the research was conducted in the absence of any commercial or financial relationships that could be construed as a potential conflict of interest.

Appendix A

Table A1. Risk identification in PPP projects.
Table A1. Risk identification in PPP projects.
Risk FactorsReferencesTotal
ABCDEFGHIJKLMNOPQRSTUVWXYZ
Lack of support from government** ** * * * ****11
Unstable government** * **** * * * **12
political interference** * ** ** *** ** ** * *16
Corruption and bribery** * ** * * * 8
Nationalization/expropriation** ** * * * * ** 10
Inflation risk** *** **** * ** * 13
Interest rate fluctuation risk** *** * *** * ** * 13
Legal changes or imperfect risk** *** ** ** *** ****** *19
Tax changes risk** *** * * * 8
Government/Public opposition risk** ** ** * * *** * 12
Environmental risk** *** * ** *** *****16
Force majeure risk*** * * **** * ****** 16
Climatic/Geological conditions risk** * ** * * *8
Construction time delay risk** ** ** * * * *** 12
Site safety and security risk** * * * 5
Construction quality risk** ** ** ** * ** 11
Construction cost overrun risk** *** *** ** * *** 14
Contractual risk** ** *** ** * *** 13
Material/Labor availability risk** ** ** ** ** 10
Delays in approvals and permits risk** ** * ** * 8
Design flaw/changes risk* *** *** ** * *** 13
Demand risk** * * ** ** ** *** 13
Maintenance cost overrun risk** * * *** ** 9
Operation cost overrun risk** * ** *** ***** 13
High frequency of maintenance risk** * * *** 7
Low operational efficiency risk** * ** * 6
Residual risk** * * * 5
Organization coordination risk** * * * ** * 8
Political risk *** ** * *** *******16
Land acquisition risk * ** * * * ** 8
Revenue risk *** * ** *** ** * 12
Technical risk** **** **** ** ***** 17
Financing risk** *** ** * * * *****15
Concession period risk * * * * 4
Payment risk * * * * * * 6
Bankruptcy/Default risk * * ** * 5
Competitive risk * * * * * * * ** 9
Improper public decision-making process risk * * *** * ** * ** 11
Foreign exchange and convertibility risk * * * * * * *6
Lack of supporting infrastructure risk * ** ** * 6
Public credit risk ** * * ** * 7
Pricing risk * * * * * * * 7
Project change risk * * ** * *6
* Inclusion of the specific risk factor in a reference. References: A = Hwang et al. [71]; B = Chou and Pramudawardhani [72]; C = Loosemore and Cheung [73]; D = Zhang et al. [74]; E = Shrestha et al. [75]; F = Shrestha et al. [76]; G = Nguyen et al. [77]; H = Keers and Van Fenema [78]; I = Wang et al. [79]; J = Le et al. [80]; K = Owolabi et al. [81]; L = Feng et al. [82]; M = Luo et al. [83]; N = Othman and Khallaf [84]; O = Kaminsky [85]; P = Bao et al. [86]; Q = Sun et al. [87]; R = Wang et al. [88]; S = Othman [89]; T = Chen et al. [90]; U = Guo et al. [91]; V = Jiang et al. [92]; W = Liu et al. [93]; X = Wang et al. [94]; Y = Chang et al. [95]; Z = Fleta-Asín and Muñoz [96].
Table A2. List of risk factors for PPP projects.
Table A2. List of risk factors for PPP projects.
Project PhaseRisk FactorRisk Description
Decision-making phaseLand acquisitionWind energy projects often face challenges related to environmental protection requirements and land use rights negotiations, which can lead to increased costs and project delays.
Delays in approvals and permits riskThe complex environmental impact assessments and energy planning approval processes add to the costs and time, limiting the flexibility for project adjustments.
Improper public decision-making process riskIrregular decision-making procedures and a lack of expertise may lead to errors in risk assessment and project delays.
Government/Public opposition riskEnvironmental impacts may trigger opposition from the public and government, thereby increasing the political and social risks of the project.
Financing phaseFinancing riskThe financing risk of wind energy projects primarily arises from fluctuations in the financial markets and an inadequate financing structure, which may lead to increased funding costs and hinder the financing process.
Construction phaseConstruction time delay riskDelays in construction result in increased costs and project schedule slippage, affecting the timely commissioning of wind energy projects.
Site safety and security riskSafety incidents that may occur during construction, including risks associated with high-altitude work and equipment operation.
Construction quality riskFailure to meet standards in materials or construction may lead to quality issues in wind turbines and their supporting structures.
Construction cost overrun riskBudget overruns due to fluctuations in raw material prices or construction delays.
Material/Labor availability riskShortages of critical materials, such as steel or specialized technical labor, can lead to project delays.
Technical riskChallenges in implementing wind power technology, including system integration and energy efficiency that do not meet expectations.
Design flaw/changes riskInsufficient initial design leading to subsequent changes, increasing costs and complexity.
Lack of supporting infrastructure riskInsufficient connections to the electrical grid or inadequate road infrastructure can impact the construction and operation of wind farms.
Project change riskNecessary engineering adjustments due to changes in policies, environmental requirements, or technological updates.
Operational phaseDemand riskInstability in wind power market demand caused by market dynamics, economic fluctuations, or policy changes.
Maintenance cost overrun riskFrequent repairs and increased costs due to quality issues with wind power equipment.
High frequency of maintenance riskExtreme weather conditions and other force majeure factors frequently impact the stability and maintenance requirements of wind power equipment.
Operation cost overrun riskIncreased operational costs due to changes in interest rates, tax policies, or poor management.
Low operational efficiency riskOperational inefficiencies or outdated technology affecting the efficiency and energy output of wind farms.
Operational phaseRevenue riskRevenue falling below expectations due to market price fluctuations in wind power or substandard energy output.
Pricing riskFluctuations in electricity market prices or policy adjustments affecting wind power sales prices, leading to revenue falling below expectations.
Competitive riskMarket share loss due to new competitors entering the market or improvements in alternative energy technologies.
Payment riskDelays or inability of the power purchaser to pay electricity fees due to economic pressures or policy changes.
Full life cycle phaseLegal changes or imperfect riskNew environmental regulations or changes that affect the cost and operation of wind power projects.
Contractual riskAmbiguous risk allocation or unclear responsibilities in wind power contracts leading to legal disputes.
Force majeure riskDamage to wind power facilities caused by natural disasters such as storms or earthquakes.
Environmental riskCost increases or project delays due to stricter environmental protection regulations affecting wind power projects.
Climatic/Geological conditions riskExtreme weather or unstable geological conditions increasing the construction and operational risks of wind power projects.
Bankruptcy/Default riskFinancial difficulties or defaults by partners affecting the continuity of the wind power project.
Inflation riskInflation potentially leading to increased operational costs for wind power projects.
Interest rate fluctuation riskFluctuations in financing costs due to changes in interest rates, affecting the financial stability of wind power projects.
Tax changes riskChanges in tax laws that may impact the economic benefits of wind power projects.
Public credit riskFailure of the government to fulfill support policies or financial commitments, affecting the investment return of the project.
Residual riskThe residual value of facilities after the project ends may be lower than expected.
Concession period riskAn early end to the concession period could result in insufficient investment recovery.
Foreign exchange and convertibility riskExchange rate fluctuations or conversion restrictions affecting the cost of procuring equipment from international markets.
Organization coordination riskInefficiency and cost overruns caused by poor project management.

Appendix B

Table A3. Respondent information table.
Table A3. Respondent information table.
Respondent ProfileCategory and Percentage
Type of OrganizationGovernment (1.96%)
State-owned Enterprise (29.41%)
Private Enterprise (9.8%)
Research Institution (11.76%)
Universities (47.06%)
Years of Experience in the Construction IndustryLess than 6 years (39.22%)
6–10 years (21.57%)
11–15 years (13.73%)
More than 15 years (25.49%)
Years of Experience in PPP ProjectsNone (5.88%)
Less than 3 years (41.18%)
3–5 years (23.53%)
More than 5 years (29.41%)
Number of PPP Projects Participated InNone (3.92%)
Less than 3 projects (54.9%)
3–5 projects (13.73%)
More than 5 projects (27.45%)
Table A4. Expert scoring standards.
Table A4. Expert scoring standards.
Importance LevelScore
Extremely important7
Strongly important6
Significantly important5
Comparatively important4
Fairly important3
Slightly important2
Not important1
Table A5. Weights used in the improved G1 weighting method.
Table A5. Weights used in the improved G1 weighting method.
Progress risk Boundary   risk   j Delays in approvals and permits riskConstruction time delay riskImproper public
decision-making process risk
Land acquisition riskLack of supporting infrastructure risk
Weights   W j 0.2070.2030.2150.1960.176
Change in construction quality risk Boundary   risk   j Progress riskTechnical riskForce majeure risk
Weights   W j 0.3450.2990.359
Project change risk Boundary   risk   j Design flaw/changes riskLegal changes or imperfect risk
Weights   W j 0.5200.480
Construction time delay risk Boundary   risk   j Project change riskClimatic/Geological conditions riskDesign flaw/changes riskEnvironmental riskSite security riskTechnical riskMaterial/Labor availability risk
Weights   W j 0.1590.1300.1520.1320.1490.1340.134
Construction cost overrun risk Boundary   risk   j Rework riskClimatic/Geological conditions riskEnvironmental riskTax changes riskFinancing riskInflation risk
Weights   W j 0.1780.1540.1580.1980.1580.156
Financing risk Boundary   risk   j Legal changes or imperfect riskInterest rate fluctuation riskForeign exchange and convertibility risk
Weights   W j 0.4050.3230.272
High frequency of maintenance risk Boundary   risk   j Force majeure riskClimatic/Geological conditions risk
Weights   W j 0.5060.494
Maintenance cost overrun risk Boundary   risk   j Change in construction quality riskHigh frequency of maintenance risk
Weights   W j 0.5220.478
Low operational efficiency risk Boundary   risk   j Maintenance cost overrun riskHigh frequency of maintenance risk
Weights   W j 0.5030.497
Operation cost overrun risk Boundary   risk   j Tax changes riskMaintenance cost overrun riskLow operational efficiency riskInterest rate fluctuation risk
Weights   W j 0.2800.2670.2370.215
Demand risk Boundary   risk   j Competitive riskPricing risk
Weights   W j 0.4880.512
Pricing risk Boundary   risk   j Payment riskInflation riskConcession period riskOperating cost risk
Weights   W j 0.2700.2510.2550.224
Revenue risk Boundary   risk   j Demand riskPricing risk
Weights   W j 0.5110.489
Insolvency default risk Boundary   risk   j Organization coordination riskContractual risk
Weights   W j 0.4630.537
Public credit risk Boundary   risk   j Contractual riskLegal changes or imperfect riskGovernment/Public opposition risk
Weights   W j 0.3290.3420.329
Insufficiency expected return risk Boundary   risk   j Revenue riskConstruction cost overrun riskFinancing riskSalvage value riskOperation cost overrun riskBankruptcy/
Default risk
Public credit risk
Weights   W j 0.1620.1490.1490.1340.1460.1440.116
Table A6. Coefficients of key risks determined using the entropy method.
Table A6. Coefficients of key risks determined using the entropy method.
Key RisksRisks j e i g i W i
Progress riskDelays in approvals and permits risk0.9630.0370.313
Construction time delay risk0.9820.0180.155
Improper public decision-making process risk0.9850.0150.131
Land acquisition risk0.9750.0250.215
Lack of supporting infrastructure risk0.9780.0220.186
Change in construction quality riskProgress risk0.9500.0500.427
Technical risk0.9760.0240.207
Force majeure risk0.9570.0430.365
Project change riskDesign flaw/changes risk0.9770.0230.421
Legal changes or imperfect risk0.9680.0320.579
Construction time delay riskProject change risk0.9820.0180.066
Climatic/Geological conditions risk0.9580.0420.155
Design flaw/changes risk0.9820.0180.067
Environmental risk0.9580.0420.156
Site security risk0.9740.0260.096
Technical risk0.9190.0810.300
Material/Labor availability risk0.9570.0430.159
Construction cost overrun riskRework risk0.9460.0540.260
Climatic/Geological conditions risk0.9660.0350.167
Environmental risk0.9710.0290.141
Tax changes risk0.9660.0340.163
Financing risk0.980.0200.095
Inflation risk0.9640.0360.175
Financing riskLegal changes or imperfect risk0.9680.0320.263
Interest rate fluctuation risk0.9670.0330.271
Foreign exchange and convertibility risk0.9440.0570.466
High frequency of maintenance riskForce majeure risk0.9710.0290.401
Climatic/Geological conditions risk0.9570.0430.599
Maintenance cost overrun riskChange in construction quality risk0.9640.0360.454
High frequency of maintenance risk0.9560.0440.547
Low operational efficiency riskMaintenance cost overrun risk0.9650.0350.468
High frequency of maintenance risk0.9600.040.532
Operation cost overrun riskTax changes risk0.9380.0620.336
Maintenance cost overrun risk0.9670.0330.179
Low operational efficiency risk0.9570.0430.234
Interest rate fluctuation risk0.9540.0470.251
Demand riskCompetitive risk0.9800.0200.463
Pricing risk0.9770.0230.537
Pricing riskPayment risk0.9690.0320.242
Inflation risk0.9710.0290.222
Concession period risk0.9540.0460.351
Operating cost risk0.9760.0240.185
Revenue riskDemand risk0.9800.0200.538
Pricing risk0.9830.0170.462
Insolvency default riskOrganization coordination risk0.9680.0320.650
Contractual risk0.9830.0170.350
Public credit riskContractual risk0.9780.0220.318
Legal changes or imperfect risk0.9760.0250.360
Government/Public opposition risk0.9780.0220.322
Insufficiency expected return riskRevenue risk0.9740.0260.134
Construction cost overrun risk0.9670.0330.171
Financing risk0.9800.0200.103
Salvage value risk0.9620.0380.198
Operation cost overrun risk0.9680.0320.168
Bankruptcy/Default risk0.9780.0220.116
Public credit risk0.9790.0210.111
Table A7. Combined weights of risk factors.
Table A7. Combined weights of risk factors.
Progress risk Boundary   risk   j Delays in approvals and permits riskConstruction time delay riskImproper public
decision-making process risk
Land acquisition riskLack of supporting infrastructure risk
Weights   W j 0.2600.1790.1730.2060.181
Change in construction quality risk Boundary   risk   j Progress riskTechnical riskForce majeure risk
Weights   W j 0.3860.2530.362
Project change risk Boundary   risk   j Design flaw/changes riskLegal changes or imperfect risk
Weights   W j 0.4710.480
Construction time delay risk Boundary   risk   j Project change riskClimatic/Geological conditions riskDesign flaw/changes riskEnvironmental riskSite security riskTechnical riskMaterial/Labor availability risk
Weights   W j 0.1130.1430.1100.1440.1230.2170.147
Construction cost overrun risk Boundary   risk   j Rework riskClimatic/Geological conditions riskEnvironmental riskTax changes riskFinancing riskInflation risk
Weights   W j 0.2190.1610.1500.1810.1270.166
Financing risk Boundary   risk   j Legal changes or imperfect riskInterest rate fluctuation riskForeign exchange and convertibility risk
Weights   W j 0.3340.2970.369
High frequency of maintenance risk Boundary   risk   j Force majeure riskClimatic/Geological conditions risk
Weights   W j 0.4540.547
Maintenance cost overrun risk Boundary   risk   j Change in construction quality riskHigh frequency of maintenance risk
Weights   W j 0.4880.513
Low operational efficiency risk Boundary   risk   j Maintenance cost overrun riskHigh frequency of maintenance risk
Weights   W j 0.4860.515
Operation cost overrun risk Boundary   risk   j Tax changes riskMaintenance cost overrun riskLow operational efficiency riskInterest rate fluctuation risk
Weights   W j 0.3080.2230.2360.233
Demand risk Boundary   risk   j Competitive riskPricing risk
Weights   W j 0.4760.525
Pricing risk Boundary   risk   j Payment riskInflation riskConcession period riskOperating cost risk
Weights   W j 0.2560.2370.3030.205
Revenue risk Boundary   risk   j Demand riskPricing risk
Weights   W j 0.5250.476
Bankruptcy default risk Boundary   risk   j Organization coordination riskContractual risk
Weights   W j 0.5570.444
Public credit risk Boundary   risk   j Contractual riskLegal changes or imperfect riskGovernment/Public opposition risk
Weights   W j 0.3240.3510.326
Insufficiency expected return risk Boundary   risk   j Revenue riskConstruction cost overrun riskFinancing riskSalvage value riskOperation cost overrun riskBankruptcy/
Default risk
Public credit risk
Weights   W j 0.1480.1600.1260.1660.1570.1300.114

References

  1. Liu, Y.; Song, P. Digital Transformation and Green Innovation of Energy Enterprises. Sustainability 2023, 15, 7703. [Google Scholar] [CrossRef]
  2. Li, Y.; Tang, D.; Yuan, C.; Diaz-Londono, C.; Agundis-Tinajero, G.D.; Guerrero, J.M. The Roles of Hydrogen Energy in Ports: Comparative Life-Cycle Analysis Based on Hydrogen Utilization Strategies. Int. J. Hydrogen Energy 2025, 106, 1356–1372. [Google Scholar] [CrossRef]
  3. Yang, Q.-C.; Zheng, M.; Chang, C.-P. Energy Policy and Green Innovation: A Quantile Investigation into Renewable Energy. Renew. Energy 2022, 189, 1166–1175. [Google Scholar] [CrossRef]
  4. Berg, V.I.; Zakirzakov, A.G.; Gordievskaya, E.F. Dynamics Analysis of Wind Energy Production Development. IOP Conf. Ser. Earth Environ. Sci. 2017, 50, 012033. [Google Scholar] [CrossRef]
  5. Li, M.; Carroll, J.; Ahmad, A.S.; Hasan, N.S.; Zolkiffly, M.Z.B.; Falope, G.B.; Sabil, K.M. Potential of Offshore Wind Energy in Malaysia: An Investigation into Wind and Bathymetry Conditions and Site Selection. Energies 2023, 17, 65. [Google Scholar] [CrossRef]
  6. Acosta-Silva, Y.D.J.; Torres-Pacheco, I.; Matsumoto, Y.; Toledano-Ayala, M.; Soto-Zarazúa, G.M.; Zelaya-Ángel, O.; Méndez-López, A. Applications of Solar and Wind Renewable Energy in Agriculture: A Review. Sci. Prog. 2019, 102, 127–140. [Google Scholar] [CrossRef] [PubMed]
  7. Mengi-Dinçer, H.; Ediger, V.Ş.; Yesevi, Ç.G. Evaluating the International Renewable Energy Agency through the Lens of Social Constructivism. Renew. Sustain. Energy Rev. 2021, 152, 111705. [Google Scholar] [CrossRef]
  8. Hopuare, M.; Manni, T.; Laurent, V.; Maamaatuaiahutapu, K. Investigating Wind Energy Potential in Tahiti, French Polynesia. Energies 2022, 15, 2090. [Google Scholar] [CrossRef]
  9. Kamali Saraji, M.; Streimikiene, D. A Novel Multicriteria Assessment Framework for Evaluating the Performance of the EU in Dealing with Challenges of the Low-Carbon Energy Transition: An Integrated Fermatean Fuzzy Approach. Sustain. Environ. Res. 2024, 34, 6. [Google Scholar] [CrossRef]
  10. Costoya, X.; deCastro, M.; Carvalho, D.; Gómez-Gesteira, M. On the Suitability of Offshore Wind Energy Resource in the United States of America for the 21st Century. Appl. Energy 2020, 262, 114537. [Google Scholar] [CrossRef]
  11. Dorrell, J.; Lee, K. The Politics of Wind: A State Level Analysis of Political Party Impact on Wind Energy Development in the United States. Energy Res. Soc. Sci. 2020, 69, 101602. [Google Scholar] [CrossRef]
  12. Mourão, R.R.; Mayer, A.; Cavallini Johansen, I.; Bortoleto, A.P.; Ninni Ramos, K.; Brown, E.; McCright, A.; Lopez, M.C.; Moran, E. News Consumption, Partisanship, and Energy Preferences in Brazil and the United States. Environ. Commun. 2024, 1–20. [Google Scholar] [CrossRef]
  13. Borunda, M.; Ramírez, A.; Garduno, R.; García-Beltrán, C.; Mijarez, R. Enhancing Long-Term Wind Power Forecasting by Using an Intelligent Statistical Treatment for Wind Resource Data. Energies 2023, 16, 7915. [Google Scholar] [CrossRef]
  14. Mastoi, M.S.; Zhuang, S.; Haris, M.; Hassan, M.; Ali, A. Large-Scale Wind Power Grid Integration Challenges and Their Solution: A Detailed Review. Environ. Sci. Pollut. Res. 2023, 30, 103424–103462. [Google Scholar] [CrossRef] [PubMed]
  15. Tan, J.D.; Chang, C.C.W.; Bhuiyan, M.A.S.; Minhad, K.N.; Ali, K. Advancements of Wind Energy Conversion Systems for Low-Wind Urban Environments: A Review. Energy Rep. 2022, 8, 3406–3414. [Google Scholar] [CrossRef]
  16. Spyridonidou, S.; Vagiona, D.G. Systematic Review of Site-Selection Processes in Onshore and Offshore Wind Energy Research. Energies 2020, 13, 5906. [Google Scholar] [CrossRef]
  17. Onar, S.Ç.; Kılavuz, T.N. Risk Analysis of Wind Energy Investments in Turkey. Hum. Ecol. Risk Assess. Int. J. 2015, 21, 1230–1245. [Google Scholar] [CrossRef]
  18. Martins, A.C.; Marques, R.C.; Cruz, C.O. Public–Private Partnerships for Wind Power Generation: The Portuguese Case. Energy Policy 2011, 39, 94–104. [Google Scholar] [CrossRef]
  19. Awuku, S.A.; Bennadji, A.; Muhammad-Sukki, F.; Sellami, N. Promoting the Solar Industry in Ghana through Effective Public-Private Partnership (PPP): Some Lessons from South Africa and Morocco. Energies 2022, 15, 17. [Google Scholar] [CrossRef]
  20. Sastoque, L.M.; Arboleda, C.A.; Ponz, J.L. A Proposal for Risk Allocation in Social Infrastructure Projects Applying PPP in Colombia. Procedia Eng. 2016, 145, 1354–1361. [Google Scholar] [CrossRef]
  21. Tallaki, M.; Bracci, E. Risk Allocation, Transfer and Management in Public–Private Partnership and Private Finance Initiatives: A Systematic Literature Review. Int. J. Public Sect. Manag. 2021, 34, 709–731. [Google Scholar] [CrossRef]
  22. Li, F.; Phoon, K.K.; Du, X.; Zhang, M. Improved AHP Method and Its Application in Risk Identification. J. Constr. Eng. Manag. 2013, 139, 312–320. [Google Scholar] [CrossRef]
  23. Cesarone, F.; Colucci, S. Minimum Risk versus Capital and Risk Diversification Strategies for Portfolio Construction. J. Oper. Res. Soc. 2018, 69, 183–200. [Google Scholar] [CrossRef]
  24. Akomea-Frimpong, I.; Jin, X.; Osei-Kyei, R. A Holistic Review of Research Studies on Financial Risk Management in Public–Private Partnership Projects. Eng. Constr. Arch. Manag. 2021, 28, 2549–2569. [Google Scholar] [CrossRef]
  25. Gao, Y.; Lau, C.K. Risk Assessment of Urban Rail Transit Project Using Interpretative Structural Modelling: Evidence from China. Math. Probl. Eng. 2021, 2021, 5581686. [Google Scholar] [CrossRef]
  26. Zhang, K.; Zhou, H.; Li, H.; Tang, A.; Li, C. Composite Power System Risk Evaluation Considering the Accurate Model of Renewable Power Output. Energy Rep. 2023, 9, 1861–1874. [Google Scholar] [CrossRef]
  27. Liu, J.; Liu, J.; Hu, J. Forecasting the Investors’ Escalation of Commitment in PPP Project at Different Project Stages: A Regression Model Based on the Influence of Social Factors. Eng. Manag. J. 2024, 36, 30–41. [Google Scholar] [CrossRef]
  28. Martiniello, L.; Morea, D.; Paolone, F.; Tiscini, R. Energy Performance Contracting and Public-Private Partnership: How to Share Risks and Balance Benefits. Energies 2020, 13, 3625. [Google Scholar] [CrossRef]
  29. Mao, Y.; Zhang, Y. Risk Identification and Allocation of the Utility Tunnel PPP Project. AIP Publishing LLC 2017, 1839, 020132. [Google Scholar] [CrossRef]
  30. Karim, N.A.A. Risk Allocation in Public Private Partnership (PPP) Project: A Review on Risk Factors. Int. J. Sustain. Constr. Eng. Technol. 2011, 2, 8–16. [Google Scholar]
  31. Liu, J.; Liu, J.; Bu, Z.; Zhou, Y.; He, P. Path Analysis of Influencing Government’s Excessive Behavior in PPP Project: Based on Field Dynamic Theory. Transp. Res. Part A Policy Pract. 2022, 166, 522–540. [Google Scholar] [CrossRef]
  32. Wang, D.; Qiao, Z. The Influence of Capital Deepening on Regional Economic Development Gap: The Intermediary Effect of the Labor Income Share. Sustainability 2022, 14, 16853. [Google Scholar] [CrossRef]
  33. Liu, Y.; Ling, H.; Ou, P.; Xu, K.; Kong, L. Pollution Emission Right Trading Policy and Green Total Factor Productivity. Technol. Anal. Strateg. Manag. 2024, 1–18. [Google Scholar] [CrossRef]
  34. Choo, W.; De Jong, P. Insights to Systematic Risk and Diversification across a Joint Probability Distribution. Insur. Math. Econ. 2016, 67, 142–150. [Google Scholar] [CrossRef]
  35. Li, Q.; Zhang, W. Sparse and Risk Diversification Portfolio Selection. Optim. Lett. 2023, 17, 1181–1200. [Google Scholar] [CrossRef]
  36. Ciullo, A.; Strobl, E.; Meiler, S.; Martius, O.; Bresch, D.N. Increasing Countries’ Financial Resilience through Global Catastrophe Risk Pooling. Nat. Commun. 2023, 14, 922. [Google Scholar] [CrossRef]
  37. Frey, R.; Hledik, J. Diversification and Systemic Risk: A Financial Network Perspective. Risks 2018, 6, 54. [Google Scholar] [CrossRef]
  38. Deng, G.; Kang, S.; Guo, K. Analysis on the Present Situation of Agricultural Catastrophe Risk Diversification in China. In Proceedings of the 7th Annual Meeting of Risk Analysis Council of China Association for Disaster Prevention, Changsha, China, 4–6 November 2016. [Google Scholar]
  39. Uchiyama, Y.; Kadoya, T.; Nakagawa, K. Complex Valued Risk Diversification. Entropy 2019, 21, 119. [Google Scholar] [CrossRef]
  40. Sugitomo, S.; Maeta, K. Quaternion Valued Risk Diversification. Entropy 2020, 22, 390. [Google Scholar] [CrossRef]
  41. Amiri, O.; Ayazi, A.; Rahimi, M.; Khazaeni, G. Risks of Water and Wastewater PPP Projects: An Investors’ Perspective. Constr. Innov. 2022, 22, 1104–1121. [Google Scholar] [CrossRef]
  42. Adu Gyamfi, T.; Aigbavboa, C.O.; Thwala, W.D. Risk Resources Management Influence on Public–Private Partnership Risk Management in Construction Industry. Confirmatory Factor Analysis Approach. J. Eng. Des. Technol. 2022, 22, 1544–1569. [Google Scholar] [CrossRef]
  43. Zhang, J.; Wang, T.; Zhang, L. Legal Risk Assessment Framework for International PPP Projects Based on Metanetwork. J. Constr. Eng. Manag. 2021, 147, 04021090. [Google Scholar] [CrossRef]
  44. Chen, H.; Wan, A.; Wei, G.; Peng, B. Multi-Dimensional Identification of Investment Risks in Renewable Energy Projects along the Belt and Road: An Integrated Framework Based on HHM and WRT. Technol. Anal. Strateg. Manag. 2024, 1–14. [Google Scholar] [CrossRef]
  45. Attarzadeh, M.; Chua, D.K.H.; Beer, M.; Abbott, E.L.S. Options-Based Negotiation Management of PPP–BOT Infrastructure Projects. Constr. Manag. Econ. 2017, 35, 676–692. [Google Scholar] [CrossRef]
  46. Cvetković, P.N. Typology and Control of the Risks by the Public Private Partnership. Zb. Rad. Pravnog Fak. Nišu 2012, 63, 121–145. [Google Scholar]
  47. Mineo, S. Comparing Rockfall Hazard and Risk Assessment Procedures along Roads for Different Planning Purposes. J. Mt. Sci. 2020, 17, 653–669. [Google Scholar] [CrossRef]
  48. Guo, J.; Ma, K. Risk Analysis for Hazardous Chemical Vehicle-Bridge Transportation System: A Dynamic Bayesian Network Model Incorporating Vehicle Dynamics. Reliab. Eng. Syst. Saf. 2024, 242, 109732. [Google Scholar] [CrossRef]
  49. Li, X.; Yan, X.; Ma, L.; Li, H.; Wang, H.; Cai, L.; Lu, S.; Tang, C.; Wei, X. Probabilistic Risk Analysis for Catenary System of Heavy-Haul Railway Based on Casual Inference. Concurr. Comput. 2025, 37, e8368. [Google Scholar] [CrossRef]
  50. Xu, Z.; He, Z.; Wang, X. Efficient Risk Estimation via Nested Multilevel Quasi-Monte Carlo Simulation. J. Comput. Appl. Math. 2024, 443, 115745. [Google Scholar] [CrossRef]
  51. Guo, B.; Li, J. Research on the Evolution of Participants Collaboration Mechanism in PPP Model Based on Computer Simulation: Based on the Old Community Renovation Project. J. Supercomput. 2020, 76, 2417–2434. [Google Scholar] [CrossRef]
  52. Li, R.; Zhang, G.; Li, S.; Wang, A. Driving Mechanism of High-Tech Enterprises Sustainable Development from Collaborative Dual Innovation Perspective in Eastern China Based on System Dynamics Model. Technol. Anal. Strateg. Manag. 2023, 36, 4531–4548. [Google Scholar] [CrossRef]
  53. Bajomo, M.; Ogbeyemi, A.; Zhang, W. A Systems Dynamics Approach to the Management of Material Procurement for Engineering, Procurement and Construction Industry. Int. J. Prod. Econ. 2022, 244, 108390. [Google Scholar] [CrossRef]
  54. Zhao, Y.; Zhou, Y.; Zhang, Y.; Chen, H. Exploring Intellectual Property Risk Inducement and Formation Mechanism of Innovation-Oriented Enterprises: A Grounded Theory Approach and System Dynamics Model Analysis. Technol. Anal. Strateg. Manag. 2023, 36, 4686–4700. [Google Scholar] [CrossRef]
  55. Liu, A.; Chen, K.; Huang, X.; Li, D.; Zhang, X. Dynamic risk assessment model of buried gas pipelines based on system dynamics. Reliab. Eng. Syst. Saf. 2021, 208, 107326. [Google Scholar] [CrossRef]
  56. Huang, L.; Wang, C.; Cui, B.; Zhou, H.; Wu, M.; Li, C. Employing an Interpretive Structural Modeling–System Dynamics Approach for Deep Foundation Pit Risk Assessment Model. ASCE-ASME J. Risk Uncertain. Eng. Syst. Part A Civ. Eng. 2024, 10, 04024004. [Google Scholar] [CrossRef]
  57. Hu, B.; Leopold, A.; Pickl, S. Concept and Prototype of a Web Tool for Public–Private Project Contracting Based on a System Dynamics Model. Cent. Eur. J. Oper. Res. 2015, 23, 407–419. [Google Scholar] [CrossRef]
  58. Morcillo, J.D.; Angulo, F.; Franco, C.J. Analyzing the Hydroelectricity Variability on Power Markets from a System Dynamics and Dynamic Systems Perspective: Seasonality and ENSO Phenomenon. Energies 2020, 13, 2381. [Google Scholar] [CrossRef]
  59. Calvo-Amodio, J.; Tercero-Gómez, V.G.; Ramirez-Galindo, J.G.; Martínez-Salazar, I. A Systemic Analysis of Professional Certification Rates: The Case of a Six Sigma Training Certificate Program. Eng. Manag. J. 2014, 26, 13–22. [Google Scholar] [CrossRef]
  60. Reiner, G.; Natter, M.; Drechsler, W. Life Cycle Profit–Reducing Supply Risks by Integrated Demand Management. Technol. Anal. Strateg. Manag. 2009, 21, 653–664. [Google Scholar] [CrossRef]
  61. Li, B.; Akintoye, A.; Edwards, P.J.; Hardcastle, C. Perceptions of Positive and Negative Factors Influencing the Attractiveness of PPP/PFI Procurement for Construction Projects in the UK: Findings from a Questionnaire Survey. Eng. Constr. Archit. Manag. 2005, 12, 125–148. [Google Scholar] [CrossRef]
  62. Salman, A.F.M.; Skibniewski, M.J.; Basha, I. BOT Viability Model for Large-Scale Infrastructure Projects. J. Constr. Eng. Manag. 2007, 133, 50–63. [Google Scholar] [CrossRef]
  63. Ying, L.; Qianying, D.; Zhihui, C.; Junwen, C.; Zhengjiang, L. Generation Model of Optimal EmergencyTreatment Technology for Sudden Heavy MetalPollution Based on Group-G1 Method. Pol. J. Environ. Stud. 2021, 30, 5899–5908. [Google Scholar] [CrossRef]
  64. de Rada, V.D. Handbook of Survey Research. Rev. Int. Sociol. 2013, 71, 229–233. [Google Scholar]
  65. Shannon, C.E. The Mathematical Theory of Communication. Bell Labs Tech. J. 1950, 3, 31–32. [Google Scholar] [CrossRef]
  66. Nikunj Agarwal, H.G. Entropy Based Multi-Criteria Decision Making Method under Fuzzy Environment and Unknown Attribute Weights. Glob. J. Technol. Optim. 2015, 06, 13–20. [Google Scholar] [CrossRef]
  67. Bayer, S. Business Dynamics: Systems Thinking and Modeling for a Complex World. Interfaces 2004, 34, 324–326. [Google Scholar]
  68. Wang, Y.; Gong, L.; Zheng, S.; Han, X.; Zhang, J.; Huang, Y. Temporal and Spatial Evolution of Public–Private Partnership (PPP) Project Risks in China: 2003–2019. Adv. Civ. Eng. 2024, 2024, 2689594. [Google Scholar] [CrossRef]
  69. John, A.; Yang, Z.; Riahi, R.; Wang, J. A Risk Assessment Approach to Improve the Resilience of a Seaport System Using Bayesian Networks. Ocean Eng. 2016, 111, 136–147. [Google Scholar] [CrossRef]
  70. Saltelli, A.; Puy, A.; Lo Piano, S. Sensitivity Analysis. SSRN J. 2021. [Google Scholar] [CrossRef]
  71. Hwang, B.-G.; Zhao, X.; Gay, M.J.S. Public Private Partnership Projects in Singapore: Factors, Critical Risks and Preferred Risk Allocation from the Perspective of Contractors. Int. J. Proj. Manag. 2013, 31, 424–433. [Google Scholar] [CrossRef]
  72. Chou, J.-S.; Pramudawardhani, D. Cross-Country Comparisons of Key Drivers, Critical Success Factors and Risk Allocation for Public-Private Partnership Projects. Int. J. Proj. Manag. 2015, 33, 1136–1150. [Google Scholar] [CrossRef]
  73. Loosemore, M.; Cheung, E. Implementing Systems Thinking to Manage Risk in Public Private Partnership Projects. Int. J. Proj. Manag. 2015, 33, 1325–1334. [Google Scholar] [CrossRef]
  74. Zhang, S.; Chan, A.P.C.; Feng, Y.; Duan, H.; Ke, Y. Critical Review on PPP Research—A Search from the Chinese and International Journals. Int. J. Proj. Manag. 2016, 34, 597–612. [Google Scholar] [CrossRef]
  75. Shrestha, A.; Chan, T.-K.; Aibinu, A.A.; Chen, C.; Martek, I. Risks in PPP Water Projects in China: Perspective of Local Governments. J. Constr. Eng. Manag. 2017, 143, 05017006. [Google Scholar] [CrossRef]
  76. Shrestha, A.; Chan, T.-K.; Aibinu, A.A.; Chen, C.; Martek, I. Risk Allocation Inefficiencies in Chinese PPP Water Projects. J. Constr. Eng. Manag. 2018, 144, 04018013. [Google Scholar] [CrossRef]
  77. Nguyen, A.; Mollik, A.; Chih, Y.-Y. Managing Critical Risks Affecting the Financial Viability of Public–Private Partnership Projects: Case Study of Toll Road Projects in Vietnam. J. Constr. Eng. Manag. 2018, 144, 05018014. [Google Scholar] [CrossRef]
  78. Keers, B.B.M.; Van Fenema, P.C. Managing Risks in Public-Private Partnership Formation Projects. Int. J. Proj. Manag. 2018, 36, 861–875. [Google Scholar] [CrossRef]
  79. Wang, H.; Liu, Y.; Xiong, W.; Song, J. The Moderating Role of Governance Environment on the Relationship between Risk Allocation and Private Investment in PPP Markets: Evidence from Developing Countries. Int. J. Proj. Manag. 2019, 37, 117–130. [Google Scholar] [CrossRef]
  80. Le, P.T.; Chileshe, N.; Kirytopoulos, K.; Rameezdeen, R. Investigating the Significance of Risks in BOT Transportation Projects in Vietnam. Eng. Constr. Arch. Manag. 2020, 27, 1401–1425. [Google Scholar] [CrossRef]
  81. Owolabi, H.A.; Oyedele, L.O.; Alaka, H.A.; Ajayi, S.O.; Akinade, O.O.; Bilal, M. Critical Success Factors for Ensuring Bankable Completion Risk in PFI/PPP Megaprojects. J. Manag. Eng. 2020, 36, 04019032. [Google Scholar] [CrossRef]
  82. Feng, Y.; Guo, X.; Wei, B.; Chen, B. A Fuzzy Analytic Hierarchy Process for Risk Evaluation of Urban Rail Transit PPP Projects. J. Intell. Fuzzy Syst. 2021, 41, 5117–5128. [Google Scholar] [CrossRef]
  83. Luo, C.; Ju, Y.; Dong, P.; Gonzalez, E.D.R.S.; Wang, A. Risk Assessment for PPP Waste-to-Energy Incineration Plant Projects in China Based on Hybrid Weight Methods and Weighted Multigranulation Fuzzy Rough Sets. Sustain. Cities Soc. 2021, 74, 103120. [Google Scholar] [CrossRef]
  84. Othman, K.; Khallaf, R. Identification of the Barriers and Key Success Factors for Renewable Energy Public-Private Partnership Projects: A Continental Analysis. Buildings 2022, 12, 1511. [Google Scholar] [CrossRef]
  85. Kaminsky, J.A. Improving Public–Private Partnerships for Renewable Electricity Infrastructure in Lower- and Middle-Income Countries. J. Constr. Eng. Manag. 2022, 148, 04022012. [Google Scholar] [CrossRef]
  86. Bao, F.; Martek, I.; Chen, C.; Wu, Q.; Chan, A.P.C. Critical Risks Inherent to the Transfer Phase of Public–Private Partnership Water Projects in China. J. Manag. Eng. 2022, 38, 04022006. [Google Scholar] [CrossRef]
  87. Sun, G.; Sun, J.; Li, F. Influencing Factors of Early Termination for PPP Projects Based on Multicase Grounded Theory. J. Constr. Eng. Manag. 2022, 148, 04022120. [Google Scholar] [CrossRef]
  88. Wang, Y.; Li, Q.; Zuo, J.; Bartsch, K. How Did Balance Loss Occur? A Cross-Stakeholder Analysis of Risk Misallocation in a Sponge City PPP Project. Water Resour. Manag. 2022, 36, 5225–5240. [Google Scholar] [CrossRef]
  89. Othman, K. Renewable Energy Public-Private Partnership Projects in Egypt: Perception of the Barriers and Key Success Factors by Sector. Alex. Eng. J. 2023, 75, 513–530. [Google Scholar] [CrossRef]
  90. Chen, H.; Wang, J.; Feng, Z.; Liu, Y.; Xu, W.; Qin, Y. Research on the Risk Evaluation of Urban Wastewater Treatment Projects Based on an Improved Fuzzy Cognitive Map. Sustain. Cities Soc. 2023, 98, 104796. [Google Scholar] [CrossRef]
  91. Guo, Y.; Wang, X.; Liu, L.; Chen, C.; Martek, I.; Luo, X. Dynamic Assessment of the Transfer Risks in China’s Public–Private Partnership Water Projects: A System Dynamics Approach. J. Infrastruct. Syst. 2023, 29, 04023033. [Google Scholar] [CrossRef]
  92. Jiang, F.; Lyu, Y.; Zhang, Y.; Guo, Y. Research on the Differences between Risk-Factor Attention and Risk Losses in PPP Projects. J. Constr. Eng. Manag. 2023, 149, 04023090. [Google Scholar] [CrossRef]
  93. Liu, Y.; Wang, X.; Zhang, J.; Guo, S. How Risk Factors Lead to the Early Termination of Public–Private Partnership Projects in China: A Multi-Case Study Based on Social Network Analysis and Interpretive-Structure Modeling. Eng. Constr. Arch. Manag. 2023, 32, 824–846. [Google Scholar] [CrossRef]
  94. Wang, Z.; Zhou, Y.; Jin, X.; Zhao, N.; Sun, J. Risk Allocation and Benefit Distribution of PPP Projects for Construction Waste Recycling: A Case Study of China. Eng. Constr. Archit. Manag. 2023, 30, 3927–3956. [Google Scholar] [CrossRef]
  95. Chang, Z.; Zheng, Y.; Qu, M.; Gao, X.; Tian, X.; Liu, G. Motion Analysis of International Energy Agency Wind 15 MW Floating Offshore Wind Turbine under Extreme Conditions. J. Mar. Sci. Eng. 2024, 12, 1166. [Google Scholar] [CrossRef]
  96. Fleta-Asín, J.; Muñoz, F. Risk Allocation Schemes between Public and Private Sectors in Green Energy Projects. J. Environ. Manag. 2024, 357, 120650. [Google Scholar] [CrossRef] [PubMed]
Figure 1. Flowchart of this paper.
Figure 1. Flowchart of this paper.
Systems 13 00237 g001
Figure 2. Causal feedback diagram of risk factors for wind energy PPP projects. (The “+” indicates the positive cumulative relationship between the factors.)
Figure 2. Causal feedback diagram of risk factors for wind energy PPP projects. (The “+” indicates the positive cumulative relationship between the factors.)
Systems 13 00237 g002
Figure 3. Stock and flow diagram of risk factors for wind energy PPP projects. The “+” symbol represents the positive cumulative relationship between factors. (The “Source” refers to the starting or ending point of the flow, and “Valve” is used to control the flow rate.)
Figure 3. Stock and flow diagram of risk factors for wind energy PPP projects. The “+” symbol represents the positive cumulative relationship between factors. (The “Source” refers to the starting or ending point of the flow, and “Valve” is used to control the flow rate.)
Systems 13 00237 g003
Figure 4. Cause tree analysis of construction time delay risk.
Figure 4. Cause tree analysis of construction time delay risk.
Systems 13 00237 g004

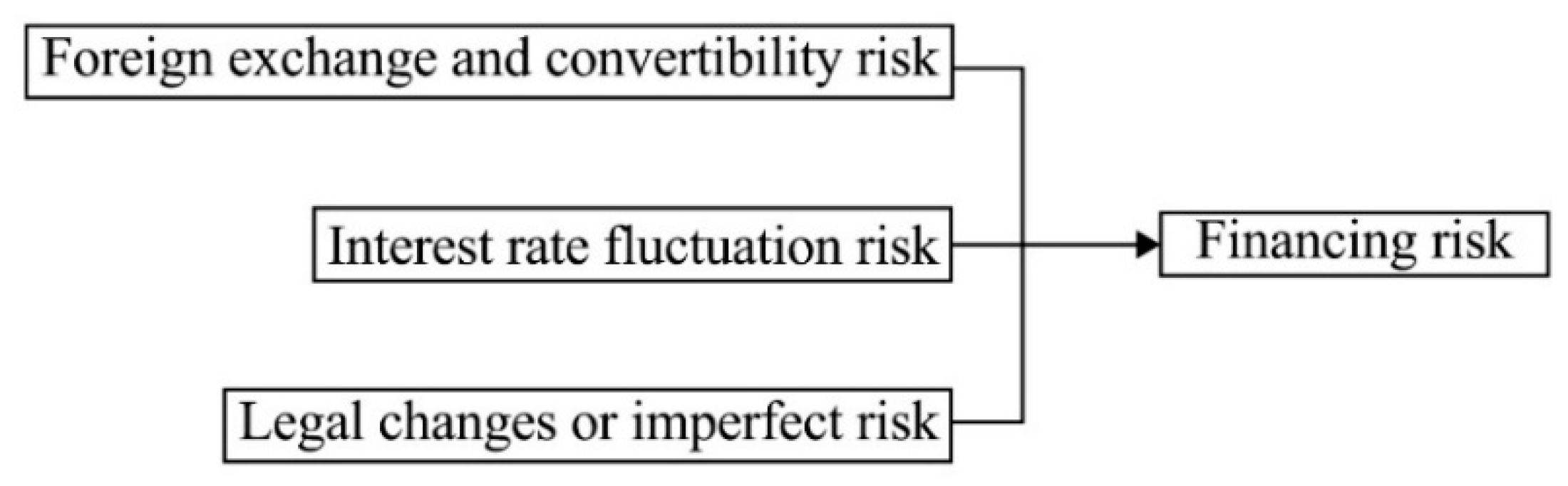

Figure 5. Cause tree analysis of financing risk.
Figure 5. Cause tree analysis of financing risk.
Systems 13 00237 g005

Figure 6. Cause tree analysis of construction quality risk.
Figure 6. Cause tree analysis of construction quality risk.
Systems 13 00237 g006
Figure 7. Cause tree analysis of construction cost overrun risk.
Figure 7. Cause tree analysis of construction cost overrun risk.
Systems 13 00237 g007

Figure 8. Cause tree analysis of operation cost overrun risk.
Figure 8. Cause tree analysis of operation cost overrun risk.
Systems 13 00237 g008

Figure 9. Cause tree analysis of insufficient expected return risk.
Figure 9. Cause tree analysis of insufficient expected return risk.
Systems 13 00237 g009

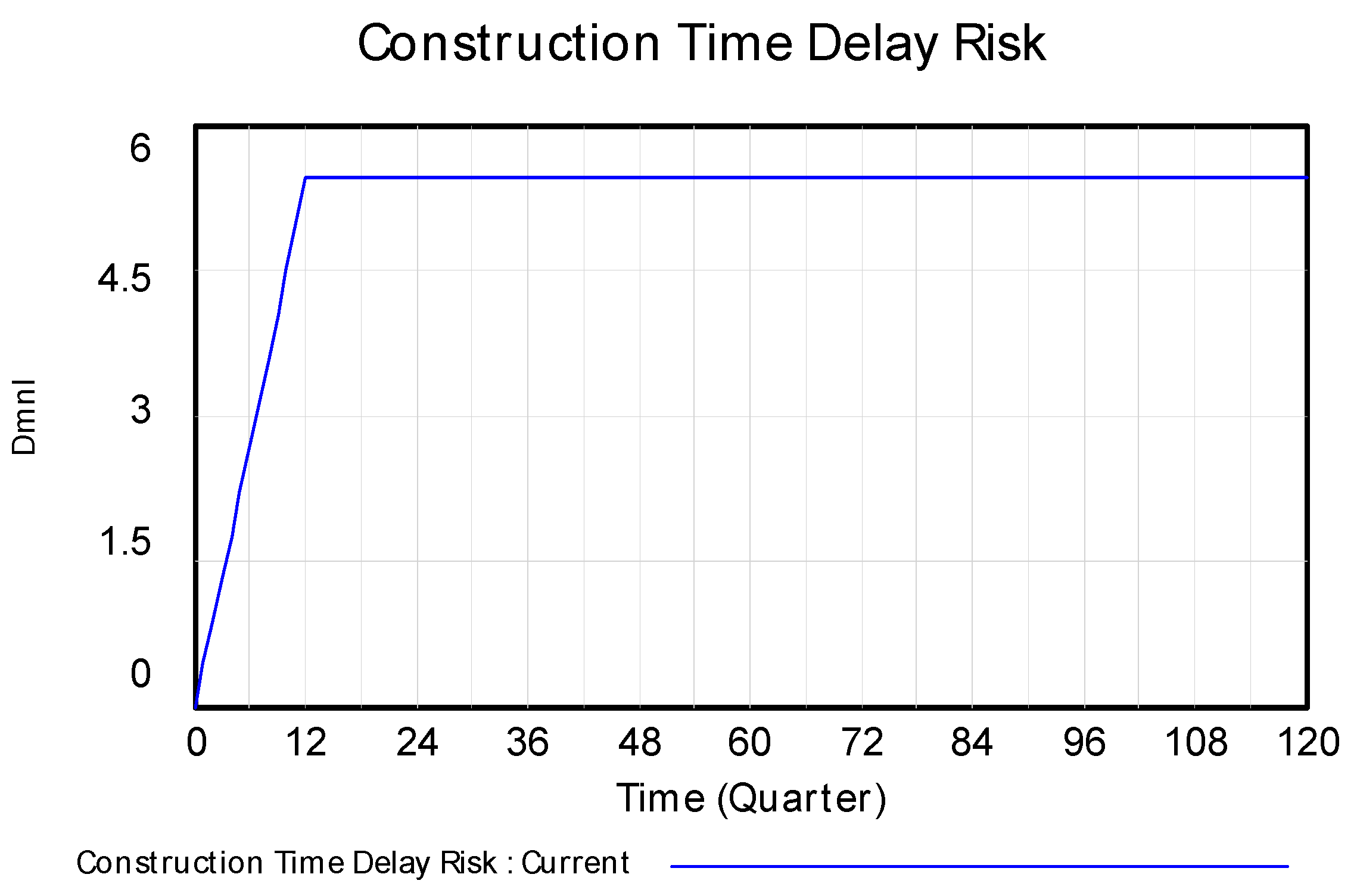

Figure 10. Construction time delay risk simulation results (“DMNL” refers to dimensionless units used in the model to represent the ratios or relative changes between variables, while “Quarter” denotes the division of the time axis into quarters, which is used to display seasonal data or the results of time series analyses).
Figure 10. Construction time delay risk simulation results (“DMNL” refers to dimensionless units used in the model to represent the ratios or relative changes between variables, while “Quarter” denotes the division of the time axis into quarters, which is used to display seasonal data or the results of time series analyses).
Systems 13 00237 g010

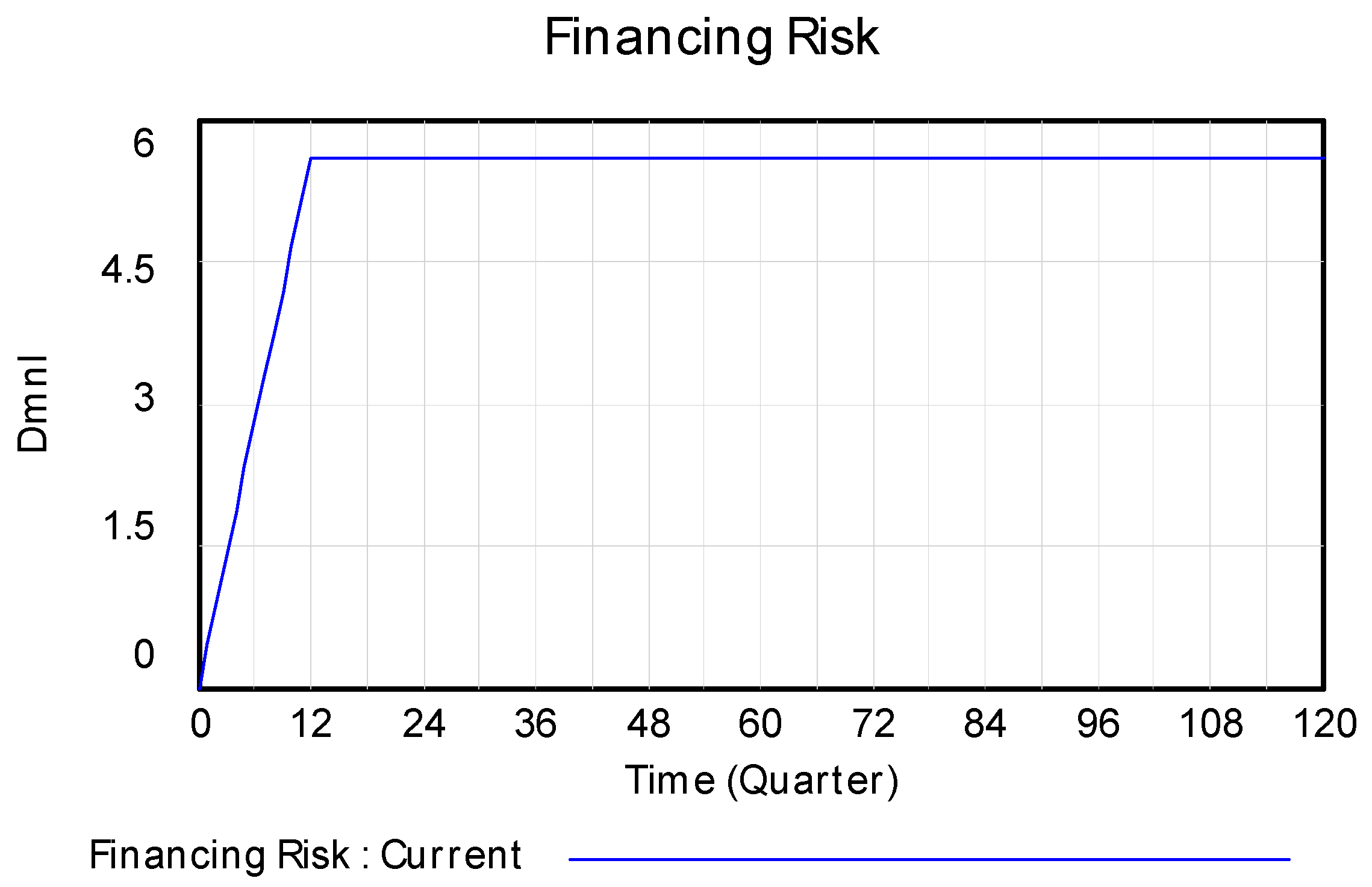

Figure 11. Financing risk simulation results.
Figure 11. Financing risk simulation results.
Systems 13 00237 g011
Figure 12. Construction quality risk simulation results.
Figure 12. Construction quality risk simulation results.
Systems 13 00237 g012

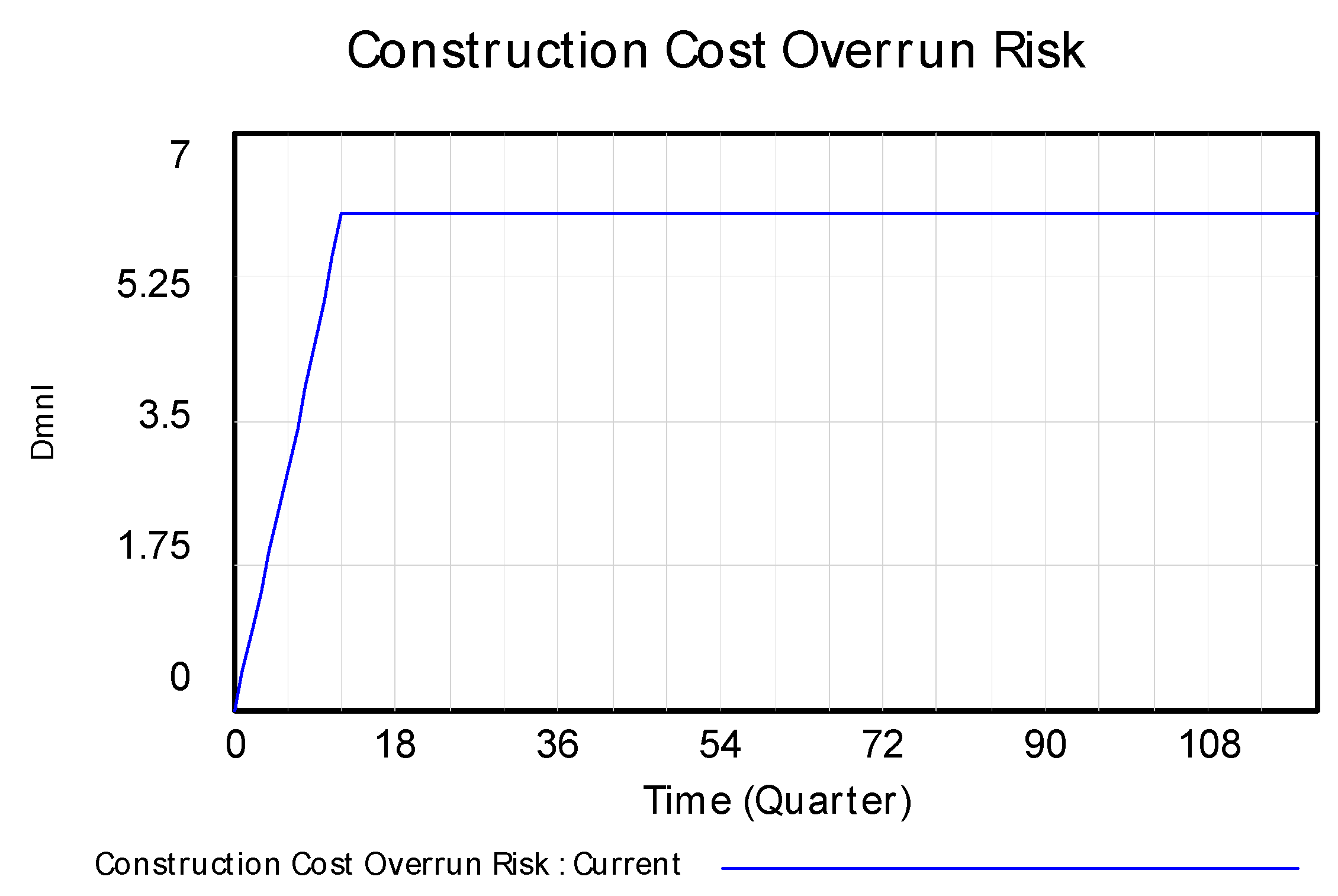

Figure 13. Construction cost overrun risk simulation results.
Figure 13. Construction cost overrun risk simulation results.
Systems 13 00237 g013

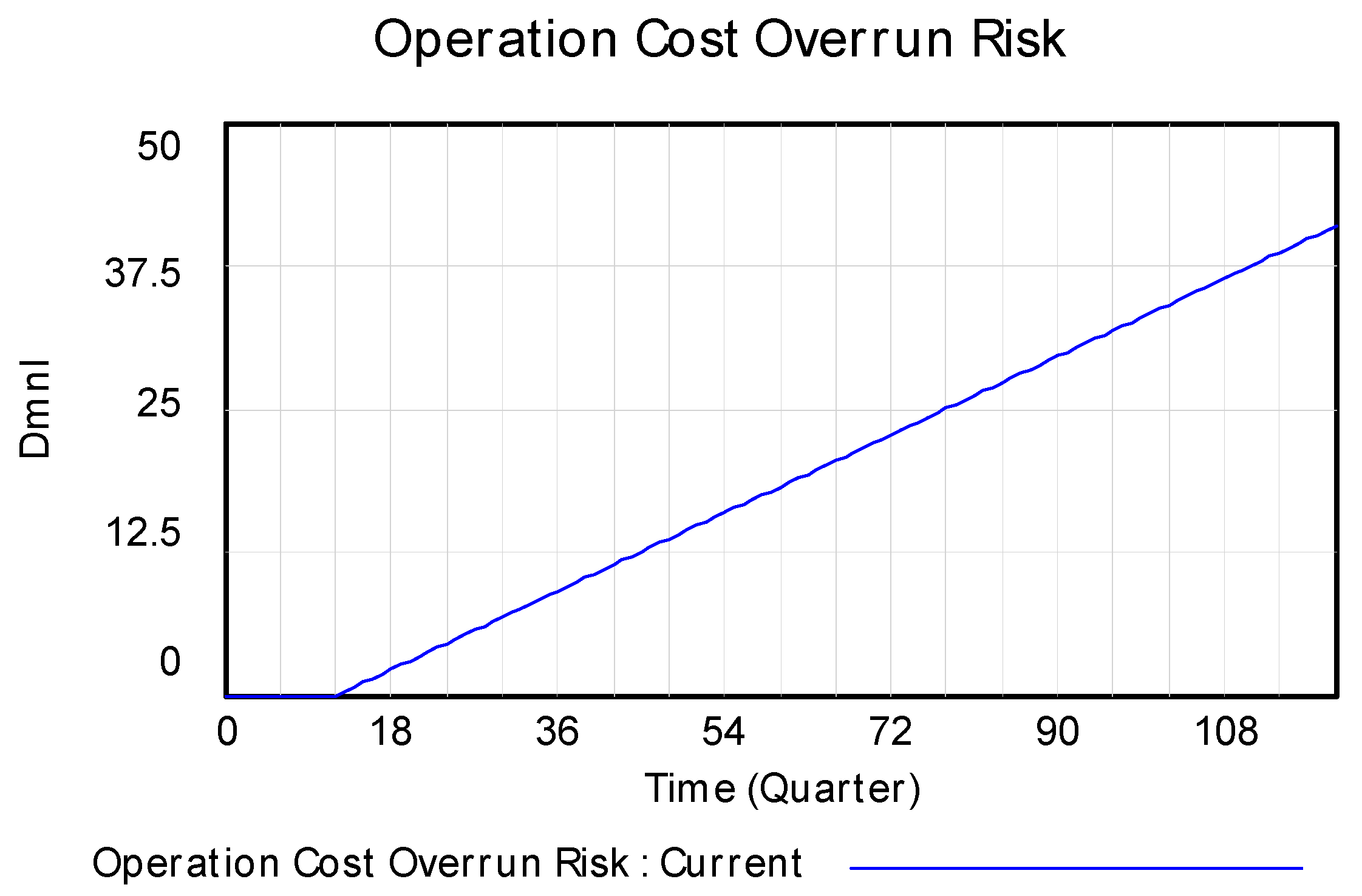

Figure 14. Operation cost overrun risk simulation results.
Figure 14. Operation cost overrun risk simulation results.
Systems 13 00237 g014

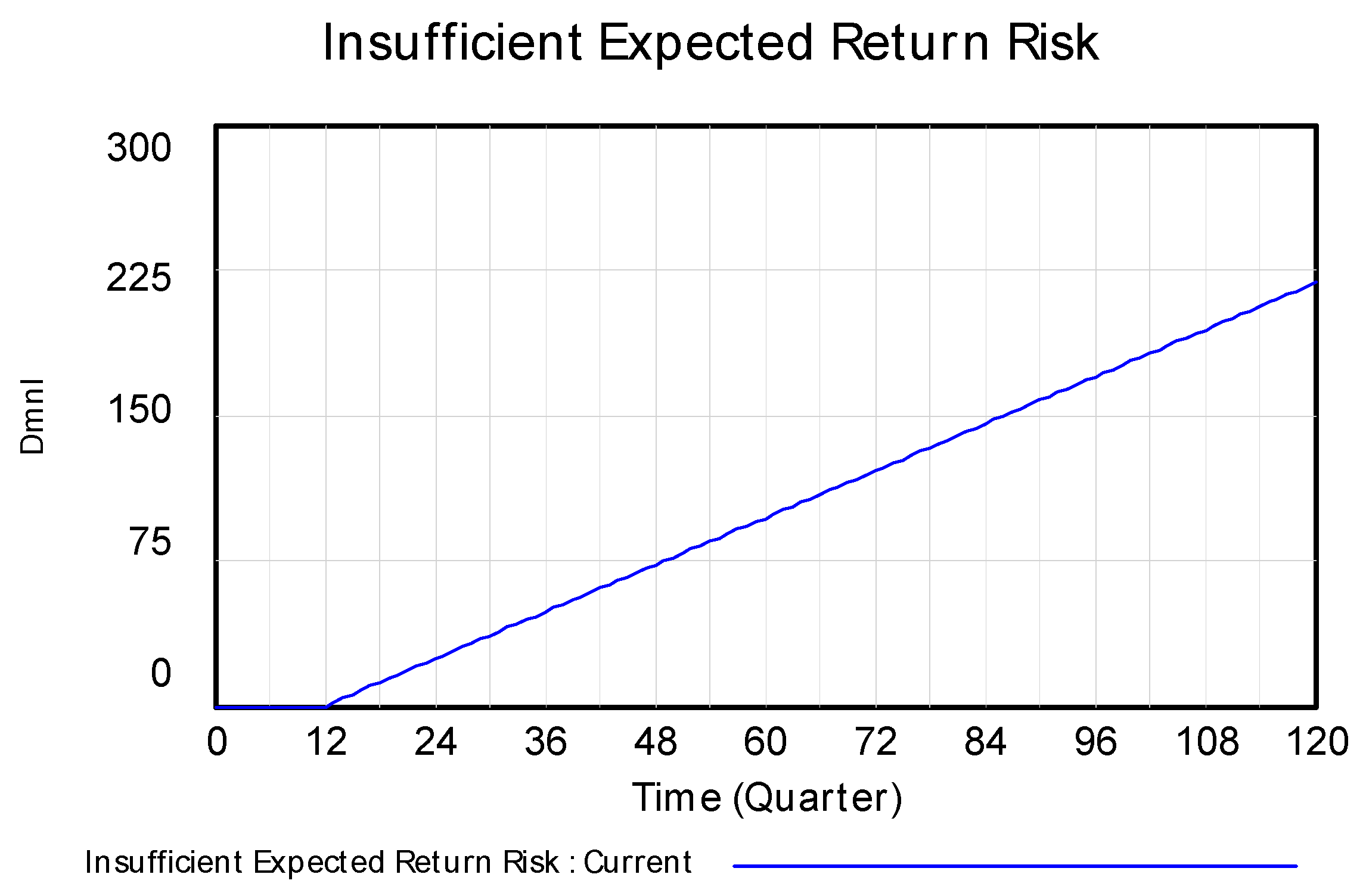

Figure 15. Insufficient expected return risk simulation results.
Figure 15. Insufficient expected return risk simulation results.
Systems 13 00237 g015

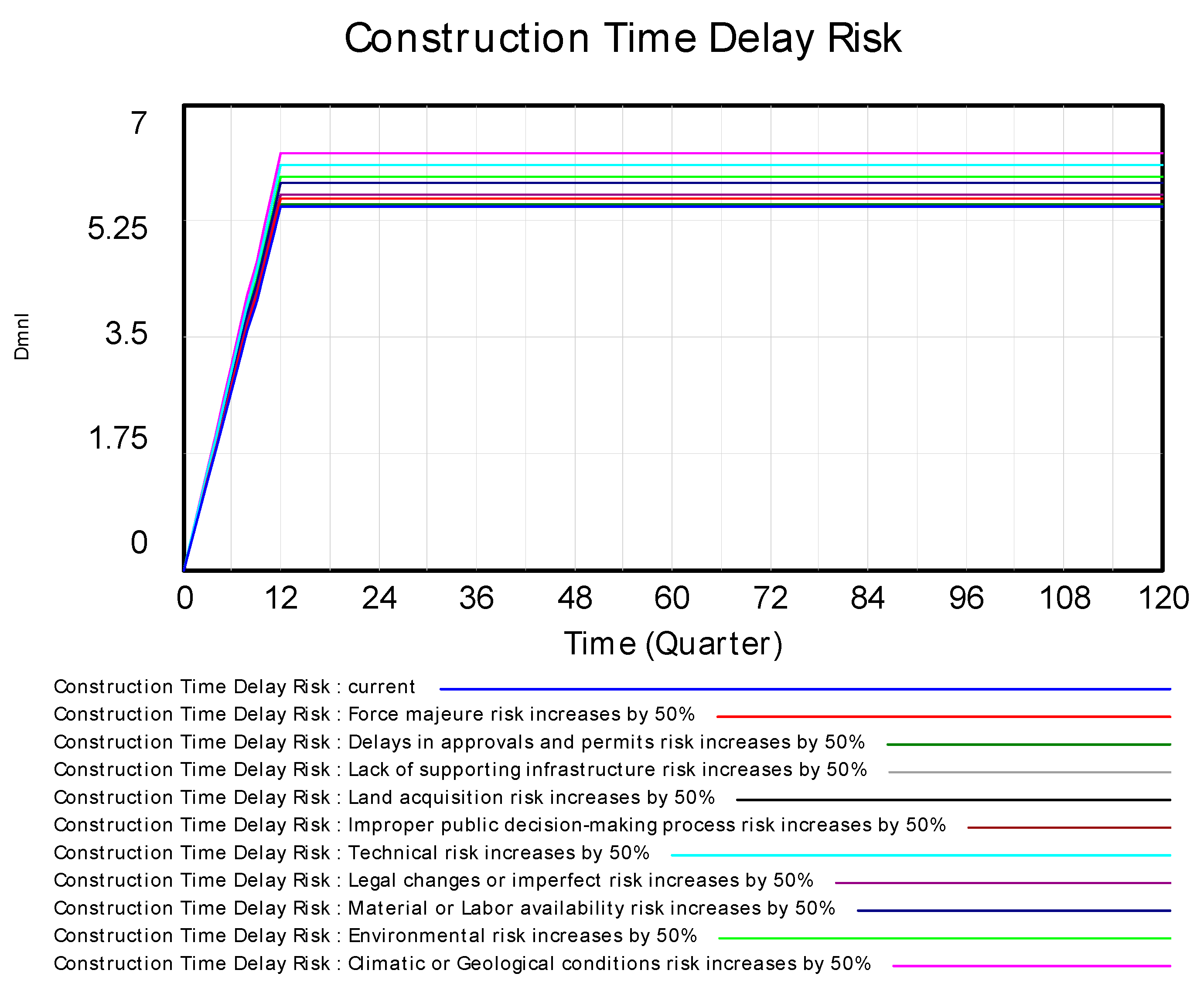

Figure 16. Construction time delay risk sensitivity analysis.
Figure 16. Construction time delay risk sensitivity analysis.
Systems 13 00237 g016

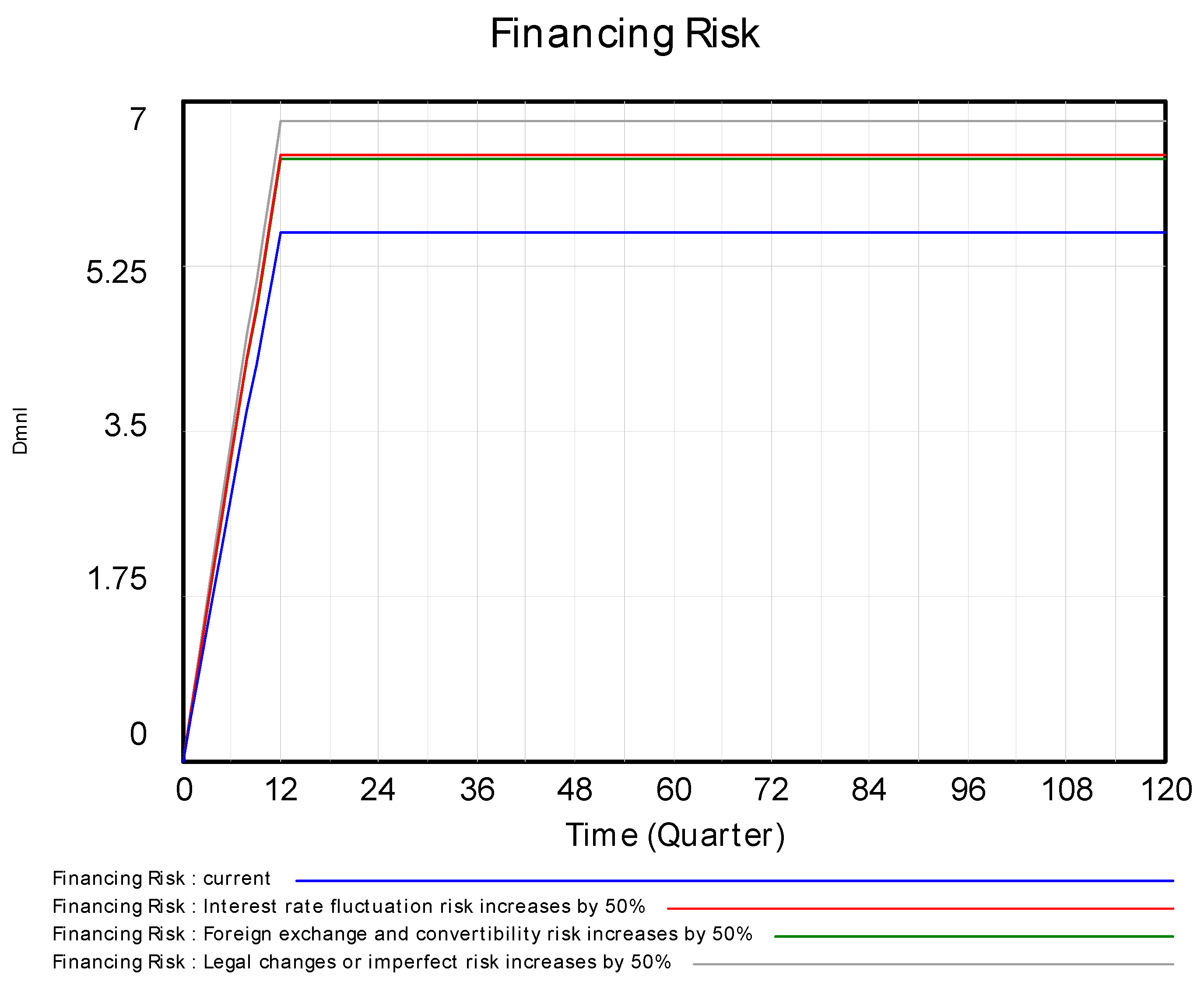

Figure 17. Financing risk sensitivity analysis.
Figure 17. Financing risk sensitivity analysis.
Systems 13 00237 g017

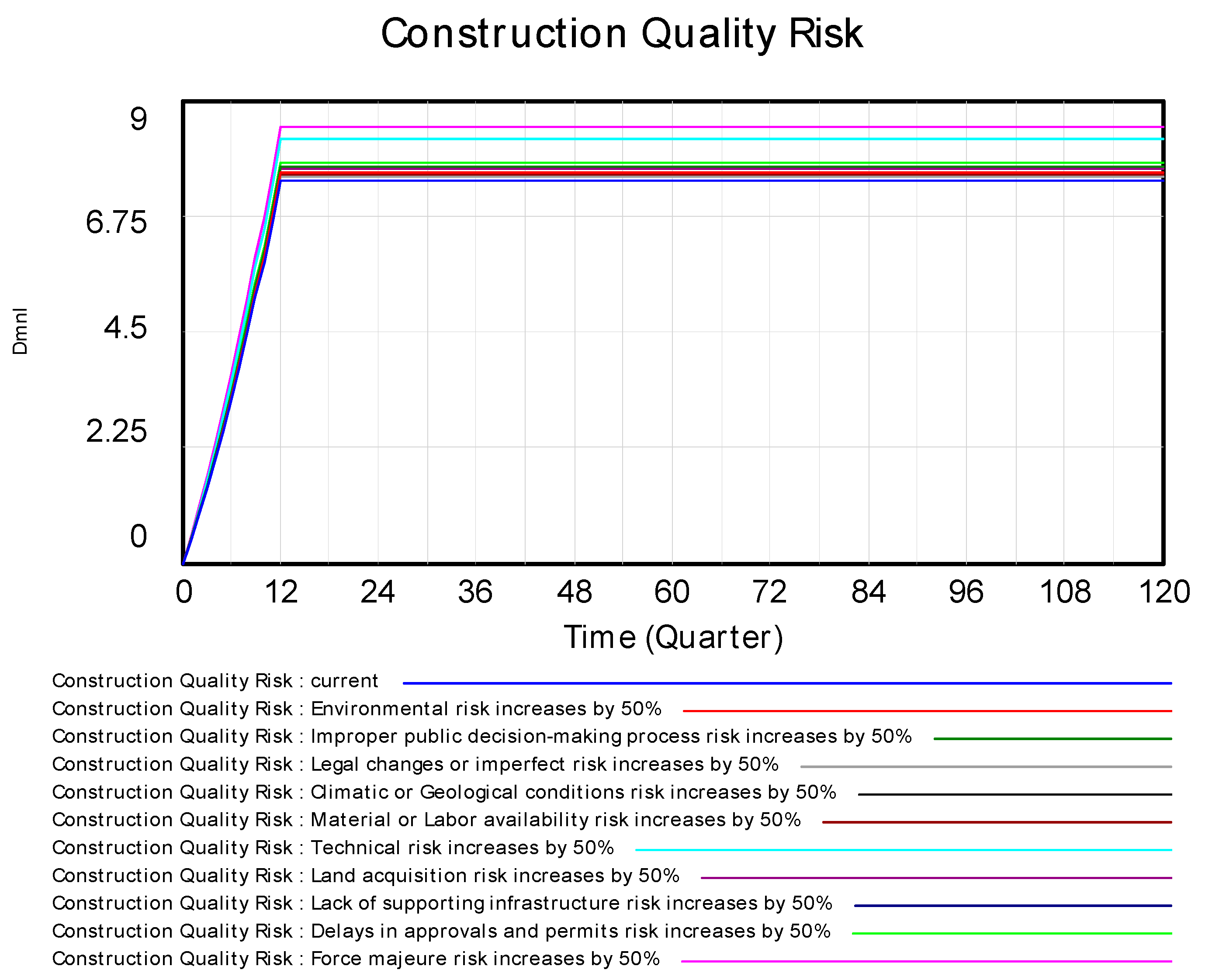

Figure 18. Construction quality risk sensitivity analysis.
Figure 18. Construction quality risk sensitivity analysis.
Systems 13 00237 g018

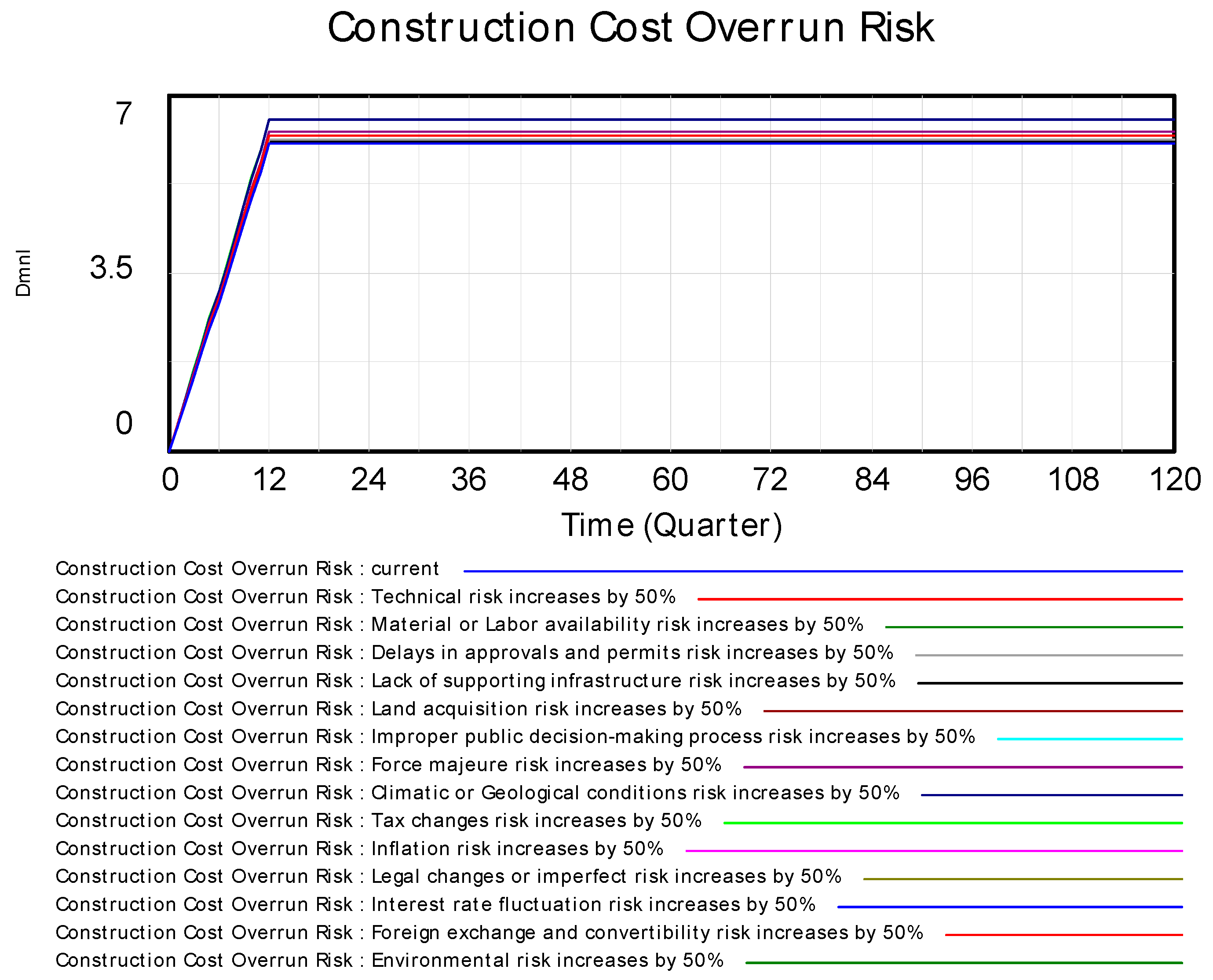

Figure 19. Construction cost overrun risk sensitivity analysis.
Figure 19. Construction cost overrun risk sensitivity analysis.
Systems 13 00237 g019
Figure 20. Operation cost overrun risk sensitivity analysis.
Figure 20. Operation cost overrun risk sensitivity analysis.
Systems 13 00237 g020
Figure 21. Insufficient expected return risk sensitivity analysis.
Figure 21. Insufficient expected return risk sensitivity analysis.
Systems 13 00237 g021
Table 1. Dynamic equations for each risk subsystem.
Table 1. Dynamic equations for each risk subsystem.
Name of Risk SubsystemEquation
Construction time delay risk subsystem C o n s t r u c t i o n   t i m e   d e l a y   r i s k = INTEG ( T h e   a m o u n t   o f   c h a n g e   c o n s t r u c t i o n   t i m e   d e l a y   r i s k ,   0 )
T h e   a m o u n t   o f   c h a n g e   c o n s t r u c t i o n   t i m e   d e l a y   r i s k = ( 0.113 × P r o j e c t   c h a n g e   r i s k + 0.143 × C l i m a t i c / G e o l o g i c a l   c o n d i t i o n s   r i s k + 0.110 × D e s i g n   f l a w / c h a n g e s   r i s k + 0.144 × E n v i r o n m e n t a l   r i s k + 0.123 × S i t e   s a f e t y   a n d   s e c u r i t y   r i s k + 0.217 × T e c h n i c a l   r i s k + 0.147 × M a t e r i a l / L a b o r   a v a i l a b i l i t y   r i s k ) × PULSE ( 0 , a )
D e s i g n   f l a w / c h a n g e s   r i s k = C l i m a t i c / G e o l o g i c a l   c o n d i t i o n s   r i s k × PULSE ( 0 , a )
P r o j e c t c h a n g e   r i s k = ( 0.471 × D e s i g n   f l a w / c h a n g e s   r i s k + 0.480 × L e g a l   c h a n g e s   o r   i m p e r f e c t   r i s k ) × PULSE ( 0 , a )
S i t e   s a f e t y   a n d   s e c u r i t y   r i s k = T h e   a m o u n t   o f   c h a n g e   c o n s t r u c t i o n   q u a l i t y   r i s k × PULSE ( 0 , a )
Financing risk subsystem F i n a n c i n g   r i s k = INTEG ( T h e   a m o u n t   o f   c h a n g e   f i n a n c i n g   r i s k , 0 )
T h e   m o u n t o f   c h a n g e   f i n a n c i n g   risk = ( 0.334 × L e g a l   c h a n g e s   o r   i m p e r f e c t   r i s k + 0.297 × I n t e r e s t   r a t e   f l u c t u a t i o n   r i s k + 0.369 × F o r e i g n   e x c h a n g e   a n d   c o n v e r t i b i l i t y   r i s k ) × PULSE ( 0 , a )
Construction quality risk subsystem C h a n g e   i n   c o n s t r u c t i o n   q u a l i t y   r i s k = INTEG ( T h e   a m o u n t   o f   C h a n g e   c o n s t r u c t i o n   q u a l i t y   r i s k , 0 )
T h e   a m o u n t   o f   C h a n g e   c o n s t r u c t i o n   q u a l i t y   r i s k = ( 0.386 × S c h e d u l e   r i s k + 0.253 × T e c h n i c a l   r i s k + 0.362 × F o r c e   m a j e u r e   r i s k ) × PULSE ( 0 , a )
S c h e d u l e   r i s k = ( 0.260 × D e l a y s   i n   a p p r o v a l s   a n d   p e r m i t s   r i s k + 0.179 × C o n s t r u c t i o n   t i m e   d e l a y   r i s k + 0.173 × I m p r o p e r   p u b l i c   d e c i s i o n m a k i n g   p r o c e s s   r i s k + 0.206 × L a n d   a c q u i s i t i o n   r i s k + 0.181 × L a c k   o f   s u p p o r t i n g   i n f r a s t r u c t u r e   r i s k ) × PULSE ( 0 , a )
Construction cost overrun risk subsystem C o n s t r u c t i o n   c o s t   o v e r r u n   r i s k = INTEG ( T h e   a m o u n t   o f   c h a n g e   c o n s t r u c t i o n   c o s t   o v e r r u n   r i s k , 0 )
T h e   a m o u n t   o f   c h a n g e s   c o n s t r u c t i o n   c o s t   o v e r r u n   r i s k = ( 0.219 × R e w o r k   r i s k + 0.161 × C l i m a t i c / G e o l o g i c a l   c o n d i t i o n s   r i s k + 0.150 × E n v i r o n m e n t a l   r i s k + 0.181 × T a x   c h a n g e s   r i s k + 0.127 × F i n a n c i n g   r i s k + 0.166 × I n f l a t i o n   r i s k ) × PULSE ( 0 , a )
R e w o r k   r i s k = T h e   a m o u n t   o f   c h a n g e   c o n s t r u c t i o n   q u a l i t y   r i s k × PULSE ( 0 , 12 )
Operation cost overrun risk subsystem O p e r a t i o n   c o s t   o v e r r u n   r i s k = INTEG ( T h e   a m o u n t   o f   c h a n g e   o p e r a t i n g   c o s t   o v e r r u n   r i s k , 0 )
T h e   a m o u n t   o f   c h a n g e   o p e r a t i o n   c o s t   o v e r r u n   r i s k = ( 0.308 × T a x   c h a n g e s   r i s k + 0.223 × M a i n t e n a n c e   c o s t   o v e r r u n   r i s k + 0.236 × L o w   o p e r a t i o n a l   e f f i c i e n c y   r i s k + 0.233 × I n t e r e s t   r a t e   f l u c t u a t i o n   r i s k ) × PULSE ( a , b )
M a i n t e n a n c e   c o s t   o v e r r u n   r i s k = ( 0.488 × T h e   a m o u n t   o f   c h a n g e   c o n s t r u c t i o n   q u a l i t y   r i s k + 0.513 × H i g h   f r e q u e n c y   o f   m a i n t e n a n c e   r i s k ) × PULSE ( a , b )
H i g h   f r e q u e n c y   o f   m a i n t e n a n c e   r i s k = ( 0.454 × F o r c e   m a j e u r e   r i s k + 0.547 × C l i m a t i c / G e o l o g i c a l   c o n d i t i o n s   r i s k ) × PULSE ( a , b )
L o w   o p e r a t i o n a l   e f f i c i e n c y   r i s k = ( 0.486 × M a i n t e n a n c e   c o s t   o v e r r u n   r i s k + 0.515 × H i g h   f r e q u e n c y   o f   m a i n t e n a n c e   r i s k ) × PULSE ( a , b )
Insufficiency expected return risk subsystem I n s u f f i c i e n t   e x p e c t e d   r e t u r n   r i s k = INTEG ( T h e   a m o u n t   o f   c h a n g e   i n s u f f i c i e n t   e x p e c t e d   r e t u r n   r i s k , 0 )
T h e   a m o u n t   o f   c h a n g e   i n s u f f i c i e n t   e x p e c t e d   r e t u r n   r i s k = ( 0.148 × R e v e n u e   r i s k + 0.160 × C o n s t r u c t i o n   c o s t   o v e r r u n   r i s k + 0.126 × F i n a n c i n g   r i s k + 0.166 × R e s i d u a l r i s k + 0.157 × T h e   a m o u n t   o f   c h a n g e   o p e r a t i o n   c o s t   o v e r r u n   r i s k + 0.130 × B a n k r u p t c y / D e f a u l t   r i s k + 0.114 × P u b l i c   c r e d i t   r i s k ) × PULSE ( a , b )
R e v e n u e   r i s k = ( 0.525 × D e m a n d   r i s k + 0.476 × P r i c i n g   r i s k ) × PULSE ( a , b )
P r i c i n g   r i s k = ( 0.256 × P a y m e n t   r i s k + 0.237 × I n f l a t i o n   r i s k + 0.303 × C o n c e s s i o n   p e r i o d   r i s k + 0.205 × T h e   a m o u n t   o f   c h a n g e   o p e r a t i o n   c o s t   o v e r r u n   r i s k ) × PULSE ( a , b )
P a y m e n t   r i s k = C o m p e t i t i v e   r i s k × PULSE ( a , b )
D e m a n d   r i s k = ( 0.476 × C o m p e t i t i v e   r i s k + 0.525 × P r i c i n g   r i s k ) × PULSE ( a , b )
B a n k r u p t c y / D e f a u l t   r i s k = ( 0.557 × O r g a n i z a t i o n   c o o r d i n a t i o n   r i s k + 0.444 × C o n t r a c t u a l   r i s k ) × PULSE ( a , b )
P u b l i c c r e d i t r i s k = ( 0.324 × C o n t r a c t u a l   r i s k + 0.351 × L e g a l   c h a n g e s   o r   i m p e r f e c t   r i s k + 0.326 × G o v e r n m e n t / P u b l i c   o p p o s i t i o n   r i s k ) × PULSE ( a , b )
Table 2. Estimates of boundary risk factors for wind energy PPP projects.
Table 2. Estimates of boundary risk factors for wind energy PPP projects.
Boundary RiskRisk ValueBoundary RiskRisk ValueBoundary RiskRisk Value
Improper public decision-making process risk 0.659 Foreign exchange and convertibility risk 0.353 Concession period risk 0.529
Land acquisition risk 0.492 Technical risk 0.398 Competitive risk 0.543
Lack of supporting infrastructure risk 0.531 Environmental risk 0.490 Organization coordination risk 0.573
Delays in approvals and permits risk 0.598 Climatic/Geological conditions risk 0.425 Contractual risk 0.633
Material/Labor availability risk 0.404 Inflation risk 0.498 Residual risk 0.435
Legal changes or imperfect risk 0.594 Force majeure risk 0.463 Government/Public opposition risk 0.524
Interest rate fluctuation risk 0.463 Tax changes risk 0.457
Table 3. Wind energy PPP projects risk levels.
Table 3. Wind energy PPP projects risk levels.
Risk LevelValue-at-Risk RangeConstruction PhaseOperational Phase
Low risk [ 0 , 0.2 X max ] [0,1.484][0,43.632]
Average risk [ 0.2 X max , 0.4 X max ] [1.484,2.967][43.632,87.264]
Medium risk [ 0.4 X max , 0.6 X max ] [2.967,4.451][87.264,130.897]
High risk [ 0.6 X max , 0.8 X max ] [4.451,5.934][130.897,174.529]
Significant risk [ 0.8 X max , X max ] [5.934,7.418][174.529,218.161]
Table 4. Boundary risk ranking under sensitivity analysis.
Table 4. Boundary risk ranking under sensitivity analysis.
PeriodRisk SubsystemRisk Ranking (Top Five)
Construction periodConstruction time delay risk subsystemClimatic/Geological conditions risk > Technical risk > Environmental risk > Material/Labor availability risk > Legal changes
or imperfect risk
Financing risk subsystemLegal changes or imperfect risk > Interest rate fluctuation risk > Foreign exchange and convertibility risk
Construction quality risk subsystemForce majeure risk > Technical risk > Delays in approvals and permits risk > Climatic/Geological conditions risk > Environmental risk
Construction cost overrun risk subsystemTax changes risk> Interest rate fluctuation risk >Climatic/Geological conditions risk > Environmental risk > Force majeure risk
Operation periodOperation cost overrun risk subsystemTax changes risk > Interest rate fluctuation risk > Climatic/Geological conditions risk > Force majeure risk
Insufficiency expected return risk subsystemLegal changes or imperfect risk > Interest rate fluctuation risk > Foreign exchange and convertibility risk > Tax changes risk > Inflation risk
Table 5. Boundary risks that require key control and their diversification measures.
Table 5. Boundary risks that require key control and their diversification measures.
Boundary RiskGovernment and Regulatory AgenciesProject ImplementersMarket and Societal Stakeholders
Force Majeure RiskDevelop disaster response plans and emergency protocols to ensure a quick and effective response mechanism in the event of natural disasters or other force majeure events.Ensure the use of construction methods that meet disaster resistance standards and develop comprehensive disaster management plans to ensure business continuity and rapid recovery.Strengthen project understanding and cooperation, jointly develop risk mitigation measures for force majeure events, and enhance overall response capabilities.
Technical RiskSupport and promote technological research and innovation and provide technology validation and certification services to ensure that the adopted technologies are suitable for local application and reliable.Adopt mature technological solutions and collaborate with technology providers for preliminary trials and technology validation to ensure technology adaptability and reliability.Actively participate in the technology evaluation process to ensure that the technology choices meet environmental and societal needs.
Delays in Approvals and Permits RiskOptimize the approval process to ensure transparency and efficiency and set clear approval timelines and requirements to reduce project delays caused by administrative inefficiencies.Proactively communicate with government agencies, submit accurate application materials on time, anticipate potential approval delays, and make corresponding adjustments to the project plan.Strengthen public participation in the approval process, improve process transparency, and help mitigate the potential impact of approval delays on the project.
Climatic/Geological Conditions RiskEstablish strict construction standards and regulations to ensure that wind energy projects can operate stably in complex environments, and regularly monitor the project to ensure compliance with safety standards.Project design and technology solutions should be based on detailed geological and climatic data, enhancing the durability and disaster resistance of buildings and infrastructure while developing emergency response plans.Actively participate in the project’s environmental impact assessment to ensure that concerns and perspectives are considered, and promote project planning that is sensitive to climatic and geological conditions.
Environmental RiskEstablish strict environmental protection policies and regulatory mechanisms, continuously monitor the project’s environmental impact, and implement necessary environmental protection measures.Implement rigorous environmental management and monitoring plans, ensuring that environmentally friendly materials and technologies are used during construction and operation to minimize impact on ecosystems.Actively participate in environmental monitoring and management, promote sustainable environmental strategies, and improve community involvement and project transparency through environmental education, thereby enhancing public trust.
Tax Changes RiskEnsure the stability and predictability of tax policies, provide timely updates on tax law changes, and offer project implementers sufficient time for preparation and adaptation measures.Enhance financial planning flexibility by collaborating with financial advisors to forecast tax changes and develop response strategies, including the use of potential tax incentives and benefits.Focus on tax policy changes and actively participate in tax law reform discussions to influence policy formation, ensuring the fairness and transparency of tax policies.
Legal Changes/Imperfect RiskEnsure continuity and stability in laws and policies, provide a clear and reliable legal environment for the project, promptly communicate any major legal changes, and offer clear guidance and training.Collaborate closely with legal advisors to continuously monitor changes in the legal environment, assess the potential impact of these changes on wind energy projects, and design flexible contract terms to address potential legal risks.Participate in policy-making and legal discussions, ensuring that new laws or policy changes support the development of sustainable energy projects.
Interest Rate Fluctuation RiskThe government should consider providing fixed-rate loans or interest rate subsidies to reduce the risk of interest rate fluctuations in project financing. Additionally, adjusting monetary policies to stabilize market interest rates can help mitigate the impact of economic volatility.Use financial derivatives, such as interest rate swaps and futures contracts, to lock in loan interest rates or hedge against interest rate fluctuations, and design flexible financing structures that combine fixed and floating-rate loans to adapt to market changes.Monitor and evaluate the potential impact of interest rate trends on the financial stability of the project. Adjust investment decisions or credit strategies in a timely manner to minimize negative effects on project financing.
Foreign Exchange and Convertibility RiskImplement foreign exchange control policies and exchange rate stabilization measures, offering exchange rate hedging tools or fiscal subsidies to help projects mitigate the impact of exchange rate fluctuations caused by international capital.Use foreign exchange hedging strategies, such as forward contracts and options, to stabilize exchange rate costs, and, whenever possible, settle transactions in local currency to reduce dependency on foreign currency.Strengthen education and communication regarding foreign exchange risk, ensuring that investors and power purchasers use appropriate financial tools to protect their investments.
Inflation RiskMonitor economic indicators and adjust fiscal and monetary policies in a timely manner to mitigate the impact of inflation on the project’s economic feasibility.Incorporate inflation-adjustment mechanisms into financial planning by adjusting project costs and fee structures, and by using fixed-rate loans or other financial instruments to lock in costs, ensuring that project revenue can withstand the impact of inflation.Focus on assessing the impact of inflation on the long-term sustainability of the project, adjusting investment strategies and business models to mitigate inflation risks throughout the project lifecycle.
Materials/Labor Availability RiskPromote the development of local materials and labor markets through policy support, thereby increasing the project’s reliance on local resources.Establish a diversified supply chain and labor sources, conduct market research to assess and forecast material costs and supply conditions, and ensure a stable supply of materials and labor through contracts and strategic procurement.Collaborate with the project management team to promote the use of local materials and labor, thereby reducing reliance on external resources. Additionally, participate in environmental and resource conservation awareness campaigns to raise public understanding of sustainable resource usage.
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Lai, R.; Liu, S.; Wang, Y. Sustainable Operations: Risk Evolution and Diversification Strategies Throughout the Lifecycle of Wind Energy Public–Private Partnership Projects. Systems 2025, 13, 237. https://doi.org/10.3390/systems13040237

AMA Style

Lai R, Liu S, Wang Y. Sustainable Operations: Risk Evolution and Diversification Strategies Throughout the Lifecycle of Wind Energy Public–Private Partnership Projects. Systems. 2025; 13(4):237. https://doi.org/10.3390/systems13040237

Chicago/Turabian Style

Lai, Rongji, Shiying Liu, and Yinglin Wang. 2025. "Sustainable Operations: Risk Evolution and Diversification Strategies Throughout the Lifecycle of Wind Energy Public–Private Partnership Projects" Systems 13, no. 4: 237. https://doi.org/10.3390/systems13040237

APA Style

Lai, R., Liu, S., & Wang, Y. (2025). Sustainable Operations: Risk Evolution and Diversification Strategies Throughout the Lifecycle of Wind Energy Public–Private Partnership Projects. Systems, 13(4), 237. https://doi.org/10.3390/systems13040237

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
