Abstract
Nowadays, companies employ various project management (PM) methodologies to ensure that their projects are effective and successful. It is worth knowing that differences in principles and processes of PM methodologies influence the use of different PMs in managing non-repetitive and repetitive construction projects. This paper presents the selection and application of a rational construction PM methodology to a repetitive construction project after a comparison of two PM methodologies, namely Project Management Body of Knowledge (PMBOK) and Projects IN Controlled Environments (PRINCE2). The object of this study is a repetitive anti-corrosion works project for steel structures conducted at Company X. The research was carried out in two steps. First, a quantitative survey of the respondents from companies involved in the management and execution of construction projects was conducted with the aim to identify a rational approach to construction PM. The questionnaire consisted of fourteen closed-ended questions, six of which were generic and eight were PMBOK- and PRINCE2-specific questions. Companies that took part in the quantitative study identified the PRINCE2 project management approach as the most suitable for managing a repetitive construction project. Using the PRINCE2 PM methodology, the repetitive construction project would aim to provide as much information as possible to the project participants, form a team and assign team leaders responsible for the phases, establish a financial plan, a detailed timetable for the execution of the works, a quality control plan, and a plan of responsible persons, and detail the technological sequencing of the works. Second, a quantitative study on the selection of a rational construction project management approach for a repetitive construction project was pursued, and a qualitative assessment of construction project monitoring trends and actions was conducted. The qualitative research was performed using a structured interview method and asking the representatives of different companies X, Y, and Z the same 15 questions. The results of the qualitative research showed that a successful PM depends on the size of the project team, the PM tools and methodologies used, the PM philosophy, and the frequency of monitoring and discussing the project progress.
1. Introduction
Why do construction projects take longer to implement than they should? Why do they fail to deliver the desired results on time and to ensure sustainability? The analysis of project management (PM) experience from different sectors has revealed such aspects as mistakes made by project team members, changes in law, unclear roles and responsibilities, ineffective communication, problems with suppliers, and the sustainability of the results. These factors do not really answer the questions raised above. Apparently, there are general laws of PM and challenges that project managers (PJMs) have to handle.
In the digital economy, business and governmental organisations design and implement projects of all types and sizes. However, not all project activities run smoothly. Despite the availability of financial resources and competent PM teams, projects are not always completed on time, they often exceed the budget, they do not meet quality and time requirements, and they fail to meet sustainability goals. What does this mean? If a PJM sets a deadline, the staff usually report the work carried out when the deadline comes, even if the work was finished earlier. What are the factors behind this? The project team may try to avoid additional tasks because next time new tasks may have shorter deadlines and less-inspired staff members may be late in completing the planned goals. Poor planning and high urgency can lead to project failure or the need for additional resources due to the changes in scope, lack of quality, and weak sustainability. Project planning is a crucial stage. It is inappropriate to start implementing ideas without a good-quality plan.
The benefits of a good PM methodology include the easy handling and distribution of project reports, transparent management practices, successful risk management, effective problem-solving, easy measurement of the completion percentage, improved control and command of the project, regulated stakeholder inventories, the measurement of accomplishments against plans, improved estimation for future planning, and identifying objectives that cannot be met or will be exceeded [1]. PM is employed to ensure the efficient and effective organisation of a project from its initiation to its completion [2,3,4,5]. It also encompasses all strategies and activities that ensure the project’s success based on the quality, cost, and timeliness triangle. In this case, standard PM frameworks that include PMBOK (Project Management Body of Knowledge), PRINCE2 (Projects IN Controlled Environments), and the international standard ISO 21500:2012 are used for project management [6,7]. Both the PMBOK and the PRINCE2 PM methodologies have positive and improvable areas. According to popularity in regions, the PMBOK PM methodology is more widespread in North America, while the PRINCE2 management methodology is more popular in Europe, as it originated in the United Kingdom [4,5]. The PMBOK methodology represents the collective knowledge that is widely accepted as best practice in the field of PM, while PRINCE2 is focused on the business aspects of the project and emphasises a structured organisational approach to PM with an emphasis on dividing the project into manageable stages and a product-oriented approach to planning [8,9]. The above-mentioned standard PM frameworks are popular with scientists who explore non-repetitive construction projects.
Repetitive construction projects refer to projects that involve the construction of recurring units, where each unit consists of the same group of sequential activities. These projects often occur in the construction industry, such as building multiple identical houses, constructing similar sections of a highway, or conducting similar anti-corrosion works for steel structures. The repetitive nature of these projects offers several advantages including significant time and cost savings. By working on similar units with the same sequence of activities, construction crews and resources can maintain continuity and efficiency. Once they become familiar with the process, they can work more quickly and effectively, reducing the overall construction time [10,11,12]. Maintaining work continuity in repetitive construction projects is crucial for achieving time and cost savings, and it can be achieved through various means:
- By keeping a consistent workforce throughout the project, there is no need for the frequent hiring and firing of labour. This reduces recruitment and training costs as well as the time required to onboard new workers. Skilled workers who are familiar with the project’s requirements can continue working on subsequent units, ensuring higher productivity and efficiency.
- In repetitive projects, skilled labour becomes more proficient and experienced over time. By retaining these skilled workers, their expertise and knowledge are preserved, leading to improved performance and quality. They become familiar with the project’s specific requirements and can work more efficiently, minimising errors and rework.
- In repetitive projects, the use of equipment can be optimised since the same activities are repeated. By maintaining work continuity, equipment idle time is minimised as well. Equipment can be kept operational and utilised efficiently without long periods of downtime between units. This reduces equipment-related costs and increases overall productivity.
- As workers become more experienced with the sequential activities involved in the project, they can perform their tasks more quickly and accurately. This leads to improved productivity and reduced construction time with each successive unit.
On the other hand, maintaining work continuity in repetitive projects indeed presents an additional constraint that traditional scheduling and planning tools and techniques struggle to address effectively [13,14,15]. The following negative aspects can be mentioned:
- Traditional scheduling tools are often rigid and not well-suited to adapt to the specific requirements of repetitive projects. These methods typically assume a high level of task variability, making it difficult to account for the repetitive nature of the project and the streamlined workflow it entails.
- Repetitive projects demand efficient resource allocation and management to maintain work continuity. However, traditional tools may not adequately account for the optimisation of crew allocation, equipment utilisation, and material flow. This can lead to suboptimal resource allocation, increased idle time, and reduced productivity.
- Traditional planning and scheduling techniques often overlook or underestimate the learning effect, resulting in unrealistic timelines and cost projections.
- While repetitive projects consist of recurring units, there may still be variations in design, site conditions, or other factors. Traditional tools may struggle to handle these variations effectively, leading to challenges in maintaining the desired work continuity and achieving accurate project planning.
The purpose of standard PM frameworks is to establish clear project objectives, prioritise quality, enhance communication, and provide professionals with the necessary project management tools. As a result, it is not clear which PM methodology—PRINCE2 or PMBOK—would be the most rational and efficient for implementing repetitive construction projects. Therefore, the purpose of this study is to determine which PM methodology is more effective for repetitive construction projects. In order to identify a rational methodology for construction PM, an analytical quantitative survey of respondents from companies involved in the management and execution of construction projects was conducted. In addition, a descriptive qualitative study was performed in order to identify the trends and actions of monitoring the progress of construction projects.
2. Background
It is known that PM combines knowledge, skills, tools, and techniques to efficiently manage project activities and meet stakeholders’ expectations [1]. It involves nine knowledge areas and enables project PJMs to ensure that projects are conducted rationally and efficiently. PM techniques are primarily applied in the planning and control of time, cost, and quality to achieve success in different projects. However, there is a lack of precision in distinguishing between the P and PM. The overlapping definitions of the two can potentially impact their relationship. Therefore, understanding the difference between the P and the PM can increase the likelihood of a project’s success, as concluded by the authors of [9].
The rising stakeholder expectations demand for integrating all PM activities within an organisation. This integration is known as organisational project management (OPM), which combines organisation and PM. The foundation of organisation theory is based on organisational structure, forms, and the concept of integration. PM is linked to organisations through the use of projects as platforms for improving business, implementing changes, fostering innovation, and gaining a competitive edge, as explained by the authors of [16]. In their research, Aubry et al. [17] highlighted a growing interest in social perspectives that take politics, organisational dynamics, paradoxes, and pluralism into consideration. This presents an opportunity for PM scholars to contribute to management and organisational theory. The premise of the authors of [18] is that the project management office (PMO) is an integral part of a complex network that connects strategy, projects, and structures. Thus, it provides a point of entry to the organisation for studying the fundamentals of OPM. The proposed theoretical framework refers to three complementary fields, namely innovation, sociology, and organisational theory, to provide a novel understanding of the PMO and OPM. Other researchers [19] suggest that robust management structures, particularly PMOs, can enhance the oversight capabilities of contractors when implementing sustainable procurement management (SPM) processes.
Numerous projects may encounter significant delays that exceed their initial time and cost estimates. Construction delays can be attributed to various parties including the owner, contractor, and other involved parties. Thus, it is crucial to identify the responsibility for delays among these parties, and it is necessary to understand the causes and types of delays [20,21,22,23,24,25,26]. In this case, different approaches have been offered by scientists to decrease the likelihood of delays in construction [24,25,27]. An important aspect of the construction industry is the implementation of PM success methods. The authors of [28,29,30,31,32] in their research identified factors that influence a construction project’s success. A summary of studies that analyse the causes of delays in construction projects, approaches to decrease the likelihood of delays in construction, and the success of PM implementation methodologies is presented in Table 1.
Table 1.
Summary of studies that analyse the causes of delays in construction projects, approaches to decrease the likelihood of delays in construction, and the success of PM implementation methodologies.
The PM process typically involves establishing a business plan for the project, preparing an opportunity statement that aligns with the management’s strategy, defining a business model for the project, and identifying potential risks in advance [2,3,4,5]. The Project Management Institute has developed the PMBOK methodology as a guide to ensure a standardised set of principles and knowledge in the field of PM [8]. The PMBOK methodology comprises a framework of nine knowledge areas, which are divided into activities across five stages of the project life cycle [8]. It was approved by the American National Standards Institute (ANSI) as early as 1998, and the sixth standard version was released in 2017 [4,5]. Another widely used methodology is PRINCE2, which was developed by the Central Computer and Telecommunications Agency in 1989. PRINCE2 is focused on the business aspects of a project and emphasises a structured organisational approach to PM [8,9]. At the request of the UK government, the PRINCE2 PM methodology was released in 1996, and the sixth version of the methodology was released in 2017, which is applicable to projects to this day [4,5]. The release of the seventh edition of PMBOK in 2021 brought about a significant transformation in the approach to project management [7]. In this latest edition, the previously detailed process and group-based view of project management have been replaced by a comprehensive principle-based perspective. This shift has broadened the applicability of the PMBOK document, making it relevant and adaptable to all types of projects.
Matos et al. [34] explained that while PMBOK defines a project as a temporary endeavour aimed at creating a unique product, service, or result, PRINCE2 defines a project as a management environment created to deliver one or more business products according to a specified business case. In order to provide an integrative approach in respect to business stakeholders and openness on the international scale, the authors of [6] combined the two PM standards (PMBOK and PRINCE2) and proposed a new hybrid approach to PM. A comparative analysis of the controls of PRINCE2 and PMBOK is presented in Table 2.
Table 2.
Comparative analysis of controls of PRINCE2 and PMBOK.
While PMBOK and PRINCE2 have similar control definitions, there are many differences between the two PM methodologies. One PM methodology may have a more-detailed process, while another may have a less-detailed one. PMBOK can be identified as a methodology that comprehensively covers such knowledge areas: project integration management, project scope management, project time management, project cost management, project quality management, project resource management, project communication management, project risk management, project procurement management, and project stakeholder management [4]. Meanwhile, the PRINCE2 PM themes cover the following topics: business case, changes, and progress; planning and progress; quality; planning, organization; risk; undefined; organisation [4]. It is seen that the PRINCE2 PM themes cover all the same topics apart from one topic—procurement management, which is not covered by PRINCE2 PM.
Another advantage of the PRINCE2 methodology is the integration of processes with the seven themes. The integration of processes and themes creates a methodology that can be applied widely to manage projects of any type. The author [4] analysed the seven PRINCE2 PM processes and the process model that includes the PMBOK PM methodology. It was stated that the PRINCE2 PM processes cover the following four management levels: corporate or programme management, directing (project board), managing (PJM), and delivering (team manager). Meanwhile, the PMBOK methodology prioritises the level of managing for which the PJM is responsible.
The drawbacks of the PMBOK PM methodology include a lack of responsibility for PM team members and overly detailed descriptions of certain aspects. The PJM plays the main role in the PMBOK methodology, with the primary responsibilities being assigned to them, but the responsibilities of other project team members have been defined ambiguously [4]. The main drawback of the PRINCE2 PM methodology is the limited selection, only 40, of tools and methodologies. Although the PRINCE2 PM methodology does not limit the use of best practice tools and methodologies from external sources, in comparison, PMBOK has 132 integrated tools and methodologies. Additionally, each project team member must know their tasks and responsibilities precisely in the PRINCE2 methodology, and if at least one team member does not follow the PRINCE2 methodology process and flow, the project can become uncontrollable. According to the PBMOK methodology, the schedule baseline serves as a fundamental component of delay analysis in projects [35]. The schedule baseline refers to the authorised project timeline, against which actual dates and modifications must be compared to assess schedule delays in the project model. When updating the project schedule, it is crucial to retain accurate data on project time performance. Any alteration to the critical path within the schedule baseline results in delays. In their study, the authors of [36] put forward a risk management framework that refers to the PMBOK standards. This framework aims to assist in the selection of appropriate risk response strategies for addressing a specific case study within a construction company. To handle the complexity of the proposed model, different state-of-the-art metaheuristic algorithms were employed. Applying the principles of the PMBOK methodology to identify sources of health, safety, and environmental (HSE) risks and utilising a fuzzy analytic hierarchy process can enhance the accuracy of risk assessments for hazards in construction projects [37]. This comprehensive approach enables a more realistic estimation of the risk index, thereby improving the overall understanding and management of HSE risks in construction projects.
Hence, while project management standards may have their unique features, they generally encompass elements such as terminology, areas of knowledge, an administration system, the project life cycle, and alignment with organisational objectives. These components provide guidance and a common framework for professionals to effectively manage projects [7].
3. Research Object and Methodology
This part presents the project under analysis on anti-corrosion works for steel frames of gas distribution stations at Company X, the description project management model at Company X, the identification of problems related to project management at Company X by conducting repetitive construction projects, and the aim and progress of execution of quantitative and qualitative research.
3.1. The Repetitive Construction Project
The project under analysis was an anti-corrosion works project for steel frames of gas distribution stations. The company that carried out the anti-corrosion work on gas distribution stations and allowed to use of the obtained data for the research was called Company X. The project consisted of abrasive cleaning by sandblasting and anti-corrosion painting of nine gas distribution stations. The total value of the anti-corrosion works for the gas distribution stations was EUR 92.565 including value-added tax.
The planned duration of the project was 23 working days, and the maximum number of staff required during the project was 17. The number of staff depended on the number of gas distribution stations running in parallel. After the welding of the gas distribution stations, the metal structures were transported to the sandblasting chamber, and after the sandblasting, the structures were transported to the anti-corrosive painting chamber. According to the size of the metal structures, the sandblasting work was planned to be carried out within a maximum of 2 working days (4 shifts), and the anti-corrosive painting work was planned to be carried out within 5 working days (10 shifts) in order to meet the specified deadlines. The two-shift front end was more than half of the planned project duration.
Depending on the type of gas distribution station (three different types in total), the metal structures were painted with three to five different anti-corrosive painting systems. The surfaces of the metal structures were painted with the paint systems appropriate for the operating characteristics of the distribution station. Not only did each painting system have different paint dry film thicknesses (ranging from 50 to 150 µm) and several intermediate layers (ranging from 2 to 4) but also colour variants (grey, yellow, or red) depending on the type of gas distribution station (Figure 1).

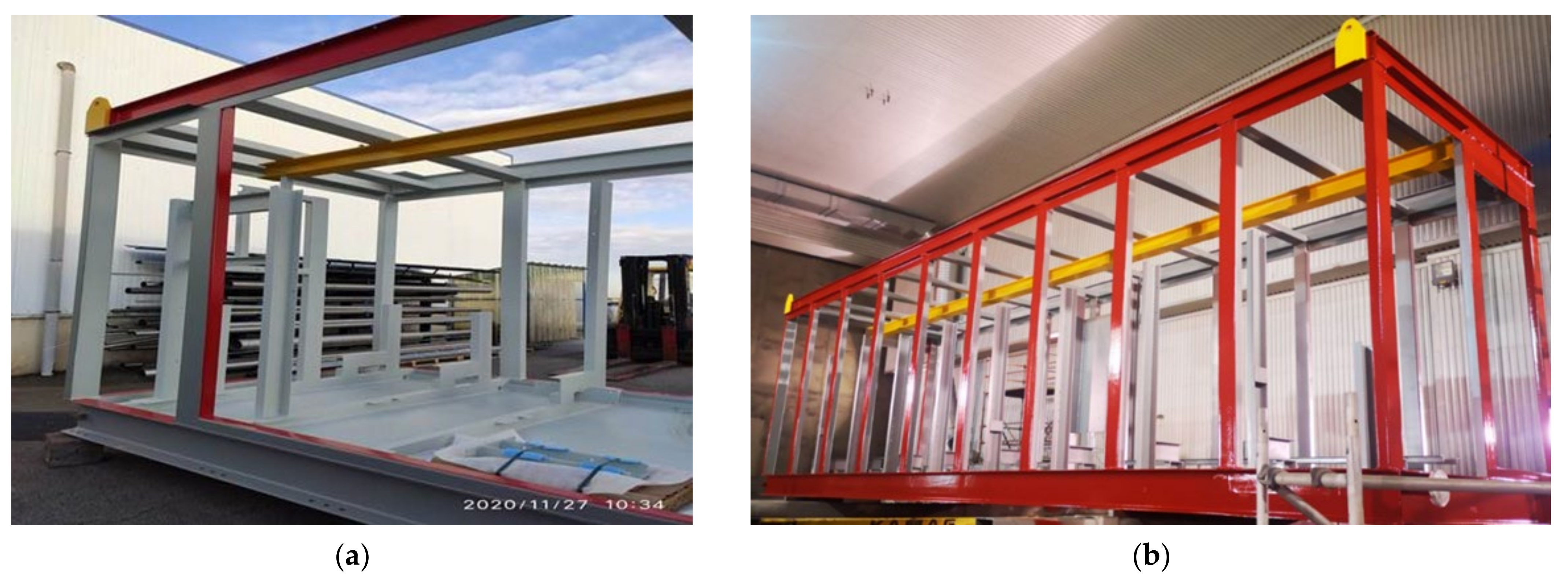

Figure 1.
Examples of a steel frame of gas distribution stations: (a) station type no. 1; (b) station type no. 3.
The anti-corrosion coating was subject to high-quality requirements. Before the transportation of the structures, the work carried out for the installation of the equipment was handed over to the FROSIO (nor. Faglig Råd for Opplæring og Sertifisering av Inspektører innen Overflatebehandling) inspector responsible for the condition of the welded metal structures, the surface preparation, and the anti-corrosion coating. At the time of the intermediate acceptance, the FROSIO inspector had to be provided with the gas distribution station’s performance documentation, such as measurements of the sub-surface preparation of the metallic structures, dustiness, salt content, and adhesion of the paint coating. In addition, intermediate-temperature and dry-coating measurements had to be carried out in accordance with the requirements of the project’s technical specifications.
The sandblasting and anti-corrosive painting works were performed according to technical documents and standards that governed the installation technology. During the sandblasting and painting operations, it was necessary to ensure intermediate quality control by measuring the number of soluble contaminants present on the surface to be sandblasted, ensuring the quality of the abrasive used, ensuring the correct air temperature during sandblasting, anti-corrosive painting, etc. Thus, the project specified the quality requirements, the criteria to be met, and their values. The quality control plan for the anti-corrosion work is presented in Table 3.
Table 3.
Quality control plan for anti-corrosion work.
If the values did not meet the intended criteria, e.g., the SA 2.5 cleanliness class was not achieved during the sandblasting according to the ISO 8501-1:2007 standard [45], these areas were re-sandblasted to ensure the cleanliness class specified in the design.
3.2. Project Management Model at Company X
The PM in Company X was based on a customised model developed internally. The responsibilities and duties of the project team were defined in the project implementation process so that each member of the project team had a clear understanding of his/her tasks. The project initiation phase involved the appointment of a PJM, an understanding of the project purpose and expectations, the phasing and scheduling of the project, a review of contractual requirements for additional documentation (e.g., site access permits), a risk assessment, and the creation of the project initiation documents, namely the appointment letter, the order, and the site file.
The standard PM organisational structure in Company X included the following personnel: project director, PJM, works manager, works organisation manager, engineer, delivery manager, works supervisor, and workers. As one of the key criteria of the project was to complete the work on time, the technical director was also involved in the PM organisational structure. The responsibilities of the project team are broken down by function below (Table 4).
Table 4.
Responsibilities of the project team by function at Company X.
3.3. Problems Related to Project Management at Company X
The problems that related to project management at Company X were identified by the project team conducting repetitive anti-corrosion work projects for steel frames of gas distribution stations. The following problems were identified during the repetitive construction PM:
- Increased design quantities that were not paid for by the contract;
- The technological solutions for the project were only adjusted during the project;
- Lack of quality control of the project and poor quality of the anti-corrosion work carried out on certain steel structures;
- Failure to assign the responsible works managers to the relevant work operations;
- Works not foreseen in the project (installation of elevation aids, coating of steel structures before painting, and repeating the same operation twice);
- Delays in the agreed work schedule;
- Exceeded material resources.
The project foresaw the execution of 1360 m2 of anti-corrosive painting, but the actual quantities were higher, i.e., 1653 m2 (21.54% increase), and the contract did not provide payment for additional works. As the actual quantities were not in line with the projected quantities, the cost of the project increased, requiring more man-hours, materials, and machinery to complete the project. During the project, the observed over-quantities led to additional orders for materials, which were transported directly from the paint supplier, resulting in higher project costs. The following cost increases were identified: the wage bill increased by 37.68%, the number of materials used increased by 38.69%, and the cost of machinery increased by 68.47%. But the direct and other costs decreased by 7.66%.
Increased design quantities, technological complexity, and continuous work in several shifts were identified as PM weaknesses, which had a major impact on the overall project’s result. This shows that the above-mentioned management areas have to be improved to seek good project results. In this case, it was decided to apply two PM methodologies, PMBOK and PRINCE2, to improve the management areas in conducting repetitive construction projects at Company X.
3.4. Methodologies
Analytical quantitative research in the form of a survey and qualitative research using a structured interview method were carried out by the researchers. To enhance the validity and reliability of research results, it is crucial to integrate quantitative and qualitative approaches in the research design and data collection. By adopting a mixed-methods research approach, researchers can strengthen their ability to derive trustworthy and compelling conclusions from empirical research [49].
3.4.1. The Analytical Quantitative Study
In order to help Company X to solve the problems related to the project management of their repetitive anti-corrosion work projects, analytical quantitative research was carried out in the form of a survey. By employing this technique, researchers can create an appealing and well-structured questionnaire with a suitable introduction, clear instructions, and a thoughtfully arranged set of questions with aligned response alternatives that aim to facilitate ease of response for the respondents [50]. The researchers developed a survey questionnaire to assess the perceptions of the respondents of construction PM and execution companies of the application importance of two PM methodologies, PMBOK and PRINCE2, for repetitive construction projects. Not only did it aim to extract general information about the respondents (age, experience in the construction sector, etc.) but also their knowledge of PM methodologies. The survey analysed two PM methodologies, PMBOK and PRINCE2, which were discussed in the literature review section above. The survey results were used to determine which of the two PM approaches would be more suitable for a repetitive construction project.
The questionnaire for the quantitative study on the selection of a rational construction PM approach for the repetitive process consisted of fourteen closed-ended questions, six of which were generic and eight were PMBOK- and PRINCE2-specific questions. The six general questions were related to gender, age group, educational background, work experience, position in the company, and scope of the company activities. Each of the eight questions on project management had two possible answer options, one related to PMBOK and the other to the PRINCE2 methodology. The respondents, by choosing the answer options, could consider what methodology would be more suitable for managing repetitive construction projects. The questions given to the respondents are discussed in Section 4.1. A repetitive construction project involving the abrasive cleaning and anti-corrosive coating of steel structures of gas distribution stations was presented for the case study. In addition, it was highlighted that the project was subject to stringent requirements in terms of the budget, the quantities of materials, and relatively short lead times.
The quantitative research was carried out over two weeks, from 22 November to 5 December 2021, targeting the respondents from construction PM and execution companies. The survey was conducted online using the Google Forms platform. Construction companies with recurring construction projects in Lithuania were surveyed. The survey link was distributed via email and the LinkedIn platform. The respondents were randomly selected if their job title was related to project management in the company. Based on the findings of the researchers [22], the selection of a simple random sampling method ensured that every element within the population had an equal opportunity to be included in the sample. A total of 104 respondents took part in the quantitative study over a two-week period. Responses to the questionnaire were then collected and analysed.
3.4.2. The Descriptive Qualitative Study
To identify trends and actions related to monitoring the progress of construction projects, a descriptive qualitative study was conducted. In qualitative research, structured interviews serve as a prevalent method for data collection. It is worth noting that the effectiveness of the study results is fundamentally influenced by the quality of the interview guide [51]. To collect the needed information, the qualitative research was carried out using a structured interview method, asking representatives of different companies, X, Y, and Z, the same 15 questions. The qualitative study involved three different-sized companies dealing with construction PM and implementations. In the analysis of the replies received, the companies were identified as Company X, Company Y, and Company Z.
The descriptive qualitative study aimed to obtain information about the structure of the company, the tools, methods, and methodologies used to improve PM, project progress monitoring, progress indicators monitored in the report, additional report information, and other relevant issues, as listed in Table 5. Author [52] in his work provided a working knowledge of the whole building industry, i.e. the technical skills required to manage a construction project from conception through occupancy. The useful information provided helped to prepare the questionnaire for the descriptive qualitative study.
Table 5.
Company representatives were asked to answer the following questions.
The interviews in the qualitative research were carried out in person and online. The results obtained are analysed in Section 4.3.
4. Results, Discussion and Recommendations
This part presents the results of the quantitative results, gives recommendations for improvement of the implemented repetitive project management at Company X, presents the results of a descriptive qualitative study, and discusses the sustainability aspect of project management for future studies.
4.1. The Results of the Analytical Quantitative Study
A survey was conducted in order to determine which of the two PM approaches would be more suitable for a repetitive construction project; 104 respondents took part in the quantitative study over a two-week period. The respondents’ answers to the questions and the choice of the most appropriate option are presented in Table 6 and Table 7. The first six questions were generic and related to gender, age, educational background, working experience, and current position in a company. The answers showed that the majority of the respondents were male (77.0%), aged 25–30 (33.7%), held a Bachelor’s degree (61.5%), and had 5–10 years of working experience (39.4%). By position in the company, the majority of the respondents were PJMs (25.0%) and came from companies mainly specialised in construction works (45.2%) (see Table 6).
Table 6.
Respondents’ characterisation.
Table 7.
Survey responses.
The remaining eight out of fourteen questions were related to PMBOK and PRINCE2 PM methodologies, and the respondents had to choose an appropriate option from the two presented. The majority of the respondents (see Table 7) chose the answer options related to the PRINCE2 PM methodology, i.e., they considered this methodology to be more suitable for managing repetitive construction projects.
To summarise the results of the quantitative study based on the responses of the 104 respondents, the PRINCE2 PM methodology was more rational for the project under consideration. The answers to the eight questions related to PM methodologies in the quantitative survey showed that the PRINCE2 PM methodology was given a priority. After the conversion of the answers of the one hundred and four respondents to eight questions into points, PMBOK scored 274 points, whereas PRINCE2 scored 558 points (see Figure 2). As a percentage, the PRINCE2 PM methodology accounted for 67% of the total points and the PMBOK methodology for 33%.

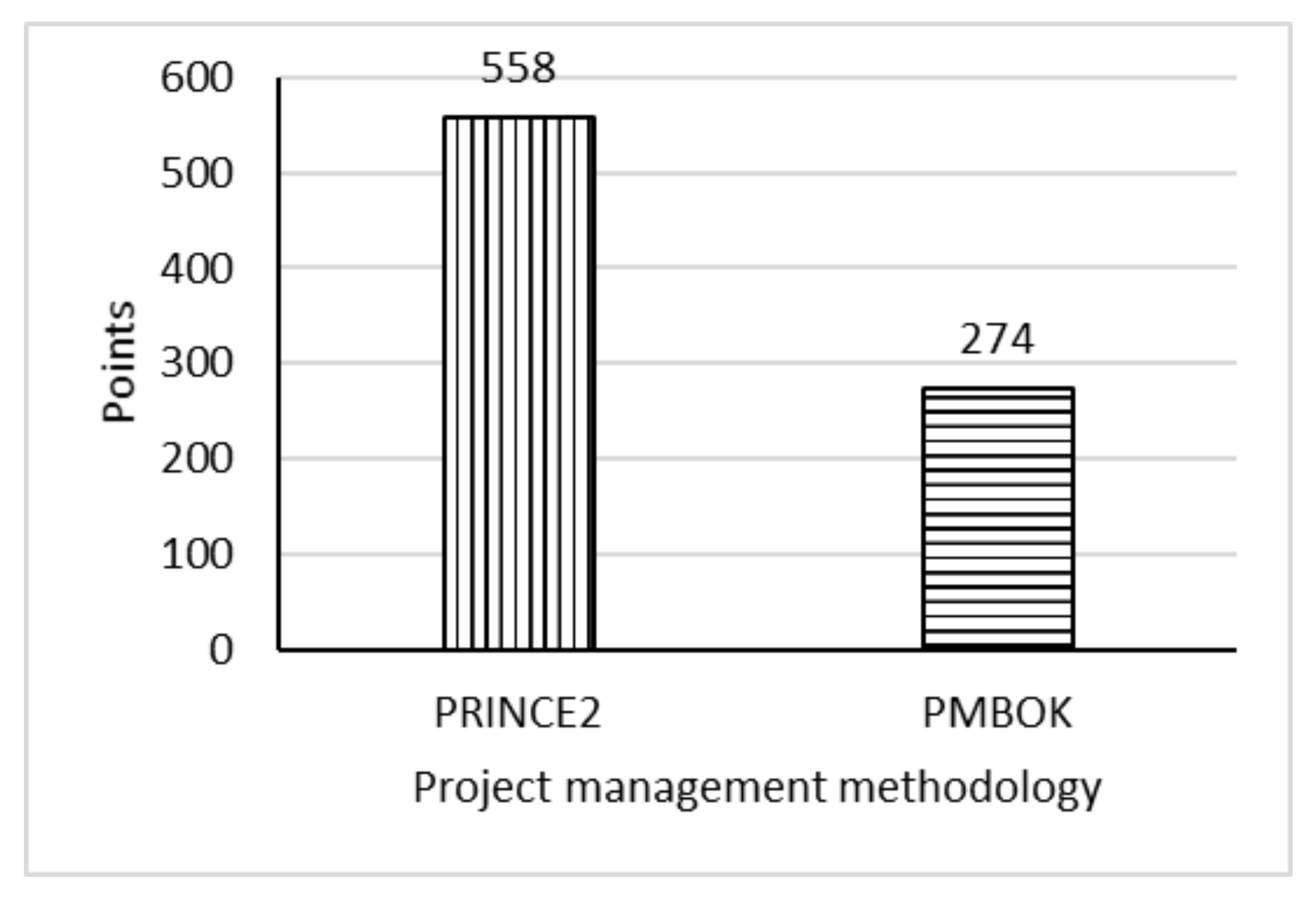

Figure 2.
PRINCE2 vs. PMBOK according to quantitative study.
Thus, based on the results of the quantitative study, the PRINCE2 PM methodology was chosen for further development of the repetitive construction project.
One of the principles of the PRINCE2 PM methodology is to learn from experience, so the lessons learnt must be applied to the repetitive project under analysis. The project was integrated through three main elements of PRINCE2: principles, themes, and processes [5]. The business case, organisation, quality, planning, risks, change, and progress are some of the key elements of PRINCE2 PM. In this case, the processes and tasks of the PRINCE2 PM methodology for the repetitive construction project were outlined and compared with the structure of the project in question and the tasks carried out [5]. A comparison of the PM processes using the PRINCE2 project management methodology and standard project management is presented in Table 8.
Table 8.
Comparison of the PM processes using the PRINCE2 project management methodology and standard project management.
Table 8 shows that the fundamental differences between the objectives of the PRINCE2 PM methodology for a repetitive construction project and a completed project are the information flow and different PM processes. For example, a repetitive construction project would introduce phases and phase boundary management, whereas an implemented project is not divided into phases. According to the PRINCE2 PM methodology, a repetitive construction project would aim to provide as much information as possible to the project participants, form a team and assign team leaders responsible for the phases, establish a financial plan, a detailed timetable for the execution of the works, a quality control plan, and a plan of responsible persons, and detail the technological sequencing of the works. These things were not carried out in the project under consideration. In addition, a repetitive project based on the PRINCE2 PM methodology would include a problem register, a risk and action plan, more frequent monitoring of the project progress, and more frequent meetings with the project’ team leaders and/or team members.
4.2. Recommendations for Improvement of the Implemented Repetitive Project Management at Company X
Given the results of the quantitative study and the comparison presented in Table 9, the PRINCE2 PM methodology was chosen for improvement of the implemented repetitive project management at Company X. The problems related to project management at Company X are presented in Section 3.3. Some recommendations about how to improve the identified problem areas using the PRINCE2 methodology are given below.
Table 9.
The answers of the Company X representative.
Increased design quantities. The customer calculated the design quantities using software. However, the actual demand for human resources and the yield of materials was higher than the customer’s design calculations. The recalculation of the quantities showed an increase of 21.54% over the projected quantities. Using the PRINCE2 PM methodology, the project initiation process, i.e., the pre-project phase, must clarify and justify the client’s expectations and enable a smooth start of the planned project. Therefore, the PJM has to give the task to a team member to check the project quantities internally against the customer’s drawings to avoid any misunderstandings during the execution of the project. The implementation of embedded sensors for automated tracking of construction equipment and materials on-site can lead to cost reductions in material expenses [53]. By leveraging this technology, construction projects can achieve improved efficiency and accuracy in managing their resources, resulting in potential savings in material costs.
Technological solutions. The technological painting solutions were refined during the project. Initially, the painting process was experimental in order to determine the most rational sequence of coat application. The lack of clarity in the tasks and the allocation of responsibilities in the teams before the start of the project resulted in poor-quality painting and inefficiency, as the work was conducted on the basis of impulsive decision-making. According to PRINCE2 PM principles related to roles and responsibilities and the nature of the organisation, before the start of a project, everyone involved in the project must know their responsibilities and tasks. Also, the PRINCE2 methodology calls for a clearly defined structure and sequence to guide the entire project team. Although the timeframe for the project preparation was shortened, a joint meeting of the project board (technical director, project director, works supervisor, and PJM), with the participation of the works supervisor, was able to find compromises to improve the project.
Lack of quality control. The poor quality of the anti-corrosive painting during the project execution indicated a lack of project control. Prior to approving the next stage of the project, the PJM must ensure that the work is carried out to the specified requirements and high standards. Failure to ensure the quality led to repeated operations that take as much time as the initial operation. Several factors contributed to this shortcoming, such as the inadequate induction of new works managers and their teams into the project, a lack of feedback from the works managers, and the absence of a coordinating person. A project team is formed with respect to the size and complexity of a project. The standard project team in Company X consisted of a project director, a PJM, a works organisation manager, an engineer, a supply manager, a works manager, and workers. The PRINCE2 methodology places an exceptional emphasis on quality control. Each member of the project team must have a clear understanding of the quality requirements, and the responsible persons (PJM, works manager) must be able to ensure that the work is carried out to a high standard. For example, to manage the project properly, the sandblasting work had to be divided into phases to ensure the quality of the project and to assign the responsible works managers for the sandblasting work. According to the authors of ref. [7], the analysis of stakeholders in a construction project should serve as a foundation for supporting and strengthening team-building activities. These activities encompass various aspects such as strategy development, aligning with project goals, defining members’ roles, and managing interfaces between different sections. By leveraging the outputs of stakeholder analysis, team-building efforts can be enhanced and aligned with the needs and expectations of relevant stakeholders involved in the project.
Failure to assign responsible works managers. The work was carried out in two shifts (morning and evening), with information being passed from the morning shift to the evening shift by the works managers. However, the evening shift and the morning shift did not meet, and thus the quality of the project was compromised because hard-to-reach areas were inadequately prepared and/or unpainted due to the lack of communication. To avoid quality control errors, it is necessary to assign a person responsible for certain operations, such as the works manager responsible for the quality of the sandblasting work, person X, who identifies and defines the shortcomings of the evening shift and communicates the backlog, highlighting the hard-to-reach spots, and the works manager Y who is responsible for the sandblasting. The PRINCE2 PM methodology helps to avoid such errors by breaking the project down into phases, thereby increasing control over certain operations, such as the first coat of paint. Once the project has been phased, it is necessary to assign responsible persons to ensure the quality of the phase. No further work is to be undertaken until the first phase, the first coat of paint in this case, has been approved. The PJM is responsible for the approval of the phase and may delegate the intermediate control of operations to team leaders.
Works not foreseen in the project. The project in question provided that the customer would supply scaffolding, but due to the poor mobility of the scaffolding, the work was carried out inefficiently, and it was not possible to reach a part of the steel structures. The contractor, therefore, decided to provide a mobile aluminium scaffolding system. Another problem encountered was the need for additional polyethilene film cover for the structures while using different painting systems. The change in the painting sequence necessitated a change in the pre-design solutions and an additional cover of the steel structures to achieve the highest quality. In this case, a detailed project preparation plan would have helped to avoid unforeseen activities or to plan them most efficiently, as emphasised by the PRINCE2 PM principles. Time and resource commitment must be clear, and everyone involved in the project must know in advance what is expected from the product. According to the authors of [54], the increasing adoption of prefabrication, modular construction, and additive manufacturing offers significant benefits in terms of reducing fabrication costs and enabling the timely completion of construction projects. The construction industry can streamline the production process, enhance cost-effectiveness, and improve project delivery timelines.
Delays in the agreed work schedule. Although the project timelines were clearly defined and the timeframe for each gas distribution station was known, the technological process of the project was only revised during the project, and errors were unavoidable. The painting of the steel structures in different sequences presented technological challenges, resulting in a deteriorated quality of the painting. The increase in project volumes also had an impact on the duration of the work, as the number of workers had to be increased to complete the work on time. The PRINCE2 PM model can be used to overcome such problems by checking the contractual quantities at the start of the project, preparing a detailed project plan, and phasing the work to be carried out in the project, thus eliminating the risks associated with the project delays. According to the authors of [35], by utilising project control software systems, specifically those professionally designed for project time and cost management, PJMs can effectively plan the construction sequence, monitor the progress of project activities, and update the project’s overall progress. These software systems enable PJMs to identify and track project delays efficiently.
Exceeding foreseen material resources. The overruns consisted of poor workmanship and work not foreseen in the design. For example, the demand for materials due to substandard work almost doubled as a repainting operation was required. Also, without knowing the exact quantities of the project, it was difficult to predict the exact material resources. This proves once again that in order to manage a project according to the business plan, it is essential to follow PRINCE2 PM principles and processes to avoid mistakes during the project. Firstly, the contractual quantities of the project have to be checked before the project starts. Also, the phases of work to be carried out are to be identified not only for quality control but also for intermediate control of material utilisation.
Thus, by following the PRINCE2 PM methodology, it is possible to avoid the problems that occur in certain phases and processes of PM.
4.3. The Results of a Descriptive Qualitative Study
Three companies of different sizes agreed to take part in the qualitative study. These companies were asked a series of questions (see Table 5), which were answered by company representatives. To ensure the confidentiality of information, the companies participating in the qualitative research were labeled as Company X, Company Y, and Company Z.
Company X was a specialised construction company providing services in constructing and repairing infrastructure, industrial, energy, commercial, and other building projects. Its main activities included anti-corrosion protection (blasting, shot blasting, anti-corrosion painting. and thermal coating), concrete repair and protection, installation of cast-in-place floors, fireproofing, and supply and installation of fire protection products. The company had more than 120 employees. The answers of the Company X representative are given in Table 9.
The second company participating in the qualitative study, labelled as Company Y, was also involved in specialised construction work. The portfolio of work included the design, installation, and assembly of water boreholes, the installation of water supply using hydrophores and frequency converters, the construction of domestic wastewater treatment plants and pumping stations, the restoration of borehole performance, deep grounding, etc. The company had around 90 employees. The answers of the Company Y representative are given in Table 10.
Table 10.
The answers of the Company Y representative.
Company Z was a general construction contractor engaged in industrial, residential, public, administrative, and cultural heritage construction and reconstruction, offering advanced, innovative, and sustainable construction solutions to the public and private sectors. The company applied advanced certification systems and international building standards—LEED, BREEAM, BIM, and ISO. The company employed more than 230 people. The answers of the Company Z representative are given in Table 11.
Table 11.
The answers of the Company Z representative.
The summary of responses provided in Table 9, Table 10 and Table 11 reveal that construction PJMs are responsible for managing the entire construction project, from the planning and design to execution and completion. Therefore, they have the power to make decisions that can affect the successes and effectiveness of the project.
Comparing the answers given by the representatives of the different companies, some similarities and differences were identified. These are summarised in Table 12.
Table 12.
Comparison of responses of the representatives of Companies X, Y and Z.
According to Table 12, the standard project teams varied according to the size of the company. In Company Y, the standard project team consisted of a PJM, a works manager, a works supervisor, and workers, while in Company X, an engineer was added, and in Company Z, in comparison with Company Y, the standard project team included a construction manager, a project engineer, and several works supervisors. This shows that the companies implemented projects of different sizes. Of course, the composition of a project team may vary for certain projects.
The comparison of companies X, Y, and Z in terms of the tools and techniques used for PM, PM approaches, and philosophies revealed significant differences. General contracting Company Z used six different applications for PM such as Building Information Modeling, an intelligent cost forecasting and management program, Dalux, Trimble, and the MS Project software, and it applied LEAN PM philosophies, which helped it to stay on track with project plans. Company X used four different applications for PM such as a unique software that tracks labour hours and material output based on work carried out, MS Excel, MS Project, and Power BI, but it did not identify the PM methodologies and philosophies used. Company Y employed the least number of tools, only three, which were Dalux, an electronic journal of construction works, and MS Excel, and it did not indicate any specific PM methodologies or philosophies but plans to implement additional PM tools shortly. In the future, various technologies such as machine learning, automation, artificial intelligence, the Internet of Things (IoT), data analytics, drone technologies, and robotics will present exciting opportunities for the workplace and, particularly, for the intelligent management of projects [55]. As project managers play a crucial role in implementing these transformative changes, the profession needs to be agile and adaptable to embrace the emerging wave of digitalisation. By embracing these advancements, project managers can effectively leverage the potential benefits and drive successful project outcomes in this rapidly evolving digital landscape.
Among the three companies (X, Y, and Z), the relevant project progress indicators were similar: monitoring man-hours and deviations in terms of materials and machinery used. Company X also focused on the number of human resources in the project, while Company Y additionally monitored the wear and tear of machinery, and Company Z monitored the duration of projects.
The comparison of the monitoring frequency and discussion of the progress of corporate projects revealed both differences and similarities. The companies participating in the qualitative study discussed financial results in monthly meetings. Companies X and Z monitored the progress of ongoing work projects daily, whereas in Company Y, the progress was monitored depending on the progress or size of the project. The notable differences between the companies could be seen in the discussion of the progress of the projects with the contractors. In Company X, no discussion was organised if the project was implemented according to the plan, except for larger projects, in which case the meetings were held every day. In Company Y, there was no defined periodicity of project progress discussion for small projects, but for larger projects, the meetings were held at least once a week. In Company Z, a meeting was held once a week regardless of the project results. Currently, virtual project teams have the advantage of utilising a wide range of technologies and communication tools to facilitate collaboration, even when team members are geographically dispersed, both domestically and internationally [55]. Tools such as Zoom meetings, Slack, FaceTime, Periscope, video conferences, and chat rooms have become invaluable assets for virtual teams. By harnessing these technologies, project teams can effectively bridge the distance and create seamless communication channels enabling efficient collaboration and coordination regardless of physical location.
The areas for improvement in the project progress reports of companies X and Z were the same, with representatives of both companies stating that they would like to see the financial results more often, while the representative of Company Z said that the company would like to systematise everything and introduce additional software, as there was a lack of supporting tools. The monitoring of project progress in companies X, Y, and Z helped to deal with the changes in project schedules and changes in the number of employees. In addition, the decision to terminate a contract may be taken in Company X. The general contracting Company Z monitored the sustainable use of materials and machinery to ensure their efficient use and to avoid downtime and keep within the planned quantities of materials. By leveraging the power of data analytics, project managers gain the capability to analyse and dissect intricate project data providing valuable insights and real-time predictions [56]. These analytical reports enable project managers to make informed decisions by drawing upon historical data, allowing them to effectively maintain project schedules and adhere to budgetary constraints [57]. This predictive information empowers project managers to proactively address potential challenges, optimise resource allocation, and ensure successful project outcomes.
The companies participating in the qualitative study had different perceptions of the project change plan. Company X organised a project change committee, where problems were identified and solved, while in Company Y, the causes of deviations were first identified, and then a meeting was organised to optimise the project plan, and finally, in Company Z, project changes were solved by the project team with the participation of department managers in meetings if extraordinary problems were encountered.
Successful PM in Company X consisted of a standardised implementation procedure, priority attention to the pre-project phase, and responsiveness of PJMs to problems and deviations. In Company Y, the focus was placed on the project, the optimisation of bottlenecks, and close communication with the customer. Company Z distinguished internal and external success factors in PM. The external success factors were detailed, and correct project decisions and the internal success factors involved timely communication of the project teams and constant planning. To enhance the PM success and improve the overall project results, continuous development of competencies and improvement of management methodologies are highly significant [30]. The authors of [58] examined organisation and management processes, empirically focusing on ontological and epistemological issues related to process research. They present effective methodological strategies for conducting empirical process studies and highlight some unique forms of insight that process research can provide.
It can be argued that the reasons for project delays identified by the companies in the qualitative study were similar. A lack of staff competence, inadequate project team structure, delays in material and machinery supply, breakdowns, and inconsistencies in design solutions were the main reasons for not meeting project deadlines. Leveraging Building Information Modeling and other simulation technologies can result in reduced project delivery time and enhanced cost management, ensuring projects stay within the allocated budget [59]. By utilising these advanced tools, project teams can optimise project planning, streamline coordination among stakeholders, and identify potential issues before they arise. This proactive approach facilitates efficient decision-making, mitigates risks, and improves overall project performance, leading to timely project completion and adherence to budgetary constraints. According to the authors of [60], incorporating design thinking into PM education is necessary to produce more effective PJMs and reduce the occurrence of project failures in the future.
4.4. Sustainability Aspect in Project Management for Future Studies
Construction projects have a significant impact on the environment and the society; therefore, construction project management and sustainability are strongly linked. This means that sustainability in construction project management requires the consideration of the environmental, social, and economic impact of a project throughout its life cycle. A variety of project management methodologies must be used to ensure that the desired sustainability outcomes are achieved. According to the authors of [61], integrating sustainability concepts into construction processes at both the strategic and operational levels has a profound impact on employees, the community, and the environment. Not only does this incorporation of sustainable practices benefit the well-being of employees, it also contributes to the enhancement of the community and the preservation of the environment. By prioritising sustainability in construction, organisations can drive positive changes and promote a more responsible and environmentally conscious approach to their operations. Embracing sustainable development enables project managers to shift their focus towards various aspects such as value creation, performance enhancement, efficiency improvement, business agility, project excellence, operational quality, paradigm shifts in thinking, flexibility, and more. New questionnaires can be designed based on the sustainable factors that include environmental, social, and economic impacts.
Future studies should also be linked with sustainability in construction PM through energy-efficient building development. One of the things which sustainability in construction PM could adopt is green building practices. These practices involve designing and constructing energy-efficient buildings using renewable resources and minimising waste. Green buildings are designed to reduce the carbon footprint of the building and ensure that the building operates efficiently throughout its life cycle. Given the increasing environmental concerns, reverse logistics also plays a crucial role in promoting sustainability within the construction industry. According to the authors of [62], reverse logistics has the potential to address and mitigate some of the adverse environmental impacts associated with construction activities, but its implementation level in the construction industry is still low. The root barriers to adopting reverse logistics in construction are as follows: the lack of financial incentives to incorporate recycled materials, the lack of knowledge about RL, the lack of technical support, standard codes, and regulations in favour of using recycled materials, the lack of information sharing, cooperation, and coordination among entities of the supply chain, the fact that current buildings have not been designed for deconstruction, and the lack of construction and demolition waste management and recycling infrastructures and markets for the materials resulting from construction and demolition waste.
In the case of PJMs, they have a critical role to play in promoting sustainability in the future. PJMs could also adopt sustainable procurement practices to ensure that the materials used in a construction project are sustainable. Sustainable procurement involves selecting materials that are environmentally friendly, socially responsible, and economically viable. Sustainable procurement practices can reduce the carbon footprint of a construction project, improve working conditions for workers, and support the local economy. In addition, they could promote sustainability through waste reduction and management. Waste reduction involves minimising the amount of waste generated during a construction project, while waste management involves the responsible disposal of waste. By adopting these practices, construction PJMs can minimise the environmental impact of a construction project. According to the authors of [63], inadequate stakeholder engagement, ineffective scope management, subpar schedule management, and insufficient resource management have detrimental effects on project sustainability over time. Moreover, these factors adversely impact employee wellbeing, resulting in decreased productivity, and they undermine the effectiveness of organisational management. The authors of [64] in their study indicated that obstacles such as ‘insufficient sub-contractor cooperation,’ ‘resistance to changes in existing company structure and policy,’ and ‘the need for additional employee training’ pose significant barriers to the successful implementation of environmental management systems in the construction industry. These identified barriers highlight that the primary challenge faced by construction professionals regarding environmental management systems implementation revolves around the level of emphasis placed on effectively communicating environmental concerns.
5. Conclusions
Based on the research conducted, the following conclusions were drawn:
- The respondents identified the PRINCE2 project management approach as the most suitable for managing a repetitive construction project. According to the PRINCE2 project management methodology, a repetitive construction project would aim to provide as much information as possible to the project participants, to form a team and assign team leaders responsible for the phases, to establish a financial plan, a detailed timetable for the execution of the works, a quality control plan, and a plan of responsible persons, and to detail the technological sequencing of the works.
- The rational project management approach PRINCE2 should be integrated into the management of a project under study by applying the seven principles, seven themes, and seven processes. Regular project meetings with the project board should be organised, information and plans should be prepared according to the principles and themes of the project management methodology, the project manager should appoint the persons responsible for the execution of the work, quality, and material control, and the phases should be analysed responsibly with the project board. Before the works are handed over to the client, the project manager should carry out a quality control check, and the project board should control the communication between the project manager and the project team. In the project closure process, a learning-from-experience re-list should be completed, and the project results should be summarised and evaluated.
- The analysis of the anti-corrosion works project under the PRINCE2 methodology suggested the following areas for improvement: checking the project quantities and describing the technological process before the start of the project to eliminate the risks associated with project delays; periodic control of the quality of the intermediate, understanding of quality requirements, and ensuring that work is carried out to a high standard; clarifying responsibilities and tasks in the teams before the start of the project; breaking the project down into phases to increase control over certain operations (such as the first coat of paint); and preparing a detailed project plan to avoid unforeseen activities (such as an additional cover of the steel structures).
- The results of the qualitative research and the comparison of the participating companies revealed the following key similarities in project management: monitoring of relevant project progress indicators, project changes based on the project progress report, and the monitoring of project delays. Meanwhile, the main differences in project management among the surveyed companies were the project team size, the tools and methodologies used for project management, the project management philosophy, and the frequency of monitoring and discussing project progress.
- According to the studied companies, a successful project management should consist of a standardised implementation procedure, priority attention to the pre-project phase and responsiveness of project managers to problems and deviations, focus on the project, optimisation of mistakes and close communication with the customer, detailed and correct project decisions, timely communication of the project teams, and constant planning. Meanwhile, the reasons for project delays were mainly related to the lack of staff competence, inadequate project team structure, delays in materials and machinery supply, breakdowns, and inconsistencies in design solutions.
- Sustainable construction projects can minimise a project’s environmental impact, improve working conditions, and support the local economy by adopting green building practices, sustainable procurement practices, and waste reduction and management practices. By prioritising sustainability development in construction, project managers can shift their focus towards various aspects such as value creation, performance enhancement, efficiency improvement, business agility, project excellence, operational quality, paradigm shifts in thinking, flexibility, and more. Future studies should also be linked with sustainability in construction project management through energy-efficient building development. One of the things which sustainability in construction project management could adopt is green building practices.
