Assessing Environmental Management Plan Implementation in Water Supply Construction Projects: Key Performance Indicators

by
Afiqah R. Radzi
1,
Abdelrahman M. Farouk
2,
Noor Suraya Romali
2,
Mohamed Farouk
3,4,*,
Mohamed Elgamal
3 and
Rahimi A. Rahman
2,5,*
1
Faculty of Built Environment, University of Malaya, Kuala Lumpur 50603, Malaysia
2
Faculty of Civil Engineering Technology, Universiti Malaysia Pahang Al-Sultan Abdullah, Kuantan 26300, Malaysia
3
Civil Engineering Department, College of Engineering, Imam Mohammad Ibn Saud Islamic University (IMSIU), Riyadh 11432, Saudi Arabia
4
Faculty of Engineering, Ain Shams University, Cairo 11517, Egypt
5
Faculty of Graduate Studies, Daffodil International University, Dhaka 1341, Bangladesh
*
Authors to whom correspondence should be addressed.
Sustainability 2024, 16(2), 600; https://doi.org/10.3390/su16020600
Submission received: 28 October 2023 / Revised: 30 December 2023 / Accepted: 4 January 2024 / Published: 10 January 2024

Abstract

:
Assessing the implementation of environmental management plans (EMPs) in construction projects is crucial for meeting environmental sustainability goals and reducing potential adverse impacts. By using performance indicators (PIs), stakeholders can objectively measure the performance of EMP implementation, identifying areas of success and areas that may require improvement. Therefore, this study aims to examine the PIs for assessing EMP implementation in water supply construction projects, using Saudi Arabia as a case study. Data from semi-structured interviews and a systematic literature review were used to develop a potential list of PIs. Then, the PIs were used to create a survey and distributed to industry professionals. Data from 112 respondents were analyzed using mean ranking analysis, the normalization method, exploratory factor analysis (EFA), and fuzzy synthetic evaluation (FSE). Eighteen critical PIs for assessing EMP implementation in water supply construction projects were identified, including public safety, road safety hazards, construction waste, clogged drainage, irregular flooding, the spilling of chemical substances, slope failures, soil erosion, landslide occurrence, increased schedule waste, changes in the color of bodies of water, oil/fuel spills, restricted site accessibility, the smell of run-off water, traffic accidents on construction sites, the spread of disease, changes in the color of run-off water, and overflowing silt traps. The EFA revealed that PIs can be grouped into three underlying constructs: fluid-related indicators, health and safety-related indicators, and site environment-related indicators. The FSE results confirmed that all PIs are between moderately critical to critical. This study’s significance lies in its examination of PIs that aim to improve the environmental performance of water supply construction projects. Understanding which indicators are most effective allows for targeted improvements, helping to minimize negative environmental impacts and ensuring sustainable practices. Finally, this study is a pioneer in examining the critical PIs for assessing EMP implementation in water supply construction projects.

1. Introduction

Environmental management plans (EMPs) are developed to ensure that construction projects are carried out in an environmentally responsible and sustainable manner [1]. Normally, construction projects result in substantial energy and natural resource consumption [2,3], accompanied by the release of significant levels of air, water, noise, and land pollution [4,5]. Furthermore, the construction and demolition debris generated by this industry has detrimental consequences, contributing to environmental issues such as pollution in water, soil, and air [6,7,8]. These challenges also extend to economic repercussions, including the depletion of essential resources and increased public health risks [9]. Hence, EMPs are designed to protect the environment from the potential harm caused by project activities by reducing or mitigating various adverse impacts. On the contrary, poor EMP implementation can expose nearby communities to health risks such as waterborne diseases, respiratory issues, and other health problems, particularly if pollutants or hazardous materials are released into the environment [10]. Failure to implement EMP can result in significant environmental damage, including habitat destruction, water pollution, soil erosion, and biodiversity loss [11,12]. These environmental impacts can be long-lasting and may harm ecosystems and natural resources. Therefore, it is essential to ensure effective EMP implementation to minimize these risks and ensure responsible project management.
Construction project stakeholders may not correctly implement EMPs for several reasons. Some stakeholders, especially those indirectly involved in environmental management, may have little awareness and not fully understand the importance of EMP implementation [13]. Moreover, there is a lack of enthusiasm among project stakeholders when it comes to implementing EMPs due to the perception that the associated benefits and competitive advantages are relatively minimal [14]. In addition, implementing EMP measures often requires financial resources, technical expertise, and personnel. Stakeholders may face budgetary constraints or a shortage of trained personnel, making it challenging to execute the plan effectively. In addition, stakeholders may prioritize other aspects of the project, such as cost and schedule, over environmental considerations. Stakeholders who do not prioritize environmental sustainability or do not have a strong commitment to responsible environmental management may not allocate the necessary resources and attention to EMP implementation. Thus, there is a need to find appropriate approaches to ensure the correct and effective EMP implementation by construction project stakeholders. Despite this imperative, the existing body of literature in relation to indicators that assess EMP implementation holds limited studies. While [15] made notable contributions by developing a set of environmental operational indicators and performance indicators, the focus primarily centered on environmental performance assessment, and the perspectives were derived from project managers. Similarly, Ref. [16] delved into indicators for EMP implementation but primarily within the context of road construction projects. Additionally, Ref. [17] extended this inquiry to highway construction projects. Notably, these works have concentrated on indicators specifically tailored to highway and road construction, leaving a notable gap in the exploration of EMP indicators for a broader range of construction projects.
PIs are often an integral part of multi-criteria decision-making (MCDM) processes. In MCDM, decision makers evaluate and compare multiple criteria to make informed decisions. PIs serve as measurable criteria that are used to assess the effectiveness or performance of a system, process, or project. MCDM allows for the prioritization of the critical aspects of EMP implementation. By assigning weights to different PIs, stakeholders can focus on the most crucial elements, optimizing resource allocation, addressing the most pressing environmental concerns, and ensuring a more targeted approach to improvement. Moreover, PIs provide a structured way of monitoring the progress and effectiveness of EMP implementation by offering measurable data points that allow stakeholders to gauge how well environmental measures are being executed. These indicators are early warning signs of potential issues and challenges in EMP implementation. The early identification of problems allows for timely corrective action, preventing the escalation of issues that could disrupt this project’s progress. In addition, project managers and environmental professionals can establish robust monitoring systems by understanding the indicators of poor EMP implementation. This project’s environmental performance may be tracked more effectively, ensuring that EMP measures are consistently applied. Moreover, recognizing indicators of poor EMP implementation helps project stakeholders prioritize ecological protection by focusing on areas where EMP may fail, leading to the improved protection of ecosystems, water quality, and biodiversity. Thus, there is a need to investigate the appropriate PIs for assessing EMP implementation to improve environmental management practices in water supply construction projects, leading to more sustainable and environmentally friendly construction practices.
Based on this background, this study aims to investigate the effectiveness of PIs in assessing EMP implementation in water supply construction projects, using Saudi Arabia as a case study. Specifically, the study objectives are to identify the critical PIs, group the PIs, and evaluate the effectiveness of the PIs to assess EMP implementation in water supply construction projects. To accomplish this goal, 112 environmental professionals completed a questionnaire survey. The data were analyzed using the mean ranking analysis, normalization method, exploratory factor analysis (EFA), and fuzzy synthetic evaluation (FSE). Finally, a set of effective PIs for assessing EMP implementation in water supply construction projects was established. This study contributes to a better knowledge of PIs for assessing EMP implementation in water supply construction projects. Moreover, the study findings can serve as a significant reference for industry practitioners and policymakers in assuring the success of EMP implementation in water supply construction projects. Using the right set of PIs is crucial for assessing EMP implementation accurately and improving environmental management practices in water supply construction projects, leading to more sustainable and environmentally friendly construction practices. Also, this study is a pioneer in examining the critical PIs for EMP implementation in water supply construction projects. By identifying critical PIs and evaluating EMP implementation, this study contributes to the protection and conservation of the environment, safeguarding natural resources, ecosystems, and biodiversity, which directly impact the well-being of the community. Moreover, this study uses of a combination of semi-structured interviews, a systematic literature review, and multiple analytical methods (mean ranking analysis, normalization method, EFA, and FSE) to provide a comprehensive methodological approach. Other researchers can learn from and potentially adopt these methods for future research, especially in the context of identifying PIs for assessing EMP implementation in construction projects. The list of critical PIs can serve as a starting point for researchers working on similar topics, providing a foundation for developing other performance indicators or refining existing ones. This study’s outcomes can also serve as a benchmark for future comparative studies. Researchers may use the identified PIs and the categorization of constructs as a reference point when comparing the effectiveness of implementing an environmental management plan across different projects, regions, and time periods.

2. Literature Review

2.1. Performance Indicators for Construction Projects

PIs for construction projects are vital for monitoring and managing construction activities [18,19]. The construction industry has a long history of developing and using indicators, particularly in the context of sustainable development [20]. These indicators are essential tools for measuring and assessing the environmental, social, and economic impacts of construction projects and for guiding efforts to make the industry more sustainable. Moreover, as public awareness of environmental issues is paramount, educating the public about these concerns, including their causes, consequences, and potential policy solutions, can increase support for government initiatives addressing environmental challenges [21]. In this broader context, PIs play a vital role in evaluating environmental performance and monitoring progress toward sustainable development goals. They can also be applied at the national level to assist in planning, setting policy goals, and establishing environmental priorities. Through the measurement and analysis of environmental-related PIs, construction projects can minimize their environmental impact and contribute to the preservation of the environment, ensuring that development activities align with broader environmental conservation goals. In essence, PIs are integral to effective environmental management and public involvement in environmental issues.
Prior work has recognized the existence of various environmental PIs across different project types. The appropriate use of indicators can be a powerful tool in addressing the sustainability of businesses both at a corporate-wide level and at a project level [22]. For instance, Ref. [20] identified and evaluated performance indicators aimed at monitoring and appraising the sustainable performance of construction projects in the execution phase within the United Arab Emirates. Their findings underscore the significance of indicators related to renewable energy and construction site safety. Furthermore, Ref. [23] delved into environmental performance indicators to assess the sustainability of building projects. This work highlighted key indicators, such as the project’s impact on water quality, air quality, energy consumption, conservation, environmental compliance, and management. These investigations contribute valuable insights to stakeholders, aiding in identifying the most pertinent sustainability indicators for construction projects, thereby facilitating assessments of sustainability performance.

2.2. Construction Industry in Saudi Arabia

The construction industry in Saudi Arabia is globally recognized as one of the largest and most influential industries, mainly due to its substantial contributions to the development of numerous mega projects [24]. In terms of economic significance, the construction industry accounts for approximately 6% of Saudi Arabia’s Gross Domestic Product (GDP) [25]. Moreover, this contribution to the GDP is anticipated to continue increasing in the coming years. The Saudi Arabian government has made a substantial commitment to bolster the construction industry by earmarking a significant portion of the annual national budget for its growth over the next decade, with the aim of achieving the ambitious targets outlined in the Vision 2030 initiative [26]. Vision 2030, coupled with the National Transformation Programme 2020, aiming for a boost in private sector investments and ongoing reforms, collectively serve as the driving forces behind the expansion of the Saudi construction industry. These developments have yielded positive outcomes, particularly in the advancement of housing and industrial construction activities throughout the nation. Furthermore, Saudi Arabia has a multitude of megaprojects slated for completion by the year 2030, reflecting the nation’s commitment to ambitious development goals and economic diversification.
Several works have been conducted to enhance the construction industry in Saudi Arabia. In a work by [27], critical success factors (CSFs) were identified to facilitate the adoption of value management practices within Saudi Arabia’s construction industry. To enhance the adoption of value management, 25 CSFs were defined with insights from construction experts. Another work by [24] focused on understanding the constraints and restrictions affecting construction projects in Saudi Arabia, particularly during the planning stage. This work indicated that disputes over project timelines, cost overruns, and project abandonment were significant factors contributing to project failures. In addition, government officials and contractors were identified as contributors to project delays and delivery issues. Additionally, Ref. [28] examined the implementation and design of safety practices in the Saudi Arabian construction industry. This work highlighted that crucial success factors for safety practices include legislation and stakeholder awareness, while a major barrier involves clients’ and their representatives’ apprehension regarding cost overruns. These prior findings collectively provide valuable insights into different facets of the construction industry in Saudi Arabia, offering opportunities to enhance industry practices and address critical challenges for improved performance.

2.3. Water Supply Construction Projects

The body of existing work on water supply construction projects is relatively limited, but several noteworthy works have explored the critical aspects of these projects [29], for instance, investigated the key risk factors associated with public–private partnerships (PPPs) in water supply infrastructure projects. Their findings emphasized the importance of risk-sharing between the government and private sector entities rather than solely transferring the specific risks to one party. Ref. [30] delved into the CSFs for water infrastructure projects delivered through public–private partnerships. Their work underscored the significance of thorough planning to ensure project viability, a high degree of transparency and accountability, and the establishment of a legal framework ensuring policy continuity as CSFs for the successful delivery of water infrastructure projects under PPP initiatives. Their findings emerged from factor analysis, leading to the identification of grouped factors related to public cooperation, project viability, and policy and legislation enhancement. Furthermore, Ref. [31] explored the challenges associated with poor delivery and the underlying factors contributing to inadequate outcomes in water infrastructure projects in South Africa. Their work revealed major challenges, such as project completion delays, cost overruns, subpar work quality, inefficient fund utilization, and unsatisfactory service delivery. They further identified the factors contributing to these challenges across four critical dimensions of infrastructure projects: project management, organization and management, construction and construction management, and sociopolitical aspects.

2.4. Positioning This Study

The background information provided highlights a critical gap in the current body of knowledge on EMP implementation. While various works have been conducted in this country, there is a noticeable dearth of research on EMP implementation. Furthermore, it is worth noting that existing works on water supply construction projects have primarily centered around risk assessments, CSFs, and challenges. This study aims to proceed beyond these aspects by comprehensively analyzing PIs, their interrelationships, and their effectiveness in evaluating EMP implementation. This holistic approach can provide a more nuanced and comprehensive understanding of the role of PIs in promoting effective environmental management within water supply construction projects. Therefore, this study aims to address this gap by focusing on the effectiveness of PIs. In doing so, this study seeks to pinpoint areas where improvement is needed and propose tailored approaches for assessing EMP implementation. This approach is crucial for refining environmental management practices in water supply construction projects and ensuring sustainability and environmentally friendly construction practices. In other words, this study endeavors to fill a significant research gap, enhance an understanding of EMP implementation in the context of water supply construction projects and contribute to more sustainable and environmentally conscious construction practices.

3. Methodology

3.1. Survey Development

This study used a questionnaire survey to collect data on PIs quantitatively to assess EMP implementation in water supply construction projects. Surveys are a proven and efficient method for gathering diverse responses from professionals, especially when random sampling is applied [32]. The subsequent sections provide insights into the survey development process used in this study.

3.1.1. Systematic Literature Review

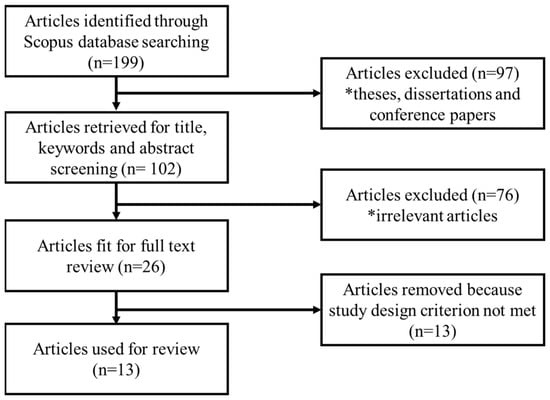

A systematic literature review (SLR) was conducted to identify the potential PIs reported in the prior literature. The process commenced with a search conducted in the Scopus database. Scopus was chosen as the database of choice due to its popularity and relevance in the field of construction management [33]. The SLR began with an extensive search for relevant articles, using the “title/abstract/keyword” function in the Scopus database, resulting in the identification of 199 papers. To ensure the robustness of the selected literature, only peer-reviewed journals were selected for their higher quality from a more thorough peer review process [34]. Following the initial screening of abstracts, 26 articles were deemed suitable for further review. However, not all articles were directly related to PIs in construction projects. Thus, articles that did not meet the subject matter were eliminated following a thorough examination of their content. Consequently, a total of 13 articles were found to be valid for further investigation. Figure 1 shows the SLR process conducted in this study.

3.1.2. Interview

In addition to the SLR, interviews were conducted with environmental professionals to identify the potential PIs that might not have been previously documented in the existing body of knowledge. This approach aligns with previous works that have used a combination of SLR and interviews to comprehensively identify relevant variables during survey development [35,36]. The interview process commenced with an introductory phase, during which the purpose of the interview and the topic of discussion were outlined. Subsequently, interview questions were presented to the interviewee. In some instances, follow-up questions were posed based on the interviewees’ responses to gain a deeper understanding of the information provided and ensure clarity. If needed, questions were rephrased to facilitate accurate responses. At the conclusion of each session, the interviewer expressed gratitude to the interviewees for their participation. To maintain transparency and accuracy, a summary of each interview was prepared and shared with the respective respondents for validation [37,38].
The interviews involved ten environmental professionals due to data saturation. Data saturation is an important tool for evaluating qualitative data [39]. Data saturation occurs when researchers reach a point where collecting more data does not provide additional information relevant to the research questions [40]. During the interviews, data saturation was achieved with the tenth participant, signifying that further data collection would likely yield redundant information. It is noteworthy that a qualitative inquiry employing interviews often advocates for a participant range between 5 and 25 [41]. Prior works in the construction project management area have also used data saturation in qualitative studies [42,43].
The interview data were analyzed using the thematic analysis technique, as described by [44]. The analysis aimed to identify and categorize the PIs that emerged from the interviews, ultimately contributing to developing a comprehensive list of PIs for assessing EMP implementation in water supply construction projects. Table 1 summarizes the 39 potential PIs for assessing EMP implementation that were identified through the SLR and semi-structured interviews.

3.1.3. Survey Design

The front page of the survey included the study objectives and contact information. The first section of the survey asked respondents about their backgrounds and experience in relation to water supply construction projects to assess their applicability to answering the survey. The PIs were listed and evaluated in the second section on a five-point Likert scale (1 = not important; 2 = slightly important; 3 = moderately important; 4 = important; 5 = very important). The Likert scale is commonly used in construction project management research due to its precision [64,65]. At the end of the survey, respondents were given spaces to describe and rank any additional PIs to assess EMP implementation in water supply construction projects.

3.1.4. Pilot Test

Detecting design and instrumentation issues in a survey is possible through a pilot test [66]. Additionally, feedback from the pilot test is vital for enhancing the survey’s quality and estimating the time needed for its completion [67]. A pilot test involving five environmental professionals and five academics possessing over a decade of experience in water supply construction projects was executed. This pilot study aimed to eliminate unclear language and ensure the correct usage of technical terms within the survey. Consequently, this survey was refined based on feedback from the pilot test participants and then deemed finalized.

3.2. Data Collection

The target population for the survey was environmental professionals involved in water supply construction projects in Saudi Arabia. Purposive sampling was adopted to achieve the target population. Purposive sampling entails identifying and choosing knowledgeable and skilled individuals [68]. In addition, the respondents must be available, willing to participate, and able to express their experiences and opinions clearly, expressively, and reflectively [69]. Finally, a total of 112 valid responses were obtained.
Table 2 shows that more than half of the respondents, accounting for 58.9% of the total sample, possessed 10 or more years of experience in water supply construction projects. Regarding the number of water supply construction projects they had been involved in, only 27.7% of those surveyed reported having experience with just one project. In contrast, the remaining 72.3% of the sample had experience with at least two water supply construction projects. This suggests that the data collected can be regarded as reliable for further analysis, given the respondents’ substantial level of professional experience in water supply construction projects.

3.3. Data Analysis

3.3.1. Reliability of Data

Reliability analysis was undertaken to assess the survey’s reliability and consistency. The internal consistency of the 39 PIs was tested using Cronbach’s alpha (α) coefficient. The α value ranged from 0 to 1, where 0 denotes no consistency, and 1 denotes internal consistency. An acceptable level of consistency was indicated by an α value of 0.70 or above [70]. The 39 PIs obtained an overall score of 0.944 at the 5% significance level, confirming data reliability. As a result, the acquired data are suitable for further investigation.
Outliers were then identified by screening the dataset with a two-standard deviation technique [36]. Data points that deviated from the norm significantly and that could have a major impact on the outcome were considered outliers. In the two-standard deviation approach, two separate standard deviation intervals were calculated. Variables were considered outliers if their means were outside any of these two standard deviation ranges. Intervals of 2.504 and 4.178 were determined using the two standard deviation approaches. As “Deforestation” (PI29) and “Public Safety” (PI28) were outside the two SD interval values, they were considered outliers. “Deforestation” (PI29) was not included in the further analysis. given that practitioners deemed it to be less important than other variables. However, “Public safety” (PI28) was still included in subsequent analysis because it was considered to potentially be very important. The importance or relevance of an indicator may outweigh its deviation from the mean. In some cases, a particular indicator may have unique significance or may be considered critical by stakeholders or experts, even if it exhibits outlier characteristics. For example, “Public safety” (PI28) might indicate a high level of importance in a water supply construction project, justifying its retention despite being an outlier.

3.3.2. Mean Ranking Analysis and Normalization Method

This study employed a mean score ranking method to establish the relative rankings of the PIs. In cases where multiple PIs had identical mean values, the PI with the lowest standard deviation (SD) was accorded the highest rank. A smaller SD indicates that the differences in responses are not statistically significant, making the mean value a more reliable representation for most respondents [70].
After ranking the PIs, a normalization technique was applied to facilitate a more meaningful interpretation of the data, particularly when identifying crucial variables. This normalization approach was adapted from the work of [71]. This procedure involved setting the minimum mean value to 0 and the maximum mean value to 1. Subsequently, the other mean values were converted into decimal values within the range of 0 to 1. PIs with normalized values of at least 0.50 were identified as critical for evaluating EMP implementation in water supply construction projects.

3.3.3. Exploratory Factor Analysis

This study employed EFA as a method that condenses a large number of interrelated variables into more manageable and relevant sets or constructs [72]. The ratio of the sample size to the number of variables was calculated to determine the sample size for the EFA. Eighteen critical PIs were identified based on the normalization method. The calculated ratio of the sample size to the number of variables was 6.22, which exceeded the recommended value of 5.00 [73], indicating that the sample size was sufficient for EFA.
Two assessments were conducted to determine the appropriateness of the data for EFA. The Kaiser–Meyer–Olkin (KMO) measure of sample adequacy compared the squared correlation between variables to the squared partial correlation between variables; a good EFA typically had a KMO value higher than 0.50 [74]. Additionally, Bartlett’s test of sphericity was used to assess the relationships between variables. EFA is considered appropriate if the original correlation matrix is not an identity matrix, indicating significant relationships between the variables [75].
Principal Component Analysis (PCA) was utilized as the method for factor extraction to uncover the underlying constructs within the dataset. Variables with eigenvalues greater than one, indicating their substantial contribution to the principal constructs, were retained for further analysis. Following this, a varimax rotation was applied to the PIs to uncover any latent constructs. Variables with factor loadings surpassing 0.50 were deemed significant and valuable for interpreting these constructs [76].

3.3.4. Fuzzy Synthetic Evaluation

Finally, this study employed the FSE technique to assess the effectiveness of each PI and construct. This method has been used in previous construction project management research to evaluate different types of variables, including strategies and impacts [65,77,78]. The steps for executing the FSE are as follows:
  • Step 1: Weightings for each performance indicator
The effectiveness of the FSE method relies on the weights assigned to each component and subcomponent. Equation (1) was used to calculate the weightings for each critical PI.
W i = M i i = 1 5 M i , 0 w i 1 , 0 i 1
where W i is the weighting; M i is the mean score, and M i is the summation of the mean score of all critical PIs.
  • Step 2: The membership function for each component
FSE employs grading alternatives to generate membership functions (MFs) for the critical PIs. A five-point Likert grading scale was used, ranging from 1 (very low) to 5 (very high), denoted as E = (1, 2, 3, 4, 5). Equation (2) was used to calculate the MF of each critical PI based on the survey responses.
M F u i n = x 1 u i n E 1 + x 2 u i n E 2 + x 3 u i n E 3 + x 4 u i n E 4 + x 5 u i n E 5
where uin is the PIs; M F u i n is the MF of a given PI; x j u i n (j = 1, 2, 3, 4, 5) is the percentage of respondents who were rated j for the significance of a specific PI, which measures the degree of MF; x j u i n E 1 is the relationship between x j u i n and its grade alternative; and ‘+’ is a notation in a fuzzy set. Using Equation (3), the MF of a specific critical PI could be indicated as follows:
M F u i n = x 1 u i n + x 2 u i n + x 3 u i n + x 4 u i n + x 5 u i n
Equation (4) is used to process and can be adopted when multiple components are considered, and the difference in their weight is minimal.
M · , b j = min 1 , w i × r i j m i n = 1 b j B
where wi represents the weightings of each PI; r i j is the membership function of each critical PI; and ⊕ is the sum of the weighting and membership function product.
  • Step 3: Overall effectiveness level
The overall effectiveness level (OEL) of critical PIs was computed using Equation (5). This equation considers the weightings (W), the degree of the MF (R), and L as the linguistic variables (1—very low, 2—low, 3—neutral, 4—high, 5—very high) to determine the OEL. The OEL of the critical PIs can be computed as follows:
O E L = Σ n i = 1 W × R i × L

4. Result

4.1. Result of Mean Ranking Analysis and Normalization Method

The results of ranking the PIs for assessing EMP implementation in water supply construction projects are presented in Table 3. The mean value of the PIs extends from 2.571 to 4.214. The critical PIs have normalized mean values of at least 0.50. Eighteen PIs were found to have normalized values of 0.50 or above, making them critical PIs.

4.2. Result of EFA

The Kaiser–Meyer–Olkin (KMO) value for the PIs stands at 0.855, surpassing the minimum threshold of 0.50 [74]. Conversely, Bartlett’s test of sphericity returned a significant value of 0.000, indicating that the dataset is not an identity matrix. Consequently, the data are deemed suitable for EFA.
As illustrated in Table 4, 14 PIs are successfully loaded into three underlying constructs, each possessing factor loadings greater than 0.50. These three constructs collectively account for 60.414% of the total variance. To determine the appropriate label for each construct, one can consider variables with higher factor loadings or the entire set of variables. Hence, the constructs are categorized as fluid-related indicators (F), health and safety-related indicators (HS), and site environment-related indicators (SE).
Additionally, Cronbach’s alpha reliability test was conducted to ensure the accuracy of the grouping of factors. As indicated in Table 4, Cronbach’s alpha coefficients exceeded the minimum threshold of 0.60 [79]. This implies that each construct exhibits good internal consistency.

4.3. Result of FSE

Table 5, Table 6 and Table 7 display the FSE results for key PIs, including MFs for levels 3, 2, and 1, along with an OEL value of 3.72. Meanwhile, site environment-related indicators have the highest criticality at 3.84. This is followed by health and safety-related indicators (3.75) and fluid-related indicators (3.65). In other words, all constructs have values between “moderately critical” to “critical”. Policymakers should consider focusing on the key PIs in site environmental-related indicators. However, the other constructs cannot be ignored when assessing EMP implementation in water supply construction projects.

5. Discussions

5.1. Fluid-Related Indicators

The first construct identified through factor analysis is referred to as “Fluid-Related Indicators.” This construct encompasses indicators that pertain to fluid elements used to assess the implementation of an EMP in water supply construction projects. It comprises the following seven specific indicators: PI12, PI18, PI6, PI9, PI8, PI7, and PI1.
Changes in the color of bodies of water (PI12) are an indicator of the poor implementation of an EMP in water supply construction projects. Water bodies changing color, typically to a murky or unnatural hue, can be a visible and easily noticeable sign of pollution or contamination. It serves as an early warning signal that something may be wrong with the water quality. Another indicator of poor EMP implementation is changes in the color of run-off water (PI18). Run-off water is water that flows over the surface of the ground rather than soaking into it. It occurs when precipitation, such as rain or melted snow, falls onto the Earth’s surface and cannot be absorbed by the soil or vegetation. Changes in the color of run-off water, especially if it becomes discolored or murky, can be a clear sign of pollution or contamination. Run-off water should ideally be clear or match the natural color of the surrounding environment. Color changes can indicate the presence of sediments, chemicals, or other pollutants.
In addition, the spill of chemical substances (PI6) is one of the indicators of poor EMP implementation in water supply construction projects. When chemical spills occur despite the presence of an EMP, it may suggest shortcomings in the plan’s implementation and management. Water environments are often highly sensitive to chemical contamination. Even small chemical spills can have significant adverse effects on aquatic ecosystems, water quality, and the health of aquatic organisms. Furthermore, oil/fuel spills (PI9) are also one of the indicators to assess the implementation of an EMP. Oil and fuel spills can lead to water pollution, affecting the quality of water bodies. Monitoring and mitigating such spills are essential to prevent contamination and ensure that water remains safe for various uses, including drinking water supply and recreational activities.
Also, an overflowing silt trap (PI8) indicates poor EMP implementation in water supply construction projects. When a silt trap overflows, erosion control measures may not effectively prevent sediment run-off, potentially leading to increased water pollution. Sediment pollution is the most significant pollutant from construction sites as it could potentially simultaneously affect the economy, environment, and society [80]. Clogged drainage (PI7) is another indicator of poor EMP implementation. Drainage systems are crucial for managing the flow of water on construction sites. When drainage systems become clogged, it can disrupt the intended flow of water, potentially leading to localized flooding, erosion, or other water-related issues. Soil erosion (PI11) is another indicator to assess the implementation of an EMP in water supply construction projects. Soil erosion is a primary concern in construction projects, especially those near water bodies. Uncontrolled erosion can result in the loss of topsoil, the sedimentation of water bodies, and the release of contaminants, which can negatively impact water quality and aquatic ecosystems.

5.2. Health and Safety-Related Indicators

The second construct identified through factor analysis is referred to as “Health and Safety-Related Indicators”. This construct comprises indicators that are associated with health and safety considerations and are used to assess the implementation of an EMP in water supply construction projects. It has the following five specific indicators: PI28, PI33, PI19, PI2, and PI25.
Public safety (PI28) is one of the indicators to assess the implementation of an EMP in water supply construction projects. Public safety incidents, such as accidents or injuries involving nearby residents or visitors, indicate that safety measures outlined in the EMP may not be adequately enforced or effective. Ensuring the safety of workers, nearby residents, and the general public is a top priority in any construction project. Also, the spread of disease (PI33) is another indicator of poor EMP implementation in water supply construction projects. Construction activities can pose a risk of contributing to the growth and spread of waterborne pathogens in building water systems [81]. Moreover, construction sites near water bodies can pose health risks due to the potential for the spread of waterborne diseases. Monitoring the spread of disease is critical for safeguarding the health and safety of workers and nearby communities.
Another indicator of poor EMP implementation is the occurrence of landslides (PI19). Landslides pose a significant safety risk to workers on the construction site and nearby communities. Construction activities near water bodies can alter the stability of slopes and increase the likelihood of landslides [82]. Traffic accidents on construction sites (PI2) are also an indicator to assess the implementation of an EMP in water supply construction projects. Traffic accidents on construction sites can lead to injuries or fatalities among construction workers. Traffic accidents can disrupt nearby communities, lead to complaints, and negatively impact community relations, especially if the public perceives that the construction project is causing avoidable accidents. In addition, slope failures (PI25) are one of the indicators of the poor implementation of an EMP. Slope failures pose a significant safety risk to construction workers on the site, as well as to nearby communities and the public. Slope failures can result in soil erosion, the sedimentation of water bodies, or the release of contaminants, harming aquatic ecosystems, disrupting habitats, and degrading water quality.

5.3. Site Enviroment-Related Indicators

The third construct identified through factor analysis is referred to as “Site Environment-Related Indicators”. This construct encompasses indicators that are associated with the site’s environment and are used to assess the implementation of an EMP in water supply construction projects. It includes the following three specific indicators: PI21, PI26, and PI38.
The first indicator in this construct is restricted site accessibility (PI21). Limited site accessibility can impact the safety of construction workers and site visitors. Restricted access routes can lead to delays in emergency response, potentially jeopardizing the safety of workers and the public. Irregular flooding (PI26) is also one of the indicators to assess the implementation of an EMP in water supply construction projects. Irregular flooding can pose a severe safety risk to construction workers on the site, as well as to nearby communities and the public. Road safety hazards (PI38) are another indicator of poor EMP implementation. Construction sites near water bodies, including heavy construction vehicles, often involve increased traffic. Road safety hazards can also affect nearby communities and the general public. Additionally, injuries and fatalities associated with construction accidents impose a huge cost on the industry [83].

5.4. Comparison with Prior Works

A comparison of this study’s results with prior findings offers a nuanced understanding of the PIs for assessing EMP implementation. Specifically, this study’s outputs were compared with PIs identified in the context of road construction [16] and highway construction projects [17], revealing both commonalities and disparities. Table 8 captures the essence of this comparative analysis, indicating that out of the 18 critical PIs identified in this study, 6 were not deemed critical in prior works. Notably, in road construction projects, indicators such as restricted site accessibility, road safety hazards, the smell of runoff water, traffic accidents on construction sites, and the spread of disease were not considered critical. Similarly, in highway construction projects, increased schedule waste, restricted site accessibility, the smell of runoff water, and the spread of disease did not emerge as critical indicators. Despite these variations, a noteworthy observation is the substantial overlap in critical PIs between this study and prior research. Most of the PIs identified as critical in the current study were consistently reported as critical in the context of road and highway construction projects. This consistency underscores the pivotal role that these particular indicators play in assessing EMP implementation across diverse construction scenarios, implying that certain environmental considerations encapsulated in these critical PIs have universal relevance and importance in evaluating the sustainability of construction projects. In essence, the persistent identification of these shared critical PIs underscores their centrality in gauging the effectiveness of EMP implementation. Recognizing and acknowledging these indicators is not only crucial but forms an integral part of ensuring sustainable construction practices, fostering a comprehensive and standardized approach toward achieving environmentally responsible construction outcomes.

6. Conclusions

This study focuses on identifying and assessing the effectiveness of PIs for assessing the implementation of EMPs in water supply construction projects. This study identified a total of 39 potential PIs based on insights from interviews with environmental professionals and a comprehensive review of the existing literature. This study collected data from 112 environmental professionals who completed surveys to evaluate the effectiveness of these PIs. The analysis employed several techniques, including mean ranking, normalization, EFA, and FSE. This study identified 18 critical PIs for assessing EMP implementation through these analyses. These critical PIs encompass a wide range of factors, including public safety, road safety hazards, construction waste, clogged drainage, irregular flooding, spilling chemical substances, slope failures, soil erosion, landslide occurrence, increased schedule waste, changes in the color of bodies of water, oil/fuel spills, restricted site accessibility, the smell of run-off water, traffic accidents on construction site, spread of disease, changes in the color of run-off water, and overflowing silt traps. Additionally, the result of EFA grouped these PIs into the following three underlying constructs: fluid-related indicators, health and safety-related indicators, and site environment-related indicators. The FSE results confirmed that all PIs are between moderately critical to critical in their importance.
This study’s findings have several implications. First, the results can serve as a valuable resource for academics and researchers interested in developing frameworks for improved EMP implementation in water supply construction projects. Second, the results can enhance environmental management practices in water supply construction projects, ultimately leading to more sustainable and eco-friendly construction practices. In conclusion, this study provides valuable insights into PIs for assessing EMP implementation in water supply construction projects, offering a foundation for further research and potential improvements in environmental management practices in the construction industry.
Despite its contributions, this study has certain limitations. The sample size of 112 survey respondents might be considered relatively small. Thus, future scholars can replicate this study with a larger sample size. Also, the findings are specific to the local context of the case study. Therefore, caution should be exercised when applying these results to other countries or regions. Additionally, future research could expand upon this study by employing more advanced statistical techniques, such as structural equation modeling, to explore causal relationships among the identified PIs. Additionally, the application of machine learning techniques could contribute to external validation and bolster the robustness assessment of the current study. Moreover, this study uses FSE as one of its data analysis methods. FSE is known for its simplicity and ease of interpretation. In assessing EMP implementation in water supply construction projects, where stakeholders may include industry professionals with diverse backgrounds, a straightforward and easily understandable method can be more effective. FSE clearly indicates the criticality of performance indicators without the need for the complex probabilistic reasoning inherent in Bayesian networks. Also, FSE is particularly useful when dealing with imprecise or uncertain data. Data may not always be precise or quantifiable in construction projects, and FSE allows for a flexible and adaptive approach to handling such uncertainties. Bayesian networks, while powerful in handling probabilistic relationships, might require a more precise dataset and may be less accommodating to vagueness in the data. Thus, future studies could explore the use of Bayesian networks to model the complex interdependencies among performance indicators, providing a more nuanced understanding of how these indicators influence each other in the context of EMP implementation. Nevertheless, this study’s findings still provide significant knowledge about the PIs that can assess EMP implementation in water supply construction projects.

Author Contributions

Conceptualization, A.M.F., M.F., M.E. and R.A.R.; methodology, A.R.R., A.M.F., M.F., M.E. and R.A.R.; validation, R.A.R.; formal analysis, A.R.R.; resources, A.M.F., M.F., M.E. and R.A.R.; data curation, A.M.F., M.F. and M.E.; writing—original draft preparation, A.R.R.; writing—review and editing, A.M.F., N.S.R., M.F., M.E. and R.A.R.; visualization, A.R.R.; supervision, N.S.R., M.F., M.E. and R.A.R.; project administration, M.F. and R.A.R.; funding acquisition: M.F. All authors have read and agreed to the published version of the manuscript.

Funding

This study is supported and funded by the Deanship of Scientific Research at Imam Mohammad Ibn Saud Islamic University (IMSIU), grant number IMSIU-RG23107.

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

The data presented in this study are available upon request from the corresponding authors. The data are not publicly available due to some data being proprietary or confidential in nature. Therefore, data may only be provided with restrictions.

Conflicts of Interest

The authors declare no conflicts of interest.

References

  1. Worldbank. 2012. Available online: https://www.worldbank.org/content/dam/Worldbank/document/Kyrgyzstan-EMF-health-project.pdf (accessed on 19 September 2023).
  2. Maund, K.; Gajendran, T.; Brewer, G. Key issues for implementation of environmental planning policy: Construction management practice. Sustainability 2018, 10, 2156. [Google Scholar] [CrossRef]
  3. Udawatta, N.; Zuo, J.; Chiveralls, K.; Zillante, G. Attitudinal and behavioural approaches to improving waste management on construction projects in Australia: Benefits and limitations. Int. J. Constr. Manag. 2015, 15, 137–147. [Google Scholar] [CrossRef]
  4. Ofori, G. The environment: The fourth construction project objective? Constr. Manag. Econ. 1992, 10, 369–395. [Google Scholar] [CrossRef]
  5. United Nations Environment Programme. 2021 Global Status Report for Buildings and Construction: Towards a Zero-Emission, Efficient and Resilient Buildings and Construction Sector; UN: New York, NY, USA, 2021. [Google Scholar]
  6. Esin, T.; Cosgun, N. A study conducted to reduce construction waste generation in Turkey. Build. Environ. 2007, 42, 1667–1674. [Google Scholar] [CrossRef]
  7. Xing, J.; Ye, K.; Zuo, J.; Jiang, W. Control dust pollution on construction sites: What governments do in China? Sustainability 2018, 10, 2945. [Google Scholar] [CrossRef]
  8. Wieser, A.A.; Scherz, M.; Passer, A.; Kreiner, H. Challenges of a healthy built environment: Air pollution in construction industry. Sustainability 2021, 13, 10469. [Google Scholar] [CrossRef]
  9. Marzouk, M.; Abdelkader, E.M.; El-zayat, M.; Aboushady, A. Assessing environmental impact indicators in road construction projects in developing countries. Sustainability 2017, 9, 843. [Google Scholar] [CrossRef]
  10. Cheriyan, D.; Khamraev, K.; Choi, J.H. Varying health risks of respirable and fine particles from construction works. Sustain. Cities Soc. 2021, 72, 103016. [Google Scholar] [CrossRef]
  11. Li, X.; Zhu, Y.; Zhang, Z. An LCA-based environmental impact assessment model for construction processes. Build. Environ. 2010, 45, 766–775. [Google Scholar] [CrossRef]
  12. Yan, H.; Ding, G.; Li, H.; Wang, Y.; Zhang, L.; Shen, Q.; Feng, K. Field evaluation of the dust impacts from construc-tion sites on surrounding areas: A city case study in China. Sustainability 2019, 11, 1906. [Google Scholar] [CrossRef]
  13. Yuan, H. Barriers and countermeasures for managing construction and demolition waste: A case of Shenzhen in China. J. Clean. Prod. 2017, 157, 84–93. [Google Scholar] [CrossRef]
  14. Nielsen, K.J. A comparison of inspection practices within the construction industry between the Danish and Swedish Work Environment Authorities. Constr. Manag. Econ. 2017, 35, 154–169. [Google Scholar] [CrossRef]
  15. Tam, V.W.; Tam, C.M.; Shen, L.Y.; Zeng, S.X.; Ho, C.M. Environmental performance assessment: Perceptions of project managers on the relationship between operational and environmental performance indicators. Constr. Manag. Econ. 2006, 24, 287–299. [Google Scholar] [CrossRef]
  16. Dahalan, N.H.; Rahman, R.A.; Ahmad, S.W.; Che Ibrahim, C.K.I. Public monitoring of environmental management plan implementation in road construction projects: Key performance indicators. J. Eng. Des. Technol. 2023. ahead-of-print. [Google Scholar] [CrossRef]
  17. Dahalan, N.H.; Rahman, R.A.; Hassan, S.H.; Ahmad, S.W. Performance indicators for public evaluation of environmental management plan implementation in highway construction projects. Int. J. Disaster Resil. Built Environ. 2023. ahead-of-print. [Google Scholar] [CrossRef]
  18. Cleary, J.P.; Lamanna, A.J. Correlation of Construction Performance Indicators and Project Success in a Portfolio of Building Projects. Buildings 2022, 12, 957. [Google Scholar] [CrossRef]
  19. Shaawat, M.E.; Alqahtani, S.M.S.; Qasem, A.; Jamil, R.; Almohassen, A.S.; Bongwirnso, U.M. A Performance Quality Index to Assess Professional Conduct of Contractors at Sustainable Construction Projects in Saudi Arabia. Sustainability 2023, 15, 7500. [Google Scholar] [CrossRef]
  20. Rajabi, S.; El-Sayegh, S.; Romdhane, L. Identification and assessment of sustainability performance indicators for construction projects. Environ. Sustain. Indic. 2022, 15, 100193. [Google Scholar] [CrossRef]
  21. Smeets, E.; Weterings, R. Environmental Indicators: Typology and Overview; European Environment Agency: Copenhagen, Denmark, 1999. [Google Scholar]
  22. Keeble, J.J.; Topiol, S.; Berkeley, S. Using indicators to measure sustainability performance at a corporate and pro-ject level. J. Bus. Ethics 2003, 44, 149–158. [Google Scholar] [CrossRef]
  23. Agyekum, K.; Botchway, S.Y.; Adinyira, E.; Opoku, A. Environmental performance indicators for assessing sus-tainability of projects in the Ghanaian construction industry. Smart Sustain. Built Environ. 2022, 11, 918–950. [Google Scholar] [CrossRef]
  24. Alsulamy, S. Investigating critical failure drivers of construction project at planning stage in Saudi Arabia. Front. Eng. Built Environ. 2022, 2, 154–166. [Google Scholar] [CrossRef]
  25. Abdulmoneim, A.M.; Samadony, A.A.; Nosair, I. Identification and ranking the most significant risks of the mega construction projects in Saudi Arabia. Saudi J. Civ. Eng. 2021, 5, 35–49. [Google Scholar]
  26. Moshashai, D.; Leber, A.M.; Savage, J.D. Saudi Arabia plans for its economic future: Vision 2030, the National Transformation Plan and Saudi fiscal reform. Br. J. Middle East. Stud. 2020, 47, 381–401. [Google Scholar] [CrossRef]
  27. Alsolami, B.M. Identifying and assessing critical success factors of value management implementation in Saudi Arabia building construc-tion industry. Ain Shams Eng. J. 2022, 13, 101804. [Google Scholar] [CrossRef]
  28. Hassanain, M.A.; Al-Harogi, M.; Sanni-Anibire, M.O. Design for safety in the construction industry: A study of architecture and engineering firms in Saudi Arabia. Facilities 2022, 40, 895–911. [Google Scholar] [CrossRef]
  29. Ameyaw, E.E.; Chan, A.P. A fuzzy approach for the allocation of risks in public–private partnership water-infrastructure projects in developing countries. J. Infrastruct. Syst. 2016, 22, 04016016. [Google Scholar] [CrossRef]
  30. Dithebe, K.; Aigbavboa, C.O.; Thwala, W.D.; Oke, A.E. Factor analysis of critical success factors for water infra-structure projects delivered under public–private partnerships. J. Financ. Manag. Prop. Construc.-Tion. 2019, 24, 338–357. [Google Scholar] [CrossRef]
  31. Aiyetan, A.O.; Das, D.K. Evaluation of the factors and strategies for water infrastructure project delivery in South Africa. Infrastructures 2021, 6, 65. [Google Scholar] [CrossRef]
  32. Krosnick, J.A. Questionnaire design. In The Palgrave Handbook of Survey Research; Palgrave Macmillan: Cham, Switzerland, 2018; pp. 439–455. [Google Scholar]
  33. Shirowzhan, S.; Sepasgozar, S.M.; Edwards, D.J.; Li, H.; Wang, C. BIM compatibility and its differentiation with interoperability challenges as an innovation factor. Autom. Constr. 2020, 112, 103086. [Google Scholar] [CrossRef]
  34. Osobajo, O.A.; Oke, A.; Omotayo, T.; Obi, L.I. A systematic review of circular economy research in the construction industry. Smart Sustain. Built Environ. 2022, 11, 39–64. [Google Scholar] [CrossRef]
  35. Munianday, P.; Radzi, A.R.; Esa, M.; Rahman, R.A. Optimal strategies for improving organizational BIM capabilities: PLS-SEM approach. J. Manag. Eng. 2022, 38, 04022015. [Google Scholar] [CrossRef]
  36. Radzi, A.R.; Rahman, R.A.; Doh, S.I.; Esa, M. Construction readiness for highway projects: Key decision criteria. J. Constr. Eng. Manag. 2022, 148, 04021196. [Google Scholar] [CrossRef]
  37. Rani, H.A.; Farouk, A.M.; Anandh, K.S.; Almutairi, S.; Rahman, R.A. Impact of COVID-19 on construction pro-jects: The case of India. Buildings 2022, 12, 762. [Google Scholar] [CrossRef]
  38. Farouk, A.M.; Zulhisham, A.Z.; Lee, Y.S.; Rajabi, M.S.; Rahman, R.A. Factors, challenges and strategies of trust in BIM-Based construction projects: A case study in Malaysia. Infrastructures 2023, 8, 13. [Google Scholar] [CrossRef]
  39. Kerr, C.; Nixon, A.; Wild, D. Assessing and demonstrating data saturation in qualitative inquiry supporting patient-reported outcomes research. Expert Rev. Pharmacoecon. Outcomes Res. 2010, 10, 269–281. [Google Scholar] [CrossRef] [PubMed]
  40. Seale, C. Grounding theory. In The Quality of Qualitative Research; Seale, C., Ed.; SAGE Publications: London, UK, 1999; pp. 87–105. [Google Scholar]
  41. Moustakas, C. Phenomenological Research Methods; Sage Publications: New York, NY, USA, 1994. [Google Scholar]
  42. Chan, D.W.; Choi, T.N. Critical analysis of the application of the safe working cycle (SWC) interview findings from Hong Kong. J. Facil. Manag. 2015, 13, 244–265. [Google Scholar] [CrossRef]
  43. Oraee, M.; Hosseini, M.R.; Edwards, D.; Papadonikolaki, E. Collaboration in BIM-based construction networks: A qualitative model of influential factors. Eng. Constr. Archit. Manag. 2022, 29, 1194–1217. [Google Scholar] [CrossRef]
  44. Braun, V.; Clarke, V. Using thematic analysis in psychology. Qual. Res. Psychol. 2006, 3, 77–101. [Google Scholar] [CrossRef]
  45. Kaufman, M.M.; Wigston, D.L.; Perlman, E.B. Environmental evaluation of subdivision site developments. Environ. Manag. 2002, 29, 801–812. [Google Scholar] [CrossRef]
  46. Niemeijer, D.; de Groot, R.S. A conceptual framework for selecting environmental indicator sets. Ecol. Indic. 2008, 8, 14–25. [Google Scholar] [CrossRef]
  47. Dangi, M.B.; Chaudhary, R.P.; Rijal, K.; Stahl, P.D.; Belbase, S.; Gerow, K.G.; Fernandez, D.; Pyakurel, B. Impacts of environmental change on agroecosystems and livelihoods in Annapurna Conservation Area, Nepal. Environ. Dev. 2018, 25, 59–72. [Google Scholar] [CrossRef]
  48. Gilchrist, A.; Allouche, E.N. Quantification of social costs associated with construction projects: State-of-the-art review. Tunn. Undergr. Space Technol. 2005, 20, 89–104. [Google Scholar] [CrossRef]
  49. Ramani, T.; Zietsman, J.; Eisele, W.; Rosa, D.; Spillane, D.; Bochner, B. Developing Sustainable Transportation Performance Measures for TXDOT’s Strategic Plan: Technical Report (No. FHWA/TX-09/0–5541-1); TX Transportation Institute: San Antonio, TX, USA, 2009. [Google Scholar]
  50. Anderson, J.L.; Muench, S.T. Sustainability trends measured by the greenroads rating system. Transp. Res. Rec. 2013, 2357, 24–32. [Google Scholar] [CrossRef]
  51. Fernandez-Sanchez, G.; Rodríguez-Lopez, F. A methodology to identify sustainability indicators in construction project management—Application to infrastructure projects in Spain. Ecol. Indic. 2010, 10, 1193–1201. [Google Scholar] [CrossRef]
  52. Gallego, I. The use of economic, social and environmental indicators as a measure of sustainable development in Spain. Corp. Soc. Responsib. Environ. Manag. 2006, 13, 78–97. [Google Scholar] [CrossRef]
  53. Park, J.W.; Ahn, Y.H. Development of a green road rating system for South Korea. Int. J. Sustain. Build. Technol. Urban Dev. 2015, 6, 249–263. [Google Scholar] [CrossRef]
  54. Shen, L.; Lu, W.; Peng, Y.; Jiang, S. Critical assessment indicators for measuring benefits of rural infrastructure investment in China. J. Infrastruct. Syst. 2011, 17, 176–183. [Google Scholar] [CrossRef]
  55. Chang, A.S.; Tsai, C.Y. Sustainable design indicators: Roadway project as an example. Ecol. Indic. 2015, 53, 137–143. [Google Scholar] [CrossRef]
  56. Umer, A.; Hewage, K.; Haider, H.; Sadiq, R. Sustainability assessment of roadway projects under uncertainty using Green Proforma: An index-based approach. Int. J. Sustain. Built Environ. 2016, 5, 604–619. [Google Scholar] [CrossRef]
  57. Wang, Z.; He, X.; Zhang, C.; Xu, J.; Wang, Y. Evaluation of geological and ecological bearing capacity and spatial pattern along du-wen road based on the analytic hierarchy process (AHP) and the technique for order of preference by similarity to an ideal solution (TOPSIS) method. ISPRS Int. J. Geo-Inf. 2020, 9, 237. [Google Scholar] [CrossRef]
  58. Yang, H.Z.; Wang, Z.F.; Dai, Q.M.; Feng, Z. Ecological impact assessment method of highways in Tibetan Plateau: A case study of Gonghe-Yushu Expressway. J. Mt. Sci. 2020, 17, 1916–1930. [Google Scholar] [CrossRef]
  59. Sun, C.; Xu, S.; Qi, W.; Chen, C.; Deng, Y.; Pei, N.; König, H.J. Biodiversity constraint indicator establishment and its optimization for urban growth: Framework and application. Environ. Res. Lett. 2019, 14, 125006. [Google Scholar] [CrossRef]
  60. Bell, S.; Morse, S. Sustainability Indicators: Measuring the Immeasurable? Routledge: London, UK, 2012. [Google Scholar]
  61. Goedkoop, M.; Spriensma, R. The Eco-Indicator 95; PRé Consultants: Amersfoort, The Netherlands, 1995; p. 85. [Google Scholar]
  62. Mihyeon Jeon, C.; Amekudzi, A. Addressing sustainability in transportation systems: Definitions, indicators, and metrics. J. Infrastruct. Syst. 2005, 11, 31–50. [Google Scholar] [CrossRef]
  63. Burns, J.; Cutshall, C.; Harper-Lore, B.; Knowles, C.; Lucas, D.W.; Peda, R.; Ryan, M.M.; Sanderson, L.; Walters, R.L.; White, T.; et al. Environmental Stewardship Practices, Procedures, and Policies for Highway Construction and Maintenance; American Association of State Highway and Transportation Officials (AASHTO) Standing Committee on the Environment; 2004. Available online: https://trid.trb.org/view/745847 (accessed on 19 September 2023).
  64. Rajabi, M.S.; Radzi, A.R.; Rezaeiashtiani, M.; Famili, A.; Rashidi, M.E.; Rahman, R.A. Key Assessment Criteria for Organizational BIM Capabilities: A Cross-Regional Study. Buildings 2022, 12, 1013. [Google Scholar] [CrossRef]
  65. Zamani, S.H.; Rahman, R.A.; Fauzi, M.A.; Mohamed Yusof, L. Government pandemic response strategies for AEC enterprises: Lessons from COVID-19. J. Eng. Des. Technol. 2022. ahead of print. [Google Scholar] [CrossRef]
  66. Cooper, D.R.; dan Schindler, P.S. Business Research Methods, 8th ed.; Mc-Graw Hill: New York, NY, USA, 2003. [Google Scholar]
  67. Fellow, R.; Liu, A. Research Methods for Construction, 2nd ed.; Blackwell: Oxford, UK, 2003. [Google Scholar]
  68. Cresswell, J.W.; Plano Clark, V.L. Designing and Conducting Mixed Method Research, 22nd ed.; Sage: Thousand Oaks, CA, USA, 2011. [Google Scholar]
  69. Bernard, H.R. Research Methods in Anthropology: Qualitative and Quantitative Approaches, 3rd ed.; Alta Mira Press: Walnut Creek, CA, USA, 2002. [Google Scholar]
  70. Staplehurst, J.; Ragsdell, G. Knowledge sharing in SMEs: A comparison of two case study organisations. J. Knowl. Manag. Pract. 2010, 11, 1–16. [Google Scholar]
  71. Chan, A.P.; Lam, P.T.; Wen, Y.; Ameyaw, E.E.; Wang, S.; Ke, Y. Cross-sectional analysis of critical risk factors for PPP water projects in China. J. Infrastruct. Syst. 2015, 21, 04014031. [Google Scholar] [CrossRef]
  72. Norusis, M. SPSS 16.0 Advanced Statistical Procedures Companion; Prentice Hall Press: Hoboken, NI, USA, 2008. [Google Scholar]
  73. Gorsuch, R.L. Factor Analysis; Erlbaum: Hillsdale, NJ, USA, 1983. [Google Scholar]
  74. Field, A. Correlation: Bivariate Correlation. Field: A Discovering Statistics Using SPSS; British Library: London, UK, 2009; pp. 175–179. [Google Scholar]
  75. Pallant, J. SPSS Survival Manual: A Step by Step Guide to Data Analysis Using IBM SPSS; McGraw-Hill Education: London, UK, 2020. [Google Scholar]
  76. Osborne, J.W. What is rotating in exploratory factor analysis? Pract. Assess. Res. Eval. 2019, 20, 2. [Google Scholar]
  77. Farouk, A.M.; Omer, M.M.; Rahman, R.; Romali, N.S. Effective approaches to water distribution network rehabilitation: Fuzzy synthetic evaluation. In AIP Conference Proceedings; AIP Publishing: Melville, NY, USA, 2023; Volume 2688. [Google Scholar]
  78. Algahtany, M.; Radzi, A.R.; Al-Mohammad, M.S.; Rahman, R.A. Government Initiatives for Enhancing Building Information Modeling Adoption in Saudi Arabia. Buildings 2023, 13, 2130. [Google Scholar] [CrossRef]
  79. Churchill, G.A., Jr. A paradigm for developing better measures of marketing constructs. J. Mark. Res. 1979, 16, 64–73. [Google Scholar] [CrossRef]
  80. Harbor, J. Engineering geomorphology at the cutting edge of land disturbance: Erosion and sediment control on construction sites. Geomorphology 1999, 31, 247–263. [Google Scholar] [CrossRef]
  81. Gamage, S.D.; Ambrose, M.; Kralovic, S.M.; Roselle, G.A. Water safety and Legionella in health care: Priorities, policy, and practice. Infect. Dis. Clin. 2016, 30, 689–712. [Google Scholar] [CrossRef]
  82. Bai, M.; Du, Y.; Chen, Y.; Xing, Y.; Zhao, P. Risk assessment of long gas and oil pipeline projects inducing landslide disasters during construction. J. Perform. Constr. Facil. 2017, 31, 04017063. [Google Scholar] [CrossRef]
  83. Manu, P.; Ankrah, N.; Proverbs, D.; Suresh, S. The health and safety impact of construction project features. Eng. Constr. Archit. Manag. 2014, 21, 65–93. [Google Scholar] [CrossRef]

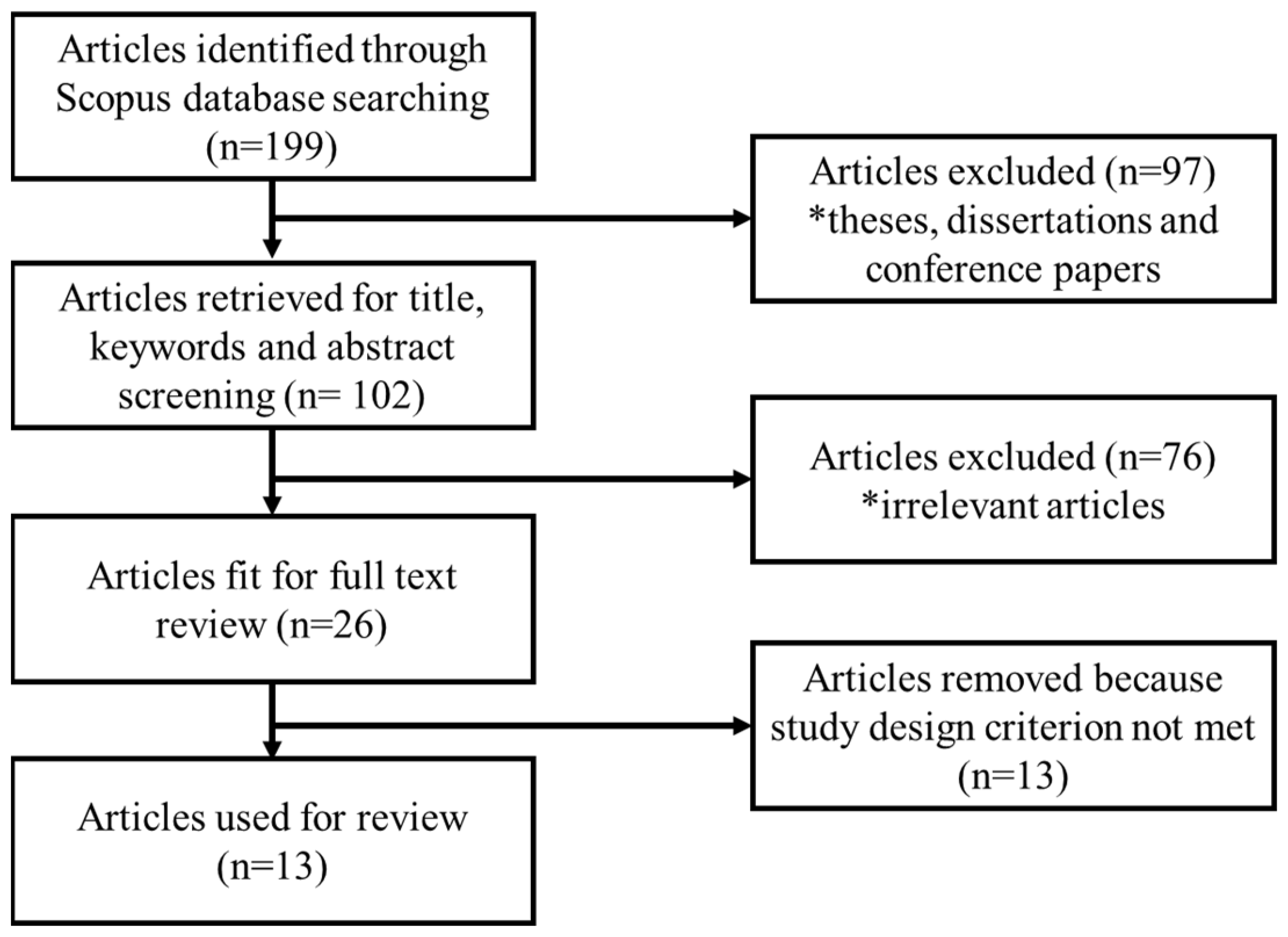

Figure 1. SLR process.
Figure 1. SLR process.
Sustainability 16 00600 g001
Table 1. PIs for assessing EMP implementation.
Table 1. PIs for assessing EMP implementation.
CodePIsSources
PI01Soil erosionInterview, [45,46]
PI02Traffic accidents on the construction siteInterview, [47,48,49]
PI03The smells of run-off waterInterview, [46,50]
PI04Appearance of dustInterview, [51]
PI05Spills of chemical substances[52]
PI06Construction waste[15,46,53,54]
PI07Clogged drainage[45]
PI08Overflowing silt trap[Interview]
PI09Oil/fuel spillsInterview, [52]
PI10Traffic accidents among public users[Interview]
PI11Visibility drops Interview, [51]
PI12Changes in the color of bodies of water[Interview]
PI13Excessive cut and fillInterview, [55]
PI14Traffic emission gas[51,52,56]
PI15Vegetation depletion[45,53,55,57,58]
PI16Wildlife appearance at construction sites[46,50,51,53,55,56,59,60]
PI17Unpleasant air odors[46,51,52,60,61,62]
PI18Changes in the color of run-off water[Interview]
PI19Landslide occurrenceInterview, [47]
PI20Light pollution (during nighttime)[46,50]
PI21Restricted site accessibility[51]
PI22The smell of nearby bodies of water[Interview]
PI23Slope failuresInterview, [45,55,57,58]
PI24Depletion of agricultural land [47]
PI25Excessive noise [Interview]
PI26Irregular flooding [Interview]
PI27Destruction of animal habitats [46,50,51,55,56,60]
PI28Public safety [45]
PI29Deforestation [47,55]
PI30Changes in the color of silt trapsInterview
PI31Open burningInterview
PI32Alteration of topography[58]
PI33Spread of disease[63]
PI34Vibration occurrencesInterview
PI35Traffic congestionInterview
PI36Social disturbance[54]
PI37Increased schedule waste[15,46,53,54]
PI38Road safety hazardInterview
PI39Proliferation of pest[63]
Table 2. Respondent profile.
Table 2. Respondent profile.
CharacteristicsCategoriesFrequencyPercent (%)
Years of experience in water supply construction projectsFresh graduate1715.2
Less than 3 years of experience1210.7
3 to 10 years1715.2
10 to 15 years1715.2
More than 15 years of experience4943.8
Number of water supply construction projects involved inOnly one project3127.7
2 to 5 projects2320.5
6 to 10 projects1412.5
11 to 20 projects1715.2
More than 20 projects2724.1
Table 3. Results of mean ranking analysis and normalization method.
Table 3. Results of mean ranking analysis and normalization method.
CodeMeanStandard DeviationNormalized Value
PI284.2141.0431.000 *
PI384.0980.9100.929 *
PI43.9550.8740.842 *
PI73.8391.2050.772 *
PI263.8131.0610.755 *
PI63.7951.4280.745 *
PI253.7591.0420.723 *
PI13.7321.1470.707 *
PI193.6961.1300.685 *
PI373.6610.9820.663 *
PI123.6521.2130.658 *
PI93.6341.4640.647 *
PI213.5711.1450.609 *
PI133.5451.0300.592 *
PI23.5001.2080.565 *
PI333.4821.2590.554 *
PI183.4551.2220.538 *
PI83.4291.0630.522 *
PI363.3750.9780.489
PI103.3131.1860.451
PI33.3041.1770.446
PI243.2861.1960.435
PI223.2051.1640.386
PI53.1611.0700.359
PI353.1521.1170.353
PI323.1161.1840.332
PI343.1071.1260.326
PI113.0890.9540.315
PI233.0711.0290.304
PI203.0361.1540.283
PI163.0271.0690.277
PI173.0091.1430.266
PI142.9641.0390.239
PI302.9551.1810.234
PI312.8661.2840.179
PI152.7681.2080.120
PI272.6881.4460.071
PI392.5711.2990.000
Note: * = critical PIs.
Table 4. Results of EFA.
Table 4. Results of EFA.
ConstructsPIsCodeFactor LoadingsVariance ExplainedCronbach Alpha
Fluid-related indicatorsChanges in the color of bodies of waterPI120.84328.5610.891
Spills of chemical substancesPI60.774
Changes in the color of run-off waterPI180.758
Overflowed silt trapPI80.702
Clogged drainagePI70.682
Oil/fuel spillsPI90.681
Soil erosionPI10.621
Health and safety-related indicatorsPublic safetyPI280.77117.1180.713
Traffic accidents on construction sitesPI20.691
Spread of diseasePI330.671
Landslide occurrencePI190.583
Site environment-related indicatorsRestricted site accessibilityPI210.78514.7350.691
Road safety hazardPI380.731
Irregular floodingPI260.713
Table 5. Description of performance indicator input variables.
Table 5. Description of performance indicator input variables.
CodeMISDNVCIORCRTMCW
FL--- u f l --25.540.492
PI73.841.200.52 u f l 1 31--
PI63.801.430.47 u f l 2 52--
PI13.731.150.39 u f l 3 63--
PI123.651.210.28 u f l 4 84--
PI93.631.460.26 u f l 5 95--
PI183.461.220.03 u f l 6 136--
PI83.431.060.00 u f l 7 147
HS--- u h s --14.890.287
PI284.211.041.00 u h s 1 11--
PI193.701.130.34 u h s 2 72--
PI23.501.210.09 u h s 3 113--
PI333.481.260.07 u h s 4 124--
SE--- u s e --11.480.221
PI384.100.910.85 u s e 2 21--
PI263.811.060.49 u s e 2 42--
PI213.571.140.18 u s e 2 103--
Total51.911.000
Note: MI = mean index SD = standard deviation; NV = normalized value = (mean e minimum mean)/(maximum mean x minimum mean); CI = codes for index system; OR = overall rank; CR = construct rank; TM = total mean; and CW = construct weighting.
Table 6. Results from the fuzzy synthetic evaluation.
Table 6. Results from the fuzzy synthetic evaluation.
CodeLevelMIWeightingsMF Value
Overall1--0.07, 0.09, 0.19, 0.34, 0.31
FL2-0.4920.09, 0.11, 0.18, 0.31, 0.31
PI733.840.1500.04, 0.13, 0.14, 0.29, 0.38
PI633.800.1490.13, 0.09, 0.12, 0.21, 0.46
PI133.730.1460.05, 0.11, 0.18, 0.38, 0.29
PI1233.650.1430.08, 0.10, 0.19, 0.36, 0.28
PI933.630.1420.15, 0.08, 0.16, 0.20, 0.41
PI1833.460.1350.10, 0.13, 0.17, 0.41, 0.19
PI833.430.1340.04, 0.14, 0.31, 0.34, 0.16
HS2-0.2870.07, 0.07, 0.21, 0.31, 0.33
PI2834.210.2830.04, 0.05, 0.08, 0.32, 0.51
PI1933.700.2480.06, 0.07, 0.24, 0.36, 0.27
PI233.500.2350.10, 0.08, 0.27, 0.33, 0.22
PI3333.480.2340.10, 0.10, 0.29, 0.24, 0.27
SE2-0.2210.04, 0.07, 0.17, 0.43, 0.29
PI3834.100.3570.02, 0.04, 0.15, 0.42, 0.38
PI2633.810.3320.04, 0.08, 0.16, 0.45, 0.27
PI2133.570.3110.07, 0.11, 0.21, 0.41, 0.21
Table 7. Effectiveness index of the constructs.
Table 7. Effectiveness index of the constructs.
No.ConstructConstruct CodeWeighting
1Fluid-related indicatorsFL3.65
2Health and safety-related indicatorsHS3.75
3Site environment-related indicatorsSE3.84
Table 8. Comparison with prior works.
Table 8. Comparison with prior works.
Performance IndicatorsRoad Projects 1Highway Projects 2Water Supply Projects (This Study)
Public safety
Road safety hazards-
Construction waste
Clogged drainage
Irregular flood
Spills of chemical substances
Slope failures
Soil erosion
Landslide occurrence
Increased schedule waste-
Changes in the color of bodies of water
Oil/fuel spills
Restricted site accessibility--
The smell of run-off water--
Traffic accidents on construction site-
Spread of disease--
Changes in the color of run-off water
Overflowed silt trap
Note: 1 = [16] 2 = [17].
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Radzi, A.R.; Farouk, A.M.; Romali, N.S.; Farouk, M.; Elgamal, M.; Rahman, R.A. Assessing Environmental Management Plan Implementation in Water Supply Construction Projects: Key Performance Indicators. Sustainability 2024, 16, 600. https://doi.org/10.3390/su16020600

AMA Style

Radzi AR, Farouk AM, Romali NS, Farouk M, Elgamal M, Rahman RA. Assessing Environmental Management Plan Implementation in Water Supply Construction Projects: Key Performance Indicators. Sustainability. 2024; 16(2):600. https://doi.org/10.3390/su16020600

Chicago/Turabian Style

Radzi, Afiqah R., Abdelrahman M. Farouk, Noor Suraya Romali, Mohamed Farouk, Mohamed Elgamal, and Rahimi A. Rahman. 2024. "Assessing Environmental Management Plan Implementation in Water Supply Construction Projects: Key Performance Indicators" Sustainability 16, no. 2: 600. https://doi.org/10.3390/su16020600

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
