Article

A Causal Network-Based Risk Matrix Model Applicable to Shield TBM Tunneling Projects

1
Technology Research Team, Incheon International Airport Corporation, Incheon 22382, Korea
2
Advanced Infrastructure Research Team, Korea Railroad Research Institute, Uiwang 16105, Korea
3
School of Civil, Environmental and Architectural Engineering, Korea University, Seoul 02841, Korea
*
Author to whom correspondence should be addressed.
Sustainability 2021, 13(9), 4846; https://doi.org/10.3390/su13094846
Submission received: 22 February 2021 / Revised: 9 April 2021 / Accepted: 9 April 2021 / Published: 26 April 2021
(This article belongs to the Special Issue Geotechnical Engineering towards Sustainability)

Abstract

:
The present study compares and analyzes three risk analysis models that are applicable to shield tunnel boring machine (TBM) tunneling, and thus proposes an improved risk matrix model based on the causal networks applicable to sustainable tunnel projects. The advantages and disadvantages of three risk analysis models are compared, and causal networks are structured by analyzing the causal relationship between risk factors and risk events. Based on the comparison and analysis results, the causal network-based risk matrix model (CN-Matrix model), which complements the disadvantages and exploits the advantages of the three existing models, is proposed in this paper. Furthermore, this study suggests a means of modifying the weighting scores in the estimation of the risk score, which permits the CN-Matrix model to determine the risk level more reasonably. Thus, the improved CN-Matrix model is more reliable and robust compared to the three existing models.

1. Introduction

Recently, the demands for new underground infrastructures have increased [1]. Risk management has increasingly become important for a number of projects in various industries including the construction of infrastructures [2,3,4]. In the case of tunnel constructions, as the geotechnical investigation at the design stage covers a large area, uncertainty always exists in the investigation results. Therefore, unexpected geological conditions can be encountered during tunneling. Unless proper countermeasures are adopted for risky ground conditions, construction cost and time may increase significantly, and lives may be lost because of tunnel collapses. Therefore, a systematic method of risk analysis, applicable at both the design and construction stages, is indispensable for ensuring safety and economic sustainability in tunnel projects.
The Land Transport Authority (2012, 2018) of Singapore specifies the standards and regulations for risk management that contractors are required to apply from the bidding stage of tunnel projects; the contractors are also compelled to manage risks at all stages of projects [5,6]. WSP | Parsons Brinckerhoff (2016) developed a risk analysis tool through the National Cooperative Highway Research Program (NCHRP) and carried out risk analyses in many construction projects [7]. However, this tool only explains the requirements and suggestions for general risk analysis and management, so it does not systematically provide risk analysis methods that are applicable to actual shield tunnel boring machine (TBM) tunneling projects.
In South Korea, the Design for Safety (DFS) has been legalized in the safety management performance guideline of the Ministry of Land, Infrastructure, and Transport (2017), which requires that a risk analysis should be performed for every construction project [8]. Furthermore, the Korea Expressway Corporation Research Institute (2017) developed an internal guide for a tunnel risk management system, which was applied to tunnel projects in charge of the Korea Expressway Corporation [9].
The present study proposes an improved matrix model, which is the causal network-based risk matrix model (CN-Matrix model), applicable to actual shield TBM tunneling projects. To verify the capacity of the proposed CN-Matrix model, the existing three risk analysis models that are applicable to actual shield TBM tunneling projects were analyzed, and their advantages and disadvantages were compared. In addition, the potential risk events that may occur during shield TBM tunnel construction, and their causal risk factors were identified. Then, causal networks were structured by analyzing the causal relationship between risk factors and risk events. Furthermore, this study suggests a way to modify the weighting scores for two categories of the risk matrix, so that the CN-Matrix model can determine the risk level with a high degree of reliability.

2. Tunnel Risk Analysis Models

Among various risk analysis models applied to a variety of fields, five models are widely adopted in tunneling projects. These risk analysis models use various analysis tools, and some of them are specialized for tunnel projects. Each of these risk analysis models is briefly described in this section.

2.1. Decision Aids for Tunneling

The decision aids for tunneling (DAT), developed by Einstein et al. (1999), enables the engineers to perform simulations considering the uncertainties in the geology and construction process for a given tunneling project and to simultaneously present the probability distributions of the tunnel construction cost and time [10]. To consider uncertain geological characteristics, various ground profiles are represented as probability distributions. Based on them, the probability distributions of the construction cost and time of the entire project can be obtained. Min et al. (2005) applied the DAT technique to predict and update the total construction cost and time of a road tunnel project [11].

2.2. Risk Evaluation Based on Event Tree Analysis

The event tree analysis (ETA) is an inductive system analysis technique that uses the initiating event (a defect in the system, process, construction, etc.) of an accident as the starting point and schematically expresses the expected consequences of the accident from the initiating event. The ETA is one of the system models that represent the system safety based on the safety of each event. An event tree is composed of the initiating event (the cause of the accident), potential sub-risk events, and final consequences of the event. The potential sub-risk events are mutually exclusive, and the consequences are dependent on the sub-risk events that occur due to the initiating event. Therefore, the probability of occurrence of a specific path can be calculated by multiplying the probabilities of all sub-risk events that exist on this path. Hong et al. (2009) utilized the ETA technique to carry out a risk analysis for an under-river shield TBM tunnel project crossing the Han River in part of Seoul subway construction [12].

2.3. Risk Analysis Based on Matrix Model

2.3.1. Risk Matrix Model

The risk matrix model, which is the most popular model in construction projects, has been proposed in various forms as a basic tool for qualitative risk analysis and assessment, as shown in Figure 1. The risk matrix is composed of two categories: the frequency of an event and its consequence. The risk level can then be determined by combining these two categories. The risk is usually divided into three to five levels; the matrix described in Figure 1 divides the risk into four levels as follows: Negligible, Acceptable, Unwanted, and Unacceptable. Figure 1 shows the risk matrix proposed by the International Tunnelling and Underground Space Association (ITA), named the ITA-Matrix model, and the classifications of frequency and consequence (or impact) are presented in Table 1 and Table 2, respectively.

2.3.2. Risk Matrix Model Using Fault Tree Analysis and Analytic Hierarchy Process

Hyun et al. (2015) proposed a risk matrix model using probability and impact as the frequency and consequence categories of risk events, respectively. In addition, to obtain a quantitative decision of these categories, they used the fault tree analysis (FTA) and the analytic hierarchy process (AHP) [14]. The risk matrix using the FTA and AHP, named the FTA-AHP Matrix model, is shown in Figure 2.
The FTA is a method for analyzing the causes of risks in a deductive method. A specific accident or a risk associated with a primary system, recognized from a qualitative assessment, is placed as the top event in the tree for deductive reasoning. It can clarify the theoretical relationship between top events and risk factors and quantitatively predict the occurrence of the top event based on the probability of each risk factor. Hence, the probability category can be quantitatively determined using the FTA. Liu et al. (2014) adopted the FTA-based method for the risk decision-making process in emergency response [15]. Zhou et al. (2019) used the FTA for evaluating the probabilities of potential severe results to select an optimal rescue plan [16].
The AHP is a decision-making process developed by Saaty (1980) [17]. The process can systematically prioritize various alternatives that can be selected by a decision-maker along with the effective application of the multi-criteria decision-making process, which involves attributes and measurement criteria of decision-making factors. Therefore, the AHP can be used to quantitatively determine the impact of risks. In other words, the impact of each risk can be determined by assigning a weighting factor to the risk. Hyun et al. (2015) applied the FTA-AHP Matrix model to a Seoul subway tunneling job site, in which a slurry shield TBM was adopted.

2.4. Risk Analysis Model Using Bayesian Network

The shield TBM risk analysis model using the Bayesian network (STRAM-BN) was proposed by Chung et al. (2019) [18]. This model is based on the causal relationships between potential risk events and the risk factors causing the events; it can identify major risk events that may occur during tunneling construction and assess the risk degrees of these potential risk events. To assess risk events quantitatively by reflecting the dependence on the causal relationships between risk factors and risk events, the STRAM-BN uses the Bayesian network, which presents the occurrences of causes and events as conditional probabilities. The schematic of the proposed STRAM-BN is shown in Figure 3. The STRAM-BN evaluates the risk degree by considering the nodes of the STRAM-BN such as the types of TBM, geological risk factors, risk events, countermeasures, direct cost, and indirect cost. Furthermore, the risk response phase of the STRAM-BN that corresponds to the risk level in the risk matrix model is presented in Table 3, which was determined based on the case histories collected from around the world. Chung et al. (2019) quantitatively assessed the degree of risk events by applying the STRAM-BN for a subsea tunnel project adopting an EPB shield TBM.

3. Development of Causal Network-based Risk Matrix Model

Among the above risk analysis models, the three risk analysis models (ITA-Matrix model, FTA-AHP Matrix model, and STRAM-BN) are compared to derive an improved risk matrix model based on the causal networks in this study.
The ITA-Matrix model in Figure 1 is a qualitative risk analysis model that represents the frequency and consequence categories of the matrix as qualitative classes and determines the risk degree by combining the frequency and consequence classes. Herein, the classification criteria of frequency and consequence rely on mainly the experiences of tunneling experts. Furthermore, the ITA-Matrix model is a general guideline for tunneling risk management but does not realize the detailed identification of risk factors and risk events that are relevant to shield TBM tunnels. In addition, this model cannot consider the causal relationship between the risk factors and risk events.
The FTA-AHP Matrix model shown in Figure 2 has the advantages of representing the probability and impact using quantitative classes ranging from 1 to 5 points along with the FTA and AHP, which can calculate the risk degree by multiplying the probability and impact scores, as expressed in Equation (1).
Risk degree = Probability score × Impact score,
Furthermore, it can systematically analyze potential risk events during shield TBM tunneling by examining the causal relationships between risk factors and risk events for shield TBM tunnels.
The STRAM-BN is a quantitative risk analysis model specialized for shield TBM tunnels and analyzes risks based on the causal relationship between a potential risk event and its causal risk factor during shield TBM tunnel excavation. This is similar to the manner in the FTA-AHP Matrix model. The STRAM-BN has the advantages of reflecting causal relationships using the conditional probabilities of potential risk events from the corresponding geological risk factor and TBM type, and further reflecting job site conditions, which considers the cost of the appropriate countermeasure.
The comparison of these three tunnel risk analysis models is summarized in Table 4, Table 5, Table 6 and Table 7 with respect to the following key items: frequency (probability), consequence (impact), risk degree, and risk level (risk response phase), respectively.
The concept of conditional probability is applied only in the STRAM-BN, not in the FTA-AHP Matrix model. Therefore, unlike the STRAM-BN, the FTA-AHP Matrix model has a limitation to calculate the probability of a risk event for each geological risk factor.
In the case of the STRAM-BN, the consequence and/or impact of a risk event is judged based on the cost that is needed to implement the suitable countermeasure when the event occurs. Unlike the STRAM-BN, the FTA-AHP Matrix model does not require the detailed countermeasure cost reflecting job site conditions because the impact is determined based on the relative downtimes caused by each risk event using the AHP. For this reason, the FTA-AHP Matrix model seems to be easier and more efficient.
The ITA-Matrix model qualitatively determines the risk degree by combining the five frequency classes and consequence classes. The FTA-AHP Matrix model determines the risk degree by Equation (1). The STRAM-BN determines the risk degree in terms of the conditional probability of risk events and the cost of countermeasures (direct and indirect costs considering the delay level) at each job site. Thus, the risk levels of the ITA-Matrix model, which is a qualitative analysis model, are represented by four levels (Negligible, Acceptable, Unwanted, Unacceptable), whereas in the case of the FTA-AHP Matrix model and the STRAM-BN, which quantitatively analyze risks, the risk degrees are represented by points of 1–25 (unit: scores) and by costs of 0–∞ (unit: ×103 US dollars), respectively. Herein, the upper and lower limits of the risk degree in the STRAM-BN do not exist because the cost of countermeasure implementation is limitless. The risk levels (risk response phases) are divided into four steps for both the risk matrix models and the STRAM-BN; however, the direct comparison of the risk degrees according to the risk level is challenging because the unit of the risk degree is different in each case.
In this paper, a causal network-based risk matrix model, the CN-Matrix model, applicable to actual shield TBM tunnels, is proposed by modifying the existing FTA-AHP Matrix model to complement its drawbacks. Like the FTA-AHP Matrix model, the risk degree in the CN-Matrix model is also calculated by Equation (1) and using the identical risk matrix and risk levels shown in Figure 2. As for the consequence (impact) in the CN-Matrix model, the AHP is adopted the same as the FTA-AHP Matrix model for better application in practice rather than the STRAM-BN. However, unlike the FTA-AHP Matrix model that uses the relative weight (impact) of downtimes of the top risk events, the CN-Matrix model adopts the impact of the sub-risk events. Therefore, the potential sub-risk events should be selected among all the 16 sub-risk events to apply the AHP for the designated job site. It can perform risk analyses based on sub-risk events rather than top risk events by evaluating the risk degree of the sub-risk events caused by each geological risk factor with consideration of conditional probability; hence, this model can be used to perform risk analyses in both the design and construction stages. The conditional probability is adopted in the CN-Matrix model, not in the FTA-AHP Matrix model. In the FTA-AHP Matrix model, the probability of a geological risk factor has the same effect on all sub-risks. However, in the CN-Matrix model, its probability depends on the specific sub-risk event. Causal networks between the potential geological risk factors and their corresponding risk events during shield TBM tunnel excavation are structured as shown in Figure 4. The geological risk factors and the risk events adopted in the CN-Matrix model are listed in Table 8 and Table 9, respectively.

4. Application of CN-Matrix Model

Risk analyses were performed on three tunneling job sites to compare the four risk analysis models mentioned above: the ITA-Matrix model; the FTA-AHP Matrix model; the STRAM-BN; and the newly proposed CN-Matrix model in this paper. First, to directly compare the job site application results from the four models, the potential risk events and their causal geological risk factors (summarized in Table 8 and Table 9), during construction of a shield TBM tunnel, were applied to the ITA-Matrix model and the FTA-AHP Matrix model. The relevance of top risk events (T1–T8) and sub-risk events (RE1-1–RE8) are presented in Table 9. The FTA-AHP Matrix model analyzes risks based on the top risk events, whereas the STRAM-BN and the CN-Matrix model analyze risks based on the sub-risk events. In the case of the ITA-Matrix model, which does not have criteria for the risk event to be analyzed, the risk was analyzed based on the top risk events when it is compared with the FTA-AHP Matrix model. On the other hand, when compared with the STRAM-BN and the CN-Matrix model, the risk was analyzed based on the sub-risk events. Furthermore, to use the FTA, the causal relationships between the risk factors and risk events in Figure 4 were restructured into a fault tree for eight top risk events (T1–T8), as shown in Figure 5. Second, the geological risk factors for each job site were identified, and the resulting potential risk events are presented. Then the risk degree was estimated by analyzing the corresponding risk events.
The risk analysis models were applied to two shield TBM under-river tunnel projects (Projects I and II) and one subsea tunnel project (Project III). A slurry shield TBM was utilized for tunneling in Project I, EPB shield TBMs were adopted for tunneling in Projects II and III, respectively. The overview of each project is provided in Table 10, and the longitudinal geological profiles are shown in Figure 6.

4.1. Modeling Conditions for Real Tunnel Projects

As for the FTA-AHP Matrix model, the probabilities of eight top risk events (T1–T8) were calculated using the restructured fault tree shown in Figure 5, and the impacts of the eight events were calculated using the AHP. The probability of each risk factor was determined for each job site via a questionnaire survey of TBM tunneling experts. In the survey, the probability of the expert’s surveys was considered as the central value in the probability range of the evaluated probability score after each expert evaluated the probability score from 1 to 5 points. For example, for a specific risk factor, the probability is determined to be 20% if the expert evaluates the probability score as 2. In addition, through a questionnaire survey of TBM tunneling experts, a pairwise comparison matrix was built; the impact of each event was calculated using this matrix. The probability and impact scores were determined according to the score ratings listed in Table 11. The calculation results of the risk degrees for the eight top risk events by applying the FTA-AHP Matrix model to each job site are listed in Table 12.
In the case of the ITA-Matrix model, the frequency and consequence classes were determined via a questionnaire survey from TBM tunneling experts using the frequency and consequence classifications presented in Table 1 and Table 2, respectively. The calculation results of the risk degrees of the ITA-Matrix model for the eight top risk events and the potential sub-risk events caused by the corresponding geological risk factors are listed in Table 12, Table 13, Table 14 and Table 15.
When it comes to the STRAM-BN, the conditional probabilities of the potential sub-risk events were determined from the identified geological risk factors, and the countermeasure for each risk event was selected by considering the conditions of each project and the TBM type. The cost of countermeasure was calculated by consulting with the cost estimation specialists in consideration of the direct and indirect cost for implementing the countermeasure for the 20 m section. The risk degrees for the potential sub-risk events of each job site are listed in Table 13, Table 14 and Table 15.
With respect to the CN-Matrix model, the probability of occurrence of potential sub-risk events caused by the corresponding geological risk factors was determined for each job site via a questionnaire survey of TBM tunneling experts. The survey item corresponding to the probability is related to the sub-risk events caused by the corresponding geological risk factors in the CN-Matrix model, but it is directly related to the geological risk factor in the FTA-AHP Matrix model. The impact of the potential sub-risk events for the downtime caused by each of these sub-risk events was calculated using the AHP. In the FTA-AHP Matrix model, the probability and impact scores were determined based on the score ratings listed in Table 11. The calculation results by applying the CN-Matrix model to each job site are listed in Table 13, Table 14 and Table 15.

4.2. Comparison of Risk Analysis Models

When the FTA-AHP Matrix model was applied, all three job sites showed high degrees of risk (more than III) in cuttability reduction, the collapse of the tunnel face, incapability of mucking, and incapability of excavation events. In Project II, the risk degree of the water leakage event was also high. The ITA-Matrix model indicated that the risk degrees of cuttability reduction, the collapse of the tunnel face, incapability of mucking, and incapability of excavation events were high for all three job sites, which is similar to the FTA-AHP Matrix model. In Projects II and III, the water leakage event was evaluated with a high-risk degree.
When the STRAM-BN was applied, the risk degree of collapse of the tunnel face was high owing to G2 (fractured zone or faults) and G7 (mixed ground conditions), which existed in all the job sites. In addition, the risk degrees of incapability of mucking (large quantity of groundwater/damage of pipe and pump) and incapability of excavation (insufficient torque and thrust force) were high owing to G9 (ground with high water pressure) for all three job sites because all three job sites are subsea/under-river tunnels. In Project III, the risk degree of collapse of the tunnel face owing to G8 (interface of different types of rock mass grades) was also high. In general, the risk degrees of Project I, which is a slurry shield TBM site, were lower than those of Projects II and III, which are EPB shield TBM sites.
When the CN-Matrix model was applied, the results of the risk degrees were similar to the STRAM-BN for each potential sub-risk event caused by the corresponding geological risk factors. However, the risk degree of the cuttability reduction was also high owing to G1 (hard or extremely hard rock/ground containing a large amount of quartz) in Project I. However, in Project I, the risk degrees of collapse of the tunnel face owing to G2 (fractured zone or faults) and G7 (mixed ground conditions) were evaluated to be low. In Project II, the risk degree of water leakage owing to G9 (ground with high water pressure) was found to be low.
As mentioned earlier, a direct comparison between the Matrix models and the Bayesian model is not feasible. The risk degree is obtained considering the top risk events in the FTA-AHP Matrix model, whereas the STRAM-BN and the CN-Matrix model determine the risk degree on the sub-risk event for each geological risk factor. In a simple comparison based on top risk events, except for the cuttability reduction event, which showed a high-risk degree in the Matrix models, all four models demonstrated a high degree of risk for the collapse of the tunnel face, incapability of mucking, and incapability of excavation events.
As presented in Table 12, in the case of event T4 (ground surface upheaval/spurt of slurry on the ground) in Project I, and events T3 (ground surface settlement) and T4 in Project III, the probability score is the highest (5), while the impact score is the lowest (1) in the FTA-AHP Matrix model, resulting in a risk degree (probability score × impact score) of 5 points. Then, the risk level is Negligible (I) of the lowest risk level in Figure 2. However, the risk level will increase up to Unwanted (III) if the ITA-Matrix model is applied even with the same frequency and consequence classes. In other words, it is possible for the FTA-AHP Matrix model to underestimate the risk degrees compared to the ITA Matrix model. It is believed that the risk level proposed by the ITA-Matrix model is more reasonable in this case because if the consequence of the event is disastrous despite the low frequency of occurrence, it might be more rational to assign a higher risk level than Negligible (I).
As for the event of the collapse of the tunnel face owing to G2 (fractured zone or faults), and G7 (mixed ground conditions) in Project I (see Table 13), the risk level obtained by the CN-Matrix model was significantly lower than that obtained by the other two models. This is because the CN-Matrix model evaluates an event as a low-risk level even when only one of the categories ranks as the highest class and the other ranks as the lowest class similar to the FTA-AHP Matrix model. From these results, it is rational to increase the risk levels of the CN-Matrix model. Some guidelines used the weighting scores for probability from the scale of 1 to 5 points to the scale of 0.05 to 0.8 points (0.05, 0.1, 0.2, 0.4, and 0.8) and for impact from the scale of 1 to 5 points to the scale of 0.1 to 0.9 points (0.1, 0.3, 0.5, 0.7, and 0.9) [1,2]. However, the guidelines cannot perfectly address the underestimating problem yet. Therefore, the CN-Matrix model modifies the weighting scores for both probability and impact identically on the scale of 0.05 to 0.8 points (0.05, 0.1, 0.2, 0.4, and 0.8) to overcome the underestimation. Moreover, because of the difficulty in calculating the risk levels by multiplying the decimal point of the weighting scores, the integers of the weighting scores on the scale of 1 to 11 points (1, 2, 4, 7, and 11) are also proposed. For this purpose, it is recommended in this paper to change the weighting scores for both probability and impact of the sub-risk events in the CN-Matrix model from the scale of 1 to 5 points to the scale of either 0.05 to 0.8 points (0.05, 0.1, 0.2, 0.4, and 0.8) or 1 to 11 points (1, 2, 4, 7, and 11) as shown in Figure 7.
In summary, the CN-Matrix model is an advanced version of the ITA-Matrix model and the FTA-AHP Matrix model, which is easily applicable to actual tunneling job sites compared to the STRAM-BN. To prevent underestimating when only one of the categories ranks as the highest class and the other ranks as the lowest class, the weighting scores for both probability and impact of the sub-risk events are modified in this model from the scale of 1 to 5 points to the scale of either 0.05 to 0.8 points (0.05, 0.1, 0.2, 0.4, and 0.8) or 1 to 11 points (1, 2, 4, 7, and 11). Furthermore, the impact of this model is determined based on the relative downtimes caused by each risk event, which is easier to apply in practice rather than estimating the cost of countermeasures.

5. Conclusions

In the present study, three tunnel risk analysis models (ITA-Matrix model, FTA-AHP Matrix model, and STRAM-BN), which are applicable to actual shield TBM tunnels, were compared in terms of their advantages and disadvantages. Based on the comparison and analysis results, an improved matrix model, a causal network-based risk matrix model (CN-Matrix model), was proposed. This new model complements the disadvantages and exploits the advantages of the three existing models. The conclusions of this study are as follows.
  • The ITA-Matrix model easily estimates the degree of risk, but its disadvantage is that it is a qualitative analysis/assessment model. The FTA-AHP Matrix model is a quantitative analysis/assessment model, but there are questions on the endowed weighting scores, which range from 1 to 5 for both the probability and impact categories. Furthermore, the current FTA-AHP Matrix model can be applied only in the design stage because it is difficult for this model to reflect the ground conditions of the job site due to its inability to estimate the degree of risk events caused by the corresponding geological risk factors.
  • The STRAM-BN, which uses the Bayesian network, can produce more reasonable results because this model estimates the degree of risk by using the cost of countermeasure on the designated job site; however, the disadvantage is that it is difficult to obtain this cost for a given site. Unlike the FTA-AHP Matrix model, the STRAM-BN has the advantage that it can be used for risk analysis in the construction stage as well as in the design stage because it can estimate the risk degree of sub-risk events caused by the corresponding geological risk factors.
  • According to the results of the comparative analysis for the three existing risk analysis models, this study proposes a new risk matrix model named the CN-Matrix model, which is a modified and improved version of the FTA-AHP Matrix model, by complementing the disadvantages of each model and exploiting their advantages. The CN-Matrix model can perform a risk analysis for sub-risk events in the same way as the STRAM-BN. In addition, the newly developed model can analyze risks even in the construction stage as well as in the design stage because it estimates the risk degree of sub-risk events caused by the corresponding geological risk factors, which is similar to the STRAM-BN.
  • This study proposed to change the weighting scores of the probability of the sub-risk event as well as its impact so that the change can address the underestimating problems. Furthermore, the impact of this model is determined based on the relative downtimes caused by each risk event, which is easier to apply in practice rather than estimating the cost of countermeasures. Thus, the improved CN-Matrix model is more reliable and robust than the three existing models.
Although this paper introduces a newly developed risk analysis model that exploits advantages of the previous conventional risk analysis models (i.e., ITA-Matrix model, FTA-AHP Matrix model, and STRAM-BN), it has some limitations. First, this study is entirely based on qualitative risk factors rather than quantitative ones. Because all of the conventional risk analysis models utilize the qualitative risk factors, the CN-Matrix model deals with risks for qualitative determination in order to compare with the conventional risk analysis models in the same manner. This lack of quantification may make it difficult to analyze risks during real-time construction. Second, since the probability of each risk factor and the impact of each event were determined for each job site via a questionnaire survey of TBM tunneling experts, the survey can be biased by respondent’s knowledge and experience.
In the follow-up research, the risk analysis model will be improved to overcome the upper mentioned limitations by considering quantitative risk factors and/or by adopting advanced data analysis technologies such as the machine learning algorithm. Moreover, it will be possible to improve objectivity and reliability of decision-making, which can also enable the automatic operation of TBM.

Author Contributions

Conceptualization, I.-M.L. and H.C. (Heeyoung Chung); Writing—original draft preparation, H.C. (Heeyoung Chung) and J.P.; Writing—review and editing, B.-K.K. and K.K.; Data curation, H.C. (Heeyoung Chung) and K.K.; Methodology, B.-K.K.; Investigation, H.C. (Heeyoung Chung) and J.P.; Supervision, I.-M.L. and H.C. (Hangseok Choi); Project administration, I.-M.L. and H.C. (Hangseok Choi); Funding acquisition, I.-M.L. and H.C. (Hangseok Choi). All authors have read and agreed to the published version of the manuscript.

Funding

This research was conducted with the support of the “National R&D Project for Smart Construction Technology (No.20SMIP-A158708-01)” funded by the Korea Agency for Infrastructure Technology Advancement under the Ministry of Land, Infrastructure.

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

Not applicable.

Acknowledgments

Management support was provided by Korea Expressway Corporation and is gratefully acknowledged.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Sharafat, A.; Latif, K.; Seo, J. Risk analysis of TBM tunneling projects based on generic bow-tie risk analysis approach in difficult ground conditions. Tunn. Undergr. Space Technol. 2021, 111, 103860. [Google Scholar] [CrossRef]
  2. Centers for Medicare & Medicaid Services. XLC Risk Management Guidance and Risk Register Instructions Version 2; Office of Information Services, Centers for Medicare & Medicaid Services: Baltimore, MD, USA, 2014.
  3. Project Management Institute. PMBOK Guide, 5th ed.; Project Management Institute, Inc.: Newtown Square, PA, USA, 2013. [Google Scholar]
  4. Tasmanian Government. Project Management Guidelines; Office of eGovernment, Department of Premier and Cabinet, Hobart: Tasmania, Australia, 2011.
  5. Land Transport Authority. Construction Safety Handbook; Land Transport Authority: Singapore, 2012.
  6. Land Transport Authority. Safety, Health and Environment (General Specification Appendix A); Land Transport Authority: Singapore, 2018.
  7. WSP | Parsons Brinckerhoff. NCHRP 08-36 Task 126 Development of Risk Register Spreadsheet Tool; Transportation Research Board, National Academy of Sciences: Washington, DC, USA, 2016. [Google Scholar]
  8. Ministry of Land, Infrastructure and Transport. Task Manual on Design for Safety; Ministry of Land, Infrastructure and Transport: Sejong, Korea, 2017.
  9. Korea Expressway Corporation Research Institute. A Development of Risk Management System for Safety Management During Tunnel Construction Stage; Korea Expressway Corporation Research Institute, Hwaseong: Gyeonggi, Korea, 2017. [Google Scholar]
  10. Einstein, H.H.; Indermitte, C.; Sinfield, J.; Descoeudres, F.P.; Dudt, J.-P. Decision aids for tunneling. Transp. Res. Rec. 1999, 1656, 6–13. [Google Scholar] [CrossRef]
  11. Min, S.; Einstein, H.; Lee, J.; Lee, H. Application of the Decision Aids for Tunneling (DAT) to update excavation cost/time information. KSCE J. Civ. Eng. 2005, 9, 335–346. [Google Scholar] [CrossRef]
  12. Hong, E.S.; Lee, I.M.; Shin, H.S.; Nam, S.W.; Kong, J.S. Quantitative risk evaluation based on event tree analysis technique: Application to the design of shield TBM. Tunn. Undergr. Space Technol. 2009, 24, 269–277. [Google Scholar] [CrossRef]
  13. Eskesen, S.D.; Tengborg, P.; Kampmann, J.; Veicherts, T.H. Guidelines for tunnelling risk management: International Tunnelling Association, Working Group No.2. Tunn. Undergr. Space Technol. 2004, 19, 217–237. [Google Scholar] [CrossRef]
  14. Hyun, K.C.; Min, S.; Choi, H.; Park, J.; Lee, I.M. Risk analysis using fault-tree analysis (FTA) and analytic hierarchy process (AHP) applicable to shield TBM tunnels. Tunn. Undergr. Space Technol. 2015, 49, 121–129. [Google Scholar] [CrossRef]
  15. Liu, Y.; Fan, Z.P.; Yuan, Y.; Li, H.Y. A FTA-based method for risk decision-making in emergency response. Comput. Oper. Res. 2014, 42, 49–57. [Google Scholar] [CrossRef] [PubMed]
  16. Zhou, X.Y.; Wang, L.Q.; Qin, J.D.; Chai, J.; Munoz, C.Q.G. Emergency rescue planning under probabilistic linguistic information: An integrated FTA-ANP method. Int. J. Disast. Risk Reduct. 2019, 37, 101170. [Google Scholar] [CrossRef]
  17. Saaty, T. The Analytical Hierarchy Process, Planning, Priority; RWS Publications: Pittshurgh, PA, USA, 1980. [Google Scholar]
  18. Chung, H.; Lee, I.-M.; Jung, J.-H.; Park, J. Bayesian networks-based shield TBM risk management system: Methodology development and application. KSCE J. Civ. Eng. 2019, 23, 452–465. [Google Scholar] [CrossRef]
Figure 1. Risk Matrix Proposed by International Tunnelling and Underground Space Association (ITA) [13].
Figure 1. Risk Matrix Proposed by International Tunnelling and Underground Space Association (ITA) [13].
Sustainability 13 04846 g001
Figure 2. Risk Matrix using fault tree analysis (FTA) and analytic hierarchy process (AHP) [14].
Figure 2. Risk Matrix using fault tree analysis (FTA) and analytic hierarchy process (AHP) [14].
Sustainability 13 04846 g002
Figure 3. Schematic of the shield TBM risk analysis model using the Bayesian network (STRAM-BN) [18].
Figure 3. Schematic of the shield TBM risk analysis model using the Bayesian network (STRAM-BN) [18].
Sustainability 13 04846 g003
Figure 4. Causal Networks between Geological Risk Factors and Risk Events: (a) Cuttability Reduction; (b) Those Related to Applying Face Pressure; (c) Incapability of Mucking; (d) Incapability of Excavation and Water Leakage.
Figure 4. Causal Networks between Geological Risk Factors and Risk Events: (a) Cuttability Reduction; (b) Those Related to Applying Face Pressure; (c) Incapability of Mucking; (d) Incapability of Excavation and Water Leakage.
Sustainability 13 04846 g004aSustainability 13 04846 g004b

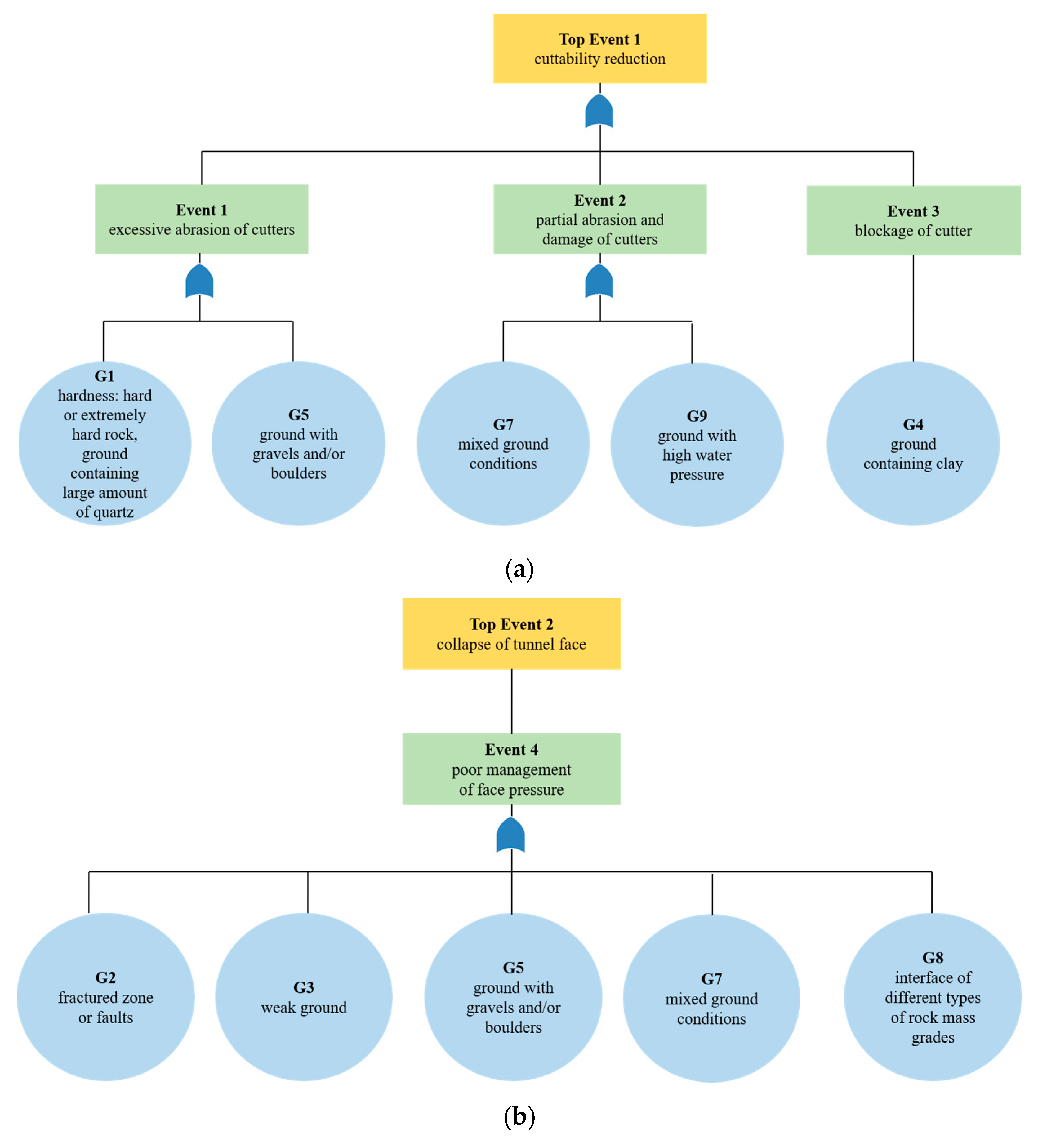

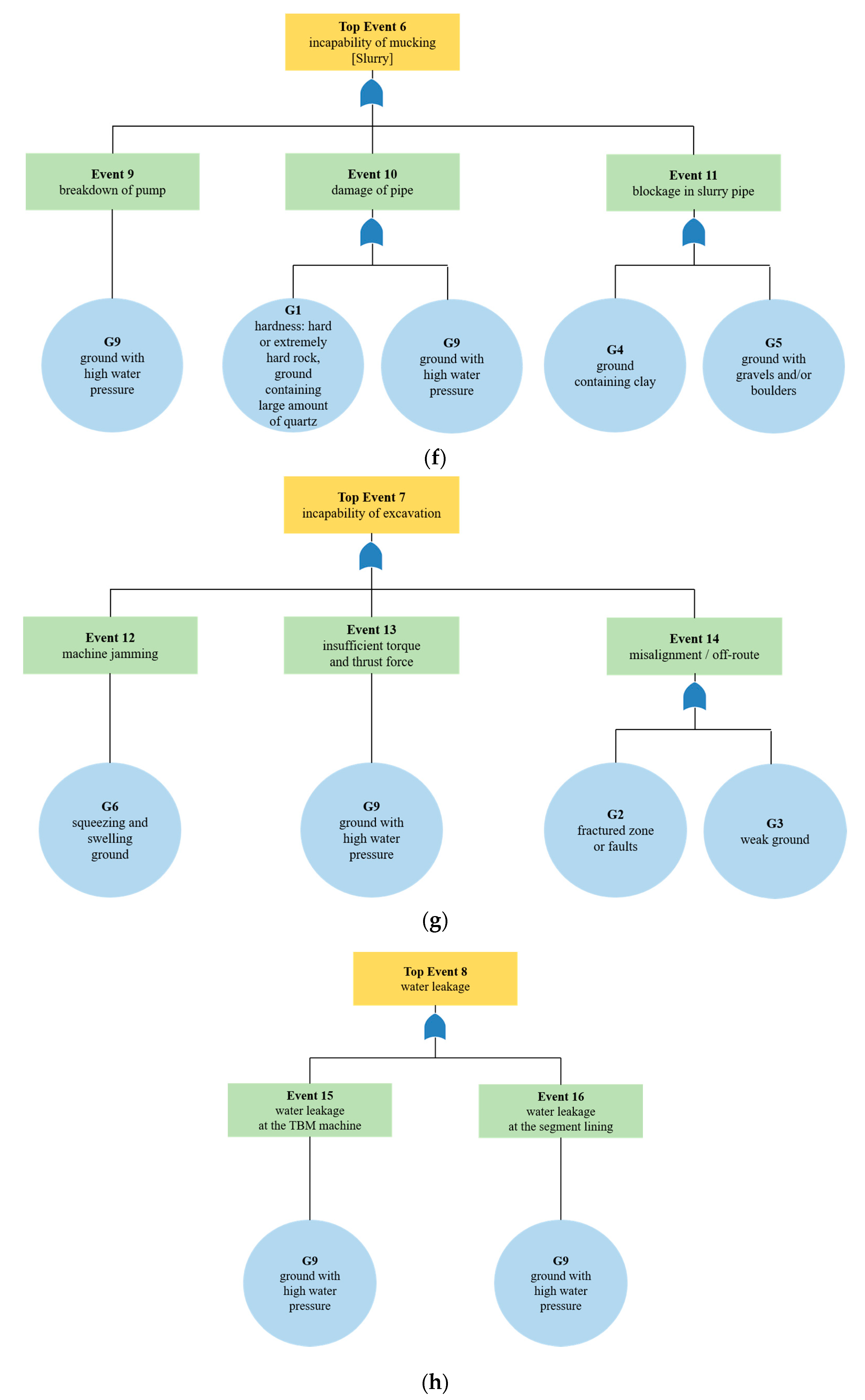

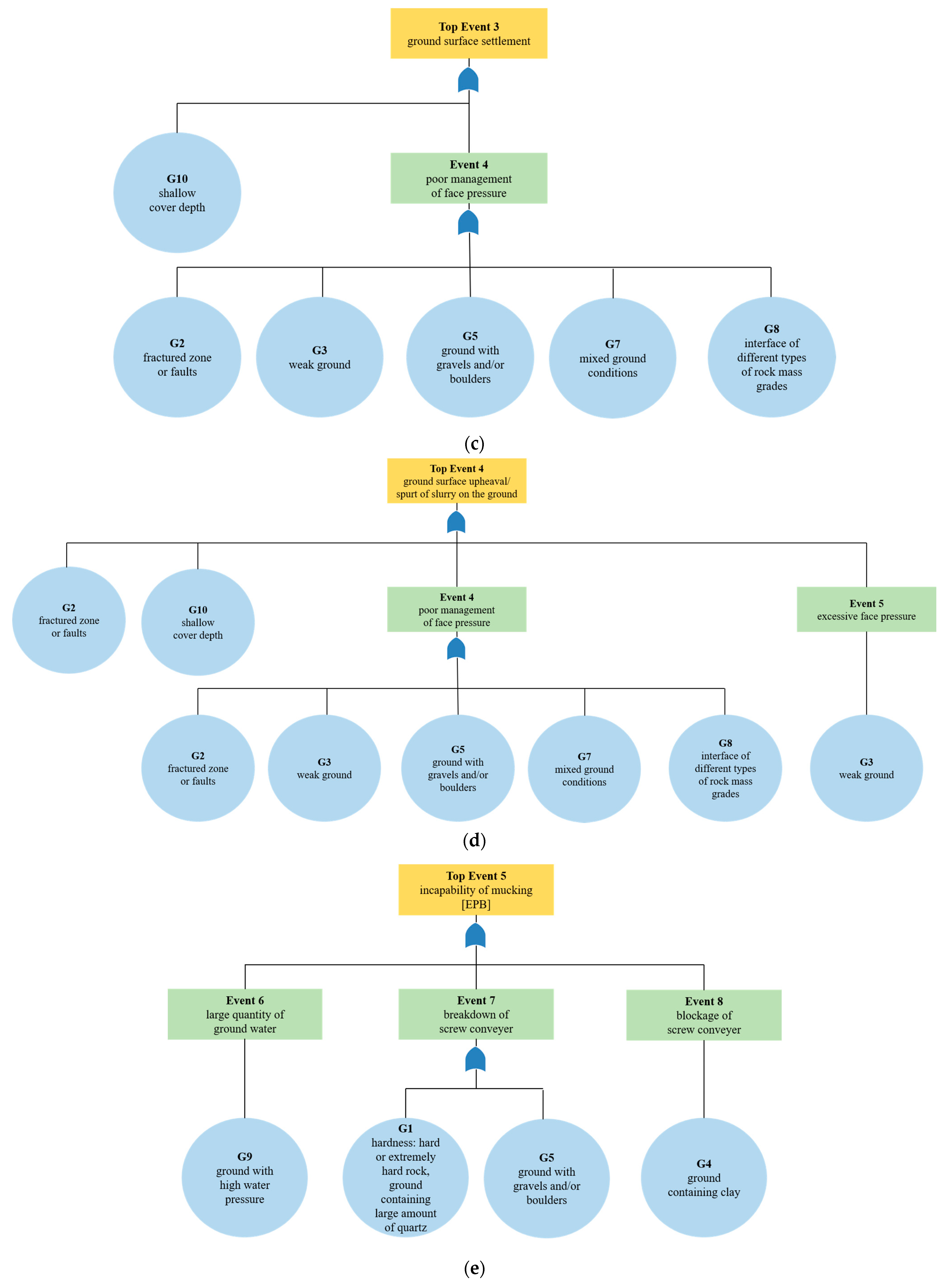

Figure 5. Restructured Fault Tree for Comparison with STRAM-BN: (a) Cuttability Reduction; (b) Collapse of tunnel face; (c) Ground surface settlement; (d) Ground surface upheaval/Spurt of slurry on the ground; (e) Incapability of mucking [EPB]; (f) Incapability of mucking [Slurry]; (g) Incapability of excavation; (h) Water leakage.
Figure 5. Restructured Fault Tree for Comparison with STRAM-BN: (a) Cuttability Reduction; (b) Collapse of tunnel face; (c) Ground surface settlement; (d) Ground surface upheaval/Spurt of slurry on the ground; (e) Incapability of mucking [EPB]; (f) Incapability of mucking [Slurry]; (g) Incapability of excavation; (h) Water leakage.
Sustainability 13 04846 g005aSustainability 13 04846 g005bSustainability 13 04846 g005c
Figure 6. Longitudinal Geological Profile of Each Project: (a) Project I; (b) Project II; (c) Project III.
Figure 6. Longitudinal Geological Profile of Each Project: (a) Project I; (b) Project II; (c) Project III.
Sustainability 13 04846 g006

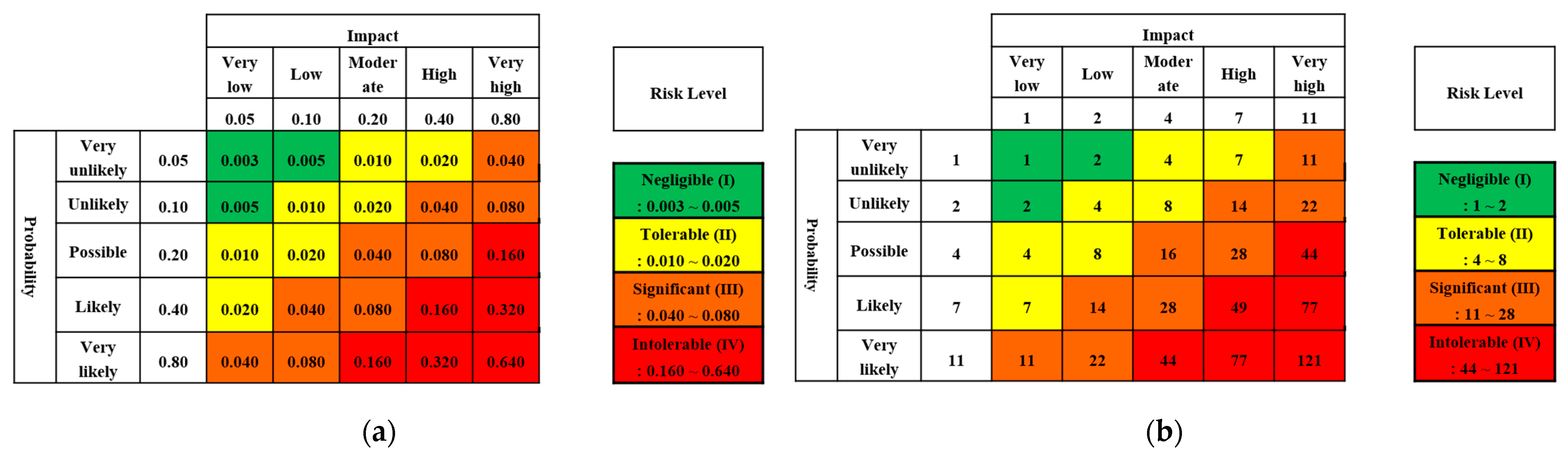

Figure 7. CN-Matrix Models: (a) Example 1; (b) Example 2.
Figure 7. CN-Matrix Models: (a) Example 1; (b) Example 2.
Sustainability 13 04846 g007
Table 1. Frequency Classification [13].
Table 1. Frequency Classification [13].
ClassInterval 1Central Value 1
Very likely>0.31
Likely0.03 to 0.30.1
Occasional0.003 to 0.030.01
Unlikely0.0003 to 0.0030.001
Very unlikely<0.00030.0001
1 Unit: potential number of events per year (during the whole construction period).
Table 2. Consequence Classification [13].
Table 2. Consequence Classification [13].
ClassInjury to Workers and Emergency Crew
[No. of Fatalities/Injuries] 1
Injury to Third Parties
[No. of Fatalities/Injuries] 1
Damage or Economic Loss to the Third Party
[Loss in Million Euro]
Harm to the Environment
[Guideline for
Proportions of Damage]
Delay
[Months per Hazard]
Economic Loss to the Owner
[Loss in Million Euro]
DisastrousF > 10F > 1,
SI > 10
>3Permanent severe damage>10 or >24>30
Severe1 < F ≤ 10,
SI > 10
1F,
1 < SI ≤ 10
0.3–3Permanent minor damage1–10 or 6–243–30
Serious1F,
1 < SI ≤ 10
1SI,
1 < MI ≤ 10
0.03–0.3Long-term effects0.1–1 or 2–60.3–3
Considerable1SI,
1 < MI ≤ 10
1MI0.003–0.03Temporary severe damage0.01–0.1 or 1/2–20.03–0.3
Insignificant1MI-<0.003Temporary minor damage<0.01 or <1/2<0.03
1 F, fatality; SI, serious injury; and MI, minor injury.
Table 3. Risk Response Phase [18].
Table 3. Risk Response Phase [18].
Response PhaseDegree of Risk 1Description
I0–10Excavation without mitigation measure owing to a low degree of risk
II10–30Excavation with the intention to prepare for the risk
III30–80Excavation with mitigation measure owing to a high degree of risk
IV>80Unconditionally applying mitigation measure owing to a very high degree of risk
1 Unit: ×103 US dollars.
Table 4. Frequency (Probability) comparison of ITA-Matrix Model, FTA-AHP Matrix Model, and STRAM-BN.
Table 4. Frequency (Probability) comparison of ITA-Matrix Model, FTA-AHP Matrix Model, and STRAM-BN.
Risk Analysis ModelFrequency (Probability)
ITA-Matrix modelDetermines the frequency class of a risk event based on the frequency classification criteria
- The grounds for the criteria are unclear [Disadvantage]
Sustainability 13 04846 i001
FTA-AHP Matrix modelDetermines the probability of top risk events by using FTA
- Difficult to calculate the probability of risk events for each geological risk factor [Disadvantage]
Sustainability 13 04846 i002
STRAM-BNDetermines the conditional probability of sub-risk events by using the Bayesian network
- Can calculate the probability of risk events for each geological risk factor [Advantage]
Sustainability 13 04846 i003
Table 5. Consequence (Impact) comparison of ITA-Matrix Model, FTA-AHP Matrix Model, and STRAM-BN.
Table 5. Consequence (Impact) comparison of ITA-Matrix Model, FTA-AHP Matrix Model, and STRAM-BN.
Risk Analysis ModelConsequence (Impact)
ITA-Matrix modelDetermines the consequence class based on the classification criteria of six consequence analysis items
- The grounds for the criteria are unclear [Disadvantage]
FTA-AHP Matrix modelCan determine the impact of top risk events using AHP even without cost estimation [Advantage]
STRAM-BNCost of countermeasure of the site are required [Disadvantage]
The consequence analysis results with consequence using the detailed countermeasure cost of the site further reflect site conditions [Advantage]
Table 6. Risk degree comparison of ITA-Matrix Model, FTA-AHP Matrix Model, and STRAM-BN.
Table 6. Risk degree comparison of ITA-Matrix Model, FTA-AHP Matrix Model, and STRAM-BN.
Risk Analysis ModelRisk Degree
ITA-Matrix modelCombination of frequency and consequence classes
-Relatively easy to determine [Advantage]
-It is based on qualitative analysis results [Disadvantage]
Difficult to determine the risk degree of potential risk events resulting from each geological risk factor [Disadvantage]
FTA-AHP Matrix modelProbability score × Impact score
(1–5 points) (1–5 points)
- Relatively easy to determine [Advantage]
- Quantitative analysis results [Advantage]
Difficult to determine the risk degree of potential risk events resulting from each geological risk factor [Disadvantage]
- Difficult to reflect site ground conditions
- Difficult to apply to the construction stage
STRAM-BNProbability × Countermeasure cost
(1–5 points) (1–5 points)
- Relatively complex to calculate [Disadvantage]
- Quantitative analysis results [Advantage]
Can determine the risk degree of potential risk events resulting from each geological risk factor [Advantage]
- Can reflect the site ground conditions
- Applicable to the construction stage as well as to the design stage
Table 7. Risk level (Risk response phase) comparison of ITA-Matrix Model, FTA-AHP Matrix Model, and STRAM-BN.
Table 7. Risk level (Risk response phase) comparison of ITA-Matrix Model, FTA-AHP Matrix Model, and STRAM-BN.
Risk Analysis ModelRisk Level (Risk Response Phase)
ITA-Matrix model
  • I: Negligible
  • II: Acceptable
  • III: Unwanted
  • IV: Unacceptable
FTA-AHP Matrix model
  • I (Negligible): 1–5
  • II (Tolerable): 6–9
  • III (Undesirable): 10–16
  • IV (Intolerable): 17–25
[Unit: scores]
STRAM-BN
  • I: 0–10
  • II: 10–30
  • III: 30–80
  • IV: 80–∞
[Unit: ×103 US dollars]
Table 8. Geological Risk Factors [18].
Table 8. Geological Risk Factors [18].
ClassGeological Risk Factor
G1Hardness: hard or extremely hard rock, ground containing a large amount of quartz
G2Fractured zone or faults
G3Weak ground
G4Ground containing clay
G5Ground with gravels and/or boulders
G6Squeezing and swelling ground
G7Mixed ground conditions
G8Interface of different types of rock mass grades
G9Ground with high water pressure
G10Shallow cover depth
Table 9. Potential Risk Events during Shield TBM Construction [18].
Table 9. Potential Risk Events during Shield TBM Construction [18].
Top Risk EventSub-Risk EventRisk Event No.
STRAM-BN/CN-MatrixFTA-AHP Matrix
Cuttability reductionExcessive abrasion of cuttersRE1-1T1
Partial abrasion and damage of cuttersRE1-2
Blockage of cutterRE1-3
Collapse of tunnel faceRE2T2
Ground surface settlementRE3T3
Ground surface upheaval [Slurry]RE4T4
Spurt of slurry on the ground [Slurry]RE5
Incapability of mucking [EPB]Large quantity of groundwaterRE6-1T5
Breakdown of screw conveyorRE6-2
Blockage of screw conveyorRE6-3
Incapability of mucking [Slurry]Damage of pipe and pumpRE6-4T6
Blockage of slurry pipeRE6-5
Incapability of excavationMachine jammingRE7-1T7
Insufficient torque and thrust forceRE7-2
Misalignment/Off-routeRE7-3
Water leakageRE8T8
Table 10. Overview of Three Projects.
Table 10. Overview of Three Projects.
Project IProject IIProject III
TBM typeSlurry shield TBMEPB shield TBMEPB shield TBM
Tunnel length1.28 km2.695 km6.297 km
Tunnel diameter7.66 m7.8 m9.7 m
Maximum water depthAbout 35 m
(Under-river tunnel)
About 45 m
(Under-river tunnel)
About 80 m
(Subsea tunnel)
Table 11. Score Rating of Probability and Impact [14].
Table 11. Score Rating of Probability and Impact [14].
ScoreProbability ClassProbabilityScoreImpact ClassImpact
5Very likelyMore than 80%5Very highMore than 0.16
4Likely50–80%4High0.12–0.16
3Occasional30–50%3Moderate0.08–0.12
2Unlikely10–30%2Low0.04–0.08
1Very unlikelyBelow 10%1Very lowBelow 0.04
Table 12. Risk Analysis Results using FTA-AHP Matrix Model and ITA-Matrix Model for Each Project.
Table 12. Risk Analysis Results using FTA-AHP Matrix Model and ITA-Matrix Model for Each Project.
Risk EventProject IProject IIProject III
FTA-AHP
Matrix
ITA-MatrixFTA-AHP
Matrix
ITA-MatrixFTA-AHP
Matrix
ITA-Matrix
Probability ScoreImpact ScoreRisk Score (Level)FrequencyConsequenceRisk Level 1Probability scoreImpact ScoreRisk Score (Level)FrequencyConsequenceRisk Level 1Probability ScoreImpact ScoreRisk Score (Level)FrequencyConsequenceRisk Level 1
T1Cuttability reduction4520
(IV)
LikelySeriousIII4312
(III)
OccasionalSeriousIII5315
(III)
LikelySeriousIII
T2Collapse of tunnel face4520
(IV)
OccasionalSevereIII4520
(IV)
OccasionalSevereIII4520
(IV)
OccasionalSevereIII
T3Ground surface settlement414
(I)
OccasionalConsiderableII414
(I)
UnlikelyConsiderableII515
(I)
OccasionalConsiderableII
T4Ground surface upheaval/Spurt of slurry on the ground [Slurry]515
(I)
OccasionalConsiderableII414
(I)
Very unlikelyInsignificantI515
(I)
Very unlikelyInsignificantI
T5Incapability of mucking [EPB]313
(I)
Very unlikelyConsiderableI2510
(III)
OccasionalSeriousIII4520
(IV)
OccasionalSeriousIII
T6Incapability of mucking [Slurry]3412
(III)
OccasionalSeriousIII313
(I)
Very unlikelyConsiderableI414
(I)
Very unlikelyConsiderableI
T7Incapability of excavation3515
(III)
UnlikelySevereIII3515
(III)
OccasionalSevereIII4520
(IV)
OccasionalSevereIII
T8Water leakage133
(I)
OccasionalConsiderableII3412
(III)
LikelySeriousIII339
(II)
LikelySevereIV
1 Risk level: Negligible (I), Acceptable (II), Unwanted (III), Unacceptable (IV).
Table 13. Risk Analysis Results using STRAM-BN, CN-Matrix Model, and ITA-Matrix Model for Project I.
Table 13. Risk Analysis Results using STRAM-BN, CN-Matrix Model, and ITA-Matrix Model for Project I.
Geological Risk FactorRisk EventSTRAM-BNCN-MatrixITA-Matrix
Degree of Risk 1
(Risk Level)
Probability ScoreImpact ScoreRisk Score
(Level)
FrequencyConsequenceRisk Level
G1Hardness: hard or extremely hard rock, ground containing large amount of quartzRE1-1Cuttability reduction
(Excessive abrasion of cutters)
24.64 (II)4312 (III)LikelySeriousIII
RE6-4Incapability of mucking
(Damage of pipe and pump)
25.14 (II)3412 (III)OccasionalSeriousIII
G2Fractured zone or faultsRE2Collapse of tunnel face33.43 (III)155 (I)UnlikelySevereIII
RE7-3Incapability of excavation
(Misalignment/Off-route)
4.22 (I)212 (I)UnlikelySeriousII
G4Ground containing clayRE1-3Cuttability reduction
(Blockage of cutter)
19.34 (II)428 (II)OccasionalSeriousIII
RE6-5Incapability of mucking
(Blockage of slurry pipe)
10.21 (II)224 (I)UnlikelySeriousII
G7Mixed ground conditionsRE1-2Cuttability reduction
(Partial abrasion and damage of cutters)
15.04 (II)339 (II)LikelySeriousIII
RE2Collapse of tunnel face33.43 (III)155 (I)UnlikelySevereIII
G9Ground with high water pressureRE1-2Cuttability reduction
(Partial abrasion and damage of cutters)
17.28 (II)339 (II)UnlikelySeriousII
RE6-4Incapability of mucking
(Damage of pipe and pump)
36.79 (III)3412 (III)OccasionalSeriousIII
RE7-2Incapability of excavation
(Insufficient torque and thrust force)
88.57 (IV)2510 (III)UnlikelySevereIII
RE8Water leakage6.62 (I)224 (I)UnlikelySeriousII
1 Unit: ×103 US dollars.
Table 14. Risk Analysis Results using STRAM-BN, CN-Matrix Model, and ITA-Matrix Model for Project II.
Table 14. Risk Analysis Results using STRAM-BN, CN-Matrix Model, and ITA-Matrix Model for Project II.
Geological Risk FactorRisk EventEPB-OpenEPB-Closed
STRAM-BNCN-MatrixITA-MatrixSTRAM-BNCN-MatrixITA-Matrix
Degree of Risk 1
(Risk Level)
Probability ScoreImpact ScoreRisk Score (Level)Risk LevelDegree of Risk 1
(Risk Level)
Probability ScoreImpact ScoreRisk Score (Level)Risk Level
G2Fractured zone or faultsRE2Collapse of tunnel face123.52 (IV)4520 (IV)IV68.62 (III)2510 (III)III
RE7-3Incapability of excavation
(Misalignment/Off-route)
3.98 (I)212 (I)II3.98 (I)212 (I)II
G4Ground containing clayRE1-3Cuttability reduction
(Blockage of cutter)
9.40 (I)224 (I)II14.65 (II)326 (II)II
RE6-3Incapability of mucking
(Blockage of screw conveyer)
6.08 (I)212 (I)II6.64 (I)212 (I)II
G7Mixed ground conditionsRE1-2Cuttability reduction
(Partial abrasion and damage of cutters)
18.61 (II)326 (II)III20.01 (II)326 (II)III
RE2Collapse of tunnel face123.52 (IV)4520 (IV)IV68.62 (III)2510 (III)III
G9Ground with high water pressureRE1-2Cuttability reduction
(Partial abrasion and damage of cutters)
18.61 (II)326 (II)III22.47 (II)428 (II)III
RE6-1Incapability of mucking
(Large quantity of ground water)
93.84 (IV)4520 (IV)IV64.97 (III)3515 (III)III
RE7-2Incapability of excavation
(Insufficient torque and thrust force)
83.24 (IV)2510 (III)III83.24 (IV)2510 (III)III
RE8Water leakage31.38 (III)339 (II)IV10.61 (II)236 (II)III
1 Unit: ×103 US dollars.
Table 15. Risk Analysis Results using STRAM-BN, CN-Matrix Model, and ITA-Matrix Model for Project III.
Table 15. Risk Analysis Results using STRAM-BN, CN-Matrix Model, and ITA-Matrix Model for Project III.
Geological Risk FactorRisk EventEPB-OpenEPB-Closed
STRAM-BNCN-MatrixITA-MatrixSTRAM-BNCN-MatrixITA-Matrix
Degree of Risk 1
(Risk Level)
Probability ScoreImpact ScoreRisk Score (Level)Risk LevelDegree of Risk 1
(Risk Level)
Probability ScoreImpact ScoreRisk Score (Level)Risk Level
G1Hardness: hard or extremely hard rock, ground containing large amount of quartzRE1-1Cuttability reduction
(Excessive abrasion of cutters)
26.96 (II)428 (II)III31.52 (III)5210 (III)III
RE6-2Incapability of mucking
(Breakdown of screw conveyer)
24.87 (II)224 (I)III27.07 (II)224 (I)III
G2Fractured zone or faultsRE2Collapse of tunnel face112.17 (IV)4520 (IV)IV62.31 (III)2510 (III)III
RE7-3Incapability of excavation
(Misalignment/Off-route)
3.77 (I)212 (I)II3.77 (I)212 (I)II
G4Ground containing clayRE1-3Cuttability reduction
(Blockage of cutter)
7.00 (I)212 (I)II10.92 (II)313 (I)II
RE6-3Incapability of mucking
(Blockage of screw conveyer)
4.53 (I)212 (I)II4.94 (I)212 (I)II
G7Mixed ground conditionsRE1-2Cuttability reduction
(Partial abrasion and damage of cutters)
18.56 (II)326 (II)III21.01 (II)326 (II)III
RE2Collapse of tunnel face112.17 (IV)4520 (IV)IV62.31 (III)2510 (III)III
G8Interface of different types of rock mass gradesRE2Collapse of tunnel face112.17 (IV)4520 (IV)III62.31 (III)2510 (III)III
G9Ground with high water pressureRE1-2Cuttability reduction
(Partial abrasion and damage of cutters)
18.56 (II)326 (II)III23.46 (II)428 (II)III
RE6-1Incapability of mucking
(Large quantity of ground water)
116.26 (IV)4520 (IV)IV80.49 (IV)3515 (III)IV
RE7-2Incapability of excavation
(Insufficient torque and thrust force)
191.20 (IV)2510 (III)III191.20 (IV)2510 (III)III
RE8Water leakage29.75 (II)339 (II)IV10.06 (II)236 (II)III
1 Unit: ×103 US dollars.
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Chung, H.; Park, J.; Kim, B.-K.; Kwon, K.; Lee, I.-M.; Choi, H. A Causal Network-Based Risk Matrix Model Applicable to Shield TBM Tunneling Projects. Sustainability 2021, 13, 4846. https://doi.org/10.3390/su13094846

AMA Style

Chung H, Park J, Kim B-K, Kwon K, Lee I-M, Choi H. A Causal Network-Based Risk Matrix Model Applicable to Shield TBM Tunneling Projects. Sustainability. 2021; 13(9):4846. https://doi.org/10.3390/su13094846

Chicago/Turabian Style

Chung, Heeyoung, Jeongjun Park, Byung-Kyu Kim, Kibeom Kwon, In-Mo Lee, and Hangseok Choi. 2021. "A Causal Network-Based Risk Matrix Model Applicable to Shield TBM Tunneling Projects" Sustainability 13, no. 9: 4846. https://doi.org/10.3390/su13094846

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
